Build IT Capabilities to Enable Digital Marketing Success

  • Buy Link or Shortcode: {j2store}553|cart{/j2store}
  • member rating overall impact: N/A
  • member rating average dollars saved: N/A
  • member rating average days saved: N/A
  • Parent Category Name: Marketing Solutions
  • Parent Category Link: /marketing-solutions
  • Misalignment: Even if IT builds the capabilities to pursue digital channels, the channels will underperform in realizing organizational goals if the channels and the goals are misaligned.
  • Ineffective analytics: Failure to integrate and analyze new data will undermine organizational success in influencer and sentiment identification.
  • Missed opportunity: If IT does not develop the capabilities to support these channels, then lead generation, brand promotion, and engagement opportunities will be lost.
  • Lack of control: Marketing is developing and depending on internal power users and agencies. This practice can isolate IT from digital marketing technology decision making.

Our Advice

Critical Insight

  • Identify and understand the digital marketing channels that can benefit your organization.
  • Get stakeholder buy-in to facilitate collaboration between IT and product marketing groups to identify necessary IT capabilities.
  • Build IT capability by purchasing software, outsourcing, and training or hiring individuals with necessary skillsets.
  • Become transformational: use IT capabilities to support analytics that identify new customer segments, key influencers, and other invaluable insights.
  • Time is of the essence! It is easier to begin strengthening the relationship between marketing and IT today then it will be at any point in the future.
  • Being transformational means more than just enabling the channels marketing wants to pursue; IT must assist in identifying new segments and digital marketing opportunities, such as enabling influencer management.

Impact and Result

  • IT is involved in decision making and has a complete understanding of the digital channels the organization is going to migrate to or phase out if unused.
  • IT has the necessary capabilities to support and enable success in all relevant digital channel management technologies.
  • IT is a key player in ensuring that all relevant data from new digital channels is managed and analyzed in order to maintain a 360 degree view of customers and feed real-time campaigns.
  • This enables the organization to not only target existing segments effectively, but also to identify and pursue new opportunities not presented before.
  • These opportunities include: identifying new segments among social networks, identifying key influencers as a new target, identifying proactive service and marketing opportunities from the public social cloud, and conducting new competitive analyses on the public social cloud.

Build IT Capabilities to Enable Digital Marketing Success Research & Tools

Besides the small introduction, subscribers and consulting clients within this management domain have access to:

1. Make the case for building IT capabilities

Identify the symptoms of inadequate IT support of digital marketing to diagnose the problems in your organization.

  • Storyboard: Build IT Capabilities to Enable Digital Marketing Success

2. Identify digital marketing opportunities to understand the need for action in your organization

Identify the untapped digital marketing value in your organization to understand where your organization needs to improve.

  • Digital Marketing Capability Builder Tool

3. Mobilize for action: get stakeholder buy-in

Develop a plan for communicating with stakeholders to ensure buy-in to the digital marketing capability building project.

  • Digital Marketing Communication Deck

4. Identify the product/segment-specific digital marketing landscape to identify required IT capabilities

Assess how well each digital channel reaches target segments. Identify the capabilities that must be built to enable digital channels.

5. Create a roadmap for building capabilities to enable digital marketing

Assess the people, processes, and technologies required to build required capabilities and determine the best fit with your organization.

[infographic]

Workshop: Build IT Capabilities to Enable Digital Marketing Success

Workshops offer an easy way to accelerate your project. If you are unable to do the project yourself, and a Guided Implementation isn't enough, we offer low-cost delivery of our project workshops. We take you through every phase of your project and ensure that you have a roadmap in place to complete your project successfully.

1 Identify Digital Marketing Opportunities

The Purpose

Determine the fit of each digital channel with your organizational goals.

Determine the fit of digital channels with your organizational structure and business model.

Compare the fit of digital channels with your organization’s current levels of use to:Identify missed opportunities your organization should capitalize on.Identify digital channels that your organization is wasting resources on.

Identify missed opportunities your organization should capitalize on.

Identify digital channels that your organization is wasting resources on.

Key Benefits Achieved

IT department achieves consensus around which opportunities need to be pursued.

Understanding that continuing to pursue excellent-fit digital channels that your organization is currently active on is a priority.

Identification of the channels that stopping activity on could free up resources for.

Activities

1.1 Define and prioritize organizational goals.

1.2 Assess digital channel fit with goals and organizational characteristics.

1.3 Identify missed opportunities and wasted resources in your digital channel mix.

1.4 Brainstorm creative ways to pursue untapped digital channels.

Outputs

Prioritized list of organizational goals.

Assigned level of fit to digital channels.

List of digital channels that represent missed opportunities or wasted resources.

List of brainstormed ideas for pursuing digital channels.

2 Identify Your Product-Specific Digital Marketing Landscape

The Purpose

Identify the digital channels that will be used for specific products and segments.

Identify the IT capabilities that must be built to enable digital channels.

Prioritize the list of IT capabilities.

Key Benefits Achieved

IT and marketing achieve consensus around which digital channels will be pursued for specific product-segment pairings.

Identification of the capabilities that IT must build.

Activities

2.1 Assess digital channel fit with specific products.

2.2 Identify the digital usage patterns of target segments.

2.3 Decide precisely which digital channels you will use to sell specific products to specific segments.

2.4 Identify and prioritize the IT capabilities that need to be built to succeed on each digital channel.

Outputs

Documented channel fit with products.

Documented channel usage by target segments.

Listed digital channels that will be used for each product-segment pairing.

Listed and prioritized capabilities that must be built to enable success on necessary digital channels.

3 Enable Digital Marketing Capabilities and Leverage Analytics

The Purpose

Identification of the best possible way to build IT capabilities for all channels.

Creation of a plan for leveraging transformational analytics to supercharge your digital marketing strategy.

Key Benefits Achieved

IT understanding of the costs and benefits of capability building options (people, process, and technology).

Information about how specific technology vendors could fit with your organization.

IT identification of opportunities to leverage transformational analytics in your organization.

Activities

3.1 Identify the gaps in your IT capabilities.

3.2 Evaluate options for building capabilities.

3.3 Identify opportunities for transformational analytics.

Outputs

A list of IT capability gaps.

An action plan for capability building.

A plan for leveraging transformational analytics.

Enterprise Architecture Trends

  • Buy Link or Shortcode: {j2store}584|cart{/j2store}
  • member rating overall impact: N/A
  • member rating average dollars saved: N/A
  • member rating average days saved: N/A
  • Parent Category Name: Strategy & Operating Model
  • Parent Category Link: /strategy-and-operating-model
  • The digital transformation journey brings business and technology increasingly closer.
  • Because the two become more and more intertwined, the role of the enterprise architecture increases in importance, aligning the two in providing additional efficiencies.
  • The current need for an accelerated digital transformation elevates the importance of enterprise architecture.

Our Advice

Critical Insight

  • Enterprise architecture is impacted and has an increasing role in the following areas:
    • Business agility
    • Security
    • Innovation
    • Collaborative EA
    • Tools and automation

Impact and Result

EA’s role in brokering and negotiating overlapping areas can lead to the creation of additional efficiencies at the enterprise level.

Enterprise Architecture Trends Research & Tools

Besides the small introduction, subscribers and consulting clients within this management domain have access to:

1. Enterprise Architecture Trends Deck – A trend report to support executives as they digitally transform the enterprise.

In an accelerated path to digitization, the increasingly important role of enterprise architecture is one of collaboration across siloes, inside and outside the enterprise, in a configurable way that allows for quick adjustment to new threats and conditions, while embracing unprecedented opportunities to scale, stimulating innovation, in order to increase the organization’s competitive advantage.

  • Enterprise Architecture Trends Report

Infographic

Further reading

Enterprise Architecture Trends

Supporting Executives to Digitally Transform the Enterprise

Analyst Perspective

Enterprise architecture, seen as the glue of the organization, aligns business goals with all the other aspects of the organization, providing additional effectiveness and efficiencies while also providing guardrails for safety.

In an accelerated path to digitization, the increasingly important role of enterprise architecture (EA) is one of collaboration across siloes, inside and outside the enterprise, in a configurable way that allows for quick adjustment to new threats and conditions while embracing unprecedented opportunities to scale, stimulating innovation to increase the organization’s competitive advantage.

Photo of Milena Litoiu, Principal/Senior Director, Enterprise Architecture, Info-Tech Research Group.

Milena Litoiu
Principal/Senior Director, Enterprise Architecture
Info-Tech Research Group

Accelerated digital transformation elevates the importance of EA

The Digital transformation journey brings Business and technology increasingly closer.

Because the two become more and more intertwined, the role OF Enterprise Architecture increases in importance, aligning the two in providing additional efficiencies.

THE Current need for an accelerated Digital transformation elevates the importance of Enterprise Architecture.

More than 70% of organizations revamp their enterprise architecture programs. (Info-Tech Tech Trends 2022 Survey)

Most organizations still see a significant gap between the business and IT.

Enterprise Architecture (EA) is impacted and has an increasing role in the following areas

Accelerated Digital Transformation

  • Business agility Business agility, needed more that ever, increases reliance on enterprise strategies.
    EA creates alignment between business and IT to improve business nimbleness.
  • Security More sophisticated attacks require more EA coordination.
    EA helps adjust to the increasing sophistication of external threats. Partnering with the CISO office to develop strategies to protect the enterprise becomes a prerequisite for survival.
  • Innovation EA's role in an innovation increases synergies at the enterprise level.
    EA plays an increasingly stronger role in innovation, from business endeavors to technology, across business units, etc.
  • Collaborative EA Collaborative EA requires new ways of working.
    Enterprise collaboration gains new meaning, replacing stiff governance.
  • Tools & automation Tools-based automation becomes increasingly common.
    Tools support as well as new artificial intelligence or machine- learning- powered approaches help achieve tools-assisted coordination across viewpoints and teams.

Info-Tech Insight

EA's role in brokering and negotiating overlapping areas can lead to the creation of additional efficiencies at the enterprise level.

EA Enabling Business Agility

Trend 01 — Business Agility is needed more than ever and THIS increases reliance on enterprise Strategies. to achieve nimbleness, organizations need to adapt timely to changes in the environment.

Approaches:
A plethora of approaches are needed (e.g. architecture modularity, data integration, AI/ML) in addition to other Agile/iterative approaches for the entire organization.

Deliver on Your Digital Product Vision

  • Buy Link or Shortcode: {j2store}351|cart{/j2store}
  • member rating overall impact: 9.2/10 Overall Impact
  • member rating average dollars saved: $133,318 Average $ Saved
  • member rating average days saved: 30 Average Days Saved
  • Parent Category Name: Development
  • Parent Category Link: /development
  • Product organizations are under pressure to align the value they provide to the organization’s goals and overall company vision.
  • You need to clearly convey your direction, strategy, and tactics to gain alignment, support, and funding from your organization.
  • Products require continuous additions and enhancements to sustain their value. This requires detailed, yet simple communication to a variety of stakeholders.

Our Advice

Critical Insight

  • A vision without tactics is an unsubstantiated dream, while tactics without a vision is working without a purpose. You need to have a handle on both to achieve outcomes that are aligned with the needs of your organization.

Impact and Result

  • Recognize that a vision is only as good as the data that backs it up – lay out a comprehensive backlog with quality built-in that can be effectively communicated and understood through roadmaps.
  • Your intent is only a dream if it cannot be implemented – define what goes into a release plan via the release canvas.
  • Define a communication approach that lets everyone know where you are heading.

Deliver on Your Digital Product Vision Research & Tools

Start here – read the Executive Brief

Read our concise Executive Brief to find out why you should build a digital product vision that you can stand behind. Review Info-Tech’s methodology and understand the four ways we can support you in completing this project.

Besides the small introduction, subscribers and consulting clients within this management domain have access to:

1. Define a digital product vision

Define a digital product vision that takes into account your objectives, business value, stakeholders, customers, and metrics.

  • Deliver on Your Digital Product Vision – Phase 1: Define a Digital Product Vision
  • Digital Product Strategy Template
  • Digital Product Strategy Supporting Workbook

2. Build a better backlog

Build a structure for your backlog that supports your product vision.

  • Deliver on Your Digital Product Vision – Phase 2: Build a Better Backlog
  • Product Backlog Item Prioritization Tool

3. Build a product roadmap

Define standards, ownership for your backlog to effectively communicate your strategy in support of your digital product vision.

  • Deliver on Your Digital Product Vision – Phase 3: Build a Product Roadmap
  • Product Roadmap Tool

4. Release and deliver value

Understand what to consider when planning your next release.

  • Deliver on Your Digital Product Vision – Phase 4: Release and Deliver Value

5. Communicate the strategy – make it happen

Build a plan for communicating and updating your strategy and where to go next.

  • Deliver on Your Digital Product Vision – Phase 5: Communicate the Strategy – Make It Happen!

Infographic

Workshop: Deliver on Your Digital Product Vision

Workshops offer an easy way to accelerate your project. If you are unable to do the project yourself, and a Guided Implementation isn't enough, we offer low-cost delivery of our project workshops. We take you through every phase of your project and ensure that you have a roadmap in place to complete your project successfully.

1 Define a Digital Product Vision

The Purpose

Understand the elements of a good product vision and the pieces that back it up.

Key Benefits Achieved

Provide a great foundation for an actionable vision and goals people can align to.

Activities

1.1 Build out the elements of an effective digital product vision

Outputs

Completed product vision definition for a familiar product via the product canvas

2 Build a Better Backlog

The Purpose

Define the standards and approaches to populate your product backlog that support your vision and overall strategy.

Key Benefits Achieved

A prioritized backlog with quality throughout that enables alignment and the operationalization of the overall strategy.

Activities

2.1 Introduction to key activities required to support your digital product vision

2.2 What do we mean by a quality backlog?

2.3 Explore backlog structure and standards

2.4 Define backlog data, content, and quality filters

Outputs

Articulate the activities required to support the population and validation of your backlog

An understanding of what it means to create a quality backlog (quality filters)

Defining the structural elements of your backlog that need to be considered

Defining the content of your backlog and quality standards

3 Build a Product Roadmap

The Purpose

Define standards and procedures for creating and updating your roadmap.

Key Benefits Achieved

Enable your team to create a product roadmap to communicate your product strategy in support of your digital product vision.

Activities

3.1 Disambiguating backlogs vs. roadmaps

3.2 Defining audiences, accountability, and roadmap communications

3.3 Exploring roadmap visualizations

Outputs

Understand the difference between a roadmap and a backlog

Roadmap standards and agreed-to accountability for roadmaps

Understand the different ways to visualize your roadmap and select what is relevant to your context

4 Define Your Release, Communication, and Next Steps

The Purpose

Build a release plan aligned to your roadmap.

Key Benefits Achieved

Understand what goes into defining a release via the release canvas.

Considerations in communication of your strategy.

Understand how to frame your vision to enable the communication of your strategy (via an executive summary).

Activities

4.1 Lay out your release plan

4.2 How to introduce your product vision

4.3 Communicate changes to your strategy

4.4 Where do we get started?

Outputs

Release canvas

An executive summary used to introduce other parties to your product vision

Specifics on communication of the changes to your roadmap

Your first step to getting started

Take the First Steps to Embrace Open-Source Software

  • Buy Link or Shortcode: {j2store}164|cart{/j2store}
  • member rating overall impact: N/A
  • member rating average dollars saved: N/A
  • member rating average days saved: N/A
  • Parent Category Name: Development
  • Parent Category Link: /development

Your organization is looking to invest in new software or a tool to solve key business and IT problems. They see open source as a viable option given the advertised opportunities and the popularity of many open-source projects, but they have concerns:

  • Despite the longevity and broad adoption of open-source software, stakeholders are hesitant about its long-term viability and the costs of ongoing support.
  • A clear direction and strategy are needed to align the expected value of open source to your stakeholders’ priorities and gain the funding required to select, implement, and support open-source software.

Our Advice

Critical Insight

  • Position open source in the same light as commercial software. The continuous improvement and evolution of popular open-source software and communities have established a reputation for reliability in the industry.
  • Consider open source as another form of outsource development. Open source is externally developed software where the code is accessible and customizable. Code quality may not align to your organization’s standards, which can require extensive testing and optimization.
  • Treat open source as any internally developed solution. Configurations, integrations, customizations, and orchestrations of open-source software are often done at the code level. While some community support is provided, most of the heavy lifting is done by the applications team.

Impact and Result

  • Outline the value you expect to gain. Discuss current business and IT priorities, use cases, and value opportunities to determine what to expect from open-source versus commercial software.
  • Define your open-source selection criteria. Clarify the driving factors in your evaluation of open-source and commercial software using your existing IT procurement practices as a starting point.
  • Assess the readiness of your team. Clarify the roles, processes, and tools needed for the implementation, use, and maintenance of open-source software.

Take the First Steps to Embrace Open-Source Software Research & Tools

Besides the small introduction, subscribers and consulting clients within this management domain have access to:

1. Take the First Steps to Embrace Open-Source Software Storyboard – A guide to learn the fit, value, and considerations of open-source software.

This research walks you through the misconceptions about open source, factors to consider in its selection, and initiatives to prepare your teams for its adoption.

  • Take the First Steps to Embrace Open-Source Software Storyboard

2. Open-Source Readiness Assessment – A tool to help you evaluate your readiness to embrace open-source software in your environment.

Use this tool to identify key gaps in the people, processes, and technologies needed to support open source in your organization. It also contains a canvas to facilitate discussions about expectations with your stakeholders and applications teams.

  • Open-Source Readiness Assessment
[infographic]

Further reading

Take the First Steps to Embrace Open-Source Software

Begin to understand what is required to embrace open-source software in your organization.

Analyst Perspective

With great empowerment comes great responsibilities.

Open-source software promotes enticing technology and functional opportunities to any organization looking to modernize without the headaches of traditional licensing. Many organizations see the value of open source in its ability to foster innovation, be flexible to various use cases and system configurations, and give complete control to the teams who are using and managing it.

However, open source is not free. While the software is freely and easily accessible, its use and sharing are bound by its licenses, and its implementation requires technical expertise and infrastructure investments. Your organization must be motivated and capable of taking on the various services traditionally provided and managed by the vendor.

Photo of Andrew Kum-Seun

Andrew Kum-Seun
Research Director,
Application Delivery and Application Management
Info-Tech Research Group

Executive Summary

Your Challenge

Your organization is looking to invest in new software or a tool to solve key business and IT problems. They see open source as a viable option because of the advertised opportunities and the popularity of many open-source projects.

Despite the longevity and the broad adoption of open-source software, stakeholders are hesitant about its adoption, its long-term viability, and the costs of ongoing support.

A clear direction and strategy is needed to align the expected value of open source to your stakeholders’ priorities and gain the funding required to select, implement, and support open-source software.

Common Obstacles

Your stakeholders’ fears, uncertainties, and doubts about open source may be driven by misinterpretation or outdated information. This hesitancy can persist despite some projects being active longer than their proprietary counterparts.

Certain software features, support capabilities, and costs are commonly overlooked when selecting open-source software because they are often assumed in the licensing and service costs of commercial software.

Open-source software is often technically complicated and requires specific skill sets and knowledge. Unfortunately, current software delivery capability gaps impede successful adoption and scaling of open-source software.

Info-Tech’s Approach

Outline the value you expect to gain. Discuss current business and IT priorities, use cases, and value opportunities to determine what to expect from open-source versus commercial software.

Define your open-source selection criteria. Clarify the driving factors in your evaluation of open-source and commercial software using your existing IT procurement practices as a starting point.

Assess the readiness of your team. Clarify the roles, processes, and tools needed for the implementation, use, and maintenance of open-source software.

Insight Summary

Overarching Info-Tech Insight

Open source is as much about an investment in people as it is about technology. It empowers applications teams to take greater control over their technology and customize it as they see fit. However, teams need the time and funding to conduct the necessary training, management, and ongoing community engagement that open-source software and its licenses require.

  • Position open source in the same light as commercial software.
    The continuous improvement and evolution of popular open-source software and communities have established a trusting and reliable reputation in the industry. Open-source software quality and community support can rival similar vendor capabilities given the community’s maturity and contributions in the technology.
  • Consider open source another form of outsource development.
    Open source is externally developed software where the code is accessible and customizable. Code quality may not align to your organization’s standards, which can require extensive testing and optimization. A thorough analysis of change logs, code repositories, contributors, and the community is recommended – much to the same degree as one would do with prospective outsourcing partners.
  • Treat open source as any internally developed solution.
    Configurations, integrations, customizations, and orchestrations of open-source software are often done at the code level. While some community support is provided, most of the heavy lifting is done by the applications team. Teams must be properly resourced, upskilled, and equipped to meet this requirement. Otherwise, third-party partners are needed.

What is open source?

According to Synopsys, “Open source software (OSS) is software that is distributed with its source code, making it available for use, modification, and distribution with its original rights. … Programmers who have access to source code can change a program by adding to it, changing it, or fixing parts of it that aren’t working properly. OSS typically includes a license that allows programmers to modify the software to best fit their needs and control how the software can be distributed.”

What are the popular use cases?

  1. Programming languages and frameworks
  2. Databases and data technologies
  3. Operating systems
  4. Git public repos
  5. Frameworks and tools for AI/ML/DL
  6. CI/CD tooling
  7. Cloud-related tools
  8. Security tools
  9. Container technology
  10. Networking

Source: OpenLogic, 2022

Common Attributes of All Open-Source Software

  • Publicly shared repository that anyone can access to use the solution and contribute changes to the design and functionality of the project.
  • A community that is an open forum to share ideas and solution enhancements, discuss project direction and vision, and seek support from peers.
  • Project governance that sets out guidelines, rules, and requirements to participate and contribute to the project.
  • Distribution license that defines the terms of how a solution can be used, assessed, modified, and distributed.

Take the first steps to embrace open-source software

Begin to understand what is required to embrace open-source software in your organization.

A diagram of open-source community.

State the Value of Open Source: Discuss current business and IT priorities, use cases, and value opportunities to determine what to expect from open-source versus commercial software.

Select Your Open-Source Software: Clarify the driving factors in your evaluation of open-source and commercial software using your existing IT procurement practices as a starting point.

Prepare for Open Source: Clarify the roles, processes, and tools needed for the implementation, use, and maintenance of open-source software.

Step 1.1: State the Value of Open Source

Diagram of step 1.1

Activities

1.1.1 Outline the value you expect to gain from open-source software

This step involves the following participants:

  • Applications team
  • Product owner

Outcomes of this step:

  • Value proposition for open source
  • Potential open-source use cases

Use a canvas to frame your open-source evaluation

A photo of open-source canvas

This canvas is intended to provide a single pane of glass to start collecting your thoughts and framing your future conversations on open-source software selection and adoption.

Record the results in the “Open-Source Canvas” tab in the Open-Source Readiness Assessment.

Open source presents unique software and tooling opportunities

Innovation

Many leading-edge and bleeding-edge technologies are collaborated and innovated in open-source projects, especially in areas that are beyond the vision and scope of vendor products and priorities.

Niche Solutions

Open-source projects are focused. They are designed and built to solve specific business and technology problems.

Flexible & Customizable

All aspects of the open-source software are customizable, including source code and integrations. They can be used to extend, complement, or replace internally developed code. Licenses define how open-source code should be and must be used, productized, and modified.

Brand & Recognition

Open-source communities encourage contribution and collaboration among their members to add functionality and improve quality and adoption.

Cost

Open-source software is accessible to everyone, free of charge. Communities do not need be consulted prior to acquisition, but the software’s use, configurations, and modifications may be restricted by its license.

However, myths continue to challenge adoption

  • Open source is less secure or poorer quality than proprietary solutions.
  • Open source is free from risk of intellectual property (IP) infringement.
  • Open source is cheaper than proprietary solutions.

What are the top perceived barriers to using enterprise open source?

  • Concerns about the level of support
  • Compatibility concerns
  • Concerns about inherent security of the code
  • Lack of internal skills to manage and support it

Source: Red Hat, 2022

Mature and Scale Product Ownership

  • Buy Link or Shortcode: {j2store}145|cart{/j2store}
  • member rating overall impact: 9.5/10 Overall Impact
  • member rating average dollars saved: $21,919 Average $ Saved
  • member rating average days saved: 13 Average Days Saved
  • Parent Category Name: Development
  • Parent Category Link: /development
  • Product owners must bridge the gap between the customers, operations, and delivery to ensure products continuously deliver increasing value.
  • Product owners are often assigned to projects or product delivery without proper support, guidance, or alignment.
  • In many organizations, the product owner role is not well-defined, serves as a proxy for stakeholder ownership, and lacks reinforcement of the key skills needed to be successful.

Our Advice

Critical Insight

A product owner is the CEO for their product. Successful product management starts with empowerment and accountability. Product owners own the vision, roadmap, and value realization for their product or family aligned to enterprise goals and priorities.

  • Product and service ownership share the same foundation - underlying capabilities and best practices to own and improve a product or service are identical for both roles. Use the terms that make the most sense for your culture.
  • Product owners represent three primary perspectives: Business (externally facing), Technical (systems and tools), or Operational (manual processes). Although all share the same capabilities, how they approach their responsibilities is influenced by their primary perspective.
  • Product owners are operating under an incomplete understanding of the capabilities needed to succeed. Most product/service owners lack a complete picture of the needed capabilities, skills, and activities to successfully perform their roles.

Impact and Result

  • Create a culture of product management trust and empowerment with product owners aligned to your operational structure and product needs.
  • Promote and develop true Agile skills among your product owners and family managers.
  • Implement Info-Tech’s product owner capability model to define the role expectations and provide a development path for product owners.

Mature and Scale Product Ownership Research & Tools

Besides the small introduction, subscribers and consulting clients within this management domain have access to:

1. Mature and Scale Product Ownership Storyboard – Establish a culture of success for product management and mature product owner capabilities.

Strengthen the product owner role in your organization by focusing on core capabilities and proper alignment.

  • Establish a foundation for empowerment and success.
  • Assign and align product owners with products and stakeholders.
  • Mature product owner capabilities and skills.
    • Mature and Scale Product Ownership Storyboard

    2. Mature and Scale Product Ownership Readiness Assessment – Determine your readiness for a product-centric culture based on Info-Tech’s CLAIM+G model.

    Using Info-Tech’s CLAIM model, quickly determine your organization’s strengths and weaknesses preparing for a product culture. Use the heat map to identify key areas.

    • Mature and Scale Product Ownership Readiness Assessment

    3. Mature and Scale Product Ownership Playbook – Playbook for product owners and product managers.

    Use the blueprint exercises to build your personal product owner playbook. You can also use the workbook to capture exercise outcomes.

    • Mature and Scale Product Ownership Playbook

    4. Mature and Scale Product Ownership Workbook – Workbook for product owners and product managers.

    Use this workbook to capture exercise outcomes and transfer them to your Mature and Scale Product Ownership Playbook (optional).

    • Mature and Scale Product Ownership Workbook

    5. Mature and Scale Product Ownership Proficiency Assessment – Determine your current proficiency and improvement areas.

    Product owners need to improve their core capabilities and real Agile skills. The assessment radar will help identify current proficiency and growth opportunities.

    • Mature and Scale Product Ownership Proficiency Assessment
    [infographic]

    Workshop: Mature and Scale Product Ownership

    Workshops offer an easy way to accelerate your project. If you are unable to do the project yourself, and a Guided Implementation isn't enough, we offer low-cost delivery of our project workshops. We take you through every phase of your project and ensure that you have a roadmap in place to complete your project successfully.

    1 Establish the foundation for product ownership

    The Purpose

    Establish the foundation for product ownership.

    Key Benefits Achieved

    Product owner playbook with role clarity and RACI.

    Activities

    1.1 Define enablers and blockers of product management.

    1.2 Define your product management roles and names.

    1.3 Assess your product management readiness.

    1.4 Identify your primary product owner perspective.

    1.5 Define your product owner RACI.

    Outputs

    Enablers and blockers

    Role definitions.

    Product culture readiness

    Product owner perspective mapping

    Product owner RACI

    2 Align product owners to products

    The Purpose

    Align product owners to products.

    Key Benefits Achieved

    Assignment of resources to open products.

    A stakeholder management strategy.

    Activities

    2.1 Assign resources to your products and families.

    2.2 Visualize relationships to identify key influencers.

    2.3 Group stakeholders into categories.

    2.4 Prioritize your stakeholders.

    Outputs

    Product resource assignment

    Stakeholder management strategy

    Stakeholder management strategy

    Stakeholder management strategy

    3 Mature product owner capabilities

    The Purpose

    Mature product owner capabilities.

    Key Benefits Achieved

    Assess your Agile product owner readiness

    Assess and mature product owner capabilities

    Activities

    3.1 Assess your real Agile skill proficiency.

    3.2 Assess your vison capability proficiency.

    3.3 Assess your leadership capability proficiency.

    3.4 Assess your PLM capability proficiency.

    3.5 Assess your value realization capability proficiency.

    3.6 Identify your business value drivers and sources of value.

    Outputs

    Real Agile skill proficiency assessment

    Info-Tech’s product owner capability model proficiency assessment

    Info-Tech’s product owner capability model proficiency assessment

    Info-Tech’s product owner capability model proficiency assessment

    Info-Tech’s product owner capability model proficiency assessment

    Business value drivers and sources of value

    Further reading

    Mature and Scale Product Ownership

    Strengthen the product owner’s role in your organization by focusing on core capabilities and proper alignment.

    Executive Brief

    Analyst Perspective

    Empower product owners throughout your organization.

    Hans Eckman

    Whether you manage a product or service, the fundamentals of good product ownership are the same. Organizations need to focus on three key elements of product ownership in order to be successful.

    • Create an environment of empowerment and service leadership to reinforce product owners and product family managers as the true owners of the vision, improvement, and realized the value of their products.
    • Align product and product family owner roles based on operational alignment and the groups defined when scaling product management.
    • Develop your product owners to improve the quality of roadmaps, alignment to enterprise goals, and profit and loss (P&L) for each product or service.

    By focusing the attention of the teammates serving in product owner or service owner roles, your organization will deliver value sooner and respond to change more effectively.

    Hans Eckman

    Principal Research Director – Application Delivery and Management
    Info-Tech Research Group

    Executive Summary

    Your Challenge

    Product owners must bridge the gap between the customers, operations, and delivery to ensure products continuously deliver increasing value.

    Product owners are often assigned to projects or product delivery without proper support, guidance, or alignment.

    In many organizations the product owner role is not well-defined, serves as a proxy for stakeholder ownership, and lacks reinforcement of the key skills needed to be successful.

    Common Obstacles

    Organizations have poor alignment or missing product owners between lines of business, IT, and operations.

    Product owners are aligned to projects and demand management rather than long-term strategic product ownership.

    Product families are not properly defined, scaled, and supported within organizations.

    Individuals in product owner roles have an incomplete understanding of needed capabilities and lack a development path.

    Info-Tech's Approach

    Create a culture of product management trust and empowerment with product owners aligned to your operational structure and product needs.

    Promote and develop true Agile skills among your product owners and family managers.

    Implement Info-Tech’s product owner capability model to define the role expectations and provide a development path for product owners.

    Extend product management success using Deliver on Your Digital Product Vision and Deliver Digital Products at Scale.

    Info-Tech Insight

    There is no single correct approach to product ownership. Product ownership must be tuned and structured to meet the delivery needs of your organization and the teams it serves.

    Info-Tech’s Approach

    Product owners make the final decision

    • Establish a foundation for empowerment and success
    • Assign product owners and align with products and stakeholders
    • Mature product owner capabilities and skills
    Product Owner capabilities: Vision, Product Lifecycle Management, Leadership, Value Realization

    The Info-Tech difference

    1. Assign product owners where product decisions are needed, not to match org charts or delivery teams. The product owner has the final word on product decisions.
    2. Organize product owners into related teams to ensure product capabilities delivered are aligned to enterprise strategy and goals.
    3. Shared products and services must support the needs of many product owners with conflicting priorities. Shared service product owners must map and prioritize demand to align to enterprise priorities and goals.
    4. All product owners share the same capability model.

    Insight summary

    There is no single correct approach to product ownership

    Successful product management starts with empowerment and accountability. Product owners own the vision, roadmap, and value realization for their product or family aligned to enterprise goals and priorities.

    Phase 1 insight

    Product owners represent three primary perspectives: business (external-facing), technical (systems and tools), or operational (manual processes). Although all share the same capabilities, how they approach their responsibilities is influenced by their primary perspective.

    Phase 2 insight

    Start with your operational grouping of products and families, identifying where an owner is needed. Then, assign people to the products and families. The owner does not define the product or family.

    Phase 3 insight

    Product owners are operating under an incomplete understanding of the capabilities needed to succeed. Most product/service owners lack a complete picture of the needed capabilities, skills, and activities to successfully perform their roles.

    Product and service ownership share the same foundation

    The underlying capabilities and best practices to own and improve a product or service are identical for both roles. Use the terms that make the most sense for your culture.

    Map product owner roles to your existing job titles

    Identify where product management is needed and align expectations with existing roles. Successful product management does not require a dedicated job family.

    Projects can be a mechanism for funding product changes and improvements

    Projects can be a mechanism for funding product changes and improvements. Shows difference of value for project life-cycles, hybrid life-cycles, and product life-cycles.

    Projects within products

    Regardless of whether you recognize yourself as a product-based or project-based shop, the same basic principles should apply.

    You go through a period or periods of project-like development to build a version of an application or product.

    You also have parallel services along with your project development, which encompass the more product-based view. These may range from basic support and maintenance to full-fledged strategy teams or services like sales and marketing.

    Product and services owners share the same foundation and capabilities

    For the purpose of this blueprint, product/service and product owner/service owner are used interchangeably. The term “product” is used for consistency but would apply to services, as well.

    Product = Service

    Common foundations: Focus on continuous improvement, ROI, and value realization. Clear vision, goals, roadmap, and backlog.

    “Product” and “service” are terms that each organization needs to define to fit its culture and customers (internal and external). The most important aspect is consistent use and understanding of:

    • External products
    • Internal products
    • External services
    • Internal services
    • Products as a service (PaaS)
    • Productizing services (SaaS)

    Recognize the product owner perspectives

    The 3 product owner perspectives. 1. Business: Customer-facing, value-generating. 2. Technical: IT systems and tools. 3. Operations: Keep-the-lights-on processes.

    Product owners represent one of three primary perspectives. Although all share the same capabilities, how they approach their responsibilities is influenced by their primary perspective.

    Info-Tech Insight

    Product owners must translate needs and constraints from their perspective into the language of their audience. Kathy Borneman, Digital Product Owner at SunTrust Bank, noted the challenges of finding a common language between lines of business and IT (e.g. what is a unit?).

    Match your product management role definitions to your product family levels

    Product ownership exists at the different operational tiers or levels in your product hierarchy. This does not imply a management relationship.

    Product portfolio

    Groups of product families within an overall value stream or capability grouping.

    Project portfolio manager

    Product family

    A collection of related products. Products can be grouped along architectural, functional, operational, or experiential patterns.

    Product family manager

    Product

    Single product composed of one or more applications and services.

    Product owner

    Info-Tech Insight

    Define the current roles that will perform the product management function or define consistent role names to product owners and managers.

    Align enterprise value through product families

    Product families are operational groups based on capabilities or business functions. Product family managers translate goals, priorities, and constraints so they are actionable at the next level. Product owners prioritize changes to enhance the capabilities that allow you to realize your product family. Enabling capabilities realize value and help reach your goals.

    Understand special circumstances

    In Deliver Digital Products at Scale, products were grouped into families using Info-Tech’s five scaling patterns. Assigning owners to Enterprise Applications and Shared Services requires special consideration.

    Value stream alignment

    • Business architecture
      • Value stream
      • Capability
      • Function
    • Market/customer segment
    • Line of business (LoB)
    • Example: Customer group > value stream > products

    Enterprise applications

    • Enabling capabilities
    • Enterprise platforms
    • Supporting apps
    • Example: HR > Workday/Peoplesoft > Modules Supporting: Job board, healthcare administrator

    Shared Services

    • Organization of related services into service family
    • Direct hierarchy does not necessarily exist within the family
    • Examples: End-user support and ticketing, workflow and collaboration tools

    Technical

    • Domain grouping of IT infrastructure, platforms, apps, skills, or languages
    • Often used in combination with Shared Services grouping or LoB-specific apps
    • Examples: Java, .NET, low-code, database, network

    Organizational alignment

    • Used at higher levels of the organization where products are aligned under divisions
    • Separation of product managers from organizational structure is no longer needed because the management team owns the product management role

    Map sources of demand and influencers

    Use the stakeholder analysis to define the key stakeholders and sources of demand for enterprise applications and shared services. Extend your mapping to include their stakeholders and influencers to uncover additional sources of demand and prioritization.

    Map of key stakeholders for enterprise applications and shared services.

    Info-Tech Insight

    Your product owner map defines the influence landscape your product operates. It is every bit as important as the teams who enhance, support and operate your product directly.

    Combine your product owner map with your stakeholder map to create a comprehensive view of influencers.

    The primary value of the product owner is to fill the backlog with the highest ROI opportunities aligned with enterprise goals.

    Info-Tech Insight

    The product owner owns the direction of the product.

    • Roadmap - Where are we going?
    • Backlog - What changes are needed to get there?
    • Product review - Did we get close enough?

    Product delivery realizes value for your product family

    While planning and analysis are done at the family level, work and delivery are done at the individual product level.

    Product strategy includes: Vision, Goals, Roadmap, backlog and Release plan.

    Product family owners are more strategic

    When assigning resources, recognize that product family owners will need to be more strategic with their planning and alignment of child families and products.

    Product family owners are more strategic. They require a roadmap that is strategic, goal-based, high-level, and flexible.

    Info-Tech Insight

    Roadmaps for your product family are, by design, less detailed. This does not mean they aren’t actionable! Your product family roadmap should be able to communicate clear intentions around the future delivery of value in both the near and long term.

    Connecting your product family roadmaps to product roadmaps

    Your product and product family roadmaps should be connected at an artifact level that is common between both. Typically, this is done with capabilities, but it can be done at a more granular level if an understanding of capabilities isn’t available.

    Product family roadmap versus Product Roadmaps.

    Develop a product owner stakeholder strategy

    Stakeholder management, Product lifecycle, Project delivery, Operational support.

    Stakeholders are a critical cornerstone to product ownership. They provide the context, alignment, and constraints that influence or control what a product owner can accomplish.

    Product owners operate within a network of stakeholders who represent different perspectives within the organization.

    First, product owners must identify members of their stakeholder network. Next, they should devise a strategy for managing stakeholders.

    Without a stakeholder strategy, product owners will encounter obstacles, resistance, or unexpected changes.

    Create a stakeholder network map to product roadmaps and prioritization

    Follow the trail of breadcrumbs from your direct stakeholders to their influencers, to uncover hidden stakeholders.

    Stakeholder network map defines the influence landscape your product operates. Connectors determine who may be influencing your direct stakeholders.

    Info-Tech Insight

    Your stakeholder map defines the influence landscape your product operates. It is every bit as important as the teams who enhance, support and operate your product directly.

    Use “connectors” to determine who may be influencing your direct stakeholders. They may not have any formal authority within the organization, but they may have informal yet substantive relationships with your stakeholders.

    Being successful at Agile is more than about just doing Agile

    The following represents the hard skills needed to “Do Agile”:

    Being successful at Agile needs 4 hard skills: 1. Engineering skills, 2. Technician Skills, 3. Framework/Process skills, 4. Tools skills.
    • Engineering skills. These are the skills and competencies required for building brand-new valuable software.
    • Technician skills. These are the skills and competencies required for maintaining and operating the software delivered to stakeholders.
    • Framework/Process skills. These are the specific knowledge skills required to support engineering or technician skills.
    • Tools skills. This represents the software that helps you deliver other software.

    While these are important, they are not the whole story. To effectively deliver software, we believe in the importance of being Agile over simply doing Agile.

    Adapted from: “Doing Agile” Is Only Part of the Software Delivery Pie

    Why focus on core skills?

    They are the foundation to achieve business outcomes

    Skills, actions, output and outcomes

    The right skills development is only possible with proper assessment and alignment against outcomes.

    Focus on these real Agile skills

    Agile skills

    • Accountability
    • Collaboration
    • Comfort with ambiguity
    • Communication
    • Empathy
    • Facilitation
    • Functional decomposition
    • Initiative
    • Process discipline
    • Resilience

    Product capabilities deliver value

    As a product owner, you are responsible for managing these facets through your capabilities and activities.

    The core product and value stream consists of: Funding - Product management and governance, Business functionality - Stakeholder and relationship management, and Technology - Product delivery.

    Info-Tech Best Practice

    It is easy to lose sight of what matters when we look at a product from a single point of view. Despite what "The Agile Manifesto" says, working software is not valuable without the knowledge and support that people need in order to adopt, use, and maintain it. If you build it, they will not come. Product owners must consider the needs of all stakeholders when designing and building products.

    Recognize product owner knowledge gaps

    Pulse survey of product owners

    Pulse survey of product owners. Graph shows large percentage of respondents have alignment to common agile definition of product owners. Yet a significant perception gap in P&L, delivery, and analytics.

    Info-Tech Insight

    1. Less than 15% of respondents identified analytics or financial management as a key component of product ownership.
    2. Assess your product owner’s capabilities and understanding to develop a maturity plan.

    Source: Pulse Survey (N=18)

    Implement the Info-Tech product owner capability model

    Unfortunately, most product owners operate with incomplete knowledge of the skills and capabilities needed to perform the role. Common gaps include focusing only on product backlogs, acting as a proxy for product decisions, and ignoring the need for key performance indicators (KPIs) and analytics in both planning and value realization.

    Product Owner capabilities: Vision, Product Lifecycle Management, Leadership, Value Realization

    Vision

    • Market Analysis
    • Business Alignment
    • Product Roadmap

    Leadership

    • Soft Skills
    • Collaboration
    • Decision Making

    Product Lifecycle Management

    • Plan
    • Build
    • Run

    Value Realization

    • KPIs
    • Financial Management
    • Business Model

    Product owner capabilities provide support

    Vision predicts impact of Value realization. Value realization provides input to vision

    Your vision informs and aligns what goals and capabilities are needed to fulfill your product or product family vision and align with enterprise goals and priorities. Each item on your roadmap should have corresponding KPIs or OKRs to know how far you moved the value needle. Value realization measures how well you met your target, as well as the impacts on your business value canvas and cost model.

    Product lifecycle management builds trust with Leadership. Leadership improves quality of Product lifecycle management.

    Your leadership skills improve collaborations and decisions when working with your stakeholders and product delivery teams. This builds trust and improves continued improvements to the entire product lifecycle. A product owner’s focus should always be on finding ways to improve value delivery.

    Product owner capabilities provide support

    Leadership enhances Vision. Vision Guides Product Lifecycle Management. Product Lifecycle Management delivers Value Realization. Leadership enhances Value Realization

    Develop product owner capabilities

    Each capability: Vision, Product lifecycle management, Value realization and Leadership has 3 components needed for successful product ownership.

    Avoid common capability gaps

    Vision

    • Focusing solely on backlog grooming (tactical only)
    • Ignoring or failing to align product roadmap to enterprise goals
    • Operational support and execution
    • Basing decisions on opinion rather than market data
    • Ignoring or missing internal and external threats to your product

    Leadership

    • Failing to include feedback from all teams who interact with your product
    • Using a command-and-control approach
    • Viewing product owner as only a delivery role
    • Acting as a proxy for stakeholder decisions
    • Avoiding tough strategic decisions in favor of easier tactical choices

    Product lifecycle management

    • Focusing on delivery and not the full product lifecycle
    • Ignoring support, operations, and technical debt
    • Failing to build knowledge management into the lifecycle
    • Underestimating delivery capacity, capabilities, or commitment
    • Assuming delivery stops at implementation

    Value realization

    • Focusing exclusively on “on time/on budget” metrics
    • Failing to measure a 360-degree end-user view of the product
    • Skipping business plans and financial models
    • Limiting financial management to project/change budgets
    • Ignoring market analysis for growth, penetration, and threats

    Your product vision is your North Star

    It's ok to dream a little!

    Who is the target customer, what is the key benefit, what do they need, what is the differentiator

    Adapted from: Crossing the Chasm

    Info-Tech Best Practice

    A product vision shouldn’t be so far out that it doesn’t feel real or so short-term that it gets bogged down in minutiae and implementation details. Finding the right balance will take some trial and error and will be different for each organization.

    Leverage the product canvas to state and inform your product vision

    Leverage the product Canvas to state and inform your product vision. Includes: Product name, Tracking info, Vision, List of business objectives or goals, Metrics used to measure value realization, List of groups who consume the product/service, and List of key resources or stakeholders.

    Define product value by aligning backlog delivery with roadmap goals

    In each product plan, the backlogs show what you will deliver. Roadmaps identify when and in what order you will deliver value, capabilities, and goals.

    In each product plan, the backlogs show what you will deliver. Roadmaps identify when and in what order you will deliver value, capabilities, and goals.

    Use a balanced value to establish a common definition of goals and value

    Value drivers are strategic priorities aligned to our enterprise strategy and translated through our product families. Each product and change has an impact on the value driver helping us reach our enterprise goals.

    Importance of the value driver multiplied by the Impact of value score is equal to the Value score.

    Info-Tech Insight

    Your value drivers and impact helps estimate the expected value of roadmap items, prioritize roadmap and backlog items, and identify KPIs and OKRs to measure value realization and actual impact.

    Use CLAIM to guide your journey

    Culture, Learning, Automation, Integrated teams, Metrics and governance.

    Value is best created by self-managing teams who deliver in frequent, short increments supported by leaders who coach them through challenges.

    Product-centric delivery and Agile are a radical change in how people work and think. Structured, facilitated learning is required throughout the transformation to help leaders and practitioners make the shift.

    Product management, Agile, and DevOps have inspired SDLC tools that have become a key part of delivery practices and work management.

    Self-organizing teams that cross business, delivery, and operations are essential to gain the full benefits of product-centric delivery.

    Successful implementations require the disciplined use of metrics that support developing better teams

    Communicate reasons for changes and how they will be implemented

    Five elements of communicating change: What is the change? Why are we doing it? How are we going to go about it? How long will it take us to do it? What will the role be for each department individual?

    Leaders of successful change spend considerable time developing a powerful change message; that is, a compelling narrative that articulates the desired end state, and that makes the change concrete and meaningful to staff.

    The organizational change message should:

    • Explain why the change is needed.
    • Summarize what will stay the same.
    • Highlight what will be left behind.
    • Emphasize what is being changed.
    • Explain how the change will be implemented.
    • Address how change will affect various roles in the organization.
    • Discuss the staff’s role in making the change successful.

    Info-Tech’s methodology for mature and scale product ownership

    Phase steps

    1. Establish the foundation for product ownership

    Step 1.1 Establish an environment for product owner success

    Step 1.2 Establish your product ownership model

    2. Align product owners to products

    Step 2.1 Assign product owners to products

    Step 2.2 Manage stakeholder influence

    3. Mature product owner capabilities

    Step 3.1 Assess your Agile product owner readiness

    Step 3.2 Mature product owner capabilities

    Phase outcomes

    1.1.1 Define enablers and blockers of product management

    1.1.2 Define your product management roles and names

    1.2.1 Identify your primary product owner perspective

    1.2.2 Define your product owner RACI

    2.1.1 Assign resources to your products and families

    2.2.1 Visualize relationships to identify key influencers

    2.2.2 Group stakeholders into categories

    2.2.3 Prioritize your stakeholders

    3.1.1 Assess your real Agile skill proficiency

    3.2 Mature product owner capabilities

    3.2.1 Assess your vision capability proficiency

    3.2.2 Assess your leadership capability proficiency

    3.2.3 Assess your PLM capability proficiency

    3.2.4 Identify your business value drivers and sources of value

    3.2.5 Assess your value realization capability proficiency

    Blueprint deliverables

    Each step of this blueprint is accompanied by supporting deliverables to help you accomplish your goals.

    Key deliverable

    Mature and Scale Product Ownership Playbook

    Capture and organize the outcomes of the activities in the workbook.

    Mature and Scale Product Ownership Workbook

    The workbook helps organize and communicate the outcomes of each activity.

    Mature and Scale Product Ownership Readiness Assessment

    Determine your level of mastery of real Agile skills and product owner capabilities.

    Blueprint benefits

    IT benefits

    • Competent product owner who can support teams operating in any delivery methodology.
    • Representative viewpoint and input from the technical and operational product owner perspectives.
    • Products aligned to business needs and committed work are achievable.
    • Single point of contact with a business representative.
    • Acceptance of product owner role outside the Scrum teams.

    Business benefits

    • Better alignment to enterprise goals, vision, and outcomes.
    • Improved coordination with stakeholders.
    • Quantifiable value realization tied to vision.
    • Product decisions made at the right time and with the right input.
    • Product owner who has the appropriate business, operations, and technical knowledge.

    Measure the value of this blueprint

    Align product owner metrics to product delivery and value realization.

    Member outcome

    Suggested Metric

    Estimated impact

    Increase business application satisfaction Satisfaction of business applications (CIO BV Diagnostic) 20% increase within one year after implementation
    Increase effectiveness of application portfolio management Effectiveness of application portfolio management (M&G Diagnostic) 20% increase within one year after implementation
    Increase importance and effectiveness of application portfolio Importance and effectiveness to business (APA Diagnostic) 20% increase within one year after implementation
    Increase satisfaction of support of business operations Support to business (CIO BV Diagnostic) 20% increase within one year after implementation
    Successfully deliver committed work (productivity) Number of successful deliveries; burndown Reduction in project implementation overrun by 20%

    Info-Tech offers various levels of support to best suit your needs

    DIY Toolkit

    "Our team has already made this critical project a priority, and we have the time and capability, but some guidance along the way would be helpful."

    Guided Implementation

    "Our team knows that we need to fix a process, but we need assistance to determine where to focus. Some check-ins along the way would help keep us on track."

    Workshop

    "We need to hit the ground running and get this project kicked off immediately. Our team has the ability to take this over once we get a framework and strategy in place."

    Consulting

    "Our team does not have the time or the knowledge to take this project on. We need assistance through the entirety of this project"

    Diagnostics and consistent frameworks are used throughout all four options.

    Guided Implementation

    What does a typical GI on this topic look like?

    Phase 1 Establish the Foundation for Product Ownership

    Phase 2 Align Product Owners to Products

    Phase 3 Mature Product Owner Capabilities

    • Call #1:
      Scope objectives and your specific challenges
    • Call #2:
      Step 1.1 Establish an environment for product owner success
      Step 1.2 Establish your product ownership model
    • Call #3:
      Step 2.1 Assign product owners to products
    • Call #4:
      Step 2.2 Manage stakeholder influence
    • Call #5:
      Step 3.1 Assess your Agile product owner readiness
    • Call #6:
      Step 3.2 Mature product owner capabilities

    A Guided Implementation (GI) is a series of calls with an Info-Tech analyst to help implement our best practices in your organization.

    A typical GI is between 8 and 12 calls over the course of 4 to 6 months.

    Workshop Overview

    Contact your account representative for more information.
    workshops@infotech.com 1-888-670-8889

    Phase 1

    Phase 2

    Phase 3

    Activities

    Establish the Foundation for Product Ownership

    Step 1.1 Establish an environment for product owner success

    1.1.1 Define enablers and blockers of product management

    1.1.2 Define your product management roles and names

    1.1.3 Assess your product management readiness

    Step 1.2 Establish your product ownership model

    1.2.1 Identify your primary product owner perspective

    1.2.2 Define your product owner RACI

    Align Product Owners to Products

    Step 2.1 Assign product owners to products

    2.1.1 Assign resources to your products and families

    Step 2.2 Manage stakeholder influence

    2.2.1 Visualize relationships to identify key influencers

    2.2.2 Group stakeholders into categories

    2.2.3 Prioritize your stakeholders

    Mature Product Owner Capabilities

    Step 3.1 Assess your Agile product owner readiness

    3.1.1 Assess your real Agile skill proficiency

    Step 3.2 Mature product owner capabilities=

    3.2.1 Assess your Vision capability proficiency

    3.2.2 Assess your Leadership capability proficiency

    3.2.3 Assess your PLM capability proficiency

    3.2.4 Identify your business value drivers and sources of value

    3.2.5 Assess your Value Realization capability proficiency

    Deliverables

    1. Enablers and blockers
    2. Role definitions
    3. Product culture readiness
    4. Product owner perspective mapping
    5. Product owner RACI
    1. Product resource assignment
    2. Stakeholder management strategy
    1. Real Agile skill proficiency assessment
    2. Info-Tech’s product owner capability model proficiency assessment
    3. Business value drivers and sources of value

    Related Info-Tech Research

    Product delivery

    Deliver on Your Digital Product Vision

    Build a product vision your organization can take from strategy through execution.

    Deliver Digital Products at Scale

    Deliver value at the scale of your organization through defining enterprise product families.

    Build Your Agile Acceleration Roadmap

    Quickly assess the state of your Agile readiness and plan your path forward to higher value realization.

    Develop Your Agile Approach for a Successful Transformation

    Understand Agile fundamentals, principles, and practices so you can apply them effectively in your organization.

    Implement DevOps Practices That Work

    Streamline business value delivery through the strategic adoption of DevOps practices.

    Extend Agile Practices Beyond IT

    Further the benefits of Agile by extending a scaled Agile framework to the business.

    Build Your BizDevOps Playbook

    Embrace a team sport culture built around continuous business-IT collaboration to deliver great products.

    Embed Security Into the DevOps Pipeline

    Shift security left to get into DevSecOps.

    Spread Best Practices With an Agile Center of Excellence

    Facilitate ongoing alignment between Agile teams and the business with a set of targeted service offerings.

    Enable Organization-Wide Collaboration by Scaling Agile

    Execute a disciplined approach to rolling out Agile methods in the organization.

    Related Info-Tech Research

    Application portfolio management

    APM Research Center

    See an overview of the APM journey and how we can support the pieces in this journey.

    Application Portfolio Management Foundations

    Ensure your application portfolio delivers the best possible return on investment.

    Streamline Application Maintenance

    Effective maintenance ensures the long-term value of your applications.

    Streamline Application Management

    Move beyond maintenance to ensuring exceptional value from your apps.

    Build an Application Department Strategy

    Delivering value starts with embracing what your department can do.

    Embrace Business-Managed Applications

    Empower the business to implement its own applications with a trusted business-IT relationship.

    Optimize Applications Release Management

    Facilitate ongoing alignment between Agile teams and the business with a set of targeted service offerings.

    Related Info-Tech Research

    Value, delivery metrics, estimation

    Build a Value Measurement Framework

    Focus product delivery on business value-driven outcomes.

    Select and Use SDLC Metrics Effectively

    Be careful what you ask for, because you will probably get it.

    Application Portfolio Assessment: End User Feedback

    Develop data-driven insights to help you decide which applications to retire, upgrade, re-train on, or maintain to meet the demands of the business.

    Create a Holistic IT Dashboard

    Mature your IT department by measuring what matters.

    Refine Your Estimation Practices With Top-Down Allocations

    Don’t let bad estimates ruin good work.

    Estimate Software Delivery With Confidence

    Commit to achievable software releases by grounding realistic expectations.

    Reduce Time to Consensus With an Accelerated Business Case

    Expand on the financial model to give your initiative momentum.

    Optimize Project Intake, Approval, and Prioritization

    Deliver more projects by giving yourself the voice to say “no” or “not yet” to new projects.

    Enhance PPM Dashboards and Reports

    Facilitate ongoing alignment between Agile teams and the business with a set of targeted service offerings.

    Related Info-Tech Research

    Organizational design and performance

    Redesign Your IT Organizational Structure

    Focus product delivery on business value-driven outcomes.

    Build a Strategic Workforce Plan

    Have the right people in the right place, at the right time.

    Implement a New Organizational Structure

    Reorganizations are inherently disruptive. Implement your new structure with minimal pain for staff while maintaining IT performance throughout the change.

    Build an IT Employee Engagement Program

    Don’t just measure engagement, act on it.

    Set Meaningful Employee Performance Measures

    Set holistic measures to inspire employee performance.

    Phase 1

    Establish the Foundation for Product Ownership

    Phase 1: Establish an environment for product owner success, Establish your product ownership model

    Mature and Scale Product Ownership

    This phase will walk you through the following activities:

    1.1.1 Define enablers and blockers of product management

    1.1.2 Define your product management roles and names

    1.1.3 Assess your product management readiness

    1.2.1 Identify your primary product owner perspective

    1.2.2 Define your product owner RACI

    This phase involves the following participants:

    • Product owners
    • Product managers
    • Development team leads
    • Portfolio managers
    • Delivery managers
    • Business analysts

    Step 1.1

    Establish an environment for product owner success

    Activities

    1.1.1 Define enablers and blockers of product management

    1.1.2 Define your product management roles and names

    1.1.3 Assess your product management readiness

    Establish the foundation for product ownership

    This step involves the following participants:

    • Product owners
    • Product managers
    • Development team leads
    • Portfolio managers
    • Delivery managers
    • Business analysts

    Outcomes of this step

    • Enablers and blockers
    • Role definitions

    Empower product owners as the true owners of their product

    Product ownership requires decision-making authority and accountability for the value realization from those decisions. POs are more than a proxy for stakeholders, aggregators for changes, and the communication of someone else’s priorities.

    “A Product Owner in its most beneficial form acts like an Entrepreneur, like a 'mini-CEO'. The Product Owner is someone who really 'owns' the product.”

    – Robbin Schuurman,
    “Tips for Starting Technical Product Managers”

    Info-Tech Best Practice

    Implement Info-Tech’s Product Owner Capability Model to help empower and hold product owners accountable for the maturity and success of their product. The product owner must understand how their product fits into the organization’s mission and strategy in order to align to enterprise value.

    Product and service owners share the same foundation and capabilities

    For the purpose of this blueprint, product/service and product owner/service owner are used interchangeably. The term “product” is used for consistency but applies to services, as well.

    Product = Service

    Common foundations: Focus on continuous improvement, ROI, and value realization. Clear vision, goals, roadmap, and backlog.

    “Product” and “service” are terms that each organization needs to define to fit its culture and customers (internal and external). The most important aspect is consistent use and understanding of:

    • External products
    • Internal products
    • External services
    • Internal services
    • Products as a service (PaaS)
    • Productizing services (SaaS)

    Define product ownership to match your culture and customers

    Characteristics of a discrete product:

    • Has end users or consumers
    • Delivers quantifiable value
    • Evolves or changes over time
    • Has predictable delivery
    • Has definable boundaries
    • Has a cost to produce and operate
    • Has a discrete backlog and roadmap of improvements

    What does not need a product owner?

    • Individual features
    • Transactions
    • Unstructured data
    • One-time solutions
    • Non-repeatable processes
    • Solutions that have no users or consumers
    • People or teams

    Info-Tech Insight

    • Products are long-term endeavors that don’t end after the project finishes.
    • Products mature and improve their ability to deliver value.
    • Products have a discrete backlog of changes to improve the product itself, separate from operational requests fulfilled by the product or service.

    Need help defining your products or services? Download our blueprint Deliver Digital Products at Scale.

    Connect roadmaps to value realization with KPIs

    Every roadmap item should have an expected realized value once it is implemented. The associate KPIs or OKRs determine if our goal was met. Any gap in value feedback back into the roadmap and backlog refinement.</p data-verified=

    " loading="lazy">

    Info-Tech Insight

    Every roadmap item should have an expected realized value once it is implemented. The associate KPIs or OKRs determine if our goal was met. Any gap in value feedback back into the roadmap and backlog refinement.

    Identify the differences between a project-centric and a product-centric organization

    Differences between Project centric and Product centric organizations in regards to: Funding, Prioritization, Accountability, Product management, Work allocation, and Capacity management.

    Info-Tech Insight

    Product delivery requires significant shifts in the way you complete development work and deliver value to your users. Make the changes that support improving end-user value and enterprise alignment.

    Projects can be a mechanism for funding product changes and improvements

    Projects lifecycle, hybrid lifecycle and product lifecycle. Period or periods of project development have parallel services that encompass a more product-based view.

    Projects withing products

    Regardless of whether you recognize yourself as a product-based or project-based shop, the same basic principles should apply.

    You go through a period or periods of project-like development to build a version of an application or product.

    You also have parallel services along with your project development, which encompasses a more product-based view. These may range from basic support and maintenance to full-fledged strategy teams or services like sales and marketing.

    Recognize common barriers to product management

    The transition to product ownership is a series of behavioral and cultural changes supported by processes and governance. It takes time and consistency to be successful.

    • Command and control structures
    • Lack of ownership and accountability
    • High instability in the market, demand, or organization
    • Lack of dedicated teams align to delivery, service, or product areas
    • Culture of one-off projects
    • Lack of identified and engaged stakeholders
    • Lack of customer exposure and knowledge

    Agile’s four core values

    “…while there is value in the items on the right, we value the items on the left more.”

    Source: “The Agile Manifesto”

    We value...

    We value being agile: Individuals and interactions, Working Software, Customer collaboration, Responding to change. Versus being prescriptive: Processes and tools, Comprehensive documentation, Contract negotiation, following a plan.

    Exercise 1.1.1 Define enablers and blockers of product management

    1 hour
    1. Identify and mitigate blockers of product management in your organization.
    2. What enablers will support strong product owners?
    3. What blockers will make the transition to product management harder?
    4. For each blocker, also define at least one mitigating step.
    Define enablers e.g. team culture. Define blockers and at least one mitigating step

    Output

    • Enablers and blockers

    Participants

    • Product owners
    • Product managers
    • Development team leads
    • Portfolio managers
    • Business analysts

    Capture in the Mature and Scale Product Ownership Playbook.

    Align enterprise value through product families

    Product families are operational groups based on capabilities or business functions. Product family managers translate goals, priorities, and constraints so they are actionable at the next level. Product owners prioritize changes to enhance the capabilities that allow you to realize your product family. Enabling capabilities realize value and help reach your goals.

    Effective product delivery requires thinking about more than just a single product

    Good application and product management begins with strengthening good practices for a single or small set of applications, products, and services.

    Product portfolio

    Groups of product families within an overall value stream or capability grouping.

    Project portfolio manager

    Product family

    A collection of related products. Products can be grouped along architectural, functional, operational, or experiential patterns.

    Product family manager

    Product

    Single product composed of one or more applications and services.

    Product owner

    Info-Tech Insight

    Define the current roles that will perform the product management function or define consistent role names to product owners and managers.

    Exercise 1.1.2 Define your product management roles and names

    1-2 hour
    1. Identify the roles in which product management activities will be owned.
    2. Define a common set of role names and describe the role.
    3. Map the level of accountability for each role: Product or Product Family
    4. Product owner perspectives will be defined in the next step.

    Define roles, description and level of product accountability.

    Output

    • Role definitions

    Participants

    • Product owners
    • Product managers
    • Development team leads
    • Portfolio managers
    • Business analysts

    Capture in the Mature and Scale Product Ownership Playbook.

    Use CLAIM to guide your journey

    Culture, Learning, Automation, Integrated teams, Metrics and governance.

    Value is best created by self-managing teams who deliver in frequent, short increments supported by leaders who coach them through challenges.

    Product-centric delivery and Agile are a radical change in how people work and think. Structured, facilitated learning is required throughout the transformation to help leaders and practitioners make the shift.

    Product management, Agile, and DevOps have inspired SDLC tools that have become a key part of delivery practices and work management.

    Self-organizing teams that cross business, delivery, and operations are essential to gain the full benefits of product-centric delivery.

    Successful implementations require the disciplined use of metrics that support developing better teams

    Exercise 1.1.3 Assess your product management readiness

    1 hour
    1. Open and complete the Mature and Scale Product Ownership Readiness Assessment in your Playbook or the provided Excel tool.
    2. Discuss high and low scores for each area to reach a consensus.
    3. Record your results in your Playbook.

    Assess your culture, learning, automation, Integrated teams, metrics and governance.

    Output

    • Assessment of product management readiness based on Info-Tech’s CLAIM+G model.

    Participants

    • Product owners
    • Product managers
    • Development team leads
    • Portfolio managers
    • Business analysts

    Capture in the Mature and Scale Product Ownership Readiness Assessment.

    Communicate reasons for changes and how they will be implemented

    Five elements of communicating change: What is the change? Why are we doing it? How are we going to go about it? How long will it take us to do it? What will the role be for each department individual?

    Leaders of successful change spend considerable time developing a powerful change message; that is, a compelling narrative that articulates the desired end state, and that makes the change concrete and meaningful to staff.

    The organizational change message should:

    Step 1.2

    Establish your product ownership model

    Activities

    1.2.1 Identify your primary product owner perspective

    1.2.2 Define your product owner RACI

    Establish the foundation for product ownership

    This step involves the following participants:

    • Product owners
    • Product managers
    • Development team leads
    • Portfolio managers
    • Delivery managers
    • Business analysts

    Outcomes of this step

    • Product owner perspective mapping
    • Product owner RACI

    Recognize the product owner perspectives

    The 3 product owner perspectives. 1. Business: Customer-facing, value-generating. 2. Technical: IT systems and tools. 3. Operations: Keep-the-lights-on processes.

    Product owners represent one of three primary perspectives. Although all share the same capabilities, how they approach their responsibilities is influenced by their primary perspective.

    Info-Tech Best Practice

    Product owners must translate needs and constraints from their perspective into the language of their audience. Kathy Borneman, Digital Product Owner at SunTrust Bank, noted the challenges of finding a common language between lines of business and IT (e.g. what is a unit?).

    Identify and align to product owner perspectives to ensure product success

    Product owner perspectives

    The 3 product owner perspectives. 1. Business: Customer-facing, value-generating. 2. Technical: IT systems and tools. 3. Operations: Keep-the-lights-on processes.
    1. Each product owner perspective provides important feedback, demand, and support for the product.
    2. Where a perspective is represented by a distinct role, the perspective is managed with that product owner.
    3. If separate roles don’t exist, the product owner must evaluate their work using two or three perspectives.
    4. The ultimate success of a product, and therefore product owner, is meeting the end-user value of the business product owner, tool support of the technical product owner, and manual processing support of the operations product owner.

    Line of business (LOB) product owners

    LOB product owners focus on the products and services consumed by the organization’s external consumers and users. The role centers on the market needs, competitive landscape, and operational support to deliver products and services.

    Business perspective

    • Alignment to enterprise strategy and priorities
    • Growth: market penetration and/or revenue
    • Perception of product value
    • Quality, stability, and predictability
    • Improvement and innovation
    • P&L
    • Market threats and opportunities
    • Speed to market
    • Service alignment
    • Meet or exceed individual goals

    Relationship to Operations

    • Customer satisfaction
    • Speed of delivery and manual processing
    • Continuity

    Relationship to Technical

    • Enabler
    • Analysis and insight
    • Lower operating and support costs

    Technical product owners

    Technical product owners are responsible for the IT systems, tools, platforms, and services that support business operations. Often they are identified as application or platform managers.

    Technical perspective

    • Application, application suite, or group of applications
    • Core platforms and tools
    • Infrastructure and networking
    • Third-party technology services
    • Enable business operations
    • Direct-to-customer product or service
    • Highly interconnected
    • Need for continuous improvement
    • End-of-life management
    • Internal value proposition and users

    Relationship to Business

    • Direct consumers
    • End users
    • Source of funding

    Relationship to Operations

    • End users
    • Process enablement or automation
    • Support, continuity, and manual intervention

    Operations (service) product owners

    Operational product owners focus on the people, processes, and tools needed for manual processing and decisions when automation is not cost-effective. Operational product owners are typically called service owners due to the nature of their work.

    Operational perspective

    • Business enablement
    • Continuity
    • Problem, incident, issue resolution
    • Process efficiency
    • Throughput
    • Error/defect avoidance
    • Decision enablement
    • Waste reduction
    • Limit time in process
    • Disaster recovery

    Relationship to Business

    • Revenue enablement
    • Manual intervention and processing
    • End-user satisfaction

    Relationship to Technical

    • Process enabler
    • Performance enhancement
    • Threat of automation

    Exercise 1.2.1 Identify your primary product owner perspective

    1 hour
    1. Identify which product owner perspective represents your primary focus.
    2. Determine where the other perspectives need to be part of your product roadmap or if they are managed by other product owners.

    Identify product/service name, identify product owner perspective, determine if other perspectives need to be part of roadmap.

    Output

    • Identification of primary product owner perspective.

    Participants

    • Product owners
    • Product managers
    • Development team leads
    • Portfolio managers
    • Business analysts

    Capture in the Mature and Scale Product Ownership Playbook.

    Realign differences between project managers and product owners

    Differences between Project Manager and Product Owners in regards to: Funding, Prioritization, Accountability, Product management, Work allocation, and Capacity management.

    Manage and communicate key milestones

    Successful product owners understand and define the key milestones in their product delivery lifecycles. These need to be managed along with the product backlog and roadmap.

    Define key milestones and their product delivery life-cycles.

    Info-Tech Best Practice

    Product ownership isn’t just about managing the product backlog and development cycles. Teams need to manage key milestones such as learning milestones, test releases, product releases, phase gates, and other organizational checkpoints.

    Define who manages each key milestone

    Key milestones must be proactively managed. If a project manager is not available, those responsibilities need to be managed by the product owner or Scrum Master. Start with responsibility mapping to decide which role will be responsible.

    Example milestones and Project Manager, Product Owner and Team Facilitator.

    *Scrum Master, Delivery Manager, Team Lead

    Exercise 1.2.2 Define your product owner RACI

    60 minutes
    1. Review your product and project delivery methodologies to identify key milestones (including approvals, gates, reviews, compliance checks, etc.). List each milestone on a flip chart or whiteboard.
    2. For each milestone, define who is accountable for the completion.
    3. For each milestone, define who is responsible for executing the milestone activity. (Who does the work that allows the milestone to be completed?)
    4. Review any responsibility and accountability gaps and identify opportunities to better support and execute your operating model.
    5. If you previously completed Deliver Digital Products at Scale , review and update your RACI in the Mature and Scale Product Ownership Workbook .

    Define: Milestones, Project Manager, Product/service owner, Team Facilitator, and Other roles.

    Output

    • Product owner RACI

    Participants

    • Product owners
    • Product managers
    • Development team leads
    • Portfolio managers
    • Business analysts

    Capture in the Mature and Scale Product Ownership Playbook.

    Phase 2

    Align Product Owners to Products

    Phase 2: Assign product owners to products, Manage stakeholder influence

    Mature and Scale Product Ownership

    This phase will walk you through the following activities:

    2.1.1 Assign resources to your products and families

    2.2.1 Visualize relationships to identify key influencers

    2.2.2 Group stakeholders into categories

    2.2.3 Prioritize your stakeholders

    This phase involves the following participants:

    • Product owners
    • Product managers
    • Development team leads
    • Portfolio managers
    • Delivery managers
    • Business analysts

    Step 2.1

    Assign product owners to products

    Activities

    2.1.1 Assign resources to your products and families

    Align product owners to products

    This step involves the following participants:

    • Product owners
    • Product managers
    • Development team leads
    • Portfolio managers
    • Delivery managers
    • Business analysts

    Outcomes of this step

    • Product resource assignment

    Match your product management role definitions to your product family levels

    Using the role definitions, you created in Exercise 1.1.2, determine which roles correspond to which levels of your product families.

    Product portfolio

    Groups of product families within an overall value stream or capability grouping.

    Project portfolio manager

    Product family

    A collection of related products. Products can be grouped along architectural, functional, operational, or experiential patterns.

    Product family manager

    Product

    Single product composed of one or more applications and services.

    Product owner

    Info-Tech Insight

    Define the current roles that will perform the product management function or define consistent role names to product owners and managers.

    Assign resources throughout your product families

    Project families are owned by a product manager. Product owners own each product that has a distinct backlog.

    Info-Tech Insight

    • Start by assigning resources to each product or product family box.
    • A product owner can be responsible for more than one product.
    • Ownership of more than one product does not mean they share the same backlog.
    • For help organizing your product families, please download Deliver Digital Products at Scale.

    Understand special circumstances

    In Deliver Digital Products at Scale , products were grouped into families using Info-Tech’s five scaling patterns. Assigning owners to Enterprise Applications and Shared Services requires special consideration.

    Value stream alignment

    • Business architecture
      • Value stream
      • Capability
      • Function
    • Market/customer segment
    • Line of business (LoB)
    • Example: Customer group > value stream > products

    Enterprise applications

    • Enabling capabilities
    • Enterprise platforms
    • Supporting apps
    • Example: HR > Workday/Peoplesoft > Modules Supporting: Job board, healthcare administrator

    Shared Services

    • Organization of related services into service family
    • Direct hierarchy does not necessarily exist within the family
    • Examples: End-user support and ticketing, workflow and collaboration tools

    Technical

    • Domain grouping of IT infrastructure, platforms, apps, skills, or languages
    • Often used in combination with Shared Services grouping or LoB-specific apps
    • Examples: Java, .NET, low-code, database, network

    Organizational alignment

    • Used at higher levels of the organization where products are aligned under divisions
    • Separation of product managers from organizational structure is no longer needed because the management team owns the product management role

    Map the source of demand to each product

    With enterprise applications and shared services, your demand comes from other product and service owners rather than end customers in a value stream.

    Enterprise applications

    • Primary demand comes from the operational teams and service groups using the platform.
    • Each group typically has processes and tools aligned to a module or portion of the overall platform.
    • Product owners determine end-user needs to assist with process improvement and automation.
    • Product family managers help align roadmap goals and capabilities across the modules and tools to ensure consistency and the alignment of changes.

    Shared services

    • Primary demand for shared services comes from other product owners and service managers whose solution or application is dependent on the shared service platform.
    • Families are grouped by related themes (e.g. workflow tools) to increase reusability, standard enterprise solutions, reduced redundancy, and consistent processes across multiple teams.
    • Product owners manage the individual applications or services within a family.

    Pattern: Enterprise applications

    A division or group delivers enabling capabilities and the team’s operational alignment maps directly to the modules/components of an enterprise application and other applications that support the specific business function.

    Workforce Management, Strategic HR, Talent Management, Core HR

    Example:

    • Human resources is one corporate function. Within HR, however, there are subfunctions that operate independently.
    • Each operational team is supported by one or more applications or modules within a primary HR system.
    • Even though the teams work independently, the information they manage is shared with, or ties into processes used by other teams. Coordination of efforts helps provide a higher level of service and consistency.

    For additional information about HRMS, please download Get the Most Out of Your HRMS.

    Assigning owners to enterprise applications

    Align your enterprise application owners to your operating teams that use the enterprise applications. Effectively, your service managers will align with your platform module owners to provide integrated awareness and planning.

    Family manager (top-level), Family managers (second-level) and Product owners.

    Pattern: Shared services

    Grouping by service type, knowledge area, or technology allows for specialization while families align service delivery to shared business capabilities.

    Grouping by service type, knowledge area, or technology allows for specialization while families align service delivery to shared business capabilities.

    Example:

    • Recommended for governance, risk, and compliance; infrastructure; security; end-user support; and shared platforms (workflow, collaboration, imaging/record retention). Direct hierarchies do not necessarily exist within the shared service family.
    • Service groupings are common for service owners (also known as support managers, operations managers, etc.).
    • End-user ticketing comes through a common request system, is routed to the team responsible for triage, and then is routed to a team for resolution.
    • Collaboration tools and workflow tools are enablers of other applications, and product families might support multiple apps or platforms delivering that shared capability.

    Assigning owners to shared services

    Assign owners by service type, knowledge area, or technology to provide alignment of shared business capabilities and common solutions.

    Family manager (top-level), Family managers (second-level) and Product owners.

    Map sources of demand and influencers

    Use the stakeholder analysis to define the key stakeholders and sources of demand for enterprise applications and shared services. Extend your mapping to include their stakeholders and influencers to uncover additional sources of demand and prioritization.

    Map of key stakeholders for enterprise applications and shared services.

    Info-Tech Insight

    Your product owner map defines the influence landscape your product operates. It is every bit as important as the teams who enhance, support, and operate your product directly.

    Combine your product owner map with your stakeholder map to create a comprehensive view of influencers.

    Exercise 2.1.1 Assign resources to your products and families

    1-4 hours
    1. Use the product families you completed in Deliver Digital Products at Scale to determine which products and product families need a resource assigned. Where the same resource fills more than one role, they are the product owner or manager for each independently.
    2. Product families that are being managed as products (one backlog for multiple products) should have one owner until the family is split into separate products later.
    3. For each product and family, define the following:
      • Who is the owner (role or person)?
      • Is ownership clearly defined?
      • Are there other stakeholders who make decisions for the product?
    4. Record the results in the Mature and Scale Product Ownership Workbook on the Product Owner Mapping worksheet.

    Output

    • Product owner and manager resource alignment.

    Participants

    • Product owners
    • Product managers
    • Development team leads
    • Portfolio managers
    • Business analysts

    Capture in the Mature and Scale Product Ownership Playbook.

    Step 2.2

    Manage stakeholder influence

    Activities

    2.2.1 Visualize relationships to identify key influencers

    2.2.2 Group stakeholders into categories

    2.2.3 Prioritize your stakeholders

    Align product owners to products

    This step involves the following participants:

    • Product owners
    • Product managers
    • Development team leads
    • Portfolio managers
    • Delivery managers
    • Business analysts

    Outcomes of this step

    • Stakeholder management strategy

    Develop a product owner stakeholder strategy

    Stakeholder management, Product lifecycle, Project delivery, Operational support.

    Stakeholders are a critical cornerstone to product ownership. They provide the context, alignment, and constraints that influence or control what a product owner can accomplish.

    Product owners operate within a network of stakeholders who represent different perspectives within the organization.

    First, product owners must identify members of their stakeholder network. Next, they should devise a strategy for managing stakeholders.

    Without a stakeholder strategy, product owners will encounter obstacles, resistance, or unexpected changes.

    Create a stakeholder network map to product roadmaps and prioritization

    Follow the trail of breadcrumbs from your direct stakeholders to their influencers to uncover hidden stakeholders.

    Create a stakeholder network map to product roadmaps and prioritization. Use connectors to determine who may be influencing your direct stakeholders.

    Info-Tech Insight

    Your stakeholder map defines the influence landscape your product operates. It is every bit as important as the teams who enhance, support, and operate your product directly.

    Use connectors to determine who may be influencing your direct stakeholders. They may not have any formal authority within the organization, but they may have informal yet substantive relationships with your stakeholders.

    Exercise 2.2.1 Visualize relationships to identify key influencers

    1 hour
    1. List direct stakeholders for your product.
    2. Determine the stakeholders of your stakeholders and consider adding each of them to the stakeholder list.
    3. Assess who has either formal or informal influence over your stakeholders; add these influencers to your stakeholder list.
    4. Construct a diagram linking stakeholders and their influencers together.
      • Use black arrows to indicate the direction of professional influence.
      • Use dashed green arrows to indicate informal bidirectional influence relationships.
    5. Record the results in the Mature and Scale Product Ownership Workbook .

    Output

    • Relationships among stakeholders and influencers

    Participants

    • Product owners
    • Product managers
    • Development team leads
    • Portfolio managers
    • Business analysts

    Capture in the Mature and Scale Product Ownership Playbook.

    Categorize your stakeholders with a prioritization map

    A stakeholder prioritization map helps product owners categorize their stakeholders by their level of influence and ownership in the product and/or teams.

    Influence versus Ownership/Interest

    There are four areas on the map, and the stakeholders within each area should be treated differently.

    • Players have a high interest in the initiative and the influence to effect change over the initiative. Their support is critical, and a lack of support can cause significant impediments to the objectives.
    • Mediators have a low interest but significant influence over the initiative. They can help to provide balance and objective opinions to issues that arise.
    • Noisemakers have low influence but high interest. They tend to be very vocal and engaged, either positively or negatively but have little ability to enact their wishes.
    • Spectators are generally apathetic and have little influence over or interest in the initiative.

    Exercise 2.2.2 Group stakeholders into categories

    1 hour
    1. Identify your stakeholders’ interest in and influence on your Agile implementation as high, medium, or low by rating the attributes below.
    2. Map your results to the model below to determine each stakeholder’s category.
    3. Record the results in the Mature and Scale Product Ownership Workbook .

    Influence versus Ownership/Interest with CMO, CIO and Product Manager in assigned areas.

    Output

    • Categorization of stakeholders and influencers

    Participants

    • Product owners
    • Product managers
    • Development team leads
    • Portfolio managers
    • Business analysts

    Capture in the Mature and Scale Product Ownership Playbook.

    Prioritize your stakeholders

    There may be too many stakeholders to be able to manage them all. Focus your attention on the stakeholders that matter most.

    Stakeholder category versus level of support.

    Consider the three dimensions of stakeholder prioritization: influence, interest, and support. Support can be determined by rating the following question: How likely is it that your stakeholder would recommend your product? These parameters are used to prioritize which stakeholders are most important and should receive your focused attention. The table to the right indicates how stakeholders are ranked.

    Exercise 2.2.3 Prioritize your stakeholders

    1 hour
    1. Identify the level of support of each stakeholder by answering the following question: How likely is it that your stakeholder would endorse your product?
    2. Prioritize your stakeholders using the prioritization scheme on the previous slide.
    3. Record the results in the Mature and Scale Product Ownership Workbook .

    Stakeholder, Category, level of support, prioritization.

    Output

    • Stakeholder and influencer prioritization

    Participants

    • Product owners
    • Product managers
    • Development team leads
    • Portfolio managers
    • Business analysts

    Capture in the Mature and Scale Product Ownership Playbook.

    Define strategies for engaging stakeholders by type

    Authority Vs. Ownership/Interest.

    Type

    Quadrant

    Actions

    Players

    High influence, high interest – actively engage Keep them updated on the progress of the project. Continuously involve players in the process and maintain their engagement and interest by demonstrating their value to its success.

    Mediators

    High influence, low interest – keep satisfied They can be the game changers in groups of stakeholders. Turn them into supporters by gaining their confidence and trust and including them in important decision-making steps. In turn, they can help you influence other stakeholders.

    Noisemakers

    Low influence, high interest – keep informed Try to increase their influence (or decrease it if they are detractors) by providing them with key information, supporting them in meetings, and using mediators to help them.

    Spectators

    Low influence, low interest – monitor They are followers. Keep them in the loop by providing clarity on objectives and status updates.

    Info-Tech Insight

    Each group of stakeholders draws attention and resources away from critical tasks. By properly identifying your stakeholder groups, the product owner can develop corresponding actions to manage stakeholders in each group. This can dramatically reduce wasted effort trying to satisfy spectators and noisemakers while ensuring the needs of mediators and players are met.

    Phase 3

    Mature Product Owner Capabilities

    Phase 3: Assess your Agile product owner readiness, Mature product owner capabilities.

    Mature and Scale Product Ownership

    This phase will walk you through the following activities:

    3.1.1 Assess your real Agile skill proficiency

    3.2.1 Assess your vision capability proficiency

    3.2.2 Assess your leadership capability proficiency

    3.2.3 Assess your PLM capability proficiency

    3.2.4 Identify your business value drivers and sources of value

    3.2.5 Assess your value realization capability proficiency

    This phase involves the following participants:

    • Product owners
    • Product managers

    Step 3.1

    Assess your Agile product owner readiness

    Activities

    3.1.1 Assess your real Agile skill proficiency

    Mature product owner capabilities

    This step involves the following participants:

    • Product owners
    • Product managers

    Outcomes of this step

    • Real Agile skill proficiency assessment

    Why focus on core skills?

    They are the foundation to achieve business outcomes

    Skills, actions, output and outcomes

    The right skills development is only possible with proper assessment and alignment against outcomes.

    Being successful at Agile is more than about just doing Agile

    The following represents the hard skills needed to “Do Agile”:

    Being successful at Agile needs 4 hard skills: 1. Engineering skills, 2. Technician Skills, 3. Framework/Process skills, 4. Tools skills.

    • Engineering skills. These are the skills and competencies required for building brand-new valuable software.
    • Technician skills. These are the skills and competencies required for maintaining and operating the software delivered to stakeholders.
    • Framework/Process skills. These are the specific knowledge skills required to support engineering or technician skills.
    • Tools skills. This represents the software that helps you deliver other software.

    While these are important, they are not the whole story. To effectively deliver software, we believe in the importance of being Agile over simply doing Agile.

    Adapted from: “Doing Agile” Is Only Part of the Software Delivery Pie

    Focus on these real Agile skills

    Agile skills

    • Accountability
    • Collaboration
    • Comfort with ambiguity
    • Communication
    • Empathy
    • Facilitation
    • Functional decomposition
    • Initiative
    • Process discipline
    • Resilience

    Info-Tech research shows these are the real Agile skills to get started with

    Skill Name

    Description

    Accountability

    Refers to the state of being accountable. In an Agile context, it implies transparency, dedication, acting responsibly, and doing what is necessary to get the job done.

    Collaboration

    Values diverse perspectives and working with others to achieve the best output possible. Effective at working toward individual, team, department, and organizational goals.

    Comfort with ambiguity

    Allows you to confidently take the next steps when presented with a problem without having all the necessary information present.

    Communication

    Uses different techniques to share information, concerns, or emotions when a situation arises, and it allows you to vary your approach depending on the current phase of development.

    Empathy

    Is the ability to understand and share the feelings of another to better serve your team and your stakeholders.

    Facilitation

    Refers to guiding and directing people through a set of conversations and events to learn and achieve a shared understanding.

    Functional decomposition

    Is being able to break down requirements into constituent epics and stories.

    Initiative

    Is being able to anticipate challenges and then act on opportunities that lead to better business outcomes.

    Process discipline

    Refers to the focus of following the right steps for a given activity at the right time to achieve the right outcomes.

    Resilience

    Refers to the behaviors, thoughts, and actions that allow a person to recover from stress and adversity.

    Accountability

    An accountable person:

    • Takes ownership of their own decisions and actions and is responsible for the quality of results.
    • Recognizes personal accountabilities to others, including customers.
    • Works well autonomously.
    • Ensures that the mutual expectations between themselves and others are clearly defined.
    • Takes the appropriate actions to ensure that obligations are met in a timely manner.
    • As a leader, takes responsibility for those being led.

    Accountability drives high performance in teams and organizations

    • The performance level of teams depends heavily on accountability and who demonstrates it:
      • In weak teams, there is no accountability.
      • In mediocre teams, supervisors demonstrate accountability.
      • In high-performance teams, peers manage most performance problems through joint accountability. (Grenny, 2014)
    • According to Bain & Company, accountability is the third most important attribute of high-performing companies. Some of the other key attributes include honest, performance-focused, collaborative, and innovative. (Mankins, 2013)

    All components of the employee empowerment driver have a strong, positive correlation with engagement.

    Employee empowerment and Correlation with engagement.

    Source: McLean & Company Engagement Database, 2018; N=71,794

    Accountability

    Your Score: ____

    1 - Foundational: Transitioning and Growing

    2 - Capable/Competent: Core Contributor

    3 - Influential: Gifted Improver

    4 - Transformational: Towering Strength

    • Alerts others to possible problems in a timely manner.
    • Seeks appropriate support to solve problems.
    • Actively contributes to the creation and evaluation of possible solutions.
    • Acts on solutions selected and decisions made as directed.
    • Makes effective decisions about how to complete work tasks.
    • Demonstrates the capability of breaking down concrete issues into parts and synthesizing information succinctly.
    • Collects and analyzes information from a variety of sources.
    • Seeks information and input to fully understand the cause of problems.
    • Takes action to address obstacles and problems before they impact performance and results.
    • Initiates the evaluation of possible solutions to problems.
    • Makes effective decisions about work task prioritization.
    • Appropriately assesses risks before deciding.
    • Effectively navigates through ambiguity, using multiple data points to analyze issues and identify trends.
    • Does not jump to conclusions.
    • Draws logical conclusions and provides opinions and recommendations with confidence.
    • Takes ownership over decisions and their consequences.
    • Demonstrates broad knowledge of information sources that can be used to assess problems and make decisions.
    • Invests time in planning, discovery, and reflection to drive better decisions.
    • Effectively leverages hard data as inputs to making decisions.
    • Garners insight from abstract data and makes appropriate decisions.
    • Coaches others in effective decision-making practices.
    • Has the authority to solve problems and make decisions.
    • Thinks several steps ahead in deciding the best course of action, anticipating likely outcomes, risks, or implications.
    • Establishes metrics to aid in decision-making, for self and teams
    • Prioritizes objective and ambiguous information and analyzes this when making decisions.
    • Solicits a diverse range of opinions and perspectives as inputs to decision making.
    • Applies frameworks to decision making, particularly in situations that have little base in prior experience.
    • Makes effective decisions about organizational priorities.
    • Holds others accountable for their decisions and consequences.
    • Creates a culture of empowerment and trust to facilitate effective problem solving and decision making.
    • Makes sound decisions that have organization-wide consequences and that influence future direction.

    Collaboration as a skill

    The principles and values of Agile revolve around collaboration.

    • Works well with others on specialized and cross-functional teams.
    • Can self-organize while part of a team.
    • Respects the commitments that others make.
    • Identifies and articulates dependencies.
    • Values diverse perspectives and works with others to achieve the best output possible.
    • Effective at working toward individual, team, department, and organizational goals.
    The principles and values of Agile revolve around collaboration. Doing what was done before (being prescriptive), going though the motions (doing Agile), living the principles (being Agile)

    Collaboration

    The Agile Manifesto has three principles that focus on collaboration:

    1. The business and developers must work together daily throughout the project.
    2. Build projects around motivated individuals. Give them the environment and support they need and trust them to get the job done.
    3. The most efficient and effective method of conveying information to and within a development team is face-to-face conversation.

    Effective collaboration supports Agile behaviors, including embracing change and the ability to work iteratively.

    Collaboration

    Your Score: ____

    1 - Foundational: Transitioning and Growing

    2 - Capable/Competent: Core Contributor

    3 - Influential: Gifted Improver

    4 - Transformational: Towering Strength

    • Understands role on the team and the associated responsibilities and accountabilities.
    • Treats team members with respect.
    • Contributes to team decisions and to the achievement of team goals and objectives.
    • Demonstrates a positive attitude.
    • Works cross-functionally to achieve common goals and to support the achievement of other team/department goals.
    • Values working in a diverse team and understands the importance of differing perspectives to develop unique solutions or ideas.
    • Fosters team camaraderie, collaboration, and cohesion.
    • Understands the impact of one's actions on the ability of team members to do their jobs.
    • Respects the differences other team members bring to the table by openly seeking others' opinions.
    • Helps the team accomplish goals and objectives by breaking down shared goals into smaller tasks.
    • Approaches challenging team situations with optimism and an open mind, focusing on coming to a respectful conclusion.
    • Makes suggestions to improve team engagement and effectiveness.
    • Supports implementation of team decisions.
    • Professionally gives and seeks feedback to achieve common goals.
    • Values working in a diverse team and understands the importance of differing perspectives to develop unique solutions or ideas.
    • Motivates the team toward achieving goals and exceeding expectations.
    • Reaches out to other teams and departments to build collaborative, cross-functional relationships.
    • Creates a culture of collaboration that leverages team members' strengths, even when the team is remote or virtual.
    • Participates and encourages others to participate in initiatives that improve team engagement and effectiveness.
    • Builds consensus to make and implement team decisions, often navigating through challenging task or interpersonal obstacles.
    • Values leading a diverse team and understands the importance of differing perspectives to develop unique solutions or ideas.
    • Creates a culture of collaboration among teams, departments, external business partners, and all employee levels.
    • Breaks down silos to achieve inter-departmental collaboration.
    • Demonstrates ownership and accountability for team/department/ organizational outcomes.
    • Uses an inclusive and consultative approach in setting team goals and objectives and making team decisions.
    • Coaches others on how to identify and proactively mitigate potential points of team conflict.
    • Recognizes and rewards teamwork throughout the organization.
    • Provides the tools and resources necessary for teams to succeed.
    • Values diverse teams and understands the importance of differing perspectives to develop unique solutions or ideas.

    Comfort with ambiguity

    Ability to handle ambiguity is a key factor in Agile success.

    • Implies the ability to maintain a level of effectiveness when all information is not present.
    • Able to confidently act when presented with a problem without all information present.
    • Risk and uncertainty can comfortably be handled.
    • As a result, can easily adapt and embrace change.
    • People comfortable with ambiguity demonstrate effective problem-solving skills.

    Relative importance of traits found in Agile teams

    1. Handles ambiguity
    2. Agreeable
    3. Conscientious

    Comfort with ambiguity

    Your Score: ____

    1 - Foundational: Transitioning and Growing

    2 - Capable/Competent: Core Contributor

    3 - Influential: Gifted Improver

    4 - Transformational: Towering Strength

    • Requires most information to be present before carrying out required activities.
    • Can operate with some information missing.
    • Comfortable asking people within their known circles for help.
    • Significant time is taken to reveal small pieces of information.
    • More adept at operating with information missing.
    • Willing to reach out to people outside of their regular circles for assistance and clarification.
    • Able to apply primary and secondary research methods to fill in the missing pieces.
    • Can operate essentially with a statement and a blank page.
    • Able to build a plan, drive others and themselves to obtain the right information to solve the problem.
    • Able to optimize only pulling what is necessary to answer the desired question and achieve the desired outcome.

    Communication

    Even though many organizations recognize its importance, communication is one of the root causes of project failure.

    Project success vs Communication effectiveness. Effective communications is associated with a 17% increase in finishing projects within budget.

    56%

    56% of the resources spent on a project are at risk due to ineffective communications.

    PMI, 2013.

    29%

    In 29% of projects started in the past 12 months, poor communication was identified as being one of the primary causes of failure.

    PMI, 2013.

    Why are communication skills important to the Agile team?

    It’s not about the volume, it’s about the method.

    • Effectively and appropriately interacts with others to build relationships and share ideas and information.
    • Uses tact and diplomacy to navigate difficult situations.
    • Relays key messages by creating a compelling story, targeted toward specific audiences.

    Communication effectiveness, Activity and Effort required.

    Adapted From: Agile Modeling

    Communication

    Your Score:____

    1 - Foundational: Transitioning and Growing

    2 - Capable/Competent: Core Contributor

    3 - Influential: Gifted Improver

    4 - Transformational: Towering Strength

    • Actively listens, learns through observation, and uses clear and precise language.
    • Possesses an open and approachable demeanor, with a positive and constructive tone.
    • Demonstrates interest in the thoughts and feelings of others.
    • Considers potential responses of others before speaking or acting.
    • Checks own understanding of others’ communication by repeating or paraphrasing.
    • Demonstrates self-control in stressful situations.
    • Provides clear, concise information to others via verbal or written communication.
    • Seeks to understand others' points of view, looking at verbal and non-verbal cues to encourage open and honest discussions.
    • Invites and encourages others to participate in discussions.
    • Projects a sincere and genuine tone.
    • Remains calm when dealing with others who are upset or angry.
    • Provides and seeks support to improve communication.
    • Does not jump to conclusions or act on assumptions.
    • Tailors messages to meet the different needs of different audiences.
    • Accurately interprets responses of others to their words and actions.
    • Provides feedback effectively and with empathy.
    • Is a role model for others on how to effectively communicate.
    • Ensures effective communication takes place at the departmental level.
    • Engages stakeholders using appropriate communication methods to achieve desired outcomes.
    • Creates opportunities and forums for discussion and idea sharing.
    • Demonstrates understanding of the feelings, motivations, and perspectives of others, while adapting communications to anticipated reactions.
    • Shares insights about their own strengths, weaknesses, successes, ad failures to show empathy and help others relate.
    • Discusses contentious issues without getting defensive and maintains a professional tone.
    • Coaches others on how to communicate effectively and craft targeted messages.
    • Sets and exemplifies standards for respectful and effective communications in the organization.
    • Comfortably delivers strategic messages supporting their function and the organization at the enterprise level.
    • Communicates with senior-level executives on complex organizational issues.
    • Promotes inter-departmental communication and transparency.
    • Achieves buy-in and consensus from people who share widely different views.
    • Shares complex messages in clear, understandable language.
    • Accurately interprets how they are perceived by others.
    • Rallies employees to communicate ideas and build upon differing perspectives to drive innovation.

    Empathy

    Empathy is the ability to understand and share the feelings of another in order to better serve your team and your stakeholders. There are three kinds:

    Cognitive

    Thought, understanding, intellect

    • Knowing how someone else feels and what they might be thinking.
    • Contributes to more effective communication.

    Emotional

    Feelings, physical sensation

    • You physically feel the emotions of the other person.
    • Helps build emotional connections with others.

    Compassionate

    Intellect, emotion with action

    • Along with understanding, you take action to help.

    How is empathy an Agile skill?

    Empathy enables you to serve your team, your customers, and your organization

    Serving the team

    • Primary types: Emotional and compassionate empathy.
    • The team is accountable for delivery.
    • By being able to empathize with the person you are talking to, complex issues can be addressed.
    • A lack of empathy leads to a lack of collaboration and being able to go forward on a common path.

    Serving your customers and stakeholders

    • Primary type: Cognitive empathy.
    • Agile enables the delivery of the right value at the right time to your stakeholders
    • Translating your stakeholders' needs requires an understanding of who they are as people. This is done through observations, interviews and conversations.
    • Leveraging empathy maps and user-story writing is an effective tool.

    Empathy

    Your Score: ____

    1 - Foundational: Transitioning and Growing

    2 - Capable/Competent: Core Contributor

    3 - Influential: Gifted Improver

    4 - Transformational: Towering Strength

    • Knowing how someone else feels and what they might be thinking.
    • Ability to build emotional connections with others.
    • Able to harness emotional connections to achieve tangible and experiential outcomes.
    • Demonstrates an awareness of different feelings and ways of thinking by both internal and external stakeholders.
    • Limited ability to make social connections with others outside of the immediate team.
    • Able to connect with similarly minded people to improve customer/stakeholder satisfaction. (Insights into action)
    • Able to interact and understand others with vastly different views.
    • Lack of agreement does not stop individual. from asking questions, understanding, and pushing the conversation forward

    Facilitation

    It’s not just your manager’s problem.

    “Facilitation is the skill of moderating discussions within a group in order to enable all participants to effectively articulate their views on a topic under discussion, and to ensure that participants in the discussion are able to recognize and appreciate the differing points of view that are articulated.” (IIBA, 2015)

    • Drives action through influence, often without authority.
    • Leads and impacts others' thinking, decisions, or behavior through inclusive practices and relationship building.
    • Encourages others to self-organize and hold themselves accountable.
    • Identifies blockers and constructively removes barriers to progress.

    Facilitation

    Your Score: ____

    1 - Foundational: Transitioning and Growing

    2 - Capable/Competent: Core Contributor

    3 - Influential: Gifted Improver

    4 - Transformational: Towering Strength

    • Drives action through influence, often without authority.
    • Leads and impacts others' thinking, decisions, or behavior through inclusive practices and relationship building.
    • Encourages others to self-organize and hold themselves accountable.
    • Identifies blockers and constructively removes barriers to progress.
    • Maps and executes processes effectively.
    • Uses facts and concrete examples to demonstrate a point and gain support from others.
    • Openly listens to the perspectives of others.
    • Builds relationships through honest and consistent behavior.
    • Understands the impact of their own actions and how others will perceive it.
    • Identifies impediments to progress.
    • Anticipates the effect of one's approach on the emotions and sensitivities of others.
    • Practices active listening while demonstrating positivity and openness.
    • Customizes discussion and presentations to include "what’s in it for me" for the audience.
    • Presents compelling information to emphasize the value of an idea.
    • Involves others in refining ideas or making decisions in order to drive buy-in and action.
    • Knows how to appropriately use influence to achieve outcomes without formal authority.
    • Seeks ways and the help of others to address barriers or blockers to progress.
    • Leverages a planned approach to influencing others by identifying stakeholder interests, common goals, and potential barriers.
    • Builds upon successes to gain acceptance for new ideas.
    • Facilitates connections between members of their network for the benefit of the organization or others.
    • Demonstrates the ability to draw on trusting relationships to garner support for ideas and action.
    • Encourages a culture that allows space for influence to drive action.
    • Adept at appropriately leveraging influence to achieve business unit outcomes.
    • Actively manages the removal of barriers and blockers for teams.

    Functional decomposition

    It’s not just a process, it’s a skill.

    “Functional decomposition helps manage complexity and reduce uncertainty by breaking down processes, systems, functional areas, or deliverables into their simpler constituent parts and allowing each part to be analyzed independently."

    (IIBA, 2015)

    Being able to break down requirements into constituent consumable items (example: epics and user stories).

    Start: Strategic Initiatives. 1: Epics. 2: Capabilities. 3: Features. End: Stories.

    Use artifact mapping to improve functional decomposition

    In our research, we refer to these items as epics, capabilities, features, and user stories. How you develop your guiding principles and structure your backlog should be based on the terminology and artifact types commonly used in your organization.

    Agile, Waterfall, Relationship, Decomposition skill most in demand, definition.

    Functional Decomposition

    Your Score: ____

    1 - Foundational: Transitioning and Growing

    2 - Capable/Competent: Core Contributor

    3 - Influential: Gifted Improver

    4 - Transformational: Towering Strength

    • Able to decompose items with assistance from other team members.
    • Able to decompose items independently, ensuring alignment with business value.
    • Able to decompose items independently and actively seeks out collaboration opportunities with relevant SME's during and after the refinement process to ensure completion.
    • Able to decompose items at a variety of granularity levels.
    • Able to teach and lead others in their decomposition efforts.
    • Able to quickly operate at different levels of the requirements stack.

    Initiative and self-organization

    A team that takes initiative can self-organize to solve critical problems.

    • "The best architectures, requirements, and designs emerge from self-organizing teams." (Agile Manifesto)
    • In a nutshell, the initiative represents the ability to anticipate challenges and act on opportunities that lead to better business outcomes.
    • Anticipates challenges and acts on opportunities that lead to better business outcomes.
    • Thinks critically and is motivated to use both specialist expertise and general knowledge.
    • Driven by the delivery of business value and better business outcomes.
    • Empowers others to act and is empowered and self-motivated.

    Initiative and self-organization

    Your Score: ____

    1 - Foundational: Transitioning and Growing

    2 - Capable/Competent: Core Contributor

    3 - Influential: Gifted Improver

    4 - Transformational: Towering Strength

    • Demonstrates awareness of an opportunity or issue which is presently occurring or is within the immediate work area.
    • Reports an opportunity or issue to the appropriate person.
    • Acts instead of waiting to be asked.
    • Willingly takes on challenges, even if they fall outside their area of expertise.
    • Is proactive in identifying issues and making recommendations to resolve them.
    • Within the scope of the work environment, takes action to improve processes or results, or to resolve problems.
    • Not deterred by obstacles.
    • Tackles challenges that require risk taking.
    • Procures the necessary resources, team and technical support to enable success.
    • Assists others to get the job done.
    • Demonstrates awareness of an opportunities or issues which are in the future or outside the immediate work area.
    • Typically exceeds the expectations of the job.
    • Learns new technology or skills outside their specialization so that they can be a more effective team member.
    • Recommends solutions to enhance results or prevent potential issues.
    • Drives implementation of new processes within the team to improve results.
    • Able to provide recommendations on plans and decisions that are strategic and future-oriented for the organization.
    • Identifies areas of high risk or of organizational level impact.
    • Able to empower significant recourses from the organization to enable success.
    • Leads long-term engagements that result in improved organizational capabilities and processes.

    Process discipline

    A common misconception is that Agile means no process and no discipline. Effective Agile teams require more adherence to the right processes to create a culture of self-improvement.

    • Refers to the focus of following the right steps for a given activity at the right time to achieve the right outcomes.
    • Focus on following the right steps for a given activity at the right time to achieve desired outcomes.
    Example: Scrum Ceremonies during a sprint (1 - 4 weeks/sprint). 1: Sprint planning, 2: Daily scrum, 3: Sprint review, 4: Sprint retrospective.

    Process discipline

    Your Score: ____

    1 - Foundational: Transitioning and Growing

    2 - Capable/Competent: Core Contributor

    3 - Influential: Gifted Improver

    4 - Transformational: Towering Strength

    • Demonstrates awareness of the key processes and steps that are needed in a given situation.
    • Limited consistency in following processes and limited understanding of the 'why' behind the processes.
    • Aware and follows through with key agile processes in a consistent manner.
    • Demonstrates not only the knowledge of processes but understands the 'why' behind their existence.
    • Aware and follows through with key agile processes in a consistent manner.
    • Demonstrates understanding of not only why specific processes exist but can suggest changes to improve efficiency, consistency, and outcomes.

    N/A -- Maximum level is '3

    Resilience

    If your team hits the wall, don’t let the wall hit them back.

    • Resilience is critical for an effective Agile transformation. A team that demonstrates resilience always exhibits:
    • Evolution over transformation – There is a recognition that changes happen over time.
    • Intensity and productivity – A race is not won by the ones who are the fastest, but by the ones who are the most consistent. Regardless of what comes up, the team can push through.
    • That organizational resistance is futile – Given that it is working on the right objectives, the team needs to demonstrate a consistency of approach and intensity regardless of what may stand in its way.
    • Refers to the behaviors, thoughts, and actions that allow a person to recover from stress and adversity.

    How resilience aligns with Agile

    A team is not “living the principles” without resilience.

    1. Purpose

      Aligns with: “Our highest priority is to satisfy the customer through early and continuous delivery of valuable software.” The vision or goals may not be clear in certain circumstances and can be difficult to relate to a single work item. Being able to intrinsically source and harness a sense of purpose becomes more important, especially as a self-organizing team.
    2. Perseverance

      Aligns with: “Agile processes harness change for the customer's competitive advantage.” Perseverance enables teams to continuously deliver at a steady pace, addressing impediments or setbacks and continuing to move forward.
    3. Composure

      Aligns with: “Agile processes promote sustainable development,” and “At regular intervals, the team reflects ... and adjusts its behavior accordingly.”
      When difficult situations arise, composure allows us to understand perspectives, empathize with customers, accept late changes, and sustain a steady pace.
    4. Self-Reliance

      Aligns with: “The best architectures, requirements, and designs emerge from self-organizing teams.” Knowing oneself, recognizing strengths, and drawing on past successes, can be a powerful aid in creating high-performing Agile teams
    5. Authenticity

      Aligns with: “At regular intervals, the team reflects … and adjusts its behavior accordingly,” and “Build projects around motivated individuals.”
      When difficult situations arise, authenticity is crucial. “For example, being able to openly disclose areas outside of your strengths in sprint planning or being able to contribute constructively toward self-organization.”

    Adapted from: Why Innovation, 2019.

    Resilience

    Your Score: ____

    1 - Foundational: Transitioning and Growing

    2 - Capable/Competent: Core Contributor

    3 - Influential: Gifted Improver

    4 - Transformational: Towering Strength

    • Easily distracted and stopped by moderately stressful and challenging situations.
    • Requires significant help from others to get back on track.
    • Not frequently able (or knows) how to ask for help
    • Handles typical stresses and challenges for the given role.
    • Able to get back on track with limited assistance.
    • Able to ask for help when they need it.
    • Quality of work unaffected by an increase in pressures and challenges.
    • Handles stresses and challenges what is deemed above and beyond their given role.
    • Able to provide advice to others on how to handle difficult and challenging situations.
    • Quality of work and outcomes is maintained and sometimes exceeded as pressure increases.
    • Team looks to this individual as being the gold standard on how to approach any given problem or situation.
    • Directly mentors others on approaches in situations regardless of the level of challenge.

    Exercise 1.2.1 Identify your primary product owner perspective

    1 hour
    1. Review each real Agile skill and determine your current proficiency.
    2. Complete your assessment in the Mature and Scale Product Owner Proficiency Assessment tool.
    3. Record the results in the Mature and Scale Product Ownership Playbook.
    4. Review the skills map to identify strengths and areas of growth.

    Accountability, Collaboration, Comfort in Ambiguity, Communication, Empathy, Facilitation, Functional Decomposition, Initiative, Process Discipline, Resilience.

    Output

    • Agile skills assessment results.

    Participants

    • Product owners
    • Product managers

    Capture in the Mature and Scale Product Owner Proficiency Assessment.

    Determine your Agile skills proficiency: Edit chart data to plot your scores or add your data points and connect the lines.

    Step 3.2

    Mature product owner capabilities

    Activities

    3.2.1 Assess your vision capability proficiency

    3.2.2 Assess your leadership capability proficiency

    3.2.3 Assess your PLM capability proficiency

    3.2.4 Identify your business value drivers and sources of value

    3.2.5 Assess your value realization capability proficiency

    Mature product owner capabilities

    This step involves the following participants:

    • Product owners
    • Product managers

    Outcomes of this step

    • Info-Tech product owner capability model proficiency assessment

    Product capabilities deliver value

    As a product owner, you are responsible for managing these facets through your capabilities and activities.

    The core product and value stream consists of: Funding - Product management and governance, Business functionality - Stakeholder and relationship management, and Technology - Product delivery.

    Info-Tech Best Practice

    It is easy to lose sight of what matters when we look at a product from a single point of view . Despite what "The Agile Manifesto" says, working software is not valuable without the knowledge and support that people need in order to adopt, use, and maintain it. If you build it, they will not come. Product owners must consider the needs of all stakeholders when designing and building products.

    Recognize product owner knowledge gaps

    Pulse survey of product owners

    Pulse survey of product owners. Graph shows large percentage of respondents have alignment to common agile definition of product owners. Yet a significant perception gap in P&L, delivery, and analytics.

    Info-Tech Insight

    1. Less than 15% of respondents identified analytics or financial management as a key component of product ownership.
    2. Assess your product owner’s capabilities and understanding to develop a maturity plan.

    Source: Pulse Survey (N=18)

    Implement the Info-Tech product owner capability model

    Unfortunately, most product owners operate with incomplete knowledge of the skills and capabilities needed to perform the role. Common gaps include focusing only on product backlogs, acting as a proxy for product decisions, and ignoring the need for key performance indicators (KPIs) and analytics in both planning and value realization.

    Product Owner capabilities: Vision, Product Lifecycle Management, Leadership, Value Realization

    Vision

    • Market Analysis
    • Business Alignment
    • Product Roadmap

    Leadership

    • Soft Skills
    • Collaboration
    • Decision Making

    Product Lifecycle Management

    • Plan
    • Build
    • Run

    Value Realization

    • KPIs
    • Financial Management
    • Business Model

    Product owner capabilities provide support

    Vision predicts impact of Value realization. Value realization provides input to vision

    Your vision informs and aligns what goals and capabilities are needed to fulfill your product or product family vision and align with enterprise goals and priorities. Each item on your roadmap should have corresponding KPIs or OKRs to know how far you moved the value needle. Value realization measures how well you met your target, as well as the impacts on your business value canvas and cost model.

    Product lifecycle management builds trust with Leadership. Leadership improves quality of Product lifecycle management.

    Your leadership skills improve collaborations and decisions when working with your stakeholders and product delivery teams. This builds trust and improves continued improvements to the entire product lifecycle. A product owner’s focus should always be on finding ways to improve value delivery.

    Product owner capabilities provide support

    Leadership enhances Vision. Vision Guides Product Lifecycle Management. Product Lifecycle Management delivers Value Realization. Leadership enhances Value Realization

    Develop product owner capabilities

    Each capability: Vision, Product lifecycle management, Value realization and Leadership has 3 components needed for successful product ownership.

    Avoid common capability gaps

    Vision

    • Focusing solely on backlog grooming (tactical only)
    • Ignoring or failing to align product roadmap to enterprise goals
    • Operational support and execution
    • Basing decisions on opinion rather than market data
    • Ignoring or missing internal and external threats to your product

    Leadership

    • Failing to include feedback from all teams who interact with your product
    • Using a command-and-control approach
    • Viewing product owner as only a delivery role
    • Acting as a proxy for stakeholder decisions
    • Avoiding tough strategic decisions in favor of easier tactical choices

    Product lifecycle management

    • Focusing on delivery and not the full product lifecycle
    • Ignoring support, operations, and technical debt
    • Failing to build knowledge management into the lifecycle
    • Underestimating delivery capacity, capabilities, or commitment
    • Assuming delivery stops at implementation

    Value realization

    • Focusing exclusively on “on time/on budget” metrics
    • Failing to measure a 360-degree end-user view of the product
    • Skipping business plans and financial models
    • Limiting financial management to project/change budgets
    • Ignoring market analysis for growth, penetration, and threats

    Capabilities: Vision

    Market Analysis

    • Customer Empathy: Identify the target users and unique value your product provides that is not currently being met. Define the size of your user base, segmentation, and potential growth.
    • Customer Journey: Define the future path and capabilities your users will respond to.
    • Competitive analysis: Complete a SWOT analysis for your end-to-end product lifecycle. Use Info-Tech’s Business SWOT Analysis Template.

    Business Alignment

    • Enterprise alignment: Align to enterprise and product family goals, strategies, and constraints.
    • Delivery and release strategy: Develop a delivery strategy to achieve value quickly and adapt to internal and external changes. Value delivery is constrained by your delivery pipeline.
    • OCM and go-to-market strategy: Create organizational change management, communications, and a user implementation approach to improve adoption and satisfaction from changes.

    Product Roadmap

    • Roadmap strategy: Determine the duration, detail, and structure of your roadmap to accurately communicate your vision.
    • Value prioritization: Define criteria used to evaluate and sequence demand items.
    • Release and capacity planning: Build your roadmap with realistic goals and milestones based on your delivery pipeline and dependencies.

    “Customers are best heard through many ears.”

    – Thomas K. Connellan, Inside the Magic Kingdom

    Vision: Market Analysis, Business Alignment, and Product Roadmap.

    Info-Tech Insight

    Data comes from many places and may still not tell the complete story.

    Build your product strategy playbook

    Complete Deliver on Your Digital Product Vision to define your Vision, Goals, Roadmap approach, and Backlog quality filters.

    Digital Product Strategy Supporting Workbook

    Supporting workbook that captures the interim results from a number of exercises that will contribute to your overall digital product vision.

    Product Backlog Item Prioritization Tool

    An optional tool to help you capture your product backlog and prioritize based on your given criteria

    Product Roadmap Tool

    An optional tool to help you build out and visualize your first roadmap.

    Your Digital Product Vision Details Strategy

    Record the results from the exercises to help you define, detail, and make real your digital product vision.

    Your product vision is your North Star

    It's ok to dream a little!

    Who is the target customer, what is the key benefit, what do they need, what is the differentiator

    Adapted from: Geoffrey Moore, 2014.

    Info-Tech Best Practice

    A product vision shouldn’t be so far out that it doesn’t feel real or so short-term that it gets bogged down in minutiae and implementation details. Finding the right balance will take some trial and error and will be different for each organization.

    Use product roadmaps to guide delivery

    In Deliver on Your Digital Product Vision, we showed how the product roadmap is key to value realization. As a product owner, the product roadmap is your communicated path to align teams and changes to your defined goals, while aligning your product to enterprise goals and strategy.

    As a product owner, the product roadmap is your communicated path to align teams and changes to your defined goals, while aligning your product to enterprise goals and strategy

    Info-Tech Best Practice

    Info-Tech Best Practice Product delivery requires a comprehensive set of business and technical competencies to effectively roadmap, plan, deliver, support, and validate your product portfolio. Product delivery is a “multi-faceted, complex discipline that can be difficult to grasp and hard to master.” It will take time to learn and adopt methods and become a competent product manager or owner (“What Is Product Management?”, Pichler Consulting Limited).

    Match your roadmap and backlog to the needs of the product

    Ultimately, you want products to be able to respond faster to changes and deliver value sooner. The level of detail in the roadmap and backlog is a tool to help the product owner plan for change. The duration of your product roadmap is all directly related to the tier of product owner in the product family.

    The level of detail in the roadmap and backlog is a tool to help the product owner plan for change. The duration of your product roadmap is all directly related to the tier of product owner in the product family.

    Product delivery realizes value for your product family

    While planning and analysis are done at the family level, work and delivery are done at the individual product level.

    Product strategy includes: Vision, Goals, Roadmap, backlog and Release plan.

    Use artifact mapping to improve functional decomposition

    In our research, we refer to these items as epics, capabilities, features, and user stories. How you develop your guiding principles and structure your backlog should be based on the terminology and artifact types commonly used in your organization.

    Agile, Waterfall, Relationship, Decomposition skill most in demand, definition.

    Manage and communicate key milestones

    Successful product owners understand and define the key milestones in their product delivery lifecycles. These need to be managed along with the product backlog and roadmap.

    Define key milestones and their release dates.

    Info-Tech Best Practice

    Product ownership isn’t just about managing the product backlog and development cycles! Teams need to manage key milestones such as learning milestones, test releases, product releases, phase gates, and other organizational checkpoints!

    Milestones

    • Points in the timeline when the established set of artifacts is complete (feature-based), or checking status at a particular point in time (time-based).
    • Typically assigned a date and used to show the progress of development.
    • Plays an important role when sequencing different types of artifacts.

    Release dates

    • Releases mark the actual delivery of a set of artifacts packaged together in a new version of the product.
    • Release dates, firm or not, allow stakeholders to anticipate when this is coming.

    Leverage the product canvas to state and inform your product vision

    Leverage the product Canvas to state and inform your product vision. Includes: Product name, Tracking info, Vision, List of business objectives or goals, Metrics used to measure value realization, List of groups who consume the product/service, and List of key resources or stakeholders.

    Capability: Vision

    Your Score: ____

    1 - Foundational: Transitioning and Growing

    2 - Capable/Competent: Core Contributor

    3 - Influential: Gifted Improver

    4 - Transformational: Towering Strength

    • Product backlog.
    • Basic roadmap with milestones and releases.
    • Unprioritized stakeholder list.
    • Understanding of product’s purpose and value.
    • Customers and end-users defined with core needs identified.
    • Roadmap with goals and capabilities defined by themes and set to appropriate time horizons.
    • Documented stakeholder management plan with communication and collaboration aligned to the stakeholder strategy.
    • Value drivers traced to product families and enterprise goals.
    • Customer personas defined with pain relievers and value creators defined.
    • Fully-developed roadmap traced to family (and child) roadmaps.
    • Expected ROI for all current and next roadmap items.
    • KPIs/OKRs used to improve roadmap prioritization and sequencing.
    • Proactive stakeholder engagement and reviews.
    • Cross-functional engagement to align opportunities and drive enterprise value.
    • Formal metrics to assess customer needs and value realization.
    • Roadmaps managed in an enterprise system for full traceability, value realization reporting, and views for defined audiences.
    • Proactive stakeholder engagement with regular planning and review ceremonies tied to their roadmaps and goals.
    • Cross-functional innovation to find disruptive opportunities to drive enterprise value.
    • Omni-channel metrics and customer feedback mechanisms to proactively evaluate goals, capabilities, and value realization.

    Exercise 3.2.1 Assess your Vision capability proficiency

    1 hour
    1. Review the expectations for this capability and determine your current proficiency for each skill.
    2. Complete your assessment in the Mature and Scale Product Owner Proficiency Assessment tool.
    3. Record the results in the Mature and Scale Product Ownership Playbook.
    4. Review the skills map to identify strengths and areas of growth.

    Output

    • Product owner capability assessment

    Participants

    • Product owners
    • Product managers

    Capture in the Mature and Scale Product Owner Proficiency Assessment.

    Capabilities: Leadership

    Soft Skills

    • Communication: Maintain consistent, concise, and appropriate communication using SMART guidelines (specific, measurable, attainable, relevant, and timely).
    • Integrity: Stick to your values, principles, and decision criteria for the product to build and maintain trust with your users and teams.
    • Influence: Manage stakeholders using influence and collaboration over contract negotiation.

    Collaboration

    • Stakeholder management: Build a communications strategy for each stakeholder group, tailored to individual stakeholders.
    • Relationship management: Use every interaction point to strengthen relationships, build trust, and empower teams.
    • Team development: Promote development through stretch goals and controlled risks to build team capabilities and performance.

    Decision Making

    • Prioritized criteria: Remove personal bias by basing decisions off data analysis and criteria.
    • Continuous improvement: Balance new features with the need to ensure quality and create an environment of continuous improvement.
    • Team empowerment/negotiation: Push decisions to teams closest to the problem and solution, using Delegation Poker to guide you.

    “Everything walks the walk. Everything talks the talk.”

    – Thomas K. Connellan, Inside the Magic Kingdom

    Leadership: Soft skills, collaboration, decision making.

    Info-Tech Insight

    Product owners cannot be just a proxy for stakeholder decisions. The product owner owns product decisions and management of all stakeholders.

    Capability: Leadership

    Your Score: ____

    1 - Foundational: Transitioning and Growing

    2 - Capable/Competent: Core Contributor

    3 - Influential: Gifted Improver

    4 - Transformational: Towering Strength

    • Activities are prioritized with minimal direction and/or assistance.
    • Progress self-monitoring against objectives with leadership apprised of deviations against plan.
    • Facilitated decisions from stakeholders or teams.
    • Informal feedback on performance and collaboration with teams.
    • Independently prioritized activities and provide direction or assistance to others as needed.
    • Managed issue resolution and provided guidance on goals, priorities, and constraints.
    • Product decision ownership with input from stakeholders, SMEs, and delivery teams.
    • Formal product management retrospectives with tracked and measured changes to improve performance.
    • Consulted in the most challenging situations to provide subject matter expertise on leading practices and industry standards.
    • Provide mentoring and coaching to your peers and/or teammates.
    • Use team empowerment, pushing decisions to the lowest appropriate level based on risk and complexity.
    • Mature and flexible communication.
    • Provide strategies and programs ensuring all individuals in the delivery organization obtain the level of coaching and supervision required for success in their position.
    • Provide leadership to the organization’s coaches ensuring delivery excellence across the organization.
    • Help develop strategic initiatives driving common approaches and utilizing information assets and processes across the enterprise.

    Exercise 3.2.2 Assess your Leadership capability proficiency

    1 hour
    1. Review the expectations for this capability and determine your current proficiency for each skill.
    2. Complete your assessment in the Mature and Scale Product Owner Proficiency Assessment tool.
    3. Record the results in the Mature and Scale Product Ownership Playbook.
    4. Review the skills map to identify strengths and areas of growth.

    Output

    • Product owner capability assessment

    Participants

    • Product owners
    • Product managers

    Capture in the Mature and Scale Product Owner Proficiency Assessment.

    Capability: Product lifecycle management

    Plan

    • Product backlog: Follow a schedule for backlog intake, grooming, updates, and prioritization.
    • Journey map: Create an end-user journey map to guide adoption and loyalty.
    • Fit for purpose: Define expected value and intended use to ensure product meets your end user’s needs.

    Build

    • Capacity management: Work with operations and delivery teams to ensure consistent and stable outcomes.
    • Release strategy: Build learning, release, and critical milestones into a repeatable release plan.
    • Compliance: Build policy compliance into delivery practices to ensure alignment and reduce avoidable risk (privacy, security).

    Run

    • Adoption: Focus attention on end-user adoption and proficiency to accelerate value and maximize retention.
    • Support: Build operational support and business continuity into every team.
    • Measure: Measure KPIs and validate expected value to ensure product alignment to goals and consistent product quality.

    “Pay fantastic attention to detail. Reward, recognize, celebrate.”

    – Thomas K. Connellan, Inside the Magic Kingdom

    Product Lifecycle Management: Plan, Build, Run

    Info-Tech Insight

    Product owners must actively manage the full lifecycle of the product.

    Define product value by aligning backlog delivery with roadmap goals

    In each product plan, the backlogs show what you will deliver. Roadmaps identify when and in what order you will deliver value, capabilities, and goals.

    In each product plan, the backlogs show what you will deliver. Roadmaps identify when and in what order you will deliver value, capabilities, and goals.

    A backlog stores and organizes PBIs at various stages of readiness

    A backlog stores and organizes PBIs at different levels of readiness. Stage 3 - Ideas are composed of raw, vague ideas that have yet to go through any formal valuation. Stage 2 - Qualified are researched and qualified PBIs awaiting refinement. Stage 1 - Ready are Discrete, refined RBIs that are read to be placed in your development team's sprint plans.

    A well-formed backlog can be thought of as a DEEP backlog:

    Detailed Appropriately: PBIs are broken down and refined, as necessary.

    Emergent: The backlog grows and evolves over time as PBIs are added and removed.

    Estimated: The effort a PBI requires is estimated at each tier.

    Prioritized: The PBI’s value and priority are determined at each tier.

    (Perforce, 2018)

    Distinguish your specific goals for refining in the product backlog vs. planning for a sprint itself

    Often backlog refinement is used interchangeably or considered a part of sprint planning. The reality is they are very similar, as the required participants and objectives are the same; however, there are some key differences.

    Backlog refinement versus Sprint planning. Differences in Objectives, Cadence and Participants

    Use quality filters to promote high value items into the delivery pipeline

    Product backlog has quality filters such as: Backlogged, Qualified and Ready. Sprint backlog has a backlog of accepted PBI's

    Basic scrum process

    The scrum process coordinates multiple stakeholders to deliver on business priorities.

    Prioritized Backlog, Sprint Backlog, Manage Delivery, Sprint Review, Product Release

    Capability: Product lifecycle management

    Your Score: ____

    1 - Foundational: Transitioning and Growing

    2 - Capable/Competent: Core Contributor

    3 - Influential: Gifted Improver

    4 - Transformational: Towering Strength

    • Informal or undocumented intake process.
    • Informal or undocumented delivery lifecycle.
    • Unstable or unpredictable throughput or quality.
    • Informal or undocumented testing and release processes.
    • Informal or undocumented organizational change management planning for each release.
    • Informal or undocumented compliance validation with every release.
    • Documented intake process with stakeholder prioritization of requests.
    • Consistent delivery lifecycle with stable and predictable throughput with an expected range of delivery variance.
    • Formal and documented testing and release processes.
    • Organizational change management planning for each major release.
    • Compliance validation with every major release.
    • Intake process using value drivers and prioritization criteria to sequence all items.
    • Consistent delivery lifecycle with stable and predictable throughput with little variance.
    • Risk-based and partially automated testing and release processes.
    • Organizational change management planning for all releases.
    • Automated compliance validation with every major release.
    • Intake process using enterprise value drivers and prioritization criteria to sequence all items.
    • Stable Agile DevOps with low variability and automation.
    • Risk-based automated and manual testing.
    • Multiple release channels based on risk. Automated build, validation, and rollback capabilities.
    • Cross-channel, integrated organizational change management for all releases.
    • Automated compliance validation with every change or release.

    Exercise 3.2.3 Assess your PLM capability proficiency

    1 hour
    1. Review the expectations for this capability and determine your current proficiency for each skill.
    2. Complete your assessment in the Mature and Scale Product Owner Proficiency Assessment tool.
    3. Record the results in the Mature and Scale Product Ownership Playbook.
    4. Review the skills map to identify strengths and areas of growth.

    Output

    • Product owner capability assessment

    Participants

    • Product owners
    • Product managers

    Capture in the Mature and Scale Product Owner Proficiency Assessment.

    Capabilities: Value realization

    Key performance indicators (KPIs)

    • Usability and user satisfaction: Assess satisfaction through usage monitoring and end-user feedback.
    • Value validation: Directly measure performance against defined value proposition, goals, and predicted ROI.
    • Fit for purpose: Verify the product addresses the intended purpose better than other options.

    Financial management

    • P&L: Manage each product as if it were its own business with profit and loss statements.
    • Acquisition cost/market growth: Define the cost of acquiring a new consumer, onboarding internal users, and increasing product usage.
    • User retention/market share: Verify product usage continues after adoption and solution reaches new user groups to increase value.

    Business model

    • Defines value proposition: Dedicate your primary focus to understanding and defining the value your product will deliver.
    • Market strategy and goals: Define your acquisition, adoption, and retention plan for users.
    • Financial model: Build an end-to-end financial model and plan for the product and all related operational support.

    “The competition is anyone the customer compares you with.”

    – Thomas K. Connellan, Inside the Magic Kingdom

    Value Realization: KPIs, Financial management, Business model

    Info-Tech Insight

    Most organizations stop with on-time and on-budget. True financial alignment needs to define and manage the full lifecycle P&L.

    Use a balanced value to establish a common definition of goals and value

    Value drivers are strategic priorities aligned to our enterprise strategy and translated through our product families. Each product and change has an impact on the value driver helping us reach our enterprise goals.

    Importance of the value driver multiplied by the Impact of value score is equal to the Value score.

    Info-Tech Insight

    Your value drivers and impact helps estimate the expected value of roadmap items, prioritize roadmap and backlog items, and identify KPIs and OKRs to measure value realization and actual impact.

    Include balanced value as one criteria to guide better decisions

    Your balanced value is just one of many criteria needed to align your product goals and sequence roadmap items. Feasibility, delivery pipeline capacity, shared services, and other factors may impact the prioritization of backlog items.

    Build your balanced business value score by using four key value drivers.

    Determine your value drivers

    Competent organizations know that value cannot always be represented by revenue or reduced expenses. However, it is not always apparent how to envision the full spectrum of sources of value. Dissecting value by benefit type and the value source’s orientation allows you to see the many ways in which a product or service brings value to the organization.

    Business value matrix

    Graph with 4 quadrants representing Outward versus Inward, and Financial benefit versus Human benefit. The quadrants are Reach customers, Increase revenue/demonstrate value, Enhance services, Reduce costs.

    Financial benefits vs. improved capabilities

    Financial benefits refer to the degree to which the value source can be measured through monetary metrics and is often quite tangible.

    Human benefits refer to how a product or service can deliver value through a user’s experience.

    Inward vs. outward orientation

    Inward refers to value sources that have an internal impact and improve your organization’s effectiveness and efficiency in performing its operations.

    Outward refers to value sources that come from your interaction with external factors, such as the market or your customers.

    Exercise 3.2.4 Identify your business value drivers and sources of value

    1 hour
    1. Brainstorm the different types of business value that you produce on the sticky notes (one item per page). Draw from examples of products in your portfolio.
    2. Identify the most important value items for your organization (two to three per quadrant).
    3. Record the results in the Mature and Scale Product Ownership Workbook.

    Output

    • Product owner capability assessment

    Participants

    • Product owners
    • Product managers

    Capture in the Mature and Scale Product Ownership Workbook.

    My business value sources

    Graph with 4 quadrants representing Outward versus Inward, and Financial benefit versus Human benefit. The quadrants are Reach customers, Increase revenue/demonstrate value, Enhance services, Reduce costs.

    Capability: Value realization

    Your Score: ____

    1 - Foundational: Transitioning and Growing

    2 - Capable/Competent: Core Contributor

    3 - Influential: Gifted Improver

    4 - Transformational: Towering Strength

    • Product canvas or basic product positioning overview.
    • Simple budget or funding mechanism for changes.
    • Product demos and informal user feedback mechanisms.
    • Business value canvas or basic business model tied to roadmap funding.
    • Product funding tied to roadmap milestones and prioritization.
    • Defined KPIs /OKRs for roadmap delivery throughput and value realization measurement.
    • Business model with operating cost structures, revenue/value traceability, and market/user segments.
    • Scenario-based roadmap funding alignment.
    • Roadmap aligned KPIs /OKRs for delivery throughput and value realization measurement as a key factor in roadmap prioritization.
    • Business model tied to enterprise operating costs and value realization KPIs/OKRs.
    • P&L roadmap and cost accounting tied to value metrics.
    • Roadmap aligned enterprise and scenario-based KPIs /OKRs for delivery throughput and value realization measurement as a key factor in roadmap prioritization.

    Exercise 3.2.5 Assess your value realization capability proficiency

    1 hour
    1. Review the expectations for this capability and determine your current proficiency for each skill.
    2. Complete your assessment in the Mature and Scale Product Owner Proficiency Assessment tool.
    3. Record the results in the Mature and Scale Product Ownership Playbook.
    4. Review the skills map to identify strengths and areas of growth.

    Output

    • Product owner capability assessment

    Participants

    • Product owners
    • Product managers

    Capture in the Mature and Scale Product Owner Proficiency Assessment.

    Determine your product owner capability proficiency in regards to: Vision, Leadership, Product Lifecycle, and Value Realization

    Summary of Accomplishment

    Problem solved.

    Product ownership can be one of the most difficult challenges facing delivery and operations teams. By focusing on operational grouping and alignment of goals, organizations can improve their value realization at all levels in the organization.

    The foundation for delivering and enhancing products and services is rooted in the same capability model. Traditionally, product owners have focused on only a subset of skills and capabilities needed to properly manage and grow their products. The product owner capability model is a useful tool to ensure optimal performance from product owners and assess the right level of detail for each product within the product families.

    Congratulations. You’ve completed a significant step toward higher-value products and services.

    If you would like additional support, have our analysts guide you through other phases as apart of an Info-Tech workshop

    Contact your account representative for more information

    workshops@infotech.com
    1-888-670-8889

    Additional Support

    If you would like additional support, have our analysts guide you through other phases as apart of an Info-Tech workshop

    Contact your account representative for more information
    workshops@infotech.com 1-888-670-8889

    The following are sample activities that will be conducted by Info-Tech analysts with your team:

    3.1.1 Assess your real Agile skill proficiency

    Assess your skills and capabilities against the real Agile skills inventory

    2.2.3 Prioritize your stakeholders

    Build a stakeholder management strategy.

    Research Contributors and Experts

    Emily Archer

    Lead Business Analyst,
    Enterprise Consulting, authentic digital agency

    Emily Archer is a consultant currently working with Fortune 500 clients to ensure the delivery of successful projects, products, and processes. She helps increase the business value returned for organizations’ investments in designing and implementing enterprise content hubs and content operations, custom web applications, digital marketing, and e-commerce platforms.

    David Berg

    Founder & CTO
    Strainprint Technologies Inc.

    David Berg is a product commercialization expert who has spent the last 20 years delivering product management and business development services across a broad range of industries. Early in his career, David worked with product management and engineering teams to build core network infrastructure products that secure and power the internet we benefit from today. David’s experience also includes working with clean technologies in the area of clean power generation, agritech, and Internet of Things infrastructure. Over the last five years, David has been focused on his latest venture, Strainprint Technologies, a data and analytics company focused on the medical cannabis industry. Strainprint has built the largest longitudinal medical cannabis dataset in the world, with a goal to develop an understanding of treatment behavior, interactions, and chemical drivers to guide future product development.

    Research Contributors and Experts

    Kathy Borneman

    Digital Product Owner, SunTrust Bank

    Kathy Borneman is a senior product owner who helps people enjoy their jobs again by engaging others in end-to-end decision making to deliver software and operational solutions that enhance the client experience and allow people to think and act strategically.

    Charlie Campbell

    Product Owner, Merchant e-Solutions

    Charlie Campbell is an experienced problem solver with the ability to quickly dissect situations and recommend immediate actions to achieve resolution, liaise between technical and functional personnel to bridge the technology and communication gap, and work with diverse teams and resources to reach a common goal.

    Research Contributors and Experts

    Yarrow Diamond

    Sr. Director, Business Architecture
    Financial Services

    Yarrow Diamond is an experienced professional with expertise in enterprise strategy development, project portfolio management, and business process reengineering across financial services, healthcare and insurance, hospitality, and real estate environments. She has a master’s in Enterprise Architecture from Penn State University, LSSMBB, PMP, CSM, ITILv3.

    Cari J. Faanes-Blakey, CBAP, PMI-PBA

    Enterprise Business Systems Analyst,
    Vertex, Inc.

    Cari J. Faanes-Blakey has a history in software development and implementation as a Business Analyst and Project Manager for financial and taxation software vendors. Active in the International Institute of Business Analysis (IIBA), Cari participated on the writing team for the BA Body of Knowledge 3.0 and the certification exam.

    Research Contributors and Experts

    Kieran Gobey

    Senior Consultant Professional Services
    Blueprint Software Systems

    Kieran Gobey is an IT professional with 24 years of experience, focused on business, technology, and systems analysis. He has split his career between external and internal customer-facing roles, and this has resulted in a true understanding of what is required to be a Professional Services Consultant. His problem-solving skills and ability to mentor others have resulted in successful software implementations.

    Kieran’s specialties include deep system troubleshooting and analysis skills, facilitating communications to bring together participants effectively, mentoring, leadership, and organizational skills.

    Rupert Kainzbauer

    VP Product, Digital Wallets
    Paysafe Group

    Rupert Kainzbauer is an experienced senior leader with a passion for defining and delivering products that deliver real customer and commercial benefit. With a team of highly experienced and motivated product managers, he has successfully led highly complex, multi-stakeholder payments initiatives, from proposition development and solution design through to market delivery. Their domain experience is in building online payment products in high-risk and emerging markets, remittance, prepaid cards, and mobile applications.

    Research Contributors and Experts

    Saeed Khan

    Founder,
    Transformation Labs

    Saeed Khan has been working in high tech for 30 years in Canada and the US and has held several leadership roles in Product Management in that time. He speaks regularly at conferences and has been writing publicly about technology product management since 2005.

    Through Transformation Labs, Saeed helps companies accelerate product success by working with product teams to improve their skills, practices, and processes. He is a cofounder of ProductCamp Toronto and currently runs a Meetup group and global Slack community called Product Leaders; the only global community of senior level product executives.

    Hoi Kun Lo

    Product Owner
    Nielsen

    Hoi Kun Lo is an experienced change agent who can be found actively participating within the IIBA and WITI groups in Tampa, FL and a champion for Agile, architecture, diversity, and inclusion programs at Nielsen. She is currently a Product Owner in the Digital Strategy team within Nielsen Global Watch Technology.

    Research Contributors and Experts

    Abhishek Mathur

    Sr Director, Product Management
    Kasisto, Inc.

    Abhishek Mathur is a product management leader, an artificial intelligence practitioner, and an educator. He has led product management and engineering teams at Clarifai, IBM, and Kasisto to build a variety of artificial intelligence applications within the space of computer vision, natural language processing, and recommendation systems. Abhishek enjoys having deep conversations about the future of technology and helping aspiring product managers enter and accelerate their careers.

    Jeff Meister

    Technology Advisor and Product Leader

    Jeff Meister is a technology advisor and product leader. He has more than 20 years of experience building and operating software products and the teams that build them. He has built products across a wide range of industries and has built and led large engineering, design, and product organizations.

    Jeff most recently served as Senior Director of Product Management at Avanade, where he built and led the product management practice. This involved hiring and leading product managers, defining product management processes, solution shaping and engagement execution, and evangelizing the discipline through pitches, presentations, and speaking engagements.

    Jeff holds a Bachelor of Applied Science (Electrical Engineering) and a Bachelor of Arts from the University of Waterloo, an MBA from INSEAD (Strategy), and certifications in product management, project management, and design thinking.

    Research Contributors and Experts

    Vincent Mirabelli

    Principal,
    Global Project Synergy Group

    With over 10 years of experience in both the private and public sectors, Vincent Mirabelli possesses an impressive track record of improving, informing, and transforming business strategy and operations through process improvement, design and re-engineering, and the application of quality to business analysis, project management, and process improvement standards.

    Oz Nazili

    VP, Product & Growth
    TWG

    Oz Nazili is a product leader with a decade of experience in both building products and product teams. Having spent time at funded startups and large enterprises, he thinks often about the most effective way to deliver value to users. His core areas of interest include Lean MVP development and data-driven product growth.

    Research Contributors and Experts

    Mike Starkey

    Director of Engineering
    W.W. Grainger

    Mike Starkey is a Director of Engineering at W.W. Grainger, currently focusing on operating model development, digital architecture, and building enterprise software. Prior to joining W.W. Grainger, Mike held a variety of technology consulting roles throughout the system delivery lifecycle spanning multiple industries such as healthcare, retail, manufacturing, and utilities with Fortune 500 companies.

    Anant Tailor

    Cofounder and Head of Product
    Dream Payments Corp.

    Anant Tailor is a cofounder at Dream Payments where he currently serves as the COO and Head of Product, having responsibility for Product Strategy & Development, Client Delivery, Compliance, and Operations. He has 20+ years of experience building and operating organizations that deliver software products and solutions for consumers and businesses of varying sizes.

    Prior to founding Dream Payments, Anant was the COO and Director of Client Services at DonRiver Inc, a technology strategy and software consultancy that he helped to build and scale into a global company with 100+ employees operating in seven countries.

    Anant is a Professional Engineer with a Bachelor degree in Electrical Engineering from McMaster University and a certificate in Product Strategy & Management from the Kellogg School of Management at Northwestern University.

    Research Contributors and Experts

    Angela Weller

    Scrum Master, Businessolver

    Angela Weller is an experienced Agile business analyst who collaborates with key stakeholders to attain their goals and contributes to the achievement of the company’s strategic objectives to ensure a competitive advantage. She excels when mediating or facilitating teams.

    Related Info-Tech Research

    Product Delivery

    Deliver on Your Digital Product Vision

    Build a product vision your organization can take from strategy through execution.

    Deliver Digital Products at Scale

    Deliver value at the scale of your organization through defining enterprise product families.

    Build Your Agile Acceleration Roadmap

    Quickly assess the state of your Agile readiness and plan your path forward to higher value realization.

    Implement Agile Practices That Work

    Improve collaboration and transparency with the business to minimize project failure.

    Implement DevOps Practices That Work

    Streamline business value delivery through the strategic adoption of DevOps practices.

    Extend Agile Practices Beyond IT

    Further the benefits of Agile by extending a scaled Agile framework to the business.

    Build Your BizDevOps Playbook

    Embrace a team sport culture built around continuous business-IT collaboration to deliver great products.

    Embed Security Into the DevOps Pipeline

    Shift security left to get into DevSecOps.

    Spread Best Practices With an Agile Center of Excellence

    Facilitate ongoing alignment between Agile teams and the business with a set of targeted service offerings.

    Enable Organization-Wide Collaboration by Scaling Agile

    Execute a disciplined approach to rolling out Agile methods in the organization.

    Related Info-Tech Research

    Application Portfolio Management

    APM Research Center

    See an overview of the APM journey and how we can support the pieces in this journey.

    Application Portfolio Management Foundations

    Ensure your application portfolio delivers the best possible return on investment.

    Streamline Application Maintenance

    Effective maintenance ensures the long-term value of your applications.

    Streamline Application Management

    Move beyond maintenance to ensuring exceptional value from your apps.

    Build an Application Department Strategy

    Delivering value starts with embracing what your department can do.

    Embrace Business-Managed Applications

    Empower the business to implement their own applications with a trusted business-IT relationship

    Optimize Applications Release Management

    Facilitate ongoing alignment between Agile teams and the business with a set of targeted service offerings.

    Related Info-Tech Research

    Value, Delivery Metrics, Estimation

    Build a Value Measurement Framework

    Focus product delivery on business value–driven outcomes.

    Select and Use SDLC Metrics Effectively

    Be careful what you ask for, because you will probably get it.

    Application Portfolio Assessment: End User Feedback

    Develop data-driven insights to help you decide which applications to retire, upgrade, re-train on, or maintain to meet the demands of the business.

    Create a Holistic IT Dashboard

    Mature your IT department by measuring what matters.

    Refine Your Estimation Practices With Top-Down Allocations

    Don’t let bad estimates ruin good work.

    Estimate Software Delivery With Confidence

    Commit to achievable software releases by grounding realistic expectations.

    Reduce Time to Consensus With an Accelerated Business Case

    Expand on the financial model to give your initiative momentum.

    Optimize Project Intake, Approval, and Prioritization

    Deliver more projects by giving yourself the voice to say “no” or “not yet” to new projects.

    Enhance PPM Dashboards and Reports

    Facilitate ongoing alignment between Agile teams and the business with a set of targeted service offerings.

    Related Info-Tech Research

    Organizational Design and Performance

    Redesign Your IT Organizational Structure

    Focus product delivery on business value-driven outcomes.

    Build a Strategic IT Workforce Plan

    Have the right people, in the right place, at the right time.

    Implement a New Organizational Structure

    Reorganizations are inherently disruptive. Implement your new structure with minimal pain for staff while maintaining IT performance throughout the change.

    Build an IT Employee Engagement Program

    Don’t just measure engagement, act on it

    Set Meaningful Employee Performance Measures

    Set holistic measures to inspire employee performance.

    Bibliography (Product Management)

    “12th Annual State of Agile Report.” VersionOne, 9 April 2018. Web.

    A, Karen. “20 Mental Models for Product Managers.” Product Management Insider, Medium, 2 Aug. 2018. Web.

    Adams, Paul. “Product Teams: How to Build & Structure Product Teams for Growth.” Inside Intercom, 30 Oct. 2019. Web.

    Aghina, Handscomb, Ludolph, West, and Abby Yip, “How to select and develop individuals for successful agile teams: A practical guide” McKinsey & Company 20 Dec. 2018. Web.

    Agile Alliance. “Product Owner.” Agile Alliance. n.d. Web.

    Ambler, Scott W. "Communication on Agile Software Teams“, Agile Modeling. 2001-2022. Web.

    Ambysoft. “2018 IT Project Success Rates Survey Results.” Ambysoft. 2018. Web.

    Banfield, Richard, et al. “On-Demand Webinar: Strategies for Scaling Your (Growing) Enterprise Product Team.” Pluralsight, 31 Jan. 2018. Web.

    Beck, Beedle, van Bennekum, Cockburn, Cunningham, Fowler, Grenning, Highsmith, Hunt, Jeffries, Kern, Marick, Martin, Mellor, Schwaber, Sutherland, Thomas, "Manifesto for Agile Software Development." agilemanifesto.org. 2001

    Berez, Steve, et al. “How to Plan and budget for Agile at Scale.” Bain & Company, 08 Oct 2019. Web

    Blueprint. “10 Ways Requirements Can Sabotage Your Projects Right From the Start.” Blueprint. 2012. Web.

    Breddels, Dajo, and Paul Kuijten. “Product Owner Value Game.” Agile2015 Conference, Agile Alliance 2015. Web.

    Cagan, Martin. “Behind Every Great Product.” Silicon Valley Product Group. 2005. Web.

    Cohn, Mike. “What Is a Product?” Mountain Goat Software. 6 Sept. 2016. Web.

    Connellan, Thomas K. Inside the Magic Kingdom, Bard Press, 1997.

    Curphey, Mark. “Product Definition.” SlideShare, 25 Feb. 2007. Web.

    “Delegation Poker Product Image.” Management 3.0, n.d. Web.

    Distel, Dominic, et al. “Finding the sweet spot in product-portfolio management.’ McKinsey, 4 Dec. 2020. Web

    Eringa, Ron. “Evolution of the Product Owner.” RonEringa.com, 12 June 2016. Web.

    Fernandes, Thaisa. “Spotify Squad Framework - Part I.” PM101, Medium, 6 Mar. 2017. Web.

    Galen, Robert. “Measuring Product Ownership – What Does ‘Good’ Look Like?” RGalen Consulting, 5 Aug. 2015. Web.

    Grenny, Joseph. “The Best Teams Hold Themselves Accountable.” Harvard Business Review, 30 May 2014. Web.

    Halisky, Merland, and Luke Lackrone. “The Product Owner’s Universe.” Agile2016 Conference, Agile Alliance, 2016. Web.

    Bibliography (Product Management)

    IIBA "A Guide to the Business Analysis Body of Knowledge® (BABOK® Guide) v3" IIBA. 15 APR 2015

    Kamer, Jurriaan. “How to Build Your Own ‘Spotify Model’.” The Ready, Medium, 9 Feb. 2018. Web.

    Kendis Team. “Exploring Key Elements of Spotify’s Agile Scaling Model.” Scaled Agile Framework, Medium, 23 Jul. 2018. Web.

    Lindstrom, Lowell. “7 Skills You Need to Be a Great Product Owner.” Scrum Alliance, n.d. Web.

    Lukassen, Chris. “The Five Belts Of The Product Owner.” Xebia.com, 20 Sept. 2016. Web.

    Mankins, Michael. “The Defining Elements of a Winning Culture.” Bain, 19 Dec. 2013. Web.

    McCloskey, Heather. “Scaling Product Management: Secrets to Defeating Common Challenges.” ProductPlan, 12 July 2019. Web.

    McCloskey, Heather. “When and How to Scale Your Product Team.” UserVoice, 21 Feb. 2017. Web. Mironov, Rich. “Scaling Up Product Manager/Owner Teams.” Rich Mironov's Product Bytes, Mironov Consulting, 12 Apr. 2014. Web.

    Moore, Geoffrey A. “Crossing the Chasm, 3rd Edition.” Collins Business Essentials, 28 Jan 2014

    Oh, Paul. “How Mastering Resilience Can Help Drive Agile Transformations.” Why Innovation!, 10 Oct. 2019.

    Overeem, Barry. “A Product Owner Self-Assessment.” Barry Overeem, 6 Mar. 2017. Web.

    Overeem, Barry. “Retrospective: Using the Team Radar.” Barry Overeem, 27 Feb. 2017. Web.

    Pichler, Roman. “How to Scale the Scrum Product Owner.” Roman Pichler, 28 June 2016 . Web.

    Pichler, Roman. “Product Management Framework.” Pichler Consulting Limited, 2014. Web.

    Pichler, Roman. “Sprint Planning Tips for Product Owners.” LinkedIn, 4 Sept. 2018. Web.

    Pichler, Roman. “What Is Product Management?” Pichler Consulting Limited, 26 Nov. 2014. Web.

    PMI "The high cost of low performance: the essential role of communications“. PMI Pulse of Profession, May 2013.

    Radigan,Dan. “Putting the ‘Flow' Back in Workflow With WIP Limits.” Atlassian, n.d. Web.

    Bibliography (Product Management)

    Rouse, Margaret. “Definition: product.” TechTarget, Sept. 2005. Web.

    Schuurman, Robbin. “10 Tips for Product Owners on (Business) Value.” Scrum.org, 30 Nov. 2017. Web.

    Schuurman, Robbin. “10 Tips for Product Owners on Agile Product Management.” Scrum.org, 28 Nov. 2017. Web.

    Schuurman, Robbin. “10 Tips for Product Owners on Product Backlog Management.” Scrum.org, 5 Dec. 2017. Web.

    Schuurman, Robbin. “10 Tips for Product Owners on the Product Vision.” Scrum.org, 29 Nov. 2017. Web.

    Schuurman, Robbin. “Tips for Starting Product Owners.” Scrum.org, 27 Nov. 2017. Web.

    Sharma, Rohit. “Scaling Product Teams the Structured Way.” Monetary Musings, 28 Nov. 2016. Web.

    Shirazi, Reza. “Betsy Stockdale of Seilevel: Product Managers Are Not Afraid To Be Wrong.” Austin Voice of Product, 2 Oct. 2018. Web.

    Spitz, Enid R. “The Three Kinds of Empathy: Emotional, Cognitive, Compassionate.” The Three Kinds of Empathy: Emotional, Cognitive, Compassionate. Heartmanity. Web.

    Steiner, Anne. “Start to Scale Your Product Management: Multiple Teams Working on Single Product.” Cprime, 6 Aug. 2019. Web.

    “The Qualities of Leadership: Leading Change.” Cornelius & Associates, 2016. Web.

    “The Standish Group 2015 Chaos Report.” The Standish Group. 2015. Web.

    Theus, Andre. “When Should You Scale the Product Management Team?” ProductPlan, 7 May 2019. Web.

    Tolonen, Arto. “Scaling Product Management in a Single Product Company.” Smartly.io, 26 Apr. 2018. Web.

    Ulrich, Catherine. “The 6 Types of Product Managers. Which One Do You Need?” Medium, 19 Dec. 2017. Web.

    Verwijs, Christiaan. “Retrospective: Do The Team Radar.” The Liberators, Medium, 10 Feb. 2017. Web.

    Vlaanderen, Kevin. “Towards Agile Product and Portfolio Management”. Academia.edu. 2010. Web.

    Backlog

    2009 Business Analysis Benchmark Study.” IAG Consulting, 2009. Web.

    Armel, Kate. “Data-driven Estimation, Management Lead to High Quality.” Quantitative Software Management Inc, 2015. Web.

    Bradley, Marty. “Agile Estimation Guidance.” Leading Agile, 30 Aug. 2016. Web. Feb. 2019.

    CollabNet and VersionOne. “12th Annual State of Agile Report.” VersionOne, 9 April 2018. Web.

    Craveiro, João. “Marty meets Martin: connecting the two triads of Product Management.” Product Coalition, 18 Nov. 2017. Accessed Feb. 2019.

    “Enablers.” Scaled Agile, n.d. Web.

    “Epic.” Scaled Agile, n.d. Web.

    Fischer, Christian. “Scrum Compact.” Itemis, n.d. Web. Feb. 2019.

    Hackshall, Robin. “Product Backlog Refinement.” Scrum Alliance, 9 Oct. 2014. Accessed Feb. 2019.

    Hartman, Bob. “New to agile? INVEST in good user stories.” Agile For All, 14 May 2009. Web.

    Huether, Derek. “Cheat Sheet for Product Backlog Refinement (Grooming).” Leading Agile, 2 Nov. 2013. Accessed Feb. 2019.

    Karlsson, Johan. “Backlog Grooming: Must-Know Tips for High-Value Products.” Perforce, 18 May 2018. Accessed Feb. 2019.

    Khan, Saeed. “Good Bye ‘Product Owner’, Hello ‘Backlog Manager.’” On Product Management, 27 June 2011. Accessed Feb. 2019.

    Khan, Saeed. “Let’s End the Confusion: A Product Owner is NOT a Product Manager.” On Product Management, 14 July 2017. Accessed Feb. 2019.

    Lawrence, Richard. “New Story Splitting Resource.” Agile For All. 27 Jan. 2012. Web. Feb. 2019.

    Leffingwell, Dean. “SAFe 4.0.” Scaled Agile Inc, 2017. Accessed Feb. 2019.

    Lucero, Mario. “Product Backlog – Deep Model.” Agilelucero, 8 Oct. 2014. Web.

    “PI Planning.” Scaled Agile, n.d. Web.

    Pichler, Roman. “The Product Roadmap and the Product Backlog.” Roman Pichler, 9 Sept. 2014. Accessed Feb. 2019.

    Rubin, Kenneth S. Essential Scrum: A Practical Guide to the Most Popular Agile Process. Pearson Education, 2012.

    Schuurman, Robbin. “10 Tips for Product Owners on Product Backlog Management.” Burozeven, 20 Nov. 2017. Accessed Feb. 2019.

    Srinivasan, Vibhu. “Product Backlog Management: Tips from a Seasoned Product Owner.” Agile Alliance, n.d. Accessed Feb. 2019.

    Todaro, Dave. “Splitting Epics and User Stories.” Ascendle, n.d. Accessed Feb. 2019.

    “What Characteristics Make Good Agile Acceptance Criteria?” Segue Technologies, 3 Sept. 2015. Web. Feb. 2019.

    Bibliography (Roadmap)

    Bastow, Janna. “Creating Agile Product roadmaps Everyone Understands.” ProdPad, 22 Mar. 2017. Accessed Sept. 2018.

    Bastow, Janna. “The Product Tree Game: Our Favorite Way To Prioritize Features.” ProdPad, 21 Feb. 2016. Accessed Sept. 2018.

    Chernak, Yuri. “Requirements Reuse: The State of the Practice.” 2012 IEEE International Conference, 12 June 2012, Herzliya, Israel. Web.

    Fowler, Martin. “Application Boundary.” MartinFowler.com, 11 Sept. 2003. Accessed 20 Nov. 2017.

    Harrin, Elizabeth. “Learn What a Project Milestone Is.” The Balance Careers, 10 May 2018. Accessed Sept. 2018.

    “How to create a product roadmap.” Roadmunk, n.d. Accessed Sept. 2018.

    Johnson, Steve. “How to Master the 3 Horizons of Product Strategy.” Aha!, 24 Sept. 2015. Accessed Sept. 2018.

    Johnson, Steve. “The Product Roadmap vs. the Technology Roadmap.” Aha!, 23 June 2016. Accessed Sept. 2018

    Juncal, Shaun. “How Should You Set Your Product Roadmap Timeframes?” ProductPlan, Web. Sept. 2018.

    Leffingwell, Dean. “SAFe 4.0.” Scaled Agile, 2017. Web.

    Maurya, Ash. “What is a Minimum Viable Product (MVP).” Leanstack, 12 June 2017. Accessed Sept. 2018.

    Pichler, Roman. “10 Tips for Creating an Agile Product Roadmap.” Roman Pichler, 20 July 2016. Accessed Sept. 2018.

    Pichler, Roman. Strategize: Product Strategy and Product Roadmap Practices for the Digital Age. Pichler Consulting, 2016.

    “Product Roadmap Contents: What Should You Include?” ProductPlan, n.d. Accessed 20 Nov. 2017.

    Saez, Andrea. “Why Your Roadmap Is Not a Release Plan.” ProdPad, 23 October 2015. Accessed Sept. 2018.

    Schuurman, Robbin. “Tips for Agile product roadmaps & product roadmap examples.” Scrum.org, 7 Dec. 2017. Accessed Sept. 2018.

    Bibliography (Vision and Canvas)

    Adams, Paul. “The Future Product Canvas.” Inside Intercom, 10 Jan. 2014. Web.

    “Aligning IT Funding Models to the Pace of Technology Change.” EDUCAUSE, 14 Dec. 2015. Web.

    Altman, Igor. “Metrics: Gone Bad.” OpenView, 10 Nov. 2009. Web.

    Barry, Richard. “The Product Vision Canvas – a Strategic Tool in Developing a Successful Business.” Polymorph, 2019. Web.

    “Business Canvas – Business Models & Value Propositions.” Strategyzer, 2019. Web.

    “Business Model Canvas.” Wikipedia: The Free Encyclopedia, 4 Aug. 2019. Web.

    Charak, Dinker. “Idea to Product: The Working Model.” ThoughtWorks, 13 July 2017. Web.

    Charak, Dinker. “Product Management Canvas - Product in a Snapshot.” Dinker Charak, 29 May 2017. Web.

    Chudley, James. “Practical Steps in Determining Your Product Vision (Product Tank Bristol, Oct. 2018).” LinkedIn SlideShare. Uploaded by cxpartners, 2 Nov. 2018. Web.

    Cowan, Alex. “The 20 Minute Business Plan: Business Model Canvas Made Easy.” COWAN+, 2019. Web.

    Craig, Desiree. “So You've Decided To Become A Product Manager.” Start it up, Medium, 2 June 2019. Web.

    “Create an Aha! Business Model Canvas Strategic Model.” Aha! Support, 2019. Web.

    Eick, Stephen. “Does Code Decay? Assessing the Evidence from Change Management Data.” IEEE Transactions on Software Engineering, vol. 27, no. 1, Jan. 2001, pp. 1-12. Web.

    Eriksson, Martin. “The next Product Canvas.” Mind the Product, 22 Nov. 2013. Web.

    “Experience Canvas: a Lean Approach: Atlassian Team Playbook.” Atlassian, 2019. Web.

    Freeman, James. “How to Make a Product Canvas – Visualize Your Product Plan.” Edraw, 23 Dec. 2019. Web.

    Fuchs, Danny. “Measure What Matters: 5 Best Practices from Performance Management Leaders.” OpenGov, 8 Aug. 2018. Web.

    Gorisse, Willem. “A Practical Guide to the Product Canvas.” Mendix, 28 Mar. 2017. Web.

    Gothelf, Jeff. “The Lean UX Canvas.” Jeff Gothelf, 15 Dec. 2016. Web.

    Gottesdiener, Ellen. “Using the Product Canvas to Define Your Product: Getting Started.” EBG Consulting, 15 Jan. 2019. Web.

    Gottesdiener, Ellen. “Using the Product Canvas to Define Your Product's Core Requirements.” EBG Consulting, 4 Feb. 2019. Web.

    Gray, Mark Krishan. “Should I Use the Business Model Canvas or the Lean Canvas?” Blog, Medium.com, 2019. Web.

    Bibliography (Vision and Canvas)

    Hanby, Jeff. "Software Maintenance: Understanding and Estimating Costs." LookFar, 21 Oct. 2016. Web.

    “How do you define a product?” Scrum.org, 4 Apr 2017, Web

    Juncal, Shaun. “How to Build a Product Roadmap Based on a Business Model Canvas.” ProductPlan, 19 June 2019. Web.

    “Lean Canvas Intro - Uber Example.” YouTube, uploaded by Railsware Product Academy, 12 Oct. 2018. Web.

    “Lesson 6: Product Canvas.” ProdPad Help Center, 2019. Web.

    Lucero, Mario. “The Product Canvas.” Agilelucero.com, 22 June 2015. Web.

    Maurya, Ash. “Create a New Lean Canvas.” Canvanizer, 2019. Web.

    Maurya, Ash. “Don't Write a Business Plan. Create a Lean Canvas Instead.” LEANSTACK, 2019. Web.

    Maurya, Ash. “Why Lean Canvas vs Business Model Canvas?” Medium, 27 Feb. 2012. Web.

    Mirabelli, Vincent. “The Project Value Canvas.” Vincent Mirabelli, 2019. Web.

    Mishra, LN. “Business Analysis Canvas – The Ultimate Enterprise Architecture.” BA Times, 19 June 2019. Web.

    Muller. Jerry Z. “Why performance metrics isn’t always the best way to judge performance.” Fast Company, 3 April 2019. Web.

    Perri, Melissa. “What Is Good Product Strategy?” Melissa Perri, 14 July 2016. Web.

    Pichler, Roman. “A Product Canvas for Agile Product Management, Lean UX, Lean Startup.” Roman Pichler, 16 July 2012. Web.

    Pichler, Roman. “Introducing the Product Canvas.” JAXenter, 15 Jan. 2013. Web.

    Pichler, Roman. “Roman's Product Canvas: Introduction.” YouTube, uploaded by Roman Pichler, 3 Mar. 2017. Web.

    Pichler, Roman. “The Agile Vision Board: Vision and Product Strategy.” Roman Pichler, 10 May 2011. Web.

    Pichler, Roman. “The Product Canvas – Template.” Roman Pichler, 11 Oct. 2016. Web.

    Pichler, Roman. “The Product Canvas Tutorial V1.0.” LinkedIn SlideShare. Uploaded by Roman Pichler, 14 Feb. 2013. Web.

    Pichler, Roman. “The Product Vision Board: Introduction.” YouTube uploaded by Roman Pichler, 3 Mar. 2017. Web.

    “Product Canvas PowerPoint Template.” SlideModel, 2019. Web.

    Bibliography (Vision and Canvas)

    “Product Canvas.” SketchBubble, 2019, Web.

    “Product Canvas.” YouTube, uploaded by Wojciech Szramowski, 18 May 2016. Web.

    “Product Roadmap Software to Help You Plan, Visualize, and Share Your Product Roadmap.” Productboard, 2019. Web.

    Roggero, Giulio. “Product Canvas Step-by-Step.” LinkedIn SlideShare, uploaded by Giulio Roggero, 18 May 2013. Web.

    Royce, Dr. Winston W. “Managing the Development of Large Software Systems.” Scf.usc.edu, 1970. Web.

    Ryan, Dustin. “The Product Canvas.” Qdivision, Medium, 20 June 2017. Web.

    Snow, Darryl. “Product Vision Board.” Medium, 6 May 2017. Web.

    Stanislav, Shymansky. “Lean Canvas – a Tool Your Startup Needs Instead of a Business Plan.” Railsware, 12 Oct. 2018. Web.

    Stanislav, Shymansky. “Lean Canvas Examples of Multi-Billion Startups.” Railsware, 20 Feb. 2019. Web.

    “The Product Vision Canvas.” YouTube, Uploaded by Tom Miskin, 20 May 2019. Web.

    Tranter, Leon. “Agile Metrics: the Ultimate Guide.” Extreme Uncertainty, n.d. Web.

    “Using Business Model Canvas to Launch a Technology Startup or Improve Established Operating Model.” AltexSoft, 27 July 2018. Web.

    Veyrat, Pierre. “Lean Business Model Canvas: Examples + 3 Pillars + MVP + Agile.” HEFLO BPM, 10 Mar. 2017. Web.

    “What Are Software Metrics and How Can You Track Them?” Stackify, 16 Sept. 2017. Web

    “What Is a Product Vision?” Aha!, 2019. Web.

    Supporting Research

    Transformation topics and supporting Info-Tech research to make the journey easier, with less rework.

    Supporting research and services

    Improving IT alignment

    Build a Business-Aligned IT Strategy

    Success depends on IT initiatives clearly aligned to business goals, IT excellence, and driving technology innovation.

    Includes a "Strategy on a page" template

    Make Your IT Governance Adaptable

    Governance isn't optional, so keep it simple and make it flexible.

    Create an IT View of the Service Catalog

    Unlock the full value of your service catalog with technical components.

    Application Portfolio Management Foundations

    Ensure your application portfolio delivers the best possible return on investment.

    Supporting research and services

    Shifting toward Agile DevOps

    Agile/DevOps Resource Center

    Tools and advice you need to be successful with Agile.

    Develop Your Agile Approach for a Successful Transformation

    Understand Agile fundamentals, principles, and practices so you can apply them effectively in your organization.

    Implement DevOps Practices That Work

    Streamline business value delivery through the strategic adoption of DevOps practices.

    Perform an Agile Skills Assessment

    Being Agile isn't about processes, it's about people.

    Define the Role of Project Management in Agile and Product-Centric Delivery

    Projects and products are not mutually exclusive.

    Supporting research and services

    Shifting toward product management

    Make the Case for Product Delivery

    Align your organization on the practices to deliver what matters most.

    Deliver on Your Digital Product Vision

    Build a product vision your organization can take from strategy through execution.

    Deliver Digital Products at Scale

    Deliver value at the scale of your organization through defining enterprise product families.

    Build a Better Product Owner

    Strengthen the product owner's role in your organization by focusing on core capabilities and proper alignment.

    Supporting research and services

    Improving value and delivery metrics

    Build a Value Measurement Framework

    Focus product delivery on business value-driven outcomes.

    Create a Holistic IT Dashboard

    Mature your IT department by measuring what matters.

    Select and Use SDLC Metrics Effectively

    Be careful what you ask for because you will probably get it.

    Reduce Time to Consensus With an Accelerated Business Case

    Expand on the financial model to give your initiative momentum.

    Supporting research and services

    Improving governance, prioritization, and value

    Make Your IT Governance Adaptable

    Governance isn't optional, so keep it simple and make it flexible.

    Maximize Business Value from IT Through Benefits Realization

    Embed benefits realization into your governance process to prioritize IT spending and confirm the value of IT.

    Drive Digital Transformation With Platform Strategies

    Innovate and transform your business models with digital platforms.

    Succeed With Digital Strategy Execution

    Building a digital strategy is only half the battle: create a systematic roadmap of technology initiatives to execute the strategy and drive digital transformation.

    Build a Value Measurement Framework

    Focus product delivery on business value-driven outcomes.

    Create a Holistic IT Dashboard

    Mature your IT department by measuring what matters.

    Supporting research and services

    Improving requirements management and quality assurance

    Requirements Gathering for Small Enterprises

    Right-size the guidelines of your requirements gathering process.

    Improve Requirements Gathering

    Back to basics: great products are built on great requirements.

    Build a Software Quality Assurance Program

    Build quality into every step of your SDLC.

    Automate Testing to Get More Done

    Drive software delivery throughput and quality confidence by extending your automation test coverage.

    Manage Your Technical Debt

    Make the case to manage technical debt in terms of business impact.

    Create a Business Process Management Strategy

    Avoid project failure by keeping the "B" in BPM.

    Build a Winning Business Process Automation Playbook

    Optimize and automate your business processes with a user-centric approach.

    Create a Winning BPI Playbook

    Don't waste your time focusing on the "as is." Focus on the improvements and the "to be."

    Supporting research and services

    Improving release management

    Optimize Applications Release Management

    Build trust by right-sizing your process using appropriate governance.

    Streamline Application Maintenance

    Effective maintenance ensures the long-term value of your applications.

    Streamline Application Management

    Move beyond maintenance to ensure exceptional value from your apps.

    Optimize Change Management

    Right-size your change management process.

    Manage Your Technical Debt

    Make the case to manage technical debt in terms of business impact.

    Improve Application Development Throughput

    Drive down your delivery time by eliminating development inefficiencies and bottlenecks while maintaining high quality.

    Supporting research and services

    Business relationship management

    Embed Business Relationship Management

    Leverage knowledge of the business to become a strategic IT partner.

    Improving security

    Build an Information Security Strategy

    Create value by aligning your strategy to business goals and business risks.

    Develop and Deploy Security Policies

    Enhance your overall security posture with a defensible and prescriptive policy suite.

    Simplify Identity and Access Management

    Leverage risk- and role-based access control to quantify and simplify the IAM process.

    Supporting research and services

    Improving and supporting business-managed applications

    Embrace Business-Managed Applications

    Empower the business to implement their own applications with a trusted business-IT relationship.

    Enhance Your Solution Architecture Practices

    Ensure your software systems solution is architected to reflect stakeholders’ short-and long-term needs.

    Satisfy Digital End Users With Low- and No-Code

    Extend IT, automation, and digital capabilities to the business with the right tools, good governance, and trusted organizational relationships.

    Build Your First RPA Bot

    Support RPA delivery with strong collaboration and management foundations.

    Automate Work Faster and More Easily With Robotic Process Automation

    Embrace the symbiotic relationship between the human and digital workforce.

    Supporting research and services

    Improving business intelligence, analytics, and reporting

    Modernize Data Architecture for Measurable Business Results

    Enable the business to achieve operational excellence, client intimacy, and product leadership with an innovative, Agile, and fit-for-purpose data architecture practice.

    Build a Reporting and Analytics Strategy

    Deliver actionable business insights by creating a business-aligned reporting and analytics strategy.

    Build Your Data Quality Program

    Quality data drives quality business decisions.

    Design Data-as-a-Service

    Journey to the data marketplace ecosystems.

    Build a Robust and Comprehensive Data Strategy

    Key to building and fostering a data-driven culture.

    Build an Application Integration Strategy

    Level the table before assembling the application integration puzzle or risk losing pieces.

    Appendix

    Pulse survey results

    Pulse survey (N=18): What are the key components of product/service ownership?

    Pulse survey results: What are the key components of product/service ownership? Table shows answer options and responses in percentage.

    Pulse Survey (N=18): What are the key individual skills for a product/service owner?

    What are the key individual skills for a product/service owner? Table shows answer options and responses in percentage

    Other choices entered by respondents:

    • Anticipating client needs, being able to support delivery in all phases of the product lifecycle, adaptability, and ensuring a healthy backlog (at least two sprints’ worth of work).
    • Requirements elicitation and prioritization.
    • The key skill is being product-focused to ensure it provides value for competitive advantage.

    Pulse Survey (N=18): What are three things an outstanding product/service owner does that an average one doesn’t?

    What are three things an outstanding product/service owner does that an average one doesn't? Table shows results.

    Improve Security Governance With a Security Steering Committee

    • Buy Link or Shortcode: {j2store}373|cart{/j2store}
    • member rating overall impact: 9.5/10 Overall Impact
    • member rating average dollars saved: $10,000 Average $ Saved
    • member rating average days saved: 20 Average Days Saved
    • Parent Category Name: Governance, Risk & Compliance
    • Parent Category Link: /governance-risk-compliance
    • Security is still seen as an IT problem rather than a business risk, resulting in security governance being relegated to the existing IT steering committee.
    • Security is also often positioned in the organization where they are not privy to the details of the organization’s overall strategy. Security leaders struggle to get the full enterprise picture.

    Our Advice

    Critical Insight

    • Work to separate the Information Security Steering Committee (ISSC) from the IT Steering Committee (ITSC). Security transcends the boundaries of IT and needs an independent, eclectic approach to make strategic decisions.
    • Be the lawyer, not the cop. Ground your communications in business terminology to facilitate a solution that makes sense to the entire organization.
    • Develop and stick to the agenda. Continued engagement from business stakeholders requires sticking to a strategic level-focused agenda. Dilution of purpose will lead to dilution in attendance.

    Impact and Result

    • Define a clear scope of purpose and responsibilities for the ISSC to gain buy-in and consensus for security governance receiving independent agenda time from the broader IT organization.
    • Model the information flows necessary to provide the steering committee with the intelligence to make strategic decisions for the enterprise.
    • Determine membership and responsibilities that shift with the evolving security landscape to ensure participation reflects interested parties and that money being spent on security mitigates risk across the enterprise.
    • Create clear presentation material and strategically oriented meeting agendas to drive continued participation from business stakeholders and executive management.

    Improve Security Governance With a Security Steering Committee Research & Tools

    Start here – read the Executive Brief

    Read our concise Executive Brief to find out how to improve your security governance with a security steering committee, review Info-Tech’s methodology, and understand the ways we can support you in completing this project.

    Besides the small introduction, subscribers and consulting clients within this management domain have access to:

    1. Define committee purpose and responsibilities

    Identify the purpose of your committee, determine the capabilities of the committee, and define roles and responsibilities.

    • Improve Security Governance With a Security Steering Committee – Phase 1: Define Committee Purpose and Responsibilities
    • Information Security Steering Committee Charter

    2. Determine information flows, membership & accountabilities

    Determine how information will flow and the process behind that.

    • Improve Security Governance With a Security Steering Committee – Phase 2: Determine Information Flows, Membership & Accountabilities

    3. Operate the Information Security Steering Committee

    Define your meeting agendas and the procedures to support those meetings. Hold your kick-off meeting. Identify metrics to measure the committee’s success.

    • Improve Security Governance With a Security Steering Committee – Phase 3: Operate the Information Security Steering Committee
    • Security Metrics Summary Document
    • Information Security Steering Committee Stakeholder Presentation
    [infographic]

    Further reading

    Improve Security Governance With a Security Steering Committee

    Build an inclusive committee to enable holistic strategic decision making.

    ANALYST PERSPECTIVE

    "Having your security organization’s steering committee subsumed under the IT steering committee is an anachronistic framework for today’s security challenges. Conflicts in perspective and interest prevent holistic solutions from being reached while the two permanently share a center stage.

    At the end of the day, security is about existential risks to the business, not just information technology risk. This focus requires its own set of business considerations, information requirements, and delegated authorities. Without an objective and independent security governance body, organizations are doomed to miss the enterprise-wide nature of their security problems."

    – Daniel Black, Research Manager, Security Practice, Info-Tech Research Group

    Our understanding of the problem

    This Research Is Designed For:

    • CIOs
    • CISOs
    • IT/Security Leaders

    This Research Will Help You:

    • Develop an effective information security steering committee (ISSC) that ensures the right people are involved in critical decision making.
    • Ensure that business and IT strategic direction are incorporated into security decisions.

    This Research Will Also Assist:

    • Information Security Steering Committee (ISSC) members

    This Research Will Help Them:

    • Formalize roles and responsibilities.
    • Define effective security metrics.
    • Develop a communication plan to engage executive management in the organization’s security planning.

    Executive summary

    Situation

    • Successful information security governance requires a venue to address security concerns with participation from across the entire business.
    • Without access to requisite details of the organization – where we are going, what we are trying to do, how the business expects to use its technology – security can not govern its strategic direction.

    Complication

    • Security is still seen as an IT problem rather than a business risk, resulting in security governance being relegated to the existing IT steering committee.
    • Security is also often positioned in the organization where they are not privy to the details of the organization’s overall strategy. Security leaders struggle to get the full enterprise picture.

    Resolution

    • Define a clear scope of purpose and responsibilities for the Information Security Steering Committee to gain buy-in and consensus for security governance receiving independent agenda time from the broader IT organization.
    • Model the information flows necessary to provide the steering committee with the intelligence to make strategic decisions for the enterprise.
    • Determine membership and responsibilities that shift with the evolving security landscape to ensure participation reflects interested parties and that money being spent on security mitigates risk across the enterprise.
    • Create security metrics that are aligned with committee members’ operational goals to incentivize participation.
    • Create clear presentation material and strategically oriented meeting agendas to drive continued participation from business stakeholders and executive management.

    Info-Tech Insight

    1. Work to separate the ISSC from the IT Steering Committee (ITSC). Security transcends the boundaries of IT and needs an independent, eclectic approach to make strategic decisions.
    2. Be the lawyer, not the cop. Ground your communications in business terminology to facilitate a solution that make sense to the entire organization.
    3. Develop and stick to the agenda. Continued engagement from business stakeholders requires sticking to a strategic level-focused agenda. Dilution of purpose will lead to dilution in attendance.

    Empower your security team to act strategically with an ISSC

    Establishing an Information Security Steering Committee (ISSC)

    Even though security is a vital consideration of any IT governance program, information security has increasingly become an important component of the business, moving beyond the boundaries of just the IT department.

    This requires security to have its own form of steering, beyond the existing IT Steering Committee, that ensures continual alignment of the organization’s security strategy with both IT and business strategy.

    An ISSC should have three primary objectives:

    • Direct Strategic Planning The ISSC formalizes organizational commitments to strategic planning, bringing visibility to key issues and facilitating the integration of security controls that align with IT and business strategy.
    • Institute Clear Accountability The ISSC facilitates the involvement and commitment of executive management through clearly defined roles and accountabilities for security decisions, ensuring consistency in participation as the organization’s strategies evolve.
    • Optimize Security Resourcing The ISSC maximizes security by monitoring the implementation of the security strategic plan, making recommendations on prioritization of effort, and securing necessary resources through the planning and budgeting processes, as necessary.

    What does the typical ISSC do?

    Ensuring proper governance over your security program is a complex task that requires ongoing care and feeding from executive management to succeed.

    Your ISSC should aim to provide the following core governance functions for your security program:

    1. Define Clarity of Intent and Direction How does the organization’s security strategy support the attainment of the business and IT strategies? The ISSC should clearly define and communicate strategic linkage and provide direction for aligning security initiatives with desired outcomes.
    2. Establish Clear Lines of Authority Security programs contain many important elements that need to be coordinated. There needs to be clear and unambiguous authority, accountability, and responsibility defined for each element so lines of reporting/escalation are clear and conflicting objectives can be mediated.
    3. Provide Unbiased Oversight The ISSC should vet the organization’s systematic monitoring processes to make certain there is adherence to defined risk tolerance levels and ensure that monitoring is appropriately independent from the personnel responsible for implementing and managing the security program.
    4. Optimize Security Value Delivery Optimized value delivery occurs when strategic objectives for security are achieved and the organization’s acceptable risk posture is attained at the lowest possible cost. This requires constant attention to ensure controls are commensurate with any changes in risk level or appetite.

    Formalize the most important governance functions for your organization

    Creation of an ISSC is deemed the most important governance and oversight practice that a CISO can implement, based on polling of IT security leaders analyzing the evolving role of the CISO.

    Relatedly, other key governance practices reported – status updates, upstream communications, and executive-level sponsorship – are within the scope of what organizations traditionally formalize when establishing their ISSC.

    Vertical bar chart highlighting the most important governance functions according to respondents. The y axis is labelled 'Percentage of Respondents' with the values 0%-60%, and the x axis is labelled 'Governance and Oversight Practices'. Bars are organized from highest percentage to lowest with 'Creation of cross-functional committee to oversee security strategy' at 56%, 'Regularly scheduled reporting on the state of security to stakeholders' at 55%, 'Upstream communication channel from security leadership to CEO' at 46%, and 'Creation of program charter approved by executive-level sponsor' at 37%. Source: Ponemon Institute, 2017; N=184 organizations; 660 respondents.

    Despite the clear benefits of an ISSC, organizations are still falling short

    83% of organizations have not established formal steering committees to evaluate the business impact and risks associated with security decisions. (Source: 2017 State of Cybersecurity Metrics Report)

    70% of organizations have delegated cybersecurity oversight to other existing committees, providing security limited agenda time. (Source: PwC 2017 Annual Corporate Director Survey)

    "This is a group of risk managers an institution would bring together to deal with a response anyway. Having them in place to do preventive discussions and formulate policy to mitigate the liability sets and understand compliance obligations is just powerful." (Kirk Bailey, CISO, University of Washington)

    Prevent the missteps that make 9 out of 10 steering committees unsuccessful

    Why Do Steering Committees Fail?

    1. A lack of appetite for a steering committee from business partners. An effective ISSC requires participation from core members of the organization’s leadership team. The challenge is that most business partners don’t understand the benefits of an ISSC and the responsibilities aren’t tailored to participants’ needs or interests. It’s the CISO’s (or senior IT/security leader’s) responsibility to make this case to stakeholders and right-size the committee responsibilities and membership.
    2. ISSC committees are given inappropriate responsibilities. The steering committee is fundamentally about decision making; it’s not a working committee. Security leadership typically struggles with clarifying these responsibilities on two fronts: either the responsibilities are too vague and there is no clear way to execute on them within a meeting or responsibilities are too tactical and require knowledge that participants do not have. Responsibilities should determine who is on the ISSC, not the other way around.
    3. Lack of process around execution. An ISSC is only valuable if members are able to successfully execute on its mandate. Without well-defined processes it becomes nearly impossible for the ISSC to be actionable. As a result, participants lack the information they need to make critical decisions, agendas are unmet, and meetings are seen as a waste of time.

    Use these icons to help direct you as you navigate this research

    Use these icons to help guide you through each step of the blueprint and direct you to content related to the recommended activities.

    A small monochrome icon of a wrench and screwdriver creating an X.

    This icon denotes a slide where a supporting Info-Tech tool or template will help you perform the activity or step associated with the slide. Refer to the supporting tool or template to get the best results and proceed to the next step of the project.

    A small monochrome icon depicting a person in front of a blank slide.

    This icon denotes a slide with an associated activity. The activity can be performed either as part of your project or with the support of Info-Tech team members, who will come onsite to facilitate a workshop for your organization.

    Info-Tech offers various levels of support to best suit your needs

    DIY Toolkit

    Guided Implementation

    Workshop

    Consulting

    "Our team has already made this critical project a priority, and we have the time and capability, but some guidance along the way would be helpful." "Our team knows that we need to fix a process, but we need assistance to determine where to focus. Some check-ins along the way would help keep us on track." "We need to hit the ground running and get this project kicked off immediately. Our team has the ability to take this over once we get a framework and strategy in place." "Our team does not have the time or the knowledge to take this project on. We need assistance through the entirety of this project."

    Diagnostics and consistent frameworks used throughout all four options

    Improve Security Governance With a Security Steering Committee – project overview

    1. Define Committee Purpose and Responsibilities

    2. Determine Information Flows, Membership & Accountabilities

    3. Operate the Information Security Steering Committee

    Supporting Tool icon

    Best-Practice Toolkit

    1.1 Tailor Info-Tech’s Information Security Steering Committee Charter Template to define terms of reference for the ISSC

    1.2 Conduct a SWOT analysis of your information security governance capabilities

    1.3 Identify the responsibilities and duties of the ISSC

    1.4 Draft the committee purpose statement of your ISSC

    2.1 Define your SIPOC model for each of the ISSC responsibilities

    2.2 Identify committee participants and responsibility cadence

    2.3 Define ISSC participant RACI for each of the responsibilities

    3.1 Define the ISSC meeting agendas and procedures

    3.2 Define which metrics you will report to the ISSC

    3.3 Hold a kick-off meeting with your ISSC members to explain the process, responsibilities, and goals

    3.4 Tailor the Information Security Steering Committee Stakeholder Presentation template

    3.5 Present the information to the security leadership team

    3.6 Schedule your first meeting of the ISSC

    Guided Implementations

    • Identify the responsibilities and duties of the ISSC.
    • Draft the committee purpose of the ISSC.
    • Determine SIPOC modeling of information flows.
    • Determine accountabilities and responsibilities.
    • Set operational standards.
    • Determine effectiveness metrics.
    • Steering committee best practices.
    Associated Activity icon

    Onsite Workshop

    This blueprint can be combined with other content for onsite engagements, but is not a standalone workshop.
    Phase 1 Outcome:
    • Determine the purpose and responsibilities of your information security steering committee.
    Phase 2 Outcome:
    • Determine membership, accountabilities, and information flows to enable operational excellence.
    Phase 3 Outcome:
    • Define agendas and standard procedures to operate your committee.
    • Design an impactful stakeholder presentation.

    Improve Security Governance With a Security Steering Committee

    PHASE 1

    Define Committee Purpose and Responsibilities

    Phase 1: Define Committee Purpose and Responsibilities

    ACTIVITIES:

    • 1.1 Tailor Info-Tech’s Information Security Steering Committee Charter Template to define terms of reference for the ISSC
    • 1.2 Conduct a SWOT analysis of your information security governance capabilities
    • 1.3 Identify the responsibilities and duties of the ISSC
    • 1.4 Draft the committee purpose statement for your ISSC

    OUTCOMES:

    • Conduct an analysis of your current information security governance capabilities and identify opportunities and weaknesses.
    • Define a clear scope of purpose and responsibilities for your ISSC.
    • Begin to customize your ISSC charter.

    Info-Tech Insight

    Balance vision with direction. Purpose and responsibilities should be defined so that they encompass your mission and objectives to the enterprise in clear terms, but provide enough detail that you can translate the charter into operational plans for the security team.

    Tailor Info-Tech’s Information Security Steering Committee Charter Template to define terms of reference for the ISSC

    Supporting Tool icon 1.1

    A charter is the organizational mandate that outlines the purpose, scope, and authority of the ISSC. Without a charter, the steering committee’s value, scope, and success criteria are unclear to participants, resulting in unrealistic stakeholder expectations and poor organizational acceptance.

    Start by reviewing Info-Tech’s template. Throughout the next two sections we will help you to tailor its contents.

    • Committee Purpose: The rationale, benefits of, and overall function of the committee.
    • Organization and Membership: Who is on the committee and how is participation measured against organizational need.
    • Responsibilities and Duties: What tasks/decisions the accountable committee is making.
    • RACI: Who is accountable, responsible, consulted, and informed regarding each responsibility.
    • Committee Procedures and Agendas: Includes how the committee will be organized and how the committee will interact and communicate with interested parties.
    Sample of the Info-Tech deliverable 'Information Security Steering Committee Charter Template'.

    Download the Information Security Steering Committee Charter to customize your organization’s charter

    Conduct a SWOT analysis of your information security governance capabilities

    Associated Activity icon 1.2

    INPUT: Survey outcomes, Governance overview handouts

    OUTPUT: SWOT analysis, Top identified challenges and opportunities

    1. Hold a meeting with your IT leadership team to conduct a SWOT analysis on your current information security governance capabilities.
    2. In small groups, or individually, have each group complete a SWOT analysis for one of the governance areas. For each consider:
      • Strengths: What is currently working well in this area?
      • Weaknesses: What could you improve? What are some of the challenges you’re experiencing?
      • Opportunities: What are some organizational trends that you can leverage? Consider whether your strengths or weaknesses could create opportunities.
      • Threats: What are some key obstacles across people, process, and technology?
    3. Have each team or individual rotate until each person has contributed to each SWOT. Add comments from the stakeholder survey to the SWOT.
    4. As a group, rank the inputs from each group and highlight the top five challenges and the top five opportunities you see for improvement.

    Identify the responsibilities and duties of the ISSC

    Associated Activity icon 1.3

    INPUT: SWOT analysis, Survey reports

    OUTPUT: Defined ISSC responsibilities

    1. With your security leadership team, review the typical responsibilities of the ISSC on the following slides (also included in the templated text of the charter linked below).
    2. Print off the following two slides, and in small teams or individually, identify which responsibilities the ISSC should have in your organization, brainstorm any additional responsibilities, and document reasoning.
    3. Have each team present to the larger group, track the similarities and differences between each of the groups, and come to consensus on the list of categories and responsibilities.
    4. Complete a sanity check: review your SWOT analysis. Do the responsibilities you’ve identified resolve the critical challenges or weaknesses?
    5. As a group, consider the responsibilities and whether you can reasonably implement those in one year or if there are any that will need to wait until year two of the committee.

    Add or modify responsibilities in Info-Tech’s Information Security Steering Committee Charter.

    Typical ISSC responsibilities and duties

    Use the following list of responsibilities to customize the list of responsibilities your ISSC may take on. These should link directly to the Responsibilities and Duties section of your ISSC charter.

    Strategic Oversight

    • Provide oversight and ensure alignment between information security strategy and company objectives.
    • Assess the adequacy of resources and funding to sustain and advance successful security programs and practices for identifying, assessing, and mitigating cybersecurity risks across all business functions.
    • Review controls to prevent, detect, and respond to cyber-attacks or information or data breaches involving company electronic information, intellectual property, data, or connected devices.
    • Review the company’s cyberinsurance policies to ensure appropriate coverage.
    • Provide recommendations, based on security best practices, for significant technology investments.

    Policy Governance

    • Review company policies pertaining to information security and cyberthreats, taking into account the potential for external threats, internal threats, and threats arising from transactions with trusted third parties and vendors.
    • Review privacy and information security policies and standards and the ramifications of updates to policies and standards.
    • Establish standards and procedures for escalating significant security incidents to the ISSC, board, other steering committees, government agencies, and law enforcement, as appropriate.

    Typical ISSC responsibilities and duties (continued)

    Use the following list of responsibilities to customize the list of responsibilities your ISSC may take on. These should link directly to the Responsibilities and Duties section of your ISSC charter.

    Risk Governance

    • Review and approve the company’s information risk governance structure and key risk management processes and capabilities.
    • Assess the company’s high-risk information assets and coordinate planning to address information privacy and security needs.
    • Provide input to executive management regarding the enterprise’s information risk appetite and tolerance.
    • Review the company’s cyber-response preparedness, incident response plans, and disaster recovery capabilities as applicable to the organization’s information security strategy.
    • Promote an open discussion regarding information risk and integrate information risk management into the enterprise’s objectives.

    Monitoring & Reporting

    • Receive periodic reports and coordinate with management on the metrics used to measure, monitor, and manage cyber and IT risks posed to the company and to review periodic reports on selected risk topics as the Committee deems appropriate.
    • Review reports provided by the IT organization regarding the status of and plans for the security of the company’s data stored on internal resources and with third-party providers.
    • Monitor and evaluate the quality and effectiveness of the company’s technology security, capabilities for disaster recovery, data protection, cyberthreat detection and cyber incident response, and management of technology-related compliance risks.

    Review the organization’s security strategy to solidify understanding of the ISSC’s purpose

    The ISSC should consistently evolve to reflect the strategic purpose of the security program. If you completed Info-Tech’s Security Strategy methodology, review the results to inform the scope of your committee. If you have not completed Info-Tech’s methodology, determining these details should be achieved through iterative stakeholder consultations.

    Strategy Components

    ISSC Considerations

    Security Pressure Analysis

    Review the ten security domains and your organization’s pressure levels to review the requisite maturity level of your security program. Consider how this may impact the focus of your ISSC.

    Security Drivers/Obligations

    Review how your security program supports the attainment of the organization’s business objectives. By what means should the ISSC support these objectives? This should inform the rationale, benefits, and overall function of the committee.

    Security Strategy Scope and Boundaries

    Consider the scope and boundaries of your security program to reflect on what the program is responsible for securing. Is this reflected adequately in the language of the committee’s purpose? Should components be added or redacted?

    Draft the committee purpose statement of your ISSC

    Associated Activity icon 1.4

    INPUT: SWOT Analysis, Security Strategy

    OUTPUT: ISSC Committee Purpose

    1. In a meeting with your IT leadership team – and considering the organization’s security strategy, defined responsibilities, and opportunities and threats identified – review the example goal statement in the Information Security Steering Committee Charter, and identify whether any of these statements apply to your organization. Select the statements that apply and collaboratively make any changes needed.
    2. Define unique goal statements by considering the following questions:
      • What three things would you realistically list for the ISSC to achieve?
      • If you were to accomplish three things in the next year, what would those be?
    3. With those goal statements in mind, consider the overall purpose of the committee. The purpose statement should be a reflection of what the committee does, why, and the goals.
    4. Have each individual review the example purpose statement and draft what they think a good purpose statement would be.
    5. Present each statement, and work together to determine a best-of-breed statement.

    Alter the Committee Purpose section in the Information Security Steering Committee Charter.

    Implement the Next-Generation IT Operating Model

    • Buy Link or Shortcode: {j2store}85|cart{/j2store}
    • member rating overall impact: N/A
    • member rating average dollars saved: N/A
    • member rating average days saved: N/A
    • Parent Category Name: IT Strategy
    • Parent Category Link: /it-strategy

    IT is being challenged to change how it operates to better support evolving organizations by:

    • Considering the needs of customers, end users, and organizational stakeholders simultaneously.
    • Leveraging resources strategically to support the various IT and digital services being offered.
    • Creating a digital services enablement office that can design, monitor, and continuously enhance services.

    Our Advice

    Critical Insight

    • The role of IT is changing, and with that, how IT needs to operate to deliver value is also changing. Don’t get left behind with an irrelevant IT operating model.
    • Elevate your reputation as a leader beyond the CIO role. Mature your organization’s digital services by considering the customer experience first.
    • As recessions, disasters, and pandemics hit, don’t adopt old ways of operating with 2008 centralized models. Embrace a hybrid IT where value sets your organization apart.

    Impact and Result

    • Embrace the Exponential IT Operating Model so you can:
      • Say “yes” to stakeholders trying to provide a better experience for customers and consumers.
      • Leverage data more effectively across your organization.
      • Consider how to integrate and deliver services using resources effectively and strategically.

    Implement the Next-Generation IT Operating Model Research & Tools

    Besides the small introduction, subscribers and consulting clients within this management domain have access to:

    1. Implement the Next-Generation IT Operating Model Deck – The next generation operating model for organizations embracing exponential IT.

    This research piece is for any IT leaders looking to support the organization in its post-transformation state by focusing on the customer experience when operating. CIOs struggling with outdated IT operating models can demonstrate true partnership with this digital services next-generation IT operating model.

    • Implement the Next-Generation IT Operating Model Storyboard

    2. Exponential IT Operating Model Readiness Assessment – A tool to assess your organization’s readiness to adopt this next generation of IT operating models.

    Use this tool to determine whether your organization has the fundamental components necessary to support the adoption of an Exponential IT operating model.

    • Exponential IT Operating Model Readiness Assessment

    3. Career Vision Roadmap Tool – A template to create a simple visual roadmap of your desired career progression from CIO to chief digital services officer (CDSO).

    Use this template to create a roadmap on how to transform your career from CIO to CDSO leveraging key strengths and relationships. Focus on opportunities to demonstrate IT’s maturity and the customer experience at the forefront of your decisions.

    • Career Vision Roadmap
    [infographic]

    Further reading

    Implement the Next-Generation IT Operating Model

    The operating model for organizations embracing Exponential IT and transforming into technology-first enterprises.

    Analyst Perspective

    Be the organization that can thrive in an exponential IT world.

    A picture of Carlene McCubbin A picture of Brittany Lutes

    Carlene McCubbin
    Research Practice Lead
    CIO Organizational
    Transformation Practice
    Info-Tech Research Group

    Brittany Lutes
    Research Director,
    CIO Organization Transformation Practice
    Info-Tech Research Group

    IT leaders are increasingly expected to be responsible for understanding and delivering high-value customer experiences. This evolution depends on the distribution and oversight of IT capabilities that are embedded throughout the organizational structure.

    Defining digital strategic objectives, establishing governance frameworks for an autonomous culture, and enabling the organization to act on insightful data are all impossible without a new way of operating that involves the oversight and accountability of advancing IT roles. Through exponential change, functional groups can lose clarity regarding their responsibilities, creating a sense of ambiguity and disorder.

    But adopting a new way of working that supports an exponential IT organization does not have to be difficult. Leveraging Info-Tech Research Group's next-generation operating model, you can clearly demonstrate how the organization will collaborate to deliver on the various digital and IT services. This is no longer just an IT operating model, but a technology-first enterprise model.

    Included in this blueprint:

    Exponential IT Model

    Defines how the Exponential IT model operates and delivers value to the organization.
    This is done by exploring:

    • Exponential IT cultural norms and behaviors
    • Opportunities and risks of the Exponential IT model
    • A breakdown of the embedded, integrated, and centralized aspects of the model
    • Operating model value stream stages
    • An assessment on whether the Exponential IT operating model is right for your organization

    Changing Role of IT Leader

    Defines how chief information officers (CIOs) can operate or elevate their role in this changing operating model.

    • Identifies why the C-suite is changing – again
    • How IT leaders should consider where they will add value in the new operating model
    • Outlines examples of future organization-wide structures and where IT roles are positioned
    • Supports IT leaders in developing themselves to operate in this structure

    Executive Summary

    Your Challenge

    IT is challenged to change how it operates to better support evolving organizations. IT must:

    • Consider the needs of customers, end users, and organization stakeholders simultaneously.
    • Leverage resources strategically to support the various IT and digital services being offered.
    • Create a digital services enablement office to design, monitor, and enhance services continuously.

    While many organizations have projects that support a digital strategy, few have an operating model that supports this digital services strategy.

    Common Obstacles

    Organizations struggle to support the definition and ongoing maintenance of services because:

    • The organization's Digital and IT services offerings are not clear.
    • The functional team accountable to deliver on each IT or Digital service is ambiguous.
    • There are insufficient resources to support all the IT and Digital services being offered.
    • C-suite leaders required to support the services are missing or in the wrong role to effectively lead.
    • Technology has not been standardized to ensure consistency and effectiveness.

    Info-Tech's Approach

    Embrace the IT operating model that focuses on the enablement and delivery of Digital and IT services by:

    • Having technology stakeholders actively collaborate to decide on priorities and deliver on objectives.
    • Leveraging data more effectively across the organization to understand and meet user needs.
    • Ensuring technology architecture and security standards are well-established and followed by all throughout the organization.
    • Allocating dedicated and skilled resources to ensure services can be continuously delivered.

    Info-Tech Insight

    The first IT operating model where customer engagement with IT and Digital Services is at the forefront.

    What is an operating model?

    An IT operating model is a visual representation of the way your IT organization will function using a clear and coherent blueprint. This visualization demonstrates how capabilities are organized and aligned to deliver on the business mission and strategic and technological objectives.

    The should visualize the optimization and alignment of the IT organization to deliver the capabilities required to achieve business goals. Additionally, it should demonstrate the workflow so key stakeholders can understand where inputs flow in and outputs flow out of the IT organization. Investing time in the front-end to get the operating model right is critical. This will give you a framework to rationalize future organizational changes, allowing you to be more iterative and your model to change as the business changes.

    An image of a sample Operating Model

    From computerization to digitization to the new frontier in autonomization, IT has progressively matured, enabling it to actively lead this next stage of business transformation.

    EXPONENTIAL RISK
    Autonomous processes will integrate with human-led processes, creating risks to business continuity, information security, and quality of delivery. Supplier power will exacerbate business risks.

    EXPONENTIAL REWARD
    The efficiency gains and new value chains created through artificial intelligence (AI), robotics, and additive manufacturing will be very significant. Most of this value will be realized through the augmentation of human labor.

    EXPONENTIAL DEMAND
    Autonomous solutions for productivity and back-office applications will eventually become commoditized and provided by a handful of large vendors. There will, however, be a proliferation of in-house algorithms and workflows to autonomize the middle and front office, offered by a busy landscape of industry-centric capability vendors.

    EXPONENTIAL IT

    Exponential IT involves IT leading the cognitive re-engineering of the organization with evolved practices for:

    • IT governance
    • Asset management
    • Vendor management
    • Data management
    • Business continuity management
    • Information security management

    To learn more about IT's journey into autonomization, check out Info-Tech Research Group's Adopt an Exponential IT Mindset blueprint.

    The IT operating model must evolve to respond to exponential change

    • Ensuring customers are not an afterthought to IT leaders. Customers inform how and where IT leaders invest resources to realize organizational objectives.
    • Adopting a formalized approach to service definition and delivery to eliminate silos.
    • Leveraging data throughout the organization to better inform and enable the various digital services in meeting customer demands.
    • Responding to employee demands for development and training opportunities by applying skills in new settings.
    • Having cross-collaboration mechanisms built into the ways of operating to reduce silos across the organization.
    • Enabling services through a strong set of governance and risk mandates and practices.
    • Eliminating the need for IT capabilities to only be within an IT department.

    IT can no longer be just a service provider:

    78% of IT leaders with established digital strategies and 45% of IT leaders with emerging digital strategies are driven by customer experiences.
    Source: Foundry "Digital Business Study,"2023

    40% - The number of CIOs that are responsible for creating new products or services to support revenue generation.
    Source: Foundry, "The State of the CIO," 2023

    This change requires a breakdown of traditional IT-business divisions

    CIOs must recognize that separating IT from the business is restrictive

    • Many organizations have recently completed or are in the process of completing a digital transformation focused on enhanced employee and customer experiences.
    • Post-transformation organizations must change how they operate to continue to deliver on those enhanced experiences, especially for the customer.
    • There must no longer be a wall between IT and the business, but a unified organization offering digital services that include IT components. Already, 81% of work is being performed across the functional boundaries created in an organization (Deloitte, 2023).
    • Effectively designing, delivering, and maintaining these services depends on a Digital Services functional layer, expanding IT's involvement into how the business delivers worthwhile experiences to customers.
    • This Digital Services functional layer will consider whether the new services are better owned by the IT group or another area of the organization.
    • CIOs need to be prepared to adopt a new way of operating or be left to manage a smaller subset of IT functions.

    "I think we've done the IT industry a disservice by constantly referring to IT and the business, artificially creating this wedge."
    – David Vidoni, VP of IT at Pegasystems
    Source: Dan Roberts, CIO, 2023

    Four trends driving an Exponential IT organization include:

    Emerging Technologies

    • 67% of respondents to KPMG's 2022 Global Tech Survey indicated they intend to embrace emerging platforms by the end of 2024.(1)
    • The technology landscape is constantly shifting with artificial intelligence (AI), quantum computing, 5G cellular networks, and next-generation robotics. Each of these technologies requires new capabilities and a new way in which those capabilities are organized.

    Enhanced Customer Experiences

    • 24% of CIOs have been tasked by their CEO to increase the customer experience.(3)
    • Organizations realize that to gain and retain customers, it has become necessary to consistently evaluate service offerings and identify opportunities for enhancement or new services.

    Digital Trust

    • 1/3 of CISOs plan to increase their GRC focus during the next year and 36% have already begun to implement Zero Trust components.(2)
    • Risk and security capabilities mature focusing on defined enterprise accountability, consideration of ethics and inclusivity and proactive security controls.

    Embedded Technology & Skills

    • Spending on embedded software is expected to increase to $21.5 billion by 2027.(4)
    • The technology strategy no longer resides solely within IT. The organization must take ownership of this strategy while they define their digital strategies. Technology services are also embedded.

    (1) "Global Tech Survey," KPMG, 2022
    (2) "Global Digital Trust Insights Report," PwC, 2023
    (3) "State of IT Report," Foundry, 2023
    (4) "Global surge in embedded software demand; here is why," DAC Digital, 2023

    Application of the Four Key Trends on your Exponential IT operating model:

    Respond to Emerging Technology In response to changing customer demands, organizations need to actively seek, assess, and integrate emerging technology offerings easily and effectively. By governing data at an enterprise level and implementing the necessary guardrails in the form of architecture and security standards at the technology layer, it becomes easier to adopt new technologies such as artificial intelligence (AI). This should be tied to any mandated objectives.
    Build Digital Trust Capabilities Finding and hiring the right security professionals has long been a challenge for organizations. In the Exponential IT model, focus on security oversight increases and fewer operational resources are required. The model sees governing IT security processes and vendor delivery as priorities to enable the right technology without exposing the organization to undue risk. There should be more security-related capabilities in your Exponential IT model.
    Elevate the Customer Experience Evolving the organization's digital offering requires understanding of and active response to the changing demands of customers. This is accomplished by leveraging information from organization-wide data sources and the modular components of the organization's current digital offerings. The components can be reconfigured (or new ones added) to create digital services for the customer.
    Formalize Embedded Business Technology & Roles Technology is actively included in the organization's business (digital) strategy. This ensures that technology remains an embedded component of how the organization competes in the market, supplies invaluable services, and delivers on strategic objectives. The separation of IT from the organization becomes redundant.
    Visualize your IT Operating Model.

    Adopting an Exponential IT operating model is typically influenced by resonating with the following drivers:

    Culture

    IT Strategy & Objectives

    Organization Operating Model

    Organization Size & Structure

    Perception of IT

    Risk Appetite

    A cooperative and innovative culture where the organization does not feel constrained by current processes. Establishing a growth mindset across all the organization's groups is reflected by the trust service owners receive.

    Focused on delivering the best customer experience. The roadmap would include ample opportunities to better support the customer in obtaining or exceeding the degree of value they receive from the organization.

    Empowering service owners across the organization to be accountable for the delivery and value of their services. Lots of collaboration among stakeholders who know what services are offered and how those services leverage technology.

    More appropriate for larger organizations due to the resources required to design and enable successful services. IT resources would also be pooled by skills.

    IT is not a service provider but an equal that enables the organization's success. Without IT involvement, digital services may be omitted and opportunities to enhance the customer experience would be missed.

    While innovation and new service offerings are critical to success, there are functional groups that remain focused on defining the level of risk tolerance that supports the appropriate risk appetite to consider new service offerings.

    Section 1: The Next-Generation Operating Model

    The Technology Value Trinity

    Delivery of Business Value & Strategic Needs

    I&T OPERATING MODEL

    DIGITAL & TECHNOLOGY STRATEGY

    I&T GOVERNANCE

    The model for how IT is organized to deliver on business needs and strategies.

    The identification of objectives and initiatives necessary to achieve business goals.

    Ensures the organization and its customers extract maximum value from the use of information and technology.

    All three elements of the Technology Value Trinity work together to deliver business value and achieve strategic needs. As one changes, the others must change as well.
    How do these three elements relate?

    • I&T Operating Model aligns resources, processes, measures, stakeholders, value streams, and decision rights to enable the delivery of your strategy and priorities. This is done by strategically structuring IT capabilities in a way that enables the organization's vision and considers the context in which the model will operate.
    • Digital and IT Strategy tells you what you must achieve to be successful. For an Exponential IT organization, customer demands and digital service offerings would drive strategic decisions.
    • I&T Governance is the confirmation of IT's goals and strategy, which ensures the alignment of IT and business strategy. This is the mechanism by which you continuously prioritize work so that what is delivered aligns with the strategy.

    Strategy, operating models, and governance are too often considered separate practices – strategies are defined without clarity on how to support. A significant change to your strategy necessitates a change to your operating model, which in turn necessitates a change to your governance and organizational structure.

    The Exponential IT operating model delivers value across seven components

    Exponential IT

    Capabilities

    Products, Services and Technology

    Performance Measures

    Stakeholder Engagement & Collaboration

    Decision Rights & Authority

    Value Streams

    Sourcing

    IT capabilities in the Exponential IT model are spread across the organization. The result removes the separation between IT and the organization. Instead, the organization takes accountability for ensuring technology capabilities are delivered.

    Digital service offerings dominate this model, focusing on providing better experiences for customers. Some technology platforms are specific to a service such as access management, while others span service offerings such as architecture or security.

    This model's success is measured by the overall ability to satisfy the customer experience through designing and delivering the right digital service offerings. Service owners are responsible for continuously monitoring and advancing the delivery of the service.

    The end-customer is the main stakeholder for this operating model, where understanding their needs and demands informs the design, maintenance, and improvement of all services. There is no longer IT vs. the business but an organizational perspective of services.

    This model's decision-making spans the organization. The service owners of digital offerings have authority and autonomy deciding which services to design, how they should be integrated with other services, and how those services will continually deliver value to customers.

    Exponential IT's five core value streams are:

    1. Identifying and prioritizing customer needs
    2. Designing IT and Digital Services
    3. Enabling IT & Digital Service success
    4. Assigning skilled employees to deliver services
    5. Owning & managing services

    Internal resource pools might need to be supplemented with contract resources when demand exceeds capacity, requiring a strong partnership with the Vendor Management Team. Service owners will also need to engage and manage the performance of their vendor solution partners.

    Organizations adopting the Exponential IT Model will experience new norms and behaviors

    Customer-Centric
    Dedicated to the customer experience and making sure that the end customer is considered first and foremost.

    "Yes" Approach
    The organization can say yes to emerging technology and customer desires because it has organized itself to be agile in its digital service offerings.

    Digital Service Ownership
    Digital service offerings are owned and managed across the organization ensuring the continuous delivery of value to customers.

    Employee Development
    Resources are organized into pods based on specific skills or functions increasing the likelihood of adopting new skills.

    Autonomization
    Centralized and accessible data provides service owners autonomy when making informed decisions that support enhanced customer experiences.

    Exponential IT is an embedded model approach

    Info-Tech has identified seven common IT operating model archetypes. Each model represents a different approach to who delivers technology services and how. Each model is designed to drive different outcomes, as the way your organization is structured will dictate the way it behaves. The Exponential IT model is an emerging archetype which capitalizes on embedded delivery.

    An image of the exponential IT embedded model approach.

    Centralized

    Shifted

    Embedded

    Owned and operated by leadership within IT. IT takes full responsibility of the functional areas and maintains control over the outcomes.

    Can be owned/operated by a variety of leadership roles throughout the organization. This can shift from IT ownership to other organizational leadership. Decisions about ownership are often made to enable quick response or mitigate risks.

    Owned/operated by leadership outside of traditional IT. Another area of the organization has taken authoritative power over the outcome of this functional area for a quicker response.

    Even as an embedded IT operating model, shifted and centralized IT functions as support

    1. Embedded functions required for scaled autonomation
      Definition and oversight of the organization's strategic direction demonstrated through a customer-first culture, data insights, and a well-defined risk appetite.
    2. Integrated design and optimization of the digital service offering
      Actively considers the customer experience and designs the appropriate services to be delivered. Considers all aspects in the design and delivery of services by exploring opportunities to integrate components to enhance customer experiences or architecting new service offerings to eliminate gaps.
    3. Centralized standards for IT technology, security & resources
      Technology functions continue to deliver exceptional services to the enterprise including clear standards for technology and solution architecture, application of security requirements, and resources to enable various service offerings.

    Opportunities and risks of the Exponential IT model

    Opportunities

    Risks
    • Focused on the end-customer experience and how to ensure that customer remains satisfied and loyal to the organization.
    • The capability center allows resources to be used strategically according to where they would most improve the customer experience.
    • Services are owned by the most appropriate areas within the organization—sometimes IT and other times not. In either case, services should always possess technological knowledge.
    • The organization's transformation strategy is not just driving IT's strategy but how IT should be organized and operating. This eliminates disconnect from larger strategic objectives.
    • Data intelligence and customer insights enable the shifted and centralized areas of the operating model to deliver effective and valuable experiences for all stakeholders.
    • Requires a high degree of maturity to support a variety of individuals in owning IT and digital capabilities.
    • Organizational buy-in to this operating model archetype is a must. IT cannot select this operating model without that support.
    • Processes around how all IT and Digital Services consider security and technology standards need to be well-documented and enforceable.
    • Depending on which leaders oversee the three areas of the model (embedded, shifted, or centralized), power struggles could occur which negatively impact services.
    • This model will demand governance, risk, and culture to be at the forefront of how it operates. If an accountability framework does not exist, expect this model to fail.

    The Exponential IT operating model blends embedded, shifted and centralized delivery to balance agility & risk

    An image of the Exponential IT Operating Model.

    The Exponential IT model commands a new placement and significance of IT capabilities

    Using capabilities for the operating model

    • Capabilities are focused on the entire system that would be in place to satisfy a particular need. This not only includes the people who are able to complete a specific task, but the technology, processes, and resources required to deliver.
    • Focusing on capabilities rather than the individuals in organizational redesign enables a more objective and holistic view of what your organization is striving toward.
    • Capabilities deliver on specific need(s) and how they are organized changes the way those needs are delivered.
    The Exponential IT principles as an image: Strategy and Governance, Financial Management, Service Planning and Architecture, People and Resources, Security and Risk, Applications, Data and Analytics, Infrastructure and Operations, and PPM and Projects.

    1. Embedded functions required for autonomization

    Overview of the function:

    • Focuses on a single strategy and roadmap for the organization that actively includes technology.
    • Governance, risk, compliance, and general oversight are defined and embedded throughout the organization.
    • Ensures that quality data is being generated to help inform the defined digital service offering.
    • Readies the organization to adopt emerging technology quickly and with minimal disruption to other digital service offerings.
    • A team of technical experts that decides what information should exist for operational efficiency or service innovation.

    Embedded functions required for autonomization

    2. Integrated design and optimization of the digital service offering

    Overview of the function:

    • Analyzes and responds to insights about the customer experience.
    • Maintains the portfolio of the organization's digital service offerings.
    • Considers what is necessary to operate efficiently as an organization while simultaneously exploring emerging technology to optimize new or existing digital services.
    • Requires the expertise and involvement of both business-minded and technology-skilled resources.
    • The differentiating factor from other IT operating models is how it holistically considers all the components throughout the organization and how they are connected.

    Integrated design and optimization of the digital service offering

    3. Centralized standards for IT technology, security & resources

    Overview of the function:

    • Compared with other IT operating model archetypes, the Exponential IT model has fewer capabilities that are centralized within the technology function of an organization.
    • Architecture and standards are the foundation of successful embedded delivery, ensuring reuse, improved integration, and a unified experience. This includes technology, risk, data, AI and security architecture, models, and standards.
    • Employee resources are also organized in pods to be leveraged based on greatest need and skills availability.
    • This lets the organization be more agile when innovating and implementing new digital service offerings.

    Centralized standards for IT technology, security & resources

    Exponential IT explores new value stream stages

    Customer Perspective

    The organization is continually anticipating their wants and needs and establishing mechanisms to vocalize those needs.

    Customer receives the right IT and digital services to respond to their needs.

    The service is easy to use and continuously responds to wants and needs.

    The service is meeting expectations or exceeding them.

    There is a dedicated service owner who can hear demands and feedback, then action desirable outcomes.

    Value Stream Stages

    An image of the Value Stream

    Organizational Perspective

    Expected Outcome

    Customers' wants and needs are understood and at times anticipated before the customer requests them.

    Assess needs to determine if service is already offered or needs to be created. Design services that will enhance the customer experience.

    Look for opportunities to integrate processes and resources to increase the performance of IT and Digital Services.

    Ensure that the right employees with the right skills are working to develop or enhance service offering.

    The service owner manages the ongoing lifecycle of the service and establishes a roadmap on how value will continue to be delivered.

    Critical Processes

    • Customer experience
    • Research and innovation
    • Stakeholder management
    • Research and innovation
    • Service design & portfolio management
    • Performance management
    • Continuous improvement
    • Integration planning
    • Service management
    • Resource planning and allocation
    • Service strategy & roadmap
    • Service governance
    • Service performance management

    Metrics

    • Customer satisfaction score
    • Service-to-need alignment
    • Gaps in service portfolio
    • Speed to design services
    • Service performance
    • Service adoption
    • Time to resolve customer demand
    • Frequency by which service requires enhancements
    • Service satisfaction
    • Alignment of service strategy to organization strategy

    1.1 Assess if the Exponential IT operating model is right for your organization

    1 hour

    1. Begin by downloading the Exponential IT Operating Model Assessment.
    2. Review the questions within each of the operating model components. For each question, use the drop-down menu to determine your level of agreement.
    3. The more your organization agrees with the statements, the more likely your organization is prepared to implement an Exponential IT operating model.
    4. The less your organization agrees with the statements, the more likely you should adopt a different IT operating model.
    5. For support implementing the Exponential IT or another IT operating model, explore the Visualize Your IT Operating Model blueprint (coming soon).

    Input

    • Desire to change the organization's IT & Digital operating model

    Output

    • Desire to implement the IT & Digital Service Enablement operating model

    Materials

    • Exponential IT Operating Model Assessment

    Participants

    • Executive IT leadership
    • Business leadership

    Explore other Info-Tech research to support your organization transformation initiatives

    Visualize the IT Operating Model blueprint (coming soon)

    Visualize the IT Operating Model blueprint (coming soon)

    Redesign Your IT Organizational Structure

    Redesign Your IT Organizational Structure

    Section 2: Elevating the CIO Role

    The next generation of IT C-suite roles are here

    As the operating model changes and becomes increasingly embedded into the organization's delivery of IT and Digital Services, new C-suite roles are being defined

    • One of the most critical roles being defined in this change is the Chief Digital Services Officer (CDSO) who focuses on all components of the digital experience from the lens of the customer.
    • There are two directions from which the CDSO role is typically approached as it gains popularity:
      • CIOs evolve beyond just information and technology—focusing on how IT & Digital Services enhance the customer experience
      • Business leaders who have technical know-how increase their involvement and responsibility over IT related functions
    • IT leaders need to consider where they would rather sit: focused only on technology and remaining a service provider to the organization, or embedding technology into the services, products, and organization in general?

    60%

    The number of APAC CIOs who can anticipate their job to be challenged by their peers within the organization.

    Source: Singh, Yashvendra, CIO, 2023.

    Info-Tech Insight

    This is not about making the CIO report to someone else but allowing the CIO to elevate their role into that of a CDSO.

    Increasing IT leadership's span of control throughout the organization

    As maturity increases so does span of control, ownership & executive influence

    Organizations hoping to fully adopt the Exponential IT operating model require a shift in leadership expectations. Notably, these leaders will have oversight and accountability for functions beyond the traditional IT group.

    As the organization matures its governance, security, and data management practices, increasing how it delivers high-impact experiences to customers, it would have one leader who owns all the components to ensure clear alignment with goals and business strategy.

    An image of a graph where the X axis is labeled Span of Control & Influence, and the Y axis is Organization Maturity.

    Emerging Exponential IT organizations will have distributed authority

    • Organizations beginning their transition toward an exponential model often continue to have distributed leaders providing oversight of distinct functional areas.
    • Their spans of control are smaller, but very clearly defined, eliminating confusion through a transparent accountability framework.
    • Each leader strives toward optimization and efficiency regarding IT capabilities, for which they are responsible.
    1. Distributed Leadership
      Embedded functions required for scaled autonomation
      Distributed leaders identify the ways technology will enable them to advance enterprise objectives while maintaining autonomy over their own functions. They may oversee technology.
    2. Experience Officer
      Integrated design and optimization of the digital service offering
      An Experience Officer will help consider the insights gained from enterprise data and make informed decisions around enterprise service offerings. They actively explore new ways to deliver high-value experiences.
    3. Chief Technology Officer (CTO)
      Centralized standards for IT technology, security & resources
      A CTO will continue to oversee the core technology, including infrastructure and service management functions.

    Established organizations will be driven by a digital transformation journey

    • Organizations that have begun to deliver on their transformation journey will typically see two distinct C-suite leaders emerge—the CIO and the CDO.
    • The Chief Digital Officer (CDO) often explores ways to optimize the integration and management of data to enable insightful decision making from the organization.
    • The Chief Information Officer (CIO), however, considers mechanisms to standardize how new technologies can be integrated with the architecture.
    • While both leaders have distinct responsibilities, their roles intersect at the customer experience.

    An image of the digital transformation journey

    Advanced organizations will be managed by a single emerging role

    • A single leader will oversee all the functional areas where value is delivered and enabled by IT capabilities.
    • Through a large span of control, this leader can holistically consider opportunities to optimize the customer experience and ensure recommendations are actioned to deliver on that enhanced experience.
    • This leader's span of control will require a strong understanding of both strategic and operational functions to authoritatively oversee all aspects for which they are responsible.

    CDSO – Chief Digital Service Officer

    1. Embedded functions required for scaled autonomation
      The CDSO will set, oversee, and manage the delivery of an enterprise's digital strategy, ensuring accountability through good governance and data practices.
    2. Integrated design and optimization of the digital service offering
      They ensure that the enterprise holistically considers the various services that could be offered to exceed customer expectations through high-impact experiences.
    3. Centralized standards for IT technology, security & resources
      They also ensure stable and secure architecture standards to enable consistency across the organization and a seamless ability to integrate new technology to support service offerings.

    Evolution of the IT C-suite now includes the CDSO

    Chief Digital Service Officer

    Chief Information Officer

    Chief Digital Officer

    Chief Technology Officer

    Chief Experience Officer

    Main Stakeholder(s):

    • Board
    • CEO/Executive Leadership
    • Organization Leadership
    • Service Owners
    • Customers & End Users

    Main Responsibilities:

    • Oversight of the entire portfolio of IT and Digital Services
    • Use of information & technology to meet organizational objectives

    *Some leaders in this role are being called Chief Digital Information Officer.

    Main Stakeholder(s):

    • Board
    • CEO/Executive Leadership
    • Organization Leadership
    • End Users

    Main Responsibilities:

    • Oversight of the information and technology required to support and enable the organization

    Main Stakeholder(s):

    • Board
    • CEO/Executive Leadership
    • Customers & End Users

    Main Responsibilities:

    • Oversight on transforming how the organization uses technology, often considering customer perspectives

    Main Stakeholder(s):

    • Organization Leadership
    • Customers & End Users

    Main Responsibilities:

    • Collaborating with the CIO, the CTO leads the organization's ability to integrate and adopt necessary technology products and services

    Main Stakeholder(s):

    • Customers & End Users

    Main Responsibilities:

    • Establish the customer experience strategy
    • Create policies to support that strategy
    • Collaborate with other organizational leaders to integrate any activities around the customer experience

    Examples of what the emerging organizational structure can look like

    An image of three hierarchies, showing what the emerging organizational structure can look like.

    This is more than a new title for IT leaders

    It's about establishing a business first perspective

    • IT leaders exploring this new way of operating are not just adopting the new title of CDSO or CDIO.
    • These leaders must change how information, technology, and digital experiences are consumed across the various stakeholders – especially the end customer.
    • IT leaders who pursue this new IT operating model choose to be more than order takers for an organization.
    • They are:
      • Partners in defining the organization's digital service offerings
      • Recognizing the benefits of distributing decision-making authority for IT-related aspects to others throughout the organization
      • Prioritizing capabilities like portfolio management, architecture, vendor management, relationship management, cloud and user experience

    "'For me, the IT portfolio for the next few years and the IT architecture have taken the place that IT strategy used to have,' he adds. This view doesn't position IT outside of the organization, but rather gives it central importance in the company."
    – Bernd Rattey, Group CIO and CDO of Deutsche Bahn (DB), qtd. by Jens Dose, CIO, 2023

    1.2 Plan your career move to CDSO

    1-3 hours

    • Create a roadmap on how to move from your current role to CDSO by identifying current strengths and opportunities to improve.
    • Download the Career Vision Roadmap Tool from the website. An example of this is on the next slide.
    • Document the tagline. This is your overarching career focus and goal – what is your passion? Think beyond titles to what you want to be doing, the atmosphere you want to be in, and what you want to add value to.
    • Document the current role: what are the strengths, achievements and opportunities?
    • Consider the CDSO role: how will you build stronger relationships and competencies to elevate your profile within the organization? What is an example of what someone would display in this role?
    • Define specific roles or stakeholders that you should develop a stronger relationship with.

    Download the Career Vision Roadmap Tool

    Input

    • Desire to implement the IT & Digital Service Enablement Operating Model

    Output

    • Roadmap to elevate from a CIO to a CDSO

    Materials

    • Career Vision Roadmap
    • IT & Digital Services Enablement operating model archetype
    • CDSO job profile

    Participants

    • CIO (or any other role aspiring to eventually become a CDSO)
    • Individual activity

    Career Vision Roadmap:
    Executive Leader
    Akbar K.

    Sample

    To provide customers with an exceptional experience by ensuring all IT and Digital Services consider and anticipate their needs or wants. Enable IT and Digital Services to be successful through clear leadership, strong collaboration, and continuous improvement or innovation.

    CIO

    1. Establish technology standards that enable the organization to consistently and securely integrate platforms or solutions.
    2. Lead the project team that defined and standardized the organization's reference architecture.
    3. Need to work on listening to a variety of stakeholder demands rather than only specific roles/titles.

    Transition

    • Strengths: Technology acumen, budget planning, allocating resources
    • Enhance: Stakeholder relationship management.
    • Work with current CDO to define and implement more digital transformation initiatives.

    CDSO

    • Being responsive to customer expectations and communicating clear and realistic timelines.
    • Establish trust among the organization that services will deliver expected value.
    • Empowering service owners to manage and oversee the delivery of their services.

    Network Opportunities

    • Connect with board members and understand each of their key areas of priority.
    • Begin to interact with end customers and define ways that will enhance their customer experience.
    • Chief Digital Officer

    Actions now in line with aspiration

    Appendix: Capabilities & Capability Model

    IT and digital capabilities

    Using capabilities for the operating model:

    • Capabilities are focused on the entire system that would be in place to satisfy a particular need. This not only includes people who have skills to complete a specific task, but also the technology, processes, and resources required to deliver.
    • Focusing on capabilities rather than the individuals in organizational redesign enables a more objective and holistic view of what your organization is striving toward.
    • Capabilities deliver on specific need(s) and how they are organized changes the way those need(s) are delivered.

    An image of the IT Management and Governance Framework.

    Strategic Direction

    • IT Governance
    • Strategic Planning
    • Digital Strategy
    • Performance Measurement
    • IT Management & Policies
    • Organizational Quality Management
    • R&D and Innovation
    • Stakeholder Management

    People & Resources

    • Strategic Communications
    • People Resource Management
    • Workforce Strategy & Planning
    • Organizational Change Enablement
    • Adoption & Training
    • Financial/Budget Management
    • Vendor Portfolio Management
    • Vendor Selection & Contract Management
    • Vendor Performance Management

    Architecture & Integration

    • Enterprise Architecture Delivery
    • Business Architecture Delivery
    • Solution Architecture Delivery
    • Technology Architecture
    • Data Architecture
    • Security Architecture
    • Process Integration
    • Integration Planning

    Service Planning

    • Service Governance
    • Service Strategy & Roadmap
    • Service Management
    • Service Governance
    • Service Performance Measurement
    • Service Design & Planning
    • Service Orchestration

    Security & Risk

    • Security Strategic Planning
    • Risk Management
    • External Compliance Management
    • Security Response & Recovery Management
    • Security Management
    • Controls & Internal Audit Planning
    • Security Defense Operations
    • Security Administration
    • Cybersecurity Threat Intelligence
    • Integrated Physical/IT Security
    • OT/IoT Security
    • Data Protection & Privacy

    Application Delivery

    • Application Lifecycle Management
    • Systems Integration Management
    • Application Development
    • User Experience
    • Quality Assurance & UAT
    • Application Maintenance
    • Low Code Development

    Project Portfolio Management

    • Demand Management
    • Requirement Analysis Management
    • Portfolio Management
    • Project Management

    Data & Business Intelligence (BI)

    • Reporting & Analytics
    • Data Management
    • Data Quality
    • Data Integration
    • Enterprise Content Management
    • Data Governance
    • Data Strategy
    • AI/ML Management

    Service Delivery

    • Operations Management
    • Service Desk Management
    • Incident Management
    • Problem Management
    • Service Enhancements
    • Operational Change Enablement
    • Release Management
    • Automation Management

    Infrastructure & Operations

    • Asset Management
    • Infrastructure Portfolio Strategic Planning
    • Availability & Capacity Management
    • Network & Infrastructure Management
    • Configuration Management
    • Cloud Orchestration
    An image of the summary slide for this blueprint, with the headings: Centralized; Shifted; and Embedded.

    Research Contributors and Experts

    Donna Bales
    Principal Research Director
    Info-Tech Research Group

    Scott Bickley
    Practice Lead – Vendor Management Practice
    Info-Tech Research Group

    Christine Coz
    Executive Counselor – Executive Services
    Info-Tech Research Group

    Valence Howden
    Principal Research Director
    Info-Tech Research Group

    Duraid Ibrahim
    Executive Counselor – Executive Services
    Info-Tech Research Group

    Chris Goodhue
    Managing Partner– Executive Services
    Info-Tech Research Group

    Carlene McCubbin
    Practice Lead – CIO Practice
    Info-Tech Research Group

    Mike Tweedie
    Practice Lead – CIO Practice
    Info-Tech Research Group

    Vicki van Alphen
    Executive Counselor – Executive Services
    Info-Tech Research Group

    *Plus an additional 5 industry experts who anonymously contributed to this research piece.

    Related Info-Tech Research

    Adopt an Exponential IT Mindset

    • To succeed in the coming business transformation, IT will have to adopt different priorities in its mission, governance, capabilities, and partnerships.
    • CIOs will have to provide exceptionally mature services while owning business targets.

    Become a Transformational CIO

    • Business transformations are happening, but CIOs are often involved only when it comes time to implement change. This makes it difficult for the CIO to be perceived as an organizational leader.
    • Elevate your stature as a business leader.
    • Create a high-powered IT organization that is focused on driving lasting change, improving client experiences, and encouraging collaboration across the entire enterprise.

    Define Your Digital Business Strategy

    • Design a strategy that applies innovation to your business model, streamline and transform processes, and make use of technologies to enhance interactions with customers and employees.
    • Pre-pandemic digital strategies have been primarily focused on automation. However, your post-pandemic digital strategy must focus on driving resilience for growth opportunities.

    Bibliography

    Bennet, Trevon. "What is a Chief Experience Officer (CXO)? And what do they do?" Indeed, 14 March 2023. https://www.indeed.com/career-advice/finding-a-job/what-is-chief-experience-officer#:~:text=A%20CXO%20plans%20strategies%20and,customer%20acquisition%20and%20retention%20strategies
    Bishop, Carrie. "Five years of Digital Services in San Francisco." Medium, 20 January 2022. https://medium.com/san-francisco-digital-services/five-years-of-digital-services-in-san-francisco-805a758c2b83
    DAC Digital and Chawla, Yash. "Global surge in embedded software demand; here is why." DAC Digital, 2023 <ttps://dac.digital/global-surge-in-embedded-software-demand-here-is-why/
    Deloitte. "If you want your digital transformation to succeed, align your operating model to your strategy." Harvard Business Review, 31 January 2020. https://hbr.org/sponsored/2020/01/if-you-want-your-digital-transformation-to-succeed-align-your-operating-model-to-your-strategy.
    Deloitte. "2023 Global Human Capital Trends Report." Deloitte, 2023. https://www2.deloitte.com/content/dam/Deloitte/sg/Documents/human-capital/sea-cons-hc-trends-report-2023.pdf
    Dose, Jens. "Deutsche Bahn CIO on track to decentralize IT." CIO, 19 April 2023. https://www.cio.com/article/473071/deutsche-bahn-cio-on-track-to-decentralize-it.html
    Ehrlich, Oliver., Fanderl, Harald., Maldara, David., & Mittangunta, Divya. "How the operating model can unlock the power of customer experience." McKinsey, 28 June 2022. https://www.mckinsey.com/capabilities/growth-marketing-and-sales/our-insights/how-the-operating-model-can-unlock-the-full-power-of-customer-experience
    FCW. "Digital Government Summit Agenda." FCW. 2021. https://events-archive.fcw.com/events/2021/digital-government-summit/index.html
    Foundry. "State of the CIO." IDG, 25 January 2023. https://foundryco.com/tools-for-marketers/research-state-of-the-cio/
    Foundry. "Digital Business Study 2023: IT Leaders are future-proofing their business with digital strategies." IDG, 2023. https://foundryco.com/tools-for-marketers/research-digital-business/
    Indeed Editorial Team. "Centralized vs. Decentralized Structures: 7 Key Differences." Indeed, 10 March 2023. https://www.indeed.com/career-advice/career-development/centralized-vs-decentralized
    Indeed Editorial Team. "What is process integration?." Indeed, 14 November 2022. https://ca.indeed.com/career-advice/career-development/process-integration#:~:text=Process%20integration%2C%20or%20business%20process,it%20reach%20its%20primary%20objectives
    KPMG International. "Global Tech Report." KPMG, 2022.
    McHugh, Brian. "Service orchestration is reshaping IT—Here's what to know." Active Batch, 8 November 2022. https://www.advsyscon.com/blog/service-orchestration-what-is/
    Morris, Chris. "IDC FutureScape: Worldwide CIO Agenda 2023 Predictions."" IDC, January, 2023. https://www.idc.com/getdoc.jsp?containerId=AP49998523
    PwC. "Global Digital Trust Insights Report." PwC, 2023
    Roberts, Dan. "5 CIOs on building a service-oriented IT culture." CIO, 13 April 2023. https://www.cio.com/article/472805/5-cios-on-building-a-service-oriented-it-culture.html
    Singh, Yashvendra. "CIOs must evolve to stave off existential threat to their role." CIO, 30 March 2023. https://www.cio.com/article/465612/cios-must-evolve-to-stave-off-existential-threat-to-their-role.html
    Spacey, John. "16 Examples of IT Services." Simplicable, 28 January 2018. https://simplicable.com/IT/it-services

    Mandate Data Valuation Before It’s Mandated

    • Buy Link or Shortcode: {j2store}121|cart{/j2store}
    • member rating overall impact: 8.0/10 Overall Impact
    • member rating average dollars saved: $25,000 Average $ Saved
    • member rating average days saved: 10 Average Days Saved
    • Parent Category Name: Data Management
    • Parent Category Link: /data-management
    • Data can be valuable if used properly or dangerous when mishandled.
    • The organization needs to understand the value of their data before they can establish proper data management practice.
    • Data is not considered a capital asset unless there is a financial transaction (e.g. buying or selling data assets).
    • Data valuation is not easy, and it costs money to collect, store, and maintain data.

    Our Advice

    Critical Insight

    • Data always outlives people, processes, and technology. They all come and go, while data remains.
    • Oil is a limited resource, data is not. Contrary to oil, data is likely to grow over time.
    • Data is likely to outlast all other current popular financial instruments including currency, assets, or commodities.
    • Data is used internally and externally and can easily be replicated or combined.
    • Data is beyond currency, assets, or commodities and needs to be a category of its own.

    Impact and Result

    • Every organization must calculate the value of their data. This will enable organizations to become truly data-driven.
    • Too much time has been spent arguing different methods of valuation. An organization must settle on valuation that is acceptable to all its stakeholders.
    • Align data governance and data management to data valuation. Often organizations struggle to justify data initiatives due to lack of visibility in data valuation.
    • Establish appropriate roles and responsibilities and ensure alignment to a common set of goals as a foundation to get the most accurate future data valuation for your organization.
    • Assess organization data assets and implementation roadmap that considers the necessary competencies and capabilities and their dependencies in moving towards the higher maturity of data assets.

    Mandate Data Valuation Before It’s Mandated Research & Tools

    Start here – read the Executive Brief

    Read our concise Executive Brief to understand the value associated with the organization's data. Review Info-Tech’s methodology for assessing data value and justifying your data initiatives with a value proposition.

    Besides the small introduction, subscribers and consulting clients within this management domain have access to:

    1. Demystify data valuation

    Understand the benefits of data valuation.

    • Mandate Data Valuation Before It’s Mandated – Phase 1: Demystify Data Valuation

    2. Data value chain

    Learn about the data value chain framework and preview the step-by-step guide to start collecting data sources.

    • Mandate Data Valuation Before It’s Mandated – Phase 2: Data Value Chain

    3. Data value assessment

    Mature your data valuation by putting in the valuation dimensions and metrics. Establish documented results that can be leveraged to demonstrate value in your data assets.

    • Mandate Data Valuation Before It’s Mandated – Phase 3: Data Value Assessment
    [infographic]

    Workshop: Mandate Data Valuation Before It’s Mandated

    Workshops offer an easy way to accelerate your project. If you are unable to do the project yourself, and a Guided Implementation isn't enough, we offer low-cost delivery of our project workshops. We take you through every phase of your project and ensure that you have a roadmap in place to complete your project successfully.

    1 Understand the Value of Data Valuation

    The Purpose

    Explain data valuation approach and value proposition.

    Key Benefits Achieved

    A clear understanding and case for data valuation.

    Activities

    1.1 Review common business data sources and how the organization will benefit from data valuation assessment.

    1.2 Understand Info-Tech’s data valuation framework.

    Outputs

    Organization data valuation priorities

    2 Capture Organization Data Value Chain

    The Purpose

    Capture data sources and data collection methods.

    Key Benefits Achieved

    A clear understanding of the data value chain.

    Activities

    2.1 Assess data sources and data collection methods.

    2.2 Understand key insights and value proposition.

    2.3 Capture data value chain.

    Outputs

    Data Valuation Tool

    3 Data Valuation Framework

    The Purpose

    Leverage the data valuation framework.

    Key Benefits Achieved

    Capture key data valuation dimensions and align with data value chain.

    Activities

    3.1 Introduce data valuation framework.

    3.2 Discuss key data valuation dimensions.

    3.3 Align data value dimension to data value chain.

    Outputs

    Data Valuation Tool

    4 Plan for Continuous Improvement

    The Purpose

    Improve organization’s data value.

    Key Benefits Achieved

    Continue to improve data value.

    Activities

    4.1 Capture data valuation metrics.

    4.2 Define data valuation for continuous monitoring.

    4.3 Create a communication plan.

    4.4 Define a plan for continuous improvements.

    Outputs

    Data valuation metrics

    Data Valuation Communication Plan

    Establish a Sustainable ESG Reporting Program

    • Buy Link or Shortcode: {j2store}194|cart{/j2store}
    • member rating overall impact: N/A
    • member rating average dollars saved: N/A
    • member rating average days saved: N/A
    • Parent Category Name: IT Governance, Risk & Compliance
    • Parent Category Link: /it-governance-risk-and-compliance

    Consistent, high-quality disclosure of ESG practices is the means by which organizations can demonstrate they are acting responsibly and in the best interest of their customers and society. Organizations may struggle with these challenges when implementing an ESG reporting program:

    • Narrowing down ESG efforts to material ESG issues
    • Building a sustainable reporting framework
    • Assessing and solving for data gaps and data quality issues
    • Being aware of the tools and best practices available to support regulatory and performance reporting

    Our Advice

    Critical Insight

    • A tactical approach to ESG reporting will backfire. The reality of climate change and investor emphasis is not going away. For long-term success, organizations need to design an ESG reporting program that is flexible, interoperable, and digital.
    • Implementing a robust reporting program takes time. Start early, remain focused, and make plans to continually improve data quality and collection and performance metrics.
    • The “G” in ESG may not be capturing the limelight under ESG legislation yet, but there are key factors within the governance component that are under the regulatory microscope, including data, cybersecurity, fraud, and diversity and inclusion. Be sure you stay on top of these issues and include performance metrics in your internal and external reporting frameworks.

    Impact and Result

    • Successful organizations recognize that transparent ESG disclosure is necessary for long-term corporate performance.
    • Taking the time up front to design a robust and proactive ESG reporting program will pay off in the long run.
    • Future-proof your ESG reporting program by leveraging new tools, technologies, and software applications.

    Establish a Sustainable ESG Reporting Program Research & Tools

    Besides the small introduction, subscribers and consulting clients within this management domain have access to:

    1. Establish a Sustainable ESG Reporting Program Storyboard – A comprehensive framework to define an ESG reporting program that supports your ESG goals and reporting requirements.

    This storyboard provides a three-phased approach to establishing a comprehensive ESG reporting framework to drive sustainable corporate performance. It will help you identify what to report, understand how to implement your reporting program, and review in-house and external software and tooling options.

    • Establish a Sustainable ESG Reporting Program Storyboard

    2. ESG Reporting Workbook – A tool to document decisions, rationale, and implications of key activities to support your ESG reporting program.

    The workbook allows IT and business leaders to document decisions as they work through the steps to establish a comprehensive ESG reporting framework.

    • ESG Reporting Workbook

    3. ESG Reporting Implementation Plan – A tool to document tasks required to deliver and address gaps in your ESG reporting program.

    This planning tool guides IT and business leaders in planning, prioritizing, and addressing gaps to build an ESG reporting program.

    • ESG Reporting Implementation Plan Template

    4. ESG Reporting Presentation Template – A guide to communicate your ESG reporting approach to internal stakeholders.

    Use this template to create a presentation that explains the drivers behind the strategy, communicates metrics, demonstrates gaps and costs, and lays out the timeline for the implementation plan.

    • ESG Reporting Presentation Template

    Infographic

    Workshop: Establish a Sustainable ESG Reporting Program

    Workshops offer an easy way to accelerate your project. If you are unable to do the project yourself, and a Guided Implementation isn't enough, we offer low-cost delivery of our project workshops. We take you through every phase of your project and ensure that you have a roadmap in place to complete your project successfully.

    1 Determine Material ESG Factors

    The Purpose

    Determine material ESG factors.

    Key Benefits Achieved

    Learn how to identify your key stakeholders and material ESG risks.

    Activities

    1.1 Create a list of stakeholders and applicable ESG factors.

    1.2 Create a materiality map.

    Outputs

    List of stakeholders and applicable ESG factors

    Materiality map

    2 Define Performance and Reporting Metrics

    The Purpose

    Define performance and reporting metrics.

    Key Benefits Achieved

    Align your ESG strategy with key performance metrics.

    Activities

    2.1 Create a list of SMART metrics.

    2.2 Create a list of reporting obligations.

    Outputs

    SMART metrics

    List of reporting obligations

    3 Assess Data and Implementation Gaps

    The Purpose

    Assess data and implementation gaps.

    Key Benefits Achieved

    Surface data and technology gaps.

    Activities

    3.1 Create a list of high-priority data gaps.

    3.2 Summarize high-level implementation considerations.

    Outputs

    List of high-priority data gaps

    Summary of high-level implementation considerations

    4 Consider Software and Tooling Options

    The Purpose

    Select software and tooling options and develop implementation plan.

    Key Benefits Achieved

    Complete your roadmap and internal communication document.

    Activities

    4.1 Review tooling and technology options.

    4.2 Prepare ESG reporting implementation plan.

    4.3 Prepare the ESG reporting program presentation.

    Outputs

    Selected tooling and technology

    ESG reporting implementation plan

    ESG reporting strategy presentation

    Further reading

    Establish a Sustainable ESG Reporting Program

    Strengthen corporate performance by implementing a holistic and proactive reporting approach.

    Analyst Perspective

    The shift toward stakeholder capitalism cannot be pinned on one thing; rather, it is a convergence of forces that has reshaped attitudes toward the corporation. Investor attention on responsible investing has pushed corporations to give greater weight to the achievement of corporate goals beyond financial performance.

    Reacting to the new investor paradigm and to the wider systemic risk to the financial system of climate change, global regulators have rapidly mobilized toward mandatory climate-related disclosure.

    IT will be instrumental in meeting the immediate regulatory mandate, but their role is much more far-reaching. IT has a role to play at the leadership table shaping strategy and assisting the organization to deliver on purpose-driven goals.

    Delivering high-quality, relevant, and consistent disclosure is the key to unlocking and driving sustainable corporate performance. IT leaders should not underestimate the influence they have in selecting the right technology and data model to support ESG reporting and ultimately support top-line growth.

    Photo of Yaz Palanichamy

    Yaz Palanichamy
    Senior Research Analyst
    Info-Tech Research Group

    Photo of Donna Bales

    Donna Bales
    Principal Research Director
    Info-Tech Research Group

    Executive Summary

    Your Challenge

    Your organization needs to define a ESG reporting strategy that is driven by corporate purpose.

    Climate-related disclosure mandates are imminent; you need to prepare for them by building a sustainable reporting program now.

    There are many technologies available to support your ESG program plans. How do you choose the one that is right for your organization?

    Common Obstacles

    Knowing how to narrow down ESG efforts to material ESG issues for your organization.

    Understanding the key steps to build a sustainable ESG reporting program.

    Assessing and solving for data gaps and data quality issues.

    Being aware of the tools and best practices available to support regulatory and performance reporting.

    Info-Tech’s Approach

    Learn best-practice approaches to develop and adopt an ESG reporting program approach to suit your organization’s unique needs.

    Understand the key features, tooling options, and vendors in the ESG software market.

    Learn through analyst insights, case studies, and software reviews on best-practice approaches and tool options.

    Info-Tech Insight

    Implementing a robust reporting program takes time. Start early, remain focused, and plan to continually improve data quality and collection and performance metrics

    Putting “E,” “S,” and “G” in context

    Corporate sustainability depends on managing ESG factors well

    Environmental, social, and governance are the components of a sustainability framework that is used to understand and measure how an organization impacts or is affected by society as a whole.

    Human activities, particularly fossil fuel burning since the middle of the twentieth century, have increased greenhouse gas concentration, resulting in observable changes to the atmosphere, ocean, cryosphere, and biosphere. The “E” in ESG relates to the positive and negative impacts an organization may have on the environment, such as the energy it takes in and the waste it discharges.

    The “S” in ESG is the most ambiguous component in the framework, as social impact relates not only to risks but also to prosocial behavior. It’s the most difficult to measure but can have significant financial and reputational impact on corporations if material and poorly managed.

    The “G” in ESG is foundational to the realization of “S” and “E.” It encompasses how well an organization integrates these considerations into the business and how well the organization engages with key stakeholders, receives feedback, and is transparent with its intentions.

    A diagram that shows common examples of ESG issues.

    The impact of ESG factors on investment decisions

    Alleviate Investment Risk

    Organizational Reputation: Seventy-four percent of those surveyed were concerned that failing to improve their corporate ESG performance would negatively impact their organization’s branding and overall reputation in the market (Intelex, 2022).

    Ethical Business Compliance: Adherence to well-defined codes of business conduct and implementation of anti-corruption and anti-bribery practices is a great way to distinguish between organizations with good/poor governance intentions.

    Shifting Consumer Preferences: ESG metrics can also largely influence consumer preferences in buying behavior intentions. Research from McKinsey shows that “upward of 70 percent” of consumers surveyed on purchases in multiple industries said they would pay an additional 5 percent for a green product if it met the same performance standards as a nongreen alternative (McKinsey, 2019).

    Responsible Supply Chain Management: The successful alignment of ESG criteria with supply chain operations can lead to several benefits (e.g. producing more sustainable product offerings, maintaining constructive relationships with more sustainability-focused suppliers).

    Environmental Stewardship: The growing climate crisis has forced companies of all sizes to rethink how they plan their corporate environmental sustainability practices.

    Compliance With Regulatory Guidelines: An increasing emphasis on regulations surrounding ESG disclosure rates may result in some institutional investors taking a more proactive stance toward ESG-related initiatives.

    Sustaining Competitive Advantage: Given today’s globalized economy, many businesses are constantly confronted with environmental issues (e.g. water scarcity, air pollution) as well as social problems (e.g. workplace wellness issues). Thus, investment in ESG factors is simply a part of maintaining competitive advantage.

    Leaders increasingly see ESG as a competitive differentiator

    The perceived importance of ESG has dramatically increased from 2020 to 2023

    A diagram that shows the perceived importance of ESG in 2020 and 2023.

    In a survey commissioned by Schneider Electric, researchers categorized the relative importance of ESG planning initiatives for global IT business leaders. ESG was largely identified as a critical factor in sustaining competitive advantage against competitors and maintaining positive investor/public relations.
    Source: S&P Market Intelligence, 2020; N=825 IT decision makers

    “74% of finance leaders say investors increasingly use nonfinancial information in their decision-making.”
    Source: EY, 2020

    Regulatory pressure to report on carbon emission is building globally

    The Evolving Regulatory Landscape

    Canada

    • Canadian Securities Administrators (CSA) NI 51-107 Disclosure of Climate-related Matters

    United States

    • Securities and Exchange Commission (SEC) 33-11042 – The Enhancement and Standardization of Climate-Related Disclosures for Investors
    • SEC 33-11038 Cybersecurity Risk Management, Strategy, Governance, and Incident Disclosure
    • Nasdaq Board Diversity Rule (5605(f))

    Europe

    • European Commission Sustainable Finance Disclosure Regulation (SFDR)
    • European Commission EU Supply Chain Act
    • The German Supply Chain Act (GSCA)
    • Financial Conduct Authority UK Proposal (DP 21/4) Sustainability Disclosure Requirements and investment labels
    • UK Modern Slavery Act, 2015

    New Zealand

    • The Financial Sector (Climate-related Disclosures and Other Matters) Amendment Act 2021

    Accurate ESG reporting will be critical to meet regulatory requirements

    ESG reporting is the disclosure of environmental, social, and governance (ESG) data via qualitative and quantitative reports.

    It is how organizations make their sustainability commitments and strategies transparent to stakeholders.

    For investors it provides visibility into a company's ESG activities, enabling them to align investments to their values and avoid companies that cause damage to the environment or are offside on social and governance issues.

    Despite the growing practice of ESG reporting, reporting standards and frameworks are still evolving and the regulatory approach for climate-related disclosure is inconsistent across jurisdictions, making it challenging for organizations to develop a robust reporting program.

    “Environmental, social and governance (ESG) commitments are at the core a data problem.”

    Source: EY, 2022

    However, organizations will struggle to meet reporting requirements

    An image that shows 2 charts: How accurately can your organization report on the impact of its ESG Initiatives; and More specifically, if it was required to do so, how accurately could your organization report on its carbon footprint.

    Despite the commitment to support an ESG Initiative, less than a quarter of IT professionals say their organization can accurately report on the impact of its ESG initiatives, and 44% say their reporting on impacts is not accurate.

    Reporting accuracy was even worse for reporting on carbon footprint with 46% saying their organization could not report on its carbon footprint accurately. This despite most IT professionals saying they are working to support environmental mandates.

    Global sustainability rankings based on ESG dimensions

    Global Country Sustainability Ranking Map

    An image of Global Country Sustainability Ranking Map, with a score of 0 to 10.

    Country Sustainability Scores (CSR) as of October 2021
    Scores range from 1 (poor) to 10 (best)
    Source: Robeco, 2021

    ESG Performance Rankings From Select Countries

    Top ESG and sustainability performer

    Finland has ranked consistently as a leading sustainability performer in recent years. Finland's strongest ESG pillar is the environment, and its environmental ranking of 9.63/10 is the highest out of all 150 countries.

    Significant score deteriorations

    Brazil, France, and India are among the countries whose ESG score rankings have deteriorated significantly in the past three years.

    Increasing political tensions and risks as well as aftershock effects of the COVID-19 pandemic (e.g. high inequality and insufficient access to healthcare and education) have severely impacted Brazil’s performance across the governance and social pillars of the ESG framework, ultimately causing its overall ESG score to drop to a CSR value of 5.31.

    Largest gains and losses in ESG scores

    Canada has received worse scores for corruption, political risk, income inequality, and poverty over the past three years.

    Taiwan has seen its rankings improve in terms of overall ESG scores. Government effectiveness, innovation, a strong semiconductor manufacturing market presence, and stronger governance initiatives have been sufficient to compensate for a setback in income and economic inequality.

    Source: Robeco, 2021

    Establish a Sustainable Environmental, Social, and Governance (ESG) Reporting Program

    A diagram of establishing a sustainable ESG reporting program.

    Blueprint benefits

    Business Benefits

    • Clarity on technical and organizational gaps in the organization’s ability to deliver ESG reporting strategy.
    • Transparency on the breadth of the change program, internal capabilities needed, and accountable owners.
    • Reduced likelihood of liability.
    • Improved corporate performance and top-line growth.
    • Confidence that the organization is delivering high-quality, comprehensive ESG disclosure.

    IT Benefits

    • Understanding of IT’s role as strategic enabler for delivering high-quality ESG disclosure and sustainable corporate performance.
    • Transparency on primary data gaps and technology and tools needed to support the ESG reporting strategy.
    • Clear direction of material ESG risks and how to prioritize implementation efforts.
    • Awareness of tool selection options.

    Blueprint deliverables

    Each step of this blueprint is accompanied by supporting deliverables to help you accomplish your goals:

    Photo of Executive Presentation.

    Key deliverable: Executive Presentation

    Leverage this presentation deck to improve corporate performance by implementing a holistic and proactive ESG reporting program.

    Photo of Workbook

    Workbook

    As you work through the activities, use this workbook to document decisions and rationale and to sketch your materiality map.

    Photo of Implementation Plan

    Implementation Plan

    Use this implementation plan to address organizational, technology, and tooling gaps.

    Photo of RFP Template

    RFP Template

    Leverage Info-Tech’s RFP Template to source vendors to fill technology gaps.

    Info-Tech offers various levels of support to best suit your needs

    DIY Toolkit
    "Our team has already made this critical project a priority, and we have the time and capability, but some guidance along the way would be helpful."

    Guided Implementation
    "Our team knows that we need to fix a process, but we need assistance to determine where to focus. Some check-ins along the way would help keep us on track."

    Workshop
    "We need to hit the ground running and get this project kicked off immediately. Our team has the ability to take this over once we get a framework and strategy in place."

    Consulting
    "Our team does not have the time or the knowledge to take this project on. We need assistance through the entirety of this project."

    Diagnostics and consistent frameworks are used throughout all four options.

    Guided Implementation

    A Guided Implementation (GI) is a series of calls with an Info-Tech analyst to help implement our best practices in your organization.

    A typical GI is 8 to 12 calls over the course of 4 to 6 months.

    What does a typical GI on this topic look like?

    A diagram that shows Guided Implementation in 3 phases.

    Workshop Overview

    Day 1

    Day 2

    Day 3

    Day 4

    Day 5

    Activities

    Determine Material ESG Factors

    1.1 Review ESG drivers.
    1.2 Identify key stakeholders and what drives their behavior.
    1.3 Discuss materiality frameworks options and select baseline model.
    1.4 Identify material risks and combine and categorize risks.
    1.5 Map material risks on materiality assessment map.

    Define Performance and Reporting Metrics

    2.1 Understand common program metrics for each ESG component.
    2.2 Consider and select program metrics.
    2.3 Discuss ESG risk metrics.
    2.4 Develop SMART metrics.
    2.5 Surface regulatory reporting obligations.

    Assess Data and Implementation Gaps

    3.1 Assess magnitude and prioritize data gaps.
    3.2 Discuss high-level implementation considerations and organizational gaps.

    Software and Tooling Options

    4.1 Review technology options.
    4.2 Brainstorm technology and tooling options and the feasibility of implementing.
    4.3 Prepare implementation plan.
    4.4 Draft ESG reporting program communication.
    4.5 Optional – Review software selection options.

    Next Steps and Wrap-Up (offsite)

    5.1 Complete in-progress deliverables from previous four days.
    5.2 Set up review time for workshop deliverables and to discuss next steps.

    Deliverables

    1. Customized list of key stakeholders and material ESG risks
    2. Materiality assessment map

    1. SMART metrics
    2. List of regulatory reporting obligations

    1. High-priority data gaps
    2. High-level implementation considerations

    1. Technology and tooling opportunities
    2. Implementation Plan
    3. ESG Reporting Communication

    1. ESG Reporting Workbook
    2. Implementation Plan

    Contact your account representative for more information.
    workshops@infotech.com
    1-888-670-8889

    Phase 1

    Explore ESG Reporting

    A diagram that shows phase 1 to 3 of establishing ESG reporting program.

    This phase will walk you through the following:

    • Define key stakeholders and material ESG factors.
    • Identify material ESG issues.
    • Develop SMART program metrics.
    • List reporting obligations.
    • Surface high-level data gaps.
    • Record high-level implementation considerations.

    This phase involves the following participants: CIO, CCO, CSO, business leaders, legal, marketing and communications, head of ESG reporting, and any dedicated ESG team members

    Practical steps for ESG disclosure

    Measuring and tracking incremental change among dimensions such as carbon emissions reporting, governance, and diversity, equity, and inclusion (DEI) requires organizations to acquire, analyze, and synthesize data from beyond their internal organizational ecosystems

    A diagram that shows 5 steps of identify, assess, implement, report & communicate, and monitor & improve.

    1.1 Ensure your reporting requirements are comprehensive

    A diagram of reporting lifecycle.

    This section will walk you through some key considerations for establishing your ESG reporting strategy. The first step in this process is to identify the scope of your reporting program.

    Defining the scope of your reporting program

    1. Stakeholder requirements: When developing a reporting program consider all your stakeholder needs as well as how they want to consume the information.
    2. Materiality assessment: Conduct a materiality assessment to identify the material ESG issues most critical to your organization. Organizations will need to report material risks to internal and external stakeholders.
    3. Purpose-driven goals: Your ESG reporting must include metrics to measure performance against your purpose-driven strategy.
    4. Regulatory requirements & industry: Work with your compliance and legal teams to understand which reporting requirements apply. Don’t forget requirements under the “S” and “G” components. Some jurisdictions require DEI reporting, and the Securities and Exchange Commission (SEC) in the US recently announced cybersecurity disclosure of board expertise and management oversight practices.

    Factor 1: Stakeholder requirements

    Work with key stakeholders to determine what to report

    A diagram that shows internal and external stakeholders.

    Evaluate your stakeholder landscape

    Consider each of these areas of the ESG Stakeholder Wheel and identify your stakeholders. Once stakeholders are identified, consider how the ESG factors might be perceived by delving into the ESG factors that matter to each stakeholder and what drives their behavior.

    A diagram of ESG impact, including materiality assessment, interviews, benchmark verses competitors, metrics and trend analysis.

    Determine ESG impact on stakeholders

    Review materiality assessment frameworks for your industry to surface ESG factors for your segment and stakeholder group(s).

    Perform research and analysis of the competition and stakeholder trends, patterns, and behavior

    Support your findings with stakeholder interviews.

    Stakeholders will prioritize ESG differently. Understanding their commitment is a critical success factor.

    Many of your stakeholders care about ESG commitments…

    27%: Support for social and environmental proposals at shareholder meetings of US companies rose to 27% in 2020 (up from 21% in 2017).
    Source: Sustainable Investments Institute, 2020.

    79%: of investors consider ESG risks and opportunities an important factor in investment decision making.
    Source: “Global Investor Survey,” PwC, 2021.

    ...Yet

    33%: of survey respondents cited that a lack of attention or support from senior leadership was one of the major barriers preventing their companies from making any progress on ESG issues.
    Source: “Consumer Intelligence Survey,” PwC, 2021.

    Info-Tech Insight

    To succeed with ESG reporting it is essential to understand who we hold ourselves accountable to and to focus ESG efforts in areas with the optimal balance between people, the planet, and profits

    Activity 1: Define stakeholders

    Input: Internal documentation (e.g. strategy, annual reports), ESG Stakeholder Wheel
    Output: List of key stakeholders and applicable ESG factors
    Materials: Whiteboard/flip charts, ESG Reporting Workbook
    Participants: Chief Sustainability Officer, Chief Compliance Officer, Head of ESG Reporting, Business leaders

    2 hours

    1. Using the ESG Stakeholder Wheel as a baseline, consider the breadth of your organization’s value chain and write down all your stakeholders.
    2. Discuss what drives their behavior. Be as detailed as you can be. For example, if it’s a consumer, delve into their age group and the factors that may drive their behavior.
    3. List the ESG factors that may be important to each stakeholder.
    4. Write down the communication channels you expect to use to communicate ESG information to this stakeholder group.
    5. Rate the priority of this stakeholder to your organization.
    6. Record this information in ESG Reporting Workbook.
    7. Optional – consider testing the results with a targeted survey.

    Download the ESG Reporting Workbook

    Activity 1: Example

    An example of activity 1 (defining stakeholders)

    Factor 2: Materiality assessments

    Conduct a materiality assessment to inform company strategy and establish targets and metrics for risk and performance reporting

    The concept of materiality as it relates to ESG is the process of gaining different perspectives on ESG issues and risks that may have significant impact (both positive and negative) on or relevance to company performance.

    The objective of a materiality assessment is to identify material ESG issues most critical to your organization by looking at a broad range of social and environmental factors. Its purpose is to narrow strategic focus and enable an organization to assess the impact of financial and non-financial risks aggregately.

    It helps to make the case for ESG action and strategy, assess financial impact, get ahead of long-term risks, and inform communication strategies.

    Organizations can use assessment tools from Sustainalytics or GRI, SASB Standards, or guidance and benchmarking information from industry associations to help assess ESG risks .

    An image of materiality matrix to understand ESG exposure

    Info-Tech Insight

    The materiality assessment informs your risk management approach. Material ESG risks identified should be integrated into your organization’s risk reporting framework.

    Supplement your materiality assessment with stakeholder interviews

    A diagram that shows steps of stakeholder interviews.

    How you communicate the results of your ESG assessment may vary depending on whether you’re communicating to internal or external stakeholders and their communication delivery preferences.

    Using the results from your materiality assessment, narrow down your key stakeholders list. Enhance your strategy for disclosure and performance measurement through direct and indirect stakeholder engagement.

    Decide on the most suitable format to reach out to these stakeholders. Smaller groups lend themselves to interviews and forums, while surveys and questionnaires work well for larger groups.

    Develop relevant questions tailored to your company and the industry and geography you are in.

    Once you receive the results, decide how and when you will communicate them.

    Determine how they will be used to inform your strategy.

    Steps to determine material ESG factors

    Step 1

    Select framework

    A diagram of framework

    Review reporting frameworks and any industry guidance and select a baseline reporting framework to begin your materiality assessment.

    Step 2

    Begin to narrow down

    A diagram of narrowing down stakeholders

    Work with stakeholders to narrow down your list to a shortlist of high-priority material ESG issues.

    Step 3

    Consolidate and group

    A diagram of ESG grouping

    Group ESG issues under ESG components, your company’s strategic goals, or the UN’s Sustainable Development Goals.

    Step 4

    Rate the risks of ESG factors

    A diagram of rating the risks of ESG factors

    Assign an impact and likelihood scale for each risk and assign your risk threshold.

    Step 5

    Map

    A diagram of material map

    Use a material map framework such as GRI or SASB or Info-Tech’s materiality map to visualize your material ESG risks.

    Materiality assessment

    The materiality assessment is a strategic tool used to help identify, refine, and assess the numerous ESG issues in the context of your organization.

    There is no universally accepted approach to materiality assessments. Although the concept of materiality is often embedded within a reporting standard, your approach to conducting the materiality assessment does not need to link to a specific reporting standard. Rather, it can be used as a baseline to develop your own.

    To arrive at the appropriate outcome for your organization, careful consideration is needed to tailor the materiality assessment to meet your organization’s objectives.

    When defining the scope of your materiality assessment consider:

    • Your corporate ESG purpose and sustainability strategy
    • Your audience and what drives their behavior
    • The relevance of the ESG issues to your organization. Do they impact strategy? Increase risk?
    • The boundaries of your materiality assessment (e.g. regions or business departments, supply chains it will cover)
    • Whether you want to assess from a double materiality perspective

    A diagram of framework

    Consider your stakeholders and your industry when selecting your materiality assessment tool – this will ensure you provide relevant disclosure information to the stakeholders that need it.

    Double materiality is an extension of the financial concept of materiality and considers the broader impact of an organization on the world at large – particularly to people and climate.

    Prioritize and categorize

    A diagram of narrowing down stakeholders

    Using internal information (e.g. strategy, surveys) and external information (e.g. competitors, industry best practices), create a longlist of ESG issues.

    Discuss and narrow down the list. Be sure to consider opportunities – not just material risks!

    A diagram of ESG grouping

    Group the issues under ESG components or defined strategic goals for your organization. Another option is to use the UN’s Sustainable Development Goals to categorize.

    Differentiate ESG factors that you already measure and report.

    The benefit of clustering is that it shows related topics and how they may positively or negatively influence one another.

    Internal risk disclosure should not be overlooked

    Bank of America estimates ESG disputes have cost S&P companies more than $600 billion in market capitalization in the last seven years alone.

    ESG risks are good predictors of future risks and are therefore key inputs to ensure long-term corporate success.

    Regardless of the size of your organization, it’s important to build resilience against ESG risks.

    To protect an organization against an ESG incident and potential liability risk, ESG risks should be treated like any other risk type and incorporated into risk management and internal reporting practices, including climate scenario analysis.

    Some regulated entities will be required to meet climate-related financial disclosure expectations, and sound risk management practices will be prescribed through regulatory guidance. However, all organizations should instill sound risk practices.

    ESG risk management done right will help protect against ESG mishaps that can be expensive and damaging while demonstrating commitment to stakeholders that have influence over all corporate performance.

    Source: GreenBiz, 2022.

    A diagram of risk landscape.

    IT has a role to play to provide the underlying data and technology to support good risk decisions.

    Visualize your material risks

    Leverage industry frameworks or use Info-Tech’s materiality map to visualize your material ESG risks.

    GRI’s Materiality Matrix

    A photo of GRI’s Materiality Matrix

    SASB’s Materiality Map

    A photo of SASB’s Materiality Map

    Info-Tech’s Materiality Map

    A diagram of material map

    Activity 2: Materiality assessment

    Input: ESG corporate purpose or any current ESG metrics; Customer satisfaction or employee engagement surveys; Materiality assessment tools from SASB, Sustainalytics, GRI, or industry frameworks; Outputs from stakeholder outreach/surveys
    Output: Materiality map, a list of material ESG issues
    Materials: Whiteboard/flip charts, ESG Reporting Workbook
    Participants: Chief Sustainability Officer, Chief Compliance Officer, Head of ESG Reporting, Business leaders, Participants from marketing and communications

    2-3 hour

    1. Begin by reviewing various materiality assessment frameworks to agree on a baseline framework. This will help to narrow down a list of topics that are relevant to your company and industry.
    2. As a group, discuss the potential impact and start listing material issues. At first the list will be long, but the group will work collectively to prioritize and consolidate the list.
    3. Begin to combine and categorize the results by aligning them to your ESG purpose and strategic pillars.
    4. Treat each ESG issue as a risk and map against the likelihood and impact of the risk.
    5. Map the topics on your materiality map. Most of the materiality assessment tools have materiality maps – you may choose to use their map.
    6. Record this information in the ESG Reporting Workbook.

    Download the ESG Reporting Workbook

    Case Study: Novartis

    Logo of Novartis

    • INDUSTRY: Pharmaceuticals
    • SOURCE: Novartis, 2022

    Novartis, a leading global healthcare company based in Switzerland, stands out as a leader in providing medical consultancy services to address the evolving needs of patients worldwide. As such, its purpose is to use science and technologically innovative solutions to address some of society’s most debilitating, challenging, and ethically significant healthcare issues.

    The application of Novartis’ materiality assessment process in understanding critical ESG topics important to their shareholders, stakeholder groups, and society at large enables the company to better quantify references to its ESG sustainability metrics.

    Novartis applies its materiality assessment process to better understand relevant issues affecting its underlying business operations across its entire value chain. Overall, employing Novartis’s materiality assessment process helps the company to better manage its societal, environmental, and economic impacts, thus engaging in more socially responsible governance practices.

    Novartis’ materiality assessment is a multitiered process that includes three major elements:

    1. Identifying key stakeholders, which involves a holistic analysis of internal colleagues and external stakeholders.
    2. Collecting quantitative feedback and asking relevant stakeholders to rank a set of issues (e.g. climate change governance, workplace culture, occupational health and safety) and rate how well Novartis performs across each of those identified issues.
    3. Eliciting qualitative insights by coordinating interviews and workshops with survey participants to better understand why the issues brought up during survey sessions were perceived as important.

    Results

    In 2021, Novartis had completed its most recent materiality assessment. From this engagement, both internal and external stakeholders had ranked as important eight clusters that Novartis is impacting on from an economic, societal, and environmental standpoint. The top four clusters were patient health and safety, access to healthcare, innovation, and ethical business practices.

    Factor 3: ESG program goals

    Incorporate ESG performance metrics that support your ESG strategy

    Another benefit of the materiality assessment is that it helps to make the case for ESG action and provides key information for developing a purpose-led strategy.

    An internal ESG strategy should drive toward company-specific goals such as green-house gas emission targets, use of carbon neutral technologies, focus on reusable products, or investment in DEI programs.

    Most organizations focus on incremental goals of reducing negative impacts to existing operations or improving the value to existing stakeholders rather than transformative goals.

    Yet, a strategy that is authentic and aligned with key stakeholders and long-term goals will bring sustainable value.

    The strategy must be supported by an accountability and performance measurement framework such as SMART metrics.

    A fulsome reporting strategy should include performance metrics

    A photo of SMART metrics: Specific, Measurable, Actionable, Realistic, Time-bound.

    Activity 3: SMART metrics

    Input: ESG corporate purpose or any current ESG metrics, Outputs from activities 1 and 2, Internally defined metrics (i.e. risk metrics or internal reporting requirements)
    Output: SMART metrics
    Materials: Whiteboard/flip charts, ESG Reporting Workbook
    Participants: Chief Sustainability Officer, Chief Compliance Officer, Chief Risk officer/Risk leaders, Head of ESG Reporting, Business leaders, Participants from marketing and communications

    1-2 hours

    1. Document a list of appropriate metrics to assess the success of your ESG program.
    2. Use the sample metrics listed in the table on the next slide as a starting point.
    3. Fill in the chart to indicate the:
      1. Name of the success metric
      2. Method for measuring success
      3. Baseline measurement
      4. Target measurement
      5. Actual measurements at various points throughout the process of improving the risk management program
      6. A deadline for each metric to meet the target measurement
    4. Record this information in the ESG Reporting Workbook.

    Download the ESG Reporting Workbook

    Sample ESG metrics

    Leverage industry resources to help define applicable metrics

    Environmental

    • Greenhouse gas emissions – total corporate
    • Carbon footprint – percent emitted and trend
    • Percentage of air and water pollution
    • Renewable energy share per facility
    • Percentage of recycled material in a product
    • Ratio of energy saved to actual use
    • Waste creation by weight
    • Circular transition indicators

    Social

    • Rates of injury
    • Lost time incident rate
    • Proportion of spend on local suppliers
    • Entry-level wage vs. local minimum wage
    • Percentage of management who identify with specific identity groups (i.e. gender and ethnic diversity)
    • Percentage of suppliers screened for accordance to ESG vs. total number of suppliers
    • Consumer responsiveness

    Governance

    • Annual CEO compensation compared to median
    • Percentage of employees trained in conflict-of-interest policy
    • Number of data breaches using personally identifiable information (PII)
    • Number of incidents relating to management corruption
    • Percentage of risks with mitigation plans in place

    Activity 3: Develop SMART project metrics

    1-3 hours

    Attach metrics to your goals to gauge the success of the ESG program.

    Sample Metrics

    An image of sample metrics

    Factor 4: Regulatory reporting obligations

    Identify your reporting obligations

    High-level overview of reporting requirements:

    An image of high-level reporting requirements in Canada, the United Kingdom, Europe, and the US.

    Refer to your legal and compliance team for the most up-to-date and comprehensive requirements.

    The focus of regulators is to move to mandatory reporting of material climate-related financial information.

    There is some alignment to the TCFD* framework, but there is a lack of standardization in terms of scope across jurisdictions.
    *TCFD is the Task Force on Climate-Related Financial Disclosures.

    Activity 4: Regulatory obligations

    Input: Corporate strategy documents; Compliance registry or internal governance, risk, and compliance (GRC) tool
    Output: A list of regulatory obligations
    Materials: Whiteboard/flip charts, ESG Reporting Workbook
    Participants: Chief Sustainability Officer, Chief Compliance Officer, Chief Legal Officer, Head of ESG Reporting, Business leaders

    1-2 hours

    1. Begin by listing the jurisdictions in which you operate or plan to operate.
    2. For each jurisdiction, list any known current or future regulatory requirements. Consider all ESG components.
    3. Log whether the requirements are mandatory or voluntary and the deadline to report.
    4. Write any details about reporting framework; for example, if a reporting framework such as TCFD is prescribed.
    5. Record this information in the ESG Reporting Workbook.

    Download the ESG Reporting Workbook

    1.2 Assess impact and weigh options

    A diagram of reporting lifecycle.

    Once the scope of your ESG reporting framework has been identified, further assessment is needed to determine program direction and to understand and respond to organizational impact.

    Key factors for further assessment and decisions include

    1. Reporting framework options. Consider mandated reporting frameworks and any industry standards when deciding your baseline reporting framework. Strive to have a common reporting methodology that serves all your reporting needs: regulatory, corporate, shareholders, risk reporting, etc.
    2. Perform gap analysis. The gap analysis will reveal areas where data may need to be sourced or where tools or external assistance may be needed to help deliver your reporting strategy.
    3. Organizational impact and readiness. The gap analysis will help to determine whether your current operating model can support the reporting program or whether additional resources, tools, or infrastructure will be needed.

    1.2.1 Decide on baseline reporting framework

    1. Determine the appropriate reporting framework for your organization

    Reporting standards are available to enable relevant, high-quality, and comparable information. It’s the job of the reporting entity to decide on the most suitable framework for their organization.

    The most established standard for sustainability reporting is the Global Reporting Initiative (GRI), which has supported sustainability reporting for over 20 years.

    The Task Force on Climate-Related Financial Disclosures (TCFD) was created by the Financial Stability Board to align ESG disclosure with financial reporting. Many global regulators support this framework.

    The International Sustainability Standards Board (ISSB) is developing high-quality, understandable, and enforceable global standards using the Sustainability Accounting Standards Board (SASB) as a baseline. It is good practice to use SASB Standards until the ISSB standards are available.

    2. Decide which rating agencies you will use and why they are important

    ESG ratings are provided by third-party agencies and are increasingly being used for financing and transparency to investors. ESG ratings provide both qualitative and quantitative information.

    However, there are multiple providers, so organizations need to consider which ones are the most important and how many they want to use.

    Some of the most popular rating agencies include Sustainalytics, MSCI, Bloomberg, Moody's, S&P Global, and CDP.

    Reference Appendix Below

    1.2.2 Determine data gaps

    The ESG reporting mandate is built on the assumption of consistent, good-quality data

    To meet ESG objectives, corporations are challenged with collecting non-financial data from across functional business and geographical locations and from their supplier base and supply chains.

    One of the biggest impediments to ESG implementation is the lack of high-quality data and of mature processes and tools to support data collection.

    An important step for delivering reporting requirements is to perform a gap analysis early on to surface gaps in the primary data needed to deliver your reporting strategy.

    The output of this exercise will also inform and help prioritize implementation, as it may show that new data sets need to be sourced or tools purchased to collect and aggregate data.

    Conduct a gap analysis to determine gaps in primary data

    A diagram of gap analysis to determine gaps in primary data.

    Activity 5: Gap analysis

    Input: Business (ESG) strategy, Data inventory (if exists), Output from Activity 1: Key stakeholders, Output from Activity 2: Materiality map, Output of Activity 3: SMART metrics, Output of Activity 4: Regulatory obligations
    Output: List of high-priority data gaps
    Materials: Whiteboard/flip charts, ESG Reporting Workbook
    Participants: Chief Sustainability Officer, Chief Compliance Officer, Chief Legal Officer, Head of ESG Reporting, Business leaders, Data analysts

    1-3 hours

    1. Using the outputs from activities 1-4, list your organization’s ESG issues in order of priority. You may choose to develop your priority list by stakeholder group or by material risks.
    2. List any defined SMART metric from Activity 3.
    3. Evaluate data availability and quality of the data (if existing) as well as any impediments to sourcing the data.
    4. Make note if this is a common datapoint, i.e. would you disclose this data in more than one report?
    5. Record this information in the ESG Reporting Workbook.

    Download the ESG Reporting Workbook

    1.3 Take a holistic implementation approach

    Currently, 84 percent of businesses don’t integrate their ESG performance with financial and risk management reporting.

    Source: “2023 Canadian ESG Reporting Insights,” PwC.

    A diagram of reporting lifecycle.

    When implementing an ESG reporting framework, it is important not to implement in silos but to take a strategic approach that considers the evolving nature of ESG and the link to value creation and sound decision making.

    Key implementation considerations include

    1. Setting clear metrics and targets. Key performance indicators (KPIs) and key risk indicators (KRIs) are used to measure ESG factor performance. It’s essential that they are relevant and are constructed using high-quality data. Your performance metrics should be continually assessed and adapted as your ESG program evolves.
    2. Data challenges. Without good-quality data it is impossible to accurately measure ESG performance, generate actionable insights on ESG performance and risk, and provide informative metrics to investors and other stakeholders. Design your data model to be flexible and digital where possible to enable data interoperability.
    3. Architectural approach. IT will play a key role in the design of your reporting framework, including the decision on whether to build, buy, or deliver a hybrid solution. Every organization will build their reporting program to suit their unique needs; however, taking a holistic and proactive approach will support and sustain your strategy long term.

    1.3.1 Metrics and targets for climate-related disclosure

    “The future of sustainability reporting is digital – and tagged.”
    Source: “XBRL Is Coming,” Novisto, 2022.

    In the last few years, global regulators have proposed or effected legislation requiring public companies to disclose climate-related information.

    Yet according to Info-Tech’s 2023 Trends and Priorities survey, most IT professionals expect to support environmental mandates but are not prepared to accurately report on their organization’s carbon footprint.

    IT groups have a critical role to play in helping organizations develop strategic plans to meet ESG goals, measure performance, monitor risks, and deliver on disclosure requirements.

    To future-proof your reporting structure, your data should be readable by humans and machines.

    eXtensible Business Reporting Language (XBRL) tagging is mandated in several jurisdictions for financial reporting, and several reporting frameworks are adopting XBRL for sustainability reporting so that non-financial and financial disclosure frameworks are aligned.

    Example environmental metrics

    • Amount of scope 1, 2, or 3 GHG emissions
    • Total energy consumption
    • Total water consumption
    • Progress toward net zero emission
    • Percentage of recycled material in a product

    1.3.1 Metrics and targets for social disclosure

    “59% of businesses only talk about their positive performance, missing opportunities to build trust with stakeholders through balanced and verifiable ESG reporting.”
    Source: “2023 Canadian ESG Reporting Insights,” PwC.

    To date, regulatory focus has been on climate-related disclosure, although we are beginning to see signals in Europe and the UK that they are turning their attention to social issues.

    Social reporting focuses on the socioeconomic impacts of an organization’s initiatives or activities on society (indirect or direct).

    The “social” component of ESG can be the most difficult to quantify, but if left unmonitored it can leave your organization open to litigation from consumers, employees, and activists.

    Although organizations have been disclosing mandated metrics such as occupational health and safety and non-mandated activities such as community involvement for years, the scope of reporting is typically narrow and hard to measure in financial terms.

    This is now changing with the recognition by companies of the value of social reporting to brand image, traceability, and overall corporate performance.

    Example social metrics

    • Rate of injury
    • Lost time incident rate
    • Proportion of spend on local suppliers
    • Entry-level wage versus local minimum wage
    • Percentage of management within specific identity groups (i.e. gender and ethnic diversity)
    • Number of workers impacted by discrimination

    Case Study: McDonald’s Corporation (MCD)

    Logo of McDonald’s

    • INDUSTRY: Food service retailer
    • SOURCE: RBC Capital Markets, 2021; McDonald’s, 2019

    McDonald’s Corporation is the leading global food service retailer. Its purpose is not only providing burgers to dinner tables around the world but also serving its communities, customers, crew, farmers, franchisees, and suppliers alike. As such, not only is the company committed to having a positive impact on communities and in maintaining the growth and success of the McDonald's system, but it is also committed to conducting its business operations in a way that is mindful of its ESG commitments.

    An image of McDonald’s Better Together

    McDonald’s Better Together: Gender Balance & Diversity strategy and Women in Tech initiative

    In 2019, MCD launched its Better Together: Gender Balance & Diversity strategy as part of a commitment to improving the representation and visibility of women at all levels of the corporate structure by 2023.

    In conjunction with the Better Together strategy, MCD piloted a “Women in Tech” initiative through its education and tuition assistance program, Archways to Opportunity. The initiative enabled women from company-owned restaurants and participating franchisee restaurants to learn skills in areas such as data science, cybersecurity, artificial intelligence. MCD partnered with Microsoft and Colorado Technical University to carry out the initiative (McDonald’s, 2019).

    Both initiatives directly correlate to the “S” of the ESG framework, as the benefits of gender-diverse leadership continue to be paramount in assessing the core strengths of a company’s overreaching ESG portfolio. Hence, public companies will continue to face pressure from investors to act in accordance with these social initiatives.

    Results

    MCD’s Better Together and Women in Tech programs ultimately helped improve recruitment and retention rates among its female employee base. After the initialization of the gender balance and diversification strategy, McDonald’s signed on to the UN Women’s Empowerment Principles to help accelerate global efforts in addressing the gender disparity problem.

    1.3.1 Metrics and targets for governance disclosure

    Do not lose sight of regulatory requirements

    Strong governance is foundational element of a ESG program, yet governance reporting is nascent and is often embedded in umbrella legislation pertaining to a particular risk factor.

    A good example of this is the recent proposal by the Securities and Exchange Commission in the US (CFR Parts 229, 232, 239, 240, and 249, Cybersecurity Risk Management, Strategy, Governance, and Incident Disclosure), which will require public companies to:

    • Disclosure of board oversight of cyber risk.
    • Disclose management’s role in managing and accessing cybersecurity-related risks.

    The "G” component includes more than traditional governance factors and acts as a catch-all for other important ESG factors such as fraud, cybersecurity, and data hygiene. Make sure you understand how risk may manifest in your organization and put safeguards in place.

    Example governance metrics

    • Annual CEO compensation compared to median
    • Percentage of employees trained in conflict-of-interest policy
    • Completed number of supplier assessments
    • Number of data breaches using PII
    • Number of material cybersecurity breaches

    Info-Tech Insight

    The "G" in ESG may not be capturing the limelight under ESG legislation yet, but there are key governance factors that are that are under regulatory radar, including data, cybersecurity, fraud, and DEI. Be sure you stay on top of these issues and include performance metrics into your internal and external reporting frameworks.

    1.3.2 Conquering data management challenges

    48% of investment decision makers, including 58% of institutional investors, say companies’ self-reported ESG performance data is “much more important” than companies’ conventional financial data when informing their investment decisions (Benchmark ESG, 2021).

    Due to the nascent nature of climate-related reporting, data challenges such as the availability, usability, comparability, and workflow integration surface early in the ESG program journey when sourcing and organizing data:

    • It is challenging to collect non-financial data across functional business and geographical locations and from supplier base and supply chains.
    • The lack of common standards leads to comparability challenges, hindering confidence in the outputs.

    In addition to good, reliable inputs, organizations need to have the infrastructure to access new data sets and convert raw data into actionable insights.

    The establishment of data model and workflow processes to track data lineage is essential to support an ESG program. To be successful, it is critical that flexibility, scalability, and transparency exist in the architectural design. Data architecture must scale to capture rapidly growing volumes of unstructured raw data with the associated file formats.

    A photo of conceptual model for data lineage.

    Download Info-Tech’s Create and Manage Enterprise Data Models blueprint

    1.3.3 Reporting architecture

    CIOs play an important part in formulating the agenda and discourse surrounding baseline ESG reporting initiatives

    Building and operating an ESG program requires the execution of a large number of complex tasks.

    IT leaders have an important role to play in selecting the right technology approach to support a long-term strategy that will sustain and grow corporate performance.

    The decision to buy a vendor solution or build capabilities in-house will largely depend on your organization’s ESG ambitions and the maturity of in-house business and IT capabilities.

    For large, heavily regulated entities an integrated platform for ESG reporting can provide organizations with improved risk management and internal controls.

    Example considerations when deciding to meet ESG reporting obligations in-house

    • Size and type of organization
    • Extent of regulatory requirements and scrutiny
    • The amount of data you want to report
    • Current maturity of data architecture, particularly your ability to scale
    • Current maturity of your risk and control program – how easy is it to enhance current processes?
    • The availability and quality of primary data
    • Data set gaps
    • In-house expertise in data, model risk, and change management
    • Current operating model – is it siloed or integrated?
    • Implementation time
    • Program cost
    • The availability of vendor solutions that may address gaps

    Info-Tech Insight

    Executive leadership should take a more holistic and proactive stance to not only accurately reporting upon baseline corporate financial metrics but also capturing and disclosing relevant ESG performance metrics to drive alternative streams of valuation across their respective organizational environments.

    Activity 6: High-level implementation considerations

    Input: Business (ESG) strategy, Data inventory (if exists), Asset inventory (if exists), Output from Activity 5
    Output: Summary of high-level implementation considerations
    Materials: Whiteboard/flip charts, ESG Reporting Workbook
    Participants: Chief Sustainability Officer, Head of ESG Reporting, Business leaders, Data analysts, Data and IT architect/leaders,

    2-3 hours

    1. Review the implementation considerations on the previous slide to help determine the appropriate technology approach.
    2. For each implementation consideration, describe the current state.
    3. Discuss and draft the implications of reaching the desired future state by listing implications and organizational gaps.
    4. Discuss as a group if there is an obvious implementation approach.
    5. At this point, further analysis may be needed. Form a subcommittee or assign a leader to conduct further analysis.
    6. Record this information in the ESG Reporting Workbook.

    Download the ESG Reporting Workbook

    1.3.4 Ensure your implementation team has a high degree of trust and communication

    If external partners are needed, dedicate an internal resource to managing the vendor and partner relationships.

    Communication: Teams must have some type of communication strategy. This can be broken into:

    • Regularity: Having a set time each day to communicate progress and a set day to conduct retrospectives.
    • Ceremonies: Injecting awards and continually emphasizing delivery of value to encourage relationship building and constructive motivation.
    • Escalation: Voicing any concerns and having someone responsible for addressing those concerns.

    Proximity: Distributed teams create complexity as communication can break down. This can be mitigated by:

    • Location: Placing teams in proximity to close the barrier of geographical distance and time zone differences.
    • Inclusion: Making a deliberate attempt to pull remote team members into discussions and ceremonies.
    • Communication tools: Having the right technology (e.g. videoconference) to help bring teams closer together virtually.

    Trust: Members should trust other members are contributing to the project and completing their required tasks on time. Trust can be developed and maintained by:

    • Accountability: Having frequent quality reviews and feedback sessions. As work becomes more transparent, people become more accountable.
    • Role clarity: Having a clear definition of what everyone’s role is.

    1.4 Clear effective communication

    Improving investor transparency is one of the key drivers behind disclosure, so making the data easy to find and consumable is essential

    A diagram of reporting lifecycle.

    Your communication of ESG performance is intricately linked to corporate value creation. When designing your communications strategy, consider:

    • Your message – make it authentic and tell a consistent story.
    • How data will be used to support the narrative.
    • How your ESG program may impact internal and external programs and build a communication strategy that is fit for purpose. Example programs are:
      • Employee recruitment
      • New product rollout
      • New customer campaign
    • The design of the communication and how well it suits the audience. Communications may take the form of campaigns, thought leadership, infographics, etc.
    • The appropriateness of communication channels to your various audiences and the messages you want to convey. For example, social media, direct outreach, shareholder circular, etc.

    1.5 Continually evaluate

    A diagram of reporting lifecycle.

    A recent BDC survey of 121 large companies and public-sector buyers found that 82% require some disclosure from their suppliers on ESG, and that's expected to grow to 92% by 2024.
    Source: BDC, 2023

    ESG's link to corporate performance means that organizations must stay on top of ESG issues that may impact the long-term sustainability of their business.

    ESG components will continue to evolve, and as they do so will stakeholder views. It is important to continually survey your stakeholders to ensure you are optimally managing ESG risks and opportunities.

    To keep ESG on the strategy agenda, we recommend that organizations:

    • Appoint a chief sustainability officer (CSO) with a seat on executive leadership committees.
    • Embed ESG into existing governance and form a tactical ESG working group committee.
    • Ensure ESG risks are integrated into the enterprise risk management program.
    • Continually challenge your ESG strategy.
    • Regularly review risks and opportunities through proactive outreach to stakeholders.

    Download The ESG Imperative and Its Impact on Organizations

    Phase 2

    Streamline Requirements and Tool Selection

    A diagram that shows phase 1 to 3 of establishing ESG reporting program.

    This phase will walk you through the following activities:

    • Assess technology and tooling opportunities.
    • Prepare ESG reporting implementation plan.
    • Write ESG reporting presentation document.

    This phase involves the following participants: CIO, CCO, CSO, EA, IT application and data leaders, procurement, business leaders, marketing and communications, head of ESG reporting, and any dedicated ESG team members

    2.1 Streamline your requirements and tool section

    Spend the time up front to enable success and meet expectations

    Before sourcing any technology, it’s important to have a good understanding of your requirements.

    Key elements to consider:

    1. ESG reporting scope. Large enterprises will have more complex workflow requirements, but they also will have larger teams to potentially manage in-house. Smaller organizations will need easy-to-use, low-cost solutions.
    2. Industry and value chain. Look for industry-specific solutions, as they will be more tailored to your needs and will enable you to be up and running quicker.
    3. Coverage. Ensure the tool has adequate regulatory coverage to meet your current and future needs.
    4. Gap in functionality. Be clear on the problem you are trying to solve and/or the gap in workflow. Refer to the reporting lifecycle and be clear on your needs before sourcing technology.
    5. Resourcing. Factor in capacity during and after implementation and negotiate the appropriate support.

    Industry perspective

    The importance of ESG is something that will need to be considered for most, if not every decision in the future, and having reliable and available information is essential. While the industry will continue to see investment and innovation that drives operational efficiency and productivity, we will also see strong ESG themes in these emerging technologies to ensure they support both sustainable and socially responsible operations.

    With the breadth of technology Datamine already has addressing the ESG needs for the mining industry combined with our new technology, our customers can make effective and timely decisions through incorporating ESG data into their planning and scheduling activities to meet customer demands, while staying within the confines of their chosen ESG targets.

    Photo of Chris Parry

    Chris Parry
    VP of ESG, Datamine

    Photo of Datamine Photo of isystain

    Activity 7: Brainstorm tooling options

    Use the technology feature list below to identify areas along the ESG workflow where automated tools or third-party solutions may create efficiencies

    Technological Solutions Feature Bucket

    Basic Feature Description

    Advanced Feature Description

    Natural language processing (NLP) tools

    Ability to use NLP tools to track and monitor sentiment data from news and social media outlets.

    Leveraging NLP toolsets can provide organizations granular insights into workplace sentiment levels, which is a core component of any ESG strategy. A recent study by MarketPsych, a company that uses NLP technologies to analyze sentiment data from news and social media feeds, linked stock price performance to workplace sentiment levels.

    Distributed ledger technologies (DLTs)

    DLTs can help ensure greater reporting transparency, in line with stringent regulatory reporting requirements.

    DLT as an ESG enabler, with advanced capabilities such as an option to provide demand response services linked to electricity usage and supply forecasting.

    Cloud-based data management and reporting systems

    Cloud-based data management and reporting can support ESG initiatives by providing increased reporting transparency and a better understanding of diverse social and environmental risks.

    Leverage newfound toolsets such as Microsoft Cloud for Sustainability – a SaaS offering that enables organizations to seamlessly record, report, and reduce their emissions on a path toward net zero.

    IoT technologies

    Integration of IoT devices can help enhance the integrity of ESG reporting through the collection of descriptive and accurate ESG metrics (e.g. energy efficiency, indoor air quality, water quality and usage).

    Advanced management of real-time occupancy monitoring: for example, the ability to reduce energy consumption rates by ensuring energy is only used when spaces and individual cubicles are occupied.

    2.2 Vendors tools and technologies to support ESG reporting

    In a recent survey of over 1,000 global public- and private-sector leaders, 87% said they see AI as a helpful tool to fight climate change.
    Source: Boston Consulting Group

    Technology providers are part of the solution and can be leveraged to collect, analyze, disclose, track, and report on the vast amount of data.

    Increasingly organizations are using artificial intelligence to build climate resiliency:

    • AI is useful for the predictive modelling of potential climate events due to its ability to gather and analyze and synthesize large complete data sets.

    And protect organizations from vulnerabilities:

    • AI can be used to identify and assess vulnerabilities that may lead to business disruption or risks in production or the supply chain.

    A diagram of tooling, including DLT, natural language processing, cloud-based data management and IoT.

    2.3 ESG reporting software selection

    What Is ESG Reporting Software?

    Our definition: ESG reporting software helps organizations improve the transparency and accountability of their ESG program and track, measure, and report their sustainability efforts.

    Key considerations for reporting software selection:

    • While there are boutique ESG vendors in the market, organizations with existing GRC tools may first want to discuss ESG coverage with their existing vendor as it will enable better integration.
    • Ensure that the vendors you are evaluating support the requirements and regulations in your region, industry, and geography. Regulation is moving quickly – functionality needs to be available now and not just on the roadmap.
    • Determine the level of software integration support you need before meeting with vendors and ensure they will be able to provide it – when you need it!

    Adoption of ESG reporting software has historically been low, but these tools will become critical as organizations strive to meet increasing ESG reporting requirements.

    In a recent ESG planning and performance survey conducted by ESG SaaS company Diligent Corporation, it was found that over half of all organizations surveyed do not publish ESG metrics of any kind, and only 9% of participants are actively using software that supports ESG data collection, analysis, and reporting.

    Source: Diligent, 2021.

    2.3.1 Elicit and prioritize granular requirements for your ESG reporting software

    Understanding business needs through requirements gathering is the key to defining everything about what is being purchased. However, it is an area where people often make critical mistakes.

    Poorly scoped requirements

    Fail to be comprehensive and miss certain areas of scope.

    Focus on how the solution should work instead of what it must accomplish.

    Have multiple levels of detail within the requirements that are inconsistent and confusing.

    Drill all the way down into system-level detail.

    Add unnecessary constraints based on what is done today rather than focusing on what is needed for tomorrow.

    Omit constraints or preferences that buyers think are obvious.

    Best practices

    Get a clear understanding of what the system needs to do and what it is expected to produce.

    Test against the principle of MECE – requirements should be “mutually exclusive and collectively exhaustive.”

    Explicitly state the obvious and assume nothing.

    Investigate what is sold on the market and how it is sold. Use language that is consistent with that of the market and focus on key differentiators – not table stakes.

    Contain the appropriate level of detail – the level should be suitable for procurement and sufficient for differentiating vendors.

    Download Info-Tech's Improve Requirements Gathering blueprint

    2.3.1 Identify critical and nice-to-have features

    Central Data Repository: Collection of stored data from existing databases merged into one location that can then be shared, analyzed, or updated.

    Automatic Data Collection: Ability to automate data flows, collect responses from multiple sources at specified intervals, and check them against acceptance criteria.

    Automatic KPI Calculations, Conversions, and Updates: Company-specific metrics can be automatically calculated, converted, and tracked.

    Built-In Indicator Catalogs and Benchmarking: Provides common recognized frameworks or can integrate a catalog of ESG indicators.

    Custom Reporting: Ability to create reports on company emissions, energy, and asset data in company-branded templates.

    User-Based Access and Permissions: Ability to control access to specific content or data sets based on the end user’s roles.

    Real-Time Capabilities: Ability to analyze and visualize data as soon as it becomes available in underlying systems.

    Version Control: Tracking of document versions with each iteration of document changes.

    Intelligent Alerts and Notifications: Ability to create, manage, send, and receive notifications, enhancing efficiency and productivity.

    Audit Trail: View all previous activity including any recent edits and user access.

    Encrypted File Storage and Transfer: Ability to encrypt a file before transmitting it over the network to hide content from being viewed or extracted.

    Activity 7: Technology and tooling options

    Input: Business (ESG) strategy, Data inventory (if exists), Asset inventory (if exists), Output from Activity 5, Output from Activity 6,
    Output: List of tooling options
    Materials: Whiteboard/flip charts, ESG Reporting Workbook
    Participants: Chief Sustainability Officer, Head of ESG Reporting, Business leaders, Data analysts, Data and IT architect/leaders

    1-2 hours

    1. Begin by listing key requirements and features for your ESG reporting program.
    2. Use the outputs from activities 5 and 6 and the technology feature list on the previous slide to help brainstorm technology and tooling options.
    3. Discuss the availability and readiness of each option. Note that regulatory requirements will have an effective date that will impact the time to market for introducing new tooling.
    4. Discuss and assign a priority.
    5. At this point, further analysis may be needed. Form a subcommittee or assign a leader to conduct further analysis.
    6. Record this information in the ESG Reporting Workbook.

    Download the ESG Reporting Workbook

    Activity 8: Implementation plan

    Input: Business (ESG) strategy, Output from Activity 5, Output from Activity 6, Output from Activity 7
    Output: ESG Reporting Implementation Plan
    Materials: Whiteboard/flip charts, ESG Reporting Implementation Plan Template
    Participants: Chief Sustainability Officer, Head of ESG Reporting, Business leaders, Data analysts, PMO, Data and IT architect/leaders

    1-2 hours

    1. Use the outputs from activities 5 to 7 and list required implementation tasks. Set a priority for each task.
    2. Assign the accountable owner as well as the group responsible. Larger organizations and large, complex change programs will have a group of owners.
    3. Track any dependencies and ensure the project timeline aligns.
    4. Add status as well as start and end dates.
    5. Complete in the ESG Reporting Implementation Plan Template.

    Download the ESG Reporting Implementation Plan Template

    Activity 9: Internal communication

    Input: Business (ESG) strategy, ESG Reporting Workbook, ESG reporting implementation plan
    Output: ESG Reporting Presentation Template
    Materials: Whiteboard/flip charts, ESG Reporting Presentation Template, Internal communication templates
    Participants: Chief Sustainability Officer, Head of Marketing/ Communications, Business leaders, PMO

    1-2 hours

    Since a purpose-driven ESG program presents a significant change in how organizations operate, the goals and intentions need to be understood throughout the organization. Once you have developed your ESG reporting strategy it is important that it is communicated, understood, and accepted. Use the ESG Reporting Presentation Template as a guide to deliver your story.

    1. Consider your audience and discuss and agree on the key elements you want to convey.
    2. Prepare the presentation.
    3. Test the presentation with smaller group before communicating to senior leadership/board

    Download the ESG Reporting Presentation Template

    Phase 3

    Select ESG Reporting Software

    A diagram that shows phase 1 to 3 of establishing ESG reporting program.

    This phase will provide additional material on Info-Tech’s expertise in the following areas:

    • Info-Tech’s approach to RFPs
    • Info-Tech tools for software selection
    • Example ESG software assessments

    3.1 Leverage Info-Tech’s expertise

    Develop an inclusive and thorough approach to the RFP process

    An image that a process of 7 steps.

    The Info-Tech difference:

    1. The secret to managing an RFP is to make it as manageable and as thorough as possible. The RFP process should be like any other aspect of business – with a standard process in place, you are better able to handle whatever comes your way, because you know the steps you need to follow to produce a top-notch RFP.
    2. The business then identifies the need for more information about a product/service or determines that a purchase is required.
    3. A team of stakeholders from each area impacted gather all business, technical, legal, and risk requirements. What are the expectations of the vendor relationship post-RFP? How will the vendors be evaluated?
    4. Based on predetermined requirements, either an RFI or an RFP is issued to vendors with a due date.

    Info-Tech Insight

    Review Info-Tech’s process and understand how you can prevent your organization from leaking negotiation leverage while preventing vendors from taking control of your RFP.

    Software Selection Engagement

    5 Advisory Calls Over a 5-Week Period to Accelerate Your Selection Process

    Expert Analyst Guidance over5 weeks on average to select and negotiate software.

    Save Money, Align Stakeholders, Speed Up the Process & make better decisions.

    Use a Repeatable, Formal Methodology to improve your application selection process.

    Better, Faster Results, guaranteed, included in membership.

    A diagram of selection engagement over a 5-week period.

    CLICK HERE to Book Your Selection Engagement

    Leverage the Contract Review Service to level the playing field with your shortlisted vendors

    You may be faced with multiple products, services, master service agreements, licensing models, service agreements, and more.

    Use the Contract Review Service to gain insights on your agreements.

    Consider the aspects of a contract review:

    1. Are all key terms included?
    2. Are they applicable to your business?
    3. Can you trust that results will be delivered?
    4. What questions should you be asking from an IT perspective?

    Validate that a contract meets IT’s and the business’ needs by looking beyond the legal terminology. Use a practical set of questions, rules, and guidance to improve your value for dollar spent.

    A photo of Contract Review Service.

    Click here to book The Contract Review Service

    Download blueprint Master Contract Review and Negotiation for Software Agreements

    3.2 Vendor spotlight assessments

    See above for a vendor landscape overview of key ESG reporting software providers

    The purpose of this section is to showcase various vendors and companies that provide software solutions to help users manage and prioritize their ESG reporting initiatives.

    This section showcases the core capabilities of each software platform to provide Info-Tech members with industry insights regarding some of the key service providers that operate within the ESG vendor market landscape.

    Info-Tech members who are concerned with risks stemming from the inability to sort and disseminate unstructured ESG data reporting metrics or interested in learning more about software offerings that can help automate the data collection, processing, and management of ESG metrics will find high-level insights into the ESG vendor market space.

    Vendor spotlight

    A photo of Datamine Isystain

    The establishment of the Datamine ESG unit comes at the same time the mining sector is showing an increased interest in managing ESG and its component systems as part of a single scope.

    With miners collecting and dealing with ever-increasing quantities of data and looking for ways to leverage it to make data-driven decisions that enhance risk management and increase profitability, integrated software solutions are – now more than ever – essential in supporting continuous improvement and maintaining data fidelity and data integrity across the entire mining value chain.

    An example of Datamine Isystain An example of Datamine Isystain An example of Datamine Isystain

    Key Features:

    • Discover GIS for geochemical, water, erosion, and vegetation modelling and management.
    • Qmed for workforce health management, COVID testing, and vaccine administration.
    • MineMarket and Reconcilor for traceability and auditing, giving visibility to chain of custody and governance across the value chain, from resource modelling to shipping and sales.
    • Centric Mining Systems – intelligence software for real-time transparency and governance across multiple sites and systems, including key ESG performance indicator reporting.
    • Zyght – a leading health, safety, and environment solution for high-impact industries that specializes in environment, injury, risk management, safe work plans, document management, compliance, and reporting.
    • Isystain – a cloud-based platform uniquely designed to support health, safety & environment, sustainability reporting, compliance and governance, and social investment reporting. Designed for seamless integration within an organization’s existing software ecosystems providing powerful analytics and reporting capabilities to streamline the production of sustainability and performance reporting.

    Vendor spotlight

    A logo of Benchmark ESG

    Benchmark ESG provides industry-leading ESG data management and reporting software that can assist organizations in managing operational risk and compliance, sustainability, product stewardship, and ensuring responsible sourcing across complex global operations.

    An example of Benchmark ESG An example of Benchmark ESG

    Key Features:

    Vendor spotlight

    A logo of PWC

    PwC’s ESG Management Solution provides quick insights into ways to improve reporting transparency surrounding your organization’s ESG commitments.

    According to PwC’s most recent CEO survey, the number one motivator for CEOs in mitigating climate change risks is their own desire to help solve this global problem and drive transparency with stakeholders.
    Source: “Annual Global CEO Survey,” PwC, 2022.

    An example of PWC An example of PWC

    Key Features:

    • Streamlined data mining capabilities. PwC’s ESG solution provides the means to streamline, automate, and standardize the input of sustainability data based on non-financial reporting directive (NFRD) and corporate sustainability reporting directive (CSRD) regulations.
    • Company and product carbon footprint calculation and verification modules.
    • Robust dashboarding capabilities. Option to create custom-tailored sustainability monitoring dashboards or integrate existing ESG data from an application to existing dashboards.
    • Team management functionalities that allow for more accessible cross-departmental communication and collaboration. Ability to check progress on tasks, assign tasks, set automatic notifications/deadlines, etc.

    Vendor spotlight

    A logo of ServiceNow

    ServiceNow ESG Management (ESGM) and reporting platform helps organizations transform the way they manage, visualize, and report on issues across the ESG spectrum.

    The platform automates the data collection process and the organization and storage of information in an easy-to-use system. ServiceNow’s ESGM solution also develops dashboards and reports for internal user groups and ensures that external disclosure reports are aligned with mainstream ESG standards and frameworks.

    We know that doing well as a business is about more than profits. One workflow at a time, we believe we can change the world – to be more sustainable, equitable, and ethical.
    Source: ServiceNow, 2021.

    An example of ServiceNow

    Key Features:

    1. An executive dashboard to help coherently outline the status of various ESG indicators, including material topics, goals, and disclosure policies all in one centralized hub
    2. Status review modules. Ensure that your organization has built-in modules to help them better document and monitor their ESG goals and targets using a single source of truth.
    3. Automated disclosure modules. ESGM helps organizations create more descriptive ESG disclosure reports that align with industry accountability standards (e.g. SASB, GRI, CDP).

    Other key vendors to consider

    An image of other 12 key vendors

    Related Info-Tech Research

    Photo of The ESG Imperative and Its Impact on Organizations

    The ESG Imperative and Its Impact on Organizations

    Use this blueprint to educate yourself on ESG factors and the broader concept of sustainability.

    Identify changes that may be needed in your organizational operating model, strategy, governance, and risk management approach.

    Learn about Info-Tech’s ESG program approach and use it as a framework to begin your ESG program journey.

    Photo of Private Equity and Venture Capital Growing Impact of ESG Report

    Private Equity and Venture Capital Growing Impact of ESG Report

    Increasingly, new capital has a social mandate attached to it due to the rise of ESG investment principles.

    Learn about how the growing impact of ESG affects both your organization and IT specifically, including challenges and opportunities, with expert assistance.

    Definitions

    Terms

    Definition

    Corporate Social Responsibility

    Management concept whereby organizations integrate social and environmental concerns in their operations and interactions with their stakeholders.

    Chief Sustainability Officer

    Steers sustainability commitments, helps with compliance, and helps ensure internal commitments are met. Responsibilities may extend to acting as a liaison with government and public affairs, fostering an internal culture, acting as a change agent, and leading delivery.

    ESG

    An acronym that stands for environment, social, and governance. These are the three components of a sustainability program.

    ESG Standard

    Contains detailed disclosure criteria including performance measures or metrics. Standards provide clear, consistent criteria and specifications for reporting. Typically created through consultation process.

    ESG Framework

    A broad contextual model for information that provides guidance and shapes the understanding of a certain topic. It sets direction but does not typically delve into the methodology. Frameworks are often used in conjunction with standards.

    ESG Factors

    The factors or issues that fall under the three ESG components. Measures the sustainability performance of an organization.

    ESG Rating

    An aggregated score based on the magnitude of an organization’s unmanaged ESG risk. Ratings are provided by third-party rating agencies and are increasingly being used for financing, transparency to investors, etc.

    ESG Questionnaire

    ESG surveys or questionnaires are administered by third parties and used to assess an organization’s sustainability performance. Participation is voluntary.

    Key Risk Indicator (KRI)

    A measure to indicate the potential presence, level, or trend of a risk.

    Key Performance Indicator (KPI)

    A measure of deviation from expected outcomes to help a firm see how it is performing.

    Materiality

    Material topics are topics that have a direct or indirect impact on an organization's ability to create, preserve, or erode economic, environmental, and social impact for itself and its stakeholder and society as a whole.

    Materiality Assessment

    A tool to identify and prioritize the ESG issues most critical to the organization.

    Risk Sensing

    The range of activities carried out to identify and understand evolving sources of risk that could have a significant impact on the organization (e.g. social listening).

    Sustainability

    The ability of an organization and broader society to endure and survive over the long term by managing adverse impacts well and promoting positive opportunities.

    Sustainalytics

    Now part of Morningstar. Sustainalytics provides ESG research, ratings, and data to institutional investors and companies.

    UN Guiding Principles on Business and Human Rights (UNGPs)

    An essential methodological foundation for how impacts across all dimensions should be assessed.

    Reporting and standard frameworks

    Standard

    Definition and focus

    CDP
    (Formally Carbon Disclosure Project)

    CDP has created standards and metrics for comparing sustainability impact. Focuses on environmental data (e.g. carbon, water, and forests) and on data disclosure and benchmarking.

    Audience: All stakeholders

    Dow Jones Sustainability Indices (DJSI)

    Heavy on corporate governance and company performance. Equal balance of economic, environmental, and social.

    Audience: All stakeholders

    Global Reporting Initiative (GRI)

    International standards organization that has a set of standards to help organizations understand and communicate their impacts on climate change and social responsibility. The standard has a strong emphasis on transparency and materiality, especially on social issues.

    Audience: All stakeholders

    International Sustainability Standards Board (ISSB)

    Standard-setting board that sits within the International Financial Reporting Standards (IFRS) Foundation. The IFRS Foundation is a not-for-profit, public-interest organization established to develop high-quality, understandable, enforceable, and globally accepted accounting and sustainability disclosure standards.

    Audience: Investor-focused

    United Nations Sustainable Development Goals (SDGs)

    Global partnership across sectors and industries that sets out 17 goals to achieve sustainable development for all.

    Audience: All stakeholders

    Sustainability Accounting Standards Board (SASB)
    Now part of IFSR foundation

    Industry-specific standards to help corporations select topics that may impact their financial performance. Focus on material impacts on financial condition or operating performance.

    Audience: Investor-focused

    Task Force on Climate-Related Financial Disclosures (TCFD; created by the Financial Stability Board)

    Standards framework focused on the impact of climate risk on financial and operating performance. More broadly the disclosures inform investors of positive and negative measures taken to build climate resilience and make transparent the exposure to climate-related risk.

    Audience: Investors, financial stakeholders

    Bibliography

    "2021 Global Investor Survey: The Economic Realities of ESG." PwC, Dec. 2021. Accessed May 2022.

    "2023 Canadian ESG Reporting Insights." PwC, Nov. 2022. Accessed Dec. 2022.

    Althoff, Judson. "Microsoft Cloud for Sustainability: Empowering Organizations On Their Path To Net Zero." Microsoft Blog, 14 July 2021. Accessed May 2022.

    "Balancing Sustainability and Profitability." IBM, Feb. 2022. Accessed June. 2022.

    "Beyond Compliance: Consumers and Employees Want Business to Do More on ESG." PwC, Nov. 2021. Accessed July 2022.

    Bizo, Daniel. "Multi-Tenant Datacenters and Sustainability: Ambitions and Reality." S&P Market Intelligence, Sept. 2020. Web.

    Bolden, Kyle. "Aligning nonfinancial reporting with your ESG strategy to communicate long-term value." EY, 18 Dec. 2020. Web.

    Carril, Christopher, et al. "Looking at Restaurants Through an ESG Lens: ESG Stratify – Equity Research Report." RBC Capital Markets, 5 Jan. 2021. Accessed Jun. 2022.

    "Celebrating and Advancing Women." McDonald’s, 8 March 2019. Web.

    Clark, Anna. "Get your ESG story straight: A sustainability communication starter kit." GreenBiz, 20 Dec. 2022, Accessed Dec. 2022.

    Courtnell, Jane. “ESG Reporting Framework, Standards, and Requirements.” Corporate Compliance Insights, Sept. 2022. Accessed Dec. 2022.

    “Country Sustainability Ranking. Country Sustainability: Visibly Harmed by Covid-19.” Robeco, Oct. 2021. Accessed June 2022.

    “Defining the “G” in ESG Governance Factors at the Heart of Sustainable Business.” World Economic Forum, June 2022. Web.

    “Digital Assets: Laying ESG Foundations.” Global Digital Finance, Nov. 2021. Accessed April 2022.

    “Dow Jones Sustainability Indices (DJCI) Index Family.” S&P Global Intelligence, n.d. Accessed June 2022.

    "ESG in Your Business: The Edge You Need to Land Large Contracts." BDC, March 2023, Accessed April 2023.

    “ESG Performance and Its Impact on Corporate Reputation.” Intelex Technologies, May 2022. Accessed July 2022.

    “ESG Use Cases. IoT – Real-Time Occupancy Monitoring.” Metrikus, March 2021. Accessed April 2022.

    Fanter, Tom, et al. “The History & Evolution of ESG.” RMB Capital, Dec. 2021. Accessed May 2022.

    Flynn, Hillary, et al. “A guide to ESG materiality assessments.” Wellington Management, June 2022, Accessed September 2022

    “From ‘Disclose’ to ‘Disclose What Matters.’” Global Reporting Initiative, Dec. 2018. Accessed July 2022.

    “Getting Started with ESG.” Sustainalytics, 2022. Web.

    “Global Impact ESG Fact Sheet.” ServiceNow, Dec. 2021. Accessed June 2022.

    Gorley, Adam. “What is ESG and Why It’s Important for Risk Management.” Sustainalytics, March 2022. Accessed May 2022.

    Hall, Lindsey. “You Need Near-Term Accountability to Meet Long-Term Climate Goals.” S&P Global Sustainable1, Oct. 2021. Accessed April 2022.

    Henisz, Witold, et al. “Five Ways That ESG Creates Value.” McKinsey, Nov. 2019. Accessed July 2022.

    “Integrating ESG Factors in the Investment Decision-Making Process of Institutional Investors.” OECD iLibrary, n.d. Accessed July 2022.

    “Investor Survey.” Benchmark ESG, Nov. 2021. Accessed July 2022.

    Jackson, Brian. Tech Trends 2023, Info-Tech Research Group, Dec. 2022, Accessed Dec. 2022.

    Keet, Lior. “What Is the CIO’s Role in the ESG Equation?” EY, 2 Feb. 2022. Accessed May 2022.

    Lev, Helee, “Understanding ESG risks and why they matter” GreenBiz, June 2022. Accessed Dec 2022.

    Marsh, Chris, and Simon Robinson. “ESG and Technology: Impacts and Implications.” S&P Global Market Intelligence, March 2021. Accessed April 2022.

    Martini, A. “Socially Responsible Investing: From the Ethical Origins to the Sustainable Development Framework of the European Union.” Environment, Development and Sustainability, vol. 23, Nov. 2021. Web.

    Maher, Hamid, et al. “AI Is Essential for Solving the Climate Crisis.” Boston Consulting Group, 7 July 2022. Web.

    “Materiality Assessment. Identifying and Taking Action on What Matters Most.” Novartis, n.d. Accessed June. 2022.

    Morrow, Doug, et al. “Understanding ESG Incidents: Key Lessons for Investors.” Sustainalytics, July 2017. Accessed May 2022.

    “Navigating Climate Data Disclosure.” Novisto, July 2022. Accessed Nov. 2022.

    Nuttall, Robin, et al. “Why ESG Scores Are Here to Stay.” McKinsey & Company, May 2020. Accessed July 2022.

    “Opportunities in Sustainability – 451 Research’s Analysis of Sustainability Perspectives in the Data Center Industry.” Schneider Electric, Sept. 2020. Accessed May 2022.

    Peterson, Richard. “How Can NLP Be Used to Quantify ESG Analytics?” Refinitiv, Feb. 2021. Accessed June 2022.

    “PwC’s 25th Annual Global CEO Survey: Reimagining the Outcomes That Matter.” PwC, Jan. 2022. Accessed June 2022.

    “SEC Proposes Rules on Cybersecurity, Risk Management, Strategy, Governance, and Incident Disclosure by Public Companies.” Securities and Exchange Commission, 9 May 2022. Press release.

    Serafeim, George. “Social-Impact Efforts That Create Real Value.” Harvard Business Review, Sept. 2020. Accessed May 2022.

    Sherrie, Gonzalez. “ESG Planning and Performance Survey.” Diligent, 24 Sept. 2021. Accessed July 2022.

    “Special Reports Showcase, Special Report: Mid-Year Report on Proposed SEC Rule 14-8 Change.” Sustainable Investments Institute, July 2020. Accessed April 2022.

    “State of European Tech. Executive Summary Report.” Atomico, Nov. 2021. Accessed June 2022.

    “Top Challenges in ESG Reporting, and How ESG Management Solution Can Help.” Novisto, Sept. 2022. Accessed Nov. 2022.

    Vaughan-Smith, Gary. “Navigating ESG data sets and ‘scores’.” Silverstreet Capital, 23 March 2022. Accessed Dec. 2022.

    Waters, Lorraine. “ESG is not an environmental issue, it’s a data one.” The Stack, 20 May 2021. Web.

    Wells, Todd. “Why ESG, and Why Now? New Data Reveals How Companies Can Meet ESG Demands – And Innovate Supply Chain Management.” Diginomica, April 2022. Accessed July 2022.

    “XBRL is coming to corporate sustainability Reporting.” Novisto, Aug. 2022. Accessed Dec. 2022.

    Research Contributors and Experts

    Photo of Chris Parry

    Chris Parry
    VP of ESG, Datamine

    Chris Parry has recently been appointed as the VP of ESG at Datamine Software. Datamine’s dedicated ESG division provides specialized ESG technology for sustainability management by supporting key business processes necessary to drive sustainable outcomes.

    Chris has 15 years of experience building and developing business for enterprise applications and solutions in both domestic and international markets.

    Chris has a true passion for business-led sustainable development and is focused on helping organizations achieve their sustainable business outcomes through business transformation and digital software solutions.

    Datamine’s comprehensive ESG capability supports ESG issues such as the environment, occupational health and safety, and medical health and wellbeing. The tool assists with risk management, stakeholder management and business intelligence.

    Manage the Active Directory in the Service Desk

    • Buy Link or Shortcode: {j2store}489|cart{/j2store}
    • member rating overall impact: N/A
    • member rating average dollars saved: N/A
    • member rating average days saved: N/A
    • Parent Category Name: Service Desk
    • Parent Category Link: /service-desk
    • Actively maintaining the Active Directory is a difficult task that only gets more difficult with issues like stale accounts and privilege creep.
    • Adding permissions without removing them in lateral transfers creates access issues, especially when regulatory requirements like HIPAA require tight controls.
    • With the importance of maintaining and granting permissions within the Active Directory, organizations are hesitant to grant domain admin access to Tier 1 of the service desk. However, inundating Tier 2 analysts with requests to grant permissions takes away project time.

    Our Advice

    Critical Insight

    • Do not treat the Active Directory like a black box. Strive for accurate data and be proactive by managing your monitoring and audit schedules.
    • Catch outage problems before they happen by splitting monitoring tasks between daily, weekly, and monthly routines.
    • Shift left to save resourcing by employing workflow automation or scripted authorization for Tier 1 technicians.
    • Design actionable metrics to monitor and manage your Active Directory.

    Impact and Result

    • Consistent and right-sized monitoring and updating of the Active Directory is key to clean data.
    • Split monitoring activities between daily, weekly, and monthly checklists to raise efficiency.
    • If need be, shift-left strategies can be implemented for identity and access management by scripting the process so that it can be done by Tier 1 technicians.

    Manage the Active Directory in the Service Desk Research & Tools

    Start here – read the Executive Brief

    Read our concise Executive Brief to find out why you should manage your Active Directory in the service desk, review Info-Tech’s methodology, and understand the four ways we can support you in completing this project.

    Besides the small introduction, subscribers and consulting clients within this management domain have access to:

    1. Maintain your Active Directory with clean data

    Building and maintaining your Active Directory does not have to be difficult. Standardized organization and monitoring with the proper metrics help you keep your data accurate and up to date.

    • Active Directory Standard Operating Procedure
    • Active Directory Metrics Tool

    2. Structure your service desk Active Directory processes

    Build a comprehensive Active Directory workflow library for service desk technicians to follow.

    • Active Directory Process Workflows (Visio)
    • Active Directory Process Workflows (PDF)
    [infographic]

    Essentials of Vendor Management for Small Business

    • Buy Link or Shortcode: {j2store}229|cart{/j2store}
    • member rating overall impact: N/A
    • member rating average dollars saved: N/A
    • member rating average days saved: N/A
    • Parent Category Name: Vendor Management
    • Parent Category Link: /vendor-management
    • Each year, SMB IT organizations spend more money “outsourcing” tasks, activities, applications, functions, and other items.
    • Many SMBs lack the affordability of implementing a sophisticated vendor management initiative or office.
    • The increased spend and associated outsourcing leads to less control, and more risk for IT organizations. Managing this becomes a higher priority for IT, but many IT organizations are ill-equipped to do this proactively.

    Our Advice

    Critical Insight

    • Vendor management is not “plug and play” – each organization’s vendor management initiative (VMI) needs to fit its culture, environment, and goals. There are commonalities among vendor management initiatives, but the key is to adapt vendor management principles to fit your needs, not the other way around.
    • All vendors are not of equal importance to an organization. Internal resources are a scarce commodity and should be deployed so that they provide the best return on the organization’s investment. Classifying or segmenting your vendors allows you to focus your efforts on the most important vendors first, allowing your VMI to have the greatest impact possible.
    • Having a solid foundation is critical to the VMI’s ongoing success. Whether you will be creating a formal vendor management office or using vendor management techniques, tools, and templates “informally”, starting with the basics is essential. Make sure you understand why the VMI exists and what it hopes to achieve, what is in and out of scope for the VMI, what strengths the VMI can leverage and the obstacles it will have to address, and how it will work with other areas within your organization.

    Impact and Result

    • Build and implement a vendor management initiative tailored to your environment.
    • Create a solid foundation to sustain your vendor management initiative as it evolves and matures.
    • Leverage vendor management-specific tools and templates to manage vendors more proactively and improve communication.
    • Concentrate your vendor management resources on the right vendors.
    • Build a roadmap and project plan for your vendor management journey to ensure you reach your destination.
    • Build collaborative relationships with critical vendors.

    Essentials of Vendor Management for Small Business Research & Tools

    Start here – read the Executive Brief

    Read this Executive Brief to understand how changes in the vendor landscape and customer reliance on vendors have made a vendor management initiative indispensible.

    Besides the small introduction, subscribers and consulting clients within this management domain have access to:

    1. Plan

    This phase helps you organize your VMI and document internal processes, relationships, roles, and responsibilities. The main outcomes from this phase are organizational documents, a baseline VMI maturity level, and a desired future state for the VMI.

    • Essentials of Vendor Management for Small Business – Phase 1: Plan
    • Phase 1 Small Business Tools and Templates Compendium

    2. Build

    This phase helps you configure and create the tools and templates that will help you run the VMI. The main outcomes from this phase are a clear understanding of which vendors are important to you, the tools to manage the vendor relationships, and an implementation plan.

    • Essentials of Vendor Management for Small Business – Phase 2: Build
    • Phase 2 Small Business Vendor Classification Tool
    • Phase 2 Small Business Risk Assessment Tool
    • Phase 2 Small Business Tools and Templates Compendium

    3. Run

    This phase helps you begin operating the VMI. The main outcomes from this phase are guidance and the steps required to implement your VMI.

    • Essentials of Vendor Management for Small Business – Phase 3: Run

    4. Review

    This phase helps the VMI identify what it should stop doing, start doing, and continue doing as it improves and matures. The main outcomes from this phase are ways to advance the VMI and maintain internal alignment.

    • Essentials of Vendor Management for Small Business – Phase 4: Review
    [infographic]

    Further reading

    Essentials of Vendor Management for Small Business

    Create and implement a vendor management framework to begin obtaining measurable results in 90 days.

    EXECUTIVE BRIEF

    Analyst Perspective

    Vendor Management Challenge

    Small businesses are often challenged by the growth and complexity of their vendor ecosystem, including the degree to which the vendors control them. Vendors are increasing, obtaining more and more budget dollars, while funding for staff or headcount is decreasing as a result of cloud-based applications and an increase in our reliance on Managed Service Providers. Initiating a vendor management initiative (VMI) vs. creating a fully staffed vendor management office will get you started on the path of proactively controlling your vendors instead of consistently operating in a reactionary mode. This blueprint is designed with that very thought: to assist small businesses in creating the essentials of a vendor management initiative.

    This is a picture of Steve Jeffery

    Steve Jeffery
    Principal Research Director, Vendor Management
    Info-Tech Research Group

    Executive Summary

    Your Challenge

    Each year, IT organizations "outsource" tasks, activities, functions, and other items. During 2021:

    • Spend on as-a-service providers increased 38% over 2020.*
    • Spend on managed service providers increased 16% over 2020.*
    • IT service providers increased their merger and acquisition numbers by 47% over 2020.*

    This leads to more spend, less control, and more risk for IT organizations. Managing this becomes a higher priority for IT, but many IT organizations are ill-equipped to do this proactively.

    Common Obstacles

    As new contracts are negotiated and existing contracts are renegotiated or renewed, there is a perception that the contracts will yield certain results, output, performance, solutions, or outcomes. The hope is that these will provide a measurable expected value to IT and the organization. Oftentimes, much of the expected value is never realized. Many organizations don't have a VMI to help:

    • Ensure at least the expected value is achieved.
    • Improve on the expected value through performance management.
    • Significantly increase the expected value through a proactive VMI.

    Info-Tech's Approach

    Vendor Management is a proactive, cross-functional lifecycle. It can be broken down into four phases:

    • Plan
    • Build
    • Run
    • Review

    The Info-Tech process addresses all four phases and provides a step-by-step approach to configure and operate your VMI. The content in this blueprint helps you quickly establish your VMI and sets a solid foundation for its growth and maturity.

    Info-Tech Insight

    Vendor management is not a one-size-fits-all initiative. It must be configured:

    • For your environment, culture, and goals.
    • To leverage the strengths of your organization and personnel.
    • To focus your energy and resources on your critical vendors.

    Executive Summary

    Your challenge

    Spend on managed service providers and as-a-service providers continues to increase. In addition, IT services vendors continue to be active in the mergers and acquisitions arena. This increases the need for a VMI to help with the changing IT vendor landscape.

    38%

    2021

    16%

    2021

    47%

    2021

    Spend on as-a-service providers

    Spend on managed services providers

    IT services merger & acquisition growth (transactions)

    Source: Information Services Group, Inc., 2022.

    Executive Summary

    Common obstacles

    When organizations execute, renew, or renegotiate a contract, there is an "expected value" associated with that contract. Without a robust VMI, most of the expected value will never be realized. With a robust VMI, the realized value significantly exceeds the expected value during the contract term.

    A contract's realized value with and without a vendor management initiative

    This is an image of a bar graph showing the difference in value between those with and without a VMI, with and for those with a VMI, with Vendor Collaboration and with Vendor Performance Management. The data for those with a VMI have substantially more value.

    Source: Based on findings from Geller & Company, 2003.

    Executive Summary

    Info-Tech's approach

    A sound, cyclical approach to vendor management will help you create a VMI that meets your needs and stays in alignment with your organization as they both change (i.e. mature and grow).

    This is an image of the 4 Step Vendor Management Process. The four steps are: 1. Plan; 2. Build; 3. Run; 4. Review.

    Info-Tech's methodology for creating and operating your vmi

    Phase 1 - Plan Phase 2 - Build Phase 3 - Run Phase 4 - Review
    Phase Steps

    1.1 Mission Statement and Goals

    1.2 Scope

    1.3 Strengths and Obstacles

    1.4 Roles and Responsibilities

    2.1 Classification Model

    2.2 Risk Assessment Tool

    2.3 Scorecards and Feedback

    2.4 Business Alignment Meeting Agenda

    2.5 Relationship Alignment Document

    2.6 Vendor Orientation

    2.7 3-Year Roadmap

    2.8 90-Day Plan

    2.9 Quick Wins2.10 Reports

    3.1 Classify Vendors

    3.2 Compile Scorecards

    3.3 Conduct Business Alignment Meetings

    3.4 Work the 90-Day Plan

    3.5 Manage the 3-Year Roadmap

    3.6 Develop/Improve Vendor Relationships

    4.1 Incorporate Leading Practices

    4.2 Leverage Lessons Learned

    4.3 Maintain Internal Alignment

    Phase Outcomes This phase helps you organize your VMI and document internal processes, relationships, roles, and responsibilities. The main outcomes from this phase are organizational documents, a baseline VMI maturity level, and a desired future state for the VMI. This phase helps you configure and create the tools and templates that will help you run the VMI. The main outcomes from this phase are a clear understanding of which vendors are important to you, the tools to manage the vendor relationships, and an implementation plan. This phase helps you begin operating the VMI. The main outcomes from this phase are guidance and the steps required to implement your VMI. This phase helps the VMI identify what it should stop doing, start doing, and continue doing as it improves and matures. The main outcomes from this phase are ways to advance the VMI and maintain internal alignment.

    Insight Summary

    Insight 1

    Vendor management is not "plug and play" – each organization's vendor management initiative (VMI) needs to fit its culture, environment, and goals. While there are commonalities and leading practices associated with vendor management, your initiative won't look exactly like another organization's. The key is to adapt vendor management principles to fit your needs.

    Insight 2

    All vendors are not of equal importance to your organization. Internal resources are a scarce commodity and should be deployed so that they provide the best return on the organization's investment. Classifying or segmenting your vendors allows you to focus your efforts on the most important vendors first, allowing your VMI to have the greatest impact possible.

    Insight 3

    Having a solid foundation is critical to the VMI's ongoing success. Whether you will be creating a formal vendor management office or using vendor management techniques, tools, and templates "informally", starting with the basics is essential. Make sure you understand why the VMI exists and what it hopes to achieve, what is in and out of scope for the VMI, what strengths the VMI can leverage and the obstacles it will have to address, and how it will work with other areas within your organization.

    Blueprint benefits

    IT benefits

    • Identify and manage risk proactively.
    • Reduce costs and maximize value.
    • Increase visibility with your critical vendors.
    • Improve vendor performance.
    • Create a collaborative environment with key vendors.
    • Segment vendors to allocate resources more effectively and more efficiently.

    Business benefits

    • Improve vendor accountability.
    • Increase collaboration between departments.
    • Improve working relationships with your vendors.
    • Create a feedback loop to address vendor/customer issues before they get out of hand or are more costly to resolve.
    • Increase access to meaningful data and information regarding important vendors.

    Phase 1 - Plan

    Phase 1

    Phase 2 Phase 3 Phase 4

    1.1 Mission Statement and Goals

    1.2 Scope

    1.3 Strengths and Obstacles

    1.4 Roles and Responsibilities

    2.1 Classification Model

    2.2 Risk Assessment Tool

    2.3 Scorecards and Feedback

    2.4 Business Alignment Meeting Agenda

    2.5 Relationship Alignment Document

    2.6 Vendor Orientation

    2.7 3-Year Roadmap

    2.8 90-Day Plan

    2.9 Quick Wins

    2.10 Reports

    3.1 Classify Vendors

    3.2 Compile Scorecards

    3.3 Conduct Business Alignment Meetings

    3.4 Work the 90-Day Plan

    3.5 Manage the 3-Year Roadmap

    3.6 Develop/Improve Vendor Relationships

    4.1 Incorporate Leading Practices

    4.2 Leverage Lessons Learned

    4.3 Maintain Internal Alignment

    This phase will walk you through the following activity:

    • Organizing your VMI and document internal processes, relationships, roles, and responsibilities. The main outcomes from this phase are organizational documents, and a desired future state for the VMI.

    This phase involves the following participants:

    • VMI team
    • Applicable stakeholders and executives
    • Procurement/Sourcing
    • IT
    • Others as needed

    Vendor Management Initiative Basics for the Small/Medium Businesses

    Phase 1 – Plan

    Get Organized

    Phase 1 – Plan focuses on getting organized. Foundational elements (Mission Statement, Goals, Scope, Strengths and Obstacles, Roles and Responsibilities, and Process Mapping) will help you define your VMI. These and the other elements of this Phase will follow you throughout the process of starting up your VMI and running it.

    Spending time up front to ensure that everyone is on the same page will help avoid headaches down the road. The tendency is to skimp (or even skip) on these steps to get to "the good stuff." To a certain extent, the process provided here is like building a house. You wouldn't start building your dream home without having a solid blueprint. The same is true with vendor management. Leveraging vendor management tools and techniques without the proper foundation may provide some benefit in the short term, but in the long term it will ultimately be a house of cards waiting to collapse.

    Step 1.1 – Mission statement and goals

    Identify why the VMI exists and what it will achieve

    Whether you are starting your vendor management journey or are already down the path, it is important to know why the vendor management initiative exists and what it hopes to achieve. The easiest way to document this is with a written declaration in the form of a Mission Statement and Goals. Although this is the easiest way to proceed, it is far from easy.

    The Mission Statement should identify at a high level the nature of the services provided by the VMI, who it will serve, and some of the expected outcomes or achievements. The Mission Statement should be no longer than one or two sentences.

    The complement to the Mission Statement is the list of goals for the VMI. Your goals should not be a reassertion of your Mission Statement in bullet format. At this stage it may not be possible to make them SMART (Specific, Measurable, Achievable/Attainable, Relevant, Time-Bound/Time-Based), but consider making them as SMART as possible. Without some of the SMART parameters attached, your goals are more like dreams and wishes. At a minimum, you should be able to determine the level of success achieved for each of the VMI goals.

    Although the VMI's Mission Statement will stay static over time (other than for significant changes to the VMI or organization as a whole), the goals should be reevaluated periodically using a SMART filter, and adjusted as needed.

    1.1.1 – Mission statement and goals

    20 – 40 Minutes

    1. Meet with the participants and use a brainstorming activity to list, on a whiteboard or flip chart, the reasons why the VMI will exist.
    2. Review external mission statements for inspiration.
    3. Review internal mission statements from other areas to ensure consistency.
    4. Draft and document your Mission Statement in the Phase 1 Tools and Templates Compendium – Tab 1.1 Mission Statement and Goals.
    5. Continue brainstorming and identify the high-level goals for the VMI.
    6. Review the list of goals and make them as SMART (Specific, Measurable, Achievable/Attainable, Relevant, Time-Bound/Time-Based) as possible.
    7. Document your goals in the Phase 1 Tools and Templates Compendium– Tab 1.1 Mission Statement and Goals.
    8. Obtain signoff on the Mission Statement and goals from stakeholders and executives as required.

    Input

    • Brainstorming results
    • Mission statements from other internal and external sources

    Output

    • Completed Mission Statement and Goals

    Materials

    • Whiteboard/Flip Charts
    • Phase 1 Tools and Templates Compendium – Tab 1.1 Mission Statement and Goals

    Participants

    • VMI team
    • Applicable stakeholders and executives (as needed)

    Download the Info-Tech Phase 1 Tools and Templates Compendium

    Step 1.2 – Scope

    Determine what is in scope and out of scope for the VMI

    Regardless of where your VMI resides or how it operates, it will be working with other areas within your organization. Some of the activities performed by the VMI will be new and not currently handled by other groups or individuals internally; at the same time, some of the activities performed by the VMI may be currently handled by other groups or individuals internally. In addition, executives, stakeholders, and other internal personnel may have expectations or make assumptions about the VMI. As a result, there can be a lot of confusion about what the VMI does and doesn't do, and the answers cannot always be found in the VMI's Mission Statement and Goals.

    One component of helping others understand the VMI landscape is formalizing the VMI Scope. The Scope will define boundaries for the VMI. The intent is not to fence itself off and keep others out but provide guidance on where the VMI's territory begins and ends. Ultimately, this will help clarify the VMI's roles and responsibilities, improve workflow, and reduce errant assumptions.

    When drafting your VMI scoping document, make sure you look at both sides of the equation (similar to what you would do when following best practices for a statement of work). Identify what is in scope and what is out of scope. Be specific when describing the individual components of the VMI Scope, and make sure executives and stakeholders are onboard with the final version.

    1.2.1 – Scope

    20 - 40 Minutes

    1. Meet with the participants and use a brainstorming activity to list, on a whiteboard or flip chart, the activities and functions in scope and out of scope for the VMI.
      1. Be specific to avoid ambiguity and improve clarity.
      2. Go back and forth between in scope and out of scope as needed; it is not necessary to list all the in-scope items and then turn your attention to the out-of-scope items.
    2. Review the lists to make sure there is enough specificity. An item may be in scope or out of scope, but not both.
    3. Use the Phase 1 Tools and Templates Compendium – Tab 1.2 Scope to document the results.
    4. Obtain signoff on the Scope from stakeholders and executives as required.

    Input

    • Brainstorming results
    • Mission Statement and Goals

    Output

    • Completed list of items in and out of scope for the VMI

    Materials

    • Whiteboard/Flip Charts
    • Phase 1 Tools and Templates Compendium – Tab 1.2 Scope

    Participants

    • VMI team
    • Applicable stakeholders and executives (as needed)

    Download the Info-Tech Phase 1 Tools and Templates Compendium

    Step 1.3 – Strengths and obstacles

    Pinpoint the VMI's strengths and obstacles

    A SWOT analysis (strengths, weaknesses, opportunities, and threats) is a valuable tool, but it is overkill for your VMI at this point. However, using a modified and simplified form of this tool (strengths and obstacles) will yield significant results and benefit the VMI as it grows and matures.

    Your output will be two lists: the strengths associated with the VMI and the obstacles the VMI is facing. For example, strengths could include items such as smart people working within the VMI and executive support. Obstacles could include items such as limited headcount and training required for VMI staff.

    The goals are 1) to harness the strengths to help the VMI be successful and 2) to understand the impact of the obstacles and plan accordingly. The output can also be used to enlighten executives and stakeholders about the challenges associated with their directives or requests (e.g. human bandwidth may not be sufficient to accomplish some of the vendor management activities and there is a moratorium on hiring until the next budget year).

    For each strength identified, determine how you will or can leverage it when things are going well or when the VMI is in a bind. For each obstacle, list the potential impact on the VMI (e.g. scope, growth rate, and number of vendors that can actively be part of the VMI).

    As you do your brainstorming, be as specific as possible and validate your lists with stakeholders and executives as needed.

    1.3.1 – Strengths and obstacles

    20 - 40 Minutes

    Meet with the participants and use a brainstorming activity to list, on a whiteboard or flip chart, the VMI's strengths and obstacles.

    Be specific to avoid ambiguity and improve clarity.

    Go back and forth between strengths and obstacles as needed; it is not necessary to list all the strengths first and then all the obstacles.

    It is possible for an item to be a strength and an obstacle; when this happens, add details to distinguish the situations.

    Review the lists to make sure there is enough specificity.

    Determine how you will leverage each strength and how you will manage each obstacle.

    Use the Phase 1 Tools and Templates Compendium – Tab 1.3 Strengths and Obstacles to document the results.

    Obtain signoff on the strengths and obstacles from stakeholders and executives as required.

    Input

    • Brainstorming
    • Mission Statement and Goals
    • Scope

    Output

    • Completed list of items impacting the VMI's ability to be successful: strengths the VMI can leverage and obstacles the VMI must manage

    Materials

    • Whiteboard/Flip Charts
    • Phase 1 Tools and Templates Compendium – Tab 1.3 Strengths and Obstacles

    Participants

    • VMI team
    • Applicable stakeholders and executives (as needed)

    Download the Info-Tech Phase 1 Tools and Templates Compendium

    Step 1.4 – Roles and responsibilities

    Obtain consensus on who is responsible for what

    One crucial success factor for VMIs is gaining and maintaining internal alignment. There are many moving parts to an organization, and a VMI must be clear on the various roles and responsibilities related to the relevant processes. Some of this information can be found in the VMI's Scope referenced in Step 1.2, but additional information is required to avoid stepping on each other's toes; many of the processes require internal departments to work together. (For example, obtaining requirements for a request for proposal takes more than one person or department). While it is not necessary to get too granular, it is imperative that you have a clear understanding of how the VMI activities will fit within the larger vendor management lifecycle (which is comprised of many sub processes) and who will be doing what.

    As we have learned through our workshops and guided implementations, a traditional RACI* or RASCI* Chart does not work well for this purpose. These charts are not intuitive, and they lack the specificity required to be effective. For vendor management purposes, a higher-level view and a slightly different approach provide much better results.

    This step will lead your through the creation of an OIC* Chart to determine vendor management lifecycle roles and responsibilities. Afterward, you'll be able to say, "Oh, I see clearly who is involved in each part of the process and what their role is."

    *RACI – Responsible, Accountable, Consulted, Informed

    *RASCI – Responsible, Accountable, Support, Consulted, Informed

    *OIC – Owner, Informed, Contributor

    This is an image of a table, where the row headings are: Role 1-5, and the Column Headings are: Step 1-5.

    Step 1.4 – Roles and responsibilities (cont'd)

    Obtain consensus on who is responsible for what

    To start, define the vendor management lifecycle steps or process applicable to your VMI. Next, determine who participates in the vendor management lifecycle. There is no need to get too granular – think along the lines of departments, subdepartments, divisions, agencies, or however you categorize internal operational units. Avoid naming individuals other than by title; this typically happens when a person oversees a large group (e.g. the CIO [chief information officer] or the CPO [chief procurement officer]). Be thorough, but don't let the chart get out of hand. For each role and step of the lifecycle, ask whether the entry is necessary; does it add value to the clarity of understanding the responsibilities associated with the vendor management lifecycle? Consider two examples, one for roles and one for lifecycle steps. 1) Is IT sufficient or do you need IT Operations and IT Development? 2) Is "negotiate contract documents" sufficient or do you need negotiate the contract and negotiate the renewal? The answer will depend on your culture and environment but be wary of creating a spreadsheet that requires an 85-inch monitor to view it.

    After defining the roles (departments, divisions, agencies) and the vendor management lifecycle steps or process, assign one of three letters to each box in your chart:

    • O – Owner – who owns the process; they may also contribute to it.
    • I – Informed – who is informed about the progress or results of the process.
    • C – Contributor – who contributes or works on the process; it can be tangible or intangible contributions.

    This activity can be started by the VMI or done as a group with representatives from each of the named roles. If the VMI starts the activity, the resulting chart should be validated by the each of the named roles.

    1.4.1 – Roles and responsibilities

    1 – 6 hours

    1. Meet with the participants and configure the OIC Chart in the Phase 1 Tools and Templates Compendium – Tab 1.4 OIC Chart.
      1. Review the steps or activities across the top of the chart and modify as needed.
      2. Review the roles listed along the left side of the chart and modify as needed.
    2. For each activity or step across the top of the chart, assign each role a letter – O for owner of that activity or step, I for informed, or C for contributor. Use only one letter per cell.
    3. Work your way across the chart. Every cell should have an entry or be left blank if it is not applicable.
    4. Review the results and validate that every activity or step has an O assigned to it; there must be an owner for every activity or step.
    5. Obtain signoff on the OIC Chart from stakeholders and executives as required.

    Input

    • A list of activities or steps to complete a project starting with requirements gathering and ending with ongoing risk management.
    • A list of internal areas (departments, divisions, agencies, etc.) and stakeholders that contribute to completing a project.

    Output

    • Completed OCI chart indicating roles and responsibilities for the VMI and other internal areas.

    Materials

    • Phase 1 Tools and Templates Compendium – Tab 1.4 OIC Chart

    Participants

    • VMI team
    • Procurement/Sourcing
    • IT
    • Representatives from other areas as needed
    • Applicable stakeholders and executives (as needed)

    Download the Info-Tech Phase 1 Tools and Templates Compendium

    Phase 2 - Build

    Create and configure tools, templates, and processes

    Phase 1

    Phase 2Phase 3Phase 4

    1.1 Mission Statement and Goals

    1.2 Scope

    1.3 Strengths and Obstacles

    1.4 Roles and Responsibilities

    2.1 Classification Model

    2.2 Risk Assessment Tool

    2.3 Scorecards and Feedback

    2.4 Business Alignment Meeting Agenda

    2.5 Relationship Alignment Document

    2.6 Vendor Orientation

    2.7 3-Year Roadmap

    2.8 90-Day Plan

    2.9 Quick Wins

    2.10 Reports

    3.1 Classify Vendors

    3.2 Compile Scorecards

    3.3 Conduct Business Alignment Meetings

    3.4 Work the 90-Day Plan

    3.5 Manage the 3-Year Roadmap

    3.6 Develop/Improve Vendor Relationships

    4.1 Incorporate Leading Practices

    4.2 Leverage Lessons Learned

    4.3 Maintain Internal Alignment

    This phase will walk you through the following activities:

    • Configuring and creating the tools and templates that will help you run the VMI. The main outcomes from this phase are a clear understanding of which vendors are important to you, the tools to manage the vendor relationships, and an implementation plan.

    This phase involves the following participants:

    • VMI team
    • Applicable stakeholders and executives
    • Human Resources
    • Legal
    • Others as needed

    Vendor Management Initiative Basics for the Small/Medium Businesses

    Phase 2 – Build

    Create and configure tools, templates, and processes

    Phase 2 – Build focuses on creating and configuring the tools and templates that will help you run your VMI. Vendor management is not a plug and play environment, and unless noted otherwise, the tools and templates included with this blueprint require your input and thought. The tools and templates must work in concert with your culture, values, and goals. That will require teamwork, insights, contemplation, and deliberation.

    During this Phase you'll leverage the various templates and tools included with this blueprint and adapt them for your specific needs and use. In some instances, you'll be starting with mostly a blank slate; while in others, only a small modification may be required to make it fit your circumstances. However, it is possible that a document or spreadsheet may need heavy customization to fit your situation. As you create your VMI, use the included materials for inspiration and guidance purposes rather than as absolute dictates.

    Step 2.1 – Classification model

    Configure the COST vendor classification tool

    One of the functions of a VMI is to allocate the appropriate level of vendor management resources to each vendor since not all vendors are of equal importance to your organization. While some people may be able intuitively to sort their vendors into vendor management categories, a more objective, consistent, and reliable model works best. Info-Tech's COST model helps you assign your vendors to the appropriate vendor management category so that you can focus your vendor management resources where they will do the most good.

    COST is an acronym for Commodity, Operational, Strategic, and Tactical. Your vendors will occupy one of these vendor management categories, and each category helps you determine the nature of the resources allocated to that vendor, the characteristics of the relationship desired by the VMI, and the governance level used.

    The easiest way to think of the COST model is as a 2 x 2 matrix or graph. The model should be configured for your environment so that the criteria used for determining a vendor's classification align with what is important to you and your organization. However, at this point in your VMI's maturation, a simple approach works best. The Classification Model included with this blueprint requires minimal configuration to get your started, and that is discussed on the activity slide associated with this Step 2.1.

    This is an image of the COST Vendor Classification Tool.

    Step 2.1 – Classification model (cont'd)

    Configure the COST vendor classification tool

    Common characteristics by vendor management category

    Operational

    Strategic
    • Low to moderate risk and criticality; moderate to high spend and switching costs
    • Product or service used by more than one area
    • Price is a key negotiation point
    • Product or service is valued by the organization
    • Quality or the perception of quality is a differentiator (i.e. brand awareness)
    • Moderate to high risk and criticality; moderate to high spend and switching costs
    • Few competitors and differentiated products and services
    • Product or service significantly advances the organization's vision, mission, and success
    • Well-established in their core industry

    Commodity

    Tactical
    • Low risk and criticality; low spend and switching costs
    • Product or service is readily available from many sources
    • Market has many competitors and options
    • Relationship is transactional
    • Price is the main differentiator
    • Moderate to high risk and criticality; low to moderate spend and switching costs
    • Vendor offerings align with or support one or more strategic objectives
    • Often IT vendors "outside" of IT (i.e. controlled and paid for by other areas)
    • Often niche or new vendors

    Source: Compiled in part from Guth, Stephen. "Vendor Relationship Management Getting What You Paid for (And More)." 2015.

    2.1.1 – Classification model

    15 – 30 Minutes

    1. Meet with the participants to configure the spend ranges in Phase 2 Vendor Classification Tool – Tab 1. Configuration for your environment.
    2. Collect your vendors and their annual spend to sort by largest to lowest.
    3. Update cells F14-J14 in the Classification Model based on your actual data.
      1. Cell F14 – Set the boundary at a point between the spend for your 10th and 11th ranked vendors. For example, if the 10th vendor by spend is $1,009, 850 and the 11th vendor by spend is $980,763, the range for F14 would be $1,000,00+.
      2. Cell G14 – Set the bottom of the range at a point between the spend for your 30th and 31st ranked vendors; the top of the range will be $1 less than the bottom of the range specified in F14.
      3. Cell H14 – Set the bottom of the range slightly below the spend for your 50th ranked vendor; the top of the range will be $1 less than the bottom of the range specified in G14.
      4. Cells I14 and J14 – Divide the remaining range in half and split it between the two cells; for J14 the range will be $0 to $1 less than the bottom range in I14.
    4. Ignore the other variables at this time.

    Input

    • Phase 1 List of Vendors by Annual Spend

    Output

    • Configured Vendor Classification Tool

    Materials

    • Phase 2 Vendor Classification Tool – Tab 1. Configuration

    Participants

    • VMI team

    Download the Info-Tech Phase 2 Vendor Classification Tool

    Step 2.2 – Risk assessment tool

    Identify risks to measure, monitor, and report on

    One of the typical drivers of a VMI is risk management. Organizations want to get a better handle on the various risks their vendors pose. Vendor risks originate from many areas: financial, performance, security, legal, and others. However, security risk is the high-profile risk, and the one organizations often focus on almost exclusively, which leaves the organization vulnerable in other areas.

    Risk management is a program, not a project; there is no completion date. A proactive approach works best and requires continual monitoring, identification, and assessment. Reacting to risks after they occur can be costly and have other detrimental effects on the organization. Any risk that adversely affects IT will adversely affect the entire organization.

    While the VMI won't necessarily be quantifying or calculating the risk directly, it generally is the aggregator of risk information across the risk categories, which it then includes in its reporting function (see Steps 2.12 and 3.8).

    At a minimum, your risk management strategy should involve:

    • Identifying the risks you want to measure and monitor.
    • Identifying your risk appetite (the amount of risk you are willing to live with).
    • Measuring, monitoring, and reporting on the applicable risks.
    • Developing and deploying a risk management plan to minimize potential risk impact.

    Vendor risk is a fact of life, but you do have options for how to handle it. Be proactive and thoughtful in your approach, and focus your resources on what is important.

    2.2.1 – Risk assessment tool

    30 - 90 Minutes

    1. Meet with the participants to configure the risk indicators in Phase 2 Vendor Risk Assessment Tool – Tab 1. Set parameters for your environment.
    2. Review the risk categories and determine which ones you will be measuring and monitoring.
    3. Review the risk indicators under each risk category and determine whether the indicator is acceptable as written, is acceptable with modifications, should be replaced, or should be deleted.
    4. Make the necessary changes to the risk indicators; these changes will cascade to each of the vendor tabs. Limit the number of risk indicators to no more than seven per risk category.
    5. Gain input and approval as needed from sponsors, stakeholders, and executives as required.

    Input

    • Scope
    • OIC Chart
    • Process Maps
    • Brainstorming

    Output

    • Configured Vendor Risk Assessment Tool

    Materials

    • Phase 2 Vendor Risk Assessment Tool – Tab 1. Set Parameters

    Participants

    • VMI team

    Download the Info-Tech Phase 2 Vendor Classification Tool

    Step 2.3 – Scorecards and feedback

    Design a two-way feedback loop with your vendors

    A vendor management scorecard is a great tool for measuring, monitoring, and improving relationship alignment. In addition, it is perfect for improving communication between you and the vendor.

    Conceptually, a scorecard is similar to a school report card. At the end of a learning cycle, you receive feedback on how well you do in each of your classes. For vendor management, the scorecard is also used to provide periodic feedback, but there are some nuances and additional benefits and objectives when compared to a report card.

    Although scorecards can be used in a variety of ways, the focus here will be on vendor management scorecards – contract management, project management, and other types of scorecards will not be included in the materials covered in this Step 2.3 or in Step 3.4.

    This image contains a table with the score for objectives A-D. The scores are: A4, B3, C5, D4.

    Step 2.3 – Scorecards and feedback (cont'd)

    Design a two-way feedback loop with your vendors

    Anatomy

    The Info-Tech scorecard includes five areas:

    • Measurement categories. Measurement categories help organize the scorecard. Limit the number of measurement categories to three to five; this allows the parties to stay focused on what's important. Too many measurement categories make it difficult for the vendor to understand the expectations.
    • Criteria. The criteria describe what is being measured. Create criteria with sufficient detail to allow the reviewers to fully understand what is being measured and to evaluate it. Criteria can be objective or subjective. Use three to five criteria per measurement category.
    • Measurement category weights. Not all your measurement categories may be of equal importance to you; this area allows you to give greater weight to a measurement category when compiling the overall score.
    • Rating. Reviewers will be asked to assign a score to each criteria using a 1 to 5 scale.
    • Comments. A good scorecard will include a place for reviewers to provide additional information regarding the rating, or other items that are relevant to the scorecard.

    An overall score is calculated based on the rating for each criteria and the measurement category weights.

    Step 2.3 – Scorecards and feedback (cont'd)

    Design a two-way feedback loop with your vendors

    Goals and objectives

    Scorecards can be used for a variety of reasons. Some of the common ones are:

    • Improving vendor performance.
    • Conveying expectations to the vendor.
    • Identifying and recognizing top vendors.
    • Increasing alignment between the parties.
    • Improving communication with the vendor.
    • Comparing vendors across the same criteria.
    • Measuring items not included in contract metrics.
    • Identifying vendors for "strategic alliance" consideration.
    • Helping the organization achieve specific goals and objectives.

    Identifying and resolving issues before they impact performance or the relationship.

    Identifying your scorecard drivers first will help you craft a suitable scorecard.

    Step 2.3 – Scorecards and feedback (cont'd)

    Design a two-way feedback loop with your vendors

    Info-Tech recommends starting with simple scorecards to allow you and the vendors to acclimate to the new process and information. As you build your scorecards, keep in mind that internal personnel will be scoring the vendors and the vendors will be reviewing the scorecard. Make your scorecard easy for your personnel to fill out, and containing meaningful content to drive the vendor in the right direction. You can always make the scorecard more complex in the future.

    Our recommendation of five categories is provided below. Choose three to five of the categories that help you accomplish your scorecard goals and objectives:

    1. Timeliness – Responses, resolutions, fixes, submissions, completions, milestones, deliverables, invoices, etc.
    2. Cost – Total cost of ownership, value, price stability, price increases/decreases, pricing models, etc.
    3. Quality – Accuracy, completeness, mean time to failure, bugs, number of failures, etc.
    4. Personnel – Skilled, experienced, knowledgeable, certified, friendly, trustworthy, flexible, accommodating, etc.
    5. Risk – Adequate contractual protections, security breaches, lawsuits, finances, audit findings, etc.

    Some criteria may be applicable in more than one category. The categories above should cover at least 80% of the items that are important to your organization. The general criteria listed for each category is not an exhaustive list, but most things break down into time, money, quality, people, and risk issues.

    Step 2.3 – Scorecards and feedback (cont'd)

    Design a two-way feedback loop with your vendors

    Additional Considerations

    • Even a good rating system can be confusing. Make sure you provide some examples or a way for reviewers to discern the differences between a 1, 2, 3, 4, and 5. Don't assume your "rating key" will be intuitive.
    • When assigning weights, don't go lower than 10% for any measurement category. If the weight is too low, it won't be relevant enough to have an impact on the total score. If it doesn't "move the needle", don't include it.
    • Final sign-off on the scorecard template should occur outside the VMI. The heavy lifting can be done by the VMI to create it, but the scorecard is for the benefit of the organization overall, and those impacted by the vendors specifically. You may end up playing arbiter or referee, but the scorecard is not the exclusive property of the VMI. Try to reach consensus on your final template whenever possible.
    • You should notice improved ratings and total scores over time for your vendors. One explanation for this is the Pygmalion Effect: "The Pygmalion [E]ffect describes situations where someone's high expectations improves our behavior and therefore our performance in a given area. It suggests that we do better when more is expected of us."* Convey your expectations and let the vendors' competitive juices take over.
    • While creating your scorecard and materials to explain the process to internal personnel, identify those pieces that will help you explain it to your vendors during vendor orientation (see Steps 2.6 and 3.4). Leveraging pre-existing materials is a great shortcut.

    *Source: The Decision Lab, n.d.

    Step 2.3 – Scorecards and feedback (cont'd)

    Design a two-way feedback loop with your vendors

    Vendor Feedback

    After you've built your scorecard, turn your attention to the second half of the equation – feedback from the vendor. A communication loop cannot be successful without dialogue flowing both ways. While this can happen with just a scorecard, a mechanism specifically geared toward the vendor providing you with feedback improves communication, alignment, and satisfaction.

    You may be tempted to create a formal scorecard for the vendor to use; avoid that temptation until later in your maturity or development of the VMI. You'll be implementing a lot of new processes, deploying new tools and templates, and getting people to work together in new ways. Work on those things first.

    For now, implement an informal process for obtaining information from the vendor. Start by identifying information that you will find useful – information that will allow you to improve overall, to reduce waste or time, to improve processes, to identify gaps in skills. Incorporate these items into your business alignment meetings (see Steps 2.4 and 3.5). Create three to five good questions to ask the vendor and include these in the business alignment meeting agenda. The goal is to get meaningful feedback, and that starts with asking good questions.

    Keep it simple at first. When the time is right, you can build a more formal feedback form or scorecard. Don't be in a rush; as long as the informal method works, keep using it.

    2.3.1 – Scorecards and feedback

    30 – 60 Minutes

    1. Meet with the participants and brainstorm ideas for your scorecard measurement categories:
      1. What makes a vendor valuable to your organization?
      2. What differentiates a "good" vendor from a "bad" vendor?
      3. What items would you like to measure and provide feedback on to the vendor to improve performance, the relationship, risk, and other areas?
    2. Select three, but no more than five, of the following measure categories: timeliness, cost, quality, personnel, and risk.
    3. Within each measurement category, list two or three criteria that you want to measure and track for your vendors. Choose items that are as universal as possible rather than being applicable to one vendor or one vendor type.
    4. Assign a weight to each measurement category, ensuring that the total weight is 100% for all measurement categories.
    5. Document your results as you go in Phase 2 Tools and Templates Compendium – Tab 2.3 Scorecard.

    Input

    • Brainstorming

    Output

    • Configured Scorecard template

    Materials

    • Phase 2 Tools and Templates Compendium – Tab 2.3 Scorecard

    Participants

    • VMI team
    • Applicable stakeholders and executives (as needed)

    Download the Info-Tech Phase 2 Tools and Templates Compendium

    2.3.2 – Scorecards and feedback

    15 to 30 Minutes

    1. Meet with the participants and brainstorm ideas for feedback to seek from your vendors during your business alignment meetings. During the brainstorming, identify questions to ask the vendor about your organization that will:
      1. Help you improve the relationship.
      2. Help you improve your processes or performance.
      3. Help you improve ongoing communication.
      4. Help you evaluate your personnel.
    2. Identify the top five questions you want to include in your business alignment meeting agenda. (Note: you may need to refine the actual questions from the brainstorming activity before they are ready to include in your business alignment meeting agenda.)
    3. Document both your brainstorming activity and your final results in Phase 2 Tools and Templates Compendium – Tab 2.3 Feedback. The brainstorming questions can be used in the future as your VMI matures and your feedback transforms from informal to formal. The results will be used in Steps 2.4 and 3.5.

    Input

    • Brainstorming

    Output

    • Feedback questions to include with the business alignment meeting agenda

    Materials

    • Phase 2 Tools and Templates Compendium – Tab 2.3 Feedback

    Participants

    • VMI team
    • Applicable stakeholders and executives (as needed)

    Download the Info-Tech Phase 2 Tools and Templates Compendium

    Step 2.4 – Business alignment meeting agenda

    Craft an agenda that meets the needs of the VMI

    A business alignment meeting (BAM) is a multi-faceted tool to ensure the customer and the vendor stay focused on what is important to the customer at a high level. BAMs are not traditional operational meetings where the parties get into the details of the contracts, deal with installation problems, address project management issues, or discuss specific cost overruns. The focus of the BAM is the scorecard (see Step 2.3), but other topics are discussed, and other purposes are served. For example:

    • You can use the BAM to develop the relationship with the vendor's leadership team so that if escalation is ever needed, your organization is more than just a name on a spreadsheet or customer list.
    • You can learn about innovations the vendor is working on (without the meeting turning into a sales call).
    • You can address high-level performance trends and request corrective action as needed.
    • You can clarify your expectations.
    • You can educate the vendor about your industry, culture, and organization.
    • You can learn more about the vendor.

    As you build your BAM Agenda, someone in your organization may say, "Oh, that's just a quarterly business review (QBR) or top-to-top meeting." In most instances, an existing QBRs or top-to-top meeting is not the same as a BAM. Using the term QBR or top-to-top meeting instead of BAM can lead to confusion internally. The VMI may say to the business unit, procurement, or another department, "We're going to start running some QBRs for our strategic vendors." The typical response is, "There's no need; we already run QBRs/top-to-top meetings with our important vendors." This may be accompanied by an invitation to join their meeting, where you may be an afterthought, have no influence, and get five minutes at the end to talk about your agenda items. Keep your BAM separate so that it meets your needs.

    Step 2.4 – Business alignment meeting agenda (cont'd)

    Craft an agenda that meets the needs of the VMI

    As previously noted, using the term BAM more accurately depicts the nature of the VMI meeting and prevents confusion internally with other meetings already occurring. In addition, hosting the BAM yourself rather than piggybacking onto another meeting ensures that the VMI's needs are met. The VMI will set and control the BAM agenda and determine the invite list for internal personnel and vendor personnel. As you may have figured out by now, having the right customer and vendor personnel attend will be essential.

    BAMs are conducted at the vendor level, not the contract level. As a result, the frequency of the BAMs will depend on the vendor's classification category (see Steps 2.1 and 3.1). General frequency guidelines are provided below, but they can be modified to meet your goals:

    • Commodity vendors – Not applicable
    • Operational vendors – Biannually or annually
    • Strategic vendors – Quarterly
    • Tactical vendors – Quarterly or biannually

    BAMs can help you achieve some additional benefits not previously mentioned:

    • Foster a collaborative relationship with the vendor.
    • Avoid erroneous assumptions by the parties.
    • Capture and provide a record of the relationship (and other items) over time.

    Step 2.4 – Business alignment meeting agenda (cont'd)

    Craft an agenda that meets the needs of the VMI

    As with any meeting, building the proper agenda will be one of the keys to an effective and efficient meeting. A high-level BAM agenda with sample topics is set out below:

    BAM Agenda

    • Opening remarks
      • Welcome and introductions
      • Review of previous minutes
    • Active discussion
      • Review of open issues
      • Scorecard and feedback
      • Current status of projects to ensure situational awareness by the vendor
      • Roadmap/strategy/future projects
      • Accomplishments
    • Closing remarks
      • Reinforce positives (good behavior, results, and performance, value added, and expectations exceeded)
      • Recap
    • Adjourn

    2.4.1 – Business alignment meeting agenda

    20 – 45 Minutes

    1. Meet with the participants and review the sample agenda in Phase 2 Tools and Templates Compendium – Tab 2.4 BAM Agenda.
    2. Using the sample agenda as inspiration and brainstorming activities as needed, create a BAM agenda tailored to your needs.
      1. Select the items from the sample agenda applicable to your situation.
      2. Add any items required based on your brainstorming.
      3. Add the feedback questions identified during Activity 2.3.2 and documented in Phase 2 Tools and Templates Compendium – Tab 2.3 Feedback.
    3. Gain input and approval from sponsors, stakeholders, and executives as required or appropriate.
    4. Document the final BAM agenda in Phase 2 Tools and Templates Compendium –Tab 2.4 BAM Agenda.

    Input

    • Brainstorming
    • Phase 2 Tools and Templates Compendium – Tab 2.3 Feedback

    Output

    • Configured BAM agenda

    Materials

    • Phase 2 Tools and Templates Compendium – Tab2 .4 BAM Agenda

    Participants

    • VMI team
    • Applicable stakeholders and executives (as needed)

    Download the Info-Tech Phase 2 Tools and Templates Compendium

    Step 2.5 – Relationship alignment document

    Draft a document to convey important VMI information to your vendors

    Throughout this blueprint, alignment is mentioned directly (e.g. business alignment meetings [Steps 2.4 and 3.3]) or indirectly implied. Ensuring you and your vendors are on the same page, have clear and transparent communication, and understand each other's expectations is critical to fostering strong relationships. One component of gaining and maintaining alignment with your vendors is the Relationship Alignment Document (RAD). Depending upon the Scope of your VMI and what your organization already has in place, your RAD will fill in the gaps on various topics.

    Early in the VMI's maturation, the easiest approach is to develop a short document (1 one page) or a pamphlet (i.e. the classic trifold) describing the rules of engagement when doing business with your organization. The RAD can convey expectations, policies, guidelines, and other items. The scope of the document will depend on:

    1. What you believe is important for the vendors to understand.
    2. Any other similar information already provided to the vendors.

    The first step to drafting a RAD is to identify what information vendors need to know to stay on your good side. You may want vendors to know about your gift policy (e.g. employees may not accept vendor gifts above a nominal value, such as a pen or mousepad). Next, compare your list of what vendors need to know and determine if the content is covered in other vendor-facing documents such as a vendor code of conduct or your website's vendor portal. Lastly, create your RAD to bridge the gap between what you want and what is already in place. In some instances, you may want to include items from other documents to reemphasize them with the vendor community.

    Info-Tech Insight

    The RAD can be used with all vendors regardless of classification category. It can be sent directly to the vendors or given to them during vendor orientation (see Step 3.3)

    2.5.1 – Relationship alignment document

    1 to 4 Hours

    1. Meet with the participants and review the RAD sample and checklist in Phase 2 Tools and Templates Compendium – Tab 2.5 Relationship Alignment Doc.
    2. Determine:
      1. Whether you will create one RAD for all vendors or one RAD for strategic vendors and another RAD for tactical and operational vendors; whether you will create a RAD for commodity vendors.
      2. The concepts you want to include in your RAD(s).
      3. The format for your RAD(s) – traditional, pamphlet, or other.
      4. Whether signoff or acknowledgement will be required by the vendors.
    3. Draft your RAD(s) and work with other internal areas, such as Marketing to create a consistent brand for the RADS, and Legal to ensure consistent use and preservation of trademarks or other intellectual property rights and other legal issues.
    4. Review other vendor-facing documents (e.g. supplier code of conduct, onsite safety and security protocols) for consistencies between them and the RAD(s).
    5. Obtain signoff on the RAD(s) from stakeholders, sponsors, executives, Legal, Marketing, and others as needed.

    Input

    • Brainstorming
    • Vendor-facing documents, policies, and procedures

    Output

    • Completed Relationship Alignment Document(s)

    Materials

    • Phase 2 Tools and Templates Compendium – Tab 2.5 Relationship Alignment Doc

    Participants

    • VMI team
    • Marketing, as needed
    • Legal, as needed

    Download the Info-Tech Phase 2 Tools and Templates Compendium

    Step 2.6 – Vendor orientation

    Create a VMI awareness process to build bridges with your vendors

    Your organization is unique. It may have many similarities with other organizations, but your culture, risk tolerance, mission, vision, and goals, finances, employees, and "customers" (those that depend on you) make it different. The same is true of your VMI. It may have similar principles, objectives, and processes to other organizations' VMIs, but yours is still unique. As a result, your vendors may not fully understand your organization and what vendor management means to you.

    Vendor orientation is another means to helping you gain and maintain alignment with your important vendors, educate them on what is important to you, and provide closure when/if the relationship with the vendor ends. Vendor orientation is comprised of three components, each with a different function:

    • Orientation
    • Reorientation
    • Debrief

    Vendor orientation focuses on the vendor management pieces of the puzzle (e.g. the scorecard process) rather than the operational pieces (e.g. setting up a new vendor in the system to ensure invoices are processed smoothly).

    Step 2.6 – Vendor orientation (cont'd)

    Create a VMI awareness process to build bridges with your vendors

    Reorientation

    • Reorientation is either identical or similar to orientation, depending upon the circumstances. Reorientation occurs for several reasons, and each reason will impact the nature and detail of the reorientation content. Reorientation occurs whenever:
    • There is a significant change in the vendor's products or services.
    • The vendor has been through a merger, acquisition, or divestiture.
    • A significant contract renewal/renegotiation has recently occurred.
    • Sufficient time has passed from orientation; commonly 2 to 3 years.
    • The vendor has been placed in a "performance improvement plan" or "relationship improvement plan" protocol.
    • Significant turnover has occurred within your organization (executives, key stakeholders, and/or VMI personnel).
    • Substantial turnover has occurred at the vendor at the executive or account management level.
    • The vendor has changed vendor classification categories after the most current classification.
    • As the name implies, the goal is to refamiliarize the vendor with your current VMI situation, governances, protocols, and expectations. The drivers for reorientation will help you determine the reorientation's scope, scale, and frequency.

    Step 2.6 – Vendor orientation (cont'd)

    Create a VMI awareness process to build bridges with your vendors

    Debrief

    To continue the analogy from orientation, debrief is like an exit interview for an employee when their employment is terminated. In this case, debrief occurs when the vendor is no longer an active vendor with your organization - all contracts have terminated or expired, and no new business with the vendor is anticipated within the next three months.

    Similar to orientation and reorientation, debrief activities will be based on the vendor's classification category within the COST model. Strategic vendors don't go away very often; usually, they transition to operational or tactical vendors first. However, if a strategic vendor is no longer providing products or services to you, dig a little deeper into their experiences and allocate extra time for the debrief meeting.

    The debrief should provide you with feedback on the vendor's experience with your organization and their participation in your VMI. Additionally, it can provide closure for both parties since the relationship is ending. Be careful that the debrief does not turn into a finger-pointing meeting or therapy session for the vendor. It should be professional and productive; if it is going off the rails, terminate the meeting before more damage can occur.

    End the debrief on a high note if possible. Thank the vendor, highlight its key contributions, and single out any personnel who went above and beyond. You never know when you will be doing business with this vendor again – don't burn bridges!

    Step 2.6 – Vendor orientation (cont'd)

    Create a VMI awareness process to build bridges with your vendors

    As you create your vendor orientation materials, focus on the message you want to convey.

    • For orientation and reorientation:
      • What is important to you that vendors need to know?
      • What will help the vendors understand more about your organization and your VMI?
      • What and how are you different from other organizations overall, and in your "industry"?
      • What will help them understand your expectations?
      • What will help them be more successful?
      • What will help you build the relationship?
    • For debrief:
      • What information or feedback do you want to obtain?
      • What information or feedback to you want to give?

    The level of detail you provide strategic vendors during orientation and reorientation may be different from the information you provide tactical and operational vendors. Commodity vendors are not typically involved in the vendor orientation process. The orientation meetings can be conducted on a one-to-one basis for strategic vendors and a one-to-many basis for operational and tactical vendors; reorientation and debrief are best conducted on a one-to-one basis. Lastly, face-to-face or video meetings work best for vendor orientation; voice-only meetings, recorded videos, or distributing only written materials seldom hit their mark or achieve the desired results.

    Step 2.7 – Three-year roadmap

    Plot your path at a high level

    1. The VMI exists in many planes concurrently:
    2. It operates both tactically and strategically.

    It focuses on different timelines or horizons (e.g., the past, the present, and the future). Creating a three-year roadmap facilitates the VMI's ability to function effectively across these multiple landscapes.

    The VMI roadmap will be influenced by many factors. The work product from Phase 1 – Plan, input from executives, stakeholders, and internal clients, and the direction of the organization are great sources of information as you begin to build your roadmap.

    To start, identify what you would like to accomplish in year 1. This is arguably the easiest year to complete: budgets are set (or you have a good idea what the budget will look like), personnel decisions have been made, resources have been allocated, and other issues impacting the VMI are known with a higher degree of certainty than any other year. This does not mean things won't change during the first year of the VMI, but expectations are usually lower, and the short event horizon makes things more predictable during the year-1 ramp-up period.

    Years 2 and 3 are more tenuous, but the process is the same: identify what you would like to accomplish or roll out in each year. Typically, the VMI maintains the year-1 plan into subsequent years and adds to the scope or maturity. For example, you may start year 1 with BAMs and scorecards for three of your strategic vendors; during year 2, you may increase that to five vendors; and during year 3, you may increase that to nine vendors. Or, you may not conduct any market research during year 1, waiting to add it to your roadmap in year 2 or 3 as you mature.

    Breaking things down by year helps you identify what is important and the timing associated with your priorities. A conservative approach is recommended. It is easy to overcommit, but the results can be disastrous and painful.

    2.7.1 – Three-year roadmap

    45 – 90 Minutes

    1. Meet with the participants and decide how to coordinate year 1 of your three-year roadmap with your existing fiscal year or reporting year. Year 1 may be shorter or longer than a calendar year.
    2. Review the VMI activities listed in Phase 2 Tools and Templates Compendium – Tab 2.7 Three-year roadmap. Use brainstorming and your prior work product from Phase 1 and Phase 2 to identify additional items for the roadmap and add them at the bottom of the spreadsheet.
    3. Starting with the first activity, determine when that activity will begin and put an X in the corresponding column; if the activity is not applicable, leave it blank or insert N/A.
    4. Go back to the top of the list and add information as needed.
      1. For any year-1 or year-2 activities, add an X in the corresponding columns if the activity will be expanded/continued in subsequent periods (e.g., if a Year 2 activity will continue in year 3, put an X in year 3 as well).
      2. Use the comments column to provide clarifying remarks or additional insights related to your plans or "X's". For example, "Scorecards begin in year 1 with three vendors and will roll out to five vendors in year 2 and nine vendors in year 3."
    5. Obtain signoff from stakeholders, sponsors, and executives as needed.

    Input

    • Phase 1 work product
    • Steps 2.1 – 2.6 work product
    • Brainstorming

    Output

    • High level three-year roadmap for the VMI

    Materials

    • Phase 2 Tools and Templates Compendium – Tab 2.7 Three-Year Roadmap

    Participants

    • VMI team
    • Applicable stakeholders and executives (as needed)

    Download the Info-Tech Phase 2 Tools and Templates Compendium

    Step 2.8 – 90-day plan

    Pave your short-term path with a series of detailed quarterly plans

    Now that you have prepared a three-year roadmap, it's time to take the most significant elements from the first year and create action plans for each three-month period. Your first 90-day plan may be longer or shorter if you want to sync to your fiscal or calendar quarters. Aligning with your fiscal year can make it easier for tracking and reporting purposes; however, the more critical item is to make sure you have a rolling series of four 90-day plans to keep you focused on the important activities and tasks throughout the year.

    The 90-day plan is a simple project plan that will help you measure, monitor, and report your progress. Use the Info-Tech tool to help you track:

    Activities.

    • Tasks comprising each activity.
    • Who will be performing the tasks.
    • An estimate of the time required per person per task.
    • An estimate of the total time to achieve the activity.
    • A due date for the activity.
    • A priority of the activity.

    The first 90-day plan will have the greatest level of detail and should be as thorough as possible; the remaining three 90-day plans will each have less detail for now. As you approach the middle of the first 90-day plan, start adding details to the next 90-day plan; toward the end of the first quarter add a high-level 90-day plan to the end of the chain. Continue repeating this cycle each quarter and consult the three-year roadmap and the leadership team, as necessary.

    2.8.1 – 90-day plan

    45 – 90 Minutes

    1. Meet with the participants and decide how to coordinate the first "90-day" plan with your existing fiscal year or reporting cycles. Your first plan may be shorter or longer than 90 days.
    2. Looking at the year-1 section of the three-year roadmap, identify the activities that will be started during the next 90 days.
    3. Using the Phase 2 Tools and Templates Compendium – Tab 2.8 90-Day Plan, enter the following information into the spreadsheet for each activity to be accomplished during the next 90 days:
      1. Activity description.
      2. Tasks required to complete the activity (be specific and descriptive).
      3. The people who will be performing each task.
      4. The estimated number of hours required to complete each task.
      5. The start date and due date for each task or the activity.
    4. Validate the tasks are a complete list for each activity and the people performing the tasks have adequate time to complete the tasks by the due date(s).
    5. Assign a priority to each Activity.

    Input

    • Three-Year Roadmap
    • Phase 1 work product
    • Steps 2.1 – 2.7 work product
    • Brainstorming

    Output

    • Detailed plan for the VMI for the next quarter or "90" days

    Materials

    • Phase 2 Tools and Templates Compendium – Tab 2.8 90-Day Plan

    Participants

    • VMI team
    • Applicable stakeholders and executives (as needed)

    Download the Info-Tech Phase 2 Tools and Templates Compendium

    Step 2.9 – Quick wins

    Identify potential short-term successes to gain momentum and show value immediately

    As the final step in the timeline trilogy, you are ready to identify some quick wins for the VMI. Using the first 90-day plan and a brainstorming activity, create a list of things you can do in 15 to 30 days that add value to your initiative and build momentum.

    As you evaluate your list of potential candidates, look for things that:

    • Are achievable within the stated timeline.
    • Don't require a lot of effort.
    • Involve stopping a certain process, activity, or task; this is sometimes known as a "stop doing stupid stuff" approach.
    • Will reduce or eliminate inefficiencies; this is sometimes known as the war on waste.
    • Have a moderate to high impact or bolster the VMI's reputation.

    As you look for quick wins, you may find that everything you identify does not meet the criteria. That's okay; don't force the issue. Return your focus to the 90-day plan and three-year roadmap and update those documents if the brainstorming activity associated with Step 2.9 identified anything new.

    2.9.1 – Quick wins

    15 - 30 Minutes

    1. Meet with the participants and review the three-year roadmap and 90-day plan. Determine if any item on either document can be completed:
      1. Quickly (30 days or less).
      2. With minimal effort.
      3. To provide or show moderate to high levels of value or provide the VMI with momentum.
    2. Brainstorm to identify any other items that meet the criteria in step 1 above.
    3. Compile a comprehensive list of these items and select up to five to pursue.
    4. Document the list in the Phase 2 Tools and Templates Compendium – Tab 2.9 Quick Wins.
    5. Manage the quick wins list and share the results with the VMI team and applicable stakeholders and executives.

    Input

    • Three-Year Roadmap
    • 90-Day Plan
    • Brainstorming

    Output

    • A list of activities that require low levels of effort to achieve moderate to high levels of value in a short period

    Materials

    • Phase 2 Tools and Templates Compendium – Tab 2.9 Quick Wins

    Participants

    • VMI team

    Download the Info-Tech Phase 2 Tools and Templates Compendium

    Step 2.10 – Reports

    Construct your reports to resonate with your audience

    Issuing reports is a critical piece of the VMI since the VMI is a conduit of information for the organization. It may be aggregating risk data from internal areas, conducting vendor research, compiling performance data, reviewing market intelligence, or obtaining relevant statistics, feedback, comments, facts, and figures from other sources. Holding onto this information minimizes the impact a VMI can have on the organization; however, the VMI's internal clients, stakeholders, and executives can drown in raw data and ignore it completely if it is not transformed into meaningful, easily-digested information.

    Before building a report, think about your intended audience:

    • What information are they looking for? What will help them understand the big picture?
    • What level of detail is appropriate, keeping in mind the audience may not be like-minded?
    • What items are universal to all the readers and what items are of interest to one or two readers?
    • How easy or hard will it be to collect the data? Who will be providing it, and how time consuming will it be?
    • How accurate, valid, and timely will the data be?
    • How frequently will each report need to be issued?

    Step 2.10 – Reports (cont'd)

    Construct your reports to resonate with your audience

    Use the following guidelines to create reports that will resonate with your audience:

    • Value information over data, but sometimes data does have a place in your report.
    • Use pictures, graphics, and other representations more than words, but words are often necessary in small, concise doses.
    • Segregate your report by user; for example, general information up top, CIO information below that on the right, CFO information to the left of CIO information, etc.
    • Send a draft report to the internal audience and seek feedback, keeping in mind you won't be able to cater to or please everyone.

    2.10.1 – Reports

    15 – 45 Minutes

    1. Meet with the participants and review the applicable work product from Phase 1 and Phase 2; identify qualitative and quantitative items the VMI measures, monitors, tracks, or aggregates.
    2. Determine which items will be reported and to whom (by category):
      1. Internally to personnel within the VMI.
      2. Internally to personnel outside the VMI.
      3. Externally to vendors.
    3. Within each category above, determine your intended audiences/recipients. For example, you may have a different list of recipients for a risk report than you do a scorecard summary report. This will help you identify the number of reports required.
    4. Create a draft structure for each report based on the audience and the information being conveyed. Determine the frequency of each report and person responsible for creating for each report.
    5. Document your final choices in Phase 2 Tools and Templates Compendium – Tab 2.10 Reports.

    Input

    • Brainstorming
    • Phase 1 work product
    • Steps 2.1 – 2.11 work product

    Output

    • A list of reports used by the VMI
    • For each report
      • The conceptual content
      • A list of who will receive or have access
      • A creation/distribution frequency

    Materials

    • Phase 2 Tools and Templates Compendium – Tab 2.10 Reports

    Participants

    • VMI team
    • Applicable stakeholders and executives (as needed)

    Download the Info-Tech Phase 2 Tools and Templates Compendium

    Phase 3 - Run

    Implement your processes and leverage your tools and templates

    Phase 1

    Phase 2Phase 3Phase 4

    1.1 Mission Statement and Goals

    1.2 Scope

    1.3 Strengths and Obstacles

    1.4 Roles and Responsibilities

    2.1 Classification Model

    2.2 Risk Assessment Tool

    2.3 Scorecards and Feedback

    2.4 Business Alignment Meeting Agenda

    2.5 Relationship Alignment Document

    2.6 Vendor Orientation

    2.7 3-Year Roadmap

    2.8 90-Day Plan

    2.9 Quick Wins

    2.10 Reports

    3.1 Classify Vendors

    3.2 Compile Scorecards

    3.3 Conduct Business Alignment Meetings

    3.4 Work the 90-Day Plan

    3.5 Manage the 3-Year Roadmap

    3.6 Develop/Improve Vendor Relationships

    4.1 Incorporate Leading Practices

    4.2 Leverage Lessons Learned

    4.3 Maintain Internal Alignment

    This phase will walk you through the following activity:

    • Beginning to operate the VMI. The main outcomes from this phase are guidance and the steps required to initiate your VMI.

    This phase involves the following participants:

    • VMI team
    • Applicable stakeholders and executives
    • Others as needed

    Vendor Management Initiative Basics for the Small/Medium Businesses

    Phase 3 – Run

    Implement your processes and leverage your tools and templates

    All the hard work invested in Phase 1 – Plan and Phase 2 – Build begins to pay off in Phase 3 – Run. It's time to stand up your VMI and ensure that the proper level of resources is devoted to your vendors and the VMI itself. There's more hard work ahead, but the foundational elements are in place. This doesn't mean there won't be adjustments and modifications along the way, but you are ready to use the tools and templates in the real world; you are ready to begin reaping the fruits of your labor.

    Phase 3 – Run guides you through the process of collecting data, monitoring trends, issuing reports, and conducting effective meetings to:

    • Manage risk better.
    • Improve vendor performance.
    • Improve vendor relationships.
    • Identify areas where the parties can improve.
    • Improve communication between the parties.
    • Increase the value proposition with your vendors.

    Step 3.1 – Classify vendors

    Begin classifying your top 25 vendors by spend

    Step 3.1 sets the table for many of the subsequent steps in Phase 3 – Run. The results of your classification process will determine which vendors go through the scorecarding process (Step 3.2); which vendors participate in BAMs (Step 3.3), and which vendors you will devote relationship-building resources to (Step 3.6).

    As you begin classifying your vendors, Info-Tech recommends using an iterative approach initially to validate the results from the classification model you configured in Step 2.1.

    1. Identify your top 25 vendors by spend.
    2. Run your top 10 vendors by spend through the classification model and review the results.
      1. If the results are what you expected and do not contain any significant surprises, go to 3. on the next page.
      2. If the results are not what you expected or do contain significant surprises, look at the configuration page of the tool (Tab 1) and adjust the weights or the spend categories slightly. Be cautious in your evaluation of the results before modifying the configuration page - some legitimate results are unexpected, or are surprises based on bias. If you modify the weighting, review the new results and repeat your evaluation. If you modify the spend categories, review the answers on the vendor tabs to ensure that the answers are still accurate; review the new results and repeat your evaluation.

    Step 3.1 – Classify vendors (cont'd)

    Review your results and adjust the classification tool as needed

    1. Run your top 11-through-25 vendors by spend through the classification model and review the results. Identify any unexpected results. Determine if further configuration makes sense and repeat the process outlined in 2.b., previous page, as necessary. If no further modifications are required, continue to 4., below.
    2. Share the preliminary results with the leadership team, executives, and stakeholders to obtain their approval or adjustments to the results.
      1. They may have questions and want to understand the process before approving the results.
      2. They may request that you move a vendor from one quadrant to another based on your organization's roadmap, the vendor's roadmap, or other information not available to you.
    3. Identify the vendors that will be part of the VMI at this stage – how many and which ones. Based on this number and the VMI's scope (Step 1.2), make sure you have the resources necessary to accommodate the number of vendors participating in the VMI. Proceed cautiously and gradually increase the number of vendors participating in the VMI.

    Step 3.1 – Classify vendors (cont'd)

    Finalize the results and update VMI tools and templates

    1. Update the vendor inventory tool (Step 1.7) to indicate the current classification status for the top 25 vendors by spend. Once your vendors have been classified, you can sort the vendor inventory tool by classification status to see all the vendors in that category at once.
    2. Review your three-year roadmap (Step 2.9) and 90-day plans (Step 2.6) to determine if any modifications are needed to the activities and timelines.

    Additional classification considerations:

    • You should only have a few vendors that fit in the strategic category. As a rough guideline, no more than 5% to 10% of your IT vendors should end up in the strategic category. If you have many vendors, even 5% may be too many. the classification model is an objective start to the classification process, but common sense must prevail over the "math" at the end of the day.
    • At this point, there is no need to go beyond the top 25 by spend. Most VMIs starting out can't handle more than three to five strategic vendors initially. Allow the VMI to run a pilot program with a small sample size, work out any bugs, make adjustments, and then ramp up the VMI's rollout in waves. Vendors can be added quarterly, biannually, or annually, depending upon the desired goals and available resources.

    Step 3.1 – Classify vendors (cont'd)

    Align your vendor strategy to your classification results

    As your VMI matures, additional vendors will be part of the VMI. Review the table below and incorporate the applicable strategies into your deployment of vendor management principles over time. Stay true to your mission, goals, and scope, and remember that not all your vendors are of equal importance.

    Operational

    Strategic
    • Focus on spend containment
    • Concentrate on lowering total cost of ownership
    • Invest moderately in cultivating the relationship
    • Conduct BAMs biannually or annually
    • Compile scorecards quarterly or biannually
    • Identify areas for performance and cost improvement
    • Focus on value, collaboration, and alignment
    • Review market intelligence for the vendor's industry
    • Invest significantly in cultivating the relationship
    • Initiate executive-to-executive relationships
    • Conduct BAMs quarterly
    • Compile scorecards quarterly
    • Understand how the vendors view your organization

    Commodity

    Tactical
    • Investigate vendor rationalization and consolidation
    • Negotiate for the best-possible price
    • Leverage competition during negotiations
    • Streamline the purchasing and payment process
    • Allocate minimal VMI resources
    • Assign the lowest priority for vendor management metrics
    • Conduct risk assessments biannually or annually
    • Cultivate a collaborative relationship based on future growth plans or potential with the vendor
    • Conduct BAMs quarterly or biannually
    • Compile scorecards quarterly
    • Identify areas of performance improvement
    • Leverage innovation and creative problem solving

    Step 3.1 – Classify vendors (cont'd)

    Be careful when using the word "partner" with your strategic and other vendors

    For decades, vendors have used the term "partner" to refer to the relationship they have with their clients and customers. This is often an emotional ploy used by the vendors to get the upper hand. To fully understand the terms "partner" and "partnership", let's evaluate them through two more objective, less cynical lenses.

    If you were to talk to your in-house or outside legal counsel, you may be told that partners share in profits and losses, and they have a fiduciary obligation to each other. Unless there is a joint venture between the parties, you are unlikely to have a partnership with a vendor from this perspective.

    What about a "business" partnership — one that doesn't involve sharing profits and losses? What would that look like? Here are some indicators of a business partnership (or preferably a strategic alliance):

    • Trust and transparent communication exist.
    • You have input into the vendor's roadmap for products and services.
    • The vendor is aligned with your desired outcomes and helps you achieve success.
    • You and the vendor are accountable for actions and inactions, with both parties being at risk.
    • There is parity in the peer-to-peer relationships between the organizations (e.g. C-Level to C-Level).
    • The vendor provides transparency in pricing models and proactively suggests ways for you to reduce costs.
    • You and the vendor work together to make each party better, providing constructive feedback on a regular basis.
    • The vendor provides innovative suggestions for you to improve your processes, performance, the bottom line, etc.
    • Negotiations are not one-sided; they are meaningful and productive, resulting in an equitable distribution of money and risk.

    Step 3.1 – Classify vendors (cont'd)

    Understand the implications and how to leverage the words "partner" and "partnership"

    By now you might be thinking, "What's all the fuss? Why does it matter?" At Info-Tech, we've seen firsthand how referring to the vendor as a partner can have the following impact:

    • Confidences are disclosed unnecessarily.
    • Negotiation opportunities and leverage are lost.
    • Vendors no longer have to earn the customer's business.
    • Vendor accountability is missing due to shared responsibilities.
    • Competent skilled vendor resources are assigned to other accounts.
    • Value erodes over time since contracts are renewed without being competitively sourced.
    • One-sided relationships are established, and false assurances are provided at the highest levels within the customer organization.

    Proceed with caution when using partner or partnership with your vendors. Understand how your organization benefits from using these terms and mitigate the negatives outlined above by raising awareness internally to ensure people understand the psychology behind the terms. Finally, use the term to your advantage when warranted by referring to the vendor as a partner when you want or need something that the vendor is reluctant to provide. Bottom line: be strategic in how you refer to vendors and know the risks.

    Step 3.2 – Compile scorecards

    Begin scoring your top vendors

    The scorecard process typically is owned and operated by the VMI, but the actual rating of the criteria within the measurement categories is conducted by those with day-to-day interactions with the vendors, those using or impacted by the services and products provided by the vendors, and those with the skills to research other information on the scorecard (e.g. risk). Chances are one person will not be able to complete an entire scorecard by themselves. As a result, the scorecard process is a team sport comprised of sub-teams where necessary.

    The VMI will compile the scores, calculate the final results, and aggregate all the comments into one scorecard. There are two common ways to approach this task:

    1. Send out the scorecard template to those who will be scoring the vendor and ask them to return it when completed, providing them with a due date a few days before you need it; you'll need time to compile, calculate, and aggregate.
    2. Invite those who will be scoring the vendor to a meeting and let the contributors use that time to score the vendors; make VMI team members available to answer questions and facilitate the process.

    Step 3.2 – Compile scorecards (cont'd)

    Gather input from stakeholders and others impacted by the vendors

    Since multiple people will be involved in the scorecarding process or have information to contribute, the VMI will have to work with the reviewers to ensure he right mix of data is provided. For example:

    • If you are tracking lawsuits filed by or against the vendor, one person from Legal may be able to provide that, but they may not be able to evaluate any other criteria on the scorecard.
    • If you are tracking salesperson competencies, multiple people from multiple areas may have valuable insights.
    • If you are tracking deliverable timeliness, several project managers may want to contribute across several projects.

    Where one person is contributing exclusively to limited criteria, make it easy for them to identify the criteria they are to evaluate. When multiple people from the same functional area will provide insights, they can contribute individually (and the VMI will average their responses) or they can respond collectively after reaching consensus as a group.

    After the VMI has compiled, calculated, and aggregated, share the results with executives, impacted stakeholders, and others who will be attending the BAM for that vendor. Depending upon the comments provided by internal personnel, you may need to create a sanitized version of the scorecard for the vendor.

    Make sure your process timeline has a buffer built in. You'll be sending the final scorecard to the vendor three to five days before the BAM, and you'll need some time to assemble the results. The scorecarding process can be perceived as a low-priority activity for people outside of the VMI, and other "priorities" will arise for them. Without a timeline buffer, the VMI may find itself behind schedule and unprepared, due to things beyond its control.

    Step 3.3 – Conduct business alignment meetings

    Determine which vendors will participate and how long the meetings will last

    At their core, BAMs aren't that different from any other meeting. The basics of running a meeting still apply, but there are a few nuances that apply to BAMs. Set out below are leading practices for conducing your BAMs; adapt them to meet your needs and suit your environment.

    Who

    Initially, BAMs are conducted with the strategic vendors in your pilot program. Over time you'll add vendors until all your strategic vendors are meeting with you quarterly. After that, roll out the BAMs to those tactical and operational vendors located close to the strategic quadrant in the classification model (Steps 2.1 and 3.1) and as VMI resources allow. It may take several years before you are holding regular BAMs with all your strategic, tactical, and operational vendors.

    Duration

    Keep the length of your meetings reasonable. The first few with a vendor may need to be 60 to 90 minutes long. After that, you should be able to trim them to 45 minutes to 60 minutes. The BAM does not have to fill the entire time. When you are done, you are done.

    Step 3.3 – Conduct business alignment meetings (cont'd)

    Identify who will be invited and send out invitations

    Invitations

    Set up a recurring meeting whenever possible. Changes will be inevitable but keeping the timeline regular works to your advantage. Also, the vendors included in your initial BAMs won't change for twelve months. For the first BAM with a vendor, provide adequate notice; four weeks is usually sufficient, but calendars will fill up quickly for the main attendees from the vendor. Treat the meeting as significant and make sure your invitation reflects this. A simple meeting request will often be rejected, treated as optional, or ignored completely by the vendor's leadership team (and maybe yours as well!).

    Invitees

    Internal invitees should include those with a vested interest in the vendor's performance and the relationship. Other functional areas may be invited based on need or interest. Be careful the attendee list doesn't get too big. Based on this, internal BAM attendees often include representatives from IT, Sourcing/Procurement, and the applicable business units. At times, Finance and Legal are included.

    From the vendor's side, strive to have decision makers and key leaders attend. The salesperson/account manager is often included for continuity, but a director or vice president of sales will have more insights and influence. The project manager is not needed at this meeting due to the nature of the meeting and its agenda; however, a director or vice president from the product or service delivery area is a good choice. Bottom line: get as high into the vendor's organization as possible whenever possible; look at the types of contracts you have with that vendor to provide guidance on the type of people to invite.

    Step 3.3 – Conduct business alignment meetings (cont'd)

    Prepare for the Meetings and Maintain Control

    Preparation

    Send the scorecard and agenda to the vendor five days prior to the BAM. The vendor should provide you with any information you require for the meeting five days prior, as well.

    Decide who will run the meeting. Some customers like to lead, and others let the vendor present. How you craft the agenda and your preferences will dictate who runs the show.

    Make sure the vendor knows what materials they should bring to the meeting or have access to. This will relate to the agenda and any specific requests listed under the discussion points. You don't want the vendor to be caught off guard and unable to discuss a matter of importance to you.

    Running the BAM

    Regardless of which party leads, make sure you manage the agenda to stay on topic. This is your meeting – not the vendor's, not IT's, not Procurement's or Sourcing's. Don't let anyone hijack it.

    Make sure someone is taking notes. If you are running this virtually, consider recording the meeting. Check with your legal department first for any concerns, notices, or prohibitions that may impact your recording the session.

    Remember, this is not a sales call, and it is not a social activity. Innovation discussions are allowed and encouraged, but that can quickly devolve into a sales presentation. People can be friendly toward one another, but the relationship building should not overwhelm the other purposes.

    Step 3.3 – Conduct business alignment meetings (cont'd)

    Follow these additional guidelines to maximize your meetings

    More leading practices

    • Remind everyone that the conversation may include items covered by various confidentiality provisions or agreements.
    • Publish the meeting minutes on a timely basis (within 48 hours).
    • Focus on the bigger picture by looking at trends over time; get into the details only when warranted.
    • Meet internally immediately beforehand to prepare – don't go in cold. Review the agenda and the roles and responsibilities for the attendees.
    • Physical meetings are better than virtual meetings, but travel constraints, budgets, and pandemics may not allow for physical meetings.

    Final thoughts

    • When performance or the relationship is suffering, be constructive in your feedback and conversations rather than trying to assign blame; lead with the carrot rather than the stick.
    • Look for collaborative solutions whenever possible and avoid referencing the contract if possible. Communicate your willingness to help resolve outstanding issues.
    • Use inclusive language and avoid language that puts the vendor on the defensive.
    • Make sure that your meetings are not focused exclusively on the negative, but don't paint a rosy picture where one doesn't exist.
    • A vendor that is doing well should be commended. This is an important part of relationship building.

    Step 3.4 – Work the 90-day plan

    Monitor your progress and share your results

    Having a 90-day plan is a good start, but assuming the tasks on the plan will be accomplished magically or without any oversight can lead to failure. While it won't take a lot of time to work the plan, following a few basic guidelines will help ensure the 90-day plan gets results and wasn't created in vain.

    1. Measure and track your progress against the initial/current 90-day plan at least weekly; with a short timeline, any delay can have a huge impact.
    2. If adjustments are needed to any elements of the plan, understand the cause and the impact of those adjustments before making them.
    3. Make adjustments ONLY when warranted. The temptation will be to push activities and tasks further out on the timeline (or to the next 90-day plan!) when there is any sort of hiccup along the way, especially when personnel outside the VMI are involved. Hold true to the timeline whenever possible; once you start slipping, it often becomes a habit.
    4. Report on progress every week and hold people accountable for their assignments and contributions.
    5. Take the 90-day plan seriously and treat it as you would any significant project. This is part of the VMI's branding and image.

    Step 3.5 – Manage the three-year roadmap

    Keep an eye on the future since it will feed the present

    The three-year roadmap is a great planning tool, but it is not 100% reliable. There are inherent flaws and challenges. Essentially, the roadmap is a set of three "crystal balls" attempting to tell you what the future holds. The vision for year 1 may be clear, but for each subsequent year, the crystal ball becomes foggier. In addition, the timeline is constantly changing; before you know it, tomorrow becomes today and year 2 becomes year 1.

    To help navigate through the roadmap and maximize its potential, follow these principles:

    • Manage each year of the roadmap differently.
      • Review the year-1 map each quarter to update your 90-day plans (See steps 2.10 and 3.4).
      • Review the year-2 map every six months to determine if any changes are necessary. As you cycle through this, your vantage point of year 2 will be 6 months or 12 months away from the beginning of year 2, and time moves quickly.
      • Review the year-3 map annually, and determine what needs to be added, changed, or deleted. Each time you review year 3, it will be a "new" year 3 that needs to be built.
    • Analyze the impact on the proposed modifications from two perspectives: 1) What is the impact if a requested modification is made? 2) What is the impact if a requested modification is not made?
    • Validate all modifications with leadership and stakeholders before updating the three-year roadmap to ensure internal alignment.

    Step 3.6 – Develop/improve vendor relationships

    Drive better performance through better relationships

    One of the key components of a VMI is relationship management. Good relationships with your vendors provide many benefits for both parties, but they don't happen by accident. Do not assume the relationship will be good or is good merely because your organization is buying products and services from a vendor.

    In many respects, the VMI should mirror a vendor's sales organization by establishing relationships at multiple levels within the vendor organizations, not just with the salesperson or account manager. Building and maintaining relationships is hard work, but the return on investment makes it worthwhile.

    Business relationships are comprised of many components, not all of which must be present to have a great relationship. However, there are some essential components. Whether you are trying to develop, improve, or maintain a relationship with a vendor, make sure you are conscious of the following:

    • Focusing your energies on strategic vendors first and then tactical and operational vendors.
    • Being transparent and honest in your communications.
    • Continuously building trust by being responsive and honoring commitments (timely).
    • Creating a collaborative environment and build upon common ground.
    • Thanking the vendor when appropriate.
    • Resolving disputes early, avoiding the "blame game", and being objective when there are disagreements.

    Phase 4 - Review

    Keep your VMI up to date and running smoothly

    Phase 1

    Phase 2Phase 3Phase 4

    1.1 Mission Statement and Goals

    1.2 Scope

    1.3 Strengths and Obstacles

    1.4 Roles and Responsibilities

    2.1 Classification Model

    2.2 Risk Assessment Tool

    2.3 Scorecards and Feedback

    2.4 Business Alignment Meeting Agenda

    2.5 Relationship Alignment Document

    2.6 Vendor Orientation

    2.7 3-Year Roadmap

    2.8 90-Day Plan

    2.9 Quick Wins

    2.10 Reports

    3.1 Classify Vendors

    3.2 Compile Scorecards

    3.3 Conduct Business Alignment Meetings

    3.4 Work the 90-Day Plan

    3.5 Manage the 3-Year Roadmap

    3.6 Develop/Improve Vendor Relationships

    4.1 Incorporate Leading Practices

    4.2 Leverage Lessons Learned

    4.3 Maintain Internal Alignment

    This phase will walk you through the following activity:

    • Helping the VMI identify what it should stop doing, start doing, and continue doing as it improves and matures. The main outcomes from this phase are ways to advance the VMI and maintain internal alignment.

    This phase involves the following participants:

    • VMI team
    • Applicable stakeholders and executives
    • Others as needed

    Vendor Management Initiative Basics for the Small/Medium Businesses

    Phase 4 – Review

    Keep your VMI up to date and running smoothly

    As the adage says, "The only thing constant in life is change." This is particularly true for your VMI. It will continue to mature, people inside and outside of the VMI will change, resources will expand or contract from year to year, your vendor base will change. As a result, your VMI needs the equivalent of a physical every year. In place of bloodwork, x-rays, and the other paces your physician may put you through, you'll assess compliance with your policies and procedures, incorporate leading practices, leverage lessons learned, maintain internal alignment, and update governances.

    Be thorough in your actions during this Phase to get the most out of it. It requires more than the equivalent of gauging a person's health by taking their temperature, measuring their blood pressure, and determining their body mass index. Keeping your VMI up-to-date and running smoothly takes hard work.

    Some of the items presented in this Phase require an annual review; others may require quarterly review or timely review (i.e. when things are top of mind and current). For example, collecting lessons learned should happen on a timely basis rather than annually, and classifying your vendors should occur annually rather than every time a new vendor enters the fold.

    Ultimately, the goal is to improve over time and stay aligned with other areas internally. This won't happen by accident. Being proactive in the review of your VMI further reinforces the nature of the VMI itself – proactive vendor management, not reactive!

    Step 4.1 – Incorporate leading practices

    Identify and evaluate what external VMIs are doing

    The VMI's world is constantly shifting and evolving. Some changes will take place slowly, while others will occur quickly. Think about how quickly the cloud environment has changed over the past five years versus the 15 years before that; or think about issues that have popped up and instantly altered the landscape (we're looking at you COVID and ransomware). As a result, the VMI needs to keep pace, and one of the best ways to do that is to incorporate leading practices.

    At a high level, a leading practice is a way of doing something that is better at producing a particular outcome or result or performing a task or activity than other ways of proceeding. The leading practice can be based on methodologies, tools, processes, procedures, and other items. Leading practices change periodically due to innovation, new ways of thinking, research, and other factors. Consequently, a leading practice is to identify and evaluate leading practices each year.

    Step 4.1 – Incorporate leading practices (cont'd)

    Update your VMI based on your research

    • A simple approach for incorporating leading practices into your regular review process is set out below:
    • Research:
      • What other VMIs in your industry are doing.
      • What other VMIs outside your industry are doing.
      • Vendor management in general.
    • Based on your results, list specific leading practices others are doing that would improve your VMI (be specific – e.g. other VMIs are incorporating risk into their classification process).
    • Evaluate your list to determine which of these potential changes fit or could be modified to fit your culture and environment.
    • Recommend the proposed changes to leadership (with a short business case or explanation/justification, as needed) and gain approval.

    Remember: Leading practices or best practices may not be what is best for you. In some instances, you will have to modify them to fit in your culture and environment; in other instances, you will elect not to implement them at all (in any form).

    Step 4.2 – Leverage lessons learned

    Tap into the collective wisdom and experience of your team members

    There are many ways to keep your VMI running smoothly, and creating a lessons learned library is a great complement to the other ways covered in this Phase 4 - Review. By tapping into the collective wisdom of the team and creating a safe feedback loop, the VMI gains the following benefits:

    • Documented institutional wisdom and knowledge normally found only in the team members' brains.
    • The ability for one team member to gain insights and avoid mistakes without having to duplicate the events leading to the insights or mistakes.
    • Improved methodologies, tools, processes, procedures, skills, and relationships.

    Many of the processes raised in this Phase can be performed annually, but a lessons learned library works best when the information is deposited in a timely manner. How you choose to set up your lessons learned process will depend on the tools you select and your culture. You may want to have regular input meetings to share the lessons as they are being deposited, or you may require team members to deposit lessons learned on a regular basis (within a week after they happen, monthly, or quarterly). Waiting too long can lead to vague or lost memories and specifics; timeliness of the deposits is a crucial element.

    Step 4.2 – Leverage lessons learned (cont'd)

    Create a library to share valuable information across the team

    Lessons learned are not confined to identifying mistakes or dissecting bad outcomes. You want to reinforce good outcomes, as well. When an opportunity for a lessons-learned deposit arises, identify the following basic elements:

    • A brief description of the situation and outcome.
    • What went well (if anything) and why did it go well?
    • What didn't go well (if anything) and why didn't it go well?
    • What would/could you do differently next time?
    • A synopsis of the lesson(s) learned.

    Info-Tech Insights

    The lessons learned library needs to be maintained. Irrelevant material needs to be culled periodically, and older or duplicate material may need to be archived.

    the lessons learned process should be blameless. The goal is to share insightful information, not to reward or punish people based on outcomes or results.

    Step 4.3 – Maintain internal alignment

    Review the plans of other internal areas to stay in sync

    Maintaining internal alignment is essential for the ongoing success of the VMI. Over time, it is easy to lose sight of the fact that the VMI does not operate in a vacuum; it is an integral component of a larger organization whose parts must work well together to function optimally. Focusing annually on the VMI's alignment within the enterprise helps reduce any breakdowns that could derail the organization.

    To ensure internal alignment:

    • Review the key components of the applicable materials from Phase 1 - Plan and Phase 2 - Build with the appropriate members of the leadership team (e.g. executives, sponsors, and stakeholders). Not every item from those Phases and Steps needs to be reviewed but err on the side of caution for the first set of alignment discussions, and be prepared to review each item. You can gauge the audience's interest on each topic and move quickly when necessary or dive deeper when needed. Identify potential changes required to maintain alignment.
    • Review the strategic plans (e.g. 1-, 3-, and 5- year plans) for various portions of the organization if you have access to them or gather insights if you don't have access.
      • If the VMI is under the IT umbrella, review the strategic plans for IT and its departments.
      • Review the strategic plans for the areas the VMI works with (e.g. Procurement, Business Units).
      • The organization itself.
    • Create and vet a list of modifications to the VMI and obtain approval.
    • Develop a plan for making the necessary changes.

    Summary of Accomplishment

    Problem solved

    Vendor management is a broad, often overwhelming, comprehensive spectrum that encompasses many disciplines. By now, you should have a great idea of what vendor management can or will look like in your organization. Focus on the basics first: Why does the VMI exist and what does it hope to achieve? What is it's scope? What are the strengths you can leverage, and what obstacles must you manage? How will the VMI work with others? From there, the spectrum of vendor management will begin to clarify and narrow.

    Leverage the tools and templates from this blueprint and adapt them to your needs. They will help you concentrate your energies in the right areas and on the right vendors to maximize the return on your organization's investment in the VMI of time, money, personnel, and other resources. You may have to lead by example internally and with your vendors at first, but they will eventually join you on your path if you stay true to your course.

    At the heart of a good VMI is the relationship component. Don't overlook its value in helping you achieve your vendor management goals. The VMI does not operate in a vacuum, and relationships (internal and external) will be critical.

    Lastly, seek continual improvement from the VMI and from your vendors. Both parties should be held accountable, and both parties should work together to get better. Be proactive in your efforts, and you, the VMI, and the organization will be rewarded.

    If you would like additional support, have our analysts guide you through other phases as part of an Info-Tech Workshop

    Contact your account representative for more information

    workshops@infotech.com
    1-888-670-8889

    Related Info-Tech Research

    Prepare for Negotiations More Effectively
    Don't leave negotiation preparations and outcomes to chance. Learn how to prepare for negotiations more effectively and improve your results.

    Understand Common IT Contract Provisions to Negotiate More Effectively
    Info-Tech's guidance and insights will help you navigate the complex process of contract review and identify the key details necessary to maximize the protections for your organization.

    Capture and Market the ROI of Your VMO
    Calculating the impact or value of a vendor management office (VMO) can be difficult without the right framework and tools. Let Info-Tech's tools and templates help you account for the contributions made by your VMO.

    Bibliography

    Slide 5 – ISG Index 4Q 2021, Information Services Group, Inc., 2022.

    Slide 6 – ISG Index 4Q 2021, Information Services Group, Inc., 2022.

    Slide 7 – Geller & Company. "World-Class Procurement — Increasing Profitability and Quality." Spend Matters. 2003. Web. Accessed 4 Mar. 2019.

    Slide 26 – Guth, Stephen. The Vendor Management Office: Unleashing the Power of Strategic Sourcing. Lulu.com, 2007. Print. Protiviti. Enterprise Risk Management. Web. 16 Feb. 2017.

    Slide 34 – "Why Do We Perform Better When Someone Has High Expectations of Us?" The Decision Lab. Accessed January 31, 2022.

    Slide 56 - Top 10 Tips for Creating Compelling Reports," October 11, 2019, Design Eclectic. Accessed March 29, 2022.

    Slide 56 – "Six Tips for Making a Quality Report Appealing and Easy To Skim," Agency for Health Research and Quality. Accessed March 29, 2022.

    Slide 56 –Tucker, Davis. Marketing Reporting: Tips to Create Compelling Reports, March 28, 2020, 60 Second Marketer. Accessed March 29, 2022.

    IT Governance

    • Buy Link or Shortcode: {j2store}22|cart{/j2store}
    • Related Products: {j2store}22|crosssells{/j2store}
    • Up-Sell: {j2store}22|upsells{/j2store}
    • member rating overall impact: 9.2/10
    • member rating average dollars saved: $124,127
    • member rating average days saved: 37
    • Parent Category Name: Strategy and Governance
    • Parent Category Link: /strategy-and-governance
    Read our concise Executive Brief to find out why you may want to redesign your IT governance, Review our methodology, and understand how we can support you in completing this process.

    Security Priorities 2022

    • Buy Link or Shortcode: {j2store}244|cart{/j2store}
    • member rating overall impact: N/A
    • member rating average dollars saved: N/A
    • member rating average days saved: N/A
    • Parent Category Name: Security Strategy & Budgeting
    • Parent Category Link: /security-strategy-and-budgeting
    • Ransomware activities and the cost of breaches are on the rise.
    • Cybersecurity talent is hard to find, and an increasing number of cybersecurity professionals are considering leaving their jobs.
    • Moving to the digital world increases the risk of a breach.

    Our Advice

    Critical Insight

    • The pandemic has fundamentally changed the technology landscape. Security programs must understand how their threat surface is now different and adapt their controls to meet the challenge.
    • The upside to the upheaval in 2021 is new opportunities to modernize your security program.

    Impact and Result

    • Use the report to ensure your plan in 2022 addresses what’s important in cybersecurity.
    • Understand the current situation in the cybersecurity space.

    Security Priorities 2022 Research & Tools

    Besides the small introduction, subscribers and consulting clients within this management domain have access to:

    1. Security Priorities 2022 – A report that describes priorities and recommendations for CISOs in 2022.

    Use this report to understand the current situation in the cybersecurity space and inform your plan for 2022. This report includes sections on protecting against and responding to ransomware, acquiring and retaining talent, securing a remote workforce, securing digital transformation, and adopting zero trust.

    • Security Priorities for 2022 Report

    Infographic

    Further reading

    Security Priorities 2022

    The pandemic has changed how we work

    disruptions to the way we work caused by the pandemic are here to stay.

    The pandemic has introduced a lot of changes to our lives over the past two years, and this is also true for various aspects of how we work. In particular, a large workforce moved online overnight, which shifted the work environment rapidly.

    People changed how they communicate, how they access company information, and how they connect to the company network. These changes make cybersecurity a more important focus than ever.

    Although changes like the shift to remote work occurred in response to the pandemic, they are largely expected to remain, regardless of the progression of the pandemic itself. This report will look into important security trends and the priorities that stemmed from these trends.

    30% more professionals expect transformative permanent change compared to one year ago.

    47% of professionals expect a lot of permanent change; this remains the same as last year. (Source: Info-Tech Tech Trends 2022 Survey; N=475)

    The cost of a security breach is rising steeply

    The shift to remote work exposes organizations to more costly cyber incidents than ever before.

    $4.24 million

    Average cost of a data breach in 2021
    The cost of a data breach rose by nearly 10% in the past year, the highest rate in over seven years.

    $1.07 million

    More costly when remote work involved in the breach

    The average cost of breaches where remote work is involved is $1.07 million higher than breaches where remote work is not involved.

    The ubiquitous remote work that we saw in 2021 and continue to see in 2022 can lead to more costly security events. (Source: IBM, 2021)

    Remote work is here to stay, and the cost of a breach is higher when remote work is involved.

    The cost comes not only directly from payments but also indirectly from reputational loss. (Source: IBM, 2021)

    Security teams can participate in the solution

    The numbers are clear: in 2022, when we face a threat environment like WE’VE never EXPERIENCED before, good security is worth the investment

    $1.76 million

    Saved when zero trust is deployed facing a breach

    Zero trust controls are realistic and effective controls.

    Organizations that implement zero trust dramatically reduce the cost of an adverse security event.

    35%

    More costly if it takes more than 200 days to identify and contain a breach

    With increased BYOD and remote work, detection and response is more challenging than ever before – but it is also highly effective.

    Organizations that detect and respond to incidents quickly will significantly reduce the impact. (Source: IBM, 2021)

    Breaches are 34% less costly when mature zero trust is implemented.

    A fully staffed and well-prepared security team could save the cost through quick responses. (Source: IBM, 2021)

    Top security priorities and constraints in 2022

    Survey results

    As part of its research process for the 2022 Security Priorities Report, Info-Tech Research Group surveyed security and IT leaders (N=97) to ask their top security priorities as well as their main obstacles to security success in 2022:

    Top Priorities
    A list of the top three priorities identified in the survey with their respective percentages, 'Acquiring and retaining talent, 30%', 'Protecting against and responding to ransomware, 23%', and 'Securing a remote workforce, 23%'.

    Survey respondents were asked to force-rank their security priorities.

    Among the priorities chosen most frequently as #1 were talent management, addressing ransomware threats, and securing hybrid/remote work.

    Top Obstacles
    A list of the top three obstacles identified in the survey with their respective percentages, 'Staffing constraints, 31%', 'Demand of ever-changing business environment, 23%', and 'Budget constraints, 15%'.

    Talent management is both the #1 priority and the top obstacle facing security leaders in 2022.

    Unsurprisingly, the ever-changing environment in a world emerging from a pandemic and budget constraints are also top obstacles.

    We know the priorities…

    But what are security leaders actually working on?

    This report details what we see the world demanding of security leaders in the coming year.

    Setting aside the demands – what are security leaders actually working on?

    A list of 'Top security topics among Info-Tech members' with accompanying bars, 'Security Strategy', 'Security Policies', 'Security Operations', 'Security Governance', and 'Security Incident Response'.

    Many organizations are still mastering the foundations of a mature cybersecurity program.

    This is a good idea!

    Most breaches are still due to gaps in foundational security, not lack of advanced controls.

    We know the priorities…

    But what are security leaders actually working on?

    A list of industries with accompanying bars representing their demand for security. The only industry with a significant positive percentage is 'Government'. Security projects included in annual plan relative to industry.

    One industry plainly stands out from the rest. Government organizations are proportionally much more active in security than other industries, and for good reason: they are common targets.

    Manufacturing and professional services are proportionally less interested in security. This is concerning, given the recent targeting of supply chain and personal data holders by ransomware gangs.

    5 Security Priorities for 2022 Logo for Info-Tech. Logo for ITRG.

    People

    1. Acquiring and Retaining Talent
      Create a good working environment for existing and potential employees. Invest time and effort into talent issues to avoid being understaffed.
    2. Securing a Remote Workforce
      Create a secure environment for users and help your people build safe habits while working remotely.

    Process

    1. Securing Digital Transformation
      Build in security from the start and check in frequently to create agile and secure user experiences.

    Technology

    1. Adopting Zero Trust
      Manage access of sensitive information based on the principle of least privilege.
    2. Protecting Against and Responding to Ransomware
      Put in your best effort to build defenses but also prepare for a breach and know how to recover.

    Main Influencing Factors

    COVID-19 Pandemic
    The pandemic has changed the way we interact with technology. Organizations are universally adapting their business and technology processes to fit the post-pandemic paradigm.
    Rampant Cybercrime Activity
    By nearly every conceivable metric, cybercrime is way up in the past two years. Cybercriminals smell blood and pose a more salient threat than before. Higher standards of cybersecurity capability are required to respond to this higher level of threat.
    Remote Work and Workforce Reallocation
    Talented IT staff across the globe enabled an extraordinarily fast shift to remote and distance work. We must now reckon with the security and human resourcing implications of this huge shift.

    Acquire and Retain Talent

    Priority 01

    Security talent was in short supply before the pandemic, and it's even worse now.

    Executive summary

    Background

    Cybersecurity talent has been in short supply for years, but this shortage has inflected upward since the pandemic.

    The Great Resignation contributed to the existing talent gap. The pandemic has changed how people work as well as how and where they choose work. More and more senior workers are retiring early or opting for remote working opportunities.

    The cost to acquire cybersecurity talent is huge, and the challenge doesn’t end there. Retaining top talent can be equally difficult.

    Current situation

    • A 2021 survey by ESG shows that 76% of security professional agree it’s difficult to recruit talent, and 57% said their organization is affected by this talent shortage.
    • (ISC)2 reports there are 2.72 million unfilled job openings and an increasing workforce gap (2021).

    2.72 million unfilled cybersecurity openings (Source: (ISC)2, 2021)

    IT leaders must do more to attract and retain talent in 2022

    • Over 70% of IT professionals are considering quitting their jobs (TalentLMS, 2021). Meanwhile, 51% of surveyed cybersecurity professionals report extreme burnout during the last 12 months and many of them have considered quitting because of it (VMWare, 2021).
    • Working remotely makes it easier for people to look elsewhere, lowering the barrier to leaving.
    • This is a big problem for security leaders, as cybersecurity talent is in very short supply. The cost of acquiring and retaining quality cybersecurity staff in 2022 is significant, and many organizations are unwilling or unable to pay the premium.
    • Top talent will demand flexible working conditions – even though remote work comes with security risk.
    • Most smart, talented new hires in 2022 are demanding to work remotely most of the time.
    Top reasons for resignations in 2021
    Burnout 30%
    Other remote opportunities 20%
    Lack of growth opportunities 20%
    Poor culture 20%
    Acquisition concerns 10%
    (Source: Survey of West Coast US cybersecurity professionals; TechBeacon, 2021)

    Talent will be 2022’s #1 strength and #1 weakness

    Staffing obstacles in 2022:

    “Attracting and retaining talent is always challenging. We don’t pay as well and my org wants staff in the office at least half of the time. Most young, smart, talented new hires want to work remotely 100 percent of the time.“

    “Trying to grow internal resources into security roles.”

    “Remote work expectations by employees and refusal by business to accommodate.”

    “Biggest obstacle: payscales that are out of touch with cybersecurity market.”

    “Request additional staff. Obtaining funding for additional position is most significant obstacle.”

    (Info-Tech Tech Security Priorities Survey 2022)
    Top obstacles in 2022:

    As you can see, respondents to our security priorities survey have strong feelings on the challenges of staffing a cybersecurity team.

    The growth of remote work means local talent can now be hired by anybody, vastly increasing your competition as an employer.

    Hiring local will get tougher – but so will hiring abroad. People who don’t want to relocate for a new job now have plenty of alternatives. Without a compelling remote work option, you will find non-local prospects unwilling to move for a new job.

    Lastly, many organizations are still reeling at the cost of experienced cybersecurity talent. Focused internal training and development will be the answer for many organizations.

    Recommended Actions

    Provide career development opportunities

    Many security professionals are dissatisfied with their unclear career development paths. To improve retention, organizations should provide their staff with opportunities and clear paths for career and skills advancement.

    Be open-minded when hiring

    To broaden the candidate pool, organizations should be open-minded when considering who to hire.

    • Enable remote work.
    • Do not fixate on certificates and years of experience; rather, be open to developing those who have the right interest and ability.
    • Consider using freelance workers.
    Facilitate work-life balance

    Many security professionals say they experience burnout. Promoting work-life balance in your organization can help retain critical skills.

    Create inclusive environment

    Hire a diverse team and create an inclusive environment where they can thrive.

    Talent acquisition and retention plan

    Use this template to explain the priorities you need your stakeholders to know about.

    Provide a brief value statement for the initiative.

    Address a top priority and a top obstacle with a plan to attract and retain top organizational and cybersecurity talent.

    Initiative Description:

    • Provide secure remote work capabilities for staff.
    • Work with HR to refine a hiring plan that addresses geographical and compensation gaps with cybersecurity and general staff.
    • Survey staff engagement to identify points of friction and remediate where needed.
    • Define a career path and growth plan for staff.
    Description must include what IT will undertake to complete the initiative.

    Primary Business Benefits:

    Arrow pointing down.
    Reduction in costs due to turnover and talent loss

    Other Expected Business Benefits:

    Arrow pointing up.
    Productivity due to good morale/ engagement
    Arrow pointing up.
    Improved corporate culture
    Align initiative benefits back to business benefits or benefits for the stakeholder groups that it impacts.

    Risks:

    • Big organizational and cultural changes
    • Increased attack surface of remote/hybrid workforce

    Related Info-Tech Research:

    Secure a Remote Workforce

    Priority 02

    Trends suggest remote work is here to stay. Addressing the risk of insecure endpoints can no longer be deferred.

    Executive summary

    Remote work poses unique challenges to cybersecurity teams. The personal home environment may introduce unauthorized people and unknown network vulnerabilities, and the organization loses nearly all power and influence over the daily cyber hygiene of its users.

    In addition, the software used for enabling remote work itself can be a target of cybersecurity criminals.

    Current situation

    • 70% of workers in technical services work from home.
    • Employees of larger firms and highly paid individuals are more likely to be working outside the office.
    • 80% of security and business leaders find that remote work has increased the risk of a breach.
    • (Source: StatCan, 2021)

    70% of tech workers work from home (Source: Statcan, 2021)

    Remote work demands new security solutions

    The security perimeter is finally gone

    The data is outside the datacenter.
    The users are outside the office.
    The endpoints are … anywhere and everywhere.

    Organizations that did not implement digital transformation changes following COVID-19 experience higher costs following a breach, likely because it is taking nearly two months longer, on average, to detect and contain a breach when more than 50% of staff are working remotely (IBM, 2021).

    In 2022 the cumulative risk of so many remote connections means we need to rethink how we secure the remote/hybrid workforce.

    Security
    • Distributed denial of service
    • DNS hijacking
    • Weak VPN protocols
    Identity
    • One-time verification allowing lateral movement
    Colorful tiles representing the surrounding security solutions. Network
    • Risk perimeter stops at corporate network edge
    • Split tunneling
    Authentication
    • Weak authentication
    • Weak password
    Access
    • Man-in-the-middle attack
    • Cross-site scripting
    • Session hijacking

    Recommended Actions

    Mature your identity management

    Compromised identity is the main vector to breaches in recent years. Stale accounts, contractor accounts, misalignment between HR and IT – the lack of foundational practices leads to headline-making breaches every week.
    Tighten up identity control to keep your organization out of the newspaper.

    Get a handle on your endpoints

    Work-from-home (WFH) often means unknown endpoints on unknown networks full of other unknown devices…and others in the home potentially using the workstation for non-work purposes. Gaining visibility into your endpoints can help to keep detection and resolution times short.

    Educate users

    Educate everyone on security best practices when working remotely:

    • Apply secure settings (not just defaults) to the home network.
    • Use strong passwords.
    • Identify suspicious email.
    Ease of use

    Many workers complain that the corporate technology solution makes it difficult to get their work done.

    Employees will take productivity over security if we force them to choose, so IT needs to listen to end users’ needs and provide a solution that is nimble and secure.

    Roadmap to securing remote/hybrid workforce

    Use this template to explain the priorities you need your stakeholders to know about.

    Provide a brief value statement for the initiative.

    The corporate network now extends to the internet – ensure your security plan has you covered.

    Initiative Description:

    • Reassess enterprise security strategy to include the WFH attack surface (especially endpoint visibility).
    • Ensure authentication requirements for remote workers are sufficient (e.g. MFA, strong passwords, hardware tokens for high-risk users/connections).
    • Assess the value of zero trust networking to minimize the blast radius in the case of a breach.
    • Perform penetration testing annually.
    Description must include what IT will undertake to complete the initiative.

    Primary Business Benefits:

    Arrow pointing down.

    Reduced cost of security incidents/reputational damage

    Other Expected Business Benefits:

    Arrow pointing up.
    Improved ability to attract and retain talent
    Arrow pointing up.
    Increased business adaptability
    Align initiative benefits back to business benefits or benefits for the stakeholder groups that it impacts.

    Risks:

    • Potential disruption to traditional working patterns
    • Cost of investing in WFH versus risk of BYOD

    Related Info-Tech Research:

    Secure Digital Transformation

    Priority 03

    Digital transformation could be a competitive advantage…or the cause of your next data breach.

    Executive summary

    Background

    Digital transformation is occurring at an ever-increasing rate these days. As Microsoft CEO Satya Nadella said early in the pandemic, “We’ve seen two years’ worth of digital transformation in two months.”

    We have heard similar stories from Info-Tech members who deployed rollouts that were scheduled to take months over a weekend instead.

    Microsoft’s own shift to rapidly expand its Teams product is a prime example of how quickly the digital landscape has changed. The global adaption to a digital world has largely been a success story, but rapid change comes with risk, and there is a parallel story of rampant cyberattacks like we have never seen before.

    Insight

    There is an adage that “slow is smooth, and smooth is fast” – the implication being that fast is sloppy. In 2022 we’ll see a pattern of organizations working to catch up their cybersecurity with the transformations we all made in 2020.

    $1.78 trillion expected in digital transformation investments (Source: World Economic Forum, 2021)

    An ounce of security prevention versus a pound of cure

    The journey of digital transformation is a risky one.

    Digital transformations often rely heavily on third-party cloud service providers, which increases exposure of corporate data.

    Further, adoption of new technology creates a new threat surface that must be assessed, mitigations implemented, and visibility established to measure performance.

    However, digital transformations are often run on slim budgets and without expert guidance.

    Survey respondents report as much: rushed deployments, increased cloud migration, and shadow IT are the top vulnerabilities reported by security leaders and executives.

    In a 2020 Ponemon survey, 82% of IT security and C-level executives reported experiencing at least one data breach directly resulting from a digital transformation they had undergone.

    Scope creep is inevitable on any large project like a digital transformation. A small security shortcut early in the project can have dire consequences when it grows to affect personal data and critical systems down the road.

    Recommended Actions

    Engage the business early and often

    Despite the risks, organizations engage in digital transformations because they also have huge business value.

    Security leaders should not be seeking to slow or stop digital transformations; rather, we should be engaging with the business early to get ahead of risks and enable successful transformation.

    Establish a vendor security program

    Data is moving out of datacenters and onto third-party environments. Without security requirements built into agreements, and clear visibility into vendor security capabilities, that data is a major source of risk.

    A robust vendor security program will create assurance early in the process and help to reinforce the responsibility of securing data with other parts of the organization.

    Build/revisit your security strategy

    The threat surface has changed since before your transformation. This is the right time to revisit or rebuild your security strategy to ensure that your control set is present throughout the new environment – and also a great opportunity to show how your current security investments are helping secure your new digital lines of business!

    Educate your key players

    Only 16% of security leaders and executives report alignment between security and business processes during digital transformation.

    If security is too low a priority, then key players in your transformation efforts are likely unaware of how security risks impact their own success. It will be incumbent upon the CISO to start that conversation.

    Securing digital transformation

    Use this template to explain the priorities you need your stakeholders to know about.

    Provide a brief value statement for the initiative.

    Ensure your investment in digital transformation is appropriately secured.

    Initiative Description:

    • Engage security with digital transformation and relevant governance structures (steering committees) to ensure security considerations are built into digital transformation planning.
    • Incorporate security stage gates in project management procedures.
    • Establish a vendor security assessment program.
    Description must include what IT will undertake to complete the initiative.

    Primary Business Benefits:

    Arrow pointing up.

    Increased likelihood of digital transformation success

    Other Expected Business Benefits:

    Arrow pointing up.
    Ability to make informed decisions for the field rep strategy
    Arrow pointing down.
    Reduced long-term cost of digital transformation
    Align initiative benefits back to business benefits or benefits for the stakeholder groups that it impacts.

    Risks:

    • Potential increased up front cost (reduced long-term cost)
    • Potential slowed implementation with security stage gates in project management

    Related Info-Tech Research:

    Adopt Zero Trust

    Priority 04

    Governments are recognizing the importance of zero trust strategies. So should your organization.

    Why now for zero trust?

    John Kindervag modernized the concept of zero trust back in 2010, and in the intervening years there has been enormous interest in cybersecurity circles, yet in 2022 only 30% of organizations report even beginning to roll out zero trust capabilities (Statista, 2022).

    Why such little action on a revolutionary and compelling model?

    Zero trust is not a technology; it is a principle. Zero trust adoption takes concerted planning, effort, and expense, for which the business value has been unclear throughout most of the last 10 years. However, several recent developments are changing that:

    • Securing technology has become very hard! The size, complexity, and attack surface of IT environments has grown significantly – especially since the pandemic.
    • Cyberattacks have become rampant as the cost to deploy harmful ransomware has become lower and the impact has become higher.
    • The shift away from on-premises datacenters and offices created an opening for zero trust investment, and zero trust technology is more mature than ever before.

    The time has come for zero trust adoption to begin in earnest.

    97% will maintain or increase zero trust budget (Source: Statista, 2022)

    Traditional perimeter security is not working

    Zero trust directly addresses the most prevalent attack vectors today

    A hybrid workforce using traditional VPN creates an environment where we are exposed to all the risks in the wild (unknown devices at any location on any network), but at a stripped-down security level that still provides the trust afforded to on-premises workers using known devices.

    What’s more, threats such as ransomware are known to exploit identity and remote access vulnerabilities before moving laterally within a network – vectors that are addressed directly by zero trust identity and networking. Ninety-three percent of surveyed zero trust adopters state that the benefits have matched or exceeded their expectations (iSMG, 2022).

    Top reasons for building a zero trust program in 2022

    (Source: iSMG, 2022)

    44%

    Enforce least privilege access to critical resources

    44%

    Reduce attacker ability to move laterally

    41%

    Reduce enterprise attack surface

    The business case for zero trust is clearer than ever

    Prior obstacles to Zero Trust are disappearing

    A major obstacle to zero trust adoption has been the sheer cost, along with the lack of business case for that investment. Two factors are changing that paradigm in 2022:

    The May 2021 US White House Executive Order for federal agencies to adopt zero trust architecture finally placed zero trust on the radar of many CEOs and board members, creating the business interest and willingness to consider investing in zero trust.

    In addition, the cost of adopting zero trust is quickly being surpassed by the cost of not adopting zero trust, as cyberattacks become rampant and successful zero trust deployments create a case study to support investment.

    Bar chart titled 'Cost to remediate a Ransomware attack' with bars representing the years '2021' and '2020'. 2021's cost sits around $1.8M while 2020's was only $750K The cost to remediate a ransomware attack more than doubled from 2020 to 2021. Widespread adoption of zero trust capabilities could keep that number from doubling again in 2022. (Source: Sophos, 2021)

    The cost of a data breach is on average $1.76 million less for organizations with mature zero trust deployments.

    That is, the cost of a data breach is 35% reduced compared to organizations without zero trust controls. (Source: IBM, 2021)

    Recommended Actions

    Start small

    Don’t put all your eggs in one basket by deploying zero trust in a wide swath. Rather, start as small as possible to allow for growing pains without creating business friction (or sinking your project altogether).

    Build a sensible roadmap

    Zero trust principles can be applied in a myriad of ways, so where should you start? Between identities, devices, networking, and data, decide on a use case to do pilot testing and then refine your approach.

    Beware too-good-to-be-true products

    Zero trust is a powerful buzzword, and vendors know it.

    Be skeptical and do your due diligence to ensure your new security partners in zero trust are delivering what you need.

    Zero trust roadmap

    Use this template to explain the priorities you need your stakeholders to know about.

    Provide a brief value statement for the initiative.

    Develop a practical roadmap that shows the business value of security investment.

    Initiative Description:

    • Define desired business and security outcomes from zero trust adoption.
    • Assess zero trust readiness.
    • Build roadmaps for zero trust:
      1. Identity
      2. Networking
      3. Devices
      4. Data
    Description must include what IT will undertake to complete the initiative.

    Primary Business Benefits:

    Arrow pointing up.

    Increased security posture and business agility

    Other Expected Business Benefits:

    Arrow pointing down.
    Reduced impact of security events
    Arrow pointing down.
    Reduced cost of managing complex control set
    Arrow pointing up.
    More secure business transformation (i.e. cloud/digital)
    Align initiative benefits back to business benefits or benefits for the stakeholder groups that it impacts.

    Risks:

    • Learning curve of implementation (start small and slow)
    • Transition from current control set to zero trust model

    Related Info-Tech Research:

    Protect Against and Respond to Ransomware

    Priority 05

    Ransomware is still the #1 threat to the safety of your data.

    Executive summary

    Background

    • Ransomware attacks have transformed in 2021 and show no sign of slowing in 2022. There is a new major security breach every week, despite organizations spending over $150 billion in a year on cybersecurity (Nasdaq, 2021).
    • Ransomware as a service (RaaS) is commonplace, and attackers are doubling down by holding encrypted data ransom and also demanding payment under threat to disclose exfiltrated data – and they are making good on their threats.
    • The global cost of ransomware is expected to rise to $265 billion by 2031 (Cybersecurity Ventures, 2021).
    • We expect to see an increase in ransomware incidents in 2022, both in severity and volume – multiple attacks and double extortion are now the norm.
    • High staff turnover increases risk because new employees are unfamiliar with security protocols.

    150% increase ransomware attacks in 2020 (Source: ENISA)

    This is a new golden age of ransomware

    What is the same in 2022

    Unbridled ransomware attacks make it seem like attackers must be using complex new techniques, but prevalent ransomware attack vectors are actually well understood.

    Nearly all modern variants are breaching victim systems in one of three ways:

    • Email phishing
    • Software vulnerabilities
    • RDP/Remote access compromise
    What is new in 2022
    The sophistication of victim targeting

    Victims often find themselves asking, “How did the attackers know to phish the most security-oblivious person in my staff?” Bad actors have refined their social engineering and phishing to exploit high-risk individuals, meaning your chain is only as strong as the weakest link.

    Ability of malware to evade detection

    Modern ransomware is getting better at bypassing anti-malware technology, for example, through creative techniques such as those seen in the MedusaLocker variant and in Ghost Control attacks.

    Effective anti-malware is still a must-have control, but a single layer of defense is no longer enough. Any organization that hopes to avoid paying a ransom must prepare to detect, respond, and recover from an attack.

    Many leaders still don’t know what a ransomware recovery would look like

    Do you know what it would take to recover from a ransomware incident?

    …and does your executive leadership know what it would take to recover?

    The organizations that are most likely to pay a ransom are unprepared for the reality of recovering their systems.

    If you have not done a tabletop or live exercise to simulate a true recovery effort, you may be exposed to more risk than you realize.

    Are your defenses sufficiently hardened against ransomware?

    Organizations with effective security prevention are often breached by ransomware – but they are prepared to contain, detect, and eradicate the infection.

    Ask yourself whether you have identified potential points of entry for ransomware. Assume that your security controls will fail.

    How well are your security controls layered, and how difficult would it be for an attacker to move east/west within your systems?

    Recommended Actions

    Be prepared for a breach

    There is no guarantee that an organization will not fall victim to ransomware, so instead of putting all their effort into prevention, organizations should also put effort into planning to respond to a breach.

    Security awareness training/phishing detection

    Phishing continues to be the main point of entry for ransomware. Investing in phishing awareness and detection among your end users may be the most impactful countermeasure you can implement.

    Zero trust adoption

    Always verify at every step of interaction, even when access is requested by internal users. Manage access of sensitive information based on the principle of least privilege access.

    Encrypt and back up your data

    Encrypt your data so that even if there is a breach, the attackers don’t have a copy of your data. Also, keep regular backups of data at a separate location so that you still have data to work with after a breach occurs.

    You never want to pay a ransom. Being prepared to deal with an incident is your best chance to avoid paying!

    Prevent and respond to ransomware

    Use this template to explain the priorities you need your stakeholders to know about.

    Provide a brief value statement for the initiative.

    Determine your current readiness, response plan, and projects to close gaps.

    Initiative Description:

    • Execute a systematic assessment of your current security and ransomware recovery capabilities.
    • Perform tabletop activities and live recoveries to test data recovery capabilities.
    • Train staff to detect suspicious communications and protect their identities.
    Description must include what IT will undertake to complete the initiative.

    Primary Business Benefits:

    Arrow pointing up.

    Improved productivity and brand protection

    Other Expected Business Benefits:

    Arrow pointing down.
    Reduced downtime and disruption
    Arrow pointing down.
    Reduced cost due to incidents (ransom payments, remediation)
    Align initiative benefits back to business benefits or benefits for the stakeholder groups that it impacts.

    Risks:

    • Friction with existing staff

    Related Info-Tech Research:

    Deepfakes: Dark-horse threat for 2022

    Deepfake video

    How long has it been since you’ve gone a full workday without having a videoconference with someone?

    We have become inherently trustful that the face we see on the screen is real, but the technology required to falsify that video is widely available and runs on commercially available hardware, ushering in a genuinely post-truth online era.

    Criminals can use deepfakes to enhance social engineering, to spread misinformation, and to commit fraud and blackmail.

    Deepfake audio

    Many financial institutions have recently deployed voiceprint authentication. TD describes its VoicePrint as “voice recognition technology that allows us to use your voiceprint – as unique to you as your fingerprint – to validate your identity” over the phone.

    However, hackers have been defeating voice recognition for years already. There is ripe potential for voice fakes to fool both modern voice recognition technology and the accounts payable staff.

    Bibliography

    “2021 Ransomware Statistics, Data, & Trends.” PurpleSec, 2021. Web.

    Bayern, Macy. “Why 60% of IT security pros want to quit their jobs right now.” TechRepublic, 10 Oct. 2018. Web.

    Bresnahan, Ethan. “How Digital Transformation Impacts IT And Cyber Risk Programs.” CyberSaint Security, 25 Feb. 2021. Web.

    Clancy, Molly. “The True Cost of Ransomware.” Backblaze, 9 Sept. 2021.Web.

    “Cost of a Data Breach Report 2021.” IBM, 2021. Web.

    Cybersecurity Ventures. “Global Ransomware Damage Costs To Exceed $265 Billion By 2031.” Newswires, 4 June 2021. Web.

    “Digital Transformation & Cyber Risk: What You Need to Know to Stay Safe.” Ponemon Institute, June 2020. Web.

    “Global Incident Response Threat Report: Manipulating Reality.” VMware, 2021.

    Granger, Diana. “Karmen Ransomware Variant Introduced by Russian Hacker.” Recorded Future, 18 April 2017. Web.

    “Is adopting a zero trust model a priority for your organization?” Statista, 2022. Web.

    “(ISC)2 Cybersecurity Workforce Study, 2021: A Resilient Cybersecurity Profession Charts the Path Forward.” (ISC)2, 2021. Web.

    Kobialka, Dan. “What Are the Top Zero Trust Strategies for 2022?” MSSP Alert, 10 Feb. 2022. Web.

    Kost, Edward. “What is Ransomware as a Service (RaaS)? The Dangerous Threat to World Security.” UpGuard, 1 Nov. 2021. Web.

    Lella, Ifigeneia, et al., editors. “ENISA Threat Landscape 2021.” ENISA, Oct. 2021. Web.

    Mello, John P., Jr. “700K more cybersecurity workers, but still a talent shortage.” TechBeacon, 7 Dec. 2021. Web.

    Naraine, Ryan. “Is the ‘Great Resignation’ Impacting Cybersecurity?” SecurityWeek, 11 Jan. 2022. Web.

    Oltsik, Jon. “ESG Research Report: The Life and Times of Cybersecurity Professionals 2021 Volume V.” Enterprise Security Group, 28 July 2021. Web.

    Osborne, Charlie. “Ransomware as a service: Negotiators are now in high demand.” ZDNet, 8 July 2021. Web.

    Osborne, Charlie. “Ransomware in 2022: We’re all screwed.” ZDNet, 22 Dec. 2021. Web.

    “Retaining Tech Employees in the Era of The Great Resignation.” TalentLMS, 19 Oct. 2021. Web.

    Rubin, Andrew. “Ransomware Is the Greatest Business Threat in 2022.” Nasdaq, 7 Dec. 2021. Web.

    Samartsev, Dmitry, and Daniel Dobrygowski. “5 ways Digital Transformation Officers can make cybersecurity a top priority.“ World Economic Forum, 15 Sept. 2021. Web.

    Seymour, John, and Azeem Aqil. “Your Voice is My Passport.” Presented at black hat USA 2018.

    Solomon, Howard. “Ransomware attacks will be more targeted in 2022: Trend Micro.” IT World Canada, 6 Jan. 2022. Web.

    “The State of Ransomware 2021.” Sophos, April 2021. Web.

    Tarun, Renee. “How The Great Resignation Could Benefit Cybersecurity.” Forbes Technology Council, Forbes, 21 Dec. 2021. Web.

    “TD VoicePrint.” TD Bank, n.d. Web.

    “Working from home during the COVID-19 pandemic, April 202 to June 2021.” Statistics Canada, 4 Aug. 2021. Web.

    “Zero Trust Strategies for 2022.” iSMG, Palo Alto Networks, and Optiv, 28 Jan. 2022. Web.

    Cost and Budget Management

    • Buy Link or Shortcode: {j2store}8|cart{/j2store}
    • Related Products: {j2store}8|crosssells{/j2store}
    • Up-Sell: {j2store}8|upsells{/j2store}
    • member rating overall impact: 9.5/10
    • member rating average dollars saved: $2,000
    • member rating average days saved: 5
    • Parent Category Name: Financial Management
    • Parent Category Link: /financial-management

    The challenge

    • IT is seen as a cost center in most organizations. Your IT spend is fuelled by negative sentiment instead of contributing to business value.

    • Budgetary approval is difficult, and in many cases, the starting point is lowering the cost-income ratio without looking at the benefits.
    • Provide the right amount of detail in your budgets to tell your investment and spending story. Align it with the business story. Too much detail only increases confusion, too little suspicion.

    Our advice

    Insight

    An effective IT budget complements the business story with how you will achieve the expected business targets.

    • Partner with the business to understand the strategic direction of the company and its future needs.
    • Know your costs and the value you will deliver.
    • Present your numbers and story clearly and credibly. Excellent delivery is part of good communication.
    • Guide your company by clearly explaining the implications of different choices they can make.

    Impact and results

    • Get a head-start on your IT forecasting exercise by knowing the business strategy and what initiatives they will launch.
    • The coffee corner works! Pre-sell your ideas in quick chats.
    • Do not make innovation budgets bigger than they need to be. It undermines your credibility.
    • You must know your history to accurately forecast your IT operations cost and how it will evolve based on expected business changes.
    • Anticipate questions. IT discretionary proposals are often challenged. Think ahead of time about what areas your business partners will focus on and be ready with researched and credible responses.
    • When you have an optimized budget, tie further cost reductions to consequences in service delivery or deferred projects, or a changed operating model.

    The roadmap

    Besides the small introduction, subscribers and consulting clients within this management domain have access to:

    Get started

    Our concise executive brief shows you why you should develop a budget based on value delivery. We'll show you our methodology and the ways we can help you in completing this.

    Plan for budget success

    • Build an IT Budget That Demonstrates Value Delivery – Phase 1: Plan (ppt)
    • IT Budget Interview Guide (doc)

    Build your budget.

    • Build an IT Budget That Demonstrates Value Delivery – Phase 2: Build (ppt)
    • IT Cost Forecasting Tool (xls)

    Sell your budget

    • Build an IT Budget That Demonstrates Value Delivery – Phase 3: Sell (ppt)
    • IT Budget Presentation (ppt)

    The challenge of corporate security management

    • Buy Link or Shortcode: {j2store}41|cart{/j2store}
    • Related Products: {j2store}41|crosssells{/j2store}
    • member rating overall impact: N/A
    • member rating average dollars saved: N/A
    • member rating average days saved: N/A
    • Parent Category Name: Security and Risk
    • Parent Category Link: /security-and-risk

    Corporate security management is a vital aspect in every modern business, regardless of business area or size. At Tymans Group we offer expert security management consulting to help your business set up proper protocols and security programs. More elaborate information about our security management consulting services and solutions can be found below.

    Corporate security management components

    You may be experiencing one or more of the following:

    • The risk goals should support business goals. Your business cannot operate without security, and security is there to conduct business safely.
    • Security governance supports security strategy and security management. These three components form a protective arch around your business.
    • Governance and management are like the legislative branch and the executive branch. Governance tells people what to do, and management's job is to verify that they do it.

    Our advice with regards to corporate security management

    Insight

    To have a successful information security strategy, take these three factors into account:

    • Holistic: your view must include people, processes, and technology.
    • Risk awareness: Base your strategy on the actual risk profile of your company and then add the appropriate best practices.
    • Business-aligned: When your strategic security plan demonstrates alignment with the business goals and supports it, embedding will be much more straightforward.

    Impact and results of our corporate security management approach

    • The approach of our security management consulting company helps to provide a starting point for realistic governance and realistic corporate security management.
    • We help you by implementing security governance and managing it, taking into account your company's priorities, and keeping costs to a minimum.

    The roadmap

    Besides the small introduction, subscribers and consulting clients within the corporate security management domain have access to:

    Get up to speed

    Read up on why you should build your customized corporate information security governance and management system. Review our methodology and understand the four ways we can support you.

    Align your security objectives with your business goals

    Determine the company's risk tolerance.

    • Implement a Security Governance and Management Program – Phase 1: Align Business Goals With Security Objectives (ppt)
    • Information Security Governance and Management Business Case (ppt)
    • Information Security Steering Committee Charter (doc)
    • Information Security Steering Committee RACI Chart (doc)
    • Security Risk Register Tool (xls)

    Build a practical governance framework for your company

    Our best-of-breed security framework makes you perform a gap analysis between where you are and where you want to be (your target state). Once you know that, you can define your goals and duties.

    • Implement a Security Governance and Management Program – Phase 2: Develop an Effective Governance Framework (ppt)
    • Information Security Charter (doc)
    • Security Governance Organizational Structure Template (doc)
    • Security Policy Hierarchy Diagram (ppt)
    • Security Governance Model Facilitation Questions (ppt)
    • Information Security Policy Charter Template (doc)
    • Information Security Governance Model Tool (Visio)
    • Pdf icon 20x20
    • Information Security Governance Model Tool (PDF)

    Now that you have built it, manage your governance framework.

    There are several essential management activities that we as a security management consulting company suggest you employ.

    • Implement a Security Governance and Management Program – Phase 3: Manage Your Governance Framework (ppt)
    • Security Metrics Assessment Tool (xls)
    • Information Security Service Catalog (xls)
    • Policy Exception Tracker (xls)
    • Information Security Policy Exception Request Form (doc)
    • Security Policy Exception Approval Workflow (Visio)
    • Security Policy Exception Approval Workflow (PDF)
    • Business Goal Metrics Tracking Tool (xls)

    Book an online appointment for more advice

    We are happy to tell you more about our corporate security management solutions and help you set up fitting security objectives. As a security management consulting firm we offer solutions and advice, based on our own extensive experience, which are practical and people-orientated. Discover our services, which include data security management and incident management and book an online appointment with CEO Gert Taeymans to discuss any issues you may be facing regarding risk management or IT governance.

    cybersecurity

    Adapt Your Customer Experience Strategy to Successfully Weather COVID-19

    • Buy Link or Shortcode: {j2store}536|cart{/j2store}
    • member rating overall impact: N/A
    • member rating average dollars saved: N/A
    • member rating average days saved: N/A
    • Parent Category Name: Customer Relationship Management
    • Parent Category Link: /customer-relationship-management
    • COVID-19 is an unprecedented global pandemic. It’s creating significant challenges across every sector.
    • Collapse of financial markets and a steep decline in consumer confidence has most firms nervous about revenue shortfalls and cash burn rates.
    • The economic impact of COVID-19 is freezing IT budgets and sharply changing IT priorities.
    • The human impact of COVID-19 is likely to lead to staffing shortfalls and knowledge gaps.
    • COVID-19 may be in play for up to two years.

    Our Advice

    Critical Insight

    The challenges posed by the virus are compounded by the fact that consumer expectations for strong service delivery remain high:

    • Customers still expect timely, on-demand service from the businesses they engage with.
    • There is uncertainty about how to maintain strong, revenue-driving experiences when faced with the operational challenges posed by the virus.
    • COVID-19 is changing how organizations prioritize spending priorities within their CXM strategies.

    Impact and Result

    • Info-Tech recommends rapidly updating your strategy for customer experience management to ensure it can rise to the occasion.
    • Start by assessing the risk COVID-19 poses to your CXM approach and how it’ll impact marketing, sales, and customer service functions.
    • Implement actionable measures to blunt the threat of COVID-19 while protecting revenue, maintaining consistent product and service delivery, and improving the integrity of your brand. We’ll dive into five proven techniques in this brief!

    Adapt Your Customer Experience Strategy to Successfully Weather COVID-19 Research & Tools

    Start here

    Read our concise Executive Brief to find out why you should examine the impact of COVID-19 on customer experience strategy, review Info-Tech’s methodology, and understand the four ways we can support you in completing this project.

    Besides the small introduction, subscribers and consulting clients within this management domain have access to:

    • Adapt Your Customer Experience Strategy to Successfully Weather COVID-19 Storyboard

    1. Assess the impact of COVID-19 on your CXM strategy

    Create a consolidated, updated view of your current customer experience management strategy and identify which elements can be capitalized on to dampen the impact of COVID-19 and which elements are vulnerabilities that the pandemic may threaten to exacerbate.

    2. Blunt the damage of COVID-19 with new CXM tactics

    Create a roadmap of business and technology initiatives through the lens of customer experience management that can be used to help your organization protect its revenue, maintain customer engagement, and enhance its brand integrity.

    [infographic]

    Enterprise Storage Solution Considerations

    • Buy Link or Shortcode: {j2store}507|cart{/j2store}
    • member rating overall impact: N/A
    • member rating average dollars saved: N/A
    • member rating average days saved: N/A
    • Parent Category Name: Storage & Backup Optimization
    • Parent Category Link: /storage-and-backup-optimization
    • Enterprise storage technology and options are challenging to understand.
    • There are so many options. How do you decide what the best solution is for your storage challenge??
    • Where do you start when trying to solve your enterprise storage challenge?

    Our Advice

    Critical Insight

    Take the time to understand the various data storage formats, disk types, and associated technology, as well as the cloud-based and on-premises options. This will help you select the right tool for your needs.

    Impact and Result

    Look to existing use cases based on actual Info-Tech analyst calls to help in your decision-making process.

    Enterprise Storage Solution Considerations Research & Tools

    Besides the small introduction, subscribers and consulting clients within this management domain have access to:

    1. Enterprise Storage Solution Considerations – Narrow your focus with the right product type and realize efficiencies.

    Explore the building blocks of enterprise storage so you can select the best solution, narrow your focus with the correct product type, explore the features that should be considered when evaluating enterprise storage offerings, and examine use cases based on actual Info-Tech analyst calls to find a storage solution for your situation.

    • Enterprise Storage Solution Considerations Storyboard

    2. Modernize Enterprise Storage Workbook – Understand your data requirements.

    The first step in solving your enterprise storage challenge is identifying your data sources, data volumes, and growth rates. This information will give you insight into what data sources could be stored on premises or in the cloud, how much storage you will require for the coming five to ten years, and what to consider when exploring enterprise storage solutions. This tool can be a valuable asset for determining your current storage drivers and future storage needs, structuring a plan for future storage purchases, and determining timelines and total cost of ownership.

    • Modernize Enterprise Storage Workbook
    [infographic]

    Further reading

    Enterprise Storage Solution Considerations

    Narrow your focus with the right product type and realize efficiencies.

    Analyst Perspective

    The vendor landscape is continually evolving, as are the solutions they offer. The options and features are increasing and appealing.

    The image contains a picture of P.J. Ryan.

    To say that the current enterprise storage landscape looks interesting would be an understatement. The solutions offered by vendors continue to grow and evolve. Flash and NVMe are increasing the speed of storage media and reducing latency. Software-defined storage is finding the most efficient use of media to store data where it is best served while managing a variety of vendor storage and older storage area networks and network-attached storage devices.

    Storage as a service is taking on a new meaning with creative solutions that let you keep the storage appliance on premises or in a colocated data center while administration, management, and support are performed by the vendor for a nominal monthly fee.

    We cannot discuss enterprise storage without mentioning the cloud. Bring a thermometer because you must understand the difference between hot, warm, and cold storage when discussing the cloud options. Very hot and very cold may also come into play.

    Storage hardware can assume a higher total cost of ownership with support options that replace the controllers on a regular basis. The options with this type of service are also varied, but the concept of not having to replace all disks and chassis nor go through a data migration is very appealing to many companies.

    The cloud is growing in popularity when it comes to enterprise storage, but on-premises solutions are still in demand, and whether you choose cloud or on premises, you can be guaranteed an array of features and options to add stability, security, and efficiency to your enterprise storage.

    P.J. Ryan
    Research Director, Infrastructure & Operations
    Info-Tech Research Group

    Executive Summary

    Info-Tech Insight

    The vendor landscape is continually evolving, as are the solutions they offer.

    Storage providers are getting acquired by bigger players, “outside the box” thinking is disrupting the storage support marketplace, “as a service” storage offerings are evolving, and what is a data lake and do I need one? The traditional storage vendors are not alone in the market, and the solutions they offer are no longer traditional either. Explore the landscape and understand your options before you make any enterprise storage solution purchases.

    Understand the building blocks of storage so you can select the best solution.

    There are multiple storage formats for data, along with multiple hardware form factors and disk types to hold those various data formats. Software plays a significant role in many of these storage solutions, and cloud offerings take advantage of all the various formats, form factors, and disks. The challenge is matching your data type with the correct storage format and solution.

    Look to existing use cases to help in your decision-making process.

    Explore previous experiences from others by reading use cases to determine what the best solution is for your challenge. You’re probably not the first to encounter the challenge you’re facing. Another organization may have previously reached out for assistance and found a viable solution that may be just what you also need.

    Enterprise storage has evolved, with more options than ever

    Data is growing, data security will always be a concern, and vendors are providing more and more options for enterprise storage.

    “By 2025, it’s estimated that 463 exabytes of data will be created each day globally – that’s the equivalent of 212,765,957 DVDs per day!” (Visual Capitalist)

    “Modern criminal groups target not only endpoints and servers, but also central storage systems and their backup infrastructure.” (Continuity Software)

    Cloud or on premises? Maybe a hybrid approach with both cloud and on premises is best for you. Do you want to remove the headaches of storage administration, management, and support with a fully managed storage-as-a-service solution? Would you like to upgrade your controllers every three or four years without a major service interruption? The options are increasing and appealing.

    High-Level Considerations

    1. Understand Your Data

    Understand how much data you have and where it is located. This will be crucial when evaluating enterprise storage solutions.

    2. Plan for Growth

    Your enterprise storage considerations should include your data needs now and in the future.

    3. Understand the Mechanics

    Take the time to understand the various data storage formats, disk types, and associated technology, as well as the cloud-based and on-premises options. This will help you select the right tool for your needs.

    Storage formats, disk drives, and technology

    Common data storage formats, technology, and drive types are outlined below. Understanding how data is stored as well as the core building blocks for larger systems will help you decide which solution is best for your storage needs.

    Format

    What it is

    Disk Drives and Technology

    File Storage

    File storage is hierarchical storage that uses files, folders, subfolders, and directories. You enter a specific filename and path to access the file, such as P:\users\johndoe\strategy\cloud.doc. If you ever saved a file on a server, you used file storage. File storage is usually managed by some type of file manager, such as File Explorer in Windows. Network-attached storage (NAS) devices use file storage.

    Hard Disk Drives (HDD)

    HDD use a platter of spinning disks to magnetically store data. The disks are thick enough to make them rigid and are referred to as hard disks.

    HDD is older technology but is still in demand and offered by vendors.

    Object Storage

    Object storage is when data is broken into distinct units, called objects. These objects are stored in a flat, non-hierarchical structure in a single location or repository. Each object is identified by its associated ID and metadata. Objects are accessed by an application programming interface (API).

    Flash

    Flash storage uses flash memory chips to store data. The flash memory chips are written with electricity and contain no moving parts. Flash storage is very fast, which is how the technology got its name (“Flash vs. SSD Storage,” Enterprise Storage Forum, 2018).

    Block Storage

    Block storage is when data is divided up into fixed-size blocks and stored with a unique identifier. Blocks can be stored in different environments, such as Windows or Linux. Storage area networks (SANs) use block storage.

    Solid-State Drive (SSD)

    SSD is a storage mechanism that also does not use any moving parts. Most SSD drives use flash storage, but other options are available for SSD.

    Nonvolatile Memory Express (NVMe)

    NVMe is a communications standard developed specially for SSDs by a consortium of vendors including Intel, Samsung, SanDisk, Dell, and Seagate. It operates across the PCIe bus (hence the “Express” in the name), which allows the drives to act more like the fast memory that they are rather than the hard disks they imitate (PCWorld).

    Narrow your focus with the right product type

    On-premises enterprise storage solutions fit into a few distinct product types.

    Network-Attached Storage

    Storage Area Network

    Software-Defined Storage

    Hyperconverged Infrastructure

    NAS refers to a storage device that is connected directly to your network. Any user or device with access to your network can access the available storage provided by the NAS. NAS storage is easily scalable and can add data redundancy through RAID technology. NAS uses the file storage format.

    NAS storage may or may not be the first choice in terms of enterprise storage, but it does have a solid market appeal as an on-premises primary backup storage solution.

    A SAN is a dedicated network of pooled storage devices. The dedicated network, separate from the regular network, provides high speed and scalability without concern for the regular network traffic. SANs use block storage format and can be divided into logical units that can be shared between servers or segregated from other servers. SANs can be accessed by multiple servers and systems at the same time. SANs are scalable and offer high availability and redundancy through RAID technology.

    SANs can use a variety of disk types and sizes and are quite common among on-premises storage solutions.

    “Software-defined storage (SDS) is a storage architecture that separates storage software from its hardware. Unlike traditional network-attached storage (NAS) or storage area network (SAN) systems, SDS is generally designed to perform on any industry-standard or x86 system, removing the software’s dependence on proprietary hardware.” (RedHat)

    SDS uses software-based policies and rules to grow and protect storage attached to applications.

    SDS allows you to use server-based storage products to add management, protection, and better usage.

    Hyperconverged storage uses virtualization and software-defined storage to combine the storage, compute, and network resources along with a hypervisor into one appliance.

    Hyperconverged storage can scale out by adding more nodes or appliances, but scaling up, or adding more resources to each appliance, can have limitations. There is flexibility as hyperconverged storage can work with most network and compute manufacturers.

    Cloud storage

    • Cloud storage is online storage offered by a cloud provider. Cloud storage is available almost anywhere and is set up with high availability features such as data duplication, redundancy, backup, and power failure protection.
    • Cloud storage is very scalable and typically is offered as object storage, block storage, or file storage. Cloud storage vendors may have their own naming scheme for object, block, or file storage.
    • Cloud-hosted data is marketed according to the frequency of access and length of time in storage. There are typically three main levels of storage: hot, warm, or cold. Vendors may have their own naming convention for hot, warm, and cold storage. Some may also add more layers such as very hot or very cold.
      • Hot storage is for data that is frequently accessed and modified. It is available on demand and is the most costly of the storage levels.
      • Cold storage is for data that will sit for a long period of time and not need to be accessed. Cold storage is usually only available after several hours or days. Cold storage is very low cost and, in some cases, even free, but retrieval or restoration for the free services can be costly.
      • Warm storage sits in between hot and cold storage. It is for data that is infrequently needed. The cost of warm storage is also in between hot and cold storage costs, and access times are measured in terms of minutes or hours.
      • It is not uncommon for data to start in hot storage and, as it ages, move to warm and eventually cold storage.

    “Enterprise cloud storage offers nearly unlimited scalability. Enterprises can add storage quickly and easily as it is needed, eliminating the risk and cost of over-provisioning.”

    – Spectrum Enterprise

    “Hot data will operate on fresh data. Cold data will operate on less frequent data and [is] used mainly for reporting and planning. Warm data is a balance between the two.”

    – TechBlost

    Enterprise storage features

    The features listed below, while not intended to cover all features offered by all vendors, should be considered and could act as a baseline for discussions with storage providers when evaluating enterprise storage offerings.

    • Scalability
      • What are the options to expand, and how easy or difficult it is to expand capacity in the future?
    • Security
      • Does the solution offer data encryption options as well as ransomware protections?
    • Integration options
      • Can the solution support seamless connectivity with other solutions and applications, such as cloud-based storage or backup software?
    • Storage reduction
      • Does the solution offer space-reduction options such as deduplication or data compression?
    • Replication
      • Does the solution offer replication options such as device to device on premises, device to device when geographically separated, device to cloud, or a combination of these scenarios?
    • Performance
      • “Enterprise storage systems have two main ‘speed’ measurements: throughput and IOPS. Throughput is the data transfer rate to and from storage media, measured in bytes per second; IOPS measures the number of reads and writes – input/output (I/O) operations – per second.” (Computer Weekly)
    • Protocol support
      • Does the solution support object-based, block-based, and file-based storage protocols?
    • Storage Efficiency
      • How efficient is the solution? Can they prove it?
      • Storage efficiencies must be available and baselined.
    • Management platform
      • A management/reporting platform should be a component included in the system.
    • Multi-parity
      • Does the solution offer multi-level block “parity” for RAID 6 protection equivalency, which would allow for the simultaneous failure of two disks?
    • Proactive support
      • Features such as call home, dial in, or remote support must be available on the system.
    • Financial considerations
      • The cost is always a concern, but are there subscription-based or “as-a-service” options?
      • Internally, is it better for this expenditure to be a capital expenditure or an ongoing operating expense?

    What’s new in enterprise storage

    • Data warehouses are not a new concept, but the data storage evolution and growth of data means that data lakes and data lakehouses are growing in popularity.
      • “A data lake is a centralized repository that allows you to store all your structured and unstructured data at any scale. You can store your data as-is, without having to first structure the data” (Amazon Web Services).
      • Analytics with a data lake is possible, but manipulation of the data is hindered due to the nature of the data. A data lakehouse adds data management and analytics to a data lake, similar to the data warehouse functionality added to databases.
    • Options for on-premises hardware support is changing.
      • Pure Storage was the first to shake up the SAN support model with its Evergreen support option. Evergreen//Forever support allows for storage controller upgrades without having to migrate data or replace your disks or chassis (Pure Storage).
      • In response to the Pure Storage Evergreen offering, Dell, HPE, NetApp, and others have come out with similar programs that offer controller upgrades while maintaining the data, disks, and chassis.
    • “As a service” is available as a hybrid solution.
      • Storage as a service (STaaS) originally referred to hosted, fully cloud-based offerings without the need for any on-premises hardware.
      • The latest STaaS offerings provide on-premises or colocated hardware with pay-as-you-go subscription pricing for data consumption. Administration, management, and support are included. The vendor will supply support and manage everything on your behalf.
      • Most of the major storage vendors offer a variation of storage as a service.

    “Because data lakes mostly consist of raw unprocessed data, a data scientist with specialized expertise is typically needed to manipulate and translate the data.”

    – DevIQ

    “A Lakehouse is also a type of centralized data repository, integrated from heterogeneous sources. As can be expected from its name, It shares features with both datawarehouses and data lakes.”

    – Cesare

    “Storage as a service (STaaS) eliminates Capex, simplifies management and offers extensive flexibility.”

    – TechTarget

    Major vendors

    The current vendor landscape for enterprise storage solutions represents a range of industry veterans and the brands they’ve aggregated along the way, as well as some relative newcomers who have come to the forefront within the past ten years.

    Vendors like Dell EMC and HPE are longstanding veterans of storage appliances with established offerings and a back catalogue of acquisitions fueling their growth. Others such as Pure Storage offer creative solutions like all-flash arrays, which are becoming more and more appealing as flash storage becomes more commoditized.

    Cloud-based vendors have become popular options in recent years. Cloud storage provides many options and has attracted many other vendors to provide a cloud option in addition to their on-premises solutions. Some software and hardware vendors also partner with cloud vendors to offer a complete solution that includes storage.

    Info-Tech Insight

    Explore your current vendor’s solutions as a starting point, then use that understanding as a reference point to dive into other players in the market

    Key Players

    • Amazon
    • Cisco
    • Dell EMC
    • Google
    • Hewlett Packard Enterprise
    • Hitachi Vantara
    • IBM
    • Microsoft
    • NetApp
    • Nutanix
    • Pure Storage

    Enterprise Storage Use Cases

    Block, object, or file storage? NAS, SAN, SDS, or HCI? Cloud or on prem? Hot, warm, or cold?
    Which one do you choose?
    The following use cases based on actual Info-Tech analyst calls may help you decide.

    1. Offsite backup solution
    2. Infrastructure consolidation
    3. DR/BCP datacenter duplication
    4. Expansion of existing storage
    5. Complete backup solution
    6. Existing storage solution going out of support soon
    7. Video storage
    8. Classify and offload storage

    Offsite backup solution

    “Offsite” may make you think of geographical separation or even cloud-based storage, but what is the best option and why?

    Use Case: How a manufacturing company dealt with retired applications

    • A leading manufacturing company had to preserve older applications no longer in use.
    • The company had completed several acquisitions and ended up with multiple legacy applications that had been merged or migrated into replacement solutions. These legacy applications were very important to the original companies, and although the data they held had been migrated to a replacement solution, executives felt they should hold on to these applications for a period of time, just in case.
    • A modern archiving solution was considered, but a research advisor from Info-Tech Research joined a call with the manufacturing company and helped the client realize that the solution was a modified backup. The application data had already been preserved through the migration, so data could be accessed in the production environment.
    • The data could be exported from the legacy application into a nonsequential database, compressed, and stored in cloud-based cold storage for less than $5 per terabyte per month. The manufacturing company staff realized that they could apply this same approach to several of their legacy applications and save tens of thousands of dollars in the process.
    • Cold storage is inexpensive until you start retrieving that data frequently. The manufacturing company knew they did not have a requirement to retrieve the application and data for a very long time, so cloud-based cold storage was ideal.

    “Data retrieval from cold storage is harder and slower than it is from hot storage. … Because of the longer retrieval time, online cold storage plans are often much cheaper. … The downside is that you’d incur additional costs when retrieving the data.”

    – Ben Stockton, Cloudwards

    Infrastructure consolidation

    Hyperconverged infrastructure combines storage, virtual infrastructure, and associated management into one piece of equipment.

    Use Case: How one company dealt with equipment and storage needs

    • One Info-Tech client had recently started in the role of IT director and realized he had inherited aging infrastructure along with a serious data challenge. The storage appliances were old and out of support. The appliances were performing inadequately, and the client was in need of more data due to ongoing growth, but he also realized that the virtual environment was running on very old servers that were no longer supported. The IT director reached out to Info-Tech to find solutions to the virtualization challenge, but the storage problem also came up throughout the course of the conversation with an analyst.
    • The analyst quickly realized that the IT director was an ideal candidate for a hyperconverged infrastructure (HCI) storage solution, which would also provide the necessary virtual environment.
    • The analyst explained the benefits of having a single appliance that would provide virtualization needs as well as storage needs. The built-in management features would ease the burden of administration, and the software-defined nature of the HCI would allow for the migration of data as well as future expansion options.
    • Hyperconverged infrastructure is offered by many vendors under a variety of names. Most are similar but some may have a better interface or other features. The expansion process is simple, and HCI is a good fit for many organizations looking to consolidate virtual infrastructure and storage.

    “HCI environments use a hypervisor, usually running on a server that uses direct-attached storage (DAS), to create a data center pool of systems and resources.”

    – Samuel Greengard, Datamation

    Datacenter duplication

    SAN providers offer a varied range of options for their products, and those options are constantly evolving.

    Use Case: Independent school district provides better data access using SAN technology

    • An independent school district was expanding by adding a second data center in a new school. This new data center would be approximately 20 miles away from the original data center used by the district. The intent was not to replace the original data center but to use both centers to store data and provide services concurrently. The district’s ideal scenario would be that users would not know or care which data center they were reaching, and there would be no difference in the service received from each data center. The school district reached out to Info-Tech when planning discussions reached the topic of data duplication and replication software.
    • An Info-Tech analyst joined a call with the school district and guided the conversation toward the existing environment to understand what options might be available. The analyst quickly discovered that all the district’s servers were virtual, and all associated data was stored on a single SAN.
    • The analyst informed the school district staff about SAN options, including SAN-to-SAN replication. If the school district had a sufficient link between the two data centers, SAN-to-SAN replication would work for them and provide the two identical copies of data at two locations.
    • The analyst continued to offer explanations of other features that some vendors offer with their SANs, such as the ability to turn on or off deduplication and compression, as well as disk options such as flash or NVMe.
    • The school district was moving to the request for proposal (RFP) stage but hoped to have SAN-to-SAN replication implemented before the next academic year started.

    “SAN-to-SAN replication is a low-cost, highly efficient way to manage mounting quantities of stored data.”

    – Secure Infrastructure & Services

    Expansion of existing storage

    That old storage area network may still have some useful life left in it.

    Use Case: Municipality solves data storage aging and growth challenge

    • A municipality in the United States reached out to Info-Tech for guidance on its storage challenge. The municipality had accumulated multiple SANs from different vendors over the years. These SANs were running out of storage, and more data storage was needed. The municipality’s data was growing at a rapid pace, thanks to municipal growth and expansion of services. The IT team was also concerned with modernizing their storage and not hindering their long-term growth by making the wrong purchase decision for their current storage needs.
    • An analyst from Info-Tech discussed several options with the municipality but in the end advised that software-defined storage may be the best solution.
    • Software-defined storage (SDS) would allow the municipality to gain better visibility into existing storage while making more efficient use of existing and new storage. SDS could take over the management of the existing storage from multiple vendors and add additional storage as required. SDS would also be able to integrate cloud-based storage if that was the direction taken by the municipality in the future.
    • The municipality moved forward with an SDS solution and added some additional storage capacity. They used some of their existing SANs but retired the more troublesome ones. The SDS system managed all the storage instances and data management. The administration of the storage environment was easier for the storage admins, and long-term savings were achieved through better storage management.

    “Often enterprises have added storage on an ad hoc basis as they needed it for various applications. That can result in a mishmash of heterogenous storage hardware from a wide variety of vendors. SDS offers the ability to unify management of these different storage devices, allowing IT to be more efficient.”

    – Cynthia Harvey, Enterprise Storage Forum (“What Is Software Defined Storage?”, 2018)

    Complete backup solution

    Many backup software solutions can provide backups to multiple locations, making two-location backups simple.

    Use Case: How an oil refinery modernized its backup solution

    • A large oil refinery needed a better solution for the storage of backups. The refinery was replacing its backup software solution but also wanted to improve the backup storage situation and move away from tape-based storage. All other infrastructure was reasonably modern and not in need of replacement at this time.
    • A research analyst from Info-Tech helped the client realize that the solution was a modified backup. The general guidance for backups is have a least one copy offsite, so the cloud was the obvious focal point. The analyst also explained that it would be beneficial to have a recent copy of the backup available on site for common restoration requests in addition to having the offsite copy for disaster recovery (DR) purposes.
    • The refinery staff conducted a data analysis to determine how much data was being backed up on a daily basis. The solution proposed by the analyst included network-attached storage (NAS) with adequate storage to hold 30 days' worth of on-premises data. The backup software would also simultaneously copy each backup to a cloud-based storage repository. The backup software was smart enough to only back up and transfer data that had changed since the previous backup, so transfer time and capacity was not a factor.
    • The NAS would allow for the restoration of any local, on-premises data while the cloud storage would provide a safe location offsite for backup data. It could also serve as the backup location for other cloud-based services that required a backup.

    “Data protection demands that enterprises have multiple methods of keeping data safe and replicating it in case of disaster or loss.”

    – Drew Robb, Enterprise Storage Forum, 2021

    Storage going out of support

    SAN solutions have come a long way with improvements in how data is stored and what is used to store the data.

    Use Case: How one organization replaced its old storage with a similar solution

    • A government organization was looking for a solution for its aging storage area network appliances. The SANs were old and would be no longer supported by the manufacturer within four months. The SANs had slower spinning disks and their individual capacity was at its limit through the addition of extra shelves and disks over the years.
    • The organization reached out to Info-Tech for guidance. An analyst arranged a call with them, and they discussed the storage situation in detail, including desired benefits from a storage solution and growth requirements. They also discussed cloud storage, but the government organization was not in a position to move its data to the cloud for a variety of reasons.
    • Although the individual SANs were at their storage capacity limit, the total amount of data was well within the limits of many modern on-premises storage solutions. SSD and flash or NVMe storage can store large amounts of data in small footprints and form factors.
    • The analyst reviewed several vendors with the client and discussed some advantages and disadvantages of each. They explored the features offered as well as scalability options.
    • SANs have been around for a long time but the features and capabilities that come with them has evolved. They are still a very viable solution for many organizations in a variety of scenarios.

    “A rapidly growing portion of SAN deployments leverages all-flash storage to gain its high performance, consistent low latency, and lower total cost when compared to spinning disk.”

    – NetApp

    Video storage

    Cloud storage would not be sufficient if you were using a dial up connection, just as on-premises storage solutions would not suffice if they were using floppy disks.

    Use Case: Body cams and public cameras in municipalities are driving storage growth

    • Municipal law enforcement agencies are wearing body cameras more frequently, for their own protection as well as for the protection of the public. Camera footage can be useful in legal situations as well. Municipalities are also installing more and more public cameras for the purposes of public safety. The recorded video footage from these cameras can result in large data files, which in turn drive data storage requirements.
    • Info-Tech analysts are joining calls about video data storage with increasing frequency. The concerns are repetitive, and the guidance is similar on most of these calls.
    • The “object” storage format is ideal for video and media data. Most cloud-based storage solutions use object storage, but it is also available with on-premises solutions such as NAS or SAN. The challenges clients are expressing are typically related to inadequate bandwidth for cloud-based storage or other storage formats instead of “object” storage. Cloud-based storage can also grow beyond the budgeted numbers, causing an increase in the monthly cloud cost. Older, slower on-premises hardware sometimes reveals itself as the latency culprit.
    • Object storage is well suited for the unstructured data that is video footage. It uses metadata to tag the video file for future retrieval and is easily expandable, which also makes it cost effective.
    • Video data stored in a cloud-based repository will work fine as long as the bandwidth is adequate. On-premises storage of video data is also quite adequate on the right storage format, with fast disks and a reasonably up-to-date network infrastructure.

    “The captured video is stored for days, weeks, months and sometimes years and consumes a lot of space. Data storage plays a new and important role in these systems. Object storage is ideal to store the video data.”

    – Object-Storage.Info

    Classify and offload primary storage

    Some software products have storage options available as a result of agreements with other storage vendors. Several backup and archive software products fall into this category.

    Use Case: Enterprise storage can help reduce data sprawl

    • A large engineering firm was trying to manage its data sprawl. The team sampled a small percentage of their data and quickly realized that when they applied their findings on the 1% of data to their entire data estate, the sheer volume of personal files, older files, and unclassified data was going to be a challenge.
    • They found a solution in archiving software. The archiving software would tag data based on several factors. The software would move older files away from primary storage to an alternate storage platform but still leave a stub of the moved file in place and maintain limited access to those files. This would reduce primary storage requirements and allow the firm to eliminate multiple file servers
    • The engineering firm reached out to Info-Tech and participated in an analyst call. During that call, they laid out their plans, and the analyst made them aware of cloud storage. The positive and negative aspects of cloud storage were discussed, and the firm fully understood that the colder the storage tier, the slower the recovery. The firm's stance was if the files had not been accessed in the past six months, waiting a day or two for retrieval would not be a concern, and the firm was content with cold storage in the cloud.
    • The firm had not purchased the archiving software at the time of the analyst call, and the analyst also explained to them that the archiving software may have an existing agreement with a cloud provider for storage options, which could be more cost effective than purchasing cloud storage separately.
    • Cold cloud-based storage was the preferred solution for this firm, but this use case also highlights the option that some software products carry regarding storage. Several backup and archive products have a cloud storage option that should be investigated, as they may be cost-effective options.

    “Cold storage is perfect for archiving your data. Online backup providers offer low-cost, off-site data backups at the expense of fast speeds and easy access, even though data retrieval often comes at an added cost. If you need to keep your data long-term, but don’t need to access it often, this is the kind of storage you need.”

    – Ben Stockton, Cloudwards

    Understand your data requirements

    Activity

    The first step in solving your enterprise storage challenge is identifying your data sources or drivers, data volume size, and growth rates. This information will give you insight into what data sources could be stored on premises or in the cloud, how much storage you will require for the coming five to ten years, and what to consider when exploring enterprise storage solutions.

    • Info-Tech’s Modernize Enterprise Storage Workbook can be a valuable asset for determining your current storage drivers and future storage needs, structuring a plan for future storage purchases, and determining timelines and total cost of ownership.
    • An example of the Storage Capacity Calculator tab from that workbook is displayed on the right. Using the Storage Capacity Requirements Calculator requires minimal steps.
    1. Enter the current date and planning timeline (horizon) in months
    2. Identify the top sources of data within the business – the current data drivers. Areas of focus could include business applications, file shares, backup, and archives.
    3. For each of these data drivers, include your best estimate of:
    • Current data volume
    • Growth rate
  • Identify the top future data drivers, such as new applications or initiatives that will result from current business plans and priorities, and record the following details:
    • Initial data volumes
    • Projected growth rates
    • Planned implementation date
  • The spreadsheet will automatically calculate the data volume at the planning horizon based on the growth rate.
  • Download the Modernize Enterprise Storage Workbook and take the first step toward understanding your data requirements.

    The image contains a screenshot of the Modernize Enterprise Storage Workbook.

    Download the Modernize Enterprise Storage Workbook

    Related Info-Tech Research

    Modernize Enterprise Storage

    Current and emerging storage technologies are disrupting the status quo – prepare your infrastructure for the exponential rise in data and its storage requirements.

    Modernize Enterprise Storage Workbook

    This workbook will complement the discussions and activities found in the Modernize Enterprise Storage blueprint. Use this workbook in conjunction with the blueprint to develop a strategy for storage modernization.

    Bibliography

    Bakkianathan, Raghunathan. “What is the difference between Hot Warm and Cold data storage?” TechBlost, n.d.. Accessed 14 July 2022.
    Cesare. “Data warehouse vs Data lake vs Lakehouse… and DeltaLake?“ Medium, 14 June 2021. Accessed 26 July 2022.
    Davison, Shawn and Ryan Sappenfield. “Data Lake Vs Lakehouse Vs Data Mesh: The Evolution of Data Transformation.” DevIQ, May 2022. Accessed 23 July 2022.
    Desjardins, Jeff. “Infographic: How Much Data is Generated Each Day?” Visual Capitalist, 15 April 2019. Accessed 26 July 2022.
    Greengard, Samuel. “Top 10 Hyperconverged Infrastructure (HCI) Solutions.” Datamation, 22 December 2020. Accessed 23 July 2022.
    Harvey, Cynthia. “Flash vs. SSD Storage: Is there a Difference?” Enterprise Storage Forum, 10 July 2018. Accessed 23 July 2022.
    Harvey, Cynthia. “What Is Software Defined Storage? Features & Benefits.” Enterprise Storage Forum, 22 February 2018. Accessed 23 July 2022.
    Hecht, Gil. “4 Predictions for storage and backup security in 2022.” Continuity Software, 09 January 2022. Accessed 22 July 2022.
    Jacobi, Jonl. “NVMe SSDs: Everything you need to know about this insanely fast storage.” PCWorld, 10 March 2019. Accessed 22 July 2022
    Pritchard, Stephen. “Briefing: Cloud storage performance metrics.” Computer Weekly, 16 July 2021. Accessed 23 July 2022
    Robb, Drew. “Best Enterprise Backup Software & Solutions 2022.” Enterprise Storage Forum, 09 April 2021. Accessed 23 July 2022.
    Sheldon, Robert. “On-premises STaaS shifts storage buying to Opex model.” TechTarget, 10 August 2020. Accessed 22 July 2022.
    “Simplify Your Storage Ownership, Forever.” PureStorage. Accessed 20 July 2022.
    Stockton, Ben. “Hot Storage vs Cold Storage in 2022: Instant Access vs Long-Term Archives.” Cloudwards, 29 September 2021. Accessed 22 July 2022.
    “The Cost Savings of SAN-to-SAN Replication.” Secure Infrastructure and Services, 31 March 2016. Accessed 16 July 2022.
    “Video Surveillance.” Object-Storage.Info, 18 December 2019. Accessed 25 July 2022.
    “What is a Data Lake?” Amazon Web Services, n.d. Accessed 17 July 2022.
    “What is enterprise cloud storage?” Spectrum Enterprise, n.d. Accessed 28 July 2022.
    “What is SAN (Storage Area Network).” NetApp, n.d. Accessed 25 July 2022.
    “What is software-defined storage?” RedHat, 08 March 2018. Accessed 16 July 2022.

    Develop a Project Portfolio Management Strategy

    • Buy Link or Shortcode: {j2store}331|cart{/j2store}
    • member rating overall impact: 9.4/10 Overall Impact
    • member rating average dollars saved: $111,064 Average $ Saved
    • member rating average days saved: 33 Average Days Saved
    • Parent Category Name: Project Management Office
    • Parent Category Link: /project-management-office
    • As an IT leader, you oversee a project environment in which the organizational demand for new products, services, and enhancements far outweighs IT’s resource capacity to adequately deliver on everything.
    • As a result, project throughput suffers. IT starts a lot of projects, but has constant difficulties delivering the bulk of them on time, on budget, in scope, and of high quality. What’s more, many of the projects that consume IT’s time are of questionable value to the business.
    • You need a project portfolio management (PPM) strategy to help bring order to IT’s project activity. With the right PPM strategy, you can ensure that you’re driving the throughput of the best projects and maximizing stakeholder satisfaction with IT.

    Our Advice

    Critical Insight

    • IT leaders commonly conflate PPM and project management, falsely believing that they already have a PPM strategy via their project management playbook. While the tactical focus of project management can help ensure that individual projects are effectively planned, executed, and closed, it is no supplement for the insight into “the big picture” that a PPM strategy can provide.
    • Many organizations falter at PPM by mistaking a set of processes for a strategy. While processes are no doubt important, without an end in mind – such as that provided by a deliberate strategy – they inevitably devolve into inertia or confusion.
    • Executive layer buy-in is a critical prerequisite for the success of a PPM strategy. Without it, any efforts to reconcile supply and demand, and improve the strategic value of IT’s project activity, could be quashed by irresponsible, non-compliant stakeholders.

    Impact and Result

    • Manage the portfolio as more than just the sum of its parts. Create a coherent strategy to maximize the sum of values that projects deliver as a whole – as a project portfolio, rather than a collection of individual projects.
    • Get to value early. Info-Tech’s methodology tackles one of PPM’s most pressing challenges upfront by helping you to articulate a strategy and get executive buy-in for it before you define your process goals. When senior management understands why a PPM strategy is necessary and of value to them, the path to implementation is much more stable.
    • Create PPM processes you can sustain. Translate your PPM strategy into specific, tangible near-term and long-term goals, which are realized through a suite of project portfolio management processes tailored to your organization and its culture.

    Develop a Project Portfolio Management Strategy Research & Tools

    Start here – read the Executive Brief

    Read our concise Executive Brief to find out why you should develop a project portfolio management strategy, review Info-Tech’s methodology, and understand the four ways we can support you in completing this project.

    Besides the small introduction, subscribers and consulting clients within this management domain have access to:

    • Develop a Project Portfolio Management Strategy – Executive Brief
    • Develop a Project Portfolio Management Strategy – Phases 1-3

    1. Get executive buy-in for your PPM strategy

    Choose the right PPM strategy for your organization and get executive buy-in before you start to set PPM process goals.

    • Develop a Project Portfolio Management Strategy – Phase 1: Get Executive Buy-In for Your PPM Strategy
    • PPM High-Level Supply-Demand Calculator
    • PPM Strategic Plan Template
    • PPM Strategy-Process Goals Translation Matrix Template

    2. Align PPM processes to your strategic goals

    Use the advice and tools in this phase to align the PPM processes that make up the infrastructure around projects with your new PPM strategy.

    • Develop a Project Portfolio Management Strategy – Phase 2: Align PPM Processes to Your Strategic Goals
    • PPM Strategy Development Tool

    3. Complete your PPM strategic plan

    Refine your PPM strategic plan with inputs from the previous phases by adding a cost-benefit analysis and PPM tool recommendation.

    • Develop a Project Portfolio Management Strategy – Phase 3: Complete Your PPM Strategic Plan
    • Project Portfolio Analyst / PMO Analyst
    [infographic]

    Workshop: Develop a Project Portfolio Management Strategy

    Workshops offer an easy way to accelerate your project. If you are unable to do the project yourself, and a Guided Implementation isn't enough, we offer low-cost delivery of our project workshops. We take you through every phase of your project and ensure that you have a roadmap in place to complete your project successfully.

    1 Get Executive Buy-In for Your PPM Strategy

    The Purpose

    Choose the right PPM strategy for your organization and ensure executive buy-in.

    Set process goals to address PPM strategic expectations and steer the PPM strategic plan.

    Key Benefits Achieved

    A right-sized PPM strategy complete with executive buy-in for it.

    A prioritized list of PPM process goals.

    Activities

    1.1 Assess leadership mandate.

    1.2 Determine potential resource capacity.

    1.3 Create a project inventory.

    1.4 Prepare to communicate your PPM strategy to key stakeholders.

    1.5 Translate each strategic goal into process goals.

    1.6 Set metrics and preliminary targets for PPM process goals.

    Outputs

    Choice of PPM strategy and the leadership mandate

    Analysis of current project capacity

    Analysis of current project demand

    PPM Strategic Plan – Executive Brief

    PPM strategy-aligned process goals

    Metrics and long-term targets for PPM process goals

    2 Align PPM Processes to Your Strategic Goals

    The Purpose

    Examine your current-state PPM processes and create a high-level description of the target-state process for each of the five PPM processes within Info-Tech’s PPM framework.

    Build a sound business case for implementing the new PPM strategy by documenting roles and responsibilities for key PPM activities as well as the time costs associated with them.

    Key Benefits Achieved

    Near-term and long-term goals as well as an organizationally specific wireframe for your PPM processes.

    Time cost assumptions for your proposed processes to ensure sustainability.

    Activities

    2.1 Develop and refine the project intake, prioritization, and approval process.

    2.2 Develop and refine the resource management process.

    2.3 Develop and refine the portfolio reporting process.

    2.4 Develop and refine the project closure process

    2.5 Develop and refine the benefits realization process.

    Outputs

    Process capability level

    Current-state PPM process description

    Retrospective examination of the current-state PPM process

    Action items to achieve the target states

    Time cost of the process at current and target states

    3 Complete Your PPM Strategic Plan

    The Purpose

    Perform a PPM tool analysis in order to determine the right tool to support your processes.

    Estimate the total cost-in-use of managing the project portfolio, as well as the estimated benefits of an optimized PPM strategy.

    Key Benefits Achieved

    A right-sized tool selection to help support your PPM strategy.

    A PPM strategy cost-benefit analysis.

    Activities

    3.1 Right-size the PPM tools for your processes.

    3.2 Conduct a cost-benefit analysis of implementing the new PPM strategy.

    3.3 Define roles and responsibilities for the new processes.

    3.4 Refine and consolidate the near-term action items into a cohesive plan.

    Outputs

    Recommendation for a PPM tool

    Cost-benefit analysis

    Roles and responsibilities matrix for each PPM process

    An implementation timeline for your PPM strategy

    Further reading

    Develop a Project Portfolio Management Strategy

    Drive IT project throughput by throttling resource capacity.

    Analyst Perspective

    “Tactics without strategy is the noise before defeat.” – Sun Tzŭ

    "Organizations typically come to project portfolio management (PPM) with at least one of two misconceptions: (1) that PPM is synonymous with project management and (2) that a collection of PPM processes constitutes a PPM strategy.

    Both foundations are faulty: project management and PPM are separate disciplines with distinct goals and processes, and a set of processes do not comprise a strategy – they should flow from a strategy, not precede one. When built upon these foundations, the benefits of PPM go unrealized, as the means (i.e. project and portfolio processes) commonly eclipse the ends of a PPM strategy – e.g. a portfolio better aligned with business goals, improved project throughput, increased stakeholder satisfaction, and so on.

    Start with the end in mind: articulate a PPM strategy that is truly project portfolio in nature, i.e. focused on the whole portfolio and not just the individual parts. Then, let your PPM strategy guide your process goals and help to drive successful outcomes, project after project." (Barry Cousins, Senior Director of Research, PMO Practice, Info-Tech Research Group)

    Our understanding of the problem

    This Research Is Designed For:

    • CIOs who want to maximize IT’s fulfillment of both business strategic goals and operational needs.
    • CIOs who want to better manage the business and project sponsors’ expectations and satisfaction.
    • CIOs, PMO directors, and portfolio managers who want a strategy to set the best projects for the highest chance of success.

    This Research Will Help You:

    • Get C-level buy-in on a strategy for managing the project portfolio and clarify their expectations on how it should be managed.
    • Draft strategy-aligned, high-level project portfolio management process description.
    • Put together a strategic plan for improving PPM processes to reclaim wasted project capacity and increase business satisfaction of IT.

    This Research Will Also Assist:

    • Steering committee and C-suite management who want to maximize IT’s value to business.
    • Project sponsors who seek clarity and fairness on pushing their projects through a myriad of priorities and objectives.
    • CIOs, PMO directors, and portfolio managers who want to enable data-driven decisions from the portfolio owners.

    This Research Will Help Them:

    • Optimize IT’s added value to the business through project delivery.
    • Provide clarity on how IT’s project portfolio should be managed and the expectations for its management.
    • Improve project portfolio visibility by making trustworthy project portfolio data available, with which to steer the portfolio.

    Executive Summary

    Situation

    • As CIO, there are too many projects and not enough resource capacity to deliver projects on time, on budget, and in scope with high quality.
    • Prioritizing projects against one another is difficult in the face of conflicting priorities and agenda; therefore, projects with dubious value/benefits consume resource capacity.

    Complication

    • Not all IT projects carry a direct value to business; IT is accountable for keeping the lights on and it consumes a significant amount of resources.
    • Business and project sponsors approve projects without considering the scarcity of resource capacity and are frustrated when the projects fail to deliver or linger in the backlog.

    Resolution

    • Create a coherent strategy to maximize the total value that projects deliver as a whole portfolio, rather than a collection of individual projects.
    • Ensure that the steering committee or senior executive layer buys into the strategy by helping them understand why the said strategy is necessary, and more importantly, why the strategy is valuable to them.
    • Translate the strategic expectations to specific, tangible goals, which are realized through a suite of project portfolio management processes tailored to your organization and its culture.
    • Putting into place people, processes, and tools that are sustainable and manageable, plus a communication strategy to maintain the stakeholder buy-in.

    Info-Tech Insight

    1. Time is money; therefore, the portfolio manager is an accountant of time. It is the portfolio manager’s responsibility to provide the project portfolio owners with reliable data and close the loop on portfolio decisions.
    2. Business satisfaction is driven by delivering projects that align to and maximize business value. Use Info-Tech’s method for developing a PPM strategy and synchronize its definition of “best projects” with yours.

    Projects that deliver on strategic goals of the business is the #1 driver of business satisfaction for IT

    Info-Tech’s CIO Business Vision Survey (N=21,367) has identified a direct correlation between IT project success and overall business satisfaction with IT.

    Comparative rankings of IT services in two columns 'Reported Importance' and 'Actual Importance' with arrows showing where each service moved to in the 'Actual Importance' ranking. The highlighted move is 'Projects' from number 10 in 'Reported' to number 1 in 'Actual'. 'Reported' rankings from 1 to 12 are 'Network Infrastructure', 'Service Desk', 'Business Applications', 'Data Quality', Devices', 'Analytical Capability', 'Client-Facing Technology', 'Work Orders', 'Innovation Leadership', 'Projects', 'IT Policies', and 'Requirements Gathering'. 'Actual' rankings from 1 to 12 are 'Projects', 'Work Orders', 'Innovation Leadership', 'Business Applications', 'Requirements Gathering', 'Service Desk', 'Client-Facing Technology', 'Network Infrastructure', 'Analytical Capability', 'Data Quality', 'IT Policies', and 'Devices'.

    Reported Importance: Initially, when CIOs were asked to rank the importance of IT services, respondents ranked “projects” low on the list – 10 out of a possible 12.

    Actual Importance: Despite this low “reported importance,” of those organizations that were “satisfied” to “fully satisfied” with IT, the service that had the strongest correlation to high business satisfaction was “projects,” i.e. IT’s ability to help plan, support, and execute projects and initiatives that help the business achieve its strategic goals.

    On average, executives perceive IT as being poorly aligned with business strategy

    Info-Tech’s CIO Business Vision Survey data highlights the importance of IT projects in supporting the business achieve its strategic goals. However, Info-Tech’s CEO-CIO Alignment Survey (N=124) data indicates that CEOs perceive IT to be poorly aligned to business’ strategic goals:

    • 43% of CEOs believe that business goals are going unsupported by IT.
    • 60% of CEOs believe that improvement is required around IT’s understanding of business goals.
    • 80% of CIOs/CEOs are misaligned on the target role for IT.
    • 30% of business stakeholders* are supporters of their IT departments.
    • (Source: Info-Tech CIO/CEO Alignment Diagnostics, * N=32,536)

    Efforts to deliver on projects are largely hampered by causes of project failure outside a project manager’s control

    The most recent data from the Project Management Institute (PMI) shows that more projects are meeting their original goals and business intent and less projects are being deemed failures. However, at the same time, more projects are experiencing scope creep. Scope creeps result in schedule and cost overrun, which result in dissatisfied project sponsors, stakeholders, and project workers.

    Graph of data from Project Management Institute comparing projects from 2015 to 2017 that 'Met original goals/business intent', 'Experienced scope creep', and were 'Deemed failures'. Projects from the first two categories went up in 2017, while projects that were deemed failures went down.

    Meanwhile, the primary causes of project failures remain largely unchanged. Interestingly, most of these primary causes can be traced to sources outside of a project manager’s control, either entirely or in part. As a result, project management tactics and processes are limited in adequately addressing them.

    Relative rank

    Primary cause of project failure

    2015

    2016

    2017

    Trend

    Change in organization's priorities 1st 1st 1st Stable
    Inaccurate requirements gathering 2nd 3rd 2nd Stable
    Change in project objectives 3rd 2nd 3rd Stable
    Inadequate vision/goal for project 6th 5th 4th Rising
    Inadequate/poor communication 5th 7th 5th Stable
    Poor change management 11th 9th 6th Rising
    (Source: Project Management Institute, Pulse of the Profession, 2015-2017)

    Project portfolio management (PPM) can improve business alignment of projects and reduce chance of project failure

    PPM is about “doing the right things.”

    The PMI describes PPM as:

    Interrelated organizational processes by which an organization evaluates, selects, prioritizes, and allocates its limited internal resources to best accomplish organizational strategies consistent with its vision, mission, and values. (PMI, Standard for Portfolio Management, 3rd ed.)

    Selecting and prioritizing projects with the strongest alignment to business strategy goals and ensuring that resources are properly allocated to deliver them, enable IT to:

    1. Improve business satisfaction and their perception of IT’s alignment with the business.
    2. Better engage the business and the project customers.
    3. Minimize the risk of project failure due to changing organizational/ project vision, goals, and objectives.

    "In today’s competitive business environment, a portfolio management process improves the linkage between corporate strategy and the selection of the ‘right’ projects for investment. It also provides focus, helping to ensure the most efficient and effective use of available resources." (Lou Pack, PMP, Senior VP, ICF International (PMI, 2015))

    PPM is a common area of shortcomings for IT, with much room for improvement

    Info-Tech’s IT Management & Governance Survey (N=879) shows that PPM tends to be regarded as neither an effective nor an important process amongst IT organizations.

    Two deviation from median charts highlighting Portfolio Management's ranking compared to other IT processes in 'Effectiveness scores' and 'Importance scores'. PPM ranks 37th out of 45 in Effectiveness and 33rd out of 45 in Importance.

    55% ... of IT organizations believe that their PPM processes are neither effective nor important.

    21% ... of IT organizations reported having no one responsible or accountable for PPM.

    62% ... of projects in organizations effective in PPM met/exceeded the expected ROI (PMI, 2015).

    In addition to PPM’s benefits, improving PPM processes presents an opportunity for getting ahead of the curve in the industry.

    Info-Tech’s methodology for developing a PPM strategy delivers extraordinary value, fast

    Our methodology is designed to tackle your hardest challenge first to deliver the highest-value part of the deliverable. For developing a PPM strategy, the biggest challenge is to get the buy-in of the executive layer.

    "Without senior management participation, PPM doesn’t work, and the organization is likely to end up with, or return to, a squeaky-wheel-gets-the-grease mindset for all those involved." (Mark Price Perry, Business Driven Project Portfolio Management)

    In the first step of the blueprint, you will be guided through the following steps:

    1. Choose the right PPM strategy: driven by the executives, supported by management.
    2. Objectively assess your current project portfolio with minimal effort to build a case for the PPM strategy.
    3. Engage the executive layer to get the critical prerequisite of a PPM strategy: their buy-in.

    A PPM strategic plan is the end deliverable of this blueprint. In the first step, download the pre-filled template with content that represents the most common case. Then, throughout the blueprint, customize with your data.

    Use this blueprint to develop, or refine, a PPM strategy that works for your organization

    Get buy-in for PPM strategy from decision makers.

    Buy-in from the owners of project portfolio (Steering Committee, C-suite management, etc.) is a critical prerequisite for any PPM strategy. This blueprint will give you the tools and templates to help you make your case and win the buy-in of portfolio owners.

    Connect strategic expectations to PPM process goals.

    This blueprint offers a methodology to translate the broad aim of PPM to practical, tactical goals of the five core PPM processes, as well as how to measure the results. Our methodology is supported with industry-leading frameworks, best practices, and our insider research.

    Develop your PPM processes.

    This blueprint takes you through a series of steps to translate the process goals into a high-level process description, as well as a business case and a roadmap for implementing the new PPM processes.

    Refine your PPM processes.

    Our methodology is also equally as applicable for making your existing PPM processes better, and help you draft a roadmap for improvement with well-defined goals, roles, and responsibilities.

    Info-Tech’s PPM model consists of five core processes

    There are five core processes in Info-Tech’s thought model for PPM.

    Info-Tech's Process Model detailing the steps and their importance in project portfolio management. Step 3: 'Status and Progress Reporting' sits above the others as a process of importance throughout the model. In the 'Intake' phase of the model are Step 1: 'Intake, Approval, and Prioritization' and Step 2: 'Resource Management'. In the 'Execution' phase is 'Project Management', the main highlighted section, and a part of Step 3, the overarching 'Status and Progress Reporting'. In the 'Closure' phase of the model are Step 4: 'Project Closure' and Step 5: 'Benefits Tracking'.

    These processes create an infrastructure around projects, which aims to enable:

    1. Initiation of the “best” projects with the right resources and project information.
    2. Timely and trustworthy reporting to facilitate the flow of information for better decision making.
    3. Proper closure of projects, releasing resources, and managing benefits realization.

    PPM has many moving pieces. To ensure that all of these processes work in harmony, you need a PPM strategy.

    De-couple project management from PPM to break down complexity and create flexibility

    Tailor project management (PM) processes to fit your projects.

    Info-Tech’s PPM thought model enables you to manage your project portfolio independent of your PM methodology or capability. Projects interact with PPM via:

    • A project charter that authorizes the use of resources and defines project benefits.
    • Status reports that feed up-to-date, trustworthy data to your project portfolio.
    • Acceptance of deliverables that enable proper project closure and benefits reporting.

    Info-Tech’s PPM strategy is applicable whether you use Agile, waterfall, or anything in between for PM.

    The process model from the previous page but with project management processes overlaid. The 'Intake' phase is covered by 'Project Charter'. The 'Execution' phase, or 'Project Management' is covered by 'Status report'. The 'Closure' phase is covered by 'Deliverable Acceptance'.

    Learn about project management approach for small projects in Info-Tech’s Tailor PM Processes to Fit Your Projects blueprint.

    Sample of the Info-Tech blueprint 'Tailor PM Processes to Fit Your Projects'.

    Info-Tech’s approach to PPM is informed by industry best practices and rooted in practical insider research

    Info-Tech uses PMI and ISACA frameworks for areas of this research.

    Logo for 'Project Management Institute (PMI)'.' Logo for 'COBIT 5 an ISACA Framework'.
    PMI’s Standard for Portfolio Management, 3rd ed. is the leading industry framework, proving project portfolio management best practices and process guidelines. COBIT 5 is the leading framework for the governance and management of enterprise IT.

    In addition to industry-leading frameworks, our best-practice approach is enhanced by the insights and guidance from our analysts, industry experts, and our clients.

    Logo for 'Info-Tech Research Group'.

    33,000+ Our peer network of over 33,000 happy clients proves the effectiveness of our research.

    1000+ Our team conducts 1,000+ hours of primary and secondary research to ensure that our approach is enhanced by best practices.

    Re-position IT as the “facilitator of business projects” for PPM success

    CASE STUDY

    Industry: Construction
    Source: Info-Tech Client

    Chaos in the project portfolio

    At first, there were no less than 14 teams of developers, each with their own methodologies and processes. Changes to projects were not managed. Only 35% of the projects were completed on time.

    Business drives, IT facilitates

    Anyone had the right to ask for something; however, converting ideas to a formal project demand required senior leadership within a business division getting on board with the idea.

    The CIO and senior leadership decided that projects, previously assigned to IT, were to be owned and driven by the business, as the projects are undertaken to serve its needs and rarely IT’s own. The rest of the organization understood that the business, not IT, was accountable for prioritizing project work: IT was re-positioned as a facilitator of business projects. While it was a long process, the result speaks for itself: 75% of projects were now being completed on time.

    Balancing the target mix of the project portfolio

    What about maintaining and feeding the IT infrastructure? The CIO reserved 40% of IT project capacity for “keeping the lights on,” and 20% for reactive, unplanned activities, with an aim to lower this percentage. With the rest of the time, IT facilitated business projects

    Three key drivers of project priority

    1. Does the project meet the overall company goals and objectives?
      “If they don't, we must ask why we are bothering with it.”
    2. Does the project address a regulatory or compliance need?
      “Half of our business is heavily regulated. We must focus on it.”
    3. Are there significant savings to be had?
      “Not soft; hard savings. Can we demonstrate that, after implementing this, can we see good hard results? And, can we measure it?”

    "Projects are dumped on IT, and the business abdicates responsibility. Flip that over, and say ‘that's your project’ and ‘how can we help you?’"

    Use these icons to help direct you as you navigate this research

    Use these icons to help guide you through each step of the blueprint and direct you to content related to the recommended activities.

    A small monochrome icon of a wrench and screwdriver creating an X.

    This icon denotes a slide where a supporting Info-Tech tool or template will help you perform the activity or step associated with the slide. Refer to the supporting tool or template to get the best results and proceed to the next step of the project.

    A small monochrome icon depicting a person in front of a blank slide.

    This icon denotes a slide with an associated activity. The activity can be performed either as part of your project or with the support of Info-Tech team members, who will come onsite to facilitate a workshop for your organization.

    Info-Tech offers various levels of support to best suit your needs

    DIY Toolkit

    Guided Implementation

    Workshop

    Consulting

    "Our team has already made this critical project a priority, and we have the time and capability, but some guidance along the way would be helpful." "Our team knows that we need to fix a process, but we need assistance to determine where to focus. Some check-ins along the way would help keep us on track." "We need to hit the ground running and get this project kicked off immediately. Our team has the ability to take this over once we get a framework and strategy in place." "Our team does not have the time or the knowledge to take this project on. We need assistance through the entirety of this project."

    Diagnostics and consistent frameworks used throughout all four options

    Develop a PPM strategy – project overview

    1. Get executive buy-in for your PPM strategy

    2. Align PPM processes to your strategic goals

    3. Complete your PPM strategic plan

    Supporting Tool icon

    Best-Practice Toolkit

    1.1 Choose the right PPM strategy for your organization

    1.2 Translate PPM strategy expectations to specific process goals

    2.1 Develop and refine project intake, prioritization, and resource management processes

    2.2 Develop and refine portfolio reporting, project closure, and benefits realization processes

    3.1 Select a right-sized PPM solution for supporting your new processes

    3.2 Finalize customizing your PPM Strategic Plan Template

    Guided Implementations

    • Scoping call: discuss current state of PPM and review strategy options.
    • How to wireframe realistic process goals, rooted in your PPM strategic expectations, that will be sustained by the organization.
    • Examine your current-state PPM process and create a high-level description of the target-state process for each of the five PPM processes (1-2 calls per each process).
    • Assess your PPM tool requirements to help support your processes.
    • Determine the costs and potential benefits of your PPM practice.
    Associated Activity icon

    Onsite Workshop

    Module 1:
    Set strategic expectations and realistic goals for the PPM strategy
    Module 2:
    Develop and refine strategy-aligned PPM processes
    Module 3:
    Compose your PPM strategic plan
    Phase 1 Outcome:
    • Analysis of the current state of PPM
    • Strategy-aligned goals and metrics for PPM processes
    Phase 2 Outcome:
    • PPM capability levels
    • High-level descriptions of near- and long-term target state
    Phase 3 Outcome:
    • PPM tool recommendations
    • Cost-benefit analysis
    • Customized PPM strategic plan

    Workshop overview

    Contact your account representative or email Workshops@InfoTech.com for more information.

    Workshop Day 1

    Workshop Day 2

    Workshop Day 3

    Workshop Day 4

    Workshop Day 5

    Get leadership buy-in for PPM strategy Set PPM process goals and metrics with strategic expectations Develop and Refine PPM processes Develop and Refine PPM processes Complete the PPM strategic plan

    Activities

    • 1.1 Assess leadership mandate.
    • 1.2 Determine potential resource capacity.
    • 1.3 Create a project inventory.
    • 1.4 Communicate your PPM strategy to key stakeholders.
    • 2.1 Translate each strategic goal into process goals.
    • 2.2 Set metrics and preliminary targets for PPM process goals.
    • 3.1 Develop and refine the project intake, prioritization, and approval process.
    • 3.2 Develop and refine the resource management process.
    • 4.1 Develop and refine the portfolio reporting process.
    • 4.2 Develop and refine the project closure process.
    • 4.3 Develop and refine the benefits realization process.
    • 5.1 Right-size the PPM tools for your processes.
    • 5.2 Conduct a cost-benefit analysis of implementing the new PPM strategy.
    • 5.3 Define roles and responsibilities for the new processes.

    Deliverables

    1. Choice of PPM strategy and the leadership mandate
    2. Analysis of current project capacity
    3. Analysis of current project demand
    4. PPM Strategic Plan – Executive Brief
    1. PPM strategy-aligned process goals
    2. Metrics and long-term targets for PPM process goals
      For each of the five PPM processes:
    1. Process capability level
    2. Current-state PPM process description
    3. Retrospective examination of the current-state PPM process
    4. Action items to achieve the target states
    5. Time cost of the process at current and target states
    1. Recommendation for a PPM tool
    2. Cost-benefit analysis
    3. Roles and responsibilities matrix for each PPM process

    Develop a Project Portfolio Management Strategy

    PHASE 1

    Get Executive Buy-In for Your PPM Strategy

    Phase 1 outline

    Associated Activity icon Call 1-888-670-8889 or email GuidedImplementations@InfoTech.com for more information.

    Complete these steps on your own, or call us to complete a guided implementation. A guided implementation is a series of 2-3 advisory calls that help you execute each phase of a project. They are included in most advisory memberships.

    Guided Implementation 1: Get executive buy-in for your PPM strategy

    Proposed Time to Completion: 2 weeks
    Step 1.1: Choose the right PPM strategy Step 1.2: Translate strategic expectations to process goals
    Start with an analyst kick-off call:
    • Scoping call to discuss the current state of PPM and review strategy options.
    Work with an analyst to:
    • Discuss how to wireframe realistic process goals, rooted in your PPM strategic expectations, that will be sustained by the organization.
    Then complete these activities…
    • Execute a leadership mandate survey.
    • Perform a high-level supply/demand analysis.
    • Prepare an executive presentation to get strategy buy-in.
    Then complete these activities…
    • Develop realistic process goals based in your PPM strategic expectations.
    • Set metrics and preliminary targets for your high-priority PPM process goals.
    With these tools & templates:
    • PPM High-Level Supply/Demand Calculator
    • PPM Strategic Plan Template
    With these tools & templates:
    • PPM Strategy-Process Translation Matrix

    Phase 1 Results & Insights

    • Executive layer buy-in is a critical prerequisite for the success of a top-down PPM strategy. Ensure your executives are onboard before proceeding to implement your PPM strategy.

    Prepare to get to value early with step 1.1 of this blueprint

    The first step of this blueprint will help you define your PPM strategy and get executive buy-in for it using section one of Info-Tech’s PPM Strategic Plan Template.

    Where traditional models of consulting can take considerable amounts of time before delivering value to clients, Info-Tech’s methodology for developing a PPM strategy gets you to value fast.

    In the first step of this blueprint, you will define your PPM strategy and prepare an executive presentation to get buy-in for the strategy. The presentation can be prepared in just a few hours.

    • The activities in step 1.1 of this blueprint will help you customize the slides in section 1 of Info-Tech’s PPM Strategic Plan Template.
    • Section one of the Template will then serve as your presentation document.

    Once you have received buy-in for your PPM strategy, the remainder of this blueprint will help you customize section 2 of the Template.

    • Section 2 of the Template will communicate:
      • Your processes and process goals.
      • Your near-term and long-term action items for implementing the strategy.
      • Your PPM tool requirements.
      • The costs and benefits of your PPM strategy.

    Download Info-Tech’s PPM Strategic Plan Template.

    Sample of Info-Tech's 'PPM Strategic Plan Template.'

    Step 1.1: Choose the right PPM strategy for your organization

    PHASE 1

    PHASE 2

    PHASE 3

    1.1 1.2 2.1 2.2 3.1 3.2
    Choose the right PPM strategy Translate strategy into process goals Define intake & resource mgmt. processes Define reporting, closure, & benefits mgmt. processes Select a right-sized PPM solution Finalize your PPM strategic plan

    This step will walk you through the following activities:

    • Perform a leadership mandate survey.
    • Choose your PPM strategy.
    • Calculate your resource capacity for projects.
    • Determine overall organizational demand for projects.
    • Prepare an executive presentation of the PPM strategy.

    This step involves the following participants:

    • CIO
    • PMO Director/Portfolio Manager
    • Project Managers
    • IT Managers

    Outcomes of this step

    • A PPM strategy
    • A resource supply/project demand analysis
    • An executive brief presentation
    • Executive buy-in for the PPM strategy

    “Too many projects, not enough resources” is the reality of most IT environments

    In today’s organizations, the desires of business units for new products and enhancements, and the appetites of senior leadership to approve more and more projects for those products and services, far outstrips IT’s ability to realistically deliver on everything.

    The vast majority of IT departments lack the resourcing to meet project demand – especially given the fact that day-to-day operational demands frequently trump project work.

    As a result, project throughput suffers – and with it, IT's reputation within the organization.

    A visualization of 'Project Demand' versus 'Resource supply' utilizing courtroom scales with numerous project titles weighing down the 'Project Demand' side and silhouettes of three little people raised aloft on the 'Resource supply' side.

    In these environments, a PPM strategy is required.

    A PPM strategy should enable executive decision makers to make sense of the excess of demand and give IT the ability to prioritize those projects that are of the most strategic value to the business.

    With the right PPM strategy, IT can improve project outcomes across its portfolio and drive business value – all while improving the workloads of IT project staff.

    Info-Tech has two PPM strategy options that you can start to deploy today

    This step will help you choose the most suitable option, depending on your project pain points and current level of executive engagement in actively steering the portfolio.

    Option A:
    Top-Down, Executive Driven Strategy

    Option B:
    Bottom-Up, Project Manager Driven Strategy

    Goals of this approach:
    • This approach is intended to assist decision makers in their job: choosing the right projects, committing to timelines for those projects, and monitoring/directing their progress.
    Goals of this approach:
    • This approach is primarily intended to ensure that projects are well managed in a standardized manner in order to provide project managers with clear direction.
    Who this approach is for:
    • IT departments looking to improve alignment of project demand and resource capacity.
    • IT departments wanting to prioritize strategically valuable work.
    • IT departments with sufficient executive backing and engagement with the portfolio.
    Who this approach is for:
    • IT departments that would not the get support for a top-down approach due to a disengaged executive layer.
    • IT departments that already have a top-down PPM strategy and feel they are sufficiently resourced to confront project demand.

    Each of these strategy options is driven by a set of specific strategic expectations to help communicate your PPM goals. See the following slides for an articulation of each strategy option.

    A top-down, executive driven strategy is the optimal route, putting leadership in a position to best conduct the portfolio

    Option A: Top-Down, Executive Driven Strategy

    Strategic Expectations:

    • Project Throughput: Maximize throughput of the best projects.
    • Portfolio Visibility: Ensure visibility of current and pending projects.
    • Portfolio Responsiveness: Make the portfolio responsive to executive steering when new projects and changing priorities need rapid action.
    • Resource Utilization: Minimize resource waste and optimize the alignment of skills to assignments.
    • Benefits Realization: Clarify accountability for post-project benefits attainment for each project, and facilitate the process of tracking/reporting those benefits.

    Info-Tech Insight

    Serve the executive with insight before you impede the projects with governance. This strategy option is where Info-Tech sees the most PPM success. A strategy focused at improving decision making at the executive layer will both improve project outcomes and help alleviate project workloads.

    A bottom-up strategy can help project managers and teams succeed where insight into the big picture is lacking

    Option B: Bottom-Up, Project Manager Driven Strategy

    Strategic Expectations:

    • Project Management Governance: All projects consuming IT resources will be continually validated in terms of best-practice process compliance.
    • Project Risk Management: Identify risks and related mitigation approaches for all high-risk areas.
    • Stakeholder Management: Ensure that project stakeholders are identified and involved.
    • Project Manager Resourcing: Provide project managers as needed.
    • Project-Level Visibility: Provide access to the details of project management processes (planning and progress) as needed.

    Info-Tech Insight

    Right-size governance to maximize success. Project management and governance success don’t necessarily equal project success. Project management processes should be a means to an end (i.e. successful project outcomes), and not an end in themselves. Ensure the ends justify the means.

    Most recurring project challenges require a top-down portfolio management approach

    While project management is a key ingredient to project success, tying to solve endemic project problems with project management alone won’t improve results over the long term.

    Why Top-Down is a better starting point than Bottom-Up.

    The most common IT project problems – schedule and budget overruns, scope creep, and poor quality – can ultimately, in the vast majority of cases, be traced back to bad decisions made at the portfolio level:

    • The wrong projects get greenlighted.
    • Shifting leadership priorities and operational demands make project plans and estimated delivery dates obsolete from the start.
    • Too many projects get approved when there are not enough resources to effectively work on them all.

    No amount of project management rigor can help alleviate these common root causes of project failure.

    With a top-down PPM strategy, however, you can make sure that leadership is informed and engaged in making the right project decisions and that project managers and teams are situated for success.

    "There is nothing so useless as doing efficiently that which should not be done at all." (Peter Drucker (quoted in Lessing))

    Info-Tech Insight

    Get Strategic About Project Success.

    The difference between project management and project portfolio management comes down to doing things right vs. doing the right things. Both are important, no doubt; but doing the wrong things well doesn’t provide much value to the business in the long run.

    Get insight into the big picture with a top-down strategy before imposing more administrative overhead on project managers and leads.

    Perform a leadership mandate assessment to gauge executive needs and expectations

    Associated Activity icon 1.1.1 – 15 to 30 minutes (prep time) 10 to 20 minutes (execution time)

    INPUT: Leadership expectations for portfolio and project management.

    OUTPUT: Leadership mandate bar chart

    Materials: Tab 6 of Info-Tech’s PPM High-Level Supply-Demand Calculator

    Participants: Portfolio manager (or equivalent), PPM strategy sponsor(s), CIO and other members of senior management

    Before choosing your strategy option, survey the organization’s leadership to assess what they’re expecting from the PPM strategy.

    Use the “Leadership Mandate Survey” (located on tab 6 of Info-Tech’s PPM High-Level Supply-Demand Calculator) to assess the degree to which your leadership expects the PPM strategy to provide outcomes across the following capabilities: portfolio reporting, project governance, and project management.

    • Deploy the 12-question survey via individual one-on-one meetings or group working sessions with your boss (the PPM strategy sponsor) as well as with the CIO and other senior managers from within IT and the business.
      • If you cannot connect with the executive layer for this survey, do your best to estimate their responses to complete the survey.
    • The survey should help distinguish if executives are looking for portfolio management or project management. It should be one input that informs your choice of strategy option A or B.
      • If leadership is looking primarily for project management, you should proceed to Info-Tech’s Tailor Project Management Processes that Fit Your Projects blueprint.

    Refer to the next slide for assistance analyzing the outputs in tab 6 and using them to inform your choice of strategy.

    How to make use of the results of the leadership survey

    Two possible result scenarios of the leadership survey. There are two bar graphs titled 'Leadership Mandate', each with an explanation of the scenario they belong to. In Scenario 1, the 'Leadership Mandate' graph has a descending trend with 'Portfolio Reporting' at the highest level, 'Project Governance' in the middle, and 'Project Management' at the lowest level. 'A result like this, with a higher portfolio reporting score, shows a higher need for a top-down approach and demonstrates well-balanced expectations for a PPM strategy from the leadership. There is greater emphasis put on the portfolio than there is project governance or project management.' In Scenario 2, the 'Leadership Mandate' graph has an ascending trend with 'Portfolio Reporting' at the lowest level, 'Project Governance' in the middle, and 'Project Management' at the highest level. 'If your graph looks like this, your executive leadership has placed greater importance on project governance and management. Completing a top-down PPM strategy may not meet their expectations at this time. In this situation, a bottom-up approach may be more applicable.'

    Customize Info-Tech’s PPM Strategic Plan Template. Insert screenshots of the survey and the bar graph from tab 6 of the PPM High-Level Supply-Demand Calculator onto slides 7 and 8, “PPM Strategy Leadership Mandate,” of the PPM Strategic Plan Template.

    Proceed with the right PPM strategy for your organization

    Based upon the results of the “Leadership Mandate Survey,” and your assessment of each strategy option as described in the previous slides, choose the strategy option that is right for your IT department/PMO at this time.

    "Without a strategic methodology, project portfolio planning is frustrating and has little chance of achieving exceptional business success." (G Wahl (quoted in Merkhofer))

    Option A:

    Those proceeding with Option A should continue with remainder of this blueprint. Update your strategy statement on slide 3 of your PPM Strategic Plan Template to reflect your choice

    Option B:

    Those proceeding with Option B should exit this blueprint and refer to Info-Tech’s Tailor Project Management Processes to Fit Your Projects blueprint to help define a project management standard operating procedure.

    Customize Info-Tech’s PPM Strategic Plan Template. If you’re proceeding with Option A, update slide 4, “Project Portfolio Management Strategy,” of your PPM Strategic Plan Template to reflect your choice of PPM strategy. If you’re proceeding with Option B, you may want to include your strategy statement in your Project Management SOP Template.

    The success of your top-down strategy will hinge on the quality of your capacity awareness and resource utilization

    A PPM strategy should facilitate alignment between project demand with resource supply. Use Info-Tech’s PPM High-Level Supply/Demand Calculator as a step towards this alignment.

    Info-Tech’s research shows that the ability to provide a centralized view of IT’s capacity for projects is one of the top PPM capabilities that contributes to overall project success.

    Accurate and reliable forecasts into IT’s capacity, coupled with an engaged executive layer making project approval and prioritization decisions based upon that capacity data, is the hallmark of an effective top-down PPM strategy.

    • Use Info-Tech’s PPM High-Level Supply/Demand Calculator to help improve visibility (and with it, organizational understanding) into project demand and IT resource supply.
    • The Calculator will help you determine IT’s actual capacity for projects and analyze organizational demand by taking an inventory of active and backlog projects.

    Download Info-Tech’s PPM High-Level Supply/Demand Calculator.

    Sample of Into-Tech's PPM High-Level Supply/Demand Calculator.

    Info-Tech Insight

    Where does the time go? The portfolio manager (or equivalent) should function as the accounting department for time, showing what’s available in IT’s human resources budget for projects and providing ongoing visibility into how that budget of time is being spent.

    Establish the total resource capacity of your portfolio

    Associated Activity icon 1.1.2 – 30 to 60 minutes

    INPUT: Staff resource types, Average work week, Estimated allocations

    OUTPUT: Breakdown of annual portfolio HR spend, Capacity pie chart

    Materials: PPM High-Level Supply/Demand Calculator, tab 3

    Participants: Portfolio manager (or equivalent), Resource and/or project managers

    Use tab 3 of the calculator to determine your actual HR portfolio budget for projects, relative to the organization’s non-project demands.

    • Tab 3 analyzes your resource supply asks you to consider how your staff spend their time weekly across four categories: out of office time, administrative time (e.g. meetings, training, checking email), keep-the-lights-on time (i.e. support and maintenance), and project time.
    • The screenshot below walks you through columns B to E of tab 3, which help calculate your potential capacity. This activity will continue on the next slide, where we will determine your realized capacity for project work from this potential capacity.
    Screenshot of tab 3 in the PPM High-Level Supply/Demand Calculator. It has 4 columns, 'Resource Type', '# People', 'Hours / Week', and 'Hours / Year', which are referred to in notes as columns B through E respectively. The note on 'Resource Type' reads '1. Compile a list of each of the roles within your department in column B'. The note on '# People' reads '2. In column C, provide the number of staff currently performing each role'. The note on 'Hours / Week' reads '3. In column D, provide a baseline for the number of hours in a typical work week for each role'. The note on 'Hours / Year' reads '4. Column E will auto-populate based on E and D. The total at the bottom of column E (row 26) constitutes your department’s total capacity'.

    Determine the project/non-project ratio for each role

    Associated Activity icon 1.1.2 (continued)

    The previous slide walked you through columns B to E of tab 3. This slide walks you through columns F to J, which ask you to consider how your potential capacity is spent.

    Screenshot of tab 3 in the PPM High-Level Supply/Demand Calculator. It has 6 columns, 'Hours / Year', 'Absence', 'Working Time / Year', 'Admin', 'KTLO', and 'Project Work', which, starting at 'Absence', are referred to in notes as columns F through J respectively. The note on 'Absence' reads '5. Enter the percentage of your total time across each role that is unavailable due to foreseeable out-of-office time (vacation, sick time, etc.) in column F. Industry standard runs anywhere from 12% to 16%, depending on your industry and geographical region'. The note on 'Working Time / Year' reads '6. Column G will auto-calculate to show your overall net capacity after out-of-office percentages have been taken off the top. These totals constitute your working time for the year'. The note on 'Admin' and 'KTLO' reads '6. Column G will auto-calculate to show your overall net capacity after out-of-office percentages have been taken off the top. These totals constitute your working time for the year'. The note on 'Project Work' reads '8. The project percentage in column J will auto-calculate based upon what’s leftover after your non-project working time allocations in columns H and I have been subtracted'.

    Review your annual portfolio capacity for projects

    Associated Activity icon 1.1.2 (continued)

    The previous slides walked you through the inputs for tab “3. Project Capacity.” This slide walks you through the outputs of the tab.

    Based upon the inputs from columns B to J, the rest of tab 3 analyzes how IT available time is spent across the time categories, highlighting how much of IT’s capacity is actually available for projects after admin work, support and maintenance work, and absences have been taken into account.

    A table and pie chart of output data from Tab 3 of the PPM High-Level Supply/Demand Calculator. Pie segments are labelled 'Admin', 'Absence', 'Project Capacity', and 'Keep The Lights On'.

    Customize Info-Tech’s PPM Strategic Plan Template. Update slide 10, “Current Project Capacity,” of your PPM Strategic Plan Template to include the outputs from tab 3 of the Calculator.

    Create an inventory of active and backlog projects to help gauge overall project demand

    Associated Activity icon 1.1.3 – 15 to 30 minutes

    INPUT: Number of active and backlog projects across different sizes

    OUTPUT: Total project demand in estimated hours of work effort

    Materials: PPM High-Level Supply/Demand Calculator, tab 4

    Participants: Portfolio manager (or equivalent), Project managers

    Where tab 3 of the Calculator gave you visibility into your overall resource supply for projects, tab 4 will help you establish insight into the demand side.

    • Before starting on tab 4, be sure to enter the required project size data on the set-up tab.
    • Using a list of current active projects, categorize the items on the list by size: small, medium, large, and extra large. Enter the number of projects in each category of project in column C of tab 4.
    • Using a list of on-hold projects, or projects that have been approved but not started, categorize the list by size and enter the number of projects in each category in column D.
    • In column E, estimate the number of new requests and projects across each size that you anticipate being added to the portfolio/backlog in the next 12 months. Use historical data from the past 12 to 24 months to inform your estimates.
    • In column F, estimate the number of projects that you anticipate being completed in each size category in the next 12 months. Take the current state of active projects into account as you make your estimates, as well as throughput data from the previous 12 to 24 months.
    Screenshot of tab 4 in the PPM High-Level Supply/Demand Calculator. It has 5 columns labelled 'Project Types' with values Small to Extra-Large, 'Number of active projects currently in the portfolio', 'Number of projects currently in the portfolio backlog', 'Number of new requests anticipated to be added to the portfolio/backlog in the next 12 months', and 'Number of projects expected to be delivered within the next 12 months'.

    Make supply and demand part of the conversation as you get buy-in for your top-down strategy

    Tab 5 of the Calculator is an output tab, visualizing the alignment (or lack thereof) of project demand and resource supply.

    Once tabs 3 and 4 are complete, use tab 5 to analyze the supply/demand data to help build your case for a top-down PPM strategy and get buy-in for it.

    Screenshots of Tab 5 in the PPM High-Level Supply/Demand Calculator. A bar chart obscures a table with the note 'The bar chart shows your estimated total project demand in person hours (in black) relative to your estimated total resource capacity for projects (in green)'. Notes on the table are 'The table below the bar chart shows your estimated annual project throughput rate (based upon the number of projects you estimated you would complete this year) as well as the rate at which portfolio demand will grow (based upon the number of new requests and projects you estimated for the next 12 months)' and 'If the “Total Estimated Project Demand (in hours) in 12 Months Time” number is more than your current demand levels, then you have a supply-demand problem that your PPM strategy will need to address'.

    Customize Info-Tech’s PPM Strategic Plan Template. Update slides 11 and 12, “Current Project Demand,” of your PPM Strategic Plan Template to include the outputs from tabs 4 and 5 of the Calculator.

    Recommended: Complete Info-Tech’s PPM Current State Scorecard to measure your resource utilization

    Associated Activity icon Contact your rep or call 1-888-670-8889

    This step is highly recommended but not required. Call 1-888-670-8889 to inquire about or request the PPM Diagnostics.

    Info-Tech’s PPM Current State Scorecard diagnostic provides a comprehensive view of your portfolio management strengths and weaknesses, including project portfolio management, project management, customer management, and resource utilization.

    Screenshots of Info-Tech's PPM Current State Scorecard diagnostic with a pie chart obscuring a table/key. The attached note reads 'In particular, the analysis of resource utilization in the PPM Current State Scorecard report, will help to complement the supply/demand analysis in the previous slides. The diagnostic will help you to analyze how, within that percentage of your overall capacity that is available for project work, your staff productively utilizes this time to successfully complete project tasks and how much of this time is lost within Info-Tech’s categories of resource waste.'

    Customize Info-Tech’s PPM Strategic Plan Template. Update slides 14 and 15, “Current State Resource Utilization” of your PPM Strategic Plan Template to include the resource utilization outputs from your PPM Current State Scorecard.

    Finalize section one of the PPM Strategic Plan Template and prepare to communicate your strategy

    Associated Activity icon 1.1.4 – 10 to 30 minutes

    INPUT: The previous activities from this step

    OUTPUT: An presentation communication your PPM strategy

    Materials: PPM Strategic Plan Template, section 1

    Participants: Portfolio manager (or equivalent)

    By now, you should be ready to complete section one of the PPM Strategic Plan Template.

    The purpose of this section of the Template is to capture the outputs of this step and use them to communicate the value of a top-down PPM strategy and to get buy-in for this strategy from senior management before you move forward to develop your PPM processes in the subsequent phases of this blueprint.

    • Within section one, update any of the text that is (in grey) to reflect the specifics of your organization – i.e. the name of your organization and department – and the specific outcomes of step 1.2 activities. In addition, replace the placeholders for a company logo with the logo of your company.
    • Replace the tool screenshots with the outputs from your version of the PPM High-Level Supply/Demand Calculator.
    • Proofread all of the text to ensure the content accurately reflects your outcomes. Edit the content as needed to more accurately reflect your outcomes.
    • Determine the audience for the presentation of your PPM strategy and make a logistical arrangement. Include PPM strategy sponsors, senior management from within IT and the business, and other important stakeholders.

    Get executive buy-in for your top-down PPM strategy

    Executive layer buy-in is a critical prerequisite for the success of a top-down PPM strategy. Ensure your executives are on board before preceding.

    You’re now ready to communicate your PPM strategy to your leadership team and other stakeholders.

    It is essential that you get preliminary buy-in for this strategy from the executive layer before you move forward to develop your PPM processes in the subsequent phases of this blueprint. Lack of executive engagement is one of the top barriers to PPM strategy success.

    • If you have gone through the preceding activities in this step, section one of your PPM Strategic Plan Template should now be ready to present.
    • As explained in 1.1.4, you should present this section to an audience of PPM strategy sponsors, C-suite executives, and other members of the senior management team.
    • Allow at least 60 minutes for the presentation – around 20 minutes to deliver the slide presentation and 40 minutes for discussion.
    • If you get sufficient buy-in by the end of the presentation, proceed to the next step of this blueprint. If buy-in is lacking, now might not be the right time for a top-down PPM strategy. Think about adopting a bottom-up approach until leadership is more engaged in the portfolio.

    "Gaining executive sponsorship early is key…It is important for the executives in your organization to understand that the PPM initiatives and the PMO organization are there to support (but never hinder) executive decision making." (KeyedIn Projects)

    Info-Tech Best Practice

    Engage(d) sponsorship. According to Prosci, the top factor in contributing to the success of a change initiative is active and visible executive sponsorship. Use this meeting to communicate to your sponsor(s) the importance of their involvement in championing the PPM strategy.

    A PPM strategic plan elevates PMO’s status to a business strategic partner

    CASE STUDY

    Industry: Public Administration
    Source: IAG / Info-Tech Interview

    Challenge

    The PMO operated in a way that is, in their self-assessment, reactive; project requests and capacity were not effectively managed. Perhaps due to this, the leadership team was not always visible, or regularly available, to PM leaders. This, in turn, complicated efforts to effectively manage their projects.

    Solution

    Establishing a simple prioritization methodology enabled the senior leadership to engage and effectively steer the project portfolio by strategic importance. The criteria and tool also gave the business units a clear understanding to promote the strategic value of each of their project requests.

    Results

    PM leaders now have the support and confidence of the senior leadership team to both proactively manage and deliver on strategic projects. This new prioritization model brought the PM Leader and senior leadership team in direct access with each other.

    "By implementing this new project intake and prioritization framework, we drastically improved our ability to predict, meet, and manage project requests and unit workload. We adopted a client-focused and client-centric approach that enabled all project participants to see their role and value in successful project delivery. We created methodologies that were easy to follow from the client participation perspective, but also as PM leaders, provided us with the metrics, planning, and proactive tools to meet and anticipate client project demand. The response from our clients was extremely positive, encouraging, and appreciative."

    Step 1.2: Translate PPM strategic expectations to process goals

    PHASE 1

    PHASE 2

    PHASE 3

    1.11.22.12.23.13.2
    Choose the right PPM strategyTranslate strategy into process goalsDefine intake & resource mgmt. processesDefine reporting, closure, & benefits mgmt. processesSelect a right-sized PPM solutionFinalize your PPM strategic plan

    This step will walk you through the following activities:

    • Determine process goals based upon your PPM strategy.
    • Set metrics and preliminary targets for your PPM processes.

    This step involves the following participants:

    • CIO
    • Steering Committee
    • Business Unit Leaders
    • PMO Director/Portfolio Manager

    Outcomes of this step

    • Stakeholder-prioritized PPM process goals
    • Metrics and targets for high-priority process goals

    Use the PPM strategy to set the direction for PPM processes that make up the infrastructure around projects

    PPM strategy enables you to answer any and all of these questions in a way that is consistent, cohesive, and aligned with one another.

    Info-Tech's PPM Process Model from earlier with notes overlaid asking a series of questions. The questions for '1. Intake, Approval, and Prioritization' are 'Who can request a project? How do you request a project? Who decides what to fund? What is the target investment mix? How will they decide?' The questions for '2. Resource Management' are 'Who assigns the resources? Who feeds the data on resources? How do we make sure it’s valid? How do we handle contingencies when projects are late, or if availability changes?' The questions for '3. Status and Progress Reporting' are 'What project information that should be reported? Who reports on project status? When? How?' The questions between 'Project Management' and '4. Project Closure' are 'Who declares that a project is done? Who validates it? Who is this reported to? Who terminates low-value projects? How will they decide?' The questions for '5. Benefits Tracking' are 'How do we validate the project benefits from the original business case? How do we track the benefits? Who reports it? When?'

    Set process goals to address PPM strategic expectations and steer the PPM strategic plan

    Associated Activity icon 1.2.1 – 2 hours

    INPUT: PPM strategy & expectations, Organizational strategy and culture

    OUTPUT: Prioritized list of strategy-aligned PPM process goals

    Materials: PPM Strategy-Process Translation Matrix

    Participants: CIO, Steering Committee, Business Unit Leaders, PMO Director/ Portfolio Manager

    This activity is designed for key departmental stakeholders to articulate how PPM processes should be developed or refined to meet the PPM strategic expectations.

    Participation of the key departmental stakeholders in this exercise is critical, e.g. CIO, Steering Committee, business unit leaders.

    Strategic Expectations x Processes = Process goals aligned to strategy
    Throughput Project Intake, Approval, & Prioritization
    Visibility Resource Management
    Responsiveness Status & Progress Reporting
    Resource Utilization Project Closure
    Benefits Benefits Realization

    Download Info-Tech’s PPM Strategy-Process Goals Translation Matrix Template.

    Use Info-Tech’s Translation Matrix to systematically articulate strategy-aligned PPM process goals

    Supporting Tool icon 1.2.1 – PPM Strategy-Process Translation Matrix, tab 2

    Formula: To answer “[question]” in a way that we can [strategic expectation], it will be important to [process goal].

    Example 1:
    To answer the question “who can request a project, and how?” in a way that we can maximize the throughput of the best projects, it will be important to standardize the project request process.

    Example 2:
    To answer the question “how will they decide what to fund?” in a way that we can maximize the throughput of the best projects, it will be important to reach a consensus on project prioritization criteria.

    Example 3:
    To answer the question “how will we track the projected benefits?” in a way that we can maximize the throughput of the best projects, it will be important to double-check the validity of benefits before projects are approved.

    Screenshot of Tab 2 in Info-Tech's PPM Strategy-Process Translation Matrix tool. There is a table with notes overlaid 'Enter the process goals in the appropriate question–strategic expectation slot' and 'Assign a priority, from the most important (1) to the least important (5)'.

    Set metrics and preliminary targets for your high-priority PPM process goals

    Associated Activity icon 1.2.2 – 1-2 hours

    INPUT: Prioritized list of strategy-aligned PPM process goals, Organizational strategy and culture

    OUTPUT: Metrics and targets for high-priority PPM process goals

    Materials: PPM Strategy-Process Translation Matrix

    Participants: CIO, Steering Committee, Business Unit Leaders, PMO Director/ Portfolio Manager

    Your highest-priority process goals and their corresponding strategy expectations are displayed in tab 3 of the PPM Strategy-Process Translation Matrix template (example below).

    Through a group discussion, document what will be measured to decide the achievement of each process goal, as well as your current estimate and the long-term target. If necessary, adjust the approximate target duration.

    Screenshot of Tab 3 in Info-Tech's PPM Strategy-Process Translation Matrix tool. There is a table with 6 columns 'PPM Process', 'High-priority Process Goals', 'Strategy Expectation', 'How will you measure success?', 'Current Estimate', and 'Long-Term Target'; they are referred to in notes as columns B through G respectively. Overlaid notes are 'Columns C and D will auto-populate based upon your inputs from tab 2. The five PPM process areas are arranged vertically in column B and your top-five process goals from each area appear in column C.' 'Use column E to brainstorm how you might measure the success of each process goal at your organization. These can be tentative for now and refined over time.' 'Determine current metrics for each process goals and long-term target metrics in columns F and G.'

    Project-client-centered approach to PPM process design improves client satisfaction and team confidence

    CASE STUDY

    Industry: Public Administration
    Source: IAG / Info-Tech Interview

    Challenge

    Reactive instead of proactive

    "We had no effective means of tracking project intake requests vs. capacity. We struggled using ad hoc processes and methods which worked to meet immediate needs, but we quickly realized that they were ineffective in tracking critical project metrics, key performance indicators (KPIs), or performance measures...In short, we were being reactive, instead of proactive."

    The result was a disorganized portfolio that led to low client satisfaction and team morale.

    Solution

    Examine processes “through the eyes of the client”

    With the guiding principle of “through the eyes of the client,” PPM processes and tools were developed to formalize project intake, prioritization, and capacity planning. All touchpoints between client and PPM processes were identified, and practices for managing client expectations were put in place. A client satisfaction survey was formulated as part of the post-project assessment and review.

    Results

    Client-centered processes improved client satisfaction and team confidence

    People, processes, and tools are now aligned to support client demand, manage client expectations, measure project KPIs, and perform post-project analysis. A standard for client satisfaction metrics was put in place. The overwhelmingly positive feedback has increased team confidence in their ability to deliver quality efforts.

    If you want additional support, have our analysts guide you through this phase as part of an Info-Tech Workshop Associated Activity icon

    Book a workshop with our Info-Tech analysts:

    Photo of Barry Cousins.
    • To accelerate this project, engage your IT team in an Info-Tech workshop with an Info-Tech analyst team.
    • Info-Tech analyst will join you and your team onsite at your location or welcome you to Info-Tech's historic Toronto office to participate in an innovative onsite workshop.
    • Contact your account manager (www.infotech.com/account), or email Workshops@InfoTech.com for more information.

    The following are sample activities that will be conducted by Info-Tech analysts with your team:

    Sample of activity 1.1.2 'Determine your actual resource capacity for projects'. Determine your actual resource capacity for projects

    Work with Info-Tech analysts to define your project vs. non-project ratio to help define how much of your overall resource capacity is actual available for projects.

    Sample of activity 1.2.1 'Set realistic PPM process goals'. Set realistic PPM process goals

    Leverage Info-Tech facilitators to help walk you through our PPM framework and define achievable process goals that are rooted in your current PPM maturity levels and organizational culture.

    Develop a Project Portfolio Management Strategy

    PHASE 2

    Align PPM Processes to Your Strategic Goals

    Phase 2 outline

    Associated Activity icon Call 1-888-670-8889 or email GuidedImplementations@InfoTech.com for more information.

    Complete these steps on your own, or call us to complete a guided implementation. A guided implementation is a series of 2-3 advisory calls that help you execute each phase of a project. They are included in most advisory memberships.

    Guided Implementation 2: Align PPM processes to your strategic goals

    Proposed Time to Completion: 2-4 weeks
    Step 2.1: Develop intake & resource mgmt. processes Step 2.2: Define reporting, closure, & benefits processes
    Work with an analyst to:
    • Assess your current intake, prioritization, and resource management processes and wireframe a sustainable target state for each capability.
    Work with an analyst to:
    • Analyze your current portfolio reporting, project closure, and benefits realization processes and wireframe a sustainable target state for each capability.
    Then complete these activities…
    • Set near-term and long-term goals.
    • Draft high-level steps within your target-state processes.
    • Document your process steps and roles and responsibilities.
    Then complete these activities…
    • Set near-term and long-term goals.
    • Draft high-level steps within your target-state processes.
    • Document your process steps and roles and responsibilities.
    With these tools & templates:
    • PPM Strategy Development Tool
    • PPM Strategic Plan Template
    With these tools & templates:
    • PPM Strategy Development Tool
    • PPM Strategic Plan Template

    Phase 2 Results & Insights

    • The means of project and portfolio management (i.e. processes) shouldn’t eclipse the ends – strategic goals. Root your process in your PPM strategic goals to realize PPM benefits (e.g. optimized portfolio value, improved project throughput, increased stakeholder satisfaction).

    Read first: Overview of the methodology for articulating new strategy-aligned PPM processes

    In the previous step of the blueprint, key department stakeholders established the PPM process goals, metrics, and targets in a way that aligns with the overall PPM strategy. In this phase, we draft a high-level description of the five PPM processes that reflect those goals using the following methodology:

    Methodology at a glance

    1. Articulate the current state of the process.
    2. Examine the process against the strategy-aligned goals.
    3. Create short- and long-term action items to refine the current process and meet the strategy-aligned targets.
    4. Develop a high-level target-state description of the PPM process.
    5. Estimate costs-in-use of the target-state process.

    Out-of-scope topics

    • Draft a detailed target-state description of the PPM process. Avoid falling into the “analysis paralysis” trap and keep the discussion focused on the overall PPM strategy.
    • PPM tools to support the process. This discussion will take place in the next phase of the blueprint.

    INPUT

    –›

    PROCESS

    –›

    OUTPUT

    • Strategy-aligned process goals, metrics, and targets (Activity 1.2.1)
    • Knowledge of current process
    • Knowledge of organizational culture and structure
    • Capability level assessment
    • Table-top design planning activity
    • Start-stop-continue retrospective
    • High-level description of the target state
    • PPM Strategy Development Tool
    • High-level descriptions of current and target states
    • Short- and long-term action items for improving the process
    • Cost-in-use of the current- and target-state processes

    Download Info-Tech’s PPM Strategy Development Tool

    Build a sound business case for implementing the new PPM strategy with realistic costs and benefits of managing your project portfolio.

    Time spent on managing the project portfolio is an investment. Like any other business endeavors, the benefits must outweigh the costs to be worth doing.

    As you draft a high-level description of the PPM processes in this phase of the blueprint, use Info-Tech’s PPM Strategy Development Tool to track the estimate the cost-in-use of the process. In the next phase, this information will be inform a cost-benefit analysis, which will be used to support your plan to implement the PPM strategy.

    Download Info-Tech’s PPM Strategy Development Tool.

    Screenshots of Info-Tech's PPM Strategy Development Tool including a Cost-Benefit Analysis with tables and graphs.

    Step 2.1: Develop and refine project intake, prioritization, and resource management processes

    PHASE 1

    PHASE 2

    PHASE 3

    1.11.22.12.23.13.2
    Choose the right PPM strategyTranslate strategy into process goalsDefine intake & resource mgmt. processesDefine reporting, closure, & benefits mgmt. processesSelect a right-sized PPM solutionFinalize your PPM strategic plan

    This step will walk you through the following activities:

    • Determine your process maturity.
    • Benchmark current processes against strategy-aligned goals.
    • Set near- and long-term action items.
    • Draft a high-level description of your target state.
    • Document your new processes.

    This step involves the following participants:

    • PMO Director/Portfolio Manager
    • Project Managers
    • Resource Managers
    • Business Analysts

    Outcomes of this step

    • A definition of current and target state maturity levels for intake, prioritization, and resource management
    • Near-term and long-term process goals for intake, prioritization, and resource management
    • A high-level wireframe for your intake, prioritization, and resource management process steps

    Project intake, prioritization, and approval: Get projects with the highest value done first

    Give your organization the voice to say “no” (or “not yet”) to new projects.

    Questions

    • Who can request a project?
    • How do you request a project?
    • Who decides what to fund?
    • What is the target investment mix?
    • How will they decide?

    Benefits

    • Maximize value of time spent on project work by aligning projects with priorities and stakeholder needs.
    • Finish the projects you start by improving alignment of intake and prioritization with resource capacity.
    • Improve stakeholder satisfaction by managing expectations with consistent, streamlined processes.

    Challenges

    • Stakeholders who benefit from political or ad hoc prioritization processes will resist or circumvent formal intake processes.
    • Many organizations lack sufficient awareness of resource capacity necessary to align intake with availability.

    A graph highlighting the sweet spot of project intake decision making. The vertical axis is 'Rigor and Effort' increasing upward, and the horizontal axis is 'Quality and Effectiveness of Decisions' increasing to the right. The trend line starts at 'Gut Feel' with low 'Rigor and Effort', and gradually curves upward to 'Analysis Paralysis' at the top. A note with an arrow pointing to a midway point in the line reads 'The sweet spot changes between situations and types of decisions'.

    Info-Tech Insight

    This process aims to control the project demand. A balance between rigor and flexibility is critical in order to avoid the “analysis paralysis” as much as the “gut feel” approach.

    Funnel project requests into a triage system for project intake

    Info-Tech recommends following a four-step process for managing project intake.

    1. Requestor fills out form and submits the request into the funnel.
    2. Requests are triaged into the proper queue.
      1. Divert non-project request.
      2. Quickly assess value and urgency.
      3. Assign specialist to follow up on request.
      4. Inform the requestor.
    3. Business analyst starts to gather preliminary requirements.
      1. Follow up with sponsors to validate and define scope.
      2. Estimate size and determine project management rigor required.
      3. Start to develop an initial business case.
    4. Requestor is given realistic expectations for approval process.

    Info-Tech Best Practice

    An excess number of intake channels is the tell-tale sign of a project portfolio in distress. The PMO needs to exercise and enforce discipline on stakeholders. PMO should demand proper documentation and diligence from stakeholders before proceeding with requests.

    Maintain reliable resourcing data with a recurrent project intake, prioritization, and approval practice

    Info-Tech recommends following a five-step process for managing project intake, prioritization, and approval.

    A diagram of Info-Tech's five-step process for managing project intake. There are four groups that may be involved in any one step, they are laid out on the side as row headers that each step's columns may fall into, 'Resources', 'Business Analysts', 'PMO', and 'Governance Layer'. The first step is 'Collect project requests' which involves 'Resources'. Step 2 is 'Screen project requests' which involves 'Business Analysts' and 'PMO'. A part of the step that may be applicable to some organizations is 'Concept approval' involving 'Governance Layer'. Step 3 is 'Develop business case' which involves 'Business Analysts' and 'PMO'. A part of the step that may be applicable to some organizations is 'Get a project sponsor' involving 'Governance Layer'. Step 4 is 'Prioritize project' which involves 'Business Analysts' and 'PMO'. Step 5 is 'Approve (greenlight) project' which involves 'Business Analysts', 'PMO', and 'Governance Layer', with an attached note that reads 'Ensure that up-to-date project portfolio information is available (project status, resource forecast, etc.)'. All of these steps lead to 'Initiate project, commit resources, etc.'

    Info-Tech Insight

    “Approval” can be a dangerous word in project and portfolio management. Use it carefully. Clarify precisely what is being “approved” at each step in the process, what is required to pass each gate, and how long the process will take.

    Determine your project intake, prioritization, and approval process maturity

    Associated Activity icon 2.1.1a – 10 minutes

    INPUT: Organizational strategy and culture

    OUTPUT: Project intake, prioritization, and approval capability level

    Materials: PPM Strategy Development Tool

    Participants: PMO Director/ Portfolio Manager, Project Managers, Resource Managers, Business Analysts

    Kick-off the discussion about the project intake, prioritization, and approval process by reading the capability level descriptions below and discussing which level currently applies to you the most.

    Capability Level Descriptions

    Capability Level 5: Optimized We have effective intake processes with right-sized administrative overhead. Work is continuously prioritized to keep up with emerging challenges and opportunities.
    Capability Level 4: Aligned We have very strong intake processes. Project approvals are based on business cases and aligned with future resource capacity.
    Capability Level 3: Engaged Processes are in place to track project requests and follow up on them. Priorities are periodically re-evaluated, based largely on the best judgment of one or several executives.
    Capability Level 2: Defined Some processes are in place, but there is no capacity to say no to new projects. There is a backlog, but little or no method for grooming it.
    Capability Level 1: Unmanaged Our organization has no formal intake processes in place. Most work is done reactively, with little ability to prioritize project work proactively.

    Benchmark the current project intake, prioritization, and approval process against strategy-aligned goals

    Associated Activity icon 2.1.1b – 1-2 hours

    INPUT: Documentation describing the current process (e.g. standard operating procedures), Process goals from activity 1.2.1

    OUTPUT: Retrospective review of current process

    Materials: 4x6” recipe cards, Whiteboard

    Participants: PMO Director/ Portfolio Manager, Project Managers, Resource Managers, Business Analysts

    Conduct a table-top planning exercise to map out the process currently in place.

    1. Use white 4”x6” recipe cards to write unique steps of a process. Use the intake, prioritization, and approval process from the previous slides as a guide.
    2. Use green cards to write artifacts or deliverables that result from a step.
    3. Use pink cards to write issues, problems, or risks.
    4. Discuss how the process could better achieve the strategy-aligned goals from activity 1.2.1. Keep a list of possible changes in the form of a start-stop-continue retrospective (example below) on a whiteboard.
    Start Stop Continue
    • Simplify business cases
    • Send emails to requestor to manage expectations
    • Accept verbal project requests
    • Approve “pet projects”
    • Monthly prioritization meetings
    • Evaluate prioritization criteria

    Set near- and long-term action items for the project intake, prioritization, and approval process

    Associated Activity icon 2.1.1c – 30 minutes - 1 hour

    INPUT: Outcome of the retrospective review, Process goals and metrics from activity 1.2.1

    OUTPUT: Action items for evolving the process to a target state

    Materials: Whiteboard

    Participants: PMO Director/ Portfolio Manager, Project Managers, Resource Managers, Business Analysts

    Analyze each item in the start-stop-continue retrospective to compile a set of near-term and long-term action items.

    The near-term plan should include steps that are within the authority of the PMO and do not require approval or investment outside of that authority. The long-term plan should include steps that may require a longer approval process, buy-in of external stakeholders, and the investment of time and money.
    Near-Term Action Items Long-Term Action Items
    For example:
    • Limit the number of channels available to request new projects.
    • Revise the intake form.
    • Establish a regular triage process.
    For example:
    • Establish a comprehensive scorecard and business case scoring process at the steering committee level.
    • Limit the rate of approval to be aligned with resource capacity.

    Review and customize slide 23, “Project intake, prioritization, and approval: action items,” in Info-Tech’s PPM Strategic Plan Template.

    Draft a high-level description of the intake, prioritization, and approval process at a target state

    Associated Activity icon 2.1.1d – 1-2 hours

    INPUT: Action items for evolving the process to a target state

    OUTPUT: High-level description of the process at the target state

    Materials: Whiteboard, PPM Strategy Development Tool

    Participants: PMO Director/ Portfolio Manager, Project Managers, Resource Managers, Business Analysts

    1. Break down the process into several tasks at a high level. Avoid getting into too much detail by limiting the number of steps.
    2. An example of high-level breakdown: project intake, prioritization, and approval
      Collect project requests –› Screen requests –› Develop business case –› Prioritize project –› Approve project

    3. Describe each task by answering the following questions. Document your response in the PPM Strategic Plan Template.
    4. Question

      Description

      Input What information do you need to perform the work?
      Output What artifacts/deliverables are produced as a result?
      Frequency/Timing How often, and when, will the work be performed?
      Responsibility Who will perform the work?

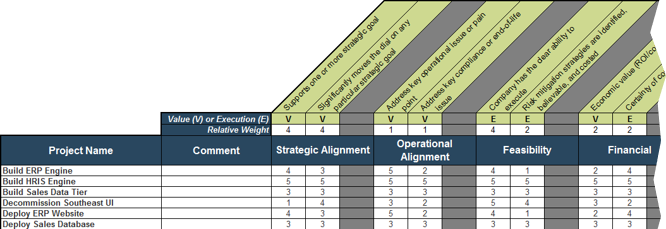

      Accountability Who will approve the work and assume the ownership of any decisions?

    5. Record the time cost of each process using the PPM Strategy Development Tool; see next slide for instructions.

    Use the PPM Strategy Development Tool to track the time cost of the process

    Supporting Tool icon 2.1.1 – PPM Strategy Development Tool, Tab 3: Costing Assumptions

    Record the time cost of each high-level process task from Activity 2.1.1d.

    Screenshot of tab 3 from Info-Tech's PPM Strategy Development Tool with notes overlaid. Columns are 'ID', 'Task Description', 'Who does the task?', a super-column titled 'Current State' which includes 'How many times per year?', 'How many people?', and 'For how long?', a super-column titled 'Near-Term Target State' with the same three sub columns, and a super-column titled 'Long-Term Target State' with the same three sub columns. Notes for 'Who does the task?' read 'Choose executive, management or resource' and 'If task is done by more than one party, duplicate the task'. Notes for the 3 recurring sub columns are 'Estimate how many times in a year the task is performed (e.g. 120 project requests per year)', 'Indicate the number of people needed to perform the task each time', 'Estimate the average work-hours for the task… either in minutes or in hours', 'If a task is not applicable to a state (e.g. currently PMO does not screen project requests), leave the row blank', and 'For meetings, remember to indicate the number of people'.

    Document the high-level description for the new intake, prioritization, and approval process

    Associated Activity icon 2.1.1e – 30 minutes - 1 hour

    INPUT: High-level description of the process at the target state

    OUTPUT: Updated PPM strategic plan

    Materials: Whiteboard, PPM Strategic Plan Template

    Participants: PMO Director/ Portfolio Manager

    Update your PPM strategic plan with the new high-level description for the new project intake, prioritization, and approval process. Depending on your current process capability level, you may wish to include additional information on your strategic document, for example:

    • Updated prioritization scorecard.
    • Roles and responsibility matrix, identifying consulted and informed parties.

    Info-Tech has a dedicated blueprint to help you develop the high-level process description into a fully operationalized process. Upon completion of this PPM strategy blueprint, speak to an Info-Tech account manager or analyst to get started.

    Read Info-Tech’s Optimize Project Intake, Prioritization, and Approval blueprint.

    Review and customize slide 24, “Project intake, prioritization, and approval: target state,” in Info-Tech’s PPM Strategic Plan Template.

    Clarity in project prioritization process leads to enterprise-wide buy-in

    CASE STUDY

    Industry: Public Administration
    Source: IAG / Info-Tech Interview

    Challenge

    "Our challenge from the start was to better understand the strategic perspective and priorities of our client departments.

    In addition, much of the work requested was not aligned to corporate goals and efforts, and seemed to be contradictory, redundant, and lacking strategic focus."

    Complicating this challenge was the fact that work requests were being received via all means of communication, which made the monitoring and controlling of requests more difficult.

    Solution

    Client departments were consulted to improve the understanding of their strategic goals and priorities. Based on the consultation:

    • A new, enterprise-wide project prioritization criteria was developed.
    • Priority of project requests from all business areas are evaluated on a quarterly basis.

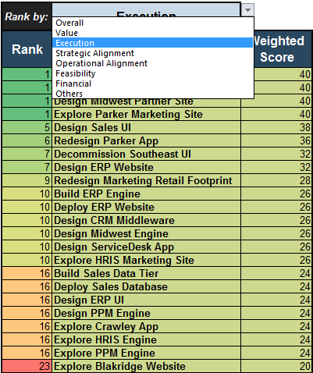

    • A prioritized list of projects are made available to the senior leadership team.

    Results

    "By creating and implementing a tool for departments to prioritize strategic efforts, we helped them consider the important overall project criteria and measure them uniformly, across all anticipated projects. This set a standard of assessment, prioritization, and ranking, which helped departments clearly see which efforts were supportive and matched their strategic goals."

    Resource management process ensures that projects get the resources they need

    Reclaim project capacity: properly allocate project work and establish more stable project timelines.

    Questions

    • Who assigns the resources?
    • Who feeds the data on resources?
    • How do we make sure it’s valid?
    • How do we handle contingencies when projects are late, or if availability changes?

    Benefits

    • Ensure that approved projects can be completed by aligning intake with real project capacity.
    • Reduce over-allocation of resources by allocating based on their proportion of project vs. non-project work.
    • Forecast future resource requirements by maintaining accurate resource capacity data.

    Challenges

    • Time tracking can be difficult when project workers balance project work with “keep the lights on” activities and other administrative work.
    • Continuous partial attention, interruptions, and distractions are a part of today’s reality that makes it very difficult to maximize productivity.
    A see-saw balancing 'Resource availability' on one side and 'Ongoing projects, Operational work, Administrative work, and Resource absence' on the other side.

    Maintain reliable resourcing data with a recurrent resource management practice

    Info-Tech recommends following a five-step process for resource management.

    A diagram of Info-Tech's five-step process for resource management. There are five groups that may be involved in any one step, they are laid out on the side as row headers that each step's columns may fall into, 'Resources', 'Resource Managers', 'Project Managers', 'PMO', and 'Governance Layer'. The first step is 'Collect resource availability' which involves 'Resources' and 'Resource Managers'. Step 2 is 'Collect resource demand' which involves 'Resource Managers', 'Project Managers' and 'PMO'. Step 3 is 'Identify need for reconciliation' which involves 'PMO'. Step 4 is 'Resolve conflicts and smoothen resource allocations' which involves 'Resource Managers', 'Project Managers' and 'PMO'. Step 5 is 'Report resource allocations and forecast' which involves all groups, with an attached note that reads 'Ensure that up-to-date information is available for project approval, portfolio reporting, closure, etc.'

    Info-Tech Insight

    This process aims to control the resource supply to meet the demand – project and non-project alike. Coordinate this process with the intake, approval, and prioritization process.

    Determine your resource management process capability level

    Associated Activity icon 2.1.2a – 10 minutes

    INPUT: Organizational strategy and culture

    OUTPUT: Resource management capability level

    Materials: PPM Strategy Development Tool

    Participants: PMO Director/ Portfolio Manager, Project Managers, Resource Managers, Business Analysts

    Kick-off the discussion about the resource management process by reading the capability level descriptions below and discussing which level currently applies to you the most.

    Capability Level Descriptions

    Capability Level 5: OptimizedOur organization has an accurate picture of project versus non-project work loads and allocates resources accordingly. We periodically reclaim lost capacity through organizational and behavioral change.
    Capability Level 4: AlignedWe have an accurate picture of how much time is spent on project versus non-project work. We allocate resources to these projects accordingly. We are checking in on project progress bi-weekly.
    Capability Level 3: PixelatedWe are allocating resources to projects and tracking progress monthly. We have a rough estimate of how much time is spent on project versus non-project work.
    Capability Level 2: OpaqueWe match resources teams to projects and check in annually, but we do not forecast future resource needs or track project versus non-project work.
    Capability Level 1: UnmanagedOur organization expects projects to be finished, but there is no process in place for allocating resources or tracking project progress.

    Benchmark the current resource management process against strategy-aligned goals

    Associated Activity icon 2.1.2b – 1-2 hours

    INPUT: Documentation describing the current process (e.g. standard operating procedures), Process goals from activity 1.2.1

    OUTPUT: Retrospective review of current process

    Materials: 4x6” recipe cards, Whiteboard

    Participants: PMO Director/ Portfolio Manager, Project Managers, Resource Managers, Business Analysts

    Conduct a table-top planning exercise to map out the process currently in place.

    1. Use white 4”x6” recipe cards to write unique steps of a process. Use the resource management process from the previous slides as a guide.
    2. Use green cards to write artifacts or deliverables that result from a step.
    3. Use pink cards to write issues, problems, or risks.
    4. Discuss how the process could better achieve the strategy-aligned goals from activity 1.2.1. Keep a list of possible changes in the form of a start-stop-continue retrospective (example below) on a whiteboard.
    Start Stop Continue
    • Collect project actuals
    • Make enhancements to the PPM tool in use
    • Over allocating resources
    • “Around the room” reporting at monthly meeting
    • Send project updates before resource management meetings

    Set near- and long-term action items for the resource management process

    Associated Activity icon 2.1.2c – 30 minutes - 1 hour

    INPUT: Outcome of the retrospective review, Process goals and metrics from activity 1.2.1

    OUTPUT: Action items for evolving the process to a target state

    Materials: Whiteboard

    Participants: PMO Director/ Portfolio Manager, Project Managers, Resource Managers, Business Analysts

    Analyze each item in the start-stop-continue retrospective to compile a set of near-term and long-term action items.

    The near-term plan should include steps that are within the authority of the PMO and do not require approval or investment outside of that authority. The long-term plan should include steps that may require a longer approval process, buy-in of external stakeholders, and the investment of time and money.
    Near-Term Action Items Long-Term Action Items
    For example:
    • Determine the percentage of project vs. non-project work through implementation of a weekly survey.
    For example:
    • Reduce resource waste to 6%.
    • Forecast resource requirements monthly.
    • Implement a mid-market PPM tool.

    Review and customize slide 26, “Resource management: action items,” in Info-Tech’s PPM Strategic Plan Template.

    Draft a high-level description of the resource management process at a target state

    Associated Activity icon 2.1.2d – 1-2 hours

    INPUT: Action items for evolving the process to a target state

    OUTPUT: High-level description of the process at the target state

    Materials: Whiteboard, PPM Strategy Development Tool

    Participants: PMO Director/ Portfolio Manager, Project Managers, Resource Managers, Business Analysts

    1. Break down the process into several tasks at a high level. Avoid getting into too much detail by limiting the number of steps.
    2. An example of high-level breakdown: resource management
      Collect resource availability –› Collect resource demand –› Identify need for reconciliation –› Resolve conflicts and over-allocation –› Update resource forecast

    3. Describe each task by answering the following questions. Document your response in the PPM Strategic Plan Template.
    4. Question

      Description

      Input What information do you need to perform the work?
      Output What artifacts/deliverables are produced as a result?
      Frequency/Timing How often, and when, will the work be performed?
      Responsibility Who will perform the work?
      Accountability Who will approve the work and assume the ownership of any decisions?

    5. Record the time cost of each process using the PPM Strategy Development Tool.

    Document the high-level description for the new resource management process

    Associated Activity icon 2.1.2e – 30 minutes - 1 hour

    INPUT: High-level description of the process at the target state

    OUTPUT: Updated PPM strategic plan

    Materials: PPM Strategic Plan Template

    Participants: PMO Director/ Portfolio Manager

    Update your PPM strategic plan with the new high-level description for the new resource management process. Depending on your current process capability level, you may wish to include additional information on your strategic plan, for example:

    • Resource management meeting agenda template
    • Roles and responsibility matrix, identifying consulted and informed parties

    Info-Tech has a dedicated blueprint to help you develop the high-level process description into a fully operationalized process. Upon completion of this PPM strategy blueprint, speak to an Info-Tech account manager or analyst to get started.

    Read Info-Tech’s Develop a Resource Management for the New Reality blueprint.

    Review and customize slide 27, “Resource management: target state,” in Info-Tech’s PPM Strategic Plan Template.

    Step 2.2: Develop and refine portfolio reporting, project closure, and benefits realization processes

    PHASE 1

    PHASE 2

    PHASE 3

    1.11.22.12.23.13.2
    Choose the right PPM strategyTranslate strategy into process goalsDefine intake & resource mgmt. processesDefine reporting, closure, & benefits mgmt. processesSelect a right-sized PPM solutionFinalize your PPM strategic plan

    This step will walk you through the following activities:

    • Determine your process maturity.
    • Benchmark current processes against strategy-aligned goals.
    • Set near- and long-term action items.
    • Draft a high-level description of your target state.
    • Document your new processes.

    This step involves the following participants:

    • PMO Director/Portfolio Manager
    • Project Managers
    • Business Analysts

    Outcomes of this step

    • A definition of current and target state maturity levels for portfolio reporting, project closure, and benefits realization
    • Near-term and long-term process goals for portfolio reporting, project closure, and benefits realization
    • A high-level wireframe for your portfolio reporting, project closure, and benefits realization process steps

    Portfolio reporting process makes trustworthy data accessible for informing decisions

    Giving stakeholders the ability to make informed decisions is the most important function of managing the project portfolio.

    Questions

    • What project information should be reported?
    • Who reports on project status?
    • When and how do we report on the status of the project portfolio?

    Benefits

    • Reporting is the linchpin of any successful PPM strategy.
    • Timely and accurate status reports enable decision makers to address issues risks and issues before they create bigger problems.
    • Executive visibility can be achieved with or without a commercial tool using spreadsheets, a content management system such as SharePoint, or a combination of tools you already have.

    Challenges

    • Trying to increase detailed visibility too fast leads to difficulty gathering and maintaining data. As a result, reporting is rarely accurate and people quickly lose trust in the portfolio.
    • If you are planning to adopt a commercial tool, Info-Tech strongly recommends validating your organization’s ability to maintain a consistent reporting process using simple tools before investing in a more sophisticated system.

    Info-Tech Insight

    If you can only do one thing, establish frequently current reporting on project status. Reporting doesn’t have to be detailed or precise, as long as it’s accurate.

    Maintain reliable portfolio status data with a recurrent status and progress reporting practice

    Info-Tech recommends following a four-step process for portfolio status and progress reporting.

    A diagram of Info-Tech's four-step process for portfolio status and progress reporting. There are four groups that may be involved in any one step, they are laid out on the side as row headers that each step's columns may fall into, 'Resources', 'Project Managers', 'PMO', and 'Governance Layer'. The first step is 'Create project status reports' which involves 'Resources' and 'Project Managers'. Step 2 is 'Create a project portfolio status report' which involves 'Project Managers' and 'PMO', with a note that reads 'Ensure that up-to-date information is available for project approval, resource management, closure, etc.' Step 3 is 'Report on project portfolio status' which involves 'PMO' and 'Governance layer'. Step 4 is 'Act on portfolio steering decisions' which involves 'Resources', 'Project Managers' and 'PMO'.

    Start by establishing a regular reporting cadence with lightweight project status KPIs:

    Red Issue or risk that requires intervention For projects that are red or yellow, high-level status reports should be elaborated on with additional comments on budget, estimated hours/days until completion, etc.
    Yellow Issue or risk that stakeholders should be aware of
    Green No significant risks or issues

    Determine your resource management process capability level

    Associated Activity icon 2.2.1a – 10 minutes

    INPUT: Organizational strategy and culture

    OUTPUT: Portfolio reporting capability level

    Materials: PPM Strategy Development Tool

    Participants: PMO Director/ Portfolio Manager, Project Managers

    Kick-off the discussion about the portfolio reporting process by reading the capability level descriptions below and discussing which level currently applies to you the most.

    Capability Level Descriptions

    Capability Level 5: OptimizedWith the right tools, we can ensure that all projects are planned and maintained at a detailed task level with high-quality estimates, and that actual task progress is updated at least weekly.
    Capability Level 4: AlignedWe have the skills, knowledge, and resources needed to prepare a detailed cost-benefit analysis for all proposed projects. We track the progress throughout project execution.
    Capability Level 3: InterventionWith the right tools, we can ensure that project issues and risks are identified and addressed on a regular basis (e.g. at least monthly) for all projects.
    Capability Level 2: OversightWith the right tools, we can ensure that project status updates are revised on a regular basis (e.g. at least monthly) for all ongoing projects.
    Capability Level 1: ReactiveProject managers escalate issues directly with their direct supervisor or project sponsor because there is no formal PPM practice.

    Benchmark the current portfolio reporting process against strategy-aligned goals

    Associated Activity icon 2.2.1b – 1-2 hours

    INPUT: Documentation describing the current process (e.g. standard operating procedures), Process goals from activity 1.2.1

    OUTPUT: Retrospective review of current process

    Materials: 4x6” recipe cards, Whiteboard

    Participants: PMO Director/ Portfolio Manager, Project Managers

    Conduct a table-top planning exercise to map out the process currently in place.

    1. Use white 4”x6” recipe cards to write unique steps of a process. Use the portfolio reporting process from the previous slides as a guide.
    2. Use green cards to write artifacts or deliverables that result from a step.
    3. Use pink cards to write issues, problems, or risks.
    4. Discuss how the process could better achieve the strategy-aligned goals from activity 1.2.1. Keep a list of possible changes in the form of a start-stop-continue retrospective (example below) on a whiteboard.
    Start Stop Continue
    • Report on lightweight KPIs
    • Standardize the status reports
    • Project managers waiting too long before declaring a red status
    • Produce weekly project portfolio-wide report for senior leadership

    Set near- and long-term action items for the portfolio reporting process

    Associated Activity icon 2.2.1c – 30 minutes - 1 hour

    INPUT: Outcome of the retrospective review, Process goals and metrics from activity 1.2.1

    OUTPUT: Action items for evolving the process to a target state

    Materials: Whiteboard

    Participants: PMO Director/ Portfolio Manager, Project Managers

    Analyze each item in the start-stop-continue retrospective to compile a set of near-term and long-term action items.

    The near-term plan should include steps that are within the authority of the PMO and do not require approval or investment outside of that authority. The long-term plan should include steps that may require a longer approval process, buy-in of external stakeholders, and the investment of time and money.
    Near-Term Action Items Long-Term Action Items
    For example:
    • Establish a reporting process that can be consistently maintained using lightweight KPIs.
    • Provide a simple dashboard that stakeholders can use to see their project status reports at a high level.
    For example:
    • Adopt a commercial tool for maintaining consistent status reports.
    • Support the tool with training and a mandate of adoption among all users.

    Review and customize slide 29, “Portfolio reporting: action items,” in Info-Tech’s PPM Strategic Plan Template.

    Draft a high-level description of the portfolio reporting process at a target state

    Associated Activity icon 2.2.1d – 1-2 hours

    INPUT: Action items for evolving the process to a target state

    OUTPUT: High-level description of the process at the target state

    Materials: Whiteboard, PPM Strategy Development Tool

    Participants: PMO Director/ Portfolio Manager, Project Managers

    1. Break down the process into several tasks at a high level. Avoid getting into too much detail by limiting the number of steps.
    2. An example of high-level breakdown: portfolio reporting
      Create project status reports –› Create a project portfolio status report –› Report on project portfolio status –› Act on portfolio steering decisions

    3. Describe each task by answering the following questions. Document your response in the PPM Strategic Plan Template.
    4. Question

      Description

      InputWhat information do you need to perform the work?
      OutputWhat artifacts/deliverables are produced as a result?
      Frequency/TimingHow often, and when, will the work be performed?
      ResponsibilityWho will perform the work?
      AccountabilityWho will approve the work and assume the ownership of any decisions?

    5. Record the time cost of each process using the PPM Strategy Development Tool.

    Document the high-level description for the new portfolio reporting process

    Associated Activity icon 2.2.1e – 30 minutes - 1 hour

    INPUT: High-level description of the process at the target state

    OUTPUT: Updated PPM strategic plan

    Materials: PPM Strategic Plan Template

    Participants: PMO Director/ Portfolio Manager

    Update your PPM strategic plan with the new high-level description for the new portfolio reporting process. Depending on your current process capability level, you may wish to include additional information on your strategic plan, for example:

    • Updated project status report template with new KPIs.
    • Documentation of requirements for improved PPM dashboards and reports.

    Info-Tech has a dedicated blueprint to help you develop the high-level process description into a fully operationalized process. Upon completion of this PPM strategy blueprint, speak to an Info-Tech account manager or analyst to get started.

    Read Info-Tech’s Enhance PPM Dashboards and Reports blueprint.

    Review and customize slide 30, “Portfolio reporting: target state,” in Info-Tech’s PPM Strategic Plan Template.

    Streamlined status reporting improves portfolio visibility for executives, enabling data-driven steering of the portfolio

    CASE STUDY

    Industry: Public Administration
    Source: IAG / Info-Tech Interview

    Challenge

    The client had no effective real-time reporting in place to summarize their work efforts. In addition, the client struggled with managing existing resources against the ability to deliver on the requested project workload.

    Existing project reporting processes were manually intensive and lacked mature reporting capabilities.

    Solution

    Through a short and effective engagement, IAG conducted surveys and facilitated interviews to identify the information needed by each stakeholder. From this analysis and industry best practices, IAG developed scorecards, dashboards, and project summary reports tailored to the needs of each stakeholder group. This integrated reporting tool was then made available on a central portal for PPM stakeholders.

    Results

    Stakeholders can access project scorecard and dashboard reports that are available at any given time.

    Resource reporting enabled the PMO to better balance client demand with available project capacity and forecast any upcoming deficiencies in resourcing that affect project delivery.

    Project closure at the portfolio level controls throughput and responsiveness of the portfolio

    Take control over projects that linger on, projects that don’t provide value, and projects that do not align with changing organizational priority.

    Questions

    • Who declares that a project is done?
    • Who validates it?
    • Who is this reported to?
    • Who terminates low-value projects?
    • How will they decide that a project is too low value to continue?

    Benefits

    • Minimize post-implementation problems by ensuring clean handoffs, with clear responsibilities for ongoing support and maintenance.
    • Drive continuous improvement by capturing and applying lessons learned.
    • Increase the project portfolio’s responsiveness to change by responding to emerging opportunities and challenges.

    Challenges

    • Completion criteria and “definition of done” need to be well defined and done so at project initiation.
    • Scope changes need to be managed and documented throughout the project.
    • Portfolio responsiveness requires deep cultural changes that will be met with confusion and resistance from some stakeholders.

    Info-Tech Insight

    Although “change in organizational priority” is the most frequently cited cause of project failure (PMI Pulse of Profession, 2017), closing projects that don’t align with organizational priority ought to be a key PPM goal. Therefore, don’t think of it as project failure; instead, think of it as PPM success.

    Maintain the health of the project portfolio with a repeatable project closure process

    Info-Tech recommends following a four-step process for project closure.

    A diagram of Info-Tech's four-step process for project closure. There are five groups that may be involved in any one step, they are laid out on the side as row headers that each step's columns may fall into, 'Resources', 'Resource Managers', 'Project Managers', 'PMO', and 'Governance Layer'. The first steps are 'Complete project' which involves 'Project Managers', and 'Terminate low value projects' which involves 'PMO' and 'Governance layer'. Step 2 is 'Validate project closure' which involves 'Project Managers' and 'PMO', with a note that reads 'This includes facilitating the project sponsor sign-off, accepting and archiving lessons learned documents, etc.' The third steps are 'Conduct post-project work' which involves 'Project Managers' and 'PMO', and 'Update resource availability' which includes 'Resource Managers'. Step 4 is 'Conduct post-implementation review' which involves all groups.

    Info-Tech Best Practice

    Post-implementation review checks which benefits (including those set out in the business case) have been achieved and identifies opportunities for further improvement. Without it, it can be difficult to demonstrate that investment in a project was worthwhile.

    Determine your project closure process capability level

    Associated Activity icon 2.2.2a – 10 minutes

    INPUT: Organizational strategy and culture

    OUTPUT: Project closure capability level

    Materials: PPM Strategy Development Tool

    Participants: PMO Director/ Portfolio Manager, Project Managers, Business Analysts

    Kick-off the discussion about the project closure process by reading the capability level descriptions below and discussing which level currently applies to you the most.

    Capability Level Descriptions

    Capability Level 5: OptimizedProject closure is centrally managed and supports post-project benefits tracking.
    Capability Level 4: AlignedProject closure is centrally managed at the portfolio level to ensure completion/acceptance criteria are satisfied.
    Capability Level 3: EngagedProject closure is confirmed at the portfolio level, but with minimal enforcement of satisfaction of completion/acceptance criteria.
    Capability Level 2: EncouragedProject managers often follow handoff and closure procedures, but project closure is not confirmed or governed at the portfolio level.
    Capability Level 1: UnmanagedProject closure is not governed at either the project or portfolio level.

    Benchmark the current project closure process against strategy-aligned goals

    Associated Activity icon 2.2.2b – 1-2 hours

    INPUT: Documentation describing the current process (e.g. standard operating procedures), Process goals from activity 1.2.1

    OUTPUT: Retrospective review of current process

    Materials: 4x6” recipe cards, Whiteboard

    Participants: PMO Director/ Portfolio Manager, Project Managers, Business Analysts

    Conduct a table-top planning exercise to map out the process currently in place.

    1. Use white 4”x6” recipe cards to write unique steps of a process. Use the project closure process from the previous slides as a guide.
    2. Use green cards to write artifacts or deliverables that result from a step.
    3. Use pink cards to write issues, problems, or risks.
    4. Discuss how the process could better achieve the strategy-aligned goals from activity 1.2.1. Keep a list of possible changes in the form of a start-stop-continue retrospective (example below) on a whiteboard.
    Start Stop Continue
    • Conduct reprioritization of projects at a regular cadence
    • Prune projects every year
    • Waive post-implementation review for time-constrained projects
    • Collect project post-mortem reports and curate in PMO SharePoint

    Set near- and long-term action items for the project closure process

    Associated Activity icon 2.2.2c – 30 minutes - 1 hour

    INPUT: Outcome of the retrospective review, Process goals and metrics from activity 1.2.1

    OUTPUT: Action items for evolving the process to a target state

    Materials: Whiteboard

    Participants: PMO Director/ Portfolio Manager, Project Managers, Resource Managers, Business Analysts

    Analyze each item in the start-stop-continue retrospective to compile a set of near-term and long-term action items.

    The near-term plan should include steps that are within the authority of the PMO and do not require approval or investment outside of that authority. The long-term plan should include steps that may require a longer approval process, buy-in of external stakeholders, and the investment of time and money.
    Near-Term Action Items Long-Term Action Items
    For example:
    • Begin establishing project closure criteria in the project initiation process.
    • Manage and document scope changes throughout the project.
    For example:
    • Institute a formal process to ensure that all projects are closed at the portfolio level and properly handed off to support and maintenance teams.

    Review and customize slide 32, “Project closure: action items,” in Info-Tech’s PPM Strategic Plan Template.

    Draft a high-level description of the project closure process at a target state

    Associated Activity icon 2.2.2d – 1-2 hours

    INPUT: Action items for evolving the process to a target state

    OUTPUT: High-level description of the process at the target state

    Materials: Whiteboard, PPM Strategy Development Tool

    Participants: PMO Director/ Portfolio Manager, Project Managers, Resource Managers, Business Analysts

    1. Break down the process into several tasks at a high level. Avoid getting into too much detail by limiting the number of steps.
    2. An example of high-level breakdown: project closure
      Complete or terminate projects –› Validate project closure –› Conduct post-project work –› Conduct post-implementation review

    3. Describe each task by answering the following questions. Document your response in the PPM Strategic Plan Template.
    4. Question

      Description

      Input What information do you need to perform the work?
      Output What artifacts/deliverables are produced as a result?
      Frequency/Timing How often, and when, will the work be performed?
      Responsibility Who will perform the work?
      Accountability Who will approve the work and assume the ownership of any decisions?

    5. Record the time cost of each process using the PPM Strategy Development Tool.

    Document the high-level description for the new project closure process

    Associated Activity icon 2.2.2e – 30 minutes - 1 hour

    INPUT: High-level description of the process at the target state

    OUTPUT: Updated PPM strategic plan

    Materials: PPM Strategic Plan Template

    Participants: PMO Director/ Portfolio Manager

    Update your PPM strategic plan with the new high-level description for the new project closure process. Depending on your current process capability level, you may wish to include additional information on your strategic plan, for example:

    • Updated project closure checklist.
    • Project value review meeting process document.
    • Post-implementation review process document.

    Info-Tech has several research notes that elaborate on aspects of project closure. Upon completion of this PPM strategy blueprint, speak to an Info-Tech account manager or analyst to get started.

    Read Info-Tech’s research notes on project closure:

    • The Importance of Conducting a Post Implementation Review
    • Five Key Steps to Mastering Project Closure
    • ‘Governance’ Will Kill Your Projects

    Review and customize slide 33, “Project closure: target state,” in Info-Tech’s PPM Strategic Plan Template.

    Validate the time and effort spent on projects with a benefits realization process

    Maximizing benefits from projects is the primary goal of PPM. Tracking and reporting on benefits post-project closes the loop on benefits.

    Questions

    • How do validate the project benefits from the original business case?
    • How do we track the benefits?
    • Who reports it? When?

    Benefits

    • Maximize benefits realization by identifying and addressing unforeseen issues or limitations to success.
    • Improve project approval and prioritization by improving validity of the business case definition process.

    Challenges

    • Project sponsors need to be willing to invest time – months and years post-project completion – to validate benefits realization.
    • Portfolio management needs to proactively work with sponsors to facilitate benefits tracking.
    • Business cases need to be well developed and documented to reflect real anticipated benefits.

    Too many projects fail to achieve the originally proposed benefits, and too few organizations are able to identify and address the root causes of those shortfalls.

    Info-Tech Insight

    In reality, benefits realization process extends across the entire project life cycle: during intake, during the execution of the project, and after project completion. Be mindful of this extended scope when you discuss benefits realization in the following activity.

    Keep project benefits front and center with a repeatable benefits realization process

    Info-Tech recommends following a four-step process for benefits realization.

    A diagram of Info-Tech's four-step process for benefits realization. There are four groups that may be involved in any one step, they are laid out on the side as row headers that each step's columns may fall into, 'Business Analysts', 'Project Managers', 'PMO', and 'Governance Layer'. The first step is 'Quantify and validate benefits in business case' which happens 'Before Project' and involves 'Business Analysts' and 'Project Managers'. Step 2 is 'Update projected project benefits' which happens 'During Project' and involves 'Project Managers' and 'PMO'. Step 3 is 'Hand-off benefits realization ownership' which happens at the end of project and involves 'Project Managers', 'PMO' and 'Governance layer'. Step 4 is 'Monitor and report on benefits' which happens 'After Project' and involves 'PMO' and 'Governance layer'.

    Info-Tech Insight

    At the heart of benefits realization is accountability: who is held accountable for projects that don’t realize the benefits and how? Without the buy-in from the entire executive layer team, addressing this issue is very difficult.

    Determine your benefits realization process capability level

    Associated Activity icon 2.2.3a – 10 minutes

    INPUT: Organizational strategy and culture

    OUTPUT: benefits realization capability level

    Materials: PPM Strategy Development Tool

    Participants: PMO Director/ Portfolio Manager, Project Managers, Resource Managers, Business Analysts

    Kick-off the discussion about the benefits realization process by reading the capability level descriptions below and discussing which level currently applies to you the most.

    Capability Level Descriptions

    Capability Level 5: OptimizedProject sponsors and key stakeholders are accountable for stated project benefits before, during and after the project. There is a process to maximize the realization of project benefits.
    Capability Level 4: AlignedProject benefits are forecasted and taken into account for approval, updated when changes are made to the project, and monitored/reported after projects are completed.
    Capability Level 3: EngagedProject benefits are forecasted and taken into account for approval, and there is a loosely defined process to report on benefits realization.
    Capability Level 2: DefinedProject benefits are forecasted and taken into account for approval, but there is no process to monitor whether the said benefits are realized.
    Capability Level 1: UnmanagedProjects are approved and initiated without discussing benefits.

    Benchmark the current benefits realization process against strategy-aligned goals

    Associated Activity icon 2.2.3b – 1-2 hours

    INPUT: Documentation describing the current process (e.g. standard operating procedures), Process goals from activity 1.2.1

    OUTPUT: Retrospective review of current process

    Materials: 4x6” recipe cards, Whiteboard

    Participants: PMO Director/ Portfolio Manager, Project Managers, Resource Managers, Business Analysts

    Conduct a table-top planning exercise to map out the process currently in place.

    1. Use white 4”x6” recipe cards to write unique steps of a process. Use the benefits realization process from the previous slides as a guide.
    2. Use green cards to write artifacts or deliverables that result from a step.
    3. Use pink cards to write issues, problems, or risks.
    4. Discuss how the process could better achieve the strategy-aligned goals from activity 1.2.1. Keep a list of possible changes in the form of a start-stop-continue retrospective (example below) on a whiteboard.
    StartStopContinue
    • Require “hard monetary value” in business benefits
    • Send project updates before resource management meetings

    Set near- and long-term action items for the benefits realization process

    Associated Activity icon 2.2.3c – 30 minutes - 1 hour

    INPUT: Outcome of the retrospective review, Process goals and metrics from activity 1.2.1

    OUTPUT: Action items for evolving the process to a target state

    Materials: Whiteboard

    Participants: PMO Director/ Portfolio Manager, Project Managers, Resource Managers, Business Analysts

    Analyze each item in the start-stop-continue retrospective to compile a set of near-term and long-term action items.

    The near-term plan should include steps that are within the authority of the PMO and do not require approval or investment outside of that authority. The long-term plan should include steps that may require a longer approval process, buy-in of external stakeholders, and the investment of time and money.
    Near-Term Action Items Long-Term Action Items
    For example:
    • Create an “orientation for project sponsors” document.
    • Encourage project managers to re-validate project benefits on an ongoing basis and report any deviation.
    For example:
    • Recruit the finance department’s help in benefits tracking.
    • Require Finance’s sign-off on project benefits in business cases during intake.

    Review and customize slide 35, “Benefits realization: action items,” in Info-Tech’s PPM Strategic Plan Template.

    Draft a high-level description of the benefits realization process at a target state

    Associated Activity icon 2.2.3d – 1-2 hours

    INPUT: Action items for evolving the process to a target state

    OUTPUT: High-level description of the process at the target state

    Materials: Whiteboard, PPM Strategy Development Tool

    Participants: PMO Director/ Portfolio Manager, Project Managers, Resource Managers, Business Analysts

    1. Break down the process into several tasks at a high level. Avoid getting into too much detail by limiting the number of steps.
    2. An example of high-level breakdown: benefits realization
      Validate benefits in business case –› Update project benefits during execution –› Hand-off benefits ownership –› Monitor and report on benefits

    3. Describe each task by answering the following questions. Document your response in the PPM Strategic Plan Template.
    4. Question

      Description

      InputWhat information do you need to perform the work?
      OutputWhat artifacts/deliverables are produced as a result?
      Frequency/TimingHow often, and when, will the work be performed?
      ResponsibilityWho will perform the work?
      AccountabilityWho will approve the work and assume the ownership of any decisions?

    5. Record the time cost of each process using the PPM Strategy Development Tool.

    Document the high-level description for the new benefits realization process

    Associated Activity icon 2.2.3e – 30 minutes - 1 hour

    INPUT: High-level description of the process at the target state

    OUTPUT: Updated PPM strategic plan

    Materials: PPM Strategic Plan Template

    Participants: PMO Director/ Portfolio Manager

    Update your PPM strategic plan with the new high-level description for the new benefits realization process. Depending on your current process capability level, you may wish to include additional information on your strategic plan, for example:

    • Updated business plan templates.
    • Communication plan for project sponsors.

    Info-Tech has a dedicated blueprint to help you develop the high-level process description into a fully operationalized process. Upon completion of this PPM strategy blueprint, speak to an Info-Tech account manager or analyst to get started.

    Read Info-Tech’s Establish the Benefits Realization Process blueprint.

    Review and customize slide 36, “Benefits realization: target state,” in Info-Tech’s PPM Strategic Plan Template.

    If you want additional support, have our analysts guide you through this phase as part of an Info-Tech Workshop Associated Activity icon

    Book a workshop with our Info-Tech analysts:

    Photo of Barry Cousins.
    • To accelerate this project, engage your IT team in an Info-Tech workshop with an Info-Tech analyst team.
    • Info-Tech analyst will join you and your team onsite at your location or welcome you to Info-Tech's historic Toronto office to participate in an innovative onsite workshop.
    • Contact your account manager (www.infotech.com/account), or email Workshops@InfoTech.com for more information.

    The following are sample activities that will be conducted by Info-Tech analysts with your team:

    Sample of activity 2.1.1 'Align your project intake, prioritization, and approval process to the PPM strategy'. Align your project intake, prioritization, and approval process to the PPM strategy

    Examine the process at the current state and develop an action plan to improve it, with a high-level description of the process at a target state and its overhead costs. The outcome of this activity feeds into the overall PPM strategic plan.

    Sample of activity 2.1.2 'Align your resource management process to the PPM strategy'. Align your resource management process to the PPM strategy

    Examine the process at the current state and develop an action plan to improve it, with a high-level description of the process at a target state and its overhead costs. The outcome of this activity feeds into the overall PPM strategic plan.

    If you want additional support, have our analysts guide you through this phase as part of an Info-Tech Workshop Associated Activity icon

    Book a workshop with our Info-Tech analysts:

    Sample of activity 2.2.1 'Align your portfolio reporting process to the PPM strategy'.Align your portfolio reporting process to the PPM strategy

    Examine the process at the current state and develop an action plan to improve it, with a high-level description of the process at a target state and its overhead costs. The outcome of this activity feeds into the overall PPM strategic plan.

    Sample of activity 2.2.2 'Align your project closure process to the PPM strategy'.Align your project closure process to the PPM strategy

    Examine the process at the current state and develop an action plan to improve it, with a high-level description of the process at a target state and its overhead costs. The outcome of this activity feeds into the overall PPM strategic plan.

    Sample of activity 2.2.3 'Align your benefits realization process to the PPM strategy'.Align your benefits realization process to the PPM strategy

    Examine the process at the current state and develop an action plan to improve it, with a high-level description of the process at a target state and its overhead costs. The outcome of this activity feeds into the overall PPM strategic plan.

    Develop a Project Portfolio Management Strategy

    PHASE 3

    Complete Your PPM Strategic Plan

    Phase 2 outline

    Associated Activity icon Call 1-888-670-8889 or email GuidedImplementations@InfoTech.com for more information.

    Complete these steps on your own, or call us to complete a guided implementation. A guided implementation is a series of 2-3 advisory calls that help you execute each phase of a project. They are included in most advisory memberships.

    Guided Implementation 3: Complete your PPM strategic plan

    Proposed Time to Completion: 2 weeks
    Step 3.1: Select a right-sized PPM solutionStep 3.2: Finalize your PPM Strategic Plan Template
    Work with an analyst to:
    • Assess your PPM tool requirements to help support your processes.
    Review findings with analyst:
    • Determine the costs and potential benefits of your PPM strategy.
    Then complete these activities…
    • Determine the functionality requirements of the PPM solution.
    • Estimate your PPM tool budget.
    • Review the tool assessment.
    Then complete these activities…
    • Estimate the total cost-in-use of managing the project portfolio.
    • Estimate the benefits of the PPM strategy.
    • Refine and consolidate the near-term action items into a cohesive implementation plan.
    With these tools & templates:
    • PPM Strategy Development Tool
    With these tools & templates:
    • PPM Strategy Development Tool
    • PPM Strategic Plan Template

    Phase 3 Insight:

    • Approach PPM as an evolving discipline that requires adaptability and long-term organizational change. Near-term process improvements should create stakeholder desire for better portfolio visibility and agility over the long term.

    Step 3.1: Select a right-sized PPM solution for supporting your new processes

    PHASE 1

    PHASE 2

    PHASE 3

    1.11.22.12.23.13.2
    Choose the right PPM strategyTranslate strategy into process goalsDefine intake & resource mgmt. processesDefine reporting, closure, & benefits mgmt. processesSelect a right-sized PPM solutionFinalize your PPM strategic plan

    This step will walk you through the following activities:

    • Determine the functionality requirements of a PPM solution in the near and long terms.
    • Estimate your PPM tool budget.
    • Review tool assessment.

    This step involves the following participants:

    • CIO
    • PMO Director/ Portfolio Manager
    • Project Managers
    • IT Managers

    Outcomes of this step

    • List of functional requirements for a PPM solution
    • An estimate budget and cost for supporting a PPM tool in the near and long terms
    • PPM tool requirements for the near and long terms

    Right-size your PPM solution/tool to fit your PPM processes

    Avoid a common pitfall: the disconnect between PPM processes and PPM tools.

    PPM tools act as both a receptacle for portfolio data generated by your processes and a source of portfolio data to drive your processes forward. Therefore, choosing a suitable PPM tool is critical to the success of your PPM strategy:

    • PPM tool inputs must match the type, level of detail, and amount of portfolio data generated by your PPM processes.
    • PPM tool outputs must be useful, insightful, easy to access, and easy to understand for people who engage in your PPM processes.

    User adoption is an often cited cause of failed PPM tool implementation:

    "The biggest problem is getting the team to work with the tool. We need to make sure that we’re not wasting time delving too far down into the tool, yet putting enough information to get useful information back." (IT Director, Financial Services)

    This final step of the blueprint will discuss the choice of PPM tools to ensure the success of PPM strategy by avoiding the process-tool disconnect.

    Common pitfalls for PPM tools

    • Purchasing and implementing a PPM tool before the process is defined and accepted.
    • Poor expectation setting: inability of tools to perform the necessary analysis.
    • Underleveraged: low user/process adoption.
    • Poor integration with the corporate finance function.
    • (WGroup, 2017)

    Leverage PPM tools to get the information you need

    An optimized PPM solution is the vehicle that provides decision makers with four key pieces of information they require when making decisions for your project portfolio:

    • Historical Insight – inform decision makers about how much time and resources have been spent to date, and benchmark the accuracy of prior project estimates and resource allocations.
    • Forecasting – provide a trustworthy estimate of demand on resources and current projects.
    • Portfolio Analytics – analyze portfolio data and generate easy-to-consume reports that provide answers to questions such as:
      • How big is our overall portfolio?
      • How much money/resource time is available?
      • How efficiently are we using our resources?
    • Project Visibility – provide a trustworthy report on the status of current projects and the resources working on them.

    Info-Tech Insight

    Without the proper information, decision makers are driving blind and are forced to make gut feel decisions as opposed to data-informed decisions. Implement a PPM solution to allocate projects properly and ensure time and money don’t vanish without being accounted for.

    Commercial PPM tools have more functionality but are more costly, complex, and difficult to adopt

    • Granular timesheet management
    • Workflow and team collaboration
    • Robust data and application integration
    • Advanced what-if planning
    • Mobile usability
    A map comparing commercial PPM tools by 'Functionality', 'Cost', and 'Difficulty to implement/adopt'. 'Functionality' and 'Difficulty to implement/adopt' share an axis and can be assumed to have a linear relationship. 'Spreadsheets' are low functionality and low cost. 'Google Sites' are low to middling functionality and low cost. 'SharePoint' is middling functionality with a slightly higher cost. The next three start at middling cost and above-average functionality and trend higher in both categories: 'Commercial Entry-Level PPM', 'Commercial Mid-Market PPM', and 'Commercial Enterprise PPM'.
    • Business case scoring and prioritization
    • Multi-user reporting and request portal
    • High-level resource management
    • Project status, cost, and risk tracking

    "Price tags [for PPM tools] vary considerably. Expensive products don't always provide more capability. Inexpensive products are generally low cost for good reason." (Merkhofer)

    Your PPM tool options are not limited to commercial offerings

    Despite the rapid growth in the commercial PPM tool market today, homegrown approaches like spreadsheets and intranet sites continue to be used as PPM tools.

    Kinds of PPM solutions used by Info-Tech clients

    A pie chart visualizing the kinds of PPM solutions that are used by Info-Tech clients. There are three sections, the largest of which is 'Spreadsheet-based, 46%', then 'Commercial, 33%', then 'No solution, 21%'. (Source: Info-Tech Research Group (2016), N=433)

    Category

    Characteristics

    PPM maturity

    Enterprise tool
    • Higher professional services requirements for enterprise deployment
    • Larger reference customers
    High
    Mid-market tool
    • Lower expectation of professional services engaged in initial deployment contract
    • Fewer globally recognizable reference clients
    • Faster deployments
    High
    Entry-level tool
    • Lower cost than mid-market & enterprise PPM tools
    • Limited configurability, reporting, and resource management functionalities
    • Compelling solutions to the organizations that wants to get a fast start to a trial deployment
    Intermediate
    Spreadsheet based
    • Little/no up-front cost, highly customizable to suit your organization’s needs
    • Varying degrees of sophistication
    • Few people in the organization may understand the logic behind the tool; knowledge may not be easily transferrable
    Intermediate Low

    Determine the functional requirements of the PPM solution

    Associated Activity icon 3.1.1 – 20 minutes

    INPUT: PPM strategic plan

    OUTPUT: Modified PPM strategic plan with a proposed choice of PPM tool

    Materials: PPM Strategy Development Tool

    Participants: PMO Director/ Portfolio Manager, Project Managers, IT Managers

    Use the Tool Assessment tab (tab 4) of Info-Tech’s PPM Strategy Development Tool to rate and analyze functional requirements of your PPM solution.

    • Review the list of PPM features provided on column B of tab 4. You can add any desired features not listed.
    • Rate your near-term and long-term feature requirements using the drop-down menus in columns C and D. Your selections here will inform the tool selection bubble chart to the right of the features list.

    Screenshot showing the features list on tab 4 of the PPM Strategy Development Tool.

    Estimate your PPM tool budget

    Associated Activity icon 3.1.2 – 20 minutes

    INPUT: PPM strategic plan

    OUTPUT: Modified PPM strategic plan with a proposed choice of PPM tool

    Materials: PPM Strategy Development Tool

    Participants: CIO, PMO Director/ Portfolio Manager, Project Managers, IT Managers

    Enter the PPM tool budget information on the Tool Assessment tab of Info-Tech’s PPM Strategy Development Tool.

    • As a starting point, it can help to know that low-priced PPM tools cost around $1,000 per user per year. High-priced PPM tools cost around $3,000 per user per year.
    • Software-as-a-Service (SaaS)-based pricing for PPM solutions is increasingly popular. If you plan to purchase perpetual licensing, divide the total implementation and licensing cost by three years to be comparable with a three-year SaaS total cost of ownership analysis.

    Screenshot showing the tool assessment from the PPM Strategy Development Tool with 'Near-Term' and 'Long-Term' budget columns. Notes include 'Enter the number of fully licensed PPM users you expect to provision for and your estimated annual budget for a PPM tool', 'The tool assessment automatically calculates your annual budget per user, which is reflected in the bubble chart analysis (see next slide)'.

    Review the tool assessment graphic

    Associated Activity icon 3.1.3 – 20 minutes

    The map comparing commercial PPM tools from before, this time overlaid with 'Near-Term' and 'Long-Term' budgets as coloured circles. The vertical axis is 'Functionality Rating' and the horizontal axis is now 'Annual Cost/Budget per User'. 'Spreadsheets' are low functionality and low cost. 'Google Sites' are low to middling functionality and low cost. 'SharePoint' is middling functionality with a slightly higher cost. The 'Near-Term' budget circle covers those three tools. The next three start at middling cost and above-average functionality and trend higher in both categories: 'Commercial Entry-Level PPM', 'Commercial Mid-Market PPM', and 'Commercial Enterprise PPM'. The 'Long-Term' budget circle covers 'Commercial Mid-Market PPM'.

    If you are in one of the non-covered areas, consider revisiting your functional requirements and PPM strategy. You may need to lessen your expectations to be able to stay within your budget, or find a way to get more money.

    Keep in mind that the long-term goal can be to work towards a commercial tool, while the short-term goal would be to be able to maintain your portfolio in a simple spreadsheet first.

    Info-Tech Insight

    If you choose a commercial solution, you will need to gain executive buy-in in order to implement the tool; proceed to near-term and long-term plans to get the ball rolling on this decision.

    Review and customize slide 37, “Tools for PPM: proposed near- and long-term solutions,” in Info-Tech’s PPM Strategic Plan Template.

    Grow your own, or select and implement, a PPM solution with Info-Tech

    Whether you choose spreadsheet-based or commercially available PPM solutions, use Info-Tech’s research for scoping, designing, and implementing them.

    Info-Tech’s Grow Your Own PPM Solution blueprint will help you implement a highly evolved spreadsheet-based PPM solution. It features the Portfolio Manager 2017, a Microsoft Excel-based workbook that leverages its business intelligence features to provide a basis for implementing a scalable, highly customizable PPM tool with useful and easy-to-manipulate analytics.

    Read Info-Tech’s Grow Your Own PPM Solution blueprint.

    Info-Tech’s Select and Implement a PPM Solution blueprint is part of our Vendor Landscape research. Make sense of the diversity of PPM solutions available in today’s market, and choose the most appropriate solutions for your organization’s size and level of PPM maturity.

    Read Info-Tech’s Select and Implement a PPM Solution blueprint.

    A right-sized PPM strategy leads to a right-sized portfolio management tool based on Info-Tech’s template

    CASE STUDY

    Industry: Energy
    Source: Info-Tech Client

    “The approach makes it easy to run the portfolio without taking time away from the project themselves.” (IT Manager, Energy Resources Firm)

    Situation

    • A small IT department struggled with balancing project work with ongoing operational management and support work.
    • The department includes experienced and successful project managers and a mature, skilled team.
    • However, the nature of the department’s role has evolved to the point where the project and operational work demands have exceeded the available time.
    • Prioritization needed to become more centralized and formalized while management control of the work assignments became increasingly decentralized.

    Complication

    • Agile projects offer clear advantages by lightening the requirement for proactive planning. However, getting the staff to adapt would be challenging because of the overall workload and competing priorities.
    • Some of the team’s time needed to be carefully tracked and reported for time & materials-based billing, but the time sheet system was unsuited to their portfolio management needs.
    • Commercial PPM systems were ruled out because strict task management seemed unlikely to gain adoption.

    Resolution

    • The team deployed Info-Tech’s Project Portfolio Workbook, based on a Microsoft Excel template, and the Grow Your Own PPM Solution blueprint.
    • For the first time, executive leadership was given a 12-month forecast of resource capacity based on existing and pending project commitments. The data behind the capacity forecast was based on allocating people to projects with a percentage of their time for each calendar month.
    • The data behind the forecast is high level but easily maintainable.

    Step 3.2: Finalize customizing your PPM Strategic Plan Template

    PHASE 1

    PHASE 2

    PHASE 3

    1.11.22.12.23.13.2
    Choose the right PPM strategyTranslate strategy into process goalsDefine intake & resource mgmt. processesDefine reporting, closure, & benefits mgmt. processesSelect a right-sized PPM solutionFinalize your PPM strategic plan

    This step will walk you through the following activities:

    • Determine the costs of support your PPM strategic plan.
    • Estimate some of the benefits of your PPM strategic plan.
    • Perform a cost-benefit analysis.
    • Refine and consolidate the near-term action items into a cohesive plan.

    This step involves the following participants:

    • CIO
    • PMO Director/ Portfolio Manager
    • Project Managers
    • IT Managers

    Outcomes of this step

    • A cost/benefit analyst
    • An implementation action plan
    • A finalized PPM Strategic Plan Template

    Estimate the total cost-in-use of managing the project portfolio

    Supporting Tool icon 3.2.1 – PPM Strategy Development Tool, Tab 5: Costing Summary

    The time cost of PPM processes (tab 3) and PPM tool costs (tab 4) are summarized in this tab. Enter additional data to estimate the total PPM cost-in-use: the setup information and the current cost of PPM software tools.

    Screenshot of the PPM Strategy Development Tool, Tab 5: Costing Summary. Notes include 'If unknown, the overall HR budget of your project portfolio can be estimated as: (# FTEs) * (fully-loaded FTE cost per hour) * 1800', 'This is your total PPM cost-in-use'.

    Estimate the benefits of managing the project portfolio

    Supporting Tool icon 3.2.2 – PPM Strategy Development Tool, Tab 6: Benefits Assumptions

    The benefits of PPM processes are estimated by projecting the sources of waste on your resource capacity.

    1. Estimate the current extent of waste on your resource capacity. If you have completed Info-Tech’s PPM Current Score Scorecard, enter the data from the report.
    2. Screenshot of a Waste Assessment pie chart from the PPM Strategy Development Tool, Tab 6: Benefits Assumptions.
    3. Given your near- and long-term action items for improving PPM processes, estimate how each source of waste on your resource capacity will change.
    4. Screenshot of a Waste Assessment table titled 'These inputs represent the percentage of your overall portfolio budget that is wasted in each scenario' from the PPM Strategy Development Tool, Tab 6: Benefits Assumptions.

    Review the cost-benefit analysis results and update the PPM Strategic Plan Template

    Supporting Tool icon 3.2.3 – PPM Strategy Development Tool, Tab 7: Conclusion Screenshot of a 'PPM Strategy Cost-Benefit Analysis' from the PPM Strategy Development Tool, Tab 7: Conclusion. It has tables on top and bar charts underneath.

    This tab summarizes the costs and benefits of your PPM strategic plan.

    • Costs are estimated from wasted project capacity and time spent on PPM process work.
    • Benefits are estimated from the project capacity to be reclaimed as a result of improvements in PPM.
    • Return on investment is calculated by dividing the value of project capacity to be reclaimed by investment in PPM in addition to the current-state cost.

    Capture this summary in your PPM strategic plan.

    Customize slides 40 and 41, “Return on PPM investment,” in Info-Tech’s PPM Strategic Plan Template.

    Determine who will be responsible for coordinating the flow, collection, and reporting of portfolio data

    Supporting Tool icon 3.2.3 – Project Portfolio/PMO Analyst Job Description

    You will need to determine responsibilities and accountabilities for portfolio management functions within your team.

    If you do not have a clearly identifiable portfolio manager at this time, you will need to clarify who will wear which hats in terms of facilitating intake and prioritization, high-level capacity awareness, and portfolio reporting.

    • Use Info-Tech’s Project Portfolio Analyst Job Description Template to help clarify some of the required responsibilities to support your PPM strategy.
      • If you need to bring in an additional staff member to help support the strategy, you can customize the job description template to help advertise the position. Simply edit the text in grey within the template.
    • If you have other PPM tasks that you need to define responsibilities for, you can use the RASCI chart on the final tab of the PPM Strategy Develop Tool.

    Download Info-Tech’s Project Portfolio Analyst Job Description Template.

    Sample of Info-Tech's Project Portfolio Analyst Job Description Template.

    Refine and consolidate the near-term action items into a cohesive plan

    Associated Activity icon 3.2.4 – 30 minutes

    INPUT: Near-term action items

    OUTPUT: Near-term action plan

    Materials: PPM Strategy Development Tool

    Participants: PMO Director/ Portfolio Manager, Project Managers, Resource Managers, Business Analysts

    Collect the near-term action items for each of the five PPM processes and arrange them into a table that outlines the near-term action plan. Once it is compiled, adjust the timeline and responsibility so that the plan is coherent and realistic as a whole.

    Example:

    Outcome

    Action required

    Timeline

    Responsibility

    Determine the percentage distribution of project vs. non-project work Run a time audit survey with all project resources 2 weeks Resource managers
    Test a simple dashboard for project status Pilot Info-Tech’s Portfolio Manager 2017 workbook 2 weeks PMO Director

    "There is a huge risk of taking on too much too soon, especially with the introduction of specific tools and tool sets. There is also an element of risk involved that can lead to failure and disappointment with PPM if these tools are not properly introduced and supported." (Jim Carse, Director of the Portfolio Office, Queen’s University)

    Review and customize slide 43, “Summary of near-term action plan,” in Info-Tech’s PPM Strategic Plan Template.

    Finalize and publish your PPM strategic plan

    Table of Contents

    Read over the document to ensure its completeness and consistency.

    At this point, you have a PPM strategic plan that is actionable and realistic, which addresses the goals set by the senior leadership.

    The executive brief establishes the need for PPM strategy, the goals and metrics are set by members of the senior leadership that gave the initial buy-in, and the target states of PPM processes that meet those goals are described. Finally, the costs and benefits of the improved PPM practice are laid out in a way that can be validated.

    The next step for your PPM strategy is to use this document as a foundation for implementing and operationalizing the target-state PPM processes.

    Review and publish the document for your executive layer and key project stakeholders. Solicit their feedback.

    Info-Tech has a library of blueprints that will guide you through each of the five processes. Contact your Info-Tech account manager or Info-Tech analyst to get started.

    • Project Portfolio Management Strategy
      • Strategic Expectations
      • Overview
    • Leadership Mandate
    • Project Demand and Resource Supply
    • The Current State of Resource Utilization
    • PPM Processes
      • Project intake, prioritization, and approval
      • Resource management
      • Portfolio reporting
      • Project closure
      • Benefits realization
      • Tools for PPM
    • The Economic Impact of PPM
    • PPM Strategy Next Steps

    If you want additional support, have our analysts guide you through this phase as part of an Info-Tech Workshop Associated Activity icon

    Book a workshop with our Info-Tech analysts:

    Photo of Barry Cousins.
    • To accelerate this project, engage your IT team in an Info-Tech workshop with an Info-Tech analyst team.
    • Info-Tech analyst will join you and your team onsite at your location or welcome you to Info-Tech's historic Toronto office to participate in an innovative onsite workshop.
    • Contact your account manager (www.infotech.com/account), or email Workshops@InfoTech.com for more information.

    The following are sample activities that will be conducted by Info-Tech analysts with your team:

    Sample of activity 3.1 'Scope the right-sized PPM solution for your PPM strategy'. Scope the right-sized PPM solution for your PPM strategy

    Use the PPM Strategy Development Tool to quickly determine our near- and long-term recommendation for your PPM solution.

    Sample of activity 3.2 'Conduct a cost-benefit analysis of your PPM strategic plan'. Conduct a cost-benefit analysis of your PPM strategic plan

    Using the time cost estimates of each process and the requirement for a PPM tool, Info-Tech helps you quantify the overhead costs of PPM and estimate the monetary benefits of reclaimed project capacity for your project portfolio.

    Insight breakdown

    Insight 1

    • Executive layer buy-in is a critical prerequisite for the success of a top-down PPM strategy. Ensure your executives are on board before preceding to implement your PPM strategy.

    Insight 2

    • The means of project and portfolio management (i.e. processes) shouldn’t eclipse the ends – strategic goals. Root your process in your PPM strategic goals to realize PPM benefits (e.g. optimized portfolio value, improved project throughput, increased stakeholder satisfaction).

    Insight 3

    • Without the proper information, decision makers are driving blind and are forced to make gut-feel decisions as opposed to data-informed decisions. Implement a PPM solution to allocate projects properly and ensure time and money don’t vanish without being accounted for.

    Summary of accomplishment

    Knowledge Gained

    • Info-Tech’s thought model on PPM processes that create an infrastructure around projects
    • Your current state of project portfolio: project capacity vs. project demand
    • Importance of gaining executive buy-in for installing the PPM practice

    Processes Optimized

    • Project intake, prioritization, and approval process
    • Resource management process
    • Portfolio reporting process
    • Project closure process
    • Benefits realization process

    Deliverables Completed

    • Choice of PPM strategy and the leadership mandate
    • Analysis of current project capacity and demand
    • PPM process goals and metrics, aligned to meet PPM strategic expectations
    • PPM process capability levels
    • Retrospective examination of current state, near/long-term action items for improvement, and high-level descriptions of the five PPM processes
    • Recommendation of PPM tools to support the processes
    • Estimate of PPM overhead costs
    • Cost-benefit analysis of PPM practice
    • PPM strategic plan

    Related Info-Tech Research

    • Develop a Project Portfolio Management Strategy
    • Grow Your Own PPM Solution
    • Optimize Project Intake, Approval, and Prioritization
    • Develop a Resource Management Strategy for the New Reality
    • Manage a Minimum-Viable PMO
    • Establish the Benefits Realization Process
    • Manage an Agile Portfolio
    • Establish the Benefits Realization Process
    • Project Portfolio Management Diagnostic Program
      The Project Portfolio Management Diagnostic Program is a low-effort, high-impact program designed to help project owners assess and improve their PPM practices. Gather and report on all aspects of your PPM environment in order to understand where you stand and how you can improve.

    Research contributors and experts

    Photo of Kiron D. Bondale PMP, PMI-RMP, CDAP, CDAI, Senior Project Portfolio Management Professional Kiron D. Bondale PMP, PMI-RMP, CDAP, CDAI
    Senior Project Portfolio Management Professional

    Kiron has worked in the project management domain for more than fifteen years managing multiple projects, leading Project Management Offices (PMO) and providing project portfolio management consulting services to over a hundred clients across multiple industries. He has been an active member of the Project Management Institute (PMI) since 1999 and served as a volunteer director on the Board of the PMI Lakeshore Chapter for six years. Kiron has published articles on project and project portfolio management in multiple journals and has delivered over a hundred webinar presentations on a variety of PPM and PM topics and has presented at multiple industry conferences. Since 2009, Kiron has been blogging on a weekly basis on project management topics and responds to questions daily in the LinkedIn PMI Project, Program and Portfolio Management discussion group.

    Photo of Shaun Cahill, Project Manager, Queen’s University Shaun Cahill, Project Manager &
    Jim Carse, Director of the Project Portfolio Office
    Queen’s University

    Research contributors and experts

    Photo of Amy Fowler Stadler, Managing Partner, Lewis Fowler Amy Fowler Stadler, Managing Partner
    Lewis Fowler

    Amy has more than 20 years of experience in business and technology, most recently owning her own management consulting firm since 2002, focused on business transformation, technology enablement, and operational improvement. Prior to that, she was at CenturyLink (formerly Qwest) as an IT Director, Perot Systems in various roles, and Information Handling Services, Inc. as a Software Development Product Manager.

    Amy holds a bachelor’s degree in Computer Science with a minor in Business Communications and is also a 2015 Hall of Fame inductee to Illinois State University College of Applied Science and Technology.

    Photo of Rick Morris, President, R2 Consulting LLC Rick Morris, President
    R2 Consulting LLC

    Rick A. Morris, PMP, is a certified Scrum Agile Master, Human Behavior Consultant, best-selling author, mentor, and evangelist for project management. Rick is an accomplished project manager and public speaker. His appetite for knowledge and passion for the profession makes him an internationally sought after speaker delivering keynote presentations for large conferences and PMI events around the world. He holds the PMP (Project Management Professional), MPM (Masters of Project Management), Scrum Agile Master, OPM3, Six Sigma Green Belt, MCITP, MCTS, MCSE, TQM, ATM-S, ITIL, and ISO certifications, and is a John Maxwell Certified Speaker, Mentor, and Coach. Rick is the Owner of R2 Consulting, LLC and has worked for organizations such as GE, Xerox, and CA, and has consulted with numerous clients in a wide variety of industries including financial services, entertainment, construction, non-profit, hospitality, pharmaceutical, retail, and manufacturing.

    Research contributors and experts

    Photo of Terry Lee Ricci PgMP, PfMP, PMP, PPM Practice Lead, IAG Consulting Terry Lee Ricci PgMP, PfMP, PMP, PPM Practice Lead
    IAG Consulting

    Terry is passionate and highly skilled at PMO transformation, developing high-performing teams that sustain long-term business results. Terry has a reputation built upon integrity, resourcefulness, and respect. She has the vision to implement long and short-term strategies, meeting both current and evolving business needs.

    Change Management/Business transformation: Terry has extensive background in PMO strategy development aligned to corporate goals. Many years in the PMO organization integration/transformation building or overhauling programs and processes.

    Governance: Terry loves to monitor and measure performance and outcomes and uses her collaborative style to successfully bring simplicity to complexity (technology – people – process). Performance optimization results are easy to use and clearly define who is doing what across functions. End results consistently align to business strategy while mitigating risks effectively.

    Comprehensive: A “through the ranks” executive with a comprehensive understanding of PMO operations, high-performance teams, and the respective business units they support.

    Photo of Alana Ruckstuhl MSc, IT Project Officer, Federal Economic Development Agency for Southern Ontario Alana Ruckstuhl MSc, IT Project Officer
    Federal Economic Development Agency for Southern Ontario

    Research contributors and experts

    Photo of Jay Wardle, Director of the PMO, Red Wing Shoes Co. Jay Wardle, Director of the PMO
    Red Wing Shoes Co.
    Photo of Bob White, Vice President/Chief Information Officer, ALM Holding Company Bob White, Vice President/Chief Information Officer
    ALM Holding Company

    As vice president and chief information officer for ALM Holding Company, Bob White directs all technology activity and support for three main verticals: road construction, energy management, and delivery and transportation. He has been with ALM Holding Company for one and a half years, focusing on PPM process improvement, cybersecurity initiatives, and IT service management.

    Prior to joining ALM, Bob was executive vice president/chief information officer at Ashley Furniture Industries, Inc. where he led the strategic direction, implementation, and management of information technology throughout the company’s global operations. Bob has also held VP/CIO positions at the Stride Rite Corporation and Timex Corporation.

    Bob holds a Master’s degree in Operations Management from the University of Arkansas and a Bachelor of Science degree in Industrial Engineering from Southern Illinois University.

    Bibliography

    Bersin, Josh. “Time to Scrap Performance Appraisals?” Forbes Magazine, 5 June 2013. Web. 30 Oct 2013.

    Cheese, Peter et al. “Creating an Agile Organization.” Accenture, Oct. 2009. Web. Nov. 2013.

    Croxon, Bruce et al. “Dinner Series: Performance Management with Bruce Croxon from CBC's 'Dragon's Den'” HRPA Toronto Chapter. Sheraton Hotel, Toronto, ON. 12 Nov. 2013. Panel discussion.

    Culbert, Samuel. “10 Reasons to Get Rid of Performance Reviews.” Huffington Post Business, 18 Dec. 2012. Web. 28 Oct. 2013.

    Denning, Steve. “The Case Against Agile: Ten Perennial Management Objections.” Forbes Magazine, 17 Apr. 2012. Web. Nov. 2013.

    Estis, Ryan. “Blowing up the Performance Review: Interview with Adobe’s Donna Morris.” Ryan Estis & Associates, 17 June 2013. Web. Oct. 2013.

    Gallup, Inc. “Gallup Study: Engaged Employees Inspire Company Innovation.” Gallup Management Journal, 12 Oct. 2006. Web. 12 Jan 2012.

    Gartside, David et al. “Trends Reshaping the Future of HR.” Accenture, 2013. Web. 5 Nov. 2013.

    KeyedIn Solutions. “Why PPM and PMOs Fail.” KeyedIn Projects, 2013. Ebook.

    Lessing, Lawrence. Free Culture. Lulu Press Inc.: 30 July 2016.

    Merkhofer, Lee. “Keys to Implementing Project Portfolio Management.” Lee Merkhofer Consulting, 2017.

    Perry, Mark Price. Business Driven Project Portfolio Management. J Ross Pub: 17 May 2011.

    Project Management Institute. “Pulse of the Profession 2015: Capturing the Value of Project Management.” PMI, Feb. 2015. Web.

    Project Management Institute. “Pulse of the Profession 2016: The High Cost of Low Performance.” PMI, 2016. Web.

    Project Management Institute. “Pulse of the Profession 2017: Success Rates Rise.” PMI, 2017. Web.

    Project Management Institute. The Standard for Portfolio Management – Third Edition. PMI: 1 Dec. 2012.

    WGroup. “Common Pitfalls in Project Portfolio Management – Part 2.” WGroup, 24 Jan. 2017. Web.

    Choose a Right-Sized Contact Center Solution

    • Buy Link or Shortcode: {j2store}334|cart{/j2store}
    • member rating overall impact: 10.0/10 Overall Impact
    • member rating average dollars saved: $25,535 Average $ Saved
    • member rating average days saved: 18 Average Days Saved
    • Parent Category Name: Strategy and Organizational Design
    • Parent Category Link: /strategy-and-organizational-design
    • IT needs a method to pinpoint which contact center solution best aligns with business objectives, adapting to a post-COVID world of remote work, flexibility, and scalability.
    • Scoring RFP and RFQ proposals is a complex process, and it is difficult to map and gap without a clear view of the organization’s needs. SOWs can contain pitfalls that cause expensive headaches for the organization in the long run. Guidance through a SOW is required to best represent the organization’s interests.

    Our Advice

    Critical Insight

    • “On-premises versus cloud” is a false dichotomy. Contact center architectures come in all shapes and sizes, and organizations should discern whether a hybrid option best meets their needs.
    • Contact centers should service customers – not capabilities. Capabilities must work for you, your agents, and your customers – not the other way around.
    • Deliverables and responsibilities should be a contract’s focal point. While organizations are right to focus on avoiding unanticipated license charges, it is more important to clearly define how deliverables and responsibilities will be divided among the organization, the vendor, and potential third parties.

    Impact and Result

    • Assess the array of contact center architectures with Info-Tech’s Contact Center Decision Points Tool to select a right-sized solution.
    • Build business requirements in a formalized process to achieve stakeholder buy-in.
    • Use Info-Tech’s Contact Center RFP Scoring Tool to evaluate and choose from a range of vendors.
    • Successfully navigate and avoid major pitfalls in a SOW construction.
    • Justify each stage of the process with this blueprint’s key deliverable: the Contact Center Playbook.

    Choose a Right-Sized Contact Center Solution Research & Tools

    Start here – read the Executive Brief

    Read our concise Executive Brief to examine the current contact center marketspace, review Info-Tech’s methodology for choosing a right-sized contact center solution, and understand the four ways we can support you in completing this project.

    Besides the small introduction, subscribers and consulting clients within this management domain have access to:

    1. Assess Contact Center Architectures

    Establish your project vision and metrics of success before shortlisting potential contact center architectures and deciding which is right-sized for the organization.

    • Choose a Right-Sized Contact Center Solution – Phase 1: Assess Contact Center Architectures
    • Contact Center Playbook
    • Contact Center Decision Points Tool

    2. Gather Requirements and Shortlist Vendors

    Build business requirements to achieve stakeholder buy-in, define key deliverables, and issue an RFP/RFQ to shortlisted vendors.

    • Choose a Right-Sized Contact Center Solution – Phase 2: Gather Requirements and Shortlist Vendors
    • Requirements Gathering Documentation Tool
    • Lean RFP Template
    • Contact Center Business Requirements Document
    • Request for Quotation Template
    • Long-Form RFP Template

    3. Score Vendors and Construct SOW

    Score RFP/RFQ responses and decide upon a vendor before constructing a SOW.

    • Choose a Right-Sized Contact Center Solution – Phase 3: Score Vendors and Construct SOW
    • Contact Center RFP Scoring Tool
    • Contact Center SOW Template and Guide
    [infographic]

    Workshop: Choose a Right-Sized Contact Center Solution

    Workshops offer an easy way to accelerate your project. If you are unable to do the project yourself, and a Guided Implementation isn't enough, we offer low-cost delivery of our project workshops. We take you through every phase of your project and ensure that you have a roadmap in place to complete your project successfully.

    1 Assess Architecture

    The Purpose

    Shortlist and decide upon a right-sized contact center architecture.

    Key Benefits Achieved

    A high-level decision for a right-sized architecture

    Activities

    1.1 Define vision and mission statements.

    1.2 Identify infrastructure metrics of success.

    1.3 Confirm key performance indicators for contact center operations.

    1.4 Complete architecture assessment.

    1.5 Confirm right-sized architecture.

    Outputs

    Project outline

    Metrics of success

    KPIs confirmed

    Quickly narrow down right-sized architecture

    Decision on right-sized contact center architecture

    2 Gather Requirements

    The Purpose

    Build business requirements and define key deliverables to achieve stakeholder buy-in and shortlist potential vendors.

    Key Benefits Achieved

    Key deliverables defined and a shortlist of no more than five vendors

    Sections 7-8 of the Contact Center Playbook completed

    Activities

    2.1 Hold focus groups with key stakeholders.

    2.2 Gather business, nonfunctional, and functional requirements.

    2.3 Define key deliverables.

    2.4 Shortlist five vendors that appear meet those requirements.

    Outputs

    User requirements identified

    Business Requirements Document completed

    Key deliverables defined

    Shortlist of five vendors

    3 Initial Vendor Scoring

    The Purpose

    Compare and evaluate shortlisted vendors against gathered requirements.

    Key Benefits Achieved

    Have a strong overview of which vendors are preferred for issuing RFP/RFQ

    Section 9 of the Contact Center Playbook

    Activities

    3.1 Input requirements to the Contact Center RFP Scoring Tool. Define which are mandatory and which are desirable.

    3.2 Determine which vendors best meet requirements.

    3.3 Compare requirements met with anticipated TCO.

    3.4 Compare and rank vendors.

    Outputs

    An assessment of requirements

    Vendor scoring

    A holistic overview of requirements scoring and vendor TCO

    An initial ranking of vendors to shape RFP process after workshop end

    4 SOW Walkthrough

    The Purpose

    Walk through the Contact Center SOW Template and Guide to identify how much time to allocate per section and who will be responsible for completing it.

    Key Benefits Achieved

    An understanding of a SOW that is designed to avoid major pitfalls with vendor management

    Section 10 of the Contact Center Playbook

    Activities

    4.1 Get familiar with the SOW structure.

    4.2 Identify which sections will demand greater time allocation.

    4.3 Strategize how to avoid potential pitfalls.

    4.4 Confirm reviewer responsibilities.

    Outputs

    A broad understanding of a SOW’s key sections

    A determination of how much time should be allocated for reviewing major sections

    A list of ways to avoid major pitfalls with vendor management

    A list of reviewers, the sections they are responsible for reviewing, and their time allocation for their review

    5 Communicate and Implement

    The Purpose

    Finalize deliverables and plan post-workshop communications.

    Key Benefits Achieved

    A completed Contact Center Playbook that justifies each decision of this workshop

    Activities

    5.1 Finalize deliverables.

    5.2 Support communication efforts.

    5.3 Identify resources in support of priority initiatives.

    Outputs

    Contact Center Playbook delivered

    Post-workshop engagement to confirm satisfaction

    Follow-up research that complements the workshop or leads workshop group in relevant new directions

    Enterprise Application Selection and Implementation

    • Buy Link or Shortcode: {j2store}29|cart{/j2store}
    • Related Products: {j2store}29|crosssells{/j2store}
    • member rating overall impact: 9.0/10
    • member rating average dollars saved: $37,356
    • member rating average days saved: 34
    • Parent Category Name: Applications
    • Parent Category Link: /applications

    The challenge

    • Large scale implementations are prone to failure. This is probably also true in your company. Typically large endeavors like this overrun the budget, are late to deliver, or are abandoned altogether. It would be best if you manage your risks when starting such a new project.

    Our advice

    Insight

    • Large-scale software implementations continue to fail at very high rates. A recent report by McKinsey & Company estimates that 66% go over budget, 33% over time, and 17% delivered less value than expected. Most companies will survive a botched implementation, but 17% threatened the existence of the company involved.
    • With all the knowledge sharing that we have today with oodles of data at our disposal, we should expect IT-providers to have clear, standardized frameworks to handle these implementations. But projects that overrun by more than 200% still occur more often than you may think.
    • When you solicit a systems integrator (SI), you want to equip yourself to manage the SI and not be utterly dependent on their methodology.

    Impact and results

    • You can assume proper accountability for the implementation and avoid over-reliance on the systems integrator.
    • Leverage the collective knowledge and advice of additional IT professionals
    • Review the pitfalls and lessons learned from failed integrations.
    • Manage risk at every stage.
    • Perform a self-assessment at various stages of the integration path.

    The roadmap

    Besides the small introduction, subscribers and consulting clients within this management domain have access to:

    Executive Summary

    Determine the rations for your implementation

    See if a custom-of-the-shelf process optimization makes sense.

    • Storyboard: Govern and Manage an Enterprise Software Implementation (ppt)

    Prepare

    Determine the right (level of) governance for your implementation.

    • Large Software Implementation Maturity Assessment Tool (xls)
    • Project Success Measurement Tool (xls)
    • Risk Mitigation Plan Template (xls)

    Plan and analyze

    Prepare for the overall implementation journey and gather your requirements. Then conduct a stage-gate assessment of this phase.

    • Project Phases Entry and Exit Criteria Checklist Tool (xls)
    • Project Lessons Learned Document (doc)

    Design, build and deploy

    Conduct a stage-gate assessment after every step below.

    • Make exact designs of the software implementation and ensure that all stakeholders and the integrator completely understand.
    • Build the solution according to the requirements and designs.
    • Thoroughly test and evaluate that the implementation meets your business expectations.
    • Then deploy

    Initiate your roadmap

    Review your dispositions to ensure they align with your goals.

    • Build an Application Rationalization Framework – Phase 4: Initiate Your Roadmap (ppt)
    • Disposition Prioritization Tool (xls)

    Service Desk

    • Buy Link or Shortcode: {j2store}11|cart{/j2store}
    • Related Products: {j2store}11|crosssells{/j2store}
    • Up-Sell: {j2store}11|upsells{/j2store}
    • member rating overall impact: 9.4/10
    • member rating average dollars saved: $22,900
    • member rating average days saved: 20
    • Parent Category Name: Infra and Operations
    • Parent Category Link: /infra-and-operations
    The service desk is typically the first point of contact for clients and staff who need something. Make sure your team is engaged, involved, knowledgeable, and gives excellent customer service.

    Modernize Data Architecture for Measurable Business Results

    • Buy Link or Shortcode: {j2store}387|cart{/j2store}
    • member rating overall impact: 9.5/10 Overall Impact
    • member rating average dollars saved: After each Info-Tech experience, we ask our members to quantify the real-time savings, monetary impact, and project improvements our research helped them achieve.
    • member rating average days saved: Read what our members are saying
    • Parent Category Name: Data Management
    • Parent Category Link: /data-management
    • Data architecture projects have often failed in the past, causing businesses today to view the launch of a new project as a costly initiative with unclear business value.
    • New technologies in big data and analytics are requiring organizations to modernize their data architecture, but most organizations have failed to spend the time and effort refining the appropriate data models and blueprints that enable them to do so.
    • As the benefits for data architecture are often diffused across an organization’s information management practice, it can be difficult for the business to understand the value and necessity of data architecture.

    Our Advice

    Critical Insight

    • At the heart of tomorrow’s insights-driven enterprises is a modern data environment anchored in fit-for-purpose data architectures.
    • The role of traditional data architecture is transcending beyond organizational boundaries and its focus is shifting from “keeping the lights on” (i.e. operational data and BI) to providing game-changing insights gleaned from untapped big data.

    Impact and Result

    • Perform a diagnostic assessment of your present day architecture and identify the capabilities of your future “to be” environment to position your organization to capitalize on new opportunities in the data space.
    • Use Info-Tech’s program diagnostic assessment and guidance for developing a strategic roadmap to support your team in building a fit-for purpose data architecture practice.
    • Create a data delivery architecture that harmonizes traditional and modern architectural opportunities.

    Modernize Data Architecture for Measurable Business Results Research & Tools

    Start here – read the Executive Brief

    Read our concise Executive Brief to find out why you should modernize your data architecture, review Info-Tech’s methodology, and understand the four ways we can support you in completing this project.

    Besides the small introduction, subscribers and consulting clients within this management domain have access to:

    1. Develop a data architecture vision

    Plan your data architecture project and align it with the business and its strategic vision.

    • Modernize Data Architecture for Measurable Business Results – Phase 1: Develop a Data Architecture Vision
    • Modernize Data Architecture Project Charter
    • Data Architecture Strategic Planning Workbook

    2. Assess data architecture capabilities

    Evaluate the current and target capabilities of your data architecture, using the accompanying diagnostic assessment to identify performance gaps and build a fit-for-purpose practice.

    • Modernize Data Architecture for Measurable Business Results – Phase 2: Assess Data Architecture Capabilities
    • Data Architecture Assessment and Roadmap Tool
    • Initiative Definition Tool

    3. Develop a data architecture roadmap

    Translate your planned initiatives into a sequenced roadmap.

    • Modernize Data Architecture for Measurable Business Results – Phase 3: Develop a Data Architecture Roadmap
    • Modernize Data Architecture Roadmap Presentation Template
    [infographic]

    Workshop: Modernize Data Architecture for Measurable Business Results

    Workshops offer an easy way to accelerate your project. If you are unable to do the project yourself, and a Guided Implementation isn't enough, we offer low-cost delivery of our project workshops. We take you through every phase of your project and ensure that you have a roadmap in place to complete your project successfully.

    1 Develop a Data Architecture (DA) Vision

    The Purpose

    Discuss key business drivers and strategies.

    Identify data strategies.

    Develop a data architecture vision.

    Assess data architecture practice capabilities.

    Key Benefits Achieved

    A data architecture vision aligned with the business.

    A completed assessment of the organization’s current data architecture practice capabilities.

    Identification of "to be" data architecture practice capabilities.

    Identification of key gaps.

    Activities

    1.1 Explain approach and value proposition

    1.2 Discuss business vision and key drivers

    1.3 Discover business pain points and needs

    1.4 Determine data strategies

    1.5 Assess DA practice capabilities

    Outputs

    Data strategies

    Data architecture vision

    Current and target capabilities for the modernized DA practice

    2 Assess DA Core Capabilities (Part 1)

    The Purpose

    Assess the enterprise data model (EDM).

    Assess current and target data warehouse, BI/analytics, and big data architectures.

    Key Benefits Achieved

    A completed assessment of the organization’s current EDM, data warehouse, BI and analytics, and big data architectures.

    Identification of "to be" capabilities for the organization’s EDM, data warehouse, BI and analytics, and big data architectures.

    Identification of key gaps.

    Activities

    2.1 Present an overarching DA capability model

    2.2 Assess current and target EDM capabilities

    2.3 Assess current/target data warehouse, BI/analytics, and big data architectures

    2.4 Identify gaps and high level strategies

    Outputs

    Target capabilities for EDM

    Target capabilities for data warehouse architecture, BI architecture, and big data architecture

    3 Assess DA Core Capabilities (Part 2)

    The Purpose

    Assess EDM.

    Assess current/target MDM, metadata, data integration, and content architectures.

    Assess dynamic data models.

    Key Benefits Achieved

    A completed assessment of the organization’s current MDM, metadata, data integration, and content architectures.

    Identification of “to be” capabilities for the organization’s MDM, metadata, data integration, and content architectures.

    Identification of key gaps.

    Activities

    3.1 Present an overarching DA capability model

    3.2 Assess current and target MDM, metadata, data integration, and content architectures

    3.3 Assess data lineage and data delivery model

    3.4 Identify gaps and high level strategies

    Outputs

    Target capabilities for MDM architecture, metadata architecture, data integration architecture, and document & content architecture

    Target capabilities for data lineage/delivery

    4 Analyze Gaps and Formulate Strategies

    The Purpose

    Map performance gaps and document key initiatives from the diagnostic assessment.

    Identify additional gaps and action items.

    Formulate strategies and initiatives to address priority gaps.

    Key Benefits Achieved

    Prioritized gap analysis.

    Improvement initiatives and related strategies.

    Activities

    4.1 Map performance gaps to business vision, pain points, and needs

    4.2 Identify additional gaps

    4.3 Consolidate/rationalize/prioritize gaps

    4.4 Formulate strategies and actions to address gaps

    Outputs

    Prioritized gaps

    Data architecture modernization strategies

    5 Develop a Data Architecture Roadmap

    The Purpose

    Plot initiatives and strategies on a strategic roadmap.

    Key Benefits Achieved

    A roadmap with prioritized and sequenced initiatives.

    Milestone plan.

    Executive report.

    Activities

    5.1 Transform strategies into a plan of action

    5.2 Plot actions on a prioritized roadmap

    5.3 Identify and discuss next milestone plan

    5.4 Compile an executive report

    Outputs

    Data architecture modernization roadmap

    Data architecture assessment and roadmap report (from analyst team)

    Streamline Application Management

    • Buy Link or Shortcode: {j2store}403|cart{/j2store}
    • member rating overall impact: 9.5/10 Overall Impact
    • member rating average dollars saved: $64,272 Average $ Saved
    • member rating average days saved: 40 Average Days Saved
    • Parent Category Name: Maintenance
    • Parent Category Link: /maintenance
    • Today’s rapidly scaling and increasingly complex products create mounting pressure on delivery teams to release new features and changes quickly and with sufficient quality.
    • Many organizations lack the critical management capabilities to balance maintenance with new development and ensure high product value.
    • Application management is often viewed as a support function rather than an enabler of business growth. Focus and investments are only placed on management when it becomes a problem.
    • The lack of governance and practice accountability leaves application management in a chaotic state: politics take over, resources are not strategically allocated, and customers are frustrated.

    Our Advice

    Critical Insight

    • New features, fixes, and enhancements are all treated the same and managed in a single backlog. Teams need to focus on prioritizing their efforts on what is valuable to the organization, not to a single department.
    • Business integration is not optional. The business (i.e. product owners) must be represented in guiding delivery efforts and performing ongoing validation and verification of new features and changes.

    Impact and Result

    • Justify the necessity to optimize application management. Gain a grounded understanding of stakeholder objectives and validate their achievability against the current maturity of application management.
    • Strengthen backlog management practices. Obtain a holistic picture of the business and technical impacts, risks, value, complexity, and urgency of each backlog item in order to justify its priority and relevance. Apply the appropriate management approach to each software product according to its criticality and value to the business.
    • Establish and govern a repeatable process. Develop a management process with well-defined steps, quality controls, and roles and responsibilities, and instill good practices to improve the success of delivery.

    Streamline Application Management Research & Tools

    Start here – read the Executive Brief

    Read our concise Executive Brief to find out why you should sustain your application management practice, review Info-Tech’s methodology, and understand the four ways we can support you in completing this project.

    Besides the small introduction, subscribers and consulting clients within this management domain have access to:

    1. Define your priorities

    State the success criteria of your application management practice through defined objectives and metrics. Assess your maturity.

    • Streamline Application Management – Phase 1: Define Your Priorities
    • Application Management Strategy Template
    • Application Management Maturity Assessment Tool

    2. Govern application management

    Structure your application management governance model with the right process and roles. Inject product ownership into your practice.

    • Streamline Application Management – Phase 2: Govern Application Management

    3. Build your optimization roadmap

    Build your application management optimization roadmap to achieve your target state.

    • Streamline Application Management – Phase 3: Build Your Optimization Roadmap
    [infographic]

    Workshop: Streamline Application Management

    Workshops offer an easy way to accelerate your project. If you are unable to do the project yourself, and a Guided Implementation isn't enough, we offer low-cost delivery of our project workshops. We take you through every phase of your project and ensure that you have a roadmap in place to complete your project successfully.

    1 Define Your Priorities

    The Purpose

    State the success criteria of your application management practice through defined objectives and metrics.

    Assess your maturity.

    Key Benefits Achieved

    Grounded stakeholder expectations

    Application management maturity and identification of optimization opportunities

    Activities

    1.1 Set your objectives.

    1.2 Assess your maturity.

    Outputs

    Application management objectives and metrics

    Application management maturity and optimization opportunities

    2 Govern Application Management

    The Purpose

    Structure your application management governance model with the right process and roles.

    Inject product ownership into your practice.

    Key Benefits Achieved

    Management approach aligned to product value and criticality

    Management techniques to govern the product backlog

    Target-state application management process and roles

    Activities

    2.1 Select your management approach.

    2.2 Manage your single product backlog.

    2.3 Optimize your management process.

    2.4 Define your management roles.

    Outputs

    Application management approach for each application

    Product backlog management practices

    Application management process

    Application management roles and responsibilities and communication flow

    3 Build Your Optimization Roadmap

    The Purpose

    Build your application management optimization roadmap to achieve your target state.

    Key Benefits Achieved

    Optimization opportunities

    Application management optimization roadmap

    Activities

    3.1 Build your optimization roadmap.

    Outputs

    Application management optimization roadmap

    The latest burning platform: Exit Plans in a shifting world

    • Large vertical image:
    • member rating overall impact: N/A
    • member rating average dollars saved: N/A
    • member rating average days saved: N/A

    The current global situation, marked by significant trade tensions and retaliatory measures between major economic powers, has elevated the importance of more detailed, robust, and executable exit plans for businesses in nearly all industries. The current geopolitical headwinds create an unpredictable environment that can severely impact supply chains, technology partnerships, and overall business operations. What was once a prudent measure is now a critical necessity – a “burning platform” – for ensuring business continuity and resilience.

    Here I will delve deeper into the essential components of an effective exit plan, outline the practical steps for its implementation, and explain the crucial role of testing in validating its readiness.

    exit plan

    Continue reading

    Design a Coordinated Vulnerability Disclosure Program

    • Buy Link or Shortcode: {j2store}322|cart{/j2store}
    • member rating overall impact: 10.0/10 Overall Impact
    • member rating average dollars saved: $10,000 Average $ Saved
    • member rating average days saved: 20 Average Days Saved
    • Parent Category Name: Threat Intelligence & Incident Response
    • Parent Category Link: /threat-intelligence-incident-response
    • Businesses prioritize speed to market over secure coding and testing practices in the development lifecycle. As a result, vulnerabilities exist naturally in software.
    • To improve overall system security, organizations are leveraging external security researchers to identify and remedy vulnerabilities, so as to mitigate the overall security risk.
    • A primary challenge to developing a coordinated vulnerability disclosure (CVD) program is designing repeatable procedures and scoping the program to the organization’s technical capacity.

    Our Advice

    Critical Insight

    • Having a coordinated vulnerability disclosure program is likely to be tomorrow’s law. With pressures from federal government agencies and recommendations from best-practice frameworks, it is likely that a CVD will be mandated in the future to encourage organizations to be equipped and prepared to respond to externally disclosed vulnerabilities.
    • CVD programs such as bug bounty and vulnerability disclosure programs (VDPs) may reward differently, but they have the same underlying goals. As a result, you don't need dramatically different process documentation.

    Impact and Result

    • Design a coordinated vulnerability disclosure program that reflects business, customer, and regulatory obligations.
    • Develop a program that aligns your resources with the scale of the coordinated vulnerability disclosure program.
    • Follow Info-Tech’s vulnerability disclosure methodology by leveraging our policy, procedure, and workflow templates to get you started.

    Design a Coordinated Vulnerability Disclosure Program Research & Tools

    Start here – read the Executive Brief

    Read our concise Executive Brief to find out why you should design a coordinated vulnerability disclosure program, review Info-Tech’s methodology, and understand the four ways we can support you in completing this project.

    Besides the small introduction, subscribers and consulting clients within this management domain have access to:

    1. Assess goals

    Define the business, customer, and compliance alignment for the coordinated vulnerability disclosure program.

    • Design a Coordinated Vulnerability Disclosure Program – Phase 1: Assess Goals
    • Information Security Requirements Gathering Tool

    2. Formalize the program

    Equip your organization for coordinated vulnerability disclosure with formal documentation of policies and processes.

    • Design a Coordinated Vulnerability Disclosure Program – Phase 2: Formalize the Program
    • Coordinated Vulnerability Disclosure Policy
    • Coordinated Vulnerability Disclosure Plan
    • Coordinated Vulnerability Disclosure Workflow (Visio)
    • Coordinated Vulnerability Disclosure Workflow (PDF)
    [infographic]

    Build a Vendor Security Assessment Service

    • Buy Link or Shortcode: {j2store}318|cart{/j2store}
    • member rating overall impact: 9.0/10 Overall Impact
    • member rating average dollars saved: $17,501 Average $ Saved
    • member rating average days saved: 17 Average Days Saved
    • Parent Category Name: Threat Intelligence & Incident Response
    • Parent Category Link: /threat-intelligence-incident-response
    • Vendor security risk management is a growing concern for many organizations. Whether suppliers or business partners, we often trust them with our most sensitive data and processes.
    • More and more regulations require vendor security risk management, and regulator expectations in this area are growing.
    • However, traditional approaches to vendor security assessments are seen by business partners and vendors as too onerous and are unsustainable for information security departments.

    Our Advice

    Critical Insight

    • An efficient and effective assessment process can only be achieved when all stakeholders are participating.
    • Security assessments are time-consuming for both you and your vendors. Maximize the returns on your effort with a risk-based approach.
    • Effective vendor security risk management is an end-to-end process that includes assessment, risk mitigation, and periodic re-assessments.

    Impact and Result

    • Develop an end-to-end security risk management process that includes assessments, risk treatment through contracts and monitoring, and periodic re-assessments.
    • Base your vendor assessments on the actual risks to your organization to ensure that your vendors are committed to the process and you have the internal resources to fully evaluate assessment results.
    • Understand your stakeholder needs and goals to foster support for vendor security risk management efforts.

    Build a Vendor Security Assessment Service Research & Tools

    Start here – read the Executive Brief

    Read our concise Executive Brief to find out why you should build a vendor security assessment service, review Info-Tech’s methodology, and understand the three ways we can support you in completing this project.

    Besides the small introduction, subscribers and consulting clients within this management domain have access to:

    1. Define governance and process

    Determine your business requirements and build your process to meet them.

    • Build a Vendor Security Assessment Service – Phase 1: Define Governance and Process
    • Vendor Security Policy Template
    • Vendor Security Process Template
    • Vendor Security Process Diagram (Visio)
    • Vendor Security Process Diagram (PDF)

    2. Develop assessment methodology

    Develop the specific procedures and tools required to assess vendor risk.

    • Build a Vendor Security Assessment Service – Phase 2: Develop Assessment Methodology
    • Service Risk Assessment Questionnaire
    • Vendor Security Questionnaire
    • Vendor Security Assessment Inventory

    3. Deploy and monitor process

    Implement the process and develop metrics to measure effectiveness.

    • Build a Vendor Security Assessment Service – Phase 3: Deploy and Monitor Process
    • Vendor Security Requirements Template
    [infographic]

    Workshop: Build a Vendor Security Assessment Service

    Workshops offer an easy way to accelerate your project. If you are unable to do the project yourself, and a Guided Implementation isn't enough, we offer low-cost delivery of our project workshops. We take you through every phase of your project and ensure that you have a roadmap in place to complete your project successfully.

    1 Define Governance and Process

    The Purpose

    Understand business and compliance requirements.

    Identify roles and responsibilities.

    Define the process.

    Key Benefits Achieved

    Understanding of key goals for process outcomes.

    Documented service that leverages existing processes.

    Activities

    1.1 Review current processes and pain points.

    1.2 Identify key stakeholders.

    1.3 Define policy.

    1.4 Develop process.

    Outputs

    RACI Matrix

    Vendor Security Policy

    Defined process

    2 Define Methodology

    The Purpose

    Determine methodology for assessing procurement risk.

    Develop procedures for performing vendor security assessments.

    Key Benefits Achieved

    Standardized, repeatable methodologies for supply chain security risk assessment.

    Activities

    2.1 Identify organizational security risk tolerance.

    2.2 Develop risk treatment action plans.

    2.3 Define schedule for re-assessments.

    2.4 Develop methodology for assessing service risk.

    Outputs

    Security risk tolerance statement

    Risk treatment matrix

    Service Risk Questionnaire

    3 Continue Methodology

    The Purpose

    Develop procedures for performing vendor security assessments.

    Establish vendor inventory.

    Key Benefits Achieved

    Standardized, repeatable methodologies for supply chain security risk assessment.

    Activities

    3.1 Develop vendor security questionnaire.

    3.2 Define procedures for vendor security assessments.

    3.3 Customize the vendor security inventory.

    Outputs

    Vendor security questionnaire

    Vendor security inventory

    4 Deploy Process

    The Purpose

    Define risk treatment actions.

    Deploy the process.

    Monitor the process.

    Key Benefits Achieved

    Understanding of how to treat different risks according to the risk tolerance.

    Defined implementation strategy.

    Activities

    4.1 Define risk treatment action plans.

    4.2 Develop implementation strategy.

    4.3 Identify process metrics.

    Outputs

    Vendor security requirements

    Understanding of required implementation plans

    Metrics inventory

    Become a Strategic CIO

    • Buy Link or Shortcode: {j2store}80|cart{/j2store}
    • member rating overall impact: 9.5/10 Overall Impact
    • member rating average dollars saved: $10,000 Average $ Saved
    • member rating average days saved: 15 Average Days Saved
    • Parent Category Name: IT Strategy
    • Parent Category Link: /it-strategy
    • As a CIO, you are currently operating in a stable and trusted IT environment, but you would like to advance your role to strategic business partner.
    • CIOs are often overlooked as a strategic partner by their peers, and therefore face the challenge of proving they deserve a seat at the table.

    Our Advice

    Critical Insight

    • To become a strategic business partner, you must think and act as a business person that works in IT, rather than an IT person that works for the business.
    • Career advancement is not a solo effort. Building relationships with your executive business stakeholders will be critical to becoming a respected business partner.

    Impact and Result

    • Create a personal development plan and stakeholder management strategy to accelerate your career and become a strategic business partner. For a CIO to be considered a strategic business partner, he or she must be able to:
      • Act as a business person that works in IT, rather than an IT person that works for the business. This involves meeting executive stakeholder expectations, facilitating innovation, and managing stakeholder relationships.
      • Align IT with the customer. This involves providing business stakeholders with information to support stronger decision making, keeping up with disruptive technologies, and constantly adapting to the ever-changing end-customer needs.
      • Manage talent and change. This involves performing strategic workforce planning, and being actively engaged in identifying opportunities to introduce change in your organization, suggesting ways to improve, and then acting on them.

    Become a Strategic CIO Research & Tools

    Start here – read the Executive Brief

    Read our concise Executive Brief to find out why you should become a strategic CIO, review Info-Tech’s methodology, and understand the four ways we can support you in completing this project.

    Besides the small introduction, subscribers and consulting clients within this management domain have access to:

    1. Launch

    Analyze strategic CIO competencies and assess business stakeholder satisfaction with IT using Info-Tech's CIO Business Vision Diagnostic and CXO-CIO Alignment Program.

    • Become a Strategic CIO – Phase 1: Launch

    2. Assess

    Evaluate strategic CIO competencies and business stakeholder relationships.

    • Become a Strategic CIO – Phase 2: Assess
    • CIO Strategic Competency Evaluation Tool
    • CIO Stakeholder Power Map Template

    3. Plan

    Create a personal development plan and stakeholder management strategy.

    • Become a Strategic CIO – Phase 3: Plan
    • CIO Personal Development Plan
    • CIO Stakeholder Management Strategy Template

    4. Execute

    Develop a scorecard to track personal development initiatives.

    • Become a Strategic CIO – Phase 4: Execute
    • CIO Strategic Competency Scorecard
    [infographic]

    Workshop: Become a Strategic CIO

    Workshops offer an easy way to accelerate your project. If you are unable to do the project yourself, and a Guided Implementation isn't enough, we offer low-cost delivery of our project workshops. We take you through every phase of your project and ensure that you have a roadmap in place to complete your project successfully.

    1 Assess Competencies & Stakeholder Relationships

    The Purpose

    Gather and review information from business stakeholders.

    Assess strategic CIO competencies and business stakeholder relationships.

    Key Benefits Achieved

    Gathered information to create a personal development plan and stakeholder management strategy.

    Analyzed the information from diagnostics and determined the appropriate next steps.

    Identified and prioritized strategic CIO competency gaps.

    Evaluated the power, impact, and support of key business stakeholders.

    Activities

    1.1 Conduct CIO Business Vision diagnostic

    1.2 Conduct CXO-CIO Alignment program

    1.3 Assess CIO competencies

    1.4 Assess business stakeholder relationships

    Outputs

    CIO Business Vision results

    CXO-CIO Alignment Program results

    CIO competency gaps

    Executive Stakeholder Power Map

    2 Take Control of Your Personal Development

    The Purpose

    Create a personal development plan and stakeholder management strategy.

    Track your personal development and establish checkpoints to revise initiatives.

    Key Benefits Achieved

    Identified personal development and stakeholder engagement initiatives to bridge high priority competency gaps.

    Identified key performance indicators and benchmarks/targets to track competency development.

    Activities

    2.1 Create a personal development plan

    2.2 Create a stakeholder management strategy

    2.3 Establish key performance indicators and benchmarks/targets

    Outputs

    Personal Development Plan

    Stakeholder Management Strategy

    Strategic CIO Competency Scorecard

    Build a Winning Business Process Automation Playbook

    • Buy Link or Shortcode: {j2store}407|cart{/j2store}
    • member rating overall impact: 8.3/10 Overall Impact
    • member rating average dollars saved: $8,065 Average $ Saved
    • member rating average days saved: 7 Average Days Saved
    • Parent Category Name: Business Analysis
    • Parent Category Link: /business-analysis
    • Organizations often have many business processes that rely on manual, routine, and repetitive data collection and processing work. These processes need to be automated to meet strategic priorities.
    • Your stakeholders may have decided to invest in process automation solutions. They may be ready to begin the planning and delivery of their first automated processes.
    • However, if your processes are costly, slow, defective, and do not generate the value end users want, automation will only magnify these inefficiencies.

    Our Advice

    Critical Insight

    • Put the user front and center. Aim to better understand the end user and their operational environment. Use cases, data models, and quality factors allow you to visualize the human-computer interactions from an end-user perspective and initiate a discussion on how technology and process improvements can be better positioned to help your end users.
    • Build for the future. Automation sets the technology foundations and process governance and management building blocks in your organization. Expect that more automation will be done using earlier investments.
    • Manage automations as part of your application portfolio. Automations are add-ons to your application portfolio. Unmanaged automations, like applications, will sprawl and reduce in value over time. A collaborative rationalization practice pinpoints where automation is required and identifies which business inefficiencies should be automated next.

    Impact and Result

    • Clarify the problem being solved. Gain a grounded understanding of your stakeholders’ drivers for business process automation. Discuss current business operations and systems to identify automation candidates.
    • Optimate your processes. Apply good practices to first optimize (opti-) and then automate (-mate) key business processes. Take a user-centric perspective to understand how users interact with technology to complete their tasks.
    • Deliver minimum viable automations (MVAs). Maximize the learning of automation solutions and business operational changes through small, strategic automation use cases. This sets the foundations for a broader automation practice.

    Build a Winning Business Process Automation Playbook Research & Tools

    Besides the small introduction, subscribers and consulting clients within this management domain have access to:

    1. Business Process Automation Deck – A step-by-step document that walks you through how to optimize and automate your business processes.

    This blueprint helps you develop a repeatable approach to understand your process challenges and to optimize and automate strategic business processes.

    • Build a Winning Business Process Automation Playbook – Phases 1-3

    2. Business Process Automation Playbook – A repeatable set of practices to assess, optimize, and automate your business processes.

    This playbook template gives your teams a step-by-step guide to build a repeatable and standardized framework to optimize and automate your processes.

    • Business Process Automation Playbook

    3. Process Interview Template – A structured approach to interviewing stakeholders about their business processes.

    Info-Tech's Process Interview Template provides a number of sections that you can populate to help facilitate and document your stakeholder interviews.

    • Process Interview Template

    4. Process Mapping Guide – A guide to mapping business processes using BPMN standards.

    Info-Tech's Process Mapping Guide provides a thorough framework for process mapping, including the purpose and benefits, the best practices for facilitation, step-by-step process mapping instructions, and process mapping naming conventions.

    • Process Mapping Guide

    Infographic

    Workshop: Build a Winning Business Process Automation Playbook

    Workshops offer an easy way to accelerate your project. If you are unable to do the project yourself, and a Guided Implementation isn't enough, we offer low-cost delivery of our project workshops. We take you through every phase of your project and ensure that you have a roadmap in place to complete your project successfully.

    1 Identify Automation Opportunities

    The Purpose

    Understand the goals and visions of business process automation.

    Develop your guiding principles.

    Build a backlog of automation opportunities

    Key Benefits Achieved

    Business process automation vision, expectations, and objectives.

    High-priority automation opportunities identified to focus on.

    Activities

    1.1 State your objectives and metrics.

    1.2 Build your backlog.

    Outputs

    Business process automation vision and objectives

    Business process automation guiding principles

    Process automation opportunity backlog

    2 Define Your MVAs

    The Purpose

    Assess and optimize high-strategic-importance business process automation use cases from the end user’s perspective.

    Shortlist your automation solutions.

    Build and plan to deliver minimum viable automations (MVAs).

    Key Benefits Achieved

    Repeatable framework to assess and optimize your business process.

    Selection of the possible solutions that best fit the business process use case.

    Maximized learning with a low-risk minimum viable automation.

    Activities

    2.1 Optimize your processes.

    2.2 Automate your processes.

    2.3 Define and roadmap your MVAs.

    Outputs

    Assessed and optimized business processes with a repeatable framework

    Fit assessment of use cases to automation solutions

    MVA definition and roadmap

    3 Deliver Your MVAs

    The Purpose

    Modernize your SDLC to support business process automation delivery.

    Key Benefits Achieved

    An SDLC that best supports the nuances and complexities of business process automation delivery.

    Activities

    3.1 Deliver your MVAs

    Outputs

    Refined and enhanced SDLC

    How to build a Service Desk Chatbot POC

    • Buy Link or Shortcode: {j2store}16|cart{/j2store}
    • Related Products: {j2store}16|crosssells{/j2store}
    • member rating overall impact: 9.7/10
    • member rating average dollars saved: 11,197
    • member rating average days saved: 8
    • Parent Category Name: Service Desk
    • Parent Category Link: /service-desk

    The challenge

    Build a chatbot that creates value for your business

    • Ensure your chatbot meets your business needs.
    • Bring scalability to your customer service delivery in a cost-effective manner.
    • Measure your chatbot objectives with clear metrics.
    • Pre-determine your ticket categories to use during the proof of concept.

    Our advice

    Insight

    • Build your chatbot to create business value. Whether increasing service or resource efficiency, keep value creation in mind when making decisions with your proof of concept.

    Impact and results

    • When implemented effectively, chatbots can help save costs, generate new revenue, and ultimately increase customer satisfaction for external and internal-facing customers.

    The roadmap

    Read our concise Executive Brief to find out why you building a chatbot proof of concept is a good idea, review our methodology, and understand the four ways we can support you to successfully complete this project. Besides the small introduction, subscribers and consulting clients within this management domain have access to:

    Start here

    Form your chatbot strategy.

    Build the right metrics to measure the success of your chatbot POC

    • Chatbot ROI Calculator (xls)
    • Chatbot POC Metrics Tool (xls)

    Build the foundation for your chatbot.

    Architect the chatbot to maximize business value

    • Chatbot Conversation Tree Library

    Continue to improve your chatbot.

    Now take your chatbot proof of concept to production

    • Chatbot POC RACI (doc)
    • Chatbot POC Implementation Roadmap (xls)
    • Chatbot POC Communication Plan (doc)Chatbot ROI Calculator (xls)

    Select a Security Outsourcing Partner

    • Buy Link or Shortcode: {j2store}246|cart{/j2store}
    • member rating overall impact: 8.8/10 Overall Impact
    • member rating average dollars saved: $13,739 Average $ Saved
    • member rating average days saved: 8 Average Days Saved
    • Parent Category Name: Security Processes & Operations
    • Parent Category Link: /security-processes-and-operations
    • Most organizations do not have a clear understanding of their current security posture, their security goals, and the specific security services they require. Without a clear understanding of their needs, organizations may struggle to identify a partner that can meet their requirements.
    • Breakdowns and lack of communication can be a significant obstacle, especially when clear lines of communication with partners, including regular check-ins, reporting, and incident response protocols, have not been clearly established.
    • Ensuring that security partners’ systems and processes integrate seamlessly with existing systems can be a challenge for most organizations in addition to making sure that security partners have the necessary access and permissions to perform their services effectively.
    • Adhering to security policies is rarely a priority to users as compliance often feels like an interference to daily workflow. For a lot of organizations, security policies are not having the desired effect.

    Our Advice

    Critical Insight

    • You can outsource your responsibilities but not your accountability.
    • Be aware that in most cases, the traditional approach is more profitable to MSSPs, and they may push you toward one, so make sure you get the service you want, not what they prescribe.

    Impact and Result

    • Determine which security responsibilities can be outsourced and which should be insourced and the right procedure to outsourcing to gain cost savings, improve resource allocation, and boost your overall security posture.

    Select a Security Outsourcing Partner Research & Tools

    Besides the small introduction, subscribers and consulting clients within this management domain have access to:

    1. Select a Security Outsourcing Partner Storyboard – A guide to help you determine your requirements and select and manage your security outsourcing partner.

    Our systematic approach will ensure that the correct procedure for selecting a security outsourcing partner is implemented. This blueprint will help you build and implement your security policy program by following our three-phase methodology: determine what to outsource, select the right MSSP, and manage your MSSP.

    • Select a Security Outsourcing Partner – Phases 1-3

    2. MSSP RFP Template – A customizable template to help you choose the right security service provider.

    This modifiable template is designed to introduce consistency and outline key requirements during the request for proposal phase of selecting an MSSP.

    • MSSP RFP Template

    Infographic

    Further reading

    Select a Security Outsourcing Partner

    Outsource the right functions to secure your business.

    Analyst Perspective

    Understanding your security needs and remaining accountable is the key to selecting the right partner.

    The need for specialized security services is fast becoming a necessity to most organizations. However, resource challenges will always mean that organizations will still have to take practical measures to ensure that the time, quality, and service that they require from outsourcing partners have been carefully crafted and packaged to elicit the right services that cover all their needs and requirements.

    Organizations must ensure that security partners are aligned not only with their needs and requirements, but also with the corporate culture. Rather than introducing hindrances to daily operations, security partners must support business goals and protect the organization’s interests at all times.

    And as always, outsource only your responsibilities and do not outsource your accountability, as that will cost you in the long run.

    Photo of Danny Hammond
    Danny Hammond
    Research Analyst
    Security, Risk, Privacy & Compliance Practice
    Info-Tech Research Group

    Executive Summary

    Your Challenge

    A lack of high-skill labor increases the cost of internal security, making outsourcing more appealing.

    A lack of time and resources prevents your organization from being able to enable security internally.

    Due to a lack of key information on the subject, you are unsure which functions should be outsourced versus which functions should remain in-house.

    Having 24/7/365 monitoring in-house is not feasible for most firms.

    There is difficulty measuring the effectiveness of managed security service providers (MSSPs).

    Common Obstacles

    InfoSec leaders will struggle to select the right outsourcing partner without knowing what the organization needs, such as:

    • How to start the process to select the right service provider that will cover your security needs. With so many service providers and technology tools in this field, who is the right partner?
    • Where to obtain guidance on externalization of resources or maintaining internal posture to enable to you confidently select an outsourcing partner.

    InfoSec leaders must understand the business environment and their own internal security needs before they can select an outsourcing partner that fits.

    Info-Tech’s Approach

    Info-Tech’s Select a Security Outsourcing Partner takes a multi-faceted approach to the problem that incorporates foundational technical elements, compliance considerations, and supporting processes:

    • Determine which security responsibilities can be insourced and which should be outsourced, and the right procedure to outsourcing in order to gain cost savings, improve resource allocation, and boost your overall security posture.
    • Understand the current landscape of MSSPs that are available today and the features they offer.
    • Highlight the future financial obligations of outsourcing vs. insourcing to explain which method is the most cost-effective.

    Info-Tech Insight

    Mitigate security risks by developing an end-to-end process that ensures you are outsourcing your responsibilities and not your accountability.

    Your Challenge

    This research is designed to help organizations select an effective security outsourcing partner.

    • A security outsourcing partner is a third-party service provider that offers security services on a contractual basis depending on client needs and requirements.
    • An effective outsourcing partner can help an organization improve its security posture by providing access to more specialized security experts, tools, and technologies.
    • One of the main challenges with selecting a security outsourcing partner is finding a partner that is a good fit for the organization's unique security needs and requirements.
    • Security outsourcing partners typically have access to sensitive information and systems, so proper controls and safeguards must be in place to protect all sensitive assets.
    • Without careful evaluation and due diligence to ensure that the partner is a good fit for the organization's security needs and requirements, it can be challenging to select an outsourcing partner.

    Outsourcing is effective, but only if done right

    • 83% of decision makers with in-house cybersecurity teams are considering outsourcing to an MSP (Syntax, 2021).
    • 77% of IT leaders said cyberattacks were more frequent (Syntax, 2021).
    • 51% of businesses suffered a data breach caused by a third party (Ponemon, 2021).

    Common Obstacles

    The problem with selecting an outsourcing partner isn’t a lack of qualified partners, it’s the lack of clarity about an organization's specific security needs.

    • Most organizations do not have a clear understanding of their current security posture, their security goals, and the specific security services they require. Without a clear understanding of their needs, organizations may struggle to identify a partner that can meet their requirements.
    • Breakdowns and lack of communication can be a significant obstacle, especially when clear lines of communication with partners, including regular check-ins, reporting, and incident response protocols, have not been clearly established.
    • Ensuring that security partner's systems and processes integrate seamlessly with existing systems can be a challenge for most organizations. This is in addition to making sure that security partners have the necessary access and permissions to perform their services effectively.
    • Adhering to security policies is rarely a priority to users, as compliance often feels like an interference to daily workflow. For a lot of organizations, security policies are not having the desired effect.

    A diagram that shows Average cost of a data breach from 2019 to 2022.
    Source: IBM, 2022 Cost of a Data Breach; N=537.

    Reaching an all-time high, the cost of a data breach averaged US$4.35 million in 2022. This figure represents a 2.6% increase from 2021, when the average cost of a breach was US$4.24 million. The average cost has climbed 12.7% since 2020.

    Info-Tech’s methodology for selecting a security outsourcing partner

    Determine your responsibilities

    Determine what responsibilities you can outsource to a service partner. Analyze which responsibilities you should outsource versus keep in-house? Do you require a service partner based on identified responsibilities?

    Scope your requirements

    Refine the list of role-based requirements, variables, and features you will require. Use a well-known list of critical security controls as a framework to determine these activities and send out RFPs to pick the best candidate for your organization.

    Manage your outsourcing program

    Adopt a program to manage your third-party service security outsourcing. Trust your managed security service providers (MSSP) but verify their results to ensure you get the service level you were promised.

    Select a Security Outsourcing Partner

    A diagram that shows your organization responsibilities & accountabilities, framework for selecting a security outsourcing partner, and benefits.

    Blueprint benefits

    IT/InfoSec Benefits

    Reduces complexity within the MSSP selection process by highlighting all the key steps to a successful selection program.

    Introduces a roadmap to clearly educate about the do’s and don’ts of MSSP selection.

    Reduces costs and efforts related to managing MSSPs and other security partners.

    Business Benefits

    Assists with selecting outsourcing partners that are essential to your organization’s objectives.

    Integrates outsourcing into corporate culture, leveraging organizational requirements while maximizing value of outsourcing.

    Reduces security outsourcing risk.

    Insight summary

    Overarching insight: You can outsource your responsibilities but not your accountability.

    Determine what to outsource: Assess your responsibilities to determine which ones you can outsource. It is vital that an understanding of how outsourcing will affect the organization, and what cost savings, if any, to expect from outsourcing is clear in order to generate a list of responsibilities that can/should be outsourced.

    Select the right partner: Create a list of variables to evaluate the MSSPs and determine which features are important to you. Evaluate all potential MSSPs and determine which one is right for your organization

    Manage your MSSP: Align the MSSP to your organization. Adopt a program to monitor the MSSP which includes a long-term strategy to manage the MSSP.

    Identifying security needs and requirements = Effective outsourcing program: Understanding your own security needs and requirements is key. Ensure your RFP covers the entire scope of your requirements; work with your identified partner on updates and adaptation, where necessary; and always monitor alignment to business objectives.

    Measure the value of this blueprint

    Phase

    Purpose

    Measured Value

    Determine what to outsource Understand the value in outsourcing and determining what responsibilities can be outsourced. Cost of determining what you can/should outsource:
    • 120 FTE hours at $90K per year = $5,400
    Cost of determining the savings from outsourcing vs. insourcing:
    • 120 FTE hours at $90K per year = $5,400
    Select the right partner Select an outsourcing partner that will have the right skill set and solution to identified requirements. Cost of ranking and selecting your MSSPs:
    • 160 FTE hours at $90K per year = $7,200
    Cost of creating and distributing RFPs:
    • 200 FTE hours at $90K per year = $9,000
    Manage your third-party service security outsourcing Use Info-Tech’s methodology and best practices to manage the MSSP to get the best value. Cost of creating and implementing a metrics program to manage the MSSP:
    • 80 FTE hours at $90K per year = $3,600

    After each Info-Tech experience, we ask our members to quantify the real-time savings, monetary impact, and project improvements our research helped them achieve.

    Overall Impact: 8.9 /10

    Overall Average Cost Saved: $22,950

    Overall Average Days Saved: 9

    Info-Tech offers various levels of support to best suit your needs

    DIY Toolkit
    "Our team has already made this critical project a priority, and we have the time and capability, but some guidance along the way would be helpful."

    Guided Implementation
    "Our team knows that we need to fix a process, but we need assistance to determine where to focus. Some check-ins along the way would help keep us on track."

    Workshop
    "We need to hit the ground running and get this project kicked off immediately. Our team has the ability to take this over once we get a framework and strategy in place."

    Consulting
    "Our team does not have the time or the knowledge to take this project on. We need assistance through the entirety of this project."

    Diagnostics and consistent frameworks are used throughout all four options.

    Cost Optimization

    • Buy Link or Shortcode: {j2store}14|cart{/j2store}
    • Related Products: {j2store}14|crosssells{/j2store}
    • Up-Sell: {j2store}14|upsells{/j2store}
    • member rating overall impact: N/A
    • member rating average dollars saved: N/A
    • member rating average days saved: N/A
    • Parent Category Name: Financial Management
    • Parent Category Link: /financial-management
    Minimize the damage of IT cost cuts

    Document Your Cloud Strategy

    • Buy Link or Shortcode: {j2store}468|cart{/j2store}
    • member rating overall impact: 8.9/10 Overall Impact
    • member rating average dollars saved: $35,642 Average $ Saved
    • member rating average days saved: 21 Average Days Saved
    • Parent Category Name: Cloud Strategy
    • Parent Category Link: /cloud-strategy

    Despite the universally agreed-upon benefit of formulating a coherent strategy, several obstacles make execution difficult:

    • Inconsistent understanding of what the cloud means
    • Inability to come to a consensus on key decisions
    • Ungoverned decision-making
    • Unclear understanding of cloud roles and responsibilities

    Our Advice

    Critical Insight

    A cloud strategy might seem like a big project, but it’s just a series of smaller conversations. The methodology presented here is designed to facilitate those conversations, using a curated list of topics, prompts, participant lists, and sample outcomes. We have divided the strategy into four key areas:

    • Vision and alignment
    • People
    • Governance
    • Technology

    Impact and Result

    • A shared understanding of what is necessary to succeed in the cloud
    • An end to ad hoc deployments that solve small problems and create larger ones
    • A unified approach and set of principles that apply to governance, architecture, integration, skills, and roles (and much, much more).

    Document Your Cloud Strategy Research & Tools

    Besides the small introduction, subscribers and consulting clients within this management domain have access to:

    1. Document Your Cloud Strategy – a phased guide to identifying, validating, and recording the steps you’ll take, the processes you’ll leverage, and the governance you’ll deploy to succeed in the cloud.

    This storyboard comprises four phases, covering mission and vision, people, governance, and technology, and how each of these areas requires forethought when migrating to the cloud.

    • Document Your Cloud Strategy – Phases 1-4

    2. Cloud Strategy Document Template – a template that allows you to record the results of the cloud strategy exercise in a clear, readable way.

    Each section of Document Your Cloud Strategy corresponds to a section in the document template. Once you’ve completed each exercise, you can record your results in the document template, leaving you with an artifact you can share with stakeholders.

    • Cloud Strategy Document Template
    [infographic]

    Workshop: Document Your Cloud Strategy

    Workshops offer an easy way to accelerate your project. If you are unable to do the project yourself, and a Guided Implementation isn't enough, we offer low-cost delivery of our project workshops. We take you through every phase of your project and ensure that you have a roadmap in place to complete your project successfully.

    1 Document Your Vision and Alignment

    The Purpose

    Understand and document your cloud vision and its alignment with your other strategic priorities.

    Key Benefits Achieved

    A complete understanding of your strategy, vision, alignment, and a list of success metrics that will help you find your way.

    Activities

    1.1 Record your cloud mission and vision.

    1.2 Document your cloud strategy’s alignment with other strategic plans.

    1.3 Record your cloud guiding principles.

    Outputs

    Documented strategy, vision, and alignment.

    Defined success metrics.

    2 Record Your People Strategy

    The Purpose

    Define how people, skills, and roles will contribute to the broader cloud strategy.

    Key Benefits Achieved

    Sections of the strategy that highlight skills, roles, culture, adoption, and the creation of a governance body.

    Activities

    2.1 Outline your skills and roles strategy.

    2.2 Document your approach to culture and adoption

    2.3 Create a cloud governing body.

    Outputs

    Documented people strategy.

    3 Document Governance Principles

    The Purpose

    This section facilitates governance in the cloud, developing principles that apply to architecture, integration, finance management, and more.

    Key Benefits Achieved

    Sections of the strategy that define governance principles.

    Activities

    3.1 Conduct discussion on architecture.

    3.2 Conduct discussion on integration and interoperability.

    3.3 Conduct discussion on operations management.

    3.4 Conduct discussion on cloud portfolio management.

    3.5 Conduct discussion on cloud vendor management.

    3.6 Conduct discussion on finance management.

    3.7 Conduct discussion on security.

    3.8 Conduct discussion on data controls.

    Outputs

    Documented cloud governance strategy.

    4 Formalize Your Technology Strategy

    The Purpose

    Creation of a formal cloud strategy relating to technology around provisioning, monitoring, and migration.

    Key Benefits Achieved

    Completed strategy sections of the document that cover technology areas.

    Activities

    4.1 Formalize organizational approach to monitoring.

    4.2 Document provisioning process.

    4.3 Outline migration processes and procedures.

    Outputs

    Documented cloud technology strategy.

    Further reading

    Document Your Cloud Strategy

    Get ready for the cloudy future with a consistent, proven strategy.

    Analyst perspective

    Any approach is better than no approach

    The image contains a picture of Jeremy Roberts

    Moving to the cloud is a big, scary transition, like moving from gas-powered to electric cars, or from cable to streaming, or even from the office to working from home. There are some undeniable benefits, but we must reorient our lives a bit to accommodate those changes, and the results aren’t always one-for-one. A strategy helps you make decisions about your future direction and how you should respond to changes and challenges. In Document Your Cloud Strategy we hope to help you accomplish just that: clarifying your overall mission and vision (as it relates to the cloud) and helping you develop an approach to changes in technology, people management, and, of course, governance. The cloud is not a panacea. Taken on its own, it will not solve your problems. But it can be an important tool in your IT toolkit, and you should aim to make the best use of it – whatever “best” happens to mean for you.

    Jeremy Roberts

    Research Director, Infrastructure and Operations

    Info-Tech Research Group

    Executive Summary

    Your Challenge

    The cloud is multifaceted. It can be complicated. It can be expensive. Everyone has an opinion on the best way to proceed – and in many cases has already begun the process without bothering to get clearance from IT. The core challenge is creating a coherent strategy to facilitate your overall goals while making the best use of cloud technology, your financial resources, and your people.

    Common Obstacles

    Despite the universally agreed-upon benefit of formulating a coherent strategy, several obstacles make execution difficult:

    • Inconsistent understanding of what the cloud means
    • Inability to come to a consensus on key decisions
    • Ungoverned decision making
    • Unclear understanding of cloud roles and responsibilities

    Info-Tech’s Approach

    A cloud strategy might seem like a big project, but it’s just a series of smaller conversations. The methodology presented here is designed to facilitate those conversations, using a curated list of topics, prompts, participant lists, and sample outcomes. We have divided the strategy into four key areas:

    1. Vision and alignment
    2. People
    3. Governance
    4. Technology

    The answers might be different, but the questions are the same

    Every organization will approach the cloud differently, but they all need to ask the same questions: When will we use the cloud? What forms will our cloud usage take? How will we manage governance? What will we do about people? How will we incorporate new technology into our environment? The answers to these questions are as numerous as there are people to answer them, but the questions must be asked.

    Your challenge

    This research is designed to help organizations that are facing these challenges or looking to:

    • Ensure that the cloud strategy is complete and accurately reflects organizational goals and priorities.
    • Develop a consistent and coherent approach to adopting cloud services.
    • Design an approach to mitigate risks and challenges associated with adopting cloud services.
    • Create a shared understanding of the expected benefits of cloud services and the steps required to realize those benefits.

    Grappling with a cloud strategy is a top initiative: 43% of respondents report progressing on a cloud-first strategy as a top cloud initiative.

    Source: Flexera, 2021.

    Definition: Cloud strategy

    A document providing a systematic overview of cloud services, their appropriate use, and the steps that an organization will take to maximize value and minimize risk.

    Common obstacles

    These barriers make this challenge difficult to address for many organizations:

    • The cloud means different things to different people, and creating a strategy that is comprehensive enough to cover a multitude of use cases while also being written to be consumable by all stakeholders is difficult.
    • The incentives to adopt the cloud differ based on the expected benefit for the individual customer. User-led decision making and historically ungoverned deployments can make it difficult to reset expectation and align with a formal strategy.
    • Getting all the right people in a room together to agree on the key components of the strategy and the direction undertaken for each one is often difficult.

    Info-Tech’s approach

    Define Your Cloud Vision

    Vision and alignment

    • Mission and vision
    • Alignment to other strategic plans
    • Guiding principles
    • Measuring success

    Technology

    • Monitoring
    • Provisioning
    • Migration

    Governance

    • Architecture
    • Integration and interoperability
    • Operations management
    • Cloud portfolio management
    • Cloud vendor management
    • Finance management
    • Security
    • Data controls

    People

    • Skills and roles
    • Culture and adoption
    • Governing bodies

    Info-Tech’s approach

    Your cloud strategy will comprise the elements listed under “vision and alignment,” “technology,” “governance,” and “people.” The Info-Tech methodology involves breaking the strategy down into subcomponents and going through a three-step process for each one. Start by reviewing a standard set of questions and understanding the goal of the exercise: What do we need to know? What are some common considerations and best practices? Once you’ve had a chance to review, discuss your current state and any gaps: What has been done? What still needs to be done? Finally, outline how you plan to go forward: What are your next steps? Who needs to be involved?

    Review

    • What questions do we need to answer to complete the discussion of this strategy component? What does the decision look like?
    • What are some key terms and best practices we must understand before deciding?

    Discuss

    • What steps have we already taken to address this component?
    • Does anything still need to be done?
    • Is there anything we’re not sure about or need further guidance on?

    Go forward

    • What are the next steps?
    • Who needs to be involved?
    • What questions still need to be asked/answered?
    • What should the document’s wording look like?

    Info-Tech’s methodology for documenting your cloud strategy

    1. Document your vision and alignment

    2. Record your people strategy

    3. Document governance principles

    4. Formalize your technology strategy

    Phase Steps

    1. Record your cloud mission and vision
    2. Document your cloud strategy’s alignment with other strategic plans
    3. Record your cloud guiding principles
    4. Define success
    1. Outline your skills and roles strategy
    2. Document your approach to culture and adoption
    3. Create a cloud governing body

    Document official organizational positions in these governance areas:

    1. Architecture
    2. Integration and interoperability
    3. Operations management
    4. Cloud portfolio management
    5. Cloud vendor management
    6. Finance management
    7. Security
    8. Data controls
    1. Formalize organizational approach to monitoring
    2. Document provisioning process
    3. Outline migration processes and procedures

    Phase Outcomes

    Documented strategy: vision and alignment

    Documented people strategy

    Documented cloud governance strategy

    Documented cloud technology strategy

    Insight summary

    Separate strategy from tactics

    Separate strategy from tactics! A strategy requires building out the framework for ongoing decision making. It is meant to be high level and achieve a large goal. The outcome of a strategy is often a sense of commitment to the goal and better communication on the topic.

    The cloud does not exist in a vacuum

    Your cloud strategy flows from your cloud vision and should align with the broader IT strategy. It is also part of a pantheon of strategies and should exist harmoniously with other strategies – data, security, etc.

    People problems needn’t preponderate

    The cloud doesn’t have to be a great disruptor. If you handle the transition well, you can focus your people on doing more valuable work – and this is generally engaging.

    Governance is a means to an end

    Governing your deployment for its own sake will only frustrate your end users. Articulate the benefits users and the organization can expect to see and you’re more likely to receive the necessary buy-in.

    Technology isn’t a panacea

    Technology won’t solve all your problems. Technology is a force multiplier, but you will still have to design processes and train your people to fully leverage it.

    Key deliverable

    Cloud Strategy Document template

    Inconsistency and informality are the enemies of efficiency. Capture the results of the cloud strategy generation exercises in the Cloud Strategy Document template.

    The image contains a screenshot of the Cloud Strategy Document Template.
    • Record the results of the exercises undertaken as part of this blueprint in the Cloud Strategy Document template.
    • It is important to remember that not every cloud strategy will look exactly the same, but this template represents an amalgamation of best practices and cloud strategy creation honed over several years of advisory service in the space.
    • You know your audience better than anyone. If you would prefer a strategy delivered in a different way (e.g. presentation format) feel free to adapt the Cloud Vision Executive Presentation into a longer strategy presentation.
    • Emphasis is an area where you should exercise discretion as well. A cost-oriented cloud strategy, or one that prioritizes one type of cloud (e.g. SaaS) at the exclusion of others, may benefit from more focus on some areas than others, or the introduction of relevant subcategories. Include as many of these as you think will be relevant.
    • Parsimony is king – if you can distill a concept to its essence, start there. Include additional detail only as needed. You want your cloud strategy document to be read. If it’s too long or overly detailed, you’ll encounter readability issues.

    Blueprint benefits

    IT benefits

    Business benefits

    • A consistent, well-defined approach to the cloud
    • Consensus on key strategy components, including security, architecture, and integration
    • A clear path forward on skill development and talent acquisition/retention
    • A comprehensive resource for information about the organization’s approach to key strategy components
    • Predictable access to cloud services
    • A business-aligned approach to leveraging the resources available in the cloud
    • Efficient and secure consumption of cloud resources where appropriate to do so
    • Answers to questions about the cloud and how it will be leveraged in the environment

    Measure the value of this blueprint

    Don’t take our word for it:

    • Document Your Cloud Strategy has been available for several years in various forms as both a workshop and as an analyst-led guided implementation.
    • After each engagement, we send a survey that asks members how they benefited from the experience. Those who have worked through Info-Tech’s cloud strategy material have given overwhelmingly positive feedback.
    • Additionally, members reported saving between 10 and 20 days and an average of $46,499.
    • Measure the value by calculating the time saved as a result of using Info-Tech’s framework vs. a home-brewed cloud strategy alternative and by comparing the overall cost of a guided implementation or workshop with the equivalent offering from another firm. We’re confident you’ll come out ahead.

    8.8/10 Average reported satisfaction

    13 Days Average reported time savings

    $46,499 Average cost savings

    Executive Brief Case Study

    INDUSTRY: Pharmaceuticals

    SOURCE: Info-Tech workshop

    Pharmaceutical company

    The unnamed pharmaceutical company that is the subject of this case study was looking to make the transition to the cloud. In the absence of a coherent strategy, the organization had a few cloud deployments with no easily discernable overall approach. Representatives of several distinct functions (legal, infrastructure, data, etc.) all had opinions on the uses and abuses of cloud services, but it had been difficult to round everyone up and have the necessary conversations. As a result, the strategy exercise had not proceeded in a speedy or well-governed way. This lack of strategic readiness presented a roadblock to moving forward with the cloud strategy and to work with the cloud implementation partner, tasked with execution.

    Results

    The company engaged Info-Tech for a four-day workshop on cloud strategy documentation. Over the course of four days, participants drawn from across the organization discussed the strategic components and generated consensus statements and next steps. The team was able to formalize the cloud strategy and described the experience as saving 10 days.

    Example output: Document your cloud strategy workshop exercise

    The image contains an example of Document your cloud streatgy workshop exercise.

    Anything in green, the team was reasonably sure they had good alignment and next steps. Those yellow flags warranted more discussion and were not ready for documentation.

    Info-Tech offers various levels of support to best suit your needs

    DIY Toolkit

    "Our team has already made this critical project a priority, and we have the time and capability, but some guidance along the way would be helpful."

    Guided Implementation

    "Our team knows that we need to fix a process, but we need assistance to determine where to focus. Some check-ins along the way would help keep us on track."

    Workshop

    "We need to hit the ground running and get this project kicked off immediately. Our team has the ability to take this over once we get a framework and strategy in place."

    Consulting

    "Our team does not have the time or the knowledge to take this project on. We need assistance through the entirety of this project."

    Diagnostics and consistent frameworks are used throughout all four options.

    Guided Implementation

    What does a typical GI on this topic look like?

    Document your vision and alignment

    Record your people strategy

    Document governance principles

    Formalize your technology strategy

    Call #1: Review existing vision/strategy documentation.

    Call #2: Review progress on skills, roles, and governance bodies.

    Call #3: Work through integration, architecture, finance management, etc. based on reqs. (May be more than one call.)

    Call #4: Discuss challenges with monitoring, provisioning, and migration as-needed.

    A Guided Implementation (GI) is a series of calls with an Info-Tech analyst to help implement our best practices in your organization. A typical GI is 4 to 6 calls over the course of 1 to 3 months

    Workshop Overview

    Contact your account representative for more information.

    workshops@infotech.com 1-888-670-8889

    Day 1

    Day 2

    Day 3

    Day 4

    Day 5

    Answer
    “so what?”

    Define the
    IT target state

    Assess the IT
    current state

    Bridge the gap and
    create the strategy

    Next steps and
    wrap-up (offsite)

    Activities

    1.1 Introduction

    1.2 Discuss cloud mission and vision

    1.3 Discuss alignment with other strategic plans

    1.4 Discuss guiding principles

    1.5 Define success metrics

    2.1 Discuss skills and roles

    2.2 Review culture and adoption

    2.3 Discuss a cloud governing body

    2.4 Review architecture position

    2.5 Discuss integration and interoperability

    3.1 Discuss cloud operations management

    3.2 Review cloud portfolio management

    3.3 Discuss cloud vendor management

    3.4 Discuss cloud finance management

    3.5 Discuss cloud security

    4.1 Review and formalize data controls

    4.2 Design a monitoring approach

    4.3 Document the workload provisioning process

    4.4 Outline migration processes and procedures

    5.1 Populate the Cloud Strategy Document

    Deliverables

    Formalized cloud mission and vision, along with alignment with strategic plans, guiding principles, and success metrics

    Position statement on skills and roles, culture and adoption, governing bodies, architecture, and integration/interoperability

    Position statements on cloud operations management, portfolio management, vendor management, finance management, and cloud security

    Position statements on data controls, monitoring, provisioning, and migration

    Completed Cloud Strategy Document

    Phase 1

    Document Your Vision and Alignment

    Phase 1

    Phase 2

    Phase 3

    Phase 4

    1.1 Document your mission and vision

    1.2 Document alignment to other strategic plans

    1.3 Document guiding principles

    1.4 Document success metrics

    2.1 Define approach to skills and roles

    2.2 Define approach to culture and adoption

    2.3 Define cloud governing bodies

    3.1 Define architecture direction

    3.2 Define integration approach

    3.3 Define operations management process

    3.4 Define portfolio management direction

    3.5 Define vendor management direction

    3.6 Document finance management tactics

    3.7 Define approach to cloud security

    3.8 Define data controls in the cloud

    4.1 Define cloud monitoring strategy

    4.2 Define cloud provisioning strategy

    4.3 Define cloud migration strategy

    This phase will walk you through the following activities:

    1. Record your cloud mission and vision
    2. Document your cloud strategy’s alignment with other strategic plans
    3. Record your cloud guiding principles
    4. Define success

    This phase has the following outcome:

    • Documented strategy: vision and alignment

    Record your mission and vision

    Build on the work you’ve already done

    Before formally documenting your cloud strategy, you should ensure that you have a good understanding of your overall cloud vision. How do you plan to leverage the cloud? What goals are you looking to accomplish? How will you distribute your workloads between different cloud service models (SaaS, PaaS, IaaS)? What will your preferred delivery model be (public, private, hybrid)? Will you support your cloud deployment internally or use the services of various consultants or managed service providers?

    The answers to these questions will inform the first section of your cloud strategy. If you haven’t put much thought into this or think you could use a deep dive on the fundamentals of your cloud vision and cloud archetypes, consider reviewing Define Your Cloud Vision, the companion blueprint to this one.

    Once you understand your cloud vision and what you’re trying to accomplish with your cloud strategy, this phase will walk you through aligning the strategy with other strategic initiatives. What decisions have others made that will impact the cloud strategy (or that the cloud strategy will impact)? Who must be involved/informed? What callouts must be involved at what point? Do users have access to the appropriate strategic documentation (and would they understand it if they did)?

    You must also capture some guiding principles. A strategy by its nature provides direction, helping readers understand the decisions they should make and why those decisions align with organizational interests. Creating some top-level principles is a useful exercise because those principles facilitate comprehension and ensure the strategy’s applicability.

    Finally, this phase will walk you through the process of measuring success. Once you know where you’d like to go, the principles that underpin your direction, and how your cloud strategy figures into the broader strategic pantheon, you should record what success actually means. If you’re looking to save money, overall cost should be a metric you track. If the cloud is all about productivity, generate appropriate productivity metrics. If you’re looking to expand into new technology or close a datacenter, you will need to track output specific to those overall goals.

    Review: mission and vision

    The overall organizational mission is a key foundational element of the cloud strategy. If you don’t understand where you’re going, how can you begin the journey to get there? This section of the strategy has four key parts that you should understand and incorporate into the beginning of the strategy document. If you haven’t already, review Define Your Cloud Vision for instructions on how to generate these elements.

    1. Cloud vision statement: This is a succinct encapsulation of your overall perspective on the suitability of cloud services for your environment – what you hope to accomplish. The ideal statement includes a scope (who/what does the strategy impact?), a goal (what will it accomplish?), and a key differentiator (what will make it happen?). This is an example: “[Organization] will leverage public cloud solutions and retire existing datacenter and colocation facilities. This transition will simplify infrastructure administration, support and security, while modernizing legacy infrastructure and reducing the need for additional capital expenditure.” You might also consider reviewing your overall cloud archetype (next slide) and including the output of that exercise in the document

    2. Service model decision framework: Services can be provided as software as a service (SaaS), platform as a service (PaaS), infrastructure as a service (IaaS), or they can be colocated or remain on premises. Not all cloud service models serve the same purpose or provide equal value in all circumstances. Understanding how you plan to take advantage of these distinct service models is an important component of the cloud strategy. In this section of the strategy, a rubric that captures the characteristics of the ideal workload for each of the named service models, along with some justification for the selection, is essential. This is a core component of Define Your Cloud Vision, and if you would like to analyze individual workloads, you can use the Cloud Vision Workbook for that purpose.

    3. Delivery model decision framework: Just as there are different cloud service models that have unique value propositions, there are several unique cloud delivery models as well, distinguished by ownership, operation, and customer base. Public clouds are the purview of third-party providers who make them available to paying customers. Private clouds are built for the exclusive use of a designated organization or group of organizations with internal clients to serve. Hybrid clouds involve the use of multiple, interoperable delivery models (interoperability is the key term here), while multi-cloud deployment models incorporate multiple delivery and service models into a single coherent strategy. What will your preferred delivery model be? Why?

    4. Support model decision framework: Once you have a service model nailed down and understand how you will execute on the delivery, the question then becomes about how you will support your cloud deployment going forward. Broadly speaking, you can choose to manage your deployment in house using internal resources (e.g. staff), to use managed service providers for ongoing support, or to hire consultants to handle specific projects/tasks. Each approach has its strengths and weaknesses, and many cloud customers will deploy multiple support models across time and different workloads. A foundational perspective on the support model is a key component of the cloud vision and should appear early in the strategy.

    Understand key cloud concepts: Archetype

    Once you understand the value of the cloud, your workloads’ general suitability for the cloud, and your proposed risks and mitigations, the next step is to define your cloud archetype. Your organization’s cloud archetype is the strategic posture that IT adopts to best support the organization’s goals. Info-Tech’s model recognizes seven archetypes, divided into three high-level archetypes. After consultation with your stakeholders, and based on the results of the suitability and risk assessment activities, define your archetype. The archetype feeds into the overall cloud vision and provides simple insight into the cloud future state for all stakeholders. The cloud vision itself is captured in a “vision statement,” a short summary of the overall approach that includes the overall cloud archetype.

    The image contains an arrow facing vertically up. The pointed end of the arrow is labelled more cloud, and the bottom of the arrow is labelled less cloud.

    We can best support the organization’s goals by:

    Cloud-Focused

    Cloud-Centric

    Providing all workloads through cloud delivery.

    Cloud-First

    Using the cloud as our default deployment model. For each workload, we should ask “why NOT cloud?”

    Cloud-Opportunistic

    Hybrid

    Enabling the ability to transition seamlessly between on-premises and cloud resources for many workloads.

    Integrated

    Combining cloud and traditional infrastructure resources, integrating data and applications through APIs or middleware.

    Split

    Using the cloud for some workloads and traditional infrastructure resources for others.

    Cloud-Averse

    Cloud-Light

    Using traditional infrastructure resources and limiting our use of the cloud to when it is absolutely necessary.

    Anti-Cloud

    Using traditional infrastructure resources and avoiding the use of cloud wherever possible.

    Implement a Social Media Program

    • Buy Link or Shortcode: {j2store}560|cart{/j2store}
    • member rating overall impact: N/A
    • member rating average dollars saved: N/A
    • member rating average days saved: N/A
    • Parent Category Name: Marketing Solutions
    • Parent Category Link: /marketing-solutions
    • IT is being caught in the middle of various business units, all separately attempting to create, staff, implement, and instrument a social media program.
    • Requests for procuring social media tools and integrating with CRM systems are coming from all directions, with no central authority governing a social media program or coordinating business goals.
    • Public Relations and Corporate Communications groups have been acting as the first level of response to social media channels since the company’s first Twitter account went live, but the volume of inquiries received through social channels has become too great for these groups to continue in a first responder role.

    Our Advice

    Critical Insight

    • Social media immaturity is an opportunity for IT leadership. As with so many of the “next new things,” IT has an opportunity to help the business understand social media technologies, trends, and risks, and coordinate efforts to approach social media as a united company.
    • Social media maturity must reach the Social Media Steering Committee stage before major investments in technology can proceed. As with all business initiatives, technology automation decisions cannot be made without respect to organizational and process maturity. Social media strategy stakeholders must join together and form a steering committee to create policies and procedures, govern strategy, develop workflows, and facilitate technology selection processes. IT not only belongs on such a steering committee, but it can also be instrumental in the formation of it.
    • Info-Tech’s research repeatedly indicates that the greatest return from social media investments is in the customer service domain, by reacting to incoming social inquiries and proactively listening to social conversations for product and service inquiry opportunities. This means CRM integration is essential to long-term social media program success.

    Impact and Result

    • Assess your organization’s social maturity to know where to begin and where to go in implementation of a social media program.
    • Form a social media steering committee to bring order to chaos among different business units.
    • Develop comprehensive workflows to categorize and prioritize inquiries, and then route them to the appropriate part of the business for resolution.
    • Consider creating one or more physical social media command centers to process large volumes of social inquiries more efficiently and monitor real-time social media metrics to improve critical response times.

    Implement a Social Media Program Research & Tools

    Besides the small introduction, subscribers and consulting clients within this management domain have access to:

    1. Assess your organization's social maturity

    Know where to begin and where to go in implementation of a social media program.

    • Storyboard: Implement a Social Media Program
    • Social Media Maturity Assessment Tool

    2. Form a social media steering committee

    Bring order to chaos among different business units.

    • Social Media Steering Committee Charter Template
    • Social Media Acceptable Use Policy
    • Blogging and Microblogging Guidelines Template

    3. Consider creating one or more physical social media command centers

    Process large volumes of social inquiries more efficiently, and monitor real-time social media metrics to improve critical response times.

    • Social Media Representative
    • Social Media Manager
    [infographic]

    Drive Real Business Value with an HRIS Strategy

    • Buy Link or Shortcode: {j2store}586|cart{/j2store}
    • member rating overall impact: 9.1/10 Overall Impact
    • member rating average dollars saved: $43,457 Average $ Saved
    • member rating average days saved: 36 Average Days Saved
    • Parent Category Name: Human Resource Systems
    • Parent Category Link: /human-resource-systems
    • In most organizations, the HR application portfolio has evolved tactically on an as-needed basis, resulting in un-integrated systems and significant effort spent on manual workarounds.
    • The relationship between HR and IT is not optimal for technology decision making. System-related decisions are made by HR and IT is typically involved only post-purchase to fix issues as they arise and offer workarounds.
    • IT systems for HR are not viewed as a strategic differentiator or business enabler, thereby leading to a limited budget and resources for HR IT systems and subsequently hindering the adoption of a strategic, holistic perspective.
    • Some organizations overinvest, while others underinvest in lightweight, point-to-point solutions. Finding the sweet spot between a full suite and lightweight functionality is no easy task.

    Our Advice

    Critical Insight

    • Align HRIS goals with the business. Organizations must position HR as a partner prior to embarking on an HRIS initiative, aligning technology goals with organizational objectives before looking at software.
    • Communication is key. Often, HR and IT speak different languages. Maintain a high degree of communication by engaging stakeholder groups early.
    • Plan where you want to go. Designing a roadmap based on clear requirements, alignment with the business, and an understanding of priorities will contribute to success.

    Impact and Result

    • Evaluate the current state of HRIS, understand the pain points, and visualize your ideal processes prior to choosing a solution.
    • Explore the different solution alternatives: maintain current system, integrate and consolidate, augment, or replace system entirely.
    • Create a plan to engage IT and HR throughout the project. Equip HR with the decision-making tools to meet business objectives and drive business strategy. Establish a common language for IT and HR to effectively communicate.
    • Develop a practical and actionable roadmap that the entire organization can buy into.

    Drive Real Business Value with an HRIS Strategy Research & Tools

    Start here – read the Executive Brief

    Read our concise Executive Brief to find out why you should develop an HRIS strategy, review Info-Tech’s methodology, and understand the four ways we can support you in completing this project.

    Besides the small introduction, subscribers and consulting clients within this management domain have access to:

    1. Conduct an environmental scan

    Create a clear project vision that outlines the goals and objectives for the HRIS strategy. Subsequently, construct an HRIS business model that is informed by enablers, barriers, and the organizational, IT, and HR needs.

    • Drive Real Business Value with an HRIS Strategy – Phase 1: Conduct an Environmental Scan
    • Establish an HRIS Strategy Project Charter Template
    • HRIS Readiness Assessment Checklist

    2. Design the future state

    Gather high-level requirements to determine the ideal future state. Explore solution alternatives and choose the path that is best aligned with the organization's needs.

    • Drive Real Business Value with an HRIS Strategy – Phase 2: Design the Future State
    • HRIS Strategy Stakeholder Interview Guide
    • Process Owner Assignment Guide

    3. Finalize the roadmap

    Identify roadmap initiatives. Prioritize initiatives based on importance and effort.

    • Drive Real Business Value with an HRIS Strategy – Phase 3: Finalize the Roadmap
    • Initiative Roadmap Tool
    • HRIS Stakeholder Presentation Template
    [infographic]

    Workshop: Drive Real Business Value with an HRIS Strategy

    Workshops offer an easy way to accelerate your project. If you are unable to do the project yourself, and a Guided Implementation isn't enough, we offer low-cost delivery of our project workshops. We take you through every phase of your project and ensure that you have a roadmap in place to complete your project successfully.

    1 Conduct an Environmental Scan

    The Purpose

    Understand the importance of creating an HRIS strategy before proceeding with software selection and implementation.

    Learn why a large percentage of HRIS projects fail and how to avoid common mistakes.

    Set expectations for the HRIS strategy and understand Info-Tech’s HRIS methodology.

    Complete a project charter to gain buy-in, build a project team, and track project success.

    Key Benefits Achieved

    A go/no-go decision on the project appropriateness.

    Project stakeholders identified.

    Project team created with defined roles and responsibilities.

    Finalized project charter to gain buy-in.

    Activities

    1.1 Set a direction for the project by clarifying the focus.

    1.2 Identify the right stakeholders for your project team.

    1.3 Identify HRIS needs, barriers, and enablers.

    1.4 Map the current state of your HRIS.

    1.5 Align your business goals with your HR goals and objectives.

    Outputs

    Project vision

    Defined project roles and responsibilities

    Completed HRIS business model

    Completed current state map and thorough understanding of the HR technology landscape

    Strategy alignment between HR and the business

    2 Design the Future State

    The Purpose

    Gain a thorough understanding of the HRIS-related pains felt throughout the organization.

    Use stakeholder-identified pains to directly inform the HRIS strategy and long-term solution.

    Visualize your ideal processes and realize the art of the possible.

    Key Benefits Achieved

    Requirements to strengthen the business case and inform the strategy.

    The art of the possible.

    Activities

    2.1 Requirements gathering.

    2.2 Sketch ideal future state processes.

    2.3 Establish process owners.

    2.4 Determine guiding principles.

    2.5 Identify metrics.

    Outputs

    Pain points classified by data, people, process, and technology

    Ideal future process vision

    Assigned process owners, guiding principles, and metrics for each HR process in scope

    3 Create Roadmap and Finalize Deliverable

    The Purpose

    Brainstorm and prioritize short- and long-term HRIS tasks.

    Key Benefits Achieved

    Understand next steps for the HRIS project.

    Activities

    3.1 Create a high-level implementation plan that shows dependencies.

    3.2 Identify risks and mitigation efforts.

    3.3 Finalize stakeholder presentation.

    Outputs

    Completed implementation plan

    Completed risk management plan

    HRIS stakeholder presentation

    Industry-Specific Digital Transformation

    • member rating overall impact: N/A
    • member rating average dollars saved: N/A
    • member rating average days saved: N/A
    • Parent Category Name: Innovation
    • Parent Category Link: /innovation

    Besides the small introduction, subscribers and consulting clients within this management domain have access to:

    Infographic

    Integrate Physical Security and Information Security

    • Buy Link or Shortcode: {j2store}383|cart{/j2store}
    • member rating overall impact: N/A
    • member rating average dollars saved: N/A
    • member rating average days saved: N/A
    • Parent Category Name: Security Processes & Operations
    • Parent Category Link: /security-processes-and-operations

    Physical security is often managed by facilities, not by IT security, resulting in segmented security systems. Integrating physical and information security introduces challenges in:

    • Understanding the value proposition of investment in governing and managing integrated systems, including migration costs, compared to separated security systems.
    • Addressing complex risks and vulnerabilities of an integrated security system.
    • Operationalizing enhanced capabilities created by adoption of emerging and disruptive technologies.

    Our Advice

    Critical Insight

    • Integrate security in people, process, and technology to improve your overall security posture. Having siloed systems running security is not beneficial. Many organizations are realizing the benefits of consolidating into a single platform across physical security, cybersecurity, HR, legal, and compliance.
    • Plan and engage stakeholders. Assemble the right team to ensure the success of your integrated security ecosystem, decide the governance model, and clearly define the roles and responsibilities.
    • Enhance strategy and risk management. Strategically, we want a physical security system that is interoperable with most technologies, flexible with minimal customization, functional, and integrated, despite the challenges of proprietary configurations, complex customization, and silos.

    Impact and Result

    Info-Tech's approach is a modular, incremental, and repeatable process to integrate physical and information security to:

    • Ensure the integration will meet the business' needs and determine effort and technical requirements.
    • Establish GRC processes that include integrated risk management and compliance.
    • Design and deploy an integrated security architecture.
    • Establish security metrics of effectiveness and efficiency for senior management and leadership.

    Integrate Physical Security and Information Security Research & Tools

    Besides the small introduction, subscribers and consulting clients within this management domain have access to:

    1. Integrate Physical Security and Information Security Storyboard – A step-by-step document that walks you through how to integrate physical security and information security.

    Info-Tech provides a three-phased framework for integrating physical security and information security: Plan, Enhance, and Monitor & Optimize.

    • Integrate Physical Security and Information Security Storyboard

    2. Integrate Physical Security and Information Security Requirements Gathering Tool – A tool to map organizational goals to IT goals, facilities goals, OT goals (if applicable), and integrated security goals.

    This tool serves as a repository for information about security integration elements, compliance, and other factors that will influence your integration of physical security and information security.

    • Integrate Physical Security and Information Security Requirements Gathering Tool

    3. Integrate Physical Security and Information Security RACI Chart Tool – A tool to identify and understand the owners of various security integration stakeholders across the organization.

    Populating a RACI chart (Responsible, Accountable, Consulted, and Informed) is a critical step that will assist you in organizing roles for carrying out integration steps. Complete this tool to assign tasks to suitable roles.

    • Integrate Physical Security and Information Security RACI Chart Tool

    4. Integrate Physical Security and Information Security Communication Deck – A tool to present your findings in a prepopulated document that summarizes the work you have completed.

    Complete this template to effectively communicate your integrated security plan to stakeholders.

    • Integrate Physical Security and Information Security Communication Deck
    [infographic]

    Further reading

    Integrate Physical Security and Information Security

    Securing information security, physical security, or personnel security in silos may not secure much

    Analyst Perspective

    Ensure integrated security success with close and continual collaboration

    From physical access control systems (PACS) such as electronic locks and fingerprint biometrics to video surveillance systems (VSS) such as IP cameras to perimeter intrusion detection and prevention to fire and life safety and beyond: physical security systems pose unique challenges to overall security. Additionally, digital transformation of physical security to the cloud and the convergence of operational technology (OT), internet of things (IoT), and industrial IoT (IIoT) increase both the volume and frequency of security threats.

    These threats can be safety, such as the health impact when a gunfire attack downed wastewater pumps at Duke Energy Substation, North Carolina, US, in 2022. The threats can also be economic, such as theft of copper wire, or they can be reliability, such as when a sniper attack on Pacific Gas & Electric’s Metcalf Substation in California, US, damaged 17 out of 21 power transformers in 2013.

    Considering the security risks organizations face, many are unifying physical, cyber, and information security systems to gain the long-term overall benefits a consolidated security strategy provides.

    Ida Siahaan
    Ida Siahaan

    Research Director, Security and Privacy Practice
    Info-Tech Research Group

    Executive Summary

    Your Challenge

    Physical security is often managed by facilities, not by IT security, resulting in segmented security systems. Meanwhile, integrating physical and information security introduces challenges in:

    • Value proposition of investment in governing and managing integrated systems including the migration costs compared to separated security systems.
    • Addressing complex risks and vulnerabilities of an integrated security system.
    • Operationalizing on enhanced capabilities created by adoption of emerging and disruptive technologies.

    Common Obstacles

    Physical security systems integration is complex due to various components such as proprietary devices and protocols and hybrid systems of analog and digital technology. Thus, open architecture with comprehensive planning and design is important.

    However, territorial protection by existing IT and physical security managers may limit security visibility and hinder security integration.

    Additionally, integration poses challenges in staffing, training and awareness programs, and dependency on third-party technologies and their migration plans.

    Info-Tech's Approach

    Info-Tech’s approach is a modular, incremental, and repeatable process to integrate physical and information security that enables organizations to:

    • Determine effort and technical requirements to ensure the integration will meet the business needs.
    • Establish GRC processes including integrated risk management and compliance.
    • Design and deploy integrated security architecture.
    • Establish metrics to monitor the effectiveness and efficiency of the security program.

    Info-Tech Insight

    An integrated security architecture, including people, process, and technology, will improve your overall security posture. These benefits are leading many organizations to consolidate their siloed systems into a single platform across physical security, cybersecurity, HR, legal, and compliance.

    Existing information security models are not comprehensive

    Current security models do not cover all areas of security, especially if physical systems and personnel are involved and safety is also an important property required.

    • The CIA triad (confidentiality, integrity, availability) is a well-known information security model that focuses on technical policies related to technology for protecting information assets.
    • The US Government’s Five Pillars of Information Assurance includes CIA, authentication, and non-repudiation, but it does not cover people and processes comprehensively.
    • The AAA model, created by the American Accounting Association, has properties of authentication, authorization, and accounting but focuses only on access control.
    • Donn Parker expanded the CIA model with three more properties: possession, authenticity, and utility. This model, which includes people and processes, is known as the Parkerian hexad. However, it does not cover physical and personnel security.

    CIA Triad

    The CIA Triad for Information Security: Confidentiality, Integrity, Availability

    Parkerian Hexad

    The Parkerian Hexad for Security: Confidentiality, Possession, Utility, Availability, Authenticity and Integrity

    Sources: Parker, 1998; Pender-Bey, 2012; Cherdantseva and Hilton, 2015

    Adopt an integrated security model

    Adopt an integrated security model which consists of information security, physical security, personnel security, and organizational security.

    The security ecosystem is shifting from segregation to integration

    Security ecosystem is shifting from the past proprietary model to open interfaces and future open architecture

    Sources: Cisco, n.d.; Preparing for Technology Convergence in Manufacturing, Info-Tech Research Group, 2018

    Physical security includes:

    • Securing physical access,
      e.g. facility access control, alarms, surveillance cameras
    • Securing physical operations
      (operational technology – OT), e.g. programmable logic controllers (PLCs), SCADA

    Info-Tech Insight

    Why is integrating physical and information security gaining more and more traction? Because the supporting technologies are becoming more matured. This includes, for example, migration of physical security devices to IP-based network and open architecture.

    Reactive responses to physical security incidents

    April 1995

    Target: Alfred P. Murrah Federal Building, Oklahoma, US. Method: Bombing. Impact: Destroyed structure of 17 federal agencies, 168 casualties, over 800 injuries. Result: Creation of Interagency Security Committee (ISC) in Executive Order 12977 and “Vulnerability Assessment of Federal Facilities” standard.
    (Source: Office of Research Services, 2017)

    April 2013

    Target: Pacific Gas & Electric’s Metcalf Substation, California, US. Method: Sniper attack. Impact: Out of 21 power transformers, 17 were damaged. Result: Creation of Senate Bill No. 699 and NERC- CIP-014 standard.
    (Source: T&D World, 2023)

    Sep. 2022

    Target: Nord Stream gas pipelines connecting Russia to Germany, Baltic sea. Method: Detonations. Impact: Methane leaks (~300,000 tons) at four exclusive economic zones (two in Denmark and two in Sweden). Result: Sweden’s Security Service investigation.
    (Source: CNBC News, 2022)

    Dec. 2022

    Target: Duke Energy Substation, North Carolina, US. Method: Gunfire. Impact: Power outages of ~40,000 customers and wastewater pumps in sewer lift stations down. Result: State of emergency was declared.
    (Source: CBS News, 2022)

    Info-Tech Insight

    When it comes to physical security, we have been mostly reactive. Typically the pattern starts with physical attacks. Next, the impacted organization mitigates the incidents. Finally, new government regulatory measures or private sector or professional association standards are put in place. We must strive to change our pattern to become more proactive.

    Physical security market forecast and top physical security challenges

    Physical security market forecast
    (in billions USD)

    A forecast by MarketsandMarkets projected growth in the physical security market, using historical data from 2015 until 2019, with a CAGR of 6.4% globally and 5.2% in North America.

    A forecast by MarketsandMarkets projected growth in the physical security market, using historical data from 2015 until 2019, with a CAGR of 6.4% globally and 5.2% in North America.

    Source: MarketsandMarkets, 2022

    Top physical security challenges

    An Ontic survey (N=359) found that threat data management (40%) was the top physical security challenge in 2022, up from 33% in 2021, followed by physical security threats to the C-suite and company leadership (35%), which was a slight increase from 2021. An interesting decrease is data protection and privacy (32%), which dropped from 36% in 2021.

    An Ontic survey (N=359) found that threat data management (40%) was the top physical security challenge in 2022, up from 33% in 2021, followed by physical security threats to the C-suite and company leadership (35%), which was a slight increase from 2021. An interesting decrease is data protection and privacy (32%), which dropped from 36% in 2021.

    Source: Ontic Center for Protective Intelligence, 2022

    Info-Tech Insight

    The physical security market is growing in systems and services, especially the integration of threat data management with cybersecurity.

    Top physical security initiatives and operations integration investments

    We know the physical security challenges and how the physical security market is growing, but what initiatives are driving this growth? These are the top physical security initiatives and top investments for physical security operations integration:

    Top physical security initiatives

    The number one physical security initiative is integrating physical security systems. Other initiatives with similar concerns included data and cross-functional integration

    A survey by Brivo asked 700 security professionals about their top physical security initiatives. The number one initiative is integrating physical security systems. Other initiatives with similar concerns included data and cross-functional integration.

    Source: Brivo, 2022

    Top investments for physical security operations integration

    The number one investment is on access control systems with software to identify physical threat actors. Another area with similar concern is integration of digital physical security with cybersecurity.

    An Ontic survey (N=359) on areas of investment for physical security operations integration shows the number one investment is on access control systems with software to identify physical threat actors. Another area with similar concern is integration of digital physical security with cybersecurity.

    Source: Ontic Center for Protective Intelligence, 2022

    Evaluate security integration opportunities with these guiding principles

    Opportunity focus

    • Identify the security integration problems to solve with visible improvement possibilities
    • Don’t choose technology for technology’s sake
    • Keep an eye to the future
    • Use strategic foresight

    Piece by piece

    • Avoid taking a big bang approach
    • Test technologies in multiple conditions
    • Run inexpensive pilots
    • Increase flexibility
    • Build a technology ecosystem

    Buy-in

    • Collaborate with stakeholders
    • Gain and sustain support
    • Maintain transparency
    • Increase uptake of open architecture

    Key Recommendations:

    Focus on your master plan

    Build a technology ecosystem

    Engage stakeholders

    Info-Tech Insight

    When looking for a quick win, consider learning the best internal or external practice. For example, in 1994 IBM reorganized its security operation by bringing security professionals and non-security professionals in one single structure, which reduced costs by approximately 30% in two years.

    Sources: Create and Implement an IoT Strategy, Info-Tech Research Group, 2022; Baker and Benny, 2013; Erich Krueger, Omaha Public Power District (contributor); Doery Abdou, March Networks Corporate (contributor)

    Case Study

    4Wall Entertainment – Asset Owner

    Industry: Architecture & Engineering
    Source: Interview

    4Wall Entertainment is quite mature in integrating its physical and information security; physical security has always been under IT as a core competency.

    4Wall Entertainment is a provider of entertainment lighting and equipment to event venues, production companies, lighting designers, and others, with a presence in 18 US and UK locations.

    After many acquisitions, 4Wall Entertainment needed to standardize its various acquired systems, including physical security systems such as access control. In its integrated security approach, IT owns the integrated security, but they interface with related entities such as HR, finance, and facilities management in every location. This allows them to obtain information such as holidays, office hours, and what doors need to be accessed as inputs to the security system and to get sponsorship in budgeting.

    In the past, 4Wall Entertainment tried delegating specific physical security to other divisions, such as facilities management and HR. This approach was unsuccessful, so IT took back the responsibility and accountability.

    Currently, 4Wall Entertainment works with local vendors, and its biggest challenge is finding third-party vendors that can provide nationwide support.

    In the future, 4Wall Entertainment envisions physical security modernization such as camera systems that allow more network accessibility, with one central system to manage and IoT device integration with SIEM and MDR.

    Results

    Lessons learned in integrating security from 4Wall Entertainment include:

    • Start with forming relationships with related divisions such as HR, finance, and facilities management to build trust and encourage sponsorship across management.
    • Create policies, procedures, and standards to deploy in various systems, especially when acquiring companies with low maturity in security.
    • Select third-party providers that offer the required functionalities, good customer support, and standard systems interoperability.
    • Close skill gaps by developing training and awareness programs for users, especially for newly acquired systems and legacy systems, or by acquiring expertise from consulting services.
    • Complete cost-benefit analysis for solutions on legacy systems to determine whether to keep them and create interfacing with other systems, upgrade them, or replace them entirely with newer systems.
    • Delegate maintenance of specific highly regulated systems, such as fire alarms and water sprinklers, to facilities management.
    Integration of Physical and Information Security Framework. Inputs: Integrated Items, Stakeholders, and Security Components. Phases, Outcomes and Benefits: Plan, Enhance and Monitor & Optimize.

    Tracking progress of physical and information security integration

    Physical security is often part of facilities management. As a result, there are interdependencies with both internal departments (such as IT, information security, and facilities) and external parties (such as third-party vendors). IT leaders, security leaders, and operational leaders should keep the big picture in mind when designing and implementing integration of physical and information security. Use this checklist as a tool to track your security integration journey.

    Plan

    • Engage stakeholders and justify value for the business.
    • Define roles and responsibilities.
    • Establish/update governance for integrated security.
    • Identify integrated elements and compliance obligations.

    Enhance

    • Determine the level of security maturity and update security strategy for integrated security.
    • Assess and treat risks of integrated security.
    • Establish/update integrated physical and information security policies and procedures.
    • Update incident response, disaster recovery, and business continuity plan.

    Monitor & Optimize

    • Identify skill requirements and close skill gaps for integrating physical and information security.
    • Design and deploy integrated security architecture and controls.
    • Establish, monitor, and report integrated security metrics on effectiveness and efficiency.

    Benefits of the security integration framework

    Today’s matured technology makes security integration possible. However, the governance and management of single integrated security presents challenges. These can be overcome using a multi-phased framework that enables a modular, incremental, and repeatable integration process, starting with planning to justify the value of investment, then enhancing the integrated security based on risks and open architecture. This is followed by using metrics for monitoring and optimization.

    1. Modular

      • Implementing a consolidated security strategy is complex and involves the integration of process, software, data, hardware, and network and infrastructure.
      • A modular framework will help to drive value while putting in appropriate guardrails.
    2. Incremental

      • Integration of physical security and information security involves many components such as security strategy, risk management, and security policies.
      • An incremental framework will help track, manage, and maintain each step while providing appropriate structure.
    3. Repeatable

      • Integration of physical security and information security is a journey that can be approached with a pilot program to evaluate effectiveness.
      • A repeatable framework will help to ensure quick time to value and enable immediate implementation of controls to meet operational and security requirements.

    Potential risks of the security integration framework

    Just as medicine often comes with side effects, our Integration of Physical and Information Security Framework may introduce risks too. However, as John F. Kennedy, thirty-fifth president of the United States, once said, "There are risks and costs to a program of action — but they are far less than the long-range cost of comfortable inaction."

    Plan Phase

    • Lack of transparency in the integration process can lead to lack of trust among stakeholders.
    • Lack of support from leadership results in unclear governance or lack of budget or human resources.
    • Key stakeholders leave the organization during the engagement and their replacements do not understand the organization’s operation yet.

    Enhance Phase

    • The risk assessment conducted focuses too much on IT risk, which may not always be applicable to physical security systems nor OT systems.
    • The integrated security does not comply with policies and regulations.

    Monitor and Optimize Phase

    • Lack of knowledge, training, and awareness.
    • Different testing versus production environments.
    • Lack of collected or shared security metrics.

    Data

    • Data quality issues and inadequate data from physical security, information security, and other systems, e.g. OT, IoT.
    • Too much data from too many tools are complex and time consuming to process.

    Develop an integration of information security, physical security, and personnel security that meets your organization’s needs

    Integrate security in people, process, and technology to improve your overall security posture

    Having siloed systems running security is not beneficial. Many organizations are realizing the benefits of consolidating into a single platform across physical security, cybersecurity, HR, legal, and compliance.

    Plan and engage stakeholders

    Assemble the right team to ensure the success of your integrated security ecosystem, decide the governance model, and clearly define the roles and responsibilities.

    Enhance strategy and risk management

    Strategically, we want a physical security system that is interoperable with most technologies, flexible with minimal customization, functional, and integrated, despite the challenges of proprietary configurations, complex customization, and silos.

    Monitor and optimize

    Find the most optimized architecture that is strategic, realistic, and based on risk. Next, perform an evaluation of the security systems and program by understanding what, where, when, and how to measure and to report the relevant metrics.

    Focus on master plan

    Identify the security integration problems to solve with visible improvement possibilities, and don’t choose technology for technology’s sake. Design first, then conduct market research by comparing products or services from vendors or manufacturers.

    Build a technology ecosystem

    Avoid a big bang approach and test technologies in multiple conditions. Run inexpensive pilots and increase flexibility to build a technology ecosystem.

    Deliverables

    Each step of this framework is accompanied by supporting deliverables to help you accomplish your goals:

    Integrate Physical Security and Information Security Requirements Gathering Tool

    Map organizational goals to IT goals, facilities goals, OT goals (if applicable), and integrated security goals. Identify your security integration elements and compliance.

    Integrate Physical Security and Information Security RACI Chart Tool

    Identify various security integration stakeholders across the organization and assign tasks to suitable roles.

    Key deliverable:

    Integrate Physical Security and Information Security Communication Deck

    Present your findings in a prepopulated document that summarizes the work you have completed.

    Plan

    Planning is foundational to engage stakeholders. Start with justifying the value of investment, then define roles and responsibilities, update governance, and finally identify integrated elements and compliance obligations.

    Plan

    Engage stakeholders

    • To initiate communication between the physical and information security teams and other related divisions, it is important to identify the entities that would be affected by the security integration and involve them in the process to gain support from planning to delivery and maintenance.
    • Possible stakeholders:
      • Executive leadership, Facilities Management leader and team, IT leader, Security & Privacy leader, compliance officer, Legal, Risk Management, HR, Finance, OT leader (if applicable)
    • A successful security integration depends on aligning your security integration initiatives and migration plan to the organization’s objectives by engaging the right people to communicate and collaborate.

    Info-Tech Insight

    It is important to speak the same language. Physical security concerns safety and availability, while information security concerns confidentiality and integrity. Thus, the two systems have different goals and require alignment.

    Similarly, taxonomy of terminologies needs to be managed,1 e.g. facility management with an emergency management background may have a different understanding from a CISO with an information security background when discussing the same term. For example:

    In emergency management prevention means “actions taken to eliminate the impact of disasters in order to protect lives, property and the environment, and to avoid economic disruption.”2

    In information security prevention is “preventing the threats by understanding the threat environment and the attack surfaces, the risks, the assets, and by maintaining a secure system.”3

    Sources: 1 Owen Yardley, Omaha Public Power District (contributor); 2 Translation Bureau, Government of Canada, n.d.; 3 Security Intelligence, 2020

    Map organizational goals to integrated security goals

    Input

    • Corporate, IT, and Facilities strategies

    Output

    • Your goals for the integrated security strategy

    Materials

    • Integrate Physical Security and Information Security Requirements Gathering Tool

    Participants

    • Executive leadership
    • Facilities Management leader and team
    • IT leader
    • Security & Privacy leader
    • Compliance officer
    • Legal
    • Risk Management
    • HR & Finance
    • OT leader (if applicable)
    1. As a group, brainstorm organization goals.
      • Review relevant corporate, IT, and facilities strategies.
    2. Record the most important business goals in the “Goals Cascade” tab of the Integrate Physical Security and Information Security Requirements Gathering Tool. Try to limit the number of business goals to no more than ten goals. This limitation will be critical to helping focus on your integrated security goals.
    3. For each goal, identify one to two security alignment goals. These should be objectives for the security strategy that will support the identified organization goals.

    Download the Integrate Physical Security and Information Security Requirements Gathering Tool.

    Record organizational goals

    A table to identify Organization, IT, OT(if applicable), Facilities, and Security Goals Definitions.

    Refer to the Integration of Physical and Information Security Framework when filling in the table.

    1. Record your identified organizational goals in the “Goals Cascade” tab of the Integrate Physical Security and Information Security Requirements Gathering Tool.
    2. For each organizational goal, identify IT alignment goals.
    3. For each organizational goal, identify OT alignment goals (if applicable).
    4. For each organizational goal, identify Facilities alignment goals.
    5. For each organizational goal, select an integrated security goal from the drop-down menu.

    Justify value for the business

    Facilities in most cases have a team that is responsible for physical security installations such as access key controllers. Whenever there is an issue, they contact the provider to fix the error. However, with smart buildings and smart devices, the threat surface grows to include information security threats, and Facilities may not possess the knowledge and skills required to deal with them. At the same time, delegating physical security to IT may add more tasks to their already-too-long list of responsibilities. Consolidating security to a focused security team that covers both physical and information security can help.1 We need to develop the security integration business case beyond physical security "gates, guns, and guards" mentality.2

    An example of a cost-benefit analysis for security integration:

    Benefits

    Metrics

    Operational Efficiency and Cost Savings

    • Reduction in deployment, maintenance, and staff time in manual operations of physical security devices such as logs collection from analog cameras to be automated into digital.
    • Reduction in staffing costs by bringing physical security SOC and information security SOC in one single structure.

    Reliability Improvements

    • Reduction in field crew time by identifying hardware that can be virtualized to have a centralized remote control.
    • Improvement of operating reliability through continuous and real-time monitoring of equipment such as door access control systems and camera surveillance systems.

    Customers & Users Benefits

    • Improvement of customer safety for essential services such as access to critical locations only by authorized personnel.
    • Improvement of reliability of services and address human factor in adoption of change by introducing change as a friendly activity.

    Cost

    Metrics

    Equipment and Infrastructure

    • Upgrade of existing physical security equipment, e.g. replacement of separated access control, video management system (VMS), and physical access control system (PACS) with a unified security platform.
    • Implementation of communication network equipment and labor to install, configure, and maintain the new network component.

    Software and Commission

    • The software and maintenance fee as well as upgrade implementation project cost.
    • Labor cost of field commissioning and troubleshooting.
    • Integration with security systems, e.g. event and log management, continuous monitoring, and investigation.

    Support and Resources

    • Cost to hire/outsource security FTEs for ongoing management and operation of security devices, e.g. SOC, MSSP.
    • Cost to hire/outsource FTEs to analyze, design, and deploy the integrated security architecture, e.g. consulting fee.

    Sources: 1 Andrew Amaro, KLAVAN Security Services (contributor); 2 Baker and Benny, 2013;
    Industrial Control System Modernization, Info-Tech Research Group, 2023; Lawrence Berkeley National Laboratory, 2021

    Plan

    Define roles and responsibilities

    Input

    • List of relevant stakeholders

    Output

    • Roles and responsibilities for the integration of physical and information security program

    Materials

    • Integrate Physical Security and Information Security RACI Chart Tool

    Participants

    • Executive leadership
    • Facilities Management leader and team
    • HR & Finance
    • IT leader and team
    • OT leader and team
    • Security & Privacy leader and team

    Many factors impact an organization’s level of effectiveness as it relates to integration of physical and information security. How the team interacts, what skill sets exist, the level of clarity around roles and responsibilities, and the degree of executive support and alignment are only a few. Thus, we need to identify stakeholders that are:

    • Responsible: The person(s) who does the work to accomplish the activity; they have been tasked with completing the activity and/or getting a decision made.
    • Accountable: The person(s) who is accountable for the completion of the activity. Ideally, this is a single person and is often an executive or program sponsor.
    • Consulted: The person(s) who provides information. This is usually several people, typically called subject matter experts (SMEs).
    • Informed: The person(s) who is updated on progress. These are resources that are affected by the outcome of the activities and need to be kept up to date.

    Download the Integrate Physical Security and Information Security RACI Chart Tool

    Define RACI chart

    Define Responsible, Accountable, Consulted, Informed (RACI) stakeholders.

    1. Customize the Work Units to best reflect your operation with applicable stakeholders.
    2. Customize the Action rows as required.

    Integrate Physical Security and Information Security RACI Chart

    Sources: ISC, 2015; ISC, 2021

    Info-Tech Insight

    The roles and responsibilities should be clearly defined. For example, IT Security should be responsible for the installation and configuration of all physical access controllers and devices, and facility managers should be responsible for the physical maintenance including malfunctioning such as access device jammed or physically broken.

    Plan

    Establish/update governance for integrated security

    HR & Finance

    HR provides information such as new hires and office hours as input to the security system. Finance assists in budgeting.

    Security & Privacy

    The security and privacy team will need to evaluate solutions and enforce standards on various physical and information security systems and to protect data privacy.

    Business Leaders

    Business stakeholders will provide clarity for their strategy and provide input into how they envision security furthering those goals.

    IT Executives

    IT stakeholders will be a driving force, ensuring all necessary resources are available and funded.

    Facilities/ Operations

    Operational plans will include asset management, monitoring, and support to meet functional goals and manage throughout the asset lifecycle.

    Infrastructure & Enterprise Architects

    Each solution added to the environment will need to be chosen and architected to meet business goals and security functions.

    Info-Tech Insight

    Assemble the right team to ensure the success of your integrated security ecosystem and decide the governance model, e.g. security steering committee (SSC) or a centralized single structure.

    Adapted from Create and Implement an IoT Strategy, Info-Tech Research Group, 2022

    What does the SSC do?

    Ensuring proper governance over your security program is a complex task that requires ongoing care and feeding from executive management to succeed.

    Your SSC should aim to provide the following core governance functions for your security program:

    1. Define Clarity of Intent and Direction

      How does the organization’s security strategy support the attainment of the business, IT, facilities management, and physical and information security strategies? The SSC should clearly define and communicate strategic linkage and provide direction for aligning security initiatives with desired outcomes.
    2. Establish Clear Lines of Authority

      Security programs contain many important elements that need to be coordinated. There must be clear and unambiguous authority, accountability, and responsibility defined for each element so lines of reporting/escalation are clear and conflicting objectives can be mediated.
    3. Provide Unbiased Oversight

      The SSC should vet the organization’s systematic monitoring processes to ensure there is adherence to defined risk tolerance levels and that monitoring is appropriately independent from the personnel responsible for implementing and managing the security program.
    4. Optimize Security Value Delivery

      Optimized value delivery occurs when strategic objectives for security are achieved and the organization’s acceptable risk posture is attained at the lowest possible cost. This requires constant attention to ensure controls are commensurate with any changes in risk level or appetite.

    Adapted from Improve Security Governance With a Security Steering Committee , Info-Tech Research Group, 2018

    Plan

    Identify integrated elements and compliance obligations

    To determine what elements need to be integrated, it’s important to scope the security integration program and to identify the consequences of integration for compliance obligations.

    INTEGRATED ELEMENTS

    What are my concerns?

    Process integrations

    Determine which processes need to be integrated and how

    • Examples: Security prevention, detection, and response; risk assessment

    Software and data integration

    Determine which software and data need to be integrated and how

    • Examples: Threat management tools, SIEM, IDPS, security event logs

    Hardware integration

    Determine which hardware needs to be integrated and how

    • Examples: Sensors, alarms, cameras, keys, locks, combinations, and card readers

    Network and infrastructure

    Determine which network and infrastructure components need to be integrated and how

    • Example: Network segmentation for physical access controllers.

    COMPLIANCE

    How can I address my concerns?

    Regulations

    Adhere to mandatory laws, directives, industry standards, specific contractual obligations, etc.

    • Examples: NERC CIP (North American Utilities), Network and Information Security (NIS) Directive (EU), Health and Safety at Work etc Act 1974 (UK), Occupational Safety and Health Act, 1970 (US), Emergency Management Act, 2007 (Canada)

    Standards

    Adhere to voluntary standards and obligations

    • Examples: NIST Cybersecurity Framework (CSF), The Risk Management Process for Federal Facilities: An Interagency Security Committee Standard (US), Cybersecurity Maturity Model Certification (CMMC), Service Organization Control (SOC 1 and 2)

    Guidelines

    Adopt guidelines that can improve the integrated security program

    • Examples: Best Practices for Planning and Managing Physical Security Resources (US Interagency Security Committee), Information Security Manual - Guidelines for Physical Security (Australian Cyber Security Centre), 1402-2021-Guide for Physical Security of Electric Power Substations (IEEE)

    Record integrated elements

    Scope and Boundaries from the Integrate Physical Security and Information Security Requirements Gathering Tool.

    Refer to the “Scope” tab of the Integrate Physical Security and Information Security Requirements Gathering Tool when filling in the following elements.

    1. Record your integrated elements, i.e. process integration, software and data integration, hardware integration, network and infrastructure, and physical scope of your security integration, in the “Scope” tab of the Integrate Physical Security and Information Security Requirements Gathering Tool.
    2. For each of your scoping give the rationale for including them in the Comments column. Careful attention should be paid to any elements that are not in scope.

    Record your compliance obligations

    Refer to the “Compliance Obligations” tab of the Integrate Physical Security and Information Security Requirements Gathering Tool.

    1. Identify your compliance obligations. These can include both mandatory and voluntary obligations. Mandatory obligations include:
      • Laws
      • Government regulations
      • Industry standards
      • Contractual agreements
      Voluntary obligations include standards that the organization has chosen to follow for best practices and any obligations that are required to maintain certifications. Organizations will have many different compliance obligations. For the purposes of your integrated security, include those that include physical security requirements.
    2. Record your compliance obligations, along with any notes, in your copy of the Integrate Physical Security and Information Security Requirements Gathering Tool.
    3. Refer to the “Compliance DB” tab for lists of standards/regulations/ guidelines.
    The “Compliance Obligations” tab of the Integrate Physical Security and Information Security Requirements Gathering Tool.

    Remediate third-party compliance gaps

    If you have third-party compliance gaps, there are four primary ways to eliminate them:

    1. Find a New, Compliant Partner

      Terminate existing contract and find another organization to partner with.
    2. Bring the Capability In-House

      Expense permitting, this may be the best way to protect yourself.
    3. Demand Compliance

      Tell the third party they must become compliant. Make sure you set a deadline.
    4. Accept Noncompliance and Assume the Risk

      Sometimes remediation just isn’t cost effective and you have no choice.

    Follow Contracting Best Practices to Mitigate the Risk of Future Third-Party Compliance Gaps

    1. Perform Initial Due Diligence: Request proof of third-party compliance prior to entering into a contract.
    2. Perform Ongoing Due Diligence: Request proof of third-party contractor compliance annually.
    3. Contract Negotiation: Insert clauses requesting periodic assertions of compliance.

    View a sample contract provided by the US Department of Health and Human Services.

    Source: Take Control of Compliance Improvement to Conquer Every Audit, Info-Tech Research Group, 2015

    Pitfalls to avoid when planning security integration

    • No Resources Lineups

      Integration of security needs support from leadership, proper planning, and clear and consistent communication across the organization.
    • Not Addressing Holistic Security

      Create policies and procedures and follow standards that are holistic and based on threats and risks, e.g. consolidated access control policies.
    • Lack of Governance

      While the IT department is a critical partner in cybersecurity, the ownership of such a role sits squarely in the organizational C-suite, with regular reporting to the board of directors (if applicable).
    • Overlooking Business Continuity Effort

      IT and physical security are integral to business continuity and disaster recovery strategies.
    • Not Having Relevant Training and Awareness

      Provide a training and awareness program based on relevant attack vectors. Trained employees are key assets to the development of a safe and secure environment. They must form the base of your security culture.
    • Overbuilding or Underbuilding

      Select third-party providers that offer systems interoperability with other security tools. The intent is to promote a unified approach to security to avoid a cumbersome tooling zoo.

    Sources: Real Time Networks, 2022; Andrew Amaro, KLAVAN Security Services (contributor)

    Enhance

    Enhancing is the development of an integrated security strategy, policies, procedures, BCP, DR, and IR based on the organization’s risks.

    Enhance

    Determine the level of security maturity and update the security strategy

    • Before updating your security strategies, you need to understand the organization’s business strategies, IT strategies, facilities strategies, and physical and information security strategies. The goal is to align your integrated security strategies to contribute to your organization’s success.
    • The integrated security leaders need to understand the direction of the organization. For example:
      • Growth expectation
      • Expansions or mergers anticipation
      • Product or service changes
      • Regulatory requirements
    • Wise security investments depend on aligning your security initiatives to the organization’s objectives by supporting operational performance and ensuring brand protection and shareholder values.
    Integrated security strategies. Consists of an organization’s business strategies, IT strategies, facilities strategies, and physical and information security strategies.

    Sources: Amy L. Meger, Platte River Power Authority (contributor); Baker and Benny, 2013; IFSEC Global, 2023; Security Priorities 2023, Info-Tech Research Group, 2023; Build an Information Security Strategy, Info-Tech Research Group, 2020; ISC, n.d.

    Understanding security maturity

    Maturity models are very effective for determining security states. This table provides examples of general descriptions for physical and information security maturity levels.

    Determine which framework is suitable and select the description that most accurately reflects the ideal state for security in your organization.

    Level 1

    Level 2

    Level 3

    Level 4

    Level 5

    Minimum security with simple physical barriers. Low-level security to prevent and detect some unauthorized external activity. Medium security to prevent, detect, and assess most unauthorized external activity and some unauthorized internal activity. High-level security to prevent, detect, and assess most unauthorized external and internal activity. Maximum security to prevent, detect, assess, and neutralize all unauthorized external and internal activity.

    Physical security maturity level1

    Initial/Ad hoc security programs are reactive. Developing security programs can be effective at what they do but are not holistic. A defined security program is holistic, documented, and proactive. Managed security programs have robust governance and metrics processes. An optimized security program is based on strong risk management practices, including the production of key risk indicators (KRIs).

    Information security maturity level2

    Sources: 1 Fennelly, 2013; 2 Build an Information Security Strategy, Info-Tech Research Group, 2020

    Enhance

    Assess and treat integrated security risks

    The risk assessment conducted consists of analyzing existing inherent risks, existing pressure to the risks such as health and safety laws and codes of practice, new risks from the integration process, risk tolerance, and countermeasures.

    • Some organizations already integrate security into corporate security that consists of risk management, compliance, governance, information security, personnel security, and physical security. However, some organizations are still separating security components, especially physical security and information security, which limits security visibility and the organization’s ability to complete a comprehensive risks assessment.
    • Many vendors are also segregating physical security and information security solutions because their tools do well only on certain aspects. This forces organizations to combine multiple tools, creating a complex environment.
    • Additionally, risks related to people such as mental health issues must be addressed properly. The prevalence of hybrid work post-pandemic makes this aspect especially important.
    • Assess and treat risks based on the organization’s requirements, including its environments. For example, the US federal facility security organization is required to conduct risk assessments at least every five years for Level I (lowest risk) and Level II facilities and at least every three years for Level III, IV, and V (highest risk) facilities.

    Sources: EPA, n.d.; America's Water Infrastructure Act (AWIA), 2018; ISC, 2021

    “In 2022, 95% of US companies are consolidating into a single platform across physical security, cybersecurity, HR, legal and compliance.”

    Source: Ontic Center for Protective Intelligence, 2022; N=359

    Example risk levels

    The risk assessment conducted is based on a combination of physical and information security factors such as certain facilities factors. The risk level can be used to determine the baseline level of protection (LOP). Next, the baseline LOP is customized to the achievable LOP. The following is an example for federal facilities determined by Interagency Security Committee (ISC).

    Risk factor, points and score. Facility security level (FSL), level of risk, and baseline level of protection.

    Source: ISC, 2021

    Example assets

    It is important to identify the organization’s requirements, including its environments (IT, IoT, OT, facilities, etc.), and to measure and evaluate its risks and threats using an appropriate risk framework and tools with the critical step of identifying assets prior to acquiring solutions.

    Organizational requirements including its environments(IT, loT, OT, facilities, etc.)

    Info-Tech Insight

    Certain exceptions must be identified in risk assessment. Usually physical barriers such as gates and intrusion detection sensors are considered as countermeasures,1 however, under certain assessment, e.g. America's Water Infrastructure Act (AWIA),2 physical barriers are also considered assets and as such must also be assessed.

    Compromising a fingerprint scanner

    An anecdotal example of why physical security alone is not sufficient.

    Biometrics: secure access and data security.

    Image by Rawpixel.com on Freepik

    Lessons learned from using fingerprints for authentication:

    • Fingerprint scanners can be physically circumvented by making a copy an authorized user’s fingerprint with 3D printing or even by forcefully amputating an authorized user’s finger.
    • Authorized users may not be given access when the fingerprint cannot be recognized, e.g. if the finger is covered by bandage due to injury.
    • Integration with information security may help detect unauthorized access, e.g. a fingerprint being scanned in a Canadian office when the same user was scanned at a close time interval from an IP in Europe will trigger an alert of a possible incident.

    Info-Tech Insight

    In an ideal world, we want a physical security system that is interoperable with all technologies, flexible with minimal customization, functional, and integrated. In the real world, we may have physical systems with proprietary configurations that are not easily customized and siloed.

    Source: Robert Dang, Info-Tech Research Group

    Use case: Microchip implant

    Microchip implants can be used instead of physical devices such as key cards for digital identity and access management. Risks can be assessed using quantitative or qualitative approaches. In this use case a qualitative approach is applied to impact and likelihood, and a quantitative approach is applied to revenue and cost.

    Asset: Microchip implant

    Benefits

    Impact

    • Improve user satisfaction by removing the need to carry key cards, IDs, etc.
    • Improve operating reliability by reducing the likelihood of losing physical devices such as key cards.
    • Improve reliability of services through continuous and real-time connection with other systems such as payment system.

    Likelihood

    • Improve user satisfaction: High
    • Improve operating reliability: High
    • Improve reliability of services: High

    Revenue

    • Acquire new customers or retain existing customers by making daily lives easier with no need to carry key cards, IDs, etc.
    • Cost reduction in staffing of security personnel, e.g. reducing the staffing of building guards or receptionist.

    Risks

    Impact

    • Security: issues such as biohacking of wearable technology and interconnected devices.
    • Safety: issues such as infections or reactions in the body's immune system.
    • Privacy: issues such as unauthorized surveillance and tracking of activities.

    Likelihood

    • Biohacking: Medium
    • Infections: Low
    • Surveillance: High

    Cost

    • Installation costs and hardware costs.
    • Overall lifecycle cost including estimated software and maintenance costs.
    • Estimated cost of training and estimated increase in productivity.

    Sources: Business Insider, 2018; BBC News, 2022; ISC, 2015

    Enhance

    Update integrated security policies and procedures

    Global policies with local implementation

    This model works for corporate groups with a parent company. In this model, global security policies are developed by a parent company and local policies are applied to the unique business that is not supported by the parent company.

    Update of existing security policies

    This model works for organizations with sufficient resources. In this model, integrated security policies are derived from various policies. For example, physical security in smart buildings/devices (sensors, automated meters, HVAC, etc.) and OT systems (SCADA, PLCs, RTUs, etc.) introduce unique risk exposures, necessitating updates to security policies.

    Customization of information security policies

    This model works for smaller organizations with limited resources. In this model, integrated security policies are derived from information security policies. The issue is when these policies are not applicable to physical security systems or other environments, e.g. OT systems.

    Sources: Kris Krishan, Waymo (contributor); Isabelle Hertanto, Info-Tech Research Group (contributor); Physical and Environmental Security Policy Template, Info-Tech Research Group, 2022.

    Enhance

    Update BCP, DR, IR

    • Physical threats such as theft of material, vandalism, loitering, and the like are also part of business continuity threats.
    • These threats can be carried out by various means such as vehicles breaching perimeter security, bolt cutters used for cutting wire and cable, and ballistic attack.
    • Issues may occur when security operations are owned separately by physical security or information security, thus lacking consistent application of best practices.
    • To overcome this issue, organizations need to update BCP, DR, and IR holistically based on a cost-benefit analysis and the level of security maturity, which can be defined based on the suitable framework.

    Sources: IEEE, 2021; ISC, 2021

    “The best way to get management excited about a disaster plan is to burn down the building across the street.”

    Source: Dan Erwin, Security Officer, Dow Chemical Co., in Computerworld, 2022

    Optimize

    Optimizing means working to make the most effective and efficient use of resources, starting with identifying skill requirements and closing skill gaps, followed by designing and deploying integrated security architecture and controls, and finally monitoring and reporting integrated security metrics.

    Optimize

    Identify skill requirements and close skill gaps

    • The pandemic changed how people work and where they choose to work, and most people still want a hybrid work model. Our survey in July 2022 (N=516) found that 55.8% of employees have the option to work offsite 2-3 days per week, 21.0% can work offsite 1 day per week, and 17.8% can work offsite 4 days per week.
    • The investment (e.g. on infrastructure and networks) to initiate remote work was huge, and the costs didn’t end there; organizations needed to maintain the secure remote work infrastructure to facilitate the hybrid work model.
    • Moreover, roles are evolving due to convergence and modernization. These new roles require an integrative skill set. For example, the grid security and ops team might consist of an IT security specialist, a SCADA technician/engineer, and an OT/IIOT security specialist, where OT/IIOT security specialist is a new role.
    Identify skill gaps that hinder the successful execution of the hybrid work security strategy. Use the identified skill gaps to define the technical skill requirements for current and future work roles. Conduct a skills assessment on your current workforce to identify employee skill gaps. Decide whether to train (including certification), hire, contract, or outsource to close each skill gap.

    Strategic investment in internal security team

    Internal security governance and management using in-house developed tools or off-the-shelf solutions, e.g. security information and event management (SIEM).

    Security management using third parties

    Internal security management using third-party security services, e.g. managed security service providers (MSSPs).

    Outsourcing security management

    Outsourcing the entire security functions, e.g. using managed detection and response (MDR).

    Sources: Info-Tech Research Group’s Security Priorities 2023, Close the InfoSec Skills Gap, Build an IT Employee Engagement Program, and Grid Modernization

    Select the right certifications

    What are the options?

    • One issue in security certification is the complexity of relevancy in topics with respect to roles and levels.
    • The European Union Agency for Cybersecurity (ENISA) takes the approach of analyzing existing certifications of ICS/SCADA professionals' cybersecurity skills by orientation, scope, and supporting bodies that are grouped into specific certifications, relevant certifications, and safety certifications (ENISA, 2015).
    • This approach can also be applied to integrated security certifications.

    Physical security certification

    • Examples: Industrial Security Professional Certification (NCMS-ISP); Physical Security Professional (ASIS-PSP); Physical Security Certification (CDSE-PSC); ISC I-100, I-200, I-300, and I-400

    Cyber physical system security certification

    • Examples: Certified SCADA Security Architect (CSSA), EC-Council ICS/SCADA Cybersecurity Training Course

    Information security certification

    • Examples: Network and Information Security (NIS) Driving License, ISA/IEC 62443 Cybersecurity Certificate Program, GIAC Global Industrial Cyber Security Professional (GICSP)

    Safety Certifications

    • Examples: Board of Certified Safety Professionals (BCSP), European Network of Safety and Health Professional Organizations (ENSHPO)
    Table showing options for Certification orientation, scope and supporting bodies.

    Optimize

    Design and deploy integrated security architecture and controls

    • A survey by Brivo found that 38% of respondents have partly centralized security platforms, 25% have decentralized platforms, and 36% have centralized platforms (Brivo, 2022; N=700).
    • If your organization’s security program is still decentralized or partly centralized and your organization is planning to establish an integrated security program, then the recommendation is to perform a holistic risk assessment based on probability and impact assessments on threats and vulnerabilities.
    • The impacted factors, for example, are customers served, criticality of services, equipment present inside the building, personnel response time for operational recovery and the mitigation of hazards, and costs.
    • Frameworks such as Sherwood Applied Business Security Architecture (SABSA), Control Objectives for Information and Related Technologies (COBIT), and The Open Group Architecture Framework (TOGAF) can be used to build security architecture that aligns security goals with business goals.
    • Finally, analyze the security design against the design criteria.

    Sources: ISA and Honeywell Integrated Security Technology Lab, n.d.; IEEE, 2021

    “As long as organizations treat their physical and cyber domains as separate, there is little hope of securing either one.”

    Source: FedTech magazine, 2009

    Analyze architecture design

    Cloud, on-premises, or hybrid? During the pandemic, many enterprises were under tight deadlines to migrate to the cloud. Many did not refactor data and applications correctly for cloud platforms during migration, with the consequence of high cloud bills. This happened because the migrated applications cannot take advantage of on-premises capabilities such as autoscaling. Thus, in 2023, it is plausible that enterprises will bring applications and data back on-premises.

    Below is an example of a security design analysis of platform architecture. Design can be assessed using quantitative or qualitative approaches. In this example, a qualitative approach is applied using high-level advantages and disadvantages.

    Design criteria

    Cloud

    Hybrid

    On-premises

    Effort

    Consumer effort is within a range, e.g. < 60%

    Consumer effort is within a range e.g. < 80%

    100% organization

    Reliability

    High reliability

    High reliability

    Medium reliability that depends on data centers

    Cost

    High cost when data and applications are not correctly designed for cloud

    Optimized cost when data and applications are correctly designed either for cloud or native

    Medium cost when data and applications take advantage of on-prem capabilities

    Info-Tech Insight

    It is important for organizations to find the most optimized architecture to support them, for example, a hybrid architecture of cloud and on-premises based on operations and cost-effectiveness. To help design a security architecture that is strategic, realistic, and based on risk, see Info-Tech’s Identify the Components of Your Cloud Security Architecture research.

    Sources: InfoWorld, 2023; Identify the Components of Your Cloud Security Architecture , Info-Tech Research Group, 2021

    Analyze equipment design

    Below is an example case of a security design analysis of electronic security systems. Design can be assessed using quantitative or qualitative approaches. In this example a qualitative approach is applied using advantages and disadvantages.

    Surveillance design criteria

    Video camera

    Motion detector

    Theft of security system equipment

    Higher economic loss Lower economic loss

    Reliability

    Positive detection of intrusion Spurious indication and lower reliability

    Energy savings and bandwidth

    Only record when motion is detected Detect and process all movement

    Info-Tech Insight

    Once the design has been analyzed, the next step is to conduct market research to analyze the solutions landscape, e.g. to compare products or services from vendors or manufacturers.

    Sources: IEEE, 202; IEC, n.d.; IEC, 2013

    Analyze off-the-shelf solutions

    Criteria to consider when comparing solutions:

    Criteria to consider when comparing solutions: 1 - Visibility and asset management. 2 - Threat detection, mitigation and response. 3 - Risk assessment and vulnerability management. 4 - Usability, architecture, Cost.

    Visibility and Asset Management

    Passively monitoring data using various protocol layers, actively sending queries to devices, or parsing configuration files of physical security devices, OT, IoT, and IT environments on assets, processes, and connectivity paths.

    Threat Detection, Mitigation, and Response (+ Hunting)

    Automation of threat analysis (signature-based, specification-based, anomaly-based, flow-based, content-based, sandboxing) not only in IT but also in relevant environments, e.g. physical, IoT, IIoT, and OT on assets, data, network, and orchestration with threat intelligence sharing and analytics.

    Risk Assessment and Vulnerability Management

    Risk scoring approach (qualitative, quantitative) based on variables such as behavioral patterns and geolocation. Patching and vulnerability management.

    Usability, Architecture, Cost

    The user and administrative experience, multiple deployment options, extensive integration capabilities, and affordability.

    Source: Secure IT/OT Convergence, Info-Tech Research Group, 2022

    Optimize

    Establish, monitor, and report integrated security metrics

    Security metrics serve various functions in a security program.1 For example:

    • As audit requirements. For integrated security, the requirements are derived from mandatory or voluntary compliance, e.g. NERC CIP.
    • As an indicator of maturity level. For integrated security, maturity level is used to measure the state of security, e.g. C2M2, CMMC.
    • As a measurement of effectiveness and efficiency. Security metrics consist of operational metrics, financial metrics, etc.

    Safety

    Physical security interfaces with the physical world. Thus, metrics based on risks related to safety are crucial. These metrics motivate personnel by making clear why they should care about security.
    Source: EPRI, 2017

    Business Performance

    The impact of security on the business can be measured with various metrics such as operational metrics, service level agreements (SLAs), and financial metrics.
    Source: BMC, 2022

    Technology Performance

    Early detection leads to faster remediation and less damage. Metrics such as maximum tolerable downtime (MTD) and mean time to recovery (MTR) indicate system reliability.
    Source: Dark Reading, 2022

    Security Culture

    Measure the overall quality of security culture with indicators such as compliance and audit, vulnerability management, and training and awareness.

    Info-Tech Insight

    Security failure can be avoided by evaluating the security systems and program. Security evaluation requires understanding what, where, when, and how to measure and to report the relevant metrics.

    Related Info-Tech Research

    Secure IT/OT Convergence

    The previously entirely separate OT ecosystem is migrating into the IT ecosystem, primarily to improve access via connectivity and to leverage other standard IT capabilities for economic benefit.

    Hence, IT and OT need to collaborate, starting with communication to build trust and to overcome their differences and followed by negotiation on components such as governance and management, security controls on OT environments, compliance with regulations and standards, and establishing metrics for OT security.

    Preparing for Technology Convergence in Manufacturing

    Information technology (IT) and operational technology (OT) teams have a long history of misalignment and poor communication.

    Stakeholder expectations and technology convergence create the need to leave the past behind and build a culture of collaboration.

    Build an Information Security Strategy

    Info-Tech has developed a highly effective approach to building an information security strategy – an approach that has been successfully tested and refined for over seven years with hundreds of organizations.

    This unique approach includes tools for ensuring alignment with business objectives, assessing organizational risk and stakeholder expectations, enabling a comprehensive current-state assessment, prioritizing initiatives, and building a security roadmap.

    Bibliography

    "1402-2021 - IEEE Guide for Physical Security of Electric Power Substations." IEEE, 2021. Accessed 25 Jan. 2023.

    "2022 State of Protective Intelligence Report." Ontic Center for Protective Intelligence, 2022. Accessed 16 Jan. 2023.

    "8 Staggering Statistics: Physical Security Technology Adoption." Brivo, 2022. Accessed 5 Jan. 2023.

    "America's Water Infrastructure Act of 2018." The United States' Congress, 2018. Accessed 19 Jan. 2023.

    Baker, Paul and Daniel Benny. The Complete Guide to Physical Security. Auerbach Publications. 2013

    Bennett, Steve. "Physical Security Statistics 2022 - Everything You Need to Know." WebinarCare, 4 Dec. 2022. Accessed 30 Dec. 2022.

    "Best Practices for Planning and Managing Physical Security Resources: An Interagency Security Committee Guide." Interagency Security Committee (ISC), Dec. 2015. Accessed 23 Jan. 2023.

    Black, Daniel. "Improve Security Governance With a Security Steering Committee." Info-Tech Research Group, 23 Nov. 2018. Accessed 30 Jan. 2023.

    Borg, Scott. "Don't Put Up Walls Between Your Security People." FedTech Magazine, 17 Feb. 2009. Accessed 15 Dec. 2022.

    Burwash, John. “Preparing for Technology Convergence in Manufacturing.” Info-Tech Research Group, 12 Dec. 2018. Accessed 7 Dec. 2022.

    Carney, John. "Why Integrate Physical and Logical Security?" Cisco. Accessed 19 Jan. 2023.

    "Certification of Cyber Security Skills of ICS/SCADA Professionals." European Union Agency for Cybersecurity (ENISA), 2015. Accessed 27 Sep. 2022.

    Cherdantseva, Yulia and Jeremy Hilton. "Information Security and Information Assurance. The Discussion about the Meaning, Scope and Goals." Organizational, Legal, and Technological Dimensions of IS Administrator, Almeida F., Portela, I. (eds.), pp. 1204-1235. IGI Global Publishing, 2013.

    Cobb, Michael. "Physical security." TechTarget. Accessed 8 Dec. 2022.

    “Conduct a Drinking Water or Wastewater Utility Risk Assessment.” United States Environmental Protection Agency (EPA), n.d. Web.

    Conrad, Sandi. "Create and Implement an IoT Strategy." Info-Tech Research Group, 28 July 2022. Accessed 7 Dec. 2022.

    Cooksley, Mark. "The IEC 62443 Series of Standards: A Product Manufacturer's Perspective." YouTube, uploaded by Plainly Explained, 27 Apr. 2021. Accessed 26 Aug. 2022.

    "Cyber and physical security must validate their value in 2023." IFSEC Global, 12 Jan. 2023. Accessed 20 Jan. 2023.

    "Cybersecurity Evaluation Tool (CSET®)." Cybersecurity and Infrastructure Security Agency (CISA). Accessed 23 Jan. 2023.

    "Cybersecurity Maturity Model Certification (CMMC) 2.0." The United States' Department of Defense (DOD), 2021. Accessed 29 Dec. 2022.

    “Cyber Security Metrics for the Electric Sector: Volume 3.” Electric Power Research Institute (EPRI), 2017.

    Czachor, Emily. "Mass power outage in North Carolina caused by gunfire, repairs could take days." CBS News, 5 Dec. 2022. Accessed 20 Jan. 2023.

    Dang, Robert, et al. “Secure IT/OT Convergence.” Info-Tech Research Group, 9 Dec. 2022. Web.

    "Emergency Management Act (S.C. 2007, c. 15)." The Government of Canada, 2007. Accessed 19 Jan. 2023.

    "Emergency management vocabulary." Translation Bureau, Government of Canada. Accessed 19 Jan. 2023.

    Fennelly, Lawrence. Effective physical security. Butterworth-Heinemann, 2013.

    Ghaznavi-Zadeh, Rassoul. "Enterprise Security Architecture - A Top-down Approach." The Information Systems Audit and Control Association (ISACA). Accessed 25 Jan. 2023.

    "Good Practices for Security of Internet of Things." European Union Agency for Cybersecurity (ENISA), 2018. Accessed 27 Sep. 2022.

    "Health and Safety at Work etc Act 1974." The United Kingdom Parliament. Accessed 23 Jan. 2023.

    Hébert, Michel, et al. “Security Priorities 2023.” Info-Tech Research Group, 1 Feb. 2023. Web.

    "History and Initial Formation of Physical Security and the Origin of Authority." Office of Research Services (ORS), National Institutes of Health (NIH). March 3, 2017. Accessed 19 Jan. 2023.

    "IEC 62676-1-1:2013 Video surveillance systems for use in security applications - Part 1-1: System requirements - General." International Electrotechnical Commission (IEC), 2013. Accessed 9 Dec. 2022.

    "Incident Command System (ICS)." ICS Canada. Accessed 17 Jan. 2023.

    "Information Security Manual - Guidelines for Physical Security." The Australian Cyber Security Centre (ACSC), Dec. 2022. Accessed 13 Jan. 2023.

    "Integrated Physical Security Framework." Anixter. Accessed 8 Dec. 2022.

    "Integrating Risk and Security within a TOGAF® Enterprise Architecture." TOGAF 10, The Open Group. Accessed 11 Jan. 2023.

    Latham, Katherine. "The microchip implants that let you pay with your hand." BBC News, 11 Apr. 2022. Accessed 12 Jan. 2023.

    Linthicum, David. "2023 could be the year of public cloud repatriation." InfoWorld, 3 Jan. 2023. Accessed 10 Jan. 2023.

    Ma, Alexandra. "Thousands of people in Sweden are embedding microchips under their skin to replace ID cards." Business Insider, 14 May 2018. Accessed 12 Jan. 2023.

    Mendelssohn, Josh and Dana Tessler. "Take Control of Compliance Improvement to Conquer Every Audit." Info-Tech Research Group, 25 March 2015. Accessed 27 Jan. 2023.

    Meredith, Sam. "All you need to know about the Nord Stream gas leaks - and why Europe suspects 'gross sabotage'." CNBC, 11 Oct. 2022. Accessed 20 Jan. 2023.

    Nicaise, Vincent. "EU NIS2 Directive: what’s changing?" Stormshield, 20 Oct. 2022. Accessed 17 Nov. 2022.

    "NIST SP 800-53 Rev. 5 Security and Privacy Controls for Information Systems and Organizations." The National Institute of Standards and Technology (NIST), 13 Jul. 2022. Accessed 27 Jan. 2023.

    "North American Electric Reliability Corporation Critical Infrastructure Protection (NERC CIP) Series." NERC. Accessed 23 Jan. 2023.

    "North America Physical Security Market - Global Forecast to 2026." MarketsandMarkets, June 2021. Accessed 30 Dec. 2022.

    "NSTISSI No. 4011 National Training Standard For Information Systems Security (InfoSec) Professionals." The United States Committee on National Security Systems (CNSS), 20 Jun. 1994. Accessed 23 Jan. 2023.

    "Occupational Safety and Health Administration (OSH) Act of 1970." The United States Department of Labor. Accessed 23 Jan. 2023.

    Palter, Jay. "10 Mistakes Made in Designing a Physical Security Program." Real Time Networks, 7 Sep. 2022. Accessed 6 Jan. 2023.

    Parker, Donn. Fighting Computer Crime. John Wiley & Sons, 1998.

    Pathak, Parag. "What Is Threat Management? Common Challenges and Best Practices." Security Intelligence, 2020. Accessed 5 Jan. 2023.

    Pender-Bey, Georgie. "The Parkerian Hexad." Lewis University, 2012. Accessed 24 Jan. 2023.

    Philippou, Oliver. "2023 Trends to Watch: Physical Security Technologies." Omdia. Accessed 20 Jan. 2023.

    Phinney, Tom. "IEC 62443: Industrial Network and System Security." ISA and Honeywell Integrated Security Technology Lab. Accessed 30 Jan. 2023.

    "Physical Security Market, with COVID-19 Impact Analysis - Global Forecast to 2026." MarketsandMarkets, Jan. 2022. Accessed 30 Dec. 2022.

    "Physical Security Professional (PSP)" ASIS International. Accessed 17 Jan. 2023.

    "Physical Security Systems (PSS) Assessment Guide" The United States' Department of Energy (DOE), Dec. 2016. Accessed 23 Jan. 2023.

    "Policies, Standards, Best Practices, Guidance, and White Papers." Interagency Security Committee (ISC). Accessed 23 Jan. 2023.

    "Profiles, Add-ons and Specifications." ONVIF. Accessed 9 Dec. 2022.

    "Protective Security Policy Framework (PSPF)." The Australian Attorney-General's Department (AGD). Accessed 13 Jan. 2023.

    "Satellites detect methane plume in Nord Stream leak." The European Space Agency (ESA), 6 oct. 2022. Accessed 23 Jan. 2023.

    ""Satellites detect methane plume in Nord Stream leak." The European Space Agency (ESA), 6 oct. 2022. Accessed 23 Jan. 2023.

    Satgunananthan, Niru. "Challenges in Security Convergence?" LinkedIn, 8 Jan. 2022. Accessed 20 Dec. 2022.

    Sooknanan, Shastri and Isaac Kinsella. "Identify the Components of Your Cloud Security Architecture." Info-Tech Research Group, 12 March 2021. Accessed 26 Jan. 2023.

    "TC 79 Alarm and electronic security systems." International Electrotechnical Commission (IEC), n.d. Accessed 9 Dec. 2022.

    "The Risk Management Process for Federal Facilities: An Interagency Security Committee Standard." Interagency Security Committee (ISC), 2021. Accessed 26 Jan. 2023.

    "The Short Guide to Why Security Programs Can Fail." CyberTalk, 23 Sep. 2021. Accessed 30 Dec. 2022.

    Verton, Dan. "Companies Aim to Build Security Awareness." Computerworld, 27 Nov. 2022. Accessed 26 Jan. 2023.

    "Vulnerability Assessment of Federal Facilities." The United States' Department of Justice, 28 Jun. 1995. Accessed 19 Jan. 2023.

    "What is IEC 61508?" 61508 Association. Accessed 23 Jan. 2023.

    Wolf, Gene. "Better Include Physical Security With Cybersecurity." T&D World 5 Jan. 2023. Accessed 19 Jan. 2023.

    Wood, Kate, and Isaac Kinsella. “Build an Information Security Strategy.” Info-Tech Research Group, 9 Sept. 2020. Web.

    Woolf, Tim, et al. "Benefit-Cost Analysis for Utility-Facing Grid Modernization Investments: Trends, Challenges, and Considerations." Lawrence Berkeley National Laboratory, Feb. 2021. Accessed 15 Nov. 2022.

    "Work Health and Safety Act 2011." The Australian Government. Accessed 13 Jan. 2023.

    Wu, Jing. “Industrial Control System Modernization: Unlock the Value of Automation in Utilities.” Info-Tech Research Group, 6 April 2023. Web.

    Research Contributors and Experts

    Amy L. Meger, IGP

    Information and Cyber Governance Manager
    Platte River Power Authority

    Andrew Amaro

    Chief Security Officer (CSO) & Founder
    KLAVAN Security

    Bilson Perez

    IT Security Manager
    4Wall Entertainment

    Dan Adams

    VP of Information Technology
    4Wall Entertainment

    Doery Abdou

    Senior Manager
    March Networks Corporate

    Erich Krueger

    Manager of Security Engineering
    Omaha Public Power District

    Kris Krishan

    Head of IT
    Waymo

    Owen Yardley

    Director, Facilities Security Preparedness
    Omaha Public Power District

    Build Your IT Cost Optimization Roadmap

    • Buy Link or Shortcode: {j2store}72|cart{/j2store}
    • member rating overall impact: 8.9/10 Overall Impact
    • member rating average dollars saved: $57,297 Average $ Saved
    • member rating average days saved: 7 Average Days Saved
    • Parent Category Name: Cost & Budget Management
    • Parent Category Link: /cost-and-budget-management

    Cost optimization is misunderstood and inadequately tackled. IT departments face:

    • Top-down budget cuts within a narrow time frame
    • Absence of adequate governance: financial, project, data, etc.
    • Long-standing bureaucratic practices slowing down progress
    • Short-term thinking

    Our Advice

    Critical Insight

    Cost optimization is not just about reducing costs. In fact, you should aim to achieve three objectives:

    • Reduce your unwarranted IT spending.
    • Optimize your cost-to-value.
    • Sustain your cost optimization.

    Impact and Result

    • Follow Info-Tech’s approach to develop a 12-month cost optimization roadmap.
    • Develop an IT cost optimization strategy based on your specific circumstances and timeline.
    • Info-Tech’s methodology helps you maintain sustainable cost optimization across IT by focusing on four levers: assets, vendors, project portfolio, and workforce.

    Build Your IT Cost Optimization Roadmap Research & Tools

    Besides the small introduction, subscribers and consulting clients within this management domain have access to:

    1. IT Cost Optimization Roadmap Deck – A step-by-step methodology to achieve sustainable cost optimization and effectively communicate your strategy to stakeholders.

    This blueprint will help you understand your IT cost optimization mandate, identify your journey, assess your IT spend across four levers, develop your IT cost optimization roadmap, and craft a related communication strategy.

    • Build Your IT Cost Optimization Roadmap – Phases 1-4

    2. IT Cost Optimization Workbook – A structured tool to help you document your IT cost optimization goals and outline related initiatives to develop an effective 12-month roadmap.

    This tool guides an IT department in planning and prioritization activities to build an effective IT cost optimization strategy. The outputs include visual charts and a 12-month roadmap to showcase the implementation timelines and potential cost savings.

    • IT Cost Optimization Workbook

    3. IT Cost Optimization Roadmap Samples and Templates – A proactive journey template to help you communicate your IT cost optimization strategy to stakeholders in a clear, concise, and compelling manner.

    This presentation template uses sample data from "Acme Corp" to demonstrate an IT cost optimization strategy following a proactive journey. Use this template to document your final IT cost optimization strategy outputs, including the adopted journey, IT cost optimization goals, related key initiatives, potential cost savings, timelines, and 12-month roadmap.

    • IT Cost Optimization Roadmap Samples and Templates

    Infographic

    Workshop: Build Your IT Cost Optimization Roadmap

    Workshops offer an easy way to accelerate your project. If you are unable to do the project yourself, and a Guided Implementation isn't enough, we offer low-cost delivery of our project workshops. We take you through every phase of your project and ensure that you have a roadmap in place to complete your project successfully.

    1 Understand Your Mandate & Objectives

    The Purpose

    Determine your organization’s current context and its cost optimization objectives, IT’s corresponding cost optimization journey, and goals.

    Key Benefits Achieved

    A business-aligned set of specific IT cost optimization goals.

    Activities

    1.1 Understand your organization’s cost optimization objectives and how this impacts IT.

    1.2 Review potential cost optimization target areas based on your ITFM Benchmarking Report.

    1.3 Identify factors constraining cost optimization options.

    1.4 Set concrete IT cost optimization goals.

    1.5 Identify inputs required for decision making.

    Outputs

    IT cost optimization journey and guiding principles for making corresponding decisions

    2 Outline Initiatives for Vendors & Assets

    The Purpose

    Create a longlist of potential cost optimization initiatives focused on two cost optimization levers: assets and vendors.

    Key Benefits Achieved

    A comprehensive list of potential asset- and vendor-focused initiatives including cost savings estimates.

    Activities

    2.1 Identify a longlist of possible initiatives around asset lifecycle management, investment deferral, repurposing, etc., and vendor contract renegotiation, cancelation, etc.

    2.2 Estimate the cost savings of cost optimization initiatives.

    Outputs

    Longlist of potential vendor management and asset optimization IT cost optimization initiatives

    3 Outline Initiatives for Projects & Workforce

    The Purpose

    Create a longlist of potential cost optimization initiatives focused on two cost optimization levers: project portfolio and workforce.

    Key Benefits Achieved

    A comprehensive list of potential initiatives focused on project portfolio and workforce including cost savings estimates.

    Activities

    3.1 Identify a longlist of possible initiatives around project priorities, project backlog reduction, project intake restructuring, etc., and workforce productivity, skills, redeployment, etc.

    3.2 Estimate the cost savings of cost optimization initiatives.

    Outputs

    Longlist of possible cost optimization initiatives and their potential cost savings for project portfolio and workforce levers.

    4 Build an IT Cost Optimization Roadmap

    The Purpose

    Develop a visual IT cost optimization roadmap.

    Key Benefits Achieved

    A prioritized, business-aligned IT cost optimization roadmap

    Activities

    4.1 Assess feasibility of each initiative (effort and risk profile) given cost optimization goals.

    4.2 Prioritize cost optimization initiatives to create a final shortlist.

    4.3 Fine-tune key information about your final cost optimization initiatives and develop a cost optimization roadmap for proposal.

    Outputs

    Prioritized list of key cost optimization initiatives, descriptions, estimated impact, and roadmap.

    5 Communicate & Execute

    The Purpose

    Develop a communication plan and executive presentation.

    Key Benefits Achieved

    A boardroom-ready set of communication materials for gaining buy-in and support for your IT cost optimization roadmap.

    Activities

    5.1 Outline components of a communication plan, including approvers, stakeholders, and governance and management mechanisms to be used.

    5.2 Create an executive presentation.

    5.3 Set up review time for workshop deliverables and post-workshop activities.

    Outputs

    IT cost optimization communication plan and presentation strategy.

    IT Cost Optimization Executive Presentation

    Further reading

    Build Your IT Cost Optimization Roadmap

    Improve cost-to-value in a sustainable manner.

    Analyst Perspective

    Optimize your cost sustainably.

    Whether the industry is in an economic downturn, or your business is facing headwinds in the market, pressure to reduce spending across organizations is inevitable. When it comes to the IT organization, it is often handled as a onetime event. Cost optimization is an industry standard term, but it usually translates into cost cutting. How do you manage this challenge given the day-to-day demands placed on IT? Do you apply cost reduction equally across the IT landscape, or do you apply reductions using a targeted approach? How do you balance the business demands regarding innovation with keeping the lights on? What is the best path forward?

    While the situation isn't unique, all too often the IT organization response is too shortsighted.

    By using the Info-Tech methodology and tools, you will be able to develop an IT cost optimization roadmap based on your specific circumstances and timeline.

    A well-thought-out strategy should help you achieve three objectives:

    1. Reduce your unwarranted IT spending.
    2. Optimize your cost-to-value.
    3. Sustain your cost optimization.

    This blueprint will guide you to understand your mandate, identify your cost optimization journey (reactive, proactive, or strategic), and assess your IT spend across four levers (assets, vendors, project portfolio, and workforce).

    Finally, keep in mind that cost optimization is not a project to be completed, but an ongoing process to be exercised.

    Bilal Alberto Saab, Research Director, IT Financial Management

    Bilal Alberto Saab
    Research Director, IT Financial Management
    Info-Tech Research Group

    Executive Summary

    Cost optimization is misunderstood and inadequately tackled Common obstacles Follow Info-Tech's approach to develop a 12-month cost optimization roadmap
    • Top-down budget cut within a narrow time frame.
    • Absence of adequate governance: financial, project, data, etc.
    • Long-standing bureaucratic practices slowing down progress.
    • Short-term thinking.
    • Lack of alignment and collaboration among stakeholders: communication and relationships.
    • Absence of a clear plan and adequate process.
    • Lack of knowledge, expertise, and skill set.
    • Inadequate funding and no financial transparency.
    • Poor change management practices.

    Develop an IT cost optimization strategy based on your specific circumstances and timeline.

    Info-Tech's methodology helps you maintain sustainable cost optimization across IT by focusing on four levers:

    1. Assets
    2. Vendors
    3. Project Portfolio
    4. Workforce

    Info-Tech Insight
    Cost optimization is not just about reducing costs. In fact, you should aim to achieve three objectives: (1) reduce your unwarranted IT spending, (2) optimize your cost-to-value, and (3) sustain your cost optimization.

    Your challenge

    IT leaders are often asked to cut costs.

    • Cost management is a long-term challenge. Businesses and IT departments look to have a flexible cost structure focused on maximizing business value while maintaining the ability to adapt to market pressure. However, businesses must also be able to respond to unexpected events.
    • In times of economic downturn, many CEOs and CFOs shift their thinking from growth to value protection. This can force a round of cost cutting across all departments focused on short-term, immediate, and measurable objectives.
    • Many IT departments are then faced with the challenge of meeting cost cutting targets. No one knows exactly how markets will behave, but the effects of rising inflation and increasing interest rates, for example, can manifest very quickly.

    When crisis hits, does IT's hard-won gains around being seen as a partner to the business suddenly disappear and IT becomes just a cost center all over again?

    In times of economic slowdown or downturn, the key challenge of IT leaders is to optimize costs without jeopardizing their strategic and innovative contribution.

    Common obstacles

    The 90% of the budget you keep is more important than the 10% of the budget you cut.

    • While the business responds to fluctuating economic conditions, IT must ensure that its budget remains fully aligned with business strategy and expected business value.
    • However, in the face of sudden pressures, a common tendency is to make quick decisions without fully considering their long-term implications.
    • Avoid costly mistakes with a proactive and strategic mindset. Put in place a well-communicated cost optimization strategy rather than hastily cutting back the biggest line items in your budget.

    How can IT optimize costs to achieve a corporate impact, but not cut so deep that the organization can't take advantage of opportunities to recover and thrive?

    Know how you will strategically optimize IT costs before you are forced to cut cost aggressively in a reactive fashion.

    What is cost optimization?

    It's not just about cutting costs

    • While cost optimization may involve cutting costs, it is more about making smart spend and investment decisions.
    • At its core, cost optimization is a strategic decision-making process that sets out to minimize waste and get the most value for money.
    • Cost optimization encompasses near-term, mid-term, and long-term objectives, all of which are related and build upon one another. It is an accumulative practice, not a onetime exercise.
    • A sound cost optimization practice is inherently flexible, sustainable, and consequence-oriented with the positive goal of generating net benefit for the organization over time.

    Change your mindset ...

    An Info-Tech survey of IT staff reveals that while most agree that cost optimization is an important IT process, nearly 20% fewer of them agree that it's being managed well.

    Chart of cost optimization

    Info-Tech IT Management & Governance Diagnostic, 2022.

    A starting point for cost optimization improvement is adjusting your frame of mind. Know that it's not just about making difficult cuts - in reality, it's a creative pursuit that's about thriving in all circumstances, not just surviving.

    Slow revenue growth expectations generate urgency

    Many IT organizations will be directed to trim costs during turbulent times.

    • Cost optimization implies continuous cost management, which entails long-term strategic initiatives (i.e. organizations and their IT departments seek flexible cost structures and practices focused on maximizing business value while maintaining the ability to adapt to changes in the broader economic environment). However, organizations must also be able to respond to unexpected events.
    • During times of turmoil – poor economic outlook expected to negatively impact an organization's bottom line – CEOs and CFOs think more about survival than growth, driving cost cutting across all departments to create short-term, immediate, and measurable financial benefits.
    • In such situations, many IT departments will be hard-pressed to meet cost cutting targets at short notice. If not planned correctly, with a tunnel vision focus instead of a strategic one, you can end up hurting yourself in the not-so-distant future.

    Build Your IT Cost Optimization Roadmap

    Insight summary

    Sustain an optimal cost-to-value ratio across four levers:

    1. Assets
    2. Vendors
    3. Project Portfolio
    4. Workforce

    Cost optimization is not just about reducing costs

    In fact, you should aim to achieve three objectives:
    (1) reduce your unwarranted IT spending, (2) optimize your cost-to-value, and (3) sustain your cost optimization.

    Reduce unwarranted IT spending

    Stop the bleeding or go for quick wins
    Start by reducing waste and bad spending habits while clearly communicating your intentions to your stakeholders – get buy-in.

    Optimize cost-to-value

    Value means tradeoffs
    Pursue value but know that it will lead you to make tradeoffs between cost, performance, and risk.

    Sustain cost optimization

    Think about tomorrow: reduce, reuse, recalibrate, and repeat
    Standardize and automate your cost optimization processes around a proper governance framework. Cost optimization is not a onetime exercise.

    Info-Tech's methodology for building your IT cost optimization roadmap

    Phase 1: Understand Your Mandate & Objectives

    Know where you stand and where you're going.

    Understand your cost optimization mandate within the context of your organization's situation and direction.

    Phase 2: Outline Your Initiatives

    Evaluate many, pick a few.

    Think of all possible cost optimization initiatives across the four optimization levers (Assets, Vendors, Project Portfolio, and Workforce), but only keep the ones that best help you fulfill your goals.

    Phase 3: Develop Your Roadmap

    Keep one eye on today and the other on tomorrow.

    Prioritize cost optimization initiatives that would help you achieve your near-term objectives first, but don't forget about the medium and long term.

    Phase 4: Communicate and Execute

    Communicate and collaborate - you are not a one-person show.

    Reach out to other business units where necessary. Your success relies on getting buy-in from various stakeholders, especially when cost optimization initiatives impact them in one way or another.

    Blueprint deliverables

    Each step of this blueprint is accompanied by supporting deliverables to help you accomplish your goals:

    IT Cost Optimization Roadmap Samples and Templates
    Templates including an abbreviated executive presentation and a final communication presentation based on a 12-month cost optimization roadmap.

    IT Cost Optimization Workbook
    A workbook generating a 12-month cost optimization roadmap.

    Measure the value of this blueprint

    Maintain an optimal IT cost-to-organization revenue ratio.

    This blueprint will guide you to set cost optimization goals across one to three main objectives, depending on your identified journey (reactive, proactive, or strategic):

    • Reduce unwarranted IT spending.
    • Optimize cost-to value.
    • Sustain cost optimization.

    In phase 1 of this blueprint, we will help you establish your goals to satisfy your organization's needs.

    In phase 3, we will help you develop a game plan and a roadmap for achieving those metrics.

    Once you implement your 12-month roadmap, start tracking the metrics below over the next fiscal year (FY) to assess the effectiveness of undertaken measures.

    Cost Optimization Objective Key Success Metric
    Reduce unwarranted IT spending Decrease IT cost in identified key areas
    Optimize cost-to-value Decrease IT cost per IT employee
    Sustain cost optimization Decrease IT cost-to-organization revenue

    Info-Tech offers various levels of support to best suit your needs

    DIY Toolkit
    "Our team has already made this critical project a priority, and we have the time and capability, but some guidance along the way would be helpful."
    Guided Implementation
    "Our team knows that we need to fix a process, but we need assistance to determine where to focus. Some check-ins along the way would help keep us on track."
    Workshop
    "We need to hit the ground running and get this project kicked off immediately. Our team has the ability to take this over once we get a framework and strategy in place.
    Consulting
    "Our team does not have the time or the knowledge to take this project on. We need assistance through the entirety of this project."

    Diagnostics and consistent frameworks are used throughout all four options.

    Guided implementation

    What does a typical GI on this topic look like?

    Phase 1 Phase 2 Phase 3 Phase 4
    Call #1:
    • Identify cost optimization scope requirements, objectives, and your specific challenges.
    • Review and assess cost optimization goals and objectives.
    Call #2:

    Review potential cost optimization initiatives for assets and vendors levers.

    Call #3:

    Assess cost optimization initiatives' cost and feasibility - for assets and vendors levers.

    Call #4:

    Review potential cost optimization initiatives for project portfolio and workforce levers.

    Call #5:

    Assess cost optimization initiatives' cost and feasibility - for project portfolio and workforce levers.

    Call #6:
    • Identify final decision criteria for cost optimization prioritization.
    • Review prioritized cost optimization initiatives and roadmap outputs.
    Call #7:
    • Review the Cost Optimization Communication Plan and IT Cost Optimization Executive Presentation.
    • Discuss next steps.

    A Guided Implementation (GI) is a series of calls with an Info-Tech analyst to help implement our best practices in your organization.

    A typical GI will include multiple calls over the course of one to two months.

    IT cost analysis and optimization workshop overview

    Session 1 Session 2 Session 3 Session 4 Session 5
    Activities Understand Your Mandate and Objectives Outline Initiatives for Assets and Vendors Outline Initiatives for Projects and Workforce Develop an IT Cost Optimization Roadmap Communicate and Execute
    1.1 Understand your organization's cost optimization objectives and how this impacts IT.
    1.2 Review potential cost optimization target areas based on your IT financial management benchmarking report.
    1.3 Identify factors constraining cost optimization options.
    1.4 Set concrete IT cost optimization goals.
    1.5 Identify inputs required for decision making.
    2.1 Identify a longlist of possible initiatives around:
    1. Asset lifecycle management, investment deferral, repurposing, etc.
    2. Vendor contract renegotiation, cancelation, etc.
    2.2 Estimate the cost savings of cost optimization initiatives.
    3.1 Identify a longlist of possible initiatives around:
    1. Project priorities, project backlog reduction, project intake restructuring, etc.
    2. Workforce productivity, skills, redeployment, etc.
    3.2 Estimate the cost savings of cost optimization initiatives.
    4.1 Assess the feasibility of each initiative (effort and risk profile) given cost optimization goals.
    4.2 Prioritize cost optimization initiatives to create a final shortlist.
    4.3 Fine-tune key information about your final cost optimization initiatives and develop a cost optimization roadmap for proposal.
    5.1 Outline components of a communication plan, including approvers, stakeholders, and governance and management mechanisms to be used.
    5.2 Create an executive presentation.
    5.3 Set up review time for workshop deliverables and post-workshop activities.
    Output
    • IT cost optimization journey and guiding principles for making corresponding decisions.
    • Long list of possible cost optimization initiatives and their potential cost savings for assets and vendors levers.
    • Long list of possible cost optimization initiatives and their potential cost savings for project portfolio and workforce levers.
    • Prioritized list of key cost optimization initiatives, descriptions, estimated impact, and roadmap.
    • IT cost optimization communication plan and presentation strategy.

    Contact your account representative for more information.
    workshops@infotech.com 1-888-670-8889

    Phase 1

    Understand Your Mandate and Objectives

    Phase 1
    Understand Your Mandate and Objectives

    Phase 2
    Outline Your Cost Optimization Initiatives

    Phase 3
    Develop Your IT Cost Optimization Roadmap

    Phase 4
    Communicate and Execute

    This phase will walk you through the following activities:

    • Business context and cost optimization journey
    • Cost constraints and parameters
    • Cost optimization goals

    This phase involves the following participants:

    • CIO/IT director
    • IT finance lead

    1.1 Gain consensus on the business context and IT cost optimization journey

    60 minutes

    • Using the questions on slide 20, conduct a brief journey assessment to ensure consensus on the direction you are planning to take.
    • Document your findings in the provided template.
    Input Output
    • Understanding business objectives and identifying your IT mandate
    • Determining the cost optimization journey: reactive, proactive, or strategic
    Materials Participants
    • Whiteboard or flip charts
    • Journey assessment template
    • CIO/IT director
    • IT finance lead

    See the next three slides for guidelines and the journey assessment questions and template.

    Distinguishing between three journeys

    By considering business objectives without forgoing your IT mandate.

    Journey Reactive Proactive Strategic
    Description
    • Business objectives are closely tied to cost reduction, forcing cost cutting across IT.
    • Typically occurs during turbulent economic times, when slow revenue growth is expected.
    • Business objectives do not include clear cost optimization initiatives but mandates IT to be fiscally conservative.
    • Typically occurs when economic turbulence is on the horizon and the organization's revenue is stable - executives only have a fiscal discipline guidance.
    • Business objectives do not include clear cost optimization initiatives.
    • Typically occurs when the overall economy is in good shape and the organization is in positive revenue growth territory.
    Main Focus
    • Quick-to-execute measures with few dependencies and concrete impact in response to business urgency and/or executive directive.
    • Enabling the organization to respond to different types and magnitudes of business change in a more planned and controlled manner.
    • Establishing an efficient, agile, sustainable, and strategically aligned cost optimization practice across all stages of the business cycle, regardless of business conditions.

    Questions to help determine your journey

    Business Objectives Business Strategy
    • What are the current business objectives?
    • Are there any stated cost-related objectives? If yes, what cost-related objectives have been stated by organizational leadership, such as cuts, areas of investment, and any targets for both?
    • Does the organization have a business strategy in place?
    • Was the business strategy reviewed or revised recently?
    • What's the business strategy focus for the next 12 months?
    • Are there any cost optimization implications within the current business strategy?
    IT Objectives IT Strategy and Mandate
    • What are your current IT objectives?
    • Are your IT objectives aligned to business objectives?
    • Do you have any IT cost-related objectives? If yes, what are your current IT cost-related objectives?
    • Are your IT cost-related objectives aligned to business objectives?
    • Do you have an IT strategy in place?
    • Is your IT strategy aligned to your organization's business strategy?
    • Do you have a cost optimization mandate? If yes, what is your cost optimization mandate?
    • What's the fiscal guidance and direction in IT?
    Journey
    Agreed-upon journey: reactive, proactive, or strategic.

    Template & Example

    Journey assessment

    Business Objectives Business Strategy
    • The founder's mission around quality persists despite ownership/leadership changes. Reliability and dependability are really important to everyone.
    • Increase visibility and interconnectivity across the supply chain.
    • Increase market share: younger markets and emerging foreign markets.
    • Economic outlook expected to negatively affect the bottom line - will need to trim and protect the core.
    • Grow Gizmo product sales by 10%.
    • Lower production cost of Gizmo product by 5%.
    IT Objectives IT Strategy and Mandate
    • IT/OT convergence, process automation, and modernization are major opportunities to better position the business for the future and introduce more agility into operations and reduce production cost.
    • Very mature and stable production processes with 100% uptime is a priority.
    • Lower IT cost related to Gizmo product.
    • There's no clear cost optimization mandate, but a fiscally conservative budget is recommended.
    Journey
    Agreed-upon journey: proactive.

    1.2 Review internal and external benchmarking reports

    60-90 minutes

    1. Review the IT spend and staffing results, summarized in your Info-Tech IT Spend & Staffing Benchmarking report.
    2. Identify areas where your IT spend is disproportionately high or low in comparison with your industry peers.
    3. Review and document any causes or rationales for high or low spend in each area identified. Do not be specific about any actual optimization targets or actions at this stage - simply make notes.
    4. Start a list of potential cost optimization initiatives to be further analyzed and investigated for feasibility at a later stage (see next slides for guidance, example, and template).
    InputOutput
    • IT Spend & Staffing Benchmarking report
    • A list of potential cost optimization focus areas
    MaterialsParticipants
    • Whiteboard or flip charts
    • Potential cost optimization initiatives list template
    • CIO/IT director
    • IT finance lead

    Info-Tech's approach

    Our IT cost model maps your IT spending and staffing according to four key views, putting IT spend in language that stakeholders across the organization can relate to.

    IT cost model maps

    Template & Example

    Potential cost optimization initiatives list

    Brainstorm and list potential cost optimization initiatives at a macro level.

    Potential Initiative Source Source Contact Notes
    Reduce application maintenance cost Internal Benchmarking Report CIO Based on current year report
    Rationalize software applications Info-Tech IT Benchmarking Report CIO Based on current year report
    Migrate key business applications to the cloud Latest iteration of the IT strategy CIO New IT strategy will be in development concurrent with cost optimization strategy development
    Align job roles to the current IT structure IT org. chart and salaries HR, CIO Based on information of the current year and will likely change in a few months (beginning of a new year)
    Renegotiate the top five vendor contracts up for renewal this year List of IT vendors Procurement office, CIO, IT infrastructure director, IT applications director, IT services manager Based on a list consolidated last week

    Want help with your IT spend transparency and benchmarking efforts?

    Let us fast-track your IT spend journey.

    The path to IT financial management maturity starts with knowing exactly where your money is going. To streamline this effort, Info-Tech offers an IT Spend & Staffing Benchmarking service that provides full transparency into where your money is going without any heavy lifting on your part.

    This unique service features:

    • A client-proven approach to meet your IT spend transparency goals.
    • Spend and staff mapping that reveals business consumption of IT.
    • Industry benchmarking to compare your spending and staffing to that of your peers.
    • Results in a fraction of the time with much less effort than going it alone.
    • Expert review of results and ongoing discussions with Info-Tech analysts.

    If you'd like Info-Tech to pave the way to IT spend transparency, contact your account manager for more information - we're happy to talk anytime.

    1.3 Identify your overarching constraints

    30 minutes

    1. Assess where spend change opportunities are currently limited or nonexistent due to organization edict or policy, industry regulatory requirements, or active contracts. Ask yourself:
      1. Where do IT spend bottlenecks exist and what are they?
      2. What IT spend objectives and practices are absolutely mandatory and nonnegotiable from both a business and an IT perspective?
      3. Are there areas where spend change is possible but would be very difficult to execute due to the stakeholders involved, governance processes, time frames, or another constraining factor?
    2. Identify where reduction or elimination of an IT service would negatively affect required service levels and business continuity or recovery.
    3. List constraints as negotiable or nonnegotiable on the template provided.
    4. Remove areas of focus from your cost optimization scope that land outside achievable parameters, and flag those that are difficult but still possible.
    InputOutput
    • Situational awareness and current state understanding
    • List of negotiable constraints to act on
    • Delimiting the cost optimization scope
    MaterialsParticipants
    • Whiteboard or flip charts
    • Constraints assessment template
    • CIO/IT director
    • IT finance lead

    See the next slides for additional guidance and a constraints assessment template.

    Acknowledge your limitations

    By recognizing your constraints, which will lead you to define your cost optimization scope.

    Constraints Organizational Legal/Regulatory Other
    What An organizational constraint is any work condition that hinders an employee's performance - be it physical, emotional, or otherwise. A legal or regulatory constraint is any law, rule, standard, or regulation - be it industry specific or otherwise - limiting the ability of any stakeholder to get the most out of a certain activity, initiative, or project. Other types of constraints affecting business units.
    Who Collaborate with your IT leaders and business partners to identify all major constraints that would affect cost optimization initiatives.
    How Discussions and information sessions to distinguish between negotiable and nonnegotiable constraints that would thwart cost optimization efforts:
    • Legal/regulatory requirements and related initiatives (past, ongoing, and planned/expected).
      Example: projects cannot be delayed, processes are difficult to simplify, etc.
    • Operational governance - organization policies, processes, methodologies, structure, etc.
      Example: adopting a waterfall model for development instead of an agile one.
    • Financial and accounting practices.
      Example: capital expenditure and operational expenditure classification.
    Challenge Degree to which you can influence certain outcomes within a set time frame:
    • Prioritize negotiating constraints where you can influence the outcome or maximize cost optimization benefits.

    We define a constraint as a restriction controlling the behavior of any of your stakeholders, hence preventing a desired outcome.

    In our context, constraints will determine your playing field: the boundaries of your cost optimization scope.

    Distinguish between constraints

    Negotiable vs. nonnegotiable to delimit your cost optimization scope.

    Distinguish between constraints

    Template & Example

    Constraints assessment

    List high-level limitations that hinder your cost optimization options.

    Nonnegotiable constraints
    Organizational Legal/Regulatory IT/Other
    Prioritization of sales/customer service activities SEC compliance/reporting mandates Production unit incident response service levels
    [Constraint] [Constraint] [Constraint]
    [Constraint] [Constraint] [Constraint]
    [Constraint] [Constraint] [Constraint]
    Negotiable constraints
    Organizational Legal/Regulatory IT/Other
    Core business operations process design Vendor contracts up for near-term renewal Current capital project commitments
    [Constraint] [Constraint] [Constraint]
    [Constraint] [Constraint] [Constraint]
    [Constraint] [Constraint] [Constraint]

    1.4 Establish overarching cost optimization goals

    60-90 minutes

    1. Establish specific IT cost optimization goals. Depending on your journey, step 1.1. You will have one to three overarching cost optimization goals, as follows:
      1. Reactive: Cost-cutting goal to reduce unwarranted IT spending.
      2. Proactive: Cost-to-value optimization goal.
      3. Strategic: Cost optimization sustainability goal.
      Consider amounts and time frames, as well as likely/suitable approaches you plan to employ to achieve these goals.
    2. Document your final cost optimization goals in the IT Cost Optimization Workbook.
    3. Revisit your goals after outlining your initiatives (phase 2) to ensure feasibility depending on your journey.

    Download the IT Cost Optimization Workbook

    InputOutput
    • Situational awareness and current state understanding
    • Defined goals for IT cost optimization
    MaterialsParticipants
    • Whiteboard or flip charts
    • Set Cost Optimization Goals tab in the IT Cost Optimization Workbook
    • CIO/IT director
    • IT finance lead

    Template & Example

    Document your overarching goals

    Excel Workbook: IT Cost Optimization – Set Optimization Goals Worksheet

    Refer to the example and guidelines below on how to document your goals based on your journey:

    Table of Overarching Goals

    Column ID Input Type Guidelines
    B Dropdown Select the appropriate journey: Reactive, Proactive, or Strategic.
    C Dropdown Select the appropriate cost optimization objective: Reduce Unwarranted IT Spending, Optimize Cost-to-Value, Sustain Cost Optimization.
    D Formula Automatic calculation, no entry required. Reduce Unwarranted IT Spending goal is the first priority, followed by Optimize Cost-to-Value, and Sustain Cost Optimization goals, respectively.
    E Text Enter the overarching goal related to each objective.

    Complete the following fields for each goal depending on your journey in the Excel Workbook as per guidelines:

    1. Navigate to the Set Cost Optimization Goals tab.
    2. Identify your journey and objective for each goal.
    3. Document your goal(s).

    Download the IT Cost Optimization Workbook

    Template & Example

    Break down your goals per quarter

    Excel Workbook: IT Cost Optimization - Set Cost Optimization Goals Worksheet

    Refer to the example and guidelines below on how to break down your goals per quarter and track your progress:

    Table break down your goals per quarter

    Column ID Input Type Guidelines
    F, G, H, I Text Enter the target per quarter: It could be a percentage, dollar amount, or description of the breakdown, depending on the cost optimization goal and objective.

    Complete the following fields for each goal depending on your journey in the Excel Workbook as per guidelines:

    1. Navigate to the Set Cost Optimization Goals tab.
    2. Determine your target per quarter for every goal.
    3. Document your targets.

    Download the IT Cost Optimization Workbook

    1.5 Identify inputs required for decision making

    60-90 minutes

    1. Each of the optimization levers (assets, vendors, project portfolio, and workforce) will require specific and unique sources of information which you will need to collect before moving forward. Examples of important sources of information include:
      1. Latest iteration of the IT strategy.
      2. List of IT assets (hardware, software).
      3. List of IT services or IT service catalog.
      4. List of current and planned IT projects and their resourcing allocations.
      5. List of largest vendor contracts and their key details, such as their expiration/renewal date.
      6. IT department organizational chart and salaries (by role).
    2. Review and analyze each of the documents.
    3. Continue to list potential cost optimization initiatives (step 1.2) to be further analyzed and investigated for feasibility at a later stage.
    InputOutput
    • IT strategy
    • Lists of IT assets, services, and projects
    • Top vendor contracts
    • IT org. chart and salaries
    • Macrolevel list of potential cost optimization initiatives
    MaterialsParticipants
    • Potential cost optimization initiatives list template (slide 24)
    • CIO/IT director
    • IT finance lead

    Prepare all pertinent sources of information

    And start drafting your cost optimization laundry list.

    Documents Benchmarking IT Strategy Other Information Sources
    What
    • Review:
      • Your IT spend trend across several years (ideally three to five years): internal benchmarking report.
      • Your IT spend compared to industry peers: external benchmarking report.
    • Analyze your internal and external benchmarking reports across the four views: service, expense, business, and innovation.
    • Review your business aligned IT strategy to identify cost optimization related initiatives.
    • At a later stage, exploit your IT strategy to prioritize cost optimization initiatives as needed.
    • Review your IT organization chart and salaries to determine whether the IT organization structure is optimal, job descriptions are mapped to the desired structure, employee skillsets and salary scale are adequate and aligned to the job description, etc.
    • Compile and examine lists of assets, vendors, projects, and services.
    • Prepare any other information sources you deem meaningful.
    Who Collaborate with your IT leaders and business partners to:
    • Prepare the necessary reports, documents, and required sources of information.
    • Identify potential cost optimization initiatives around areas of improvement.
    How Discussions and information sessions to analyze and deep dive on raw findings.
    Challenge Time to compile and analyze reports without affecting day-to-day operations:
    • Outsource some activities such as external benchmarking to organizations like Info-Tech.
    • Get consulting support on specific reports or tasks through workshops, calls, etc.

    Phase 2

    Outline Your Cost Optimization Initiatives

    Phase 1
    Understand Your Mandate and Objectives

    Phase 2
    Outline Your Cost Optimization Initiatives

    Phase 3
    Develop Your IT Cost Optimization Roadmap

    Phase 4
    Communicate and Execute

    This phase will walk you through the following activities:

    • IT cost optimization initiatives
    • IT cost optimization workbook

    This phase involves the following participants:

    • CIO/IT director
    • IT finance lead
    • IT asset manager
    • IT infrastructure manager
    • IT vendor management lead
    • PMO lead
    • IT talent management representative
    • Other IT management

    Outline your cost optimization initiatives

    Across Info-Tech's four levers.

    Levers ASSETS VENDORS PROJECT PORTFOLI WORKFORCE
    What
    • Maintain trustworthy data to optimize cost, reduce risk, and improve services in line with business priorities and requirements:
      • Optimize cost: reallocate unused hardware and software, end unneeded service agreements, and manage renewals and audits.
      • Reduce risk: provide comprehensive asset data for security controls development and incident management - manage equipment disposal.
      • Improve IT service: support incident, problem, request, and change management with ITAM data.
    • Examine your vendor contracts and vendor management practices to optimize your expected value from every IT provider you deal with.
    • Treat vendor management as a proactive, cross-functional practice aiming to create value by improving communication, relationships, processes, performance, and ultimately reducing cost.
    • Reassess your project portfolio to maximize total value in line with business objectives and strategy.
    • Reduce resource waste with a strategic approach to project portfolio management:
      • Ensure that approved projects can be completed by aligning intake with real project capacity.
      • Minimize over-allocation of resources by allocating based on the proportion of project vs. non-project work.
      • Forecast future resource requirements by maintaining accurate resource capacity data.
    • Review your strategic workforce plan to identify cost optimization opportunities.
    • Determine capability gaps to train or develop current staff and minimize the need for severance payouts and hiring costs, while providing clear career paths to retain high performers.
    • Link workforce planning with strategic planning to ensure that you have the right people in the right positions, in the right places, at the right time, with the knowledge, skills, and attributes to deliver on strategic business goals.
    Who Collaborate with your IT leaders and business partners to:
    • Prepare the necessary reports, documents, and required sources of information.
    • Determine cost optimization initiatives across the four levers.
    How You will decide on the best course of action depending on your journey.

    Most common cost optimization challenges

    Across Info-Tech's four levers.

    Levers ASSETS VENDORS PROJECT PORTFOLI WORKFORCE
    Challenge
    • Incomplete or inaccurate data, poor processes, inadequate tools, and lack of support across the organization is leading to bad decision making while damaging value.
    • Spending on IT providers is increasing while vendor contract expected value - results, output, performance, solutions, or outcomes - is not realized.
    • Poor planning, conflicting priorities, and resource scarcity is affecting project outcomes, resulting in suboptimal value.
    • Talent shortages, lack of prioritization, and experience in managing an IT workforce is leading to higher costs and a loss in value.
    Solution
    • Develop a sustainable IT asset management (ITAM) strategy aligned with your business priorities.
    • Establish a vendor management initiative (VMI) with a solid foundation to fit your organization's culture, environment, and goals.
    • Create a coherent strategy to maximize the total value that projects deliver as a portfolio, rather than a collection of individual projects.
    • Develop a strategic workforce plan (SWP) to ensure you have the right people in place at the right time.
    Related Info-Tech Research Develop an IT Asset Management Strategy Jump-start Your Vendor Management Initiative Develop a Project Portfolio Management Strategy Build a Strategic IT Workforce Plan

    2.1 Determine your cost optimization initiatives

    8 hours

    Now that you have identified your journey and understood your constraints:

    1. Review your list of potential cost optimization initiatives and document viable ones in the IT Cost Optimization Workbook.
    2. Think of potential cost optimization initiatives within the four levers: assets, vendors, project portfolio, and workforce. The following slides will help you in this endeavor.

    Download the IT Cost Optimization Workbook

    Input Output
    • Potential cost optimization initiatives list
    • Outline Initiatives in the IT Cost Optimization Workbook
    Materials Participants
    • Whiteboard or flip charts
    • Outline Initiatives tab in the IT Cost Optimization Workbook
    • CIO/IT director
    • IT finance lead
    • Other IT management - depending on the optimization lever (Assets, Vendors, Project Portfolio, or Workforce)

    Plan your cost optimization initiatives

    Your initiatives will differ depending on your journey

    In terms of aggressiveness and objectives.

    Plan cost optimization initiatives

    Cost optimization initiatives pertaining to a reactive journey are characterized by aggressive cost reduction.

    On the other hand, cost optimization initiatives within a strategic journey can vary in aggressiveness across objectives.

    2.1.1 Identify asset optimization initiatives

    2 hours

    1. Review the IT asset management strategy if available. Compile a list of all hardware, software, and facility asset costs for delivery of IT services.
    2. Analyze hardware and software assets for opportunities to consolidate, reduce, eliminate, and/or enhance functionality/automation. Look for:
      1. Redundancy or duplication of functionality not necessary for disaster recovery or business continuity purposes.
      2. Low or no-use software.
      3. Homegrown or legacy systems with high maintenance/support burdens.
      4. Multiple, old, or unsupported versions of current-use software.
      5. Opportunities to delay hardware/software refreshes or upgrades.
      6. Cloud/outsourced options.
      7. Instances of unsanctioned shadow IT.
    3. Reassess your in-house asset management processes to see where efficiency and effectiveness could be improved overall.
    4. Document cost optimization initiatives that could be driven by asset optimization objectives in the IT Cost Optimization Workbook.

    Download the IT Cost Optimization Workbook

    InputOutput
    • IT asset management strategy
    • List of current assets including hardware, software, and facilities
    • Outline Initiatives driven by asset optimization objectives in the IT Cost Optimization Workbook
    MaterialsParticipants
    • Whiteboard or flip charts
    • Outline Initiatives tab in the IT Cost Optimization Workbook
    • CIO/IT director
    • IT finance lead
    • IT asset manager
    • IT infrastructure manager
    • Other IT management

    Example

    Asset optimization

    Some examples to get you started

    Journey Reactive, Proactive, or Strategic Proactive or Strategic Strategic
    Initiatives
    • Validate the license cost of performance optimization.
    • Review the utilization of software/hardware before renewal or purchase of additional hardware or software.
    • Assess new license cost against projects to determine possibility of differing or canceling software.
    • Postpone the purchases of hardware.
    • Extend the life of hardware.
    • Consolidate and reconfigure hardware.
    • Return damaged/malfunctioning hardware under warranty.
    • Consolidate and reconfigure software.
    • Optimize software/hardware functionality.
    • Implement hardware/software standard or policy.
    • Develop an infrastructure management outsourcing strategy.
    • Optimize cloud management: review utilization, licensing, cost, etc.
    • Develop a sustainable IT asset management (ITAM) strategy aligned with your business priorities.
    • Minimize shadow IT by creating a policy and improving the service request process.
    • Develop or assess a cloud strategy for a certain service.
    No initiatives for the reactive journey. No initiatives for the reactive or proactive journeys.
    Objective Reduce Unwarranted IT Spending Optimize Cost-to-Value Sustain Cost Optimization

    Template & Example

    List your objectives and initiatives

    Excel Workbook: IT Cost Optimization – Outline Initiatives Worksheet

    Refer to the example and guidelines below on how to input your asset optimization initiatives and related objectives:

    List your objectives and initiatives

    Column ID Input Type Guidelines
    B Formula Automatic calculation, no entry required. The ID will update once there's an input in column E.
    C Dropdown Select an optimization lever: Assets, Vendors, Project Portfolio, or Workforce.
    D Dropdown Select an initiative focus from the dropdown list - this will help you think of initiatives.
    E Text Enter your initiative.
    F Text Write a brief description per initiative, providing a cost optimization rationale.
    G Dropdown Select the cost type per initiative: OpEx (operating expenditure) or CapEx (capital expenditure).
    H Dropdown Select 1 of 3 objectives for each initiative: Reduce Unwarranted IT Spending, Optimize Cost-to-Value, or Sustain Cost Optimization.

    List your initiatives in the provided Excel Workbook as per guidelines:

    1. Navigate to the Outline Initiatives tab.
    2. Enter all your initiatives driven by the asset optimization lever.
    3. Determine the cost optimization objective per initiative.

    2.1.2 Identify vendor optimization initiatives

    2 hours

    1. Revisit the IT vendor classification if available. Identify all existing vendor contracts up for renewal within the current fiscal year and create an inventory.
    2. Examine your vendor contracts to optimize your expected value from every IT provider you deal with. For each contract:
      1. Identify the business purpose/drivers.
      2. Identify the expiration/renewal date to determine time frames for action.
      3. Determine if there is an opportunity to rightsize, cancel, renegotiate costs/service levels, or postpone renewal/purchase.
      4. Identify integrations and interdependencies with other hardware and software systems to understand scope and impact of potential changes.
    3. Reassess your in-house vendor management processes to see where efficiency and effectiveness could be improved overall.
    4. Document cost optimization initiatives that could be driven by vendor optimization objectives in the IT Cost Optimization Workbook.

    Download the IT Cost Optimization Workbook

    InputOutput
    • Vendor classification
    • Vendors contracts
    • Outline Initiatives driven by vendor optimization objectives in the IT Cost Optimization Workbook
    MaterialsParticipants
    • Whiteboard or flip charts
    • Outline Initiatives tab in the IT Cost Optimization Workbook
    • CIO/IT director
    • IT finance lead
    • IT vendor management lead
    • Other IT management

    Example

    Vendor optimization

    Some examples to get you started.

    Journey Reactive, Proactive, or Strategic Proactive or Strategic Strategic
    Initiatives
    • Renegotiate and rightsize a vendor contract:
      • Cancel vendor/service/type application contract.
      • Renegotiate vendor/service/type contract.
      • Cancel vendor/service/type licenses.
      • Rationalize number of vendor/service/type licenses.
    • Consolidate vendors/resellers with similar services, products and features.
    • Implement a vendor management initiative to maximize value and minimize risk.
    • Consolidate contracts to take advantage of spending power and volume.
    • Set up custom vendor performance metrics.
    • Establish ongoing monitoring of vendor risk (financial, security, etc.).
    No initiatives for the reactive journey. No initiatives for the reactive or proactive journeys.
    Objective Reduce Unwarranted IT Spending Optimize Cost-to-Value Sustain Cost Optimization

    Template & Example

    List your objectives and initiatives

    Excel Workbook: IT Cost Optimization – Outline Initiatives Worksheet

    Refer to the example and guidelines below on how to input your vendor optimization initiatives and related objectives:

    List your objectives and initiatives

    Column ID Input Type Guidelines
    B Formula Automatic calculation, no entry required. The ID will update once there's an input in column E.
    C Dropdown Select an optimization lever: Assets, Vendors, Project Portfolio, or Workforce.
    D Dropdown Select an initiative focus from the dropdown list - this will help you think of initiatives.
    E Text Enter your initiative.
    F Text Write a brief description per initiative, providing a cost optimization rationale.
    G Dropdown Select the cost type per initiative: OpEx (operating expenditure) or CapEx (capital expenditure).
    H Dropdown Select 1 of 3 objectives for each initiative: Reduce Unwarranted IT Spending, Optimize Cost-to-Value, or Sustain Cost Optimization.

    List your initiatives in the provided Excel Workbook as per guidelines:

    1. Navigate to the Outline Initiatives tab.
    2. Enter all your initiatives driven by the vendor optimization lever.
    3. Determine the cost optimization objective per initiative.

    2.1.3 Identify project portfolio optimization initiatives

    2 hours

    1. Review the IT Project Portfolio Strategy if available, and the list of both in-flight and planned projects.
    2. Reassess your project portfolio to maximize total value in line with business objectives and strategy. For each current and pending project on the list, identify a cost optimization initiative, including:
      1. Revisiting, confirming, and documenting actual project rationale with the business in relation to strategic goals.
      2. Rescoping existing projects that are underway.
      3. Accelerating planned or existing projects that enable business cost savings or competitive advantage and revenue growth.
      4. Canceling or postponing projects that are underway or haven't started.
      5. Identifying net-new projects that enhance business capabilities or save business costs.
    3. Reassess your in-house project management and project portfolio management processes to see where efficiency and effectiveness could be improved overall.
    4. Document cost optimization initiatives that could be driven by project portfolio optimization objectives in the IT Cost Optimization Workbook.

    Download the IT Cost Optimization Workbook

    Input Output
    • Project Portfolio Management Strategy
    • List of current and pending projects
    • Outline Initiatives driven by project portfolio optimization objectives in the IT Cost Optimization Workbook
    Materials Participants
    • Outline Initiatives tab in the IT Cost Optimization Workbook
    • CIO/IT director
    • IT finance lead
    • PMO lead
    • Other IT management

    Example

    Project portfolio optimization

    Some examples to get you started.

    Journey Reactive, Proactive, or Strategic Proactive or Strategic Strategic
    Initiatives
    • Cancel projects with no executive sponsor.
    • Cancel projects with unacceptable timelines.
    • Postpone projects where there is a more urgent need for related resources.
    • Rescope projects where a more effective business case has been identified.
    • Freeze projects where scope and resourcing are uncertain.
    • Accelerate projects that enable business cost savings or a competitive advantage with revenue growth.
    • Combine projects that are better managed by realigning project managers and coordinators.
    • Break projects into phases to front-load realized value.
    • Outsource projects with commoditized skillset requirements.
    • Reassess the technology requirements when multiple vendors are involved.
    • Reexamine project rationale with the business in relation to strategic goals.
    • Identify net-new projects that offer improved value in relation to current economics.
    • Reassess the strategic drivers for project spending in the face of shifting priorities.
    • Implement a project portfolio governance function.
    • Introduce a benefits realization discipline in relation to the benefits forecasted during project approval.
    No initiatives for the reactive journey. No initiatives for the reactive or proactive journeys.
    Objective Reduce Unwarranted IT Spending Optimize Cost-to-Value Sustain Cost Optimization

    Template & Example

    List your objectives and initiatives

    Excel Workbook: IT Cost Optimization – Outline Initiatives Worksheet

    Refer to the example and guidelines below on how to input your project portfolio optimization initiatives and related objectives:

    List your objectives and initiatives

    Column ID Input Type Guidelines
    B Formula Automatic calculation, no entry required. The ID will update once there's an input in column E.
    C Dropdown Select an optimization lever: Assets, Vendors, Project Portfolio, or Workforce.
    D Dropdown Select an initiative focus from the dropdown list - this will help you think of initiatives.
    E Text Enter your initiative.
    F Text Write a brief description per initiative, providing a cost optimization rationale.
    G Dropdown Select the cost type per initiative: OpEx (operating expenditure) or CapEx (capital expenditure).
    H Dropdown Select 1 of 3 objectives for each initiative: Reduce Unwarranted IT Spending, Optimize Cost-to-Value, or Sustain Cost Optimization.

    List your initiatives in the provided Excel Workbook as per guidelines:

    1. Navigate to the Outline Initiatives tab.
    2. Enter all your initiatives driven by the project portfolio optimization lever.
    3. Determine the cost optimization objective per initiative.

    2.1.4 Identify workforce optimization initiatives

    2 hours

    1. Review the IT department's strategic workforce plan (SWP) if available, organizational chart, and salaries by role. Do not review IT staffing in terms of named individuals who occupy a given role - focus on functions, roles, and job descriptions.
    2. Determine capability gaps:
      1. Rectify efficiency, effectiveness, and other performance issues.
      2. Train IT staff to enhance or improve skills and effectiveness.
      3. Add roles, skills, or headcount to improve effectiveness.
      4. Integrate teams to improve collaboration and reduce redundancies or break out new ones to increase focus/specialization.
      5. Redesign job roles and responsibilities.
      6. Redeploy/reassign staff to other teams.
      7. Conduct layoff (as a last resort, starting by assessing contractual employees).
    3. Document cost optimization initiatives that could be driven by workforce optimization objectives in the IT Cost Optimization Workbook.

    Download the IT Cost Optimization Workbook

    InputOutput
    • Strategic workforce plan (SWP)
    • Organizational charts
    • Staff lists
    • Outline Initiatives driven by workforce optimization objectives in the IT Cost Optimization Workbook
    MaterialsParticipants
    • Outline Initiatives tab in the IT Cost Optimization Workbook
    • CIO/IT director
    • IT finance lead
    • Talent management representative
    • Other IT management

    Example

    Workforce optimization

    Some examples to get you started.

    Journey Reactive, Proactive, or Strategic Proactive or Strategic Strategic
    Initiatives
    • Defer vacancy, position, or role.
    • Freeze all overnight and unessential IT staff travel.
    • Outsource project/function to free internal resources.
    • Postpone nonessential IT staff training as per training plans.
    • Suspend IT team discretionary spend.
    • Streamline workforce related to department/service (develop the process).
    • Relocate role or function from division or group to division or group.
    • Adjust framework and level assignments.
    • Promote and train employees for a certain objective.
    • Implement a strategic workforce plan (SWP) to ensure you have the right people in place, at the right time.
    • Set up a workforce performance monitoring framework or process to optimize staffing capabilities aligned with business value.
    No initiatives for the reactive journey. No initiatives for the reactive or proactive journeys.
    Objective Reduce Unwarranted IT Spending Optimize Cost-to-Value Sustain Cost Optimization

    Template & Example

    List your objectives and initiatives

    Excel Workbook: IT Cost Optimization – Outline Initiatives Worksheet

    Refer to the example and guidelines below on how to input your workforce optimization initiatives and related objectives:

    List your objectives and initiatives

    Column ID Input Type Guidelines
    B Formula Automatic calculation, no entry required. The ID will update once there's an input in column E.
    C Dropdown Select an optimization lever: Assets, Vendors, Project Portfolio, or Workforce.
    D Dropdown Select an initiative focus from the dropdown list - this will help you think of initiatives.
    E Text Enter your initiative.
    F Text Write a brief description per initiative, providing a cost optimization rationale.
    G Dropdown Select the cost type per initiative: OpEx (operating expenditure) or CapEx (capital expenditure).
    H Dropdown Select 1 of 3 objectives for each initiative: Reduce Unwarranted IT Spending, Optimize Cost-to-Value, or Sustain Cost Optimization.

    List your initiatives in the provided Excel Workbook as per guidelines:

    1. Navigate to the Outline Initiatives tab.
    2. Enter all your initiatives driven by the workforce optimization lever.
    3. Determine the cost optimization objective per initiative.

    2.2 Estimate the cost savings of cost optimization initiatives

    8 hours

    Now that you have identified your initiatives:

    1. Review your cost optimization initiatives per lever (Assets, Vendors, Project Portfolio, and Workforce).
    2. Determine whether the implementation cost of each of your initiatives is included as part of your budget.
    3. Estimate your cost savings.
    4. Document your assessment in the IT Cost Optimization Workbook.

    Download the IT Cost Optimization Workbook

    InputOutput
    • Potential cost optimization initiatives list
    • Outline Initiatives in the IT Cost Optimization Workbook
    MaterialsParticipants
    • Whiteboard or flip charts
    • Outline Initiatives tab in the IT Cost Optimization Workbook
    • CIO/IT director
    • IT finance lead
    • Other IT management - depending on the optimization lever (Assets, Vendors, Project Portfolio, or Workforce)

    2.2.1 Estimate the costs impacting your asset optimization initiatives

    2 hours

    1. Review each asset optimization initiative to estimate cost implications.
    2. Consider implementation cost in terms of your budget, and document it in the IT Cost Optimization Workbook (see next slides). Is the implementation cost of the underlying initiative considered in your current budget? If not, move to the next initiative. You will assess the flagged initiative independently at a later stage if deemed necessary.
    3. Estimate the current cost related to the initiative (including implementation cost), and document it in the IT Cost Optimization Workbook (see next slides). This will be the first of two inputs needed to calculate the initiative's potential cost savings.
    4. Estimate the expected cost, post initiative execution, of the underlying initiative, and document it in the IT Cost Optimization Workbook (see next slides). This will be the second and last input needed to calculate the initiative's potential cost savings.

    Download the IT Cost Optimization Workbook

    InputOutput
    • Asset optimization initiatives
    • Cost and budget information
    • Cost estimates of asset optimization initiatives in the IT Cost Optimization Workbook
    MaterialsParticipants
    • Outline Initiatives tab in the IT Cost Optimization Workbook
    • CIO/IT director
    • IT finance lead
    • IT asset manager
    • IT infrastructure manager
    • Other IT management

    Template & Example

    Estimate your cost

    Excel Workbook: IT Cost Optimization – Outline Initiatives Worksheet

    Refer to the example and guidelines below on how to complete cost estimates for each asset optimization initiative:

    Estimate your cost

    Column ID Input Type Guidelines
    I Dropdown Select if the implementation cost is considered within your budget or not. If not, the initiative will be flagged to be reviewed, and no further entry is required; move to the next initiative. Implementation cost represents your cost for planning, executing, and monitoring the related initiative.
    J, K Whole Number Input a dollar amount. Current cost represents the yearly cost including implementing the initiative, while the expected cost represents the yearly cost after implementing the initiative.
    L Formula Automatic calculation, no entry required. The difference between current cost and expected cost.

    Complete the following fields for each initiative in the Excel Workbook as per guidelines:

    1. Navigate to the Outline Initiatives tab.
    2. Determine if the implementation cost is considered within the budget.
    3. If yes, estimate the current cost, and expected cost of the underlying initiative.

    2.2.2 Estimate the costs impacting your vendor optimization initiatives

    2 hours

    1. Review each vendor optimization initiative to estimate cost implications.
    2. Consider implementation cost in terms of your budget, and document it in the IT Cost Optimization Workbook (see next slides). Is the implementation cost of the underlying initiative considered in your current budget? If not, move to the next initiative. You will assess the flagged initiative independently at a later stage if deemed necessary.
    3. Estimate the current cost related to the initiative (including implementation cost), and document it in the IT Cost Optimization Workbook (see next slides). This will be the first of two inputs needed to calculate the initiative's potential cost savings.
    4. Estimate the expected cost, post initiative execution, of the underlying initiative, and document it in the IT Cost Optimization Workbook (see next slides). This will be the second and last input needed to calculate the initiative's potential cost savings.

    Download the IT Cost Optimization Workbook

    InputOutput
    • Vendor optimization initiatives
    • Cost and budget information
    • Cost estimates of vendor optimization initiatives in the IT Cost Optimization Workbook
    MaterialsParticipants
    • Outline Initiatives tab in the IT Cost Optimization Workbook
    • CIO/IT director
    • IT finance lead
    • IT vendor management lead
    • Other IT management

    Template & Example

    Estimate your cost

    Excel Workbook: IT Cost Optimization – Outline Initiatives Worksheet

    Refer to the example and guidelines below on how to complete cost estimates for each vendor optimization initiative:

    Estimate your cost

    Column ID Input Type Guidelines
    I Dropdown Select if the implementation cost is considered within your budget or not. If not, the initiative will be flagged to be reviewed, and no further entry is required; move to the next initiative. Implementation cost represents your cost for planning, executing, and monitoring the related initiative.
    J, K Whole Number Input a dollar amount. Current cost represents the yearly cost including implementing the initiative, while the expected cost represents the yearly cost after implementing the initiative.
    L Formula Automatic calculation, no entry required. The difference between current cost and expected cost.

    Complete the following fields for each initiative in the Excel Workbook as per guidelines:

    1. Navigate to the Outline Initiatives tab.
    2. Determine if the implementation cost is considered within the budget.
    3. If yes, estimate the current cost, and expected cost of the underlying initiative.

    2.2.3 Estimate the costs impacting your project portfolio optimization initiatives

    2 hours

    1. Review each project portfolio optimization initiative to estimate cost implications.
    2. Consider implementation cost in terms of your budget, and document it in the IT Cost Optimization Workbook (see next slides). Is the implementation cost of the underlying initiative considered in your current budget? If not, move to the next initiative. You will assess the flagged initiative independently at a later stage if deemed necessary.
    3. Estimate the current cost related to the initiative (including implementation cost), and document it in the IT Cost Optimization Workbook (see next slides). This will be the first of two inputs needed to calculate the initiative's potential cost savings.
    4. Estimate the expected cost, post initiative execution, of the underlying initiative, and document it in the IT Cost Optimization Workbook (see next slides). This will be the second and last input needed to calculate the initiative's potential cost savings.

    Download the IT Cost Optimization Workbook

    InputOutput
    • Project portfolio optimization initiatives
    • Cost and budget information
    • Cost estimates of project portfolio optimization initiatives in the IT Cost Optimization Workbook
    MaterialsParticipants
    • Outline Initiatives tab in the IT Cost Optimization Workbook
    • CIO/IT director
    • IT finance lead
    • PMO lead
    • Other IT management

    Template & Example

    Estimate your cost

    Excel Workbook: IT Cost Optimization – Outline Initiatives Worksheet

    Refer to the example and guidelines below on how to complete cost estimates for each project portfolio optimization initiative:

    Estimate your cost

    Column ID Input Type Guidelines
    I Dropdown Select if the implementation cost is considered within your budget or not. If not, the initiative will be flagged to be reviewed, and no further entry is required; move to the next initiative. Implementation cost represents your cost for planning, executing, and monitoring the related initiative.
    J, K Whole Number Input a dollar amount. Current cost represents the yearly cost including implementing the initiative, while the expected cost represents the yearly cost after implementing the initiative.
    L Formula Automatic calculation, no entry required. The difference between current cost and expected cost.

    Complete the following fields for each initiative in the Excel Workbook as per guidelines:

    1. Navigate to the Outline Initiatives tab.
    2. Determine if the implementation cost is considered within the budget.
    3. If yes, estimate the current cost, and expected cost of the underlying initiative.

    2.2.4 Estimate the costs impacting your workforce optimization initiatives

    2 hours

    1. Review each workforce optimization initiative to estimate cost implications.
    2. Consider implementation cost in terms of your budget, and document it in the IT Cost Optimization Workbook (see next slides). Is the implementation cost of the underlying initiative considered in your current budget? If not, move to the next initiative. You will assess the flagged initiative independently at a later stage if deemed necessary.
    3. Estimate the current cost related to the initiative (including implementation cost), and document it in the IT Cost Optimization Workbook (see next slides). This will be the first of two inputs needed to calculate the initiative's potential cost savings.
    4. Estimate the expected cost, post initiative execution, of the underlying initiative, and document it in the IT Cost Optimization Workbook (see next slides). This will be the second and last input needed to calculate the initiative's potential cost savings.

    Download the IT Cost Optimization Workbook

    InputOutput
    • Workforce optimization initiatives
    • Cost and budget information
    • Cost estimates of workforce optimization initiatives in the IT Cost Optimization Workbook
    MaterialsParticipants
    • Outline Initiatives tab in the IT Cost Optimization Workbook
    • CIO/IT director
    • IT finance lead
    • Talent management representative
    • Other IT management

    Template & Example

    Estimate your cost

    Excel Workbook: IT Cost Optimization –i Outline Initiatives Worksheet

    Refer to the example and guidelines below on how to complete cost estimates for each workforce optimization initiative:

    Estimate your cost

    Column ID Input Type Guidelines
    I Dropdown Select if the implementation cost is considered within your budget or not. If not, the initiative will be flagged to be reviewed, and no further entry is required; move to the next initiative. Implementation cost represents your cost for planning, executing, and monitoring the related initiative.
    J, K Whole Number Input a dollar amount. Current cost represents the yearly cost including implementing the initiative, while the expected cost represents the yearly cost after implementing the initiative.
    L Formula Automatic calculation, no entry required. The difference between current cost and expected cost.

    Complete the following fields for each initiative in the Excel Workbook as per guidelines:

    1. Navigate to the Outline Initiatives tab.
    2. Determine if the implementation cost is considered within the budget.
    3. If yes, estimate the current cost, and expected cost of the underlying initiative.

    Phase 3

    Develop Your IT Cost Optimization Roadmap

    Phase 1
    Understand Your Mandate and Objectives

    Phase 2
    Outline Your Cost Optimization Initiatives

    Phase 3
    Develop Your IT Cost Optimization Roadmap

    Phase 4
    Communicate and Execute

    This phase will walk you through the following activities:

    • IT cost optimization workbook
    • IT cost optimization roadmap

    This phase involves the following participants:

    • CIO/IT director
    • IT finance lead
    • IT asset manager
    • IT infrastructure manager
    • IT vendor management lead
    • PMO lead
    • IT talent management representative
    • Other IT management

    Develop your prioritized and aligned cost optimization roadmap

    The process of developing your roadmap is where you set final cost optimization priorities, conduct a final rationalization to decide what's in and what's out, and document your proposed plan of action.

    First, take a moment to consider if you missed anything. Too often, only the cost cutting elements of the cost optimization equation get attention. Remember that cost optimization also includes making smart investments. Sometimes adding and expanding is better for the business than removing or contracting.

    • Do your proposed initiatives help position the organization to recover quickly if you're dealing with a downturn or recession scenario?
    • Have you fully considered growth or innovation opportunities that will help optimize costs in the long run?

    Feasibility
    Eliminate initiatives from the longlist of potential initiatives that cannot be achieved given the cost optimization goals you determined at the beginning of this exercise.

    Priority
    Rank order the remaining initiatives according to their ability to contribute to goal attainment and dependency relationships with external constraints and one another.

    Action Plan
    Create an overarching visual roadmap that shows how you intend to achieve your cost optimization goals over the short, medium, and long-term.

    3.1 Assess the feasibility of your cost optimization initiatives

    4 hours

    Now that you have identified your initiatives across the four levers and understood the business impacts:

    1. Review each of your cost optimization initiatives and estimate the feasibility in terms of:
      1. Effort required to implement.
      2. Risk: Likelihood of failure and impact on performance.
      3. Approval rights: Within the IT or finance's accountability/domain or not.
    2. Document your assessment in the IT Cost Optimization Workbook.

    Download the IT Cost Optimization Workbook

    InputOutput
    • Cost optimization initiatives
    • Feasibility estimates of cost optimization initiatives in the IT Cost Optimization Workbook
    MaterialsParticipants
    • Define Variables tab in the IT Cost Optimization Workbook
    • Outline Initiatives tab in the IT Cost Optimization Workbook
    • CIO/IT director
    • IT finance lead
    • Other IT management - depending on the optimization lever (Assets, Vendors, Project Portfolio, or Workforce)

    3.1.1 Estimate the feasibility of your asset optimization initiatives

    1 hour

    1. Review each asset optimization initiative to estimate feasibility implications.
    2. Start by defining the effort required variables. Think in terms of how many dedicated full-time employees you would need to implement the initiative. Document your definition for each of the three variables (High, Medium, or Low) in the IT Cost Optimization Workbook (see next slides). Then, estimate the effort required to implement the related initiative. Consider complexity, scope, and resource availability, before you document it in the IT Cost Optimization Workbook (see next slides).
    3. Define your likelihood of failure variables. Think in terms of probability of failure or percent chance the underlying initiative will not succeed. Document your definition for each of the three variables (High, Medium, or Low) in the IT Cost Optimization Workbook (see next slides). Then, estimate the likelihood of failure to implement the related initiative, and document it in the IT Cost Optimization Workbook (see next slides).
    4. Consider the initiative's impact on performance. Would implementing the initiative hinder IT or business performance? If you are on a reactive journey, would it impede business recovery in any way, shape, or form? Document the impact (Positive Impact, No Impact, or Negative Impact) in the IT Cost Optimization Workbook (see next slides).
    5. Determine who is responsible for approving the initiative. Does it fall within your jurisdiction, responsibility, or accountability? If not, it would mean that it might be more difficult to implement the initiative. Document approval rights (within accountability or not within accountability) in the IT Cost Optimization Workbook (see next slides).

    Download the IT Cost Optimization Workbook

    Input Output
    • Asset optimization initiatives
    • Feasibility estimates of asset optimization initiatives in the IT Cost Optimization Workbook
    Materials Participants
    • Define Variables tab in the IT Cost Optimization Workbook
    • Outline Initiatives tab in the IT Cost Optimization Workbook
    • CIO/IT director
    • IT finance lead
    • IT asset manager
    • IT infrastructure manager
    • Other IT management

    Template & Example

    Define your feasibility variables

    Excel Workbook: IT Cost Optimization – Define Variables Worksheet

    Refer to the example and guidelines below on how to define your feasibility variables for standardization purposes. You can adopt a different definition per optimization lever (Assets, Vendors, Project Portfolio, and Workforce), or maintain the same one across initiatives, depending on what makes sense for your organization:

    Define your feasibility variables

    Column ID Input Type Guidelines
    B, G Formula Automatic calculation, no entry required. The ID will populate automatically.
    C, H Text No entry required. Three variables identified: High, Medium, Low.
    D, E Whole Number Review and input the range of each effort required variable, based on the number of dedicated full-time employees needed to implement an initiative, as it works best for your organization.
    I, J Whole Number Review and input the range of each likelihood of failure variable, based on the probability of failure of an initiative, as it works best for your organization. This example should work for most organizations.

    Define your feasibility variables in the Excel Workbook as per guidelines:

    1. Navigate to the Define Variables tab.
    2. Review and enter the range of each effort required and likelihood of failure variable as you see fit for your organization.

    Template & Example

    Estimate your feasibility

    Excel Workbook: IT Cost Optimization – Outline Initiatives Worksheet

    Refer to the example and guidelines below on how to complete feasibility estimates for each asset optimization initiative:

    Estimate your feasibility

    Column ID Input Type Guidelines
    M Dropdown Select the effort required estimate based on your defined variables. Effort required represents the number of dedicated employees needed to plan, execute, and monitor the underlying initiative, based on the level of maturity and readiness; consider complexity, scope, and resource availability.
    N Dropdown Select the likelihood of failure estimate based on your defined variables. Likelihood of failure represents the probability of failure of the underlying initiative.
    O Dropdown Select the impact on performance estimate related to the implementation of the underlying initiative. Consider the impact on IT and on business (including business recovery if on a reactive journey).
    P Dropdown Select the appropriate approval right related to the underlying initiative. Determine if the initiative's approval falls within your accountability or not.
    Q Text Write a brief description per initiative, providing an impact rationale and identifying the approver where possible.

    Complete the following fields for each initiative in the Excel Workbook as per guidelines:

    1. Navigate to the Outline Initiatives tab.
    2. Determine the appropriate effort required to implement the underlying initiative.
    3. Identify the risk of each initiative: likelihood of failure and impact on performance.
    4. Choose the adequate approval right classification for each initiative.

    3.1.2 Estimate the feasibility of your vendor optimization initiatives

    1 hour

    1. Review each vendor optimization initiative to estimate feasibility implications, along with previously defined variables (see slides 64 and 65).
    2. Consider the initiative's impact on performance. Would implementing the initiative hinder IT or business performance? If you are on a reactive journey, would it impede business recovery in any way, shape, or form? Document the impact (Positive Impact, No Impact, or Negative Impact) in the IT Cost Optimization Workbook (see next slides).
    3. Determine who is responsible for approving the initiative. Does it fall within your jurisdiction, responsibility, or accountability? If not, it would mean that it might be more difficult to implement the initiative. Document approval rights (within accountability or not within accountability) in the IT Cost Optimization Workbook (see next slides).

    Download the IT Cost Optimization Workbook

    InputOutput
    • Vendor optimization initiatives
    • Feasibility estimates of vendor optimization initiatives in the IT Cost Optimization Workbook
    MaterialsParticipants
    • Define Variables tab in the IT Cost Optimization Workbook
    • Outline Initiatives tab in the IT Cost Optimization Workbook
    • CIO/IT director
    • IT finance lead
    • IT vendor management lead
    • Other IT management

    Template & Example

    Estimate your feasibility

    Excel Workbook: IT Cost Optimization – Outline Initiatives Worksheet

    Refer to the example and guidelines below on how to complete feasibility estimates for each vendor optimization initiative:

    Estimate your feasibility

    Column ID Input Type Guidelines
    M Dropdown Select the effort required estimate based on your defined variables. Effort required represents the number of dedicated employees needed to plan, execute, and monitor the underlying initiative, based on the level of maturity and readiness; consider complexity, scope, and resource availability.
    N Dropdown Select the likelihood of failure estimate based on your defined variables. Likelihood of failure represents the probability of failure of the underlying initiative.
    O Dropdown Select the impact on performance estimate related to the implementation of the underlying initiative. Consider the impact on IT and on business (including business recovery if on a reactive journey).
    P Dropdown Select the appropriate approval right related to the underlying initiative. Determine if the initiative's approval falls within your accountability or not.
    Q Text Write a brief description per initiative, providing an impact rationale and identifying the approver where possible.

    Complete the following fields for each initiative in the Excel Workbook as per guidelines:

    1. Navigate to the Outline Initiatives tab.
    2. Determine the appropriate effort required to implement the underlying initiative.
    3. Identify the risk of each initiative: likelihood of failure and impact on performance.
    4. Choose the adequate approval right classification for each initiative.

    3.1.3 Estimate the feasibility of your project portfolio optimization initiatives

    1 hour

    1. Review each project portfolio optimization initiative to estimate feasibility implications, along with previously defined variables (see slides 64 and 65).
    2. Consider the initiative's impact on performance. Would implementing the initiative hinder IT or business performance? If you are on a reactive journey, would it impede business recovery in any way, shape, or form? Document the impact (Positive Impact, No Impact, or Negative Impact) in the IT Cost Optimization Workbook (see next slides).
    3. Determine who is responsible for approving the initiative. Does it fall within your jurisdiction, responsibility, or accountability? If not, it would mean that it might be more difficult to implement the initiative. Document approval rights (within accountability or not within accountability) in the IT Cost Optimization Workbook (see next slides).

    Download the IT Cost Optimization Workbook

    InputOutput
    • Project portfolio optimization initiatives
    • Feasibility estimates of vendor optimization initiatives in the IT Cost Optimization Workbook
    MaterialsParticipants
    • Define Variables tab in the IT Cost Optimization Workbook
    • Outline Initiatives tab in the IT Cost Optimization Workbook
    • CIO/IT director
    • IT finance lead
    • PMO lead
    • Other IT management

    Template & Example

    Estimate your feasibility

    Excel Workbook: IT Cost Optimization – Outline Initiatives Worksheet

    Refer to the example and guidelines below on how to complete feasibility estimates for each project portfolio optimization initiative:

    Estimate your feasibility

    Column ID Input Type Guidelines
    M Dropdown Select the effort required estimate based on your defined variables. Effort required represents the number of dedicated employees needed to plan, execute, and monitor the underlying initiative, based on the level of maturity and readiness; consider complexity, scope, and resource availability.
    N Dropdown Select the likelihood of failure estimate based on your defined variables. Likelihood of failure represents the probability of failure of the underlying initiative.
    O Dropdown Select the impact on performance estimate related to the implementation of the underlying initiative. Consider the impact on IT and on business (including business recovery if on a reactive journey).
    P Dropdown Select the appropriate approval right related to the underlying initiative. Determine if the initiative's approval falls within your accountability or not.
    Q Text Write a brief description per initiative, providing an impact rationale and identifying the approver where possible.

    Complete the following fields for each initiative in the Excel Workbook as per guidelines:

    1. Navigate to the Outline Initiatives tab.
    2. Determine the appropriate effort required to implement the underlying initiative.
    3. Identify the risk of each initiative: likelihood of failure and impact on performance.
    4. Choose the adequate approval right classification for each initiative.

    3.1.4 Estimate the feasibility of your workforce optimization initiatives

    1 hour

    1. Review each workforce optimization initiative to estimate feasibility implications, along with previously defined variables (see slides 64 and 65).
    2. Consider the initiative's impact on performance. Would implementing the initiative hinder IT or business performance? If you are on a reactive journey, would it impede business recovery in any way, shape, or form? Document the impact (Positive Impact, No Impact, or Negative Impact) in the IT Cost Optimization Workbook (see next slides).
    3. Determine who is responsible for approving the initiative. Does it fall within your jurisdiction, responsibility, or accountability? If not, it would mean that it might be more difficult to implement the initiative. Document approval rights (within accountability or not within accountability) in the IT Cost Optimization Workbook (see next slides).

    Download the IT Cost Optimization Workbook

    InputOutput
    • Workforce optimization initiatives
    • Feasibility estimates of workforce optimization initiatives in the IT Cost Optimization Workbook
    MaterialsParticipants
    • Define Variables tab in the IT Cost Optimization Workbook
    • Outline Initiatives tab in the IT Cost Optimization Workbook
    • CIO/IT director
    • IT finance lead
    • Talent management representative
    • Other IT management

    Template & Example

    Estimate your feasibility

    Excel Workbook: IT Cost Optimization – Outline Initiatives Worksheet

    Refer to the example and guidelines below on how to complete feasibility estimates for each workforce optimization initiative:

    Estimate your feasibility

    Column ID Input Type Guidelines
    M Dropdown Select the effort required estimate based on your defined variables. Effort required represents the number of dedicated employees needed to plan, execute, and monitor the underlying initiative, based on the level of maturity and readiness; consider complexity, scope, and resource availability.
    N Dropdown Select the likelihood of failure estimate based on your defined variables. Likelihood of failure represents the probability of failure of the underlying initiative.
    O Dropdown Select the impact on performance estimate related to the implementation of the underlying initiative. Consider the impact on IT and on business (including business recovery if on a reactive journey).
    P Dropdown Select the appropriate approval right related to the underlying initiative. Determine if the initiative's approval falls within your accountability or not.
    Q Text Write a brief description per initiative, providing an impact rationale and identifying the approver where possible.

    Complete the following fields for each initiative in the Excel Workbook as per guidelines:

    1. Navigate to the Outline Initiatives tab.
    2. Determine the appropriate effort required to implement the underlying initiative.
    3. Identify the risk of each initiative: likelihood of failure and impact on performance.
    4. Choose the adequate approval right classification for each initiative.

    3.2 Prioritize cost optimization initiatives to create a final shortlist

    4 hours

    Now that you have your cost and feasibility for each cost optimization initiative:

    1. Review each of your cost optimization initiatives and estimate the time and priority by considering:
      1. Preliminary priority assessment based on your cost and feasibility input.
      2. Time frame: start and end date of each initiative.
      3. Current budget cycle: time remaining in the current budget cycle and potential cost savings in this fiscal year.
    2. Determine the final priority of the initiative and decide whether you want to include it in your 12-month roadmap.
    3. Document your assessment in the IT Cost Optimization Workbook.

    Download the IT Cost Optimization Workbook

    InputOutput
    • Cost optimization initiatives
    • Time and priority estimates of cost optimization initiatives in the IT Cost Optimization Workbook
    MaterialsParticipants
    • Define Priority Threshold tab in the IT Cost Optimization Workbook
    • Outline Initiatives tab in the IT Cost Optimization Workbook
    • CIO/IT director
    • IT finance lead
    • Other IT management - depending on the optimization lever (Assets, Vendors, Project Portfolio, or Workforce)

    3.2.1 Prioritize your asset optimization initiatives

    1 hour

    1. Review each asset optimization initiative to set the priority.
    2. Validate your cost and feasibility estimates and consider the automated evaluation, in the IT Cost Optimization Workbook, providing you with a preliminary priority based on your cost and feasibility estimates (see next slides).
    3. Revisit your overarching goals (step 1.4) as you will assess the time it will take you to complete your initiatives and prioritize accordingly.
    4. Determine your start and end date for each initiative based on your journey, objectives, and overarching goals. Consider the urgency of each initiative. Document the quarter and year for your start and end dates in the IT Cost Optimization Workbook (see next slides).
    5. Identify the time remaining in your current budget cycle after the completion of each initiative to get a cost savings estimate for the current fiscal year. Document the number of remaining quarters (0, 1, 2, 3, or 4) in the IT Cost Optimization Workbook (see next slides).
    6. Decide on the priority of each initiative (High, Medium, or Low), and document it in the IT Cost Optimization Workbook (see next slides).
    7. Revisit the priority decision after prioritizing all your initiatives and determine which ones to include in your 12-month roadmap; consider the number of initiatives you can tackle at the same time within a 12-month period. Document your final decision (Yes or No) in the IT Cost Optimization Workbook (see next slides).

    Download the IT Cost Optimization Workbook

    InputOutput
    • Asset optimization initiatives
    • Time and priority estimates of cost optimization initiatives in the IT Cost Optimization Workbook
    MaterialsParticipants
    • Define Priority Threshold tab in the IT Cost Optimization Workbook
    • Outline Initiatives tab in the IT Cost Optimization Workbook
    • CIO/IT director
    • IT finance lead
    • IT asset manager
    • IT infrastructure manager
    • Other IT management

    Template & Example

    Understand your priority assessment

    Excel Workbook: IT Cost Optimization – Outline Initiatives Worksheet

    Refer to the example and guidelines below on how the preliminary priority assessment is assigned, for each asset optimization initiative, noting that columns Q to X are hidden automatic calculations and should not be touched:

    Understand your priority assessment

    Column ID Input Type Guidelines
    R Formula Hidden automatic calculation, no entry required. Rank of estimate cost savings (per year) in ascending order (higher cost savings implies a higher rank).
    S Formula Hidden automatic calculation, no entry required. Cost Savings Score on a scale of 1 to 3, where the top third in Cost Savings Rank are assigned a score of 1, the bottom third a score of 3, and in between a score of 2, noting that negative cost savings would imply a -1 score.
    T Formula Hidden automatic calculation, no entry required. Cost Score adds 1 to the Cost Savings Score if the underlying initiative is within the budget.
    U, V, W Formula Hidden automatic calculation, no entry required. A score on a scale of 1 to 3 based on input of columns M, N, and O, where Low or Positive Impact is assigned a score of 3, Medium or No Impact a score of 2, and High or Negative Impact a score of 1.
    X Formula Hidden automatic calculation, no entry required. The rounding of the average of columns U, V, and W, adding 1 to the result if the initiative's approval falls within your accountability (column P).
    Y Formula Hidden automatic calculation, no entry required. The sum of columns T and X, adding 3 for Reduce Unwarranted IT Spending, and 1 to Optimize Cost-to-value (column H).
    Z Formula Hidden automatic calculation, no entry required. Preliminary priority assessment based on the Define Priority Threshold worksheet (hidden, see next slide).

    Review the following fields for each initiative in the Excel Workbook as per guidelines:

    1. Navigate to the Outline Initiatives tab.
    2. Validate cost and feasibility estimates (columns I to P previously filled - steps 2.2 and 3.1) driving the Priority Score and Preliminary Priority Assessment.

    Template & Example

    Priority threshold rationale

    Excel Workbook: IT Cost Optimization – Define Priority Threshold Worksheet

    Refer to the screenshot of the Define Priority Threshold worksheet below to understand the rationale behind the priority score and priority level:

    Priority threshold rationale

    Template & Example

    Estimate your timeline

    Excel Workbook: IT Cost Optimization – Outline Initiatives Worksheet

    Refer to the example and guidelines below on how to complete timeline estimates for each asset optimization initiative:

    Estimate your timeline

    Column ID Input Type Guidelines
    AA, AC Dropdown Select the quarter(s) in which you plan to begin and complete your initiative.
    AB, AD Dropdown Select the year(s) in which you plan to begin and complete your initiative.
    AE Dropdown Select the number of remaining quarters, in the current fiscal year, after you complete the initiative (0 to 4); based on columns AA to AD.
    AF Formula Automatic calculation, no entry required. Estimate of cost savings in the current fiscal year, based on the remaining quarters after implementation. The entry in column AE is divided by 4, and the result is multiplied by the related estimated cost savings per year (entry in column L).
    AG Dropdown Select if cost savings after the implementation of the underlying initiative will be permanent or temporary.

    Complete the following fields for each initiative in the Excel Workbook as per guidelines:

    1. Navigate to the Outline Initiatives tab.
    2. Determine the appropriate quarter and year to start and complete the initiative.
    3. Identify the time remaining in your current budget cycle after the completion of the initiative.

    Template & Example

    Make your final decisions

    Excel Workbook: IT Cost Optimization – Outline Initiatives Worksheet

    Refer to the example and guidelines below on how to assign the final priority for each asset optimization initiative, and include it in your 12-month roadmap:

    Make your final decisions

    Column ID Row ID Input Type Guidelines
    AH - Dropdown Select your final priority decision after reviewing the preliminary priority assessment (column Z) and timeline estimates (columns AA to AG).
    AI - Dropdown Select whether you want to include the initiative in your 12-month roadmap (Yes or No).
    AK, AL 5 Formula Automatic calculation, no entry required. The total number of initiatives you decided to include in your 12-month roadmap; based on column AI when Yes is selected.
    AK, AL 6 Formula Automatic calculation, no entry required. Total estimated cost savings per year after the initiative's completion; based on column L when included in the 12-month roadmap (column AI when Yes is selected)
    AK, AL 7 Formula Automatic calculation, no entry required. Total estimated cost savings in the current fiscal year; based on column AF when included in the 12-month roadmap (column AI when Yes is selected)
    • Estimated cost savings per year refer to cost savings fully realized by the end of the upcoming fiscal year, following the initiatives' implementation.
    • Estimated cost savings in the current budget cycle, refer to cost savings partially realized in the current fiscal year, after the initiatives' implementation.

    Complete the following fields for each initiative in the Excel Workbook as per guidelines:

    1. Navigate to the Outline Initiatives tab.
    2. Determine the final priority of the initiative.
    3. Decide whether you want to include the initiative in your 12-month roadmap.

    3.2.2 Prioritize your vendor optimization initiatives

    1 hour

    1. Review each vendor optimization initiative to set the priority.
    2. Validate your cost and feasibility estimates and consider the automated evaluation, in the IT Cost Optimization Workbook, providing you with a preliminary priority based on your cost and feasibility estimates (see next slides).
    3. Revisit your overarching goals (step 1.4) as you will assess the time it will take you to complete your initiatives and prioritize accordingly.
    4. Determine your start and end date for each initiative based on your journey, objectives, and overarching goals. Consider the urgency of each initiative. Document the quarter and year for your start and end dates in the IT Cost Optimization Workbook (see next slides).
    5. Identify the time remaining in your current budget cycle after the completion of each initiative to get a cost savings estimate for the current fiscal year. Document the number of remaining quarters (0, 1, 2, 3, or 4) in the IT Cost Optimization Workbook (see next slides).
    6. Decide on the priority of each initiative (High, Medium, or Low), and document it in the IT Cost Optimization Workbook (see next slides).
    7. Revisit the priority decision after prioritizing all your initiatives and determine which ones to include in your 12-month roadmap; consider the number of initiatives you can tackle at the same time within a 12-month period. Document your final decision (Yes or No) in the IT Cost Optimization Workbook (see next slides).

    Download the IT Cost Optimization Workbook

    Input Output
    • Vendor optimization initiatives
    • Time and priority estimates of cost optimization initiatives in the IT Cost Optimization Workbook
    Materials Participants
    • Define Priority Threshold tab in the IT Cost Optimization Workbook
    • Outline Initiatives tab in the IT Cost Optimization Workbook
    • CIO/IT director
    • IT finance lead
    • IT vendor management lead
    • Other IT management

    Template & Example

    Understand your priority assessment

    Excel Workbook: IT Cost Optimization – Outline Initiatives Worksheet

    Refer to the example and guidelines below on how the preliminary priority assessment is assigned, for each vendor optimization initiative, noting that columns Q to X are hidden automatic calculations and should not be touched:

    Understand your priority assessment

    Column ID Input Type Guidelines
    R Formula Hidden automatic calculation, no entry required. Rank of estimate cost savings (per year) in ascending order (higher cost savings implies a higher rank).
    S Formula Hidden automatic calculation, no entry required. Cost Savings Score on a scale of 1 to 3, where the top third in Cost Savings Rank are assigned a score of 1, the bottom third a score of 3, and in between a score of 2, noting that negative cost savings would imply a -1 score.
    T Formula Hidden automatic calculation, no entry required. Cost Score adds 1 to the Cost Savings Score if the underlying initiative is within the budget.
    U, V, W Formula Hidden automatic calculation, no entry required. A score on a scale of 1 to 3 based on input of columns M, N, and O, where Low or Positive Impact is assigned a score of 3, Medium or No Impact a score of 2, and High or Negative Impact a score of 1.
    X Formula Hidden automatic calculation, no entry required. The rounding of the average of columns U, V, and W, adding 1 to the result if the initiative's approval falls within your accountability (column P).
    Y Formula Hidden automatic calculation, no entry required. The sum of columns T and X, adding 3 for Reduce Unwarranted IT Spending, and 1 to Optimize Cost-to-Value (column H).
    Z Formula Hidden automatic calculation, no entry required. Preliminary priority assessment based on the Define Priority Threshold worksheet (hidden, see next slide).

    Review the following fields for each initiative in the Excel Workbook as per guidelines:

    1. Navigate to the Outline Initiatives tab.
    2. Validate cost and feasibility estimates (columns I to P previously filled - steps 2.2 and 3.1) driving the Priority Score and Preliminary Priority Assessment.

    Template & Example

    Priority Threshold Rationale

    Excel Workbook: IT Cost Optimization – Define Priority Threshold Worksheet

    Refer to the screenshot of the Define Priority Threshold worksheet below to understand the rationale behind the Priority Score and Priority Level:

    Priority Threshold Rationale

    Template & Example

    Estimate your timeline

    Excel Workbook: IT Cost Optimization – Outline Initiatives Worksheet

    Refer to the example and guidelines below on how to complete timeline estimates for each vendor optimization initiative:

    Estimate your timeline

    Column ID Input Type Guidelines
    AA, AC Dropdown Select the quarter(s) in which you plan to begin and complete your initiative.
    AB, AD Dropdown Select the year(s) in which you plan to begin and complete your initiative.
    AE Dropdown Select the number of remaining quarters, in the current fiscal year, after you complete the initiative (0 to 4); based on columns AA to AD.
    AF Formula Automatic calculation, no entry required. Estimate of cost savings in the current fiscal year, based on the remaining quarters after implementation. The entry in column AE is divided by 4, and the result is multiplied by the related estimated cost savings per year (entry in column L).
    AG Dropdown Select if cost savings after the implementation of the underlying initiative will be Permanent or Temporary.

    Complete the following fields for each initiative in the Excel Workbook as per guidelines:

    1. Navigate to the Outline Initiatives tab.
    2. Determine the appropriate quarter and year to start and complete the initiative.
    3. Identify the time remaining in your current budget cycle after the completion of the initiative.

    Template & Example

    Make your final decisions

    Excel Workbook: IT Cost Optimization - Outline Initiatives Worksheet

    Refer to the example and guidelines below on how to assign the final priority for each vendor optimization initiative, and include it in your 12-month roadmap:

    Make your final decisions

    Column ID Row ID Input Type Guidelines
    AH - Dropdown Select your final priority decision after reviewing the preliminary priority assessment (column Z) and timeline estimates (columns AA to AG).
    AI - Dropdown Select whether you want to include the initiative in your 12-month roadmap (Yes or No).
    AK, AL 5 Formula Automatic calculation, no entry required. The total number of initiatives you decided to include in your 12-month roadmap; based on column AI when Yes is selected.
    AK, AL 6 Formula Automatic calculation, no entry required. Total estimated cost savings per year after the initiative's completion; based on column L when included in the 12-month roadmap (column AI when Yes is selected)
    AK, AL 7 Formula Automatic calculation, no entry required. Total estimated cost savings in the current fiscal year; based on column AF when included in the 12-month roadmap (column AI when Yes is selected)
    • Estimated cost savings per year refer to cost savings fully realized by the end of the upcoming fiscal year, following the initiatives' implementation.
    • Estimated cost savings in the current budget cycle, refer to cost savings partially realized in the current fiscal year, after the initiatives' implementation.

    Complete the following fields for each initiative in the Excel Workbook as per guidelines:

    1. Navigate to the Outline Initiatives tab.
    2. Determine the final priority of the initiative.
    3. Decide whether you want to include the initiative in your 12-month roadmap.

    3.2.3 Prioritize your project portfolio optimization initiatives

    1 hour

    1. Review each project portfolio optimization initiative to set the priority.
    2. Validate your cost and feasibility estimates and consider the automated evaluation, in the IT Cost Optimization Workbook, providing you with a preliminary priority based on your cost and feasibility estimates (see next slides).
    3. Revisit your overarching goals (step 1.4) as you will assess the time it will take you to complete your initiatives and prioritize accordingly.
    4. Determine your start and end date for each initiative based on your journey, objectives, and overarching goals. Consider the urgency of each initiative. Document the quarter and year for your start and end dates in the IT Cost Optimization Workbook (see next slides).
    5. Identify the time remaining in your current budget cycle after the completion of each initiative to get a cost savings estimate for the current fiscal year. Document the number of remaining quarters (0, 1, 2, 3, or 4) in the IT Cost Optimization Workbook (see next slides).
    6. Decide on the priority of each initiative (High, Medium, or Low), and document it in the IT Cost Optimization Workbook (see next slides).
    7. Revisit the priority decision after prioritizing all your initiatives and determine which ones to include in your 12-month roadmap; consider the number of initiatives you can tackle at the same time within a 12-month period. Document your final decision (Yes or No) in the IT Cost Optimization Workbook (see next slides).

    Download the IT Cost Optimization Workbook

    InputOutput
    • Project portfolio optimization initiatives
    • Time and priority estimates of cost optimization initiatives in the IT Cost Optimization Workbook
    MaterialsParticipants
    • Define Priority Threshold tab in the IT Cost Optimization Workbook
    • Outline Initiatives tab in the IT Cost Optimization Workbook
    • CIO/IT director
    • IT finance lead
    • PMO lead
    • Other IT management

    Template & Example

    Understand your priority assessment

    Excel Workbook: IT Cost Optimization - Outline Initiatives Worksheet

    Refer to the example and guidelines below on how the preliminary priority assessment is assigned, for each project portfolio optimization initiative, noting that columns Q to X are hidden automatic calculations and should not be touched:

    Understand your priority assessment

    Column ID Input Type Guidelines
    R Formula Hidden automatic calculation, no entry required. Rank of Estimate Cost Savings (per year) in ascending order (higher cost savings implies a higher rank).
    S Formula Hidden automatic calculation, no entry required. Cost Savings Score on a scale of 1 to 3, where the top third in Cost Savings Rank are assigned a score of 1, the bottom third a score of 3, and in between a score of 2, noting that negative cost savings would imply a -1 score.
    T Formula Hidden automatic calculation, no entry required. Cost Score adds 1 to the Cost Savings Score if the underlying initiative is within the budget.
    U, V, W Formula Hidden automatic calculation, no entry required. A score on a scale of 1 to 3 based on input of columns M, N, and O, where Low or Positive Impact is assigned a score of 3, Medium or No Impact a score of 2, and High or Negative Impact a score of 1.
    X Formula Hidden automatic calculation, no entry required. The rounding of the average of columns U, V, and W, adding 1 to the result if the initiative's approval falls within your accountability (column P).
    Y Formula Hidden automatic calculation, no entry required. The sum of columns T and X, adding 3 for Reduce Unwarranted IT Spending, and 1 to Optimize Cost-to-Value (column H).
    Z Formula Hidden automatic calculation, no entry required. Preliminary Priority Assessment based on the Define Priority Threshold worksheet (hidden, see next slide).

    Review the following fields for each initiative in the Excel Workbook as per guidelines:

    1. Navigate to the Outline Initiatives tab.
    2. Validate cost and feasibility estimates (columns I to P previously filled - steps 2.2 and 3.1) driving the Priority Score and Preliminary Priority Assessment.

    Template & Example

    Priority Threshold Rationale

    Excel Workbook: IT Cost Optimization - Define Priority Threshold Worksheet

    Refer to the screenshot of the Define Priority Threshold worksheet below to understand the rationale behind the Priority Score and Priority Level:

    Priority threshold rationale

    Template & Example

    Estimate your timeline

    Excel Workbook: IT Cost Optimization - Outline Initiatives Worksheet

    Refer to the example and guidelines below on how to complete timeline estimates for each project portfolio optimization initiative:

    Estimate your timeline

    Column ID Input Type Guidelines
    AA, AC Dropdown Select the quarter(s) in which you plan to begin and complete your initiative.
    AB, AD Dropdown Select the year(s) in which you plan to begin and complete your initiative.
    AE Dropdown Select the number of remaining quarters, in the current fiscal year, after you complete the initiative (0 to 4); based on columns AA to AD.
    AF Formula Automatic calculation, no entry required. Estimate of cost savings in the current fiscal year, based on the remaining quarters after implementation. The entry in column AE is divided by 4, and the result is multiplied by the related estimated cost savings per year (entry in column L).
    AG Dropdown Select if cost savings after the implementation of the underlying initiative will be Permanent or Temporary.

    Complete the following fields for each initiative in the Excel Workbook as per guidelines:

    1. Navigate to the Outline Initiatives tab.
    2. Determine the appropriate quarter and year to start and complete the initiative.
    3. Identify the time remaining in your current budget cycle after the completion of the initiative.

    Template & Example

    Make your final decisions

    Excel Workbook: IT Cost Optimization - Outline Initiatives Worksheet

    Refer to the example and guidelines below on how to assign the final priority for each project portfolio optimization initiative and include it in your 12-month roadmap:

    Make your final decisions

    Column ID Row ID Input Type Guidelines
    AH - Dropdown Select your final priority decision after reviewing the preliminary priority assessment (column Z) and timeline estimates (columns AA to AG).
    AI - Dropdown Select whether you want to include the initiative in your 12-month roadmap (Yes or No).
    AK, AL 5 Formula Automatic calculation, no entry required. The total number of initiatives you decided to include in your 12-month roadmap; based on column AI when Yes is selected.
    AK, AL 6 Formula Automatic calculation, no entry required. Total estimated cost savings per year after the initiative's completion; based on column L when included in the 12-month roadmap (column AI when Yes is selected)
    AK, AL 7 Formula Automatic calculation, no entry required. Total estimated cost savings in the current fiscal year; based on column AF when included in the 12-month roadmap (column AI when Yes is selected)
    • Estimated cost savings per year refer to cost savings fully realized by the end of the upcoming fiscal year, following the initiatives' implementation.
    • Estimated cost savings in the current budget cycle, refer to cost savings partially realized in the current fiscal year, after the initiatives' implementation.

    Complete the following fields for each initiative in the Excel Workbook as per guidelines:

    1. Navigate to the Outline Initiatives tab.
    2. Determine the final priority of the initiative.
    3. Decide whether you want to include the initiative in your 12-month roadmap.

    3.2.4 Prioritize your workforce optimization initiatives

    1 hour

    1. Review each workforce optimization initiative to set the priority.
    2. Validate your cost and feasibility estimates and consider the automated evaluation, in the IT Cost Optimization Workbook, providing you with a preliminary priority based on your cost and feasibility estimates (see next slides).
    3. Revisit your overarching goals (step 1.4) as you will assess the time it will take you to complete your initiatives and prioritize accordingly.
    4. Determine your start and end date for each initiative based on your journey, objectives, and overarching goals. Consider the urgency of each initiative. Document the quarter and year for your start and end dates in the IT Cost Optimization Workbook (see next slides).
    5. Identify the time remaining in your current budget cycle after the completion of each initiative to get a cost savings estimate for the current fiscal year. Document the number of remaining quarters (0, 1, 2, 3, or 4) in the IT Cost Optimization Workbook (see next slides).
    6. Decide on the priority of each initiative (High, Medium, or Low), and document it in the IT Cost Optimization Workbook (see next slides).
    7. Revisit the priority decision after prioritizing all your initiatives and determine which ones to include in your 12-month roadmap; consider the number of initiatives you can tackle at the same time within a 12-month period. Document your final decision (Yes or No) in the IT Cost Optimization Workbook (see next slides).

    Download the IT Cost Optimization Workbook

    InputOutput
    • Workforce optimization initiatives
    • Time and priority estimates of cost optimization initiatives in the IT Cost Optimization Workbook
    MaterialsParticipants
    • Define Priority Threshold tab in the IT Cost Optimization Workbook
    • Outline Initiatives tab in the IT Cost Optimization Workbook
    • CIO/IT director
    • IT finance lead
    • Talent management representative
    • Other IT management

    Template & Example

    Understand your priority assessment

    Excel Workbook: IT Cost Optimization - Outline Initiatives Worksheet

    Refer to the example and guidelines below on how the preliminary priority assessment is assigned, for each workforce optimization initiative, noting that columns Q to X are hidden automatic calculations and should not be touched:

    Understand your priority assessment

    Column ID Input Type Guidelines
    R Formula Hidden automatic calculation, no entry required. Rank of Estimate Cost Savings (per year) in ascending order (higher cost savings implies a higher rank).
    S Formula Hidden automatic calculation, no entry required. Cost Savings Score on a scale of 1 to 3, where the top third in Cost Savings Rank are assigned a score of 1, the bottom third a score of 3, and in between a score of 2, noting that negative cost savings would imply a -1 score.
    T Formula Hidden automatic calculation, no entry required. Cost Score adds 1 to the Cost Savings Score if the underlying initiative is within the budget.
    U, V, W Formula Hidden automatic calculation, no entry required. A score on a scale of 1 to 3 based on input of columns M, N, and O, where Low or Positive Impact is assigned a score of 3, Medium or No Impact a score of 2, and High or Negative Impact a score of 1.
    X Formula Hidden automatic calculation, no entry required. The rounding of the average of columns U, V, and W, adding 1 to the result if the initiative's approval falls within your accountability (column P).
    Y Formula Hidden automatic calculation, no entry required. The sum of columns T and X, adding 3 for Reduce Unwarranted IT Spending, and 1 to Optimize Cost-to-Value (column H).
    Z Formula Hidden automatic calculation, no entry required. Preliminary Priority Assessment based on the Define Priority Threshold worksheet (hidden, see next slide).

    Review the following fields for each initiative in the Excel Workbook as per guidelines:

    1. Navigate to the Outline Initiatives tab.
    2. Validate cost and feasibility estimates (columns I to P previously filled - steps 2.2 and 3.1) driving the Priority Score and Preliminary Priority Assessment.

    Template & Example

    Priority Threshold Rationale

    Excel Workbook: IT Cost Optimization - Define Priority Threshold

    Refer to the screenshot of the Define Priority Threshold worksheet below to understand the rationale behind the Priority Score and Priority Level:

    Priority Threshold Rationale

    Template & Example

    Estimate your timeline

    Excel Workbook: IT Cost Optimization - Outline Initiatives Worksheet

    Refer to the example and guidelines below on how to complete timeline estimates for each workforce optimization initiative:

    Estimate your timeline

    Column ID Input Type Guidelines
    AA, AC Dropdown Select the quarter(s) in which you plan to begin and complete your initiative.
    AB, AD Dropdown Select the year(s) in which you plan to begin and complete your initiative.
    AE Dropdown Select the number of remaining quarters, in the current fiscal year, after you complete the initiative (0 to 4); based on columns AA to AD.
    AF Formula Automatic calculation, no entry required. Estimate of cost savings in the current fiscal year, based on the remaining quarters after implementation. The entry in column AE is divided by 4, and the result is multiplied by the related estimated cost savings per year (entry in column L).
    AG Dropdown Select if cost savings after the implementation of the underlying initiative will be Permanent or Temporary.

    Complete the following fields for each initiative in the Excel Workbook as per guidelines:

    1. Navigate to the Outline Initiatives tab.
    2. Determine the appropriate quarter and year to start and complete the initiative.
    3. Identify the time remaining in your current budget cycle after the completion of the initiative.

    Template & Example

    Make your final decisions

    Excel Workbook: IT Cost Optimization - Outline Initiatives Worksheet

    Refer to the example and guidelines below on how to assign the final priority for each workforce optimization initiative, and include it in your 12-month roadmap:

    Make your final decisions

    Column ID Row ID Input Type Guidelines
    AH - Dropdown Select your final priority decision after reviewing the preliminary priority assessment (column Z) and timeline estimates (columns AA to AG).
    AI - Dropdown Select whether you want to include the initiative in your 12-month roadmap (Yes or No).
    AK, AL 5 Formula Automatic calculation, no entry required. The total number of initiatives you decided to include in your 12-month roadmap; based on column AI when Yes is selected.
    AK, AL 6 Formula Automatic calculation, no entry required. Total estimated cost savings per year after the initiative's completion; based on column L when included in the 12-month roadmap (column AI when Yes is selected)
    AK, AL 7 Formula Automatic calculation, no entry required. Total estimated cost savings in the current fiscal year; based on column AF when included in the 12-month roadmap (column AI when Yes is selected)
    • Estimated cost savings per year refer to cost savings fully realized by the end of the upcoming fiscal year, following the initiatives' implementation.
    • Estimated cost savings in the current budget cycle, refer to cost savings partially realized in the current fiscal year, after the initiatives' implementation.

    Complete the following fields for each initiative in the Excel Workbook as per guidelines:

    1. Navigate to the Outline Initiatives tab.
    2. Determine the final priority of the initiative.
    3. Decide whether you want to include the initiative in your 12-month roadmap.

    3.3 Develop your cost optimization roadmap

    1 hour

    1. Conduct a final evaluation of your timeline, priority decision, and initiatives you wish to include in your 12-month roadmap. Do they make sense, are they achievable, and do they all contribute individually and collectively to reaching your cost optimization goals?
    2. Review your 12-month roadmap outputs in the IT Cost Optimization Workbook (see next slides).
    3. Make adjustments to your 12-month roadmap by adding or removing initiatives as you deem necessary (step 3.2).
    4. Document your final roadmap - including initiatives and relative time frames for execution - in the IT Cost Optimization Roadmap templates provided (see slide 97). The 12-month roadmap outputs from the IT Cost Optimization Workbook (see next slide) can facilitate this task.

    Download the IT Cost Optimization Workbook

    Input Output
    • Outline Initiatives tab in the IT Cost Optimization Workbook, output from previous steps
    • IT Cost Optimization Roadmap
    Materials Participants
    • Outline Initiatives Charts tab in the IT Cost Optimization Workbook
    • Diagram Results tab in the IT Cost Optimization Workbook
    • List Results tab in the IT Cost Optimization Workbook
    • Timeline Result tab in the IT Cost Optimization Workbook
    • CIO/IT director
    • IT financial lead
    • Other IT management

    Template & Example

    Potential Cost Savings Per Year

    Excel Workbook: IT Cost Optimization - Outline Initiatives Charts Worksheet

    Refer to the example below on charts depicting different views of estimated cost savings per year across the four optimization levers (Assets, Vendors, Project Portfolio, and Workforce) that could help you in your assessment and decision making.

    Potential cost savings per year

    From the Excel Workbook, after completing your potential initiatives and filling all related entries in the Outline Initiatives tab:

    1. Navigate to the Outline Initiatives Charts tab.
    2. Review each of the charts.
    3. Navigate back to the Outline Initiatives tab to examine, drill down, and amend individual initiative entries or final decisions as you deem necessary.

    Template & Example

    12-month Roadmap Outputs

    Excel Workbook: IT Cost Optimization - Diagram Results, List Results, and Timeline Result Worksheets

    Refer to the example below depicting different roadmap output that could help you in presentations, assessment, and decision making.

    12-month Roadmap Outputs

    From the Excel Workbook:

    1. Navigate to the Diagram Results tab. This bubble diagram represent cost optimization initiatives by objective where each bubble size is determined by its estimated cost saving per year.
    2. Navigate to the List Results tab. You will find a list of the cost optimizations initiatives you've chosen to include in your roadmap and related charts.
    3. Navigate to the Timeline Result tab. This Gantt chart is a timeline view of the cost optimizations initiatives you've chosen to include in your roadmap.

    Download the IT Cost Optimization Workbook

    IT cost optimization roadmap

    Phase 4

    Communicate and Execute

    Phase 1
    Understand Your Mandate and Objectives

    Phase 2
    Outline Your Cost Optimization Initiatives

    Phase 3
    Develop Your IT Cost Optimization Roadmap

    Phase 4
    Communicate and Execute

    This phase will walk you through the following activities:

    • Cost optimization communication plan
    • Cost optimization executive presentation

    This phase involves the following participants:

    • CIO/IT director
    • IT finance lead
    • PMO lead
    • Other IT management

    Build Your IT Cost Optimization Roadmap

    4.1 Build the communication plan

    45 to 60 minutes

    1. Use the Cost Optimization Communication Plan templates and guidance on the following slides.
    2. Complete the template to develop your communication plan for your cost optimization proposal and initiatives. At a minimum, it should include:
      1. Steps for preparing and presenting your proposal to decision-makers, sponsors, and other stakeholders, including named presenters and points of contact in IT.
      2. Checkpoints for communication throughout the execution of each initiative and the cost optimization roadmap overall, including target audiences, accountabilities, modes and methods of communication, type/scope of information to be communicated at each checkpoint, and any decision/approval steps.

    Download the IT Cost Optimization Workbook

    InputOutput
    • Cost optimization roadmap
    • Completed draft of the Cost Optimization Communication Plan
    MaterialsParticipants
    • IT Cost Optimization Workbook
    • IT Cost Optimization Roadmap
    • Info-Tech's Cost Optimization Communication Plan template
    • CIO/IT director
    • IT financial lead
    • Other IT management

    Understand a communication strategy's purpose

    Put as much effort into developing your communication strategy as you would into planning and executing the cost optimization initiatives themselves. Don't skip this part.

    Your communication strategy has two major components ...

    1. A tactical plan for how and when you'll communicate with stakeholders about your proposals, activities, and progress toward meeting cost optimization goals.
    2. An executive or board presentation that outlines your final proposed cost optimization initiatives, their respective business cases, and resources/support required with the goal of gaining approval to execute.

    Your communication strategy will need to ...

    • Provide answers to the "What's in it for me?" question from all impacted stakeholders.
    • Roles, responsibilities, and accountabilities before, during, and after initiatives are completed.
    • Descriptions and high-level information about dates, deliverables, and impacts of the specific changes being made.

    You will also develop more detailed operational and project plans for each initiative. IT will use these plans to manage and track the execution of individual initiatives when the time comes.

    Template & Example

    Document the overall what and why of your planned communications

    Component Purpose Context Key Messages Intended Outcomes
    Definition Description of the topic and why you're communicating with this specific audience right now. Background information about the broader situation and how you got to where you are today. The main points you want your target audience to hear/read, absorb, and remember. What you hope you and your audience will get at the end of the communication or effort.
    Our Language
    • IT is proposing an organization-wide array of initiatives in order to reduce IT costs. We are seeking your approval and support to carry out these initiatives.
    • [Purpose]
    • The economy is in active downturn and may become a full recession.
    • IT is anticipating mandatory cost reductions and has opted to take a proactive position.
    • We used an analytical framework to look at all areas of the organization to identify and prioritize IT cost-reduction opportunities.
    • [Context]
    • IT is being proactive.
    • IT is sensitive to the business.
    • IT needs your support.
    • IT is committed to keeping you informed at every step.
    • IT wants to position the organization for rapid recovery when the economy improves.
    • [Message]
    • Buy-in, approval, and ongoing support for cost optimization initiatives proposed.
    • Update on the status of specific initiatives, including what's happened, progress, and what's coming next.
    • [Outcome]

    Template & Example

    Next, note the who, how, and when of your communication plan

    Stakeholder/Approver Initiatives Impact Format Time frame Messenger
    CEO
    • Reduce number of Minitab licenses
    • Defer hiring of new data architecture position
    • Cancel VR simulation project
    Indefinitely delays current strategic projects Monthly meeting discussion Last Wednesday of every month starting Oct. 26, FY1 CIO, IT data analytics project lead, IT VR project lead
    IT Steering Committee
    • Adjust service level framework and level assignments
    • Postpone purchases for network modernization
    • Postpone workstation/laptop upgrades for non-production functions
    • Outsource data analytics project
    Nearly all of these initiatives are enterprise-wide or affect multiple departments. Varying direct and indirect impacts will need to be independently communicated for each initiative if approved by the ITS.

    Formal presentation at quarterly ITS meetings

    Monthly progress updates via email bulletin

    Approval presentation: Oct. 31, FY1

    Quarterly updates: Jan. 31, Apr. 28, and Jul. 28, FY2

    CIO, IT service director, IT infrastructure director, IT data analytics project lead
    VP of Sales
    • Pause Salesforce view redesign project
    Delays new sales tool efficiency improvement. Meeting discussion Nov. FY1 CIO, IT Salesforce view redesign project lead
    [Name/Title/Group]
    • [Initiative]
    • [Initiative]
    [Impact statement] [Format] [Date/Period] [Name/Title]
    [Name/Title/Group]
    • [Initiative]
    • [Initiative]
    [Impact statement] [Format] [Date/Period] [Name/Title]
    [Name/Title/Group]
    • [Initiative]
    • [Initiative]
    [Impact statement] [Format] [Date/Period] [Name/Title]

    4.2 Build the executive presentation

    45-60 minutes

    1. Download Info-Tech's IT Cost Optimization Roadmap Samples and Templates.
    2. Update the content with the outputs of your cost optimization roadmap and data/graph elements from the IT Cost Optimization Workbook. Refer to your organization's standards and norms for executive-level presentations and adapt accordingly.

    Download IT Cost Optimization Roadmap Samples and Templates

    Input Output
    • IT Cost Optimization Roadmap
    • IT Cost Optimization Workbook
    • Completed draft of the IT Cost Optimization Executive Presentation
    Materials Participants
    • IT Cost Optimization Workbook
    • IT Cost Optimization Roadmap Samples and Templates
    • CIO/IT directors
    • IT financial lead
    • Other IT management

    Summary of Accomplishment

    Congratulations! You now have an IT cost optimization strategy and a communication plan.

    Throughout this blueprint, you have:

    1. Identified your IT mandate and cost optimization journey.
    2. Outlined your initiatives across the four levers (assets, vendors, project portfolio, and workforce).
    3. Put together a 12-month IT cost optimization roadmap.
    4. Developed a communication strategy and crafted an executive presentation - your initial step to communicate and discuss IT cost optimization initiatives with your key stakeholders.

    What's next?

    Communicate with your stakeholders, then follow your internal project policies and procedures to get the necessary approvals as required. Once obtained, you can start the execution and implementation of your IT cost optimization strategy.

    If you would like additional support, have our analysts guide you through other phases as part of an Info-Tech workshop.

    Contact your account representative for more information.

    workshops@infotech.com
    1-888-670-8889

    Research Contributors and Experts

    Jennifer Perrier, Principal Research Director, IT Financial Management

    Jennifer Perrier
    Principal Research Director, IT Financial Management
    Info-Tech Research Group

    Jack Hakimian, Senior Vice President, Research Development

    Jack Hakimian
    Senior Vice President, Research Development
    Info-Tech Research Group

    Graham Price, Senior Executive Counselor, Executive Services

    Graham Price
    Senior Executive Counselor, Executive Services
    Info-Tech Research Group

    Travis Duncan, Research Director, Project & Portfolio Management

    Travis Duncan
    Research Director, Project & Portfolio Management
    Info-Tech Research Group

    Dave Kish, Practice Lead, IT Financial Management

    Dave Kish
    Practice Lead, IT Financial Management
    Info-Tech Research Group

    Baird Miller, PhD, Senior Executive Advisor, Executive Services

    Baird Miller, PhD
    Senior Executive Advisor, Executive Services
    Info-Tech Research Group

    Other Research Contributors and Experts

    Monica Braun
    Research Director, IT Financial Management
    Info-Tech Research Group

    Sandi Conrad
    Principal Advisory Director, Infrastructure & Operations
    Info-Tech Research Group

    Phil Bode
    Principal Advisory Director, Vendor Management
    Info-Tech Research Group

    Donna Glidden
    Advisory Director, Vendor Management
    Info-Tech Research Group

    Barry Cousins
    Distinguished Analyst & Research Fellow
    Info-Tech Research Group

    Andrew Sharp
    Research Director, Infrastructure & Operations Practice
    Info-Tech Research Group

    Frank Sewell
    Advisory Director, Vendor Management
    Info-Tech Research Group

    Related Info-Tech Research

    Achieve IT Spend & Staffing Transparency
    Most CIOs, CFOs, and business function leaders don't enjoy a shared vocabulary when it comes to talking about technology spend. As a result, truly meaningful conversations about where and how to spend technology funds in support of business goals are rare. Enable these important conversations by transparently mapping your IT spend data against four key stakeholder views.

    Reduce Shadow IT With a Service Request Catalog
    As the business gets more innovative to solve its problems, IT finds itself in reactive mode, dealing with software bloat, managing surprise SaaS renewals, and having to integrate products that they didn't know were purchased. To solve this, IT needs to focus on service and visibility to counter Shadow IT.

    Bibliography

    "A Short Guide to Structured Cost Reduction." National Audit Office, 18 June 2010. Web.

    "IT Cost Savings: A Guide to Application Rationalization." LeanIX, 2021. Web.

    Jouravlev, Roman. "Service Financial Management: ITIL 4 Practice Guide." Axelos, 30 April 2020. Web.

    Leinwand, Paul, and Vinay Couto. "How to Cut Costs More Strategically." Harvard Business Review, March 2017. Web.

    "Role & Influence of the Technology Decision-Maker 2022." Foundry, 2022. Web.

    "State of the CIO 2022." CIO, 2022. Web.

    "The Definitive Guide to IT Cost Optimization." LeanIX, n.d. Web.

    "Understand the Principles of Cost Optimization." Google Cloud, n.d. Web.

    Build a Data Architecture Roadmap

    • Buy Link or Shortcode: {j2store}124|cart{/j2store}
    • member rating overall impact: 8.8/10 Overall Impact
    • member rating average dollars saved: $8,846 Average $ Saved
    • member rating average days saved: 23 Average Days Saved
    • Parent Category Name: Data Management
    • Parent Category Link: /data-management
    • Data architecture involves many moving pieces requiring coordination to provide greatest value from data.
    • Data architects are at the center of this turmoil and must be able to translate high-level business requirements into specific instructions for data workers using complex data models.
    • Data architects must account for the constantly growing data and application complexity, more demanding needs from the business, an ever-increasing number of data sources, and a growing need to integrate components to ensure that performance isn’t compromised.

    Our Advice

    Critical Insight

    • Data architecture needs to evolve with the changing business landscape. There are four common business drivers that put most pressure on archaic architectures. As a result, the organization’s architecture must be flexible and responsive to changing business needs.
    • Data architecture is not just about models. Viewing data architecture as just technical data modeling can lead to structurally unsound data that does not serve the business.
    • Data is used differently across the layers of an organization’s data architecture, and the capabilities needed to optimize use of data change with it. Architecting and managing data from source to warehousing to presentation requires different tactics for optimal use.

    Impact and Result

    • Have a framework in place to identify the appropriate solution for the challenge at hand. Our three-phase practical approach will help you build a custom and modernized data architecture.
      • Identify and prioritize the business drivers in which data architecture changes would create the largest overall benefit, and determine the corresponding data architecture tiers that need to be addressed.
      • Discover the best-practice trends, measure your current state, and define the targets for your data architecture tactics.
      • Build a cohesive and personalized roadmap for restructuring your data architecture. Manage your decisions and resulting changes.

    Build a Data Architecture Roadmap Research & Tools

    Start here – read the Executive Brief

    Read our concise Executive Brief to find out why your organization should optimize its data architecture as it evolves with the drivers of the business to get the most from its data.

    Besides the small introduction, subscribers and consulting clients within this management domain have access to:

    1. Prioritize your data architecture with business-driven tactics

    Identify the business drivers that necessitate data architecture improvements, then create a tactical plan for optimization.

    • Build a Business-Aligned Data Architecture Optimization Strategy – Phase 1: Prioritize Your Data Architecture With Business-Driven Tactics
    • Data Architecture Driver Pattern Identification Tool
    • Data Architecture Optimization Template

    2. Personalize your tactics to optimize your data architecture

    Analyze how you stack up to Info-Tech’s data architecture capability model to uncover your tactical plan, and discover groundbreaking data architecture trends and how you can fit them into your action plan.

    • Build a Business-Aligned Data Architecture Optimization Strategy – Phase 2: Personalize Your Tactics to Optimize Your Data Architecture
    • Data Architecture Tactical Roadmap Tool
    • Data Architecture Trends Presentation

    3. Create your tactical data architecture roadmap

    Optimize your data architecture by following tactical initiatives and managing the resulting change brought on by those optimization activities.

    • Build a Business-Aligned Data Architecture Optimization Strategy – Phase 3: Create Your Tactical Data Architecture Roadmap
    • Data Architecture Decision Template
    [infographic]

    Workshop: Build a Data Architecture Roadmap

    Workshops offer an easy way to accelerate your project. If you are unable to do the project yourself, and a Guided Implementation isn't enough, we offer low-cost delivery of our project workshops. We take you through every phase of your project and ensure that you have a roadmap in place to complete your project successfully.

    1 Identify the Drivers of the Business for Optimizing Data Architecture

    The Purpose

    Explain approach and value proposition.

    Review the common business drivers and how the organization is driving a need to optimize data architecture.

    Understand Info-Tech’s five-tier data architecture model.

    Determine the pattern of tactics that apply to the organization for optimization.

    Key Benefits Achieved

    Understanding of the current data architecture landscape.

    Priorities for tactical initiatives in the data architecture practice are identified.

    Target state for the data quality practice is defined.

    Activities

    1.1 Explain approach and value proposition.

    1.2 Review the common business drivers and how the organization is driving a need to optimize data architecture.

    1.3 Understand Info-Tech’s five-tier data architecture model.

    1.4 Determine the pattern of tactics that apply to the organization for optimization.

    Outputs

    Five-tier logical data architecture model

    Data architecture tactic plan

    2 Determine Your Tactics For Optimizing Data Architecture

    The Purpose

    Define improvement initiatives.

    Define a data architecture improvement strategy and roadmap.

    Key Benefits Achieved

    Gaps, inefficiencies, and opportunities in the data architecture practice are identified.

    Activities

    2.1 Create business unit prioritization roadmap.

    2.2 Develop subject area project scope.

    2.3 Subject area 1: data lineage analysis, root cause analysis, impact assessment, business analysis

    Outputs

    Business unit prioritization roadmap

    Subject area scope

    Data lineage diagram

    3 Create a Strategy for Data Quality Project 2

    The Purpose

    Define improvement initiatives.

    Define a data quality improvement strategy and roadmap.

    Key Benefits Achieved

    Improvement initiatives are defined.

    Improvement initiatives are evaluated and prioritized to develop an improvement strategy.

    A roadmap is defined to depict when and how to tackle the improvement initiatives.

    Activities

    3.1 Create business unit prioritization roadmap.

    3.2 Develop subject area project scope.

    3.3 Subject area 1: data lineage analysis, root cause analysis, impact assessment, business analysis.

    Outputs

    Business unit prioritization roadmap

    Subject area scope

    Data lineage diagram

    Further reading

    Build a Data Architecture Roadmap

    Optimizing data architecture requires a plan, not just a data model.

    ANALYST PERSPECTIVE

    Integral to an insight-driven enterprise is a modern and business-driven data environment.

    “As business and data landscapes change, an organization’s data architecture needs to be able to keep pace with these changes. It needs to be responsive so as to not only ensure the organization continues to operate efficiently but that it supports the overall strategic direction of the organization.

    In the dynamic marketplace of today, organizations are constantly juggling disruptive forces and are finding the need to be more proactive rather than reactive. As such, organizations are finding their data to be a source of competitive advantage where the data architecture has to be able to not only support the increasing amount, sources, and rate at which organizations are capturing and collecting data but also be able to meet and deliver on changing business needs.

    Data architecture optimization should, therefore, aid in breaking down data silos and creating a more shared and all-encompassing data environment for better empowering the business.” (Crystal Singh, Director, Research, Data and Information Practice, Info-Tech Research Group)

    Our understanding of the problem

    This Research Is Designed For:
    • Data architects or their equivalent, looking to optimize and improve the efficiency of the capture, movement and storage of data for a variety of business drivers.
    • Enterprise architects looking to improve the backbone of the holistic approach of their organization’s structure.
    This Research Will Help You:
    • Identify the business drivers that are impacted and improved by best-practice data architecture.
    • Optimize your data architecture using tactical practices to address the pressing issues of the business to drive modernization.
    • Align the organization’s data architecture with the grander enterprise architecture.
    This Research Will Also Assist:
    • CIOs concerned with costs, benefits, and the overall structure of their organizations data flow.
    • Database administrators tasked with overseeing crucial elements of the data architecture.
    This Research Will Help Them:
    • Get a handle on the current situation of data within the organization.
    • Understand how data architecture affects the operations of the data sources within the enterprise.

    Executive summary

    Situation

    • The data architecture of a modern organization involves many moving pieces requiring coordination to provide greatest value from data.
    • Data architects are at the center of this turmoil and must be able to translate high-level business requirements into specific instructions for data workers using complex data models.

    Complication

    • Data architects must account for the constantly growing data and application complexity, and more demanding needs from the business.
    • There is an ever-increasing number of data sources and a growing need to integrate components to ensure that performance isn’t compromised.
    • There isn’t always a clearly defined data architect role, yet the responsibilities must be filled to get maximum value from data.

    Resolution

    • To deal with these challenges, a data architect must have a framework in place to identify the appropriate solution for the challenge at hand.
      • Identify and prioritize the business drivers in which data architecture changes would create the largest overall benefit, and determine the corresponding data architecture tiers that need to be addressed to customize your solution.
      • Discover the best practice trends, measure your current state, and define the targets for your data architecture tactics.
      • Build a cohesive and personalized roadmap for restructuring your data architecture. Manage your decisions and resulting changes.

    Info-Tech Insight

    1. Data architecture is not just about models. Viewing data architecture as just technical data modeling can lead to a data environment that does not aptly serve or support the business. Identify the priorities of your business and adapt your data architecture to those needs.
    2. Changes to data architecture are typically driven by four common business driver patterns. Use these as a shortcut to understand how to evolve your data architecture.
    3. Data is used differently across the layers of an organization’s data architecture; therefore, the capabilities needed to optimize the use of data change with it. Architecting and managing data from source to warehousing to presentation requires different tactics for optimal use.

    Your data is the foundation of your organization’s knowledge and ability to make decisions

    Data should be at the foundation of your organization’s evolution.

    The transformational insights that executives are constantly seeking to leverage can be uncovered with a data practice that makes high quality, trustworthy information readily available to the business users who need it.

    50% Organizations that embrace data are 50% more likely to launch products and services ahead of their competitors. (Nesta, 2016)

    Whether hoping to gain a better understanding of your business or trying to become an innovator in your industry, any organization can get value from its data regardless of where you are in your journey to becoming a data-driven enterprise:

    Business Monitoring
    • Data reporting
    • Uncover inefficiencies
    • Monitor progress
    • Track inventory levels
    Business Insights
    • Data analytics
    • Expose patterns
    • Predict future trends
    Business Optimization
    • Data-based apps
    • Build apps to automate actions based on insights
    Business Transformation
    • Monetary value of data
    • Create new revenue streams
    (Journey to Data Driven Enterprise, 2015)

    As organizations seek to become more data driven, it is imperative to better manage data for its effective use

    Here comes the zettabyte era.

    A zettabyte is a billion terabytes. Organizations today need to measure their data size in zettabytes, a challenge that is only compounded by the speed at which the data is expected to move.

    Arriving at the understanding that data can be the driving force of your organization is just the first step. The reality is that the true hurdles to overcome are in facing the challenges of today’s data landscape.

    Challenges of The Modern Data Landscape
    Data at rest Data movement
    Greater amounts Different types Uncertain quality Faster rates Higher complexity

    “The data environment is very chaotic nowadays. Legacy applications, data sprawl – organizations are grappling with what their data landscape looks like. Where are our data assets that we need to use?” (Andrew Johnston, Independent Consultant)

    Solution

    Well-defined and structured data management practices are the best way to mitigate the limitations that derive from these challenges and leverage the most possible value from your data.

    Refer to Info-Tech’s capstone Create a Plan For Establishing a Business-Aligned Data Management Practice blueprint to understand data quality in the context of data disciplines and methods for improving your data management capabilities.

    Data architecture is an integral aspect of data management

    Data Architecture

    The set of rules, policies, standards, and models that govern and define the type of data collected and how it is used, stored, managed, and integrated within the organization and its database systems.

    In general, the primary objective of data architecture is the standardization of data for the benefit of the organization.

    54% of leading “analytics-driven” enterprises site data architecture as a required skill for data analytics initiatives. (Maynard 2015)

    MYTH

    Data architecture is purely a model of the technical requirements of your data systems.

    REALITY

    Data architecture is largely dependent on a human element. It can be viewed as “the bridge between defining strategy and its implementation”. (Erwin 2016)

    Functions

    A strong data architecture should:

    • Define, visualize, and communicate data strategy to various stakeholders.
    • Craft a data delivery environment.
    • Ensure high data quality.
    • Provide a roadmap for continuous improvement.

    Business value

    A strong data architecture will help you:

    • Align data processes with business strategy and the overall holistic enterprise architecture.
    • Enable efficient flow of data with a stronger focus on quality and accessibility.
    • Reduce the total cost of data ownership.

    Data architects must maintain a comprehensive view of the organization’s rapidly proliferating data

    The data architect:
    • Acts as a “translator” between the business and data workers to communicate data and technology requirements.
    • Facilitates the creation of the data strategy.
    • Manages the enterprise data model.
    • Has a greater knowledge of operational and analytical data use cases.
    • Recommends data management policies and standards, and maintains data management artifacts.
    • Reviews project solution architectures and identifies cross impacts across the data lifecycle.
    • Is a hands-on expert in data management and warehousing technologies.
    • Is not necessarily it’s own designated position, but a role that can be completed by a variety of IT professionals.

    Data architects bridge the gap between strategic and technical requirements:

    Visualization centering the 'Data Architect' as the bridge between 'Data Workers', 'Business', and 'Data & Applications'.

    “Fundamentally, the role of a data architect is to understand the data in an organization at a reasonable level of abstraction.” (Andrew Johnston, Independent Consultant)

    Many are experiencing the pains of poor data architecture, but leading organizations are proactively tackling these issues

    Outdated and archaic systems and processes limit the ability to access data in a timely and efficient manner, ultimately diminishing the value your data should bring.

    59%

    of firms believe their legacy storage systems require too much processing to meet today’s business needs. (Attivio, Survey Big Data decision Makers, 2016)

    48%

    of companies experience pains from being reliant on “manual methods and trial and error when preparing data.” (Attivio, Survey Big Data decision Makers, 2016)

    44%
    +
    22%

    44% of firms said preparing data was their top hurdle for analytics, with 22% citing problems in accessing data. (Data Virtualization blog, Data Movement Killed the BI Star, 2016)

    Intuitive organizations who have recognized these shortcomings have already begun the transition to modernized and optimized systems and processes.

    28%

    of survey respondents say they plan to replace “data management and architecture because it cannot handle the requirements of big data.” (Informatica, Digital Transformation: Is Your Data Management Ready, 2016)

    50%

    Of enterprises plan to replace their data warehouse systems and analytical tools in the next few years. (TDWI, End of the Data Warehouse as we know it, 2017)

    Leading organizations are attacking data architecture problems … you will be left behind if you do not start now!

    Once on your path to redesigning your data architecture, neglecting the strategic elements may leave you ineffective

    Focusing on only data models without the required data architecture guidance can cause harmful symptoms in your IT department, which will lead to organization-wide problems.

    IT Symptoms Due to Ineffective Data Architecture

    Poor Data Quality

    • Inconsistent, duplicate, missing, incomplete, incorrect, unstandardized, out of date, and mistake-riddled data can plague your systems.

    Poor Accessibility

    • Delays in accessing data.
    • Limits on who can access data.
    • Limited access to data remotely.

    Strategic Disconnect

    • Disconnect between owner and consumer of data.
    • Solutions address narrow scope problems.
    • System barriers between departments.
    Leads to Poor Organizational Conditions

    Inaccurate Insights

    • Inconsistent and/or erroneous operational and management reports.
    • Ineffective cross-departmental use of analytics.

    Ineffective Decision Making

    • Slow flow of information to executive decision makers.
    • Inconsistent interpretation of data or reports.

    Inefficient Operations

    • Limits to automated functionality.
    • Increased divisions within organization.
    • Regulatory compliance violations.
    You need a solution that will prevent the pains.

    Follow Info-Tech’s methodology to optimize data architecture to meet the business needs

    The following is a summary of Info-Tech’s methodology:

    1

    1. Prioritize your core business objectives and identify your business driver.
    2. Learn how business drivers apply to specific tiers of Info-Tech’s five-tier data architecture model.
    3. Determine the appropriate tactical pattern that addresses your most important requirements.
    Visualization of the process described on the left: Business drivers applying to Info-Tech's five-tier data architecture, then determining tactical patterns, and eventually setting targets of your desired optimized state.

    2

    1. Select the areas of the five-tier architecture to focus on.
    2. Measure current state.
    3. Set the targets of your desired optimized state.

    3

    1. Roadmap your tactics.
    2. Manage and communicate change.
    A roadmap leading to communication.

    Info-Tech will get you to your optimized state faster by focusing on the important business issues

    First Things First

    1. Info-Tech’s methodology helps you to prioritize and establish the core strategic objectives behind your goal of modernizing data architecture. This will narrow your focus to the appropriate areas of your current data systems and processes that require the most attention.

    Info-Tech has identified these four common drivers that lead to the need to optimize your data architecture.

    • Becoming More Data Driven
    • Regulations and Compliance
    • Mergers and Acquisitions
    • New Functionality or Business Rule

    These different core objectives underline the motivation to optimize data architecture, and will determine your overall approach.

    Use the five-tier architecture to provide a consumable view of your data architecture

    Every organization’s data system requires a unique design and an assortment of applications and storage units to fit their business needs. Therefore, it is difficult to paint a picture of an ideal model that has universal applications. However, when data architecture is broken down in terms of layers or tiers, there exists a general structure that is seen in all data systems.

    Info-Tech's Five Tier Data Architecture. The five tiers being 'Sources' which includes 'Apps', 'Excel and other documents', and 'Access database(s)'; 'Integration and Translation' the 'Movement and transformation of data'; 'Warehousing' which includes 'Data Lakes & Warehouse(s) (Raw Data)'; 'Analytics' which includes 'Data Marts', 'Data Cube', 'Flat Files', and 'BI Tools'; and 'Presentation' which includes 'Reports' and 'Dashboards'.

    Thinking of your data systems and processes in this framework will allow you to see how different elements of the architecture relate to specific business operations.

    1. This blueprint will demonstrate how the business driver behind your redesign requires you to address specific layers of the five-tier data architecture.
    1. Once you’ve aligned your business driver to the appropriate data tiers, this blueprint will provide you with the best practice tactics you should apply to achieve an optimized data architecture.

    Use the five-tier architecture to prioritize tactics to improve your data architecture in line with your pattern

    Info-Tech’s Data Architecture Capability Model
    Info-Tech’s Data Architecture Capability Model featuring the five-tier architecture listing 'Core Capabilities' and 'Advanced Capabilities' within each tier, and a list of 'Cross Capabilities' which apply to all tiers.
    1. Based on your business driver, the relevant data tiers, and your organization’s own specific requirements you will need to establish the appropriate data architecture capabilities.
    2. This blueprint will help you measure how you are currently performing in these capabilities…
    3. And help you define and set targets so you can reach your optimized state.
    1. Once completed, these steps will be provided with the information you will need to create a comprehensive roadmap.
    2. Lastly, this blueprint will provide you with the tools to communicate this plan across your organization and offer change management guidelines to ensure successful adoption.
    Info-Tech Insight

    Optimizing data architecture requires a tactical approach, not a passive approach.

    The demanding task of optimization requires the ability to heavily prioritize. After you have identified why, determine how using our pre-built roadmap to address the four common drivers.

    Do not forget: data architecture is not a standalone concept; it fits into the more holistic design of enterprise architecture

    Data Architecture in Alignment

    Data architecture can not be designed to simply address the focus of data specialists or even the IT department.

    It must act as a key component in the all encompassing enterprise architecture and reflect the strategy and design of the entire business.

    Data architecture collaborates with application architecture in the delivery of effective information systems, and informs technology architecture on data related infrastructure requirements/considerations

    Please refer to the following blueprints to see the full picture of enterprise architecture:

    A diagram titled 'Enterprise Architecture' with multiple forms of architecture interacting with each other. At the top is 'Business Architecture' which feeds into 'Data Architecture' and 'Application Architecture' which feed into each other, and influence 'Infrastructure Architecture' and 'Security Architecture'.
    Adapted from TOGAF
    Refer to Phase C of TOGAF and Bizbok for references to the components of business architecture that are used in data architecture.

    Info-Tech’s data architecture optimization methodology helped a monetary authority fulfill strict regulatory pressures

    CASE STUDY

    Industry: Financial
    Source: Info-Tech Consulting
    Symbol for 'Monetary Authority Case Study'. Look for this symbol as you walk through the blueprint for details on how Info-Tech Consulting assisted this monetary authority.

    Situation: Strong external pressures required the monetary authority to update and optimize its data architecture.

    The monetary authority is responsible for oversight of the financial situation of a country that takes in revenue from foreign incorporation. Due to increased pressure from international regulatory bodies, the monetary authority became responsible for generating multiple different types of beneficial ownership reports based on corporation ownership data within 24 hours of a request.

    A stale and inefficient data architecture prevented the monetary authority from fulfilling external pressures.

    Normally, the process to generate and provide beneficial ownership reports took a week or more. This was due to multiple points of stale data architecture, including a dependence on outdated legacy systems and a broken process for gathering the required data from a mix of paper and electronic sources.

    Provide a structured approach to solving the problem

    Info-Tech helped the monetary authority identify the business need that resulted from regulatory pressures, the challenges that needed to be overcome, and actionable tactics for addressing the needs.

    Info-Tech’s methodology was followed to optimize the areas of data architecture that address the business driver.

    • External Requirements
    • Business Driver
        Diagnose Data Architecture Problems
      • Outdated architecture (paper, legacy systems)
      • Stale data from other agencies
      • Incomplete data
          Data Architecture Optimization Tactics
        1. Optimized Source Databases
        2. Improved Integration
        3. Data Warehouse Optimization
        4. Data Marts for Reports
        5. Report Delivery Efficiency

    As you walk through this blueprint, watch for additional case studies that walk through the details of how Info-Tech helped this monetary authority.

    This blueprint’s three-step process will help you optimize data architecture in your organization

    Phase 1
    Prioritize Your Data Architecture With Business-Driven Tactics
    Phase 2
    Personalize Your Tactics to Optimize Your Data Architecture
    Phase 3
    Create Your Tactical Data Architecture Roadmap
    Step 1: Identify Your Business Driver for Optimizing Data Architecture
    • Learn about what data architecture is and how it must evolve with the drivers of the business.
    • Determine the business driver that your organization is currently experiencing.
    • Data Architecture Driver Pattern Identification Tool

    Step 2: Determine Actionable Tactics to Optimize Data Architecture
    • Create your data architecture optimization plan to determine the high-level tactics you need to follow.
    • Data Architecture Optimization Template

    Step 1: Measure Your Data Architecture Capabilities
    • Determine where you currently stand in the data architecture capabilities across the five-tier data architecture.
    • Data Architecture Tactical Roadmap Tool

    Step 2: Set a Target for Data Architecture Capabilities
    • Identify your targets for the data architecture capabilities.
    • Data Architecture Tactical Roadmap Tool

    Step 3: Identify the Tactics that Apply to Your Organization
    • Understand the trends in the field of data architecture and how they can help to optimize your environment.
    • Data Architecture Trends Presentation

    Step 1: Personalize Your Data Architecture Roadmap
    • Personalize the tactics across the tiers that apply to you to build your personalized roadmap.
    • Data Architecture Tactical Roadmap Tool

    Step 2: Manage Your Data Architecture Decisions and the Resulting Changes
    • Document the changes in the organization’s data architecture.
    • Data architecture involves change management – learn how data architects should support change management in the organization.
    • Data Architecture Decision Template

    Use these icons to help direct you as you navigate this research

    Use these icons to help guide you through each step of the blueprint and direct you to content related to the recommended activities.

    A small monochrome icon of a wrench and screwdriver creating an X.

    This icon denotes a slide where a supporting Info-Tech tool or template will help you perform the activity or step associated with the slide. Refer to the supporting tool or template to get the best results and proceed to the next step of the project.

    A small monochrome icon depicting a person in front of a blank slide.

    This icon denotes a slide with an associated activity. The activity can be performed either as part of your project or with the support of Info-Tech team members, who will come onsite to facilitate a workshop for your organization.

    Info-Tech offers various levels of support to best suit your needs

    DIY Toolkit

    Guided Implementation

    Workshop

    Consulting

    "Our team has already made this critical project a priority, and we have the time and capability, but some guidance along the way would be helpful." "Our team knows that we need to fix a process, but we need assistance to determine where to focus. Some check-ins along the way would help keep us on track." "We need to hit the ground running and get this project kicked off immediately. Our team has the ability to take this over once we get a framework and strategy in place." "Our team does not have the time or the knowledge to take this project on. We need assistance through the entirety of this project."

    Diagnostics and consistent frameworks used throughout all four options

    Build a Business-Aligned Data Architecture Optimization Strategy – project overview

    PHASE 1
    Prioritize Your Data Architecture With Business-Driven Tactics
    PHASE 2
    Personalize Your Tactics to Optimize Your Data Architecture
    PHASE 3
    Create Your Tactical Data Architecture Roadmap
    Supporting Tool icon

    Best-Practice Toolkit

    1.1 Identify Your Business Driver for Optimizing Data Architecture

    1.2 Determine Actionable Tactics to Optimize Data Architecture

    2.1 Measure Your Data Architecture Capabilities

    2.2 Set a Target for Data Architecture Capabilities

    2.3 Identify the Tactics that Apply to Your Organization

    3.1 Personalize Your Data Architecture Roadmap

    3.2 Manage Your Data Architecture Decisions and the Resulting Changes

    Guided Implementations

    • Understand what data architecture is, how it aligns with enterprise architecture, and how data architects support the needs of the business.
    • Identify the business drivers that necessitate the optimization of the organization’s data architecture.
    • Create a tactical plan to optimize data architecture across Info-Tech’s five-tier logical data architecture model.
    • Understand Info-Tech’s tactical data architecture capability model and measure the current state of these capabilities at the organization.
    • Determine the target state of data architecture capabilities.
    • Understand the trends in the field of data architecture and identify how they can fit into your environment.
    • Use the results of the data architecture capability gap assessment to determine the priority of activities to populate your personalized data architecture optimization roadmap.
    • Understand how to manage change as a data architect or equivalent.
    Associated Activity icon

    Onsite Workshop

    Module 1:
    Identify the Drivers of the Business for Optimizing Data Architecture
    Module 2:
    Create a Tactical Plan for Optimizing Data Architecture
    Module 3:
    Create a Personalized Roadmap for Data Architecture Activities

    Workshop overview

    Contact your account representative or email Workshops@InfoTech.com for more information.

    Preparation

    Workshop Day 1

    Workshop Day 2

    Workshop Day 3

    Workshop Day 4

    Workshop Day 5

    Organize and Plan Workshop Identify the Drivers of the Business for Optimizing Data Architecture Determine the Tactics For Optimizing Data Architecture Create Your Roadmap of Optimization Activities Create Your Personalized Roadmap Create a Plan for Change Management

    Morning Activities

    • Finalize workshop itinerary and scope.
    • Identify workshop participants.
    • Gather strategic documentation.
    • Engage necessary stakeholders.
    • Book interviews.
    • 1.1 Explain approach and value proposition.
    • 1.2 Review the common business drivers and how the organization is driving a need to optimize data architecture.
    • 2.1 Create your data architecture optimization plan.
    • 2.2 Interview key business stakeholders for input on business drivers for data architecture.
    • 3.1 Align with the enterprise architecture by interviewing the enterprise architect for input on the data architecture optimization roadmap.
    • 4.1 As a group, determine the roadmap activities that are applicable to your organization and brainstorm applicable initiatives.
    • 5.1 Use the Data Architecture Decision Documentation Template to document key decisions and updates.

    Afternoon Activities

    • 1.3 Understand Info-Tech’s Five-Tier Data Architecture.
    • 1.4 Determine the pattern of tactics that apply to the organization for optimization.
    • 2.3 With input from the business and enterprise architect, determine the current data architecture capabilities.
    • 3.3 With input from the business and enterprise architect, determine the target data architecture capabilities.
    • 4.2 Determine the timing and effort of the roadmap activities.
    • 5.2 Review best practices for change management.
    • 5.3 Present roadmap and findings to the business stakeholders and enterprise architect.

    Deliverables

    • Workshop Itinerary
    • Workshop Participant List
    1. Five-Tier Logical Data Architecture Model
    2. Data Architecture Tactic Plan
    1. Five-Tier Data Architecture Capability Model
    1. Data Architecture Tactical Roadmap
    1. Data Architecture Tactical Roadmap
    1. Data Architecture Decision Template

    Build a Business-Aligned Data Architecture Optimization Strategy

    PHASE 1

    Prioritize Your Data Architecture With Business-Driven Tactics

    Phase 1 outline

    Associated Activity icon Call 1-888-670-8889 or email GuidedImplementations@InfoTech.com for more information.

    Complete these steps on your own, or call us to complete a guided implementation. A guided implementation is a series of 2-3 advisory calls that help you execute each phase of a project. They are included in most advisory memberships.

    Guided Implementation 1: Prioritize Your Data Architecture With Business-Driven Tactics

    Proposed Time to Completion: 2 weeks
    Step 1.1: Identify Your Business Driver for Optimizing Data Architecture Step 1.2: Determine Actionable Tactics to Optimize Data Architecture
    Start with an analyst kick-off call:
    • Understand what data architecture is, what it is not, and how it fits into the broader enterprise architecture program.
    • Determine the drivers that fuel the need for data architecture optimization.
    Review findings with analyst:
    • Understand the Five-Tier Data Architecture Model and how the drivers of the business inform your priorities across this logical model of data architecture.
    Then complete these activities…
    • Complete the Data Architecture Driver Pattern Identification Tool.
    Then complete these activities…
    • Create a tactical data architecture optimization plan based on the business driver input.
    With these tools & templates:
    • Data Architecture Driver Pattern Identification Tool
    With these tools & templates:
    • Data Architecture Optimization Template

    Phase 1 Results & Insights

    • Data Architecture is not just about data models. The approach that Phase 1 guides you through will help to not only plan where you need to focus your efforts as a data architect (or equivalent) but also give you guidance in how you should go about optimizing the holistic data architecture environment based on the drivers of the business.

    Phase 1 will help you create a strategy to optimize your data architecture using actionable tactics

    In this phase, you will determine your focus for optimizing your data architecture based on the business drivers that are commonly felt by most organizations.

    1. Identify the business drivers that necessitate data architecture optimization efforts.
    2. Understand Info-Tech’s Five-Tier Data Architecture, a logical architecture model that will help you prioritize tactics for optimizing your data architecture environment.
    3. Identify tactics for optimizing the organization’s data architecture across the five tiers.

    “To stay competitive, we need to become more data-driven. Compliance pressures are becoming more demanding. We need to add a new functionality.”

    Info-Tech’s Five-Tier Data Architecture:

    1. Data Sources
    2. Data Integration and Translation
    3. Data Warehousing
    4. Data Analytics
    5. Data Presentation

    Tactical plan for Data Architecture Optimization

    Phase 1, Step 1: Identify Your Business Driver for Optimizing Data Architecture

    PHASE 1

    1.1 1.2
    Identify Your Business Driver for Optimizing Data Architecture Determine Actionable Tactics to Optimize Data Architecture

    This step will walk you through the following activities:

    • Understand how data architecture fits into the organization’s larger enterprise architecture.
    • Understand what data architecture is and how it should be driven by the business.
    • Identify the driver that is creating a need for data architecture optimization.

    This step involves the following participants:

    • Data Architect
    • Enterprise Architect

    Outcomes of this step

    • A starting point for the many responsibilities of the data architect role. Balancing business and technical requirements can be challenging, and to do so you need to first understand what is driving the need for data architecture improvements.
    • Holistic understanding of the organization’s architecture environment, including enterprise, application, data, and technology architectures and how they interact.

    Data architecture involves planning, communication, and understanding of technology

    Data Architecture

    A description of the structure and interaction of the enterprise’s major types and sources of data, logical data assets, physical data assets, and data management resources (TOGAF 9).

    The subject area of data management that defines the data needs of the enterprise and designs the master blueprints to meet those needs (DAMA DMBOK, 2009).

    IBM (2007) defines data architecture as the design of systems and applications that facilitate data availability and distribution across the enterprise.

    Definitions vary slightly across major architecture and management frameworks.

    However, there is a general consensus that data architecture provides organizations with:

    • Alignment
    • Planning
    • Road mapping
    • Change management
    • A guide for the organization’s data management program

    Data architecture must be based on business goals and objectives; developed within the technical strategies, constraints, and opportunities of the organization in support of providing a foundation for data management.

    Current Data Management
    • Alignment
    • Planning
    • Road mapping
    Goal for Data Management

    Info-Tech Insight

    Data Architecture is not just data models. Data architects must understand the needs of the business, as well as the existing people and processes that already exist in the organization to effectively perform their job.

    Review how data architecture fits into the broader architectural context

    A flow diagram starting with 'Business Processes/Activities' to 'Business Architecture' which through a process of 'Integration' flows to 'Data Architecture' and 'Application Architecture', the latter of which also flows into to the former, and they both flow into 'Technology Architecture' which includes 'Infrastructure' and 'Security'.

    Each layer of architecture informs the next. In other words, each layer has components that execute processes and offer services to the next layer. For example, data architecture can be broken down into more granular activities and processes that inform how the organization’s technology architecture should be arranged.

    Data does not exist on its own. It is informed by business architecture and used by other architectural domains to deliver systems, IT services, and to support business processes. As you build your practice, you must consider how data fits within the broader architectural framework.

    The Zachman Framework is a widely used EA framework; within it, data is identified as the first domain.

    The framework aims to standardize artifacts (work-products) within each architectural domain, provides a cohesive view of the scope of EA and clearly delineates data components. Use the framework to ensure that your target DA practice is aligned to other domains within the EA framework.

    'The Zachman Framework for Enterprise Architecture: The Enterprise Ontology', a complicated framework with top and bottom column headers and left and right row headers. Along the top are 'Classification Names': 'What', 'How', 'Where', 'Who', 'When', and 'Why'. Along the bottom are 'Enterprise Names': 'Inventory Sets', 'Process Flows', 'Distribution Networks', 'Responsibility Assignments', 'Timing Cycles', and 'Motivation Intentions'. Along the left are 'Audience Perspectives': 'Executive Perspective', 'Business Mgmt. Perspective', 'Architect Perspective', 'Engineer Perspective', 'Technician Perspective', and 'Enterprise Perspective'. Along the right are 'Model Names': 'Scope Contexts', 'Business Concepts', 'System Logic', 'Technology Physics', 'Tool Components', and 'Operations Instances'.
    (Source: Zachman International)

    Data architects operate in alignment with the other various architecture groups

    Data architects operate in alignment with the other various architecture groups, with coordination from the enterprise architect.

    Enterprise Architect
    The enterprise architect provides thought leadership and direction to domain architects.

    They also maintain architectural standards across all the architectural domains and serve as a lead project solution architect on the most critical assignments.

    • Business Architect
      A business subject matter expert who works with the line-of-business team to assist in business planning through capability-based planning.
    • Security Architect
      Plays a pivotal role in formulating the security strategy of the organization, working with the business and CISO/security manager. Recommends and maintains security standards, policies, and best practices.
    • Infrastructure Architect
      Recommends and maintains standards across the compute, storage, and network layers of the organization. Reviews project solution architectures to ensure compliance with infrastructure standards, regulations, and target state blueprints.
    • Application Architect
      Manages the business effectiveness, satisfaction, and maintainability of the application portfolio. Conduct application architecture assessments to document expected quality attribute standards, identify hotspots, and recommend best practices.
    • Data Architect
      Facilitates the creation of data strategy and has a greater understanding of operational and analytical data use cases. Manages the enterprise data model which includes all the three layers of modelling - conceptual, logical, and physical. Recommends data management policies and standards, and maintains data management artefacts. Reviews project solution architectures and identifies cross impacts across the data lifecycle.

    As a data architect, you must maintain balance between the technical and the business requirements

    The data architect role is integral to connecting the long-term goals of the business with how the organization plans to manage its data for optimal use.

    Data architects need to have a deep experience in data management, data warehousing, and analytics technologies. At a high level, the data architect plans and implements an organization’s data, reporting, and analytics roadmap.

    Some of the role’s primary duties and responsibilities include:

    1. Data modeling
    2. Reviewing existing data architecture
    3. Benchmark and improve database performance
    4. Fine tune database and SQL queries
    5. Lead on ETL activities
    6. Validate data integrity across all platforms
    7. Manage underlying framework for data presentation layer
    8. Ensure compliance with proper reporting to bureaus and partners
    9. Advise management on data solutions

    Data architects bridge the gap between strategic and technical requirements:

    Visualization centering the 'Data Architect' as the bridge between 'Data Workers', 'Business', and 'Data & Applications'.

    “Fundamentally, the role of a data architect is to understand the data in an organization at a reasonable level of abstraction.” (Andrew Johnston, Independent Consultant)

    Info-Tech Insight

    The data architect role is not always clear cut. Many organizations do not have a dedicated data architect resource, and may not need one. However, the duties and responsibilities of the data architect must be carried out to some degree by a combination of resources as appropriate to the organization’s size and environment.

    Understand the role of a data architect to ensure that essential responsibilities are covered in the organization

    A database administrator (DBA) is not a data architect, and data architecture is not something you buy from an enterprise application vendor.

    Data Architect Role Description

    • The data architect must develop (along with the business) a short-term and long-term vision for the enterprise’s data architecture.
    • They must be able to create processes for governing the identification, collection, and use of accurate and valid metadata, as well as for tracking data quality, completeness, and redundancy.
    • They need to create strategies for data security, backup, disaster recovery, business continuity, and archiving, and ensure regulatory compliance.

    Skills Necessary

    • Hands-on experience with data architecting and management, data mining, and large-scale data modeling.
    • Strong understanding of relational and non-relational data structures, theories, principles, and practices.
    • Strong familiarity with metadata management.
    • Knowledge of data privacy practices and laws.

    Define Policies, Processes, and Priorities

    • Policies
      • Boundaries of the data architecture.
      • Data architecture standards.
      • Data architecture security.
      • Responsibility of ownership for the data architecture and data repositories.
      • Responsibility for data architecture governance.
    • Processes
      • Data architecture communication.
      • Data architecture change management.
      • Data architecture governance.
      • Policy compliance monitoring.
    • Priorities
      • Align architecture efforts with business priorities.
      • Close technology gaps to meet service level agreements (SLAs).
      • Determine impacts on current or future projects.

    See Info-Tech’s Data Architect job description for a comprehensive description of the data architect role.

    Leverage data architecture frameworks to understand how the role fits into the greater Enterprise Architecture framework

    Enterprise data architectures are available from industry consortiums such as The Open Group (TOGAF®), and open source initiatives such as MIKE2.0.

    Logo for The Open Group.

    The Open Group TOGAF enterprise architecture model is a detailed framework of models, methods, and supporting tools to create an enterprise-level architecture.

    • TOGAF was first developed in 1995 and was based on the Technical Architecture Framework for Information Management (TAFIM) developed by the US Department of Defense.
    • TOGAF includes application, data, and infrastructure architecture domains providing enterprise-level, product-neutral architecture principles, policies, methods, and models.
    • As a member of The Open Group, it is possible to participate in ongoing TOGAF development initiatives.

    The wide adoption of TOGAF has resulted in the mapping of it to several other industry standards including CoBIT and ITIL.

    Logo for MIKE2.0.

    MIKE2.0 (Method for an Integrated Knowledge Environment), is an open source method for enterprise information management providing a framework for information development.

    • SAFE (Strategic Architecture for the Federated Enterprise) provides the technology solution framework for MIKE2.0
    • SAFE includes application, presentation, information, data, Infrastructure, and metadata architecture domains.

    Info-Tech Best Practice

    If an enterprise-level IT architecture is your goal, TOGAF is likely a better model. However, if you are an information and knowledge-based business then MIKE2.0 may be more relevant to your business.

    The data architect must identify what drives the need for data from the business to create a business-driven architecture

    As the business landscape evolves, new needs arise. An organization may undergo new compliance requirements, or look to improve their customer intimacy, which could require a new functionality from an application and its associated database.

    There are four common scenarios that lead to an organization’s need to optimize its data architecture and these scenarios all present unique challenges for a data architect:

    1. Becoming More Data Driven As organizations are looking to get more out of their data, there is a push for more accurate and timely data from applications. Data-driven decision making requires verifiable data from trustworthy sources. Result: Replace decisions made on gut or intuition with real and empirical data - make more informed and data-driven decisions.
    2. New Functionality or Business Rule In order to succeed as business landscapes change, organizations find themselves innovating on products or services and the way they do things. Changes in business rules, product or service offering, and new functionalities can subsequently demand more from the existing data architecture. Result: Prepare yourself to successfully launch new business initiatives with an architecture that supports business needs.
    3. Mergers and Acquisitions If an organization has recently acquired, been acquired, or is merging with another, the technological implications require careful planning to ensure a seamless fit. Application consolidation, retirement, data transfer, and integration points are crucial. Result: Leverage opportunities to incorporate and consolidate new synergistic assets to realize the ROI.
    4. Risk and Compliance Data in highly regulated organizations needs to be kept safe and secure. Architectural decisions around data impact the level of compliance within the organization. Result: Avoid the fear of data audits, regulatory violations, and privacy breaches.

    Info-Tech Best Practice

    These are not the only reasons why data architects need to optimize the organization’s data architecture. These are only four of the most common scenarios, however, other business needs can be addressed using the same concept as these four common scenarios.

    Use the Data Architecture Driver tool to identify your focus for data architecture

    Supporting Tool icon 1.1 Data Architecture Driver Pattern Identification Tool

    Follow Info-Tech’s process of first analyzing the needs of the business, then determining how best to architect your data based on these drivers. Data architecture needs to be able to rapidly evolve to support the strategic goals of the business, and the Data Architecture Driver Pattern Identification Tool will help you to prioritize your efforts to best do this.

    Tab 2. Driver Identification

    Objective: Objectively assess the most pressing business drivers.

    Screenshot of the Data Architecture Driver Pattern Identification Tool, tab 2.

    Tab 3. Tactic Pattern Plan, Section 1

    Purpose: Review your business drivers that require architectural changes in your environment.

    Screenshot of the Data Architecture Driver Pattern Identification Tool, tab 3, section 1.

    Tab 3. Tactic Pattern Plan, Section 2

    Purpose: Determine a list of tactics that will help you address the business drivers.

    Screenshot of the Data Architecture Driver Pattern Identification Tool, tab 3, section 2.

    Step
    • Evaluate business drivers to determine the data architecture optimization priorities and tactics.
    Step
    • Understand how each business driver relates to data architecture and how each driver gives rise to a specific pattern across the five-tier data architecture.
    Step
    • Review the list of high-level tactics presented to optimize your data architecture across the five tier architecture.

    Identify the drivers for improving your data architecture

    Associated Activity icon 1.1.1 1 hour

    INPUT: Data Architecture Driver tool assessment prompts.

    OUTPUT: Identified business driver that applies to your organization.

    Materials: Data Architecture Driver Pattern Identification Tool

    Participants: Data architect, Enterprise architect

    Instructions

    In Tab 2. Driver Identification of the Data Architecture Driver Pattern Identification Tool, assess the degree to which the organization is feeling the pains of the four most common business drivers:

    1. Is there a present or growing need for the business to be making data-driven decisions?
    2. Does the business want to explore a new functionality and hence require a new application?
    3. Is your organization acquiring or merging with another entity?
    4. Is your organization’s regulatory environment quick to change and require stricter reporting?

    Data architecture improvements need to be driven by business need.

    Screenshot of the Data Architecture Driver Pattern Identification Tool, tab 2 Driver Identification.
    Tab 2. Driver Identification

    “As a data architect, you have to understand the functional requirements, the non-functional requirements, then you need to make a solution for those requirements. There can be multiple solutions and multiple purposes. (Andrew Johnston, Independent Consultant)

    Interview the business to get clarity on business objectives and drivers

    Associated Activity icon 1.1.2 1 hour per interview

    INPUT: Sample questions targeting the activities, challenges, and opportunities of each business unit

    OUTPUT: Sample questions targeting the activities, challenges, and opportunities of each business unit

    Materials: Data Architecture Driver Pattern Identification Tool

    Participants: Data architect, Business representatives, IT representatives

    Identify 2-3 business units that demonstrate enthusiasm for or a positive outlook on improving how organizational data can help them in their role and as a unit.

    Conducting a deep-dive interview process with these key stakeholders will help further identify high-level goals for the data architecture strategy within each business unit. This process will help to secure their support throughout the implementation process by giving them a sense of ownership.

    Key Interview Questions:

    1. What are your primary activities? What do you do?
    2. What challenges do you have when completing your activities?
    3. How is poor data impacting your job?
    4. If [your selected domain]’s data is improved, what business issues would this help solve?

    Request background information and documentation from stakeholders regarding the following:

    • What current data management policies and processes exist (that you know of)?
    • Who are the data owners and end users?
    • Where are the data sources within the department stored?
    • Who has access to these data sources?
    • Are there existing or ongoing data issues within those data sources?

    Interview the enterprise architect to get input on the drivers of the business

    Associated Activity icon 1.1.3 2 hours

    INPUT: Data Architecture Driver tool assessment prompts.

    OUTPUT: Identified business driver that applies to your organization.

    Materials: Data Architecture Driver Pattern Identification Tool

    Participants: Data architect, Enterprise architect

    Data architecture improvements need to be driven by business need.

    Instructions

    As you work through Tab 2. Driver Identification of the Data Architecture Driver Pattern Identification Tool, consult with the enterprise architect or equivalent to assist you in rating the importance of each of the symptoms of the business drivers. This will help you provide greater value to the business and more aligned objectives.

    Screenshot of the Data Architecture Driver Pattern Identification Tool, tab 2 Driver Identification.
    Tab 2. Driver Identification

    Once you know what that need is, go to Step 2.

    Phase 1, Step 2: Establish Actionable Tactics to Optimize Data Architecture

    PHASE 1

    1.11.2
    Identify Your Business Driver for Optimizing Data ArchitectureDetermine Actionable Tactics to Optimize Data Architecture

    This step will walk you through the following activities:

    • Understand Info-Tech’s five-tier data architecture to begin focusing your architectural optimization.
    • Create your Data Architecture Optimization Template to plan your improvement tactics.
    • Prioritize your tactics based on the five-tier architecture to plan optimization.

    This step involves the following participants:

    • Data Architect
    • Enterprise Architect
    • DBAs

    Outcomes of this step

    • A tactical and prioritized plan for optimizing the organization’s data architecture according to the needs of the business.

    To plan a business-driven architecture, data architects need to keep the organization’s big picture in mind

    Remember… Architecting an organization involves alignment, planning, road mapping, design, and change management functions.

    Data architects must be heavily involved with:

    • Understanding the short- and long-term visions of the business to develop a vision for the organization’s data architecture.
    • Creating processes for governing the identification, collection, and use of accurate and valid data, as well as for tracking data quality, completeness, and redundancy.
    • They need to create strategies for data security, backup, disaster recovery, business continuity, and archiving, and ensure regulatory compliance.

    To do this, you need a framework. A framework provides you with the holistic view of the organization’s data environment that you can use to design short- and long-term tactics for improving the use of data for the needs of the business.

    Use Info-Tech’s five-tier data architecture to model your environment in a logical, consumable fashion.

    Info-Tech Best Practice

    The more complicated an environment is, the more need there is for a framework. Being able to pick a starting point and prioritize tasks is one of the most difficult, yet most essential, aspects of any architect’s role.

    The five tiers of an organization’s data architecture support the use of data throughout its lifecycle

    Info-Tech’s five-tier data architecture model summarizes an organization’s data environment at a logical level. Data flows from left to right, but can also flow from the presentation layer back to the warehousing layer for repatriation of data.

    Info-Tech's Five Tier Data Architecture. The five tiers being 'Sources' which includes 'App1 ', 'App2', 'Excel and other documents', 'Access database(s)', 'IOT devices', and 'External data feed(s) & social media'; 'Integration and Translation' which includes 'Solutions: SOA, Point to Point, Manual Loading, ESB , ETL, ODS, Data Hub' and 'Functions: Scrambling Masking Encryption, Tokenizing, Aggregation, Transformation, Migration, Modeling'; 'Warehousing' which includes 'Data Lakes & Warehouse(s) (Raw Data)', 'EIM, ECM, DAM', and 'Data Lakes & Warehouse(s) (Derived Data)'; 'Analytics' which includes 'Data Marts', 'Data Cube', 'Flat Files', 'BI Tools', and the 'Protected Zone: Data Marts - BDG Class Ref. MDM'; and 'Presentation' which includes 'Formulas', 'Thought Models', 'Reports', 'Dashboards', 'Presentations', and 'Derived Data (from analytics activities)'.

    Use the Data Architecture Optimization Template to build your improvement roadmap

    Supporting Tool icon 1.2 Data Architecture Optimization Template

    Download the Data Architecture Optimization Template.

    Overview

    Use this template to support your team in creating a tactical strategy for optimizing your data architecture across the five tiers of the organization’s architecture. This template can be used to document your organization’s most pressing business driver, the reasons for optimizing data architecture according to that driver, and the tactics that will be employed to address the shortcomings in the architecture.

    Sample of Info-Tech’s Data Architecture Optimization Template. Info-Tech’s Data Architecture Optimization Template Table of Contents
    1. Build Your Current Data Architecture Logical Model Use this section to document the current data architecture situation, which will provide context for your plan to optimize your data architecture.
    2. Optimization Plan Use this section to document the tactics that will be employed to optimize the current data architecture according to the tactic pattern identified by the business driver.

    Fill out as you go

    As you read about the details of the five-tier data architecture model in the following slides, start building your current logical data architecture model by filling out the sections that correspond to the various tiers. For example, if you identified that the most pressing business driver is becoming compliant with regulations, document the sources of data required for compliance, as well as the warehousing strategy currently being employed. This will help you to understand the organization’s data architecture at a logical level.

    Tier 1 represents all of the sources of your organization’s data

    Tier 1 of Info-Tech's Five Tier Data Architecture, 'Sources', which includes 'App1 ', 'App2', 'Excel and other documents', 'Access database(s)', 'IOT devices', and 'External data feed(s) & social media'.
    –› Data to integration layer

    Tier 1 is where the data enters the organization.

    All applications, data documents such as MS Excel spreadsheets, documents with table entries, manual extractions from other document types, user-level databases including MS Access and MySQL, other data sources, data feeds, big datasets, etc. reside here.

    This tier typically holds the siloed data that is so often not available across the enterprise because the data is held within department-level applications or systems. This is also the layer where transactions and operational activities occur and where data is first created or ingested.

    There are any number of business activities from transactions through business processes that require data to flow from one system to another, so it is often at this layer we see data created more than once, data corruption occurs, manual re-keying of data from system to system, and spaghetti-like point-to-point connections are built that are often fragile. This is usually the single most problematic area within an enterprise’s data environment. Application- or operational-level (siloed) reporting often occurs at this level.

    Info-Tech Best Practice

    An optimized Tier 1 has the following attributes:

    • Rationalized applications
    • Operationalized database administration
    • Databases governed, monitored, and maintained to ensure optimal performance

    Tier 2 represents the movement of data

    Tier 2 of Info-Tech's Five Tier Data Architecture, 'Integration and Translation', which includes 'Solutions: SOA, Point to Point, Manual Loading, ESB , ETL, ODS, Data Hub' and 'Functions: Scrambling Masking Encryption, Tokenizing, Aggregation, Transformation, Migration, Modeling'.
    –› Data to Warehouse Environment

    Find out more

    For more information on data integration, see Info-Tech’s Optimize the Organization’s Data Integration Practices blueprint.

    Tier 2 is where integration, transformation, and aggregation occur.

    Regardless of how you integrate your systems and data stores, whether via ETL, ESB, SOA, data hub, ODS, point-to-point, etc., the goal of this layer is to move data at differing speeds for one of two main purposes:

    1) To move data from originating systems to downstream systems to support integrated business processes. This ensures the data is pristine through the process and improves trustworthiness of outcomes and speed to task and process completion.

    2) To move data to Tier 3 - The Data Warehouse Architecture, where data rests for other purposes. This movement of data in its purest form means we move raw data to storage locations in an overall data warehouse environment reflecting any security, compliance and other standards in our choices for how to store.

    Also, this is where data is transformed for unique business purpose that will also be moved to a place of rest or a place of specific use. Data masking, scrambling, aggregation, cleansing and matching, and other data related blending tasks occur at this layer.

    Info-Tech Best Practice

    An optimized Tier 2 has the following attributes:

    • Business data glossary is leveraged
    • ETL is governed
    • ETL team is empowered
    • Data matching is facilitated
    • Canonical data model is present

    Tier 3 is where data comes together from all sources to be stored in a central warehouse environment

    Tier 3 is where data rests in long-term storage.

    This is where data rests (long-term storage) and also where an enterprise’s information, documents, digital assets, and any other content types are stored. This is also where derived and contrived data creations are stored for re-use, and where formulas, thought models, heuristics, algorithms, report styles, templates, dashboard styles, and presentations-layer widgets are all stored in the enterprise information management system.

    At this layer there may be many technologies and many layers of security to reflect data domains, classifications, retention, compliance, and other data needs. This is also the layer where data lakes exist as well as traditional relational databases, enterprise database systems, enterprise content management systems, and simple user-level databases.

    Info-Tech Best Practice

    An optimized Tier 3 has the following attributes:

    • Data warehouse is governed
    • Data warehouse operations and planning
    • Data library is comprehensive
    • Four Rosetta Stones of data are in place: BDG, data classification, reference data, master data.
    Data from integration layer –›
    Tier 3 of Info-Tech's Five Tier Data Architecture, 'Data Warehouse Environment' which includes 'Data Lakes & Warehouse(s) (Raw Data)', 'EIM, ECM, DAM'.
    –› Analytics

    Find out more

    For more information on Data Warehousing, see Info-Tech’s Build an Extensible Data Warehouse Foundation and Drive Business Innovation With a Modernized Data Warehouse Environment blueprints.

    Tier 4 is where knowledge and insight is born

    Tier 4 represents data being used for a purpose.

    This is where you build fit-for-purpose data sets (marts, cubes, flat files) that may now draw from all enterprise data and information sources as held in Tier 3. This is the first place where enterprise views of all data may be effectively done and with trust that golden records from systems of record are being used properly.

    This is also the layer where BI tools get their greatest use for performing analysis. Unlike Tier 3 where data is at rest, this tier is where data moves back into action. Data is brought together in unique combinations to support reporting, and analytics. It is here that the following enterprise analytic views are crafted:
    Exploratory, Inferential, Causal, Comparative, Statistical, Descriptive, Diagnostic, Hypothesis, Predictive, Decisional, Directional, Prescriptive

    Info-Tech Best Practice

    An optimized Tier 4 has the following attributes:

    • Reporting meets business needs
    • Data mart operations are in place
    • Governance of data marts, cubes, and BI tools in place
    Warehouse Environment –›
    Tier 4 of Info-Tech's Five Tier Data Architecture, 'Analytics', which includes 'Data Marts', 'Data Cube', 'Flat Files', and 'BI Tools'.
    –› Presentation

    Find out more

    For more information on BI tools and strategy, see Info-Tech’s Select and Implement a Business Intelligence and Analytics Solution and Build a Next Generation BI with a Game-Changing BI Strategy blueprints.

    The presentation layer, Tier 5, is where data becomes presentable information

    Tier 5 represents data in knowledge form.

    This is where the data and information combine in information insight mapping methods (presentations, templates, etc.). We craft and create new ways to slice and dice data in Tier 4 to be shown and shared in Tier 5.

    Templates for presenting insights are extremely valuable to an enterprise, both for their initial use, and for the ability to build deeper, more insightful analytics. Re-use of these also enables maximum speed for sharing, consuming the outputs, and collective understanding of these deeper meanings that is a critical asset to any enterprise. These derived datasets and the thought models, presentation styles, templates, and other derived and contrived assets should be repatriated into the derived data repositories and the enterprise information management systems respectively as shown in Tier 3.

    Find out more

    For more information on enterprise content management and metadata, see Info-Tech’s Develop an ECM Strategy and Break Open Your DAM With Intuitive Metadata blueprints.

    Tier 5 of Info-Tech's Five Tier Data Architecture, 'Presentation', which includes 'Formulas', 'Thought Models', 'Reports', 'Dashboards', 'Presentations', and 'Derived Data (from analytics activities)'. The 'Repatriation of data' feeds the derived data back into Warehousing.

    Info-Tech Best Practice

    An optimized Tier 5 has the following attributes:

    • Metadata creation is supervised
    • Metadata is organized
    • Metadata is governed
    • Content management capabilities are present

    Info-Tech Insight

    Repatriation of data and information is an essential activity for all organizations to manage organizational knowledge. This is the activity where information, knowledge, and insights that are stored in content form are moved back to the warehousing layer for long-term storage. Because of this, it is crucial to have an effective ECM strategy as well as the means to find information quickly and efficiently. This is where metadata and taxonomy come in.

    As a data architect, you must prioritize your focus according to business need

    Determine your focus.

    Now that you have an understanding of the drivers requiring data architecture optimization, as well as the current data architecture situation at your organization, it is time to determine the actions that will be taken to address the driver.

    1. Business driver

    Screenshot of Data Architecture Driver Pattern Identification Tool, Tab 2. Tactic Pattern Plan.
    Data Architecture Driver Pattern Identification Tool, Tab 2. Tactic Pattern Plan

    3. Documented tactic plan

    Data Architecture Optimization Template

    2. Tactics across the five tiers

    Another screenshot of Data Architecture Driver Pattern Identification Tool, Tab 2. Tactic Pattern Plan.

    The next four slides provide an overview of the priorities that accompany the four most common business drivers that require updates to a stale data architecture.

    Business driver #1: Adding a new functionality to an application can have wide impacts on data architecture

    Does the business wants to add a new application or supplement an existing application with a new functionality?

    Whether the business wants to gain better customer intimacy, achieve operational excellence, or needs to change its compliance and reporting strategy, the need for collecting new data through a new application or a new functionality within an existing application can arise. This business driver has the following attributes:

    • Often operational oriented and application driven.
    • An application is changed through an application version upgrade, migration to cloud, or application customization, or as a result of application rationalization or changes in the way that application data is generated.
    • However, not all new functionalities trigger this scenario. Non-data-related changes, such as a new interface, new workflows, or any other application functionality changes that do not involve data, will not have data architecture impacts.
    Stock photo of someone using a smartphone with apps.
    Modified icon for Tools & Templates. When this business driver arises, data architects should focus on optimizing architecture at the source tier and the integration of the new functionality. Tactics for this business driver should address the following pattern:
    Tiers 1 and 2 highlighted.

    Business driver #2: Organizations today are looking to become more data driven

    Does the business wants to better leverage its data?

    An organization can want to use its data for multiple reasons. Whether these reasons include improving customer experience or operational excellence, the data architect must ensure that the organization’s data aggregation environment, reporting and analytics, and presentation layer are assessed and optimized for serving the needs of the business.

    “Data-drivenness is about building tools, abilities, and, most crucially, a culture that acts on data.” (Carl Anderson, Creating a Data-Driven Organization)

    Tactics for this business driver should address the following pattern:
    Tiers 3, 4, and 5 highlighted.
    Modified icon for Tools & Templates. When this business driver arises, data architects should focus on optimizing architecture at the source tier and the integration of the new functionality.
    Stock photo of someone sitting at multiple computers with analytics screens open.
    • This scenario is typically project driven and analytical oriented.
    • The business is looking to leverage data and information by processing data through BI tools and self-service.
    • Example: The organization wants to include new third-party data, and needs to build a new data mart to provide a slice of data for analysis.

    Business driver #3: Risk and compliance demands can put pressure on outdated architectures

    Is there increasing pressure on the business to maintain compliance requirements as per regulations?

    An organization can want to use its data for multiple reasons. Whether these reasons include improving customer experience or operational excellence, the data architect must ensure that the organization’s data aggregation environment, reporting and analytics, and presentation layer are assessed and optimized for serving the needs of the business.

    There are different types of requirements:
    • Can be data-element driven. For example, PII, PHI are requirements around data elements that are associated with personal and health information.
    • Can be process driven. For example, some requirements restrict data read/write to certain groups.
    Stock photo of someone pulling a block out of a Jenga tower.
    Modified icon for Tools & Templates. When this business driver arises, data architects should focus on optimizing architecture where data is stored: at the sources, the warehouse environment, and analytics layer. Tactics for this business driver should address the following pattern:
    Tiers 1, 3, and 4 highlighted.

    Business driver #4: Mergers and acquisitions can require a restructuring of the organization’s data architecture

    Is the organization looking to acquire or merge with another organization or line of business?

    There are three scenarios that encompass the mergers and acquisitions business driver for data architecture:

    1. The organization acquires/merges with another organization and wants to integrate the data.
    2. The organization acquires/merges a subset of an organization (a line of business, for example) and wants to integrate the data.
    3. The organization acquires another organization for competitive purposes, and does not need to integrate the data.
    Regardless of what scenario your organization falls into, you must go through the same process of identifying the requirements for the new data:
    1. Understand what data you are getting.
      The business may acquire another organization for the data, for the technology, and/or for algorithms (for example). If the goal is to integrate the new data, you must understand if the data is unstructured, structured, how much data, etc.
    2. Plan for the integration of the new data into your environment.
      Do you have the expertise in-house to integrate the data? Database structures and systems are often mismatched (for example, acquired company could have an Oracle database whereas you are an SAP shop) and this may require expertise from the acquired company or a third party.
    3. Integrate the new data.
      Often, the extraction of the new data is the easy part. Transforming and loading the data is the difficult and costly part.
    “As a data architect, you must do due diligence of the acquired firm. What are the workflows, what are the data sources, what data is useful, what is useless, what is the value of the data, and what are the risks of embedding the data?” (Anonymous Mergers and Acquisitions Consultant)
    Modified icon for Tools & Templates. When this business driver arises, data architects should focus on optimizing architecture at the source tier, the warehousing layer, and analytics. Tiers 1, 3, and 4 highlighted.

    Determine your tier priority pattern and the tactics that you should address based on the business drivers

    Associated Activity icon 1.2.1 30 minutes

    INPUT: Business driver assessment

    OUTPUT: Tactic pattern and tactic plan

    Materials: Data Architecture Driver Pattern Identification Tool, Data Architecture Optimization Template

    Participants: Data architect, Enterprise architect

    Instructions
    1. After you have assessed the organization’s business driver on Tab 1. Driver Identification, move to Tab 2. Tactic Pattern Plan.
    2. Here, you will find a summary of the business driver that applies to you, as well as the tier priority pattern that will help you to focus your efforts for data architecture.
    3. Document the Tier Priority Pattern and associated tactics in Section 2. Optimization Plan of the Data Architecture Optimization Plan.
    Screenshot of Data Architecture Driver Tool.
    Data Architecture Driver Tool
    Arrow pointing right. Sample of Data Architecture Optimization Template
    Data Architecture Optimization Template

    Info-Tech Insight

    Our approach will help you to get to the solution of the organization’s data architecture problems as quickly as possible. However, keep in mind that you should still address the other tiers of your data architecture even if they are not part of the pattern we identified. For example, if you need to become more data driven, don’t completely ignore the sources and the integration of data. However, to deliver the most and quickest value, focus on tiers 3, 4, and 5.

    This phase helped you to create a tactical plan to optimize your data architecture according to business priorities

    Phase 1 is all about focus.

    Data architects and those responsible for updating an organization’s data architecture have a wide-open playing field with which to take their efforts. Being able to narrow down your focus and generate an actionable plan will help you provide more value to the organization quickly and get the most out of your data.

      Phase 1
      • Business Drivers
        • Tactic Pattern
          • Tactical Plan

    Now that you have your prioritized tactical plan, move to Phase 2. This phase will help you map these priorities to the essential capabilities and measure where you stack up in these capabilities. This is an essential step in creating your data architecture roadmap and plan for coming years to modernize the organization’s data architecture.

    To identify what the monetary authority needed from its data architecture, Info-Tech helped determine the business driver

    CASE STUDY

    Industry: Financial
    Source: Info-Tech Consulting
    Symbol for 'Monetary Authority Case Study'.

    Part 1

    Prior to receiving new external requirements, the monetary Authority body had been operating with an inefficient system. Outdated legacy systems, reports in paper form, incomplete reports, and stale data from other agencies resulted in slow data access. The new requirements demanded speeding up this process.

    Diagram comparing the 'Original Reporting' requirement of 'Up to 7 days' vs the 'New Requirement' of 'As soon as 1 hour'. The steps of reporting in that time are 'Report Request', 'Gather Data', and 'Make Report'.

    Although the organization understood it needed changes, it first needed to establish what were the business objectives, and which areas of their architecture they would need to focus on.

    The business driver in this case was compliance requirements, which directed attention to the sources, aggregation, and insights tiers.

    Tiers 1, 3, and 4 highlighted.

    Looking at the how the different tiers relate to certain business operations, the organization uncovered the best practise tactics to achieving an optimized data architecture.

    1. Source Tactics: 3. Warehousing Tactics: 4. Analytics Tactics:
    • Identify data sources
    • Ensure data quality
    • Properly catalogue data
    • Properly index data
    • Provide the means for data accessibility
    • Allow for data reduction/space for report building

    Once the business driver had been established, the organization was able to identify the specific areas it would eventually need to evaluate and remedy as needed.

    If you want additional support, have our analysts guide you through this phase as part of an Info-Tech Workshop Associated Activity icon

    Book a workshop with our Info-Tech analysts:

    Photo of an Info-Tech analyst.
    • To accelerate this project, engage your IT team in an Info-Tech workshop with an Info-Tech analyst team.
    • Info-Tech analyst will join you and your team onsite at your location or welcome you to Info-Tech's historic Toronto office to participate in an innovative onsite workshop.
    • Contact your account manager (www.infotech.com/account), or email Workshops@InfoTech.com for more information.

    The following are sample activities that will be conducted by Info-Tech analysts with your team:

    1.1.1

    Sample of activity 1.1.1 'Identify the drivers for improving your data architecture'. Identify the business driver that will set the direction of your data architecture optimization plan.

    In this activity, the facilitator will guide the team in identifying the business driver that is creating the need to improve the organization’s data architecture. Data architecture needs to adapt to the changing needs of the business, so this is the most important step of any data architecture improvements.

    1.2.1

    Sample of activity 1.2.1 'Determine your tier priority pattern and the tactics that you should address based on the business drivers'. Determine the tactics that you will use to optimize data architecture.

    In this activity, the facilitator will help the team create a tactical plan for optimizing the organization’s data architecture across the five tiers of the logical model. This plan can then be followed when addressing the business needs.

    Build a Business-Aligned Data Architecture Optimization Strategy

    PHASE 2

    Personalize Your Tactics to Optimize Your Data Architecture

    Phase 2 will determine your tactics that you should implement to optimize your data architecture

    Business Drivers
    Each business driver requires focus on specific tiers and their corresponding capabilities, which in turn correspond to tactics necessary to achieve your goal.
    New Functionality Risk and Compliance Mergers and Acquisitions Become More Data Driven
    Tiers 1. Data Sources 2. Integration 3. Warehousing 4. Insights 5. Presentation
    Capabilities Current Capabilities
    Target Capabilities
    Example Tactics Leverage indexes, partitions, views, and clusters to optimize performance.

    Cleanse data source.

    Leverage integration technology.

    Identify matching approach priorities.

    Establish governing principles.

    Install performance enhancing technologies.

    Establish star schema and snowflake principles.

    Share data via data mart.

    Build metadata architecture:
    • Data lineage
    • Sharing
    • Taxonomy
    • Automatic vs. manual creation

    Phase 2 outline

    Associated Activity icon Call 1-888-670-8889 or email GuidedImplementations@InfoTech.com for more information.

    Complete these steps on your own, or call us to complete a guided implementation. A guided implementation is a series of 2-3 advisory calls that help you execute each phase of a project. They are included in most advisory memberships.

    Guided Implementation 2: Personalize Your Tactics to Optimize Your Data Architecture

    Proposed Time to Completion: 2 weeks
    Step 2.1: Measure Your Data Architecture Capabilities Step 2.2: Set a Target for Data Architecture Capabilities Step 2.3: Identify the Tactics That Apply to Your Organization
    Start with an analyst kick-off call:
    • Understand Info-Tech’s data architecture capability model to begin identifying where to develop tactics for optimizing your data architecture.
    Review findings with analyst:
    • Understand Info-Tech’s data architecture capability model to begin identifying where to develop tactics for optimizing your data architecture.
    Finalize phase deliverable:
    • Learn about the trends in data architecture that can be leveraged to develop tactics.
    Then complete these activities…
    • Measure your current state across the tiers of the capability model that will help address your business driver.
    Then complete these activities…
    • Measure your target state for the capabilities that will address your business driver.
    Then complete these activities…
    • Review the tactical roadmap that was created with guidance from the capability gap analysis.
    With these tools & templates:
    • Data Architecture Tactical Roadmap Tool
    With these tools & templates:
    • Data Architecture Tactical Roadmap Tool
    With these tools & templates:
    • Data Architecture Trends Presentation Template

    Phase 2 Results & Insights

    • Data architecture is not just data models. Understand the essential capabilities that your organization needs from its data architecture to develop a tactical plan for optimizing data architecture across its people, processes, and technology.

    Phase 2, Step 1: Measure Your Data Architecture Capabilities

    PHASE 2

    2.1 2.2 2.3
    Measure Your Data Architecture Capabilities Set a Target for Data Architecture Capabilities Identify the Tactics That Apply to Your Organization

    This step will walk you through the following activities:

    • As you walk through the data architecture capability model, measure your current state in each of the relevant capabilities.
    • Distinguish between essential and nice-to-have capabilities for your organization.

    This step involves the following participants:

    • Data Architect

    Outcomes of this step

    • A framework for generating a tactical plan for data architecture optimization.
    • Knowledge of the various trends in the data architecture field that can be incorporated into your plan.

    To personalize your tactical strategy, you must measure up your base data architecture capabilities

    What is a capability?

    Capabilities represent a mixture of people, technology, and processes. The focus of capability design is on the outcome and the effective use of resources to produce a differentiating capability or an essential supporting capability.

    To personalize your tactics, you have to understand what the essential capabilities are across the five tiers of an organization’s data architecture. Then, assess where you currently stand in these capabilities and where you need to go in order to build your optimization plan.

    'Capability' as a mixture of 'People', 'Technology', 'Process', and 'Assets'.

    Info-Tech’s data architecture capability model can be laid over the five-tier data architecture to understand the essential and advanced capabilities that an organization should have, and to build your tactical strategy for optimizing the organization’s data architecture across the tiers.

    Use Info-Tech’s data architecture capability model as a resource to assess and plan your personalized tactics

    Info-Tech’s data architecture capability model can be laid over the five-tier data architecture to understand the essential and advanced capabilities that an organization should have, and to build your tactical strategy for optimizing the organization’s data architecture across the tiers.

    Info-Tech’s Data Architecture Capability Model featuring the five-tier architecture listing 'Core Capabilities' and 'Advanced Capabilities' within each tier, and a list of 'Cross Capabilities' which apply to all tiers.

    Use the Data Architecture Tactical Roadmap Tool to create a tailored plan of action

    Supporting Tool icon 2.1.1 Data Architecture Tactical Roadmap Tool

    Instructions

    Use the Data Architecture Tactical Roadmap Tool as your central tool to develop a tactical plan of action to optimize the organization’s data architecture.

    This tool contains the following sections:

    1. Business Driver Input
    2. Capability Assessment
    3. Capability Gap Analysis
    4. Tactical Roadmap
    5. Metrics
    6. Initiative Roadmap

    INFO-TECH DELIVERABLE

    Sample of the Info-Tech deliverable Data Architecture Tactical Roadmap Tool.

    Benefits of using this tool:

    • Comprehensive documentation of data architecture capabilities present in leading organizations.
    • Generates an accurate architecture roadmap for your organization that is developed in alignment with the broader enterprise architecture and related architectural domains.

    To create a plan for your data architecture priorities, you must first understand where you currently stand

    Now that you understand the business problem that you are trying to solve, it is time to take action in solving the problem.

    The organization likely has some of the capabilities that are needed to solve the problem, but also a need to improve other capabilities. To narrow down the capabilities that you should focus on, first select the business driver that was identified in Phase 1 in Tab 1. Business Driver Input of the Data Architecture Tactical Roadmap Tool. This will customize the roadmap tool to deselect the capabilities that are likely to be less relevant to your organization.

    For Example: If you identified your business driver as “becoming more data-driven”, you will want to focus on measuring and building out the capabilities within Tiers 3, 4, and 5 of the capability model.

    Data Architecture Capability Model
    Info-Tech’s Data Architecture Capability Model with tiers 3, 4, and 5 highlighted.

    Note

    If you want to assess your organization for all of the capabilities across the data architecture capability model, select “Comprehensive Data Architecture Assessment” in Tab 1. Business Driver Input of the Data Architecture Tactical Roadmap Tool.

    Determine your current state across the related architecture tiers

    Associated Activity icon 2.1.2 1 hour

    INPUT: Current data architecture capabilities.

    OUTPUT: An idea of where you currently stand in the capabilities.

    Materials: Data Architecture Tactical Roadmap Tool

    Participants: Data architect, Enterprise architect, Business representatives

    Use the Data Architecture Tactical Roadmap Tool to evaluate the baseline and target capabilities of your practice in terms of how data architecture is approached and executed.

    Instructions
    1. Invite the appropriate stakeholders to participate in this exercise.
    2. On Tab 2. Practice Components, assess the current and target states of each capability on a scale of 1–5.
    3. Note: “Ad hoc” implies a capability is completed, but randomly, informally, and without a standardized method.
      These results will set the baseline against which you will monitor performance progress and keep track of improvements over time.
    To assess data architecture maturity, Info-Tech uses the Capability Maturity Model Integration (CMMI) program for rating capabilities on a scale of 1 to 5:

    1 = Initial/Ad hoc

    2 = Developing

    3 = Defined

    4 = Managed and Measurable

    5 = Optimized

    Info-Tech Insight

    Focus on Early Alignment. Assessing capabilities within specific people’s job functions can naturally result in disagreement or debate, especially between business and IT people. Objectively facilitate any debate and only finalize capability assessments when there is full alignment. Remind everyone that data architecture should ultimately serve business needs wherever possible.

    Phase 2, Step 2: Set a Target for Data Architecture Capabilities

    PHASE 2

    2.12.22.3
    Measure Your Data Architecture CapabilitiesSet a Target for Data Architecture CapabilitiesIdentify the Tactics That Apply to Your Organization

    This step will walk you through the following activities:

    • Determine your target state in each of the relevant capabilities.
    • Distinguish between essential and nice-to-have capabilities for your organization.

    This step involves the following participants:

    • Data Architect

    Outcomes of this step

    • A holistic understanding of where the organization’s data architecture currently sits, where it needs to go, and where the biggest gaps lie.

    To create a plan for your data architecture priorities, you must also understand where you need to get to in the future

    Keep the goal in mind by documenting target state objectives. This will help to measure the highest priority gaps in the organization’s data architecture capabilities.

    Example driver = Becoming more data driven Arrow pointing right. Info-Tech’s Data Architecture Capability Model with tiers 3, 4, and 5 highlighted. Arrow pointing right. Current Capabilities Arrow pointing right. Target Capabilities
    Gaps and Priorities
    Stock photo of a hand placing four shelves arranged as stairs. On the first step is a mini-cut-out of a person walking.

    Determine your future state across the relevant tiers of the data architecture capability model

    Associated Activity icon 2.2.1 2 hours

    INPUT: Current state of data architecture capabilities.

    OUTPUT: Target state of data architecture capabilities.

    Materials: Data Architecture Tactical Roadmap Tool

    Participants: Data architect

    The future of data architecture is now.

    Determine the state of data architecture capabilities that the organization needs to reach to address the drivers of the business.

    For example: If you identified your business driver as “becoming more data driven”, you will want to focus on the capabilities within Tiers 3, 4, and 5 of the capability model.

    Driver = Becoming more data driven Arrow pointing right. Info-Tech’s Data Architecture Capability Model with tiers 3, 4, and 5 highlighted. Arrow pointing right. Target Capabilities

    Identify where gaps in your data architecture capabilities lie

    Associated Activity icon 2.2.2 1 hour

    INPUT: Current and target states of data architecture capabilities.

    OUTPUT: Holistic understanding of where you need to improve data architecture capabilities.

    Materials: Data Architecture Tactical Roadmap Tool

    Participants: Data architect

    Visualization of gap assessment of data quality practice capabilities

    To enable deeper analysis on the results of your capability assessment, Tab 4. Capability Gap Analysis in the Data Architecture Tactical Roadmap Tool creates visualizations of the gaps identified in each of your practice capabilities and related data management practices. These diagrams serve as analysis summaries.

    Gap Assessment of Data Source Capabilities

    Sample of the Data Architecture Tactical Roadmap Tool, tab 4. Capability Gap Analysis.

    Use Tab 3. Data Quality Practice Scorecard to enhance your data quality project.

    1. Enhance your gap analyses by forming a relative comparison of total gaps in key practice capability areas, which will help in determining priorities.
    2. Put these up on display to improve discussion in the gap analyses and prioritization sessions.
    3. Improve the clarity and flow of your strategy template, final presentations, and summary documents by copying and pasting the gap assessment diagrams.

    Phase 2, Step 3: Identify the Tactics That Apply to Your Organization

    PHASE 2

    2.12.22.3
    Measure Your Data Architecture CapabilitiesSet a Target for Data Architecture CapabilitiesIdentify the Tactics That Apply to Your Organization

    This step will walk you through the following activities:

    • Before making your personal tactic plan, identify the trends in data architecture that can benefit your organization.
    • Understand Info-Tech’s data architecture capability model.
    • Initiate the Data Architecture Roadmap Tool to begin creating a roadmap for your optimization plan.

    This step involves the following participants:

    • Data Architect

    Outcomes of this step

    • A framework for generating a tactical plan for data architecture optimization.
    • Knowledge of the various trends in the data architecture field that can be incorporated into your plan.

    Capitalize on trends in data architecture before you determine the tactics that apply to you

    Stop here. Before you begin to plan for optimization of the organization’s data environment, get a sense of the sustainability and scalability of the direction of the organization’s data architecture evolution.

    Practically any trend in data architecture is driven by an attempt to solve one or more the common challenges of today’s tumultuous data landscape, otherwise known as “big data.” Data is being produced in outrageous amounts, at very high speeds, and in a growing number of types and structures.

    To meet these demands, which are not slowing down, you must keep ahead of the curve. Consider the internal and external catalysts that might fuel your organization’s need to modernize its data architecture:

    Big Data

    Data Storage

    Advanced analytics

    Unstructured data

    Integration

    Hadoop ecosystem

    The discussion about big data is no longer about what it is, but how do businesses of all types operationalize it.

    Is your organization currently capturing and leveraging big data?

    Are they looking to do so in the near future?

    The cloud

    The cloud offers economical solutions to many aspects of data architecture.

    Have you dealt with issues of lack of storage space or difficulties with scalability?

    Do you need remote access to data and tools?

    Real-time architecture

    Advanced analytics (machine learning, natural language processing) often require data in real-time. Consider Lambda and Kappa architectures.

    Has your data flow prevented you from automation, advanced analytics, or embracing the world of IoT?

    Graph databases

    Self-service data access allows more than just technical users to participate in analytics. NoSQL can uncover buried relationships in your data.

    Has your organization struggled to make sense of different types of unstructured data?

    Is ETL enough?

    What SQL is to NoSQL, ETL is to NoETL. Integration techniques are being created to address the high variety and high velocity of data.

    Have your data scientists wasted too much time and resources in the ETL stage?

    Read the Data Architecture Trends Presentation to understand the current cutting edge topics in data architecture

    Supporting Tool icon 2.1 Data Architecture Trends Presentation

    The speed at which new technology is changing is making it difficult for IT professionals to keep pace with best practices, let alone cutting edge technologies.

    The Info-Tech Data Architecture Trends Presentation provides a glance at some of the more significant innovations in technology that are driving today’s advanced data architectures.

    This presentation also explains how these trends relate to either the data challenges you may be facing, or the specific business drivers you are hoping to bring to your organization.

    Sample of the Data Architecture Trends Presentation.
    Data Architecture Trends Presentation

    Gaps between your current and future capabilities will help you to determine the tactics that apply to you

    Now that you know where the organization currently stands, follow these steps to begin prioritizing the initiatives:

    1. What are you trying to accomplish? Determine target states that are framed in quantifiable objectives that can be clearly communicated. The more specific the objectives are the better.
    2. Evaluate the “delta,” or difference between where the organization currently stands and where it needs to go. This will be expressed in terms of gap closure strategies, and will help clarify the initiatives that will populate the road map.
    3. Determine the relative business value of each initiative, as well as the relative complexities of successfully implementing them. These scores should be created with stakeholder input, and then plotted in an effort/transition quadrant map to determine where the quickest and most valuable wins lie.
    Current State Gap Closure Strategies Target State Data Architecture Tactical Roadmap
    • Organization objectives
    • Functional needs
    • Current operating models
    • Technology assets
    Initiatives involving:
    • Organizational changes
    • Functional changes
    • Technology changes
    • Process changes
    • Performance objectives (revenue growth, customer intimacy, growth of organization)
    • Operating model improvements
    • Prioritized, simplified, and compelling vision of how the organization will optimize data architecture

    (Source: “How to Build a Roadmap”)

    Info-Tech Insight

    Optimizing data architecture requires a tactical approach, not a passive approach. The demanding task of optimization requires the ability to heavily prioritize. After you have identified why, determine how using our pre-built roadmap to address the four common drivers.

    Each of the layers of an organization’s data architecture have associated challenges to optimization

    Stop! Before you begin, recognize these “gotchas” that can present roadblocks to creating an effective data architecture environment.

    Before diving headfirst into creating your tactical data architecture plan, documenting the challenges associated with each aspect of the organization’s data architecture can help to identify where you need to focus your energy in optimizing each tier. The following table presents the common challenges across the five tiers:

    Source Tier

    Integration Tier

    Warehousing Tier

    Analytics Tier

    Presentation Tier

    Inconsistent data models Performance issues Scalability of the data warehouse Data currency, flexibility Model interoperability
    Data quality measures: data accuracy, timeliness, accessibility, relevance Duplicated data Infrastructure needed to support volume of data No business context for using the data in the correct manner No business context for using the data in the correct manner
    Free-form field and data values beyond data domain Tokenization and other required data transformations Performance
    Volume
    Greedy consumers can cripple performance
    Insufficient infrastructure
    Inefficiencies in building the data mart Report proliferation/chaos (“kitchen sink dashboards”)
    Reporting out of source systems DB model inefficiencies
    Manual errors;
    Application usability
    Elasticity

    Create metrics before you plan to optimize your data architecture

    Associated Activity icon 2.2.3 1 hour

    INPUT: Tactics that will be used to optimize data architecture.

    OUTPUT: Metrics that can be used to measure optimization success.

    Materials: Data Architecture Tactical Roadmap Tool

    Participants: Data architect

    Metrics will help you to track your optimization efforts and ensure that they are providing value to the organization.

    There are two types of metrics that are useful for data architects to track and measure: program metrics and project metrics. Program metrics represent the activities that the data architecture program, which is the sum of multiple projects, should help to improve. Project metrics are the more granular metrics that track each project.

    Program Metrics

    • TCO of IT
      • Costs associated with applications, databases, data maintenance
      • Should decrease with better data architecture (rationalized apps, operationalized databases)
    • Cost savings:
      • Retiring a legacy system and associated databases
      • Consolidated licensing
      • Introducing shared services
    • Data systems under maintenance (maintenance burden)
    • End-user data requests fulfilled
    • Improvement of time of delivery of reports and insights

    Project Metrics

    • Percent of projects in alignment with EA
    • Percent of projects compliant with the EA governance process (architectural due diligence rate)
    • Reducing time to market for launching new products
      • Reducing human error rates
      • Speeding up order delivery
      • Reducing IT costs
      • Reducing severity and frequency of security incidents

    Use Tab 6. Metrics of the Data Architecture Tactical Roadmap Tool to document and track metrics associated with your optimization tactics.

    Use Info-Tech’s resources to build your data architecture capabilities

    The following resources from Info-Tech can be used to improve the capabilities that were identified as having a gap. Read more about the details of the five-tier architecture in the blueprints below:

    Data Governance

    Data architecture depends on effective data governance. Use our blueprint, Enable Shared Insights With an Effective Data Governance Engine to get more out of your architecture.

    Data Quality

    The key to maintaining high data quality is a proactive approach that requires you to establish and update strategies for preventing, detecting, and correcting errors. Find out more on how to improve data quality with Info-Tech’s blueprint, Restore Trust in Your Data Using a Business-Aligned Data Quality Management Approach.

    Master Data Management

    When you start your data governance program, you will quickly realize that you need an effective MDM strategy for managing your critical data assets. Use our blueprint, Develop a Master Data Management Strategy and Roadmap to Better Monetize Data to get started with MDM.

    Data Warehouse

    The key to maintaining high data quality is a proactive approach that requires you to establish and update strategies for preventing, detecting, and correcting errors. Find out more on how to improve data quality with Info-Tech’s blueprint, Drive Business Innovation With a Modernized Data Warehouse Environment.

    With the optimal tactics identified, the monetary authority uncovered areas needing improvement

    CASE STUDY

    Industry: Financial
    Source: Info-Tech Consulting
    Symbol for 'Monetary Authority Case Study'.

    Part 2

    After establishing the appropriate tactics based on its business driver, the monetary authority was able to identify its shortcomings and adopt resolutions to remedy the issues.

    Best Practice Tactic Current State Solution
    Tier 1 - Data Sources Identify data sources Data coming from a number of locations. Create data model for old and new systems.
    Ensure data quality Internal data scanned from paper and incomplete. Data cleansing and update governance and business rules for migration to new system.
    External sources providing conflicting data.
    Tier 3 - Data Warehousing Data catalogue Data aggregated incompletely. Built proper business data glossary for searchability.
    Indexing Data warehouse performance sub-optimal. Architected data warehouse for appropriate use (star schema).
    Tier 4 - Data Analytics Data accessibility Relevant data buried in warehouse. Build data marts for access.
    Data reduction Accurate report building could not be performed in current storage. Built interim solution sandbox, spin up SQL database.

    Establishing these solutions provided the organization with necessary information to build their roadmap and move towards implementing an optimized data architecture.

    If you want additional support, have our analysts guide you through this phase as part of an Info-Tech Workshop Associated Activity icon

    Book a workshop with our Info-Tech analysts:

    Photo of a Info-Tech analyst.
    • To accelerate this project, engage your IT team in an Info-Tech workshop with an Info-Tech analyst team.
    • Info-Tech analyst will join you and your team onsite at your location or welcome you to Info-Tech's historic Toronto office to participate in an innovative onsite workshop.
    • Contact your account manager (www.infotech.com/account), or email Workshops@InfoTech.com for more information.

    The following are sample activities that will be conducted by Info-Tech analysts with your team:

    2.1.1 – 2.2.2

    Sample of activities 2.1.1 and 2.2.2, the first being 'Determine your current state across the related architecture tiers'. Evaluate your current capabilities and design your target data quality practice from two angles

    In this assessment and planning activity, the team will evaluate the current and target capabilities for your data architecture’s ability to meet business needs based on the essential capabilities across the five tiers of an organization’s architectural environment.

    2.2.3

    Sample of activity 2.2.3 'Create metrics before you plan to optimize your data architecture'. Create metrics to track the success of your optimization plan.

    The Info-Tech facilitator will guide you through the process of creating program and project metrics to track as you optimize your data architecture. This will help to ensure that the tactics are helping to improve crucial business attributes.

    Build a Business-Aligned Data Architecture Optimization Strategy

    PHASE 3

    Create Your Tactical Data Architecture Roadmap

    Phase 3 outline

    Associated Activity icon Call 1-888-670-8889 or email GuidedImplementations@InfoTech.com for more information.

    Complete these steps on your own, or call us to complete a guided implementation. A guided implementation is a series of 2-3 advisory calls that help you execute each phase of a project. They are included in most advisory memberships.

    Guided Implementation 3: Create Your Tactical Data Architecture Roadmap

    Proposed Time to Completion: 2 weeks
    Step 3.1: Personalize Your Data Architecture RoadmapStep 3.2: Manage Your Data Architecture Decisions and the Resulting Changes
    Start with an analyst kick-off call:
    • Review the tactical plan that addresses the business drivers by optimizing your data architecture in the relevant focus areas.
    Review findings with analyst:
    • Discuss and review the roadmap of optimization activities, including dependencies, timing, and ownership of activities.
    • Understand how change management is an integral aspect of any data architecture optimization plan.
    Then complete these activities…
    • Create your detailed data architecture initiative roadmap.
    Then complete these activities…
    • Create your Data Architecture Decision Template to document the changes that are going to be made to optimize your data architecture environment.
    • Review how change management fits into the data architecture improvement program.
    With these tools & templates:
    • Data Architecture Tactical Roadmap Tool
    With these tools & templates:
    • Data Architecture Decision Template

    Phase 3 Results & Insights

    • Phase 3 will help you to build a personalized roadmap and plan for optimizing data architecture in your organization. In carrying out this roadmap, changes will, by necessity, occur. Therefore, an integral aspect of a data architect’s role is change management. Use the resources included in Phase 3 to smoothen the change management process.

    Phase 3, Step 1: Personalize Your Data Architecture Roadmap

    PHASE 3

    3.1 3.2
    Personalize Your Data Architecture Roadmap Manage Your Data Architecture Decisions and the Resulting Changes

    This step will walk you through the following activities:

    • Determine the timing, effort, and ownership of the recommended optimization initiatives.
    • Brainstorm initiatives that are not yet on the roadmap but apply to you.

    This step involves the following participants:

    • Data Architect
    • DBAs
    • Enterprise Architect

    Outcomes of this step

    • A roadmap of specific initiatives that map to the tactical plan for optimizing your organization’s data architecture.
    • A plan for communicating high-level business objectives to data workers to address the issues of the business.

    Now that you have tactical priorities, identify the actionable steps that will lead you to an optimized data architecture

    Phase 1 and 2 helped you to identify tactics that address some of the most common business drivers. Phase 3 will bring you through the process of practically planning what those tactics look like in your organization’s environment and create a roadmap to plan how you will generate business value through optimization of your data architecture environment.

    Diagram of the three phases and the goals of each one. The first phase says 'Identify your data architecture business driver' and highlights 'Business Driver 3' out of four to focus on in Phase 2. Phase 2 says 'Optimization tactics across the five-tier logical data architecture' and identifies four of six 'Tactics' to use in Phase 3. Phase 3 is a 'Practical Roadmap of Initiatives' and utilizes a timeline of initiatives in which to apply the chosen tactics.

    Use the Data Architecture Tactic Roadmap Tool to personalize your roadmap

    Supporting Tool icon 3.1.1 Data Architecture Tactic Roadmap Tool
    Generating Your Roadmap
    1. On Tab 5. Tactic and Initiative Planning, you will find a list of tactics that correspond to every capability that applies to your chosen driver and where there is a gap. In addition, each tactic has a sequence of “Suggested Initiatives,” which represent the best-practice steps that you should take to optimize your data architecture according to your priorities and gaps.
    2. Customize this list of initiatives according to your needs.
    3. The Gantt chart is generated in Tab 7. Initiative Roadmap, and can be used to organize your plan and ensure that all of the essential aspects of optimizing data architecture are addressed.
    4. The roadmap can be used as an “executive brief” roadmap and as a communication tool for the business.
    Screenshot of the Data Architecture Tactic Roadmap Tool, Tab 5. Tactic and Initiative Planning.
    Tab 5. Tactic and Initiative Planning

    Screenshot of the Data Architecture Tactic Roadmap Tool, Tab 7. Initiative Roadmap.
    Tab 7. Initiative Roadmap

    Determine the details of your data architecture optimization activities

    Associated Activity icon 3.1.2 1 hour

    INPUT: Timing of initiatives for optimizing data architecture.

    OUTPUT: Optimization roadmap

    Materials: Data Architecture Tactic Roadmap Tool

    Participants: Data architect, Enterprise Architect

    Instructions

    1. With the list of suggested activities in place on Tab 5. Tactic and Initiative Planning, select whether or not the initiatives will be included in the roadmap. By default, all of the initiatives are set to “Yes.”
    2. Plan the sequence, starting time, and length of each initiative, as well as the assigned responsibility of the initiative in Tab 5. Tactic and Initiative Planning of the Data Architecture Tactic Roadmap Tool.
    3. The tool will a generate a Gantt chart based on the start and length of your initiatives.
    4. The Gantt chart is generated in Tab 7. Initiative Roadmap.
    Screenshot of the Data Architecture Tactic Roadmap Tool, Tab 5. Tactic and Initiative Planning. Tab 5. Tactic and Initiative Planning Screenshot of the Data Architecture Tactic Roadmap Tool, Tab 7. Initiative Roadmap. Tab 7. Initiative Roadmap

    Info-Tech Insight

    The activities that populate the roadmap can be taken as best practice activities. If you want an actionable, comprehensive, and prescriptive plan for optimizing your data architecture, fill in the timing of the activities and print the roadmap. This can serve as a rapid communication tool for your data architecture plan to the business and other architects.

    Optimizing data architecture relies on communication between the business and data workers

    Remember: Data architects bridge the gap between strategic and technical requirements of data.

    Visualization centering the 'Data Architect' as the bridge between 'Data Workers', 'Business', and 'Data & Applications'.

    Therefore, as you plan the data and its interactions with applications, it is imperative that you communicate the plan and its implications to the business and the data workers. Stock photo of coworkers communicating.
    Also remember: In Phase 1, you built your tactical data architecture optimization plan.
    Sample 1 of the Data Architecture Optimization Template. Sample 2 of the Data Architecture Optimization Template.
    Use this document to communicate your plan for data architecture optimization to both the business and the data workers. Socialize this document as a representation of your organization’s current data architecture as well as where it is headed in the future.

    Communicate your data architecture optimization plan to the business for approval

    Associated Activity icon 3.1.3 2 hours

    INPUT: Data Architecture Tactical Roadmap

    OUTPUT: Communication plan

    Materials: Data Architecture Optimization Template

    Participants: Data Architect, Business representatives, IT representatives

    Instructions

    Begin by presenting your plan and roadmap to the business units who participated in business interviews in activity 1.1.3 of Phase 1.

    If you receive feedback that suggests that you should make revisions to the plan, consult Info-Tech Research Group for suggestions on how to improve the plan.

    If you gain approval for the plan, communicate it to DBAs and other data workers.

    Iterative optimization and communication plan:
    Visualization of the Iterative optimization and communication plan. 'Start here' at 'Communicate Plan and Roadmap to the Business', and then continue in a cycle of 'Receive Approval or Suggested Modifications', 'Get Advice for Improvements to the Plan', 'Revise Plan', and back to the initial step until you receive 'Approval', then 'Present to Data Workers'.

    With a roadmap in place, the monetary authority followed a tactical and practical plan to repair outdated data architecture

    CASE STUDY

    Industry: Financial
    Source: Info-Tech Consulting
    Symbol for 'Monetary Authority Case Study'.

    Part 3

    After establishing the appropriate tactics based on its business driver, the monetary authority was able to identify its shortcomings and adopt resolutions to remedy the issues.

    Challenge

    A monetary authority was placed under new requirements where it would need to produce 6 different report types on its clients to a regulatory body within a window potentially as short as 1 hour.

    With its current capabilities, it could complete such a task in roughly 7 days.

    The organization’s data architecture was comprised of legacy systems that had poor searchability. Moreover, the data it worked with was scanned from paper, regularly incomplete and often inconsistent.

    Solution

    The solution first required the organization to establish the business driver behind the need to optimize its architecture. In this case, it would be compliance requirements.

    With Info-Tech’s methodology, the organization focused on three tiers: data sources, warehousing, and analytics.

    Several solutions were developed to address the appropriate lacking capabilities. Firstly, the creation of a data model for old and new systems. The implementation of governance principles and business rules for migration of any data. Additionally, proper indexing techniques and business data glossary were established. Lastly, data marts and sandboxes were designed for data accessibility and to enable a space for proper report building.

    Results

    With the solutions established, the monetary authority was given information it needed to build a comprehensive roadmap, and is currently undergoing the implementation of the plan to ensure it will experience its desired outcome – an optimized data architecture built with the capacity to handle external compliance requirements.

    Phase 3, Step 2: Manage Your Data Architecture Decisions and the Resulting Changes

    PHASE 3

    3.13.2
    Personalize Your Data Architecture RoadmapManage Your Data Architecture Decisions and the Resulting Changes

    This step will walk you through the following activities:

    • With a plan in place, document the major architectural decisions that have been and will be made to optimize data architecture.
    • Create a plan for change and release management, an essential function of the data architect role.

    This step involves the following participants:

    • Data Architect
    • Enterprise Architect

    Outcomes of this step

    • Resources for documenting and managing the inevitable change associated with updates to the organization’s data architecture environment.

    To implement data architecture changes, you must plan to accommodate the issues that come with change

    Once you have a plan in place, one the most challenging aspects of improving an organization is yet to come…overcoming change!

    “When managing change, the job of the data architect is to avoid unnecessary change and to encapsulate necessary change.

    You must provide motivation for simplifying change, making it manageable for the whole organization.” (Andrew Johnston, Independent Consultant)

    Stock photo of multiple hands placing app/website design elements on a piece of paper.

    Create roadmap

    Arrow pointing down.

    Communicate roadmap

    Arrow pointing down.

    Implement roadmap

    Arrow pointing down.

    Change management

    Use the Data Architecture Decision Template when architectural changes are made

    Supporting Tool icon 3.2 Data Architecture Decision Template
    Document the architectural decisions made to provide context around changes made to the organization’s data environment.

    The goal of this Data Architecture Decision Template is to provide data architects with a template for managing the changes that accompany major architectural decisions. As you work through the Build a Business-Aligned Data Architecture Optimization Strategy blueprint, you will create a plan for tactical initiatives that address the drivers of the business to optimize your data architecture. This plan will bring about changes to the organization’s data architecture that need change management considerations.

    Document any major changes to the organization’s data architecture that are required to evolve with the organization’s drivers. This will ensure that major architectural changes are documented, tracked, and that the context around the decision is maintained.

    “Environment is very chaotic nowadays – legacy apps, sprawl, ERPs, a huge mix and orgs are grappling with what our data landscape look like? Where are our data assets that we need to use?” (Andrew Johnston, Independent Consultant)

    Sample of the Data Architecture Decision Template.

    Use Info-Tech’s Data Architecture Decision Template to document any major changes in the organization’s data architecture.

    Leverage Info-Tech’s resources to smooth change management

    As changes to the architectural environment occur, data architects must stay ahead of the curve and plan the change management considerations that come with major architectural decisions.

    “When managing change, the job of the data architect is to avoid unnecessary change and to encapsulate necessary change.

    You must provide motivation for simplifying change, making it manageable for the whole organization.” (Andrew Johnston, Independent Consultant)

    See Info-Tech’s resources on change management to smooth changes:
    Banner for the blueprint set 'Optimize Change Management' with subtitle 'Turn and face the change with a right-sized change management process'.
    Sample of the Optimize Change Management blueprint.

    Change Management Blueprint

    Sample of the Change Management Roadmap Tool.

    Change Management Roadmap Tool

    Use Info-Tech’s resources for effective release management

    As changes to the architectural environment occur, data architects must stay ahead of the curve and plan the release management considerations around new hardware and software releases or updates.

    Release management is a process that encompasses the planning, design, build, configuration, and testing of hardware and software releases to create a defined set of release components (ITIL). Release activities can include the distribution of the release and supporting documentation directly to end users. See Info-Tech’s resources on Release Management to smooth changes:

    Banner for the blueprint set 'Take a Holistic View to Optimize Release Management' with subtitle 'Build trust by right-sizing your process using appropriate governance'.
    Samples of the Release Management blueprint.

    Release Management Blueprint

    Sample of the Release Management Process Standard Template.

    Release Management Process Standard Template

    If you want additional support, have our analysts guide you through this phase as part of an Info-Tech Workshop Associated Activity icon

    Book a workshop with our Info-Tech analysts:

    Photo of a Info-Tech analyst.
    • To accelerate this project, engage your IT team in an Info-Tech workshop with an Info-Tech analyst team.
    • Info-Tech analyst will join you and your team onsite at your location or welcome you to Info-Tech's historic Toronto office to participate in an innovative onsite workshop.
    • Contact your account manager (www.infotech.com/account), or email Workshops@InfoTech.com for more information.

    The following are sample activities that will be conducted by Info-Tech analysts with your team:

    3.1.1

    Sample of activity 3.1.2 'Determine the timing of your data architecture optimization activities'. Create your personalized roadmap of activities.

    In this activity, the facilitator will guide the team in evaluating practice gaps highlighted by the assessment, and compare these gaps at face value so general priorities can be documented. The same categories as in 3.1.1 are considered.

    3.1.3

    Sample of activity 3.1.3 'Communicate your Data Architecture Optimization Plan to the business for approval'. Communicate your data architecture optimization plan.

    The facilitator will help you to identify the optimal medium and timing for communicating your plan for optimizing your data architecture.

    Insight breakdown

    Insight 1

    • Data architecture needs to evolve along with the changing business landscape. There are four common business drivers that put most pressure on archaic architectures. As a result, the organization’s architecture must be flexible and responsive to changing business needs.

    Insight 2

    • Data architecture is not just about models.
      Viewing data architecture as just technical data modeling can lead to structurally unsound data that does not serve the business.

    Insight 3

    • Data is used differently across the layers of an organization’s data architecture, and the capabilities needed to optimize use of data change with it. Architecting and managing data from source to warehousing to presentation requires different tactics for optimal use.

    Summary of accomplishment

    Knowledge Gained

    • An understanding of what data architecture is, how data architects can provide value to the organization, and how data architecture fits into the larger enterprise architecture picture.
    • The capabilities required for optimization of the organization’s data architecture across the five tiers of the logical data architecture model.

    Processes Optimized

    • Prioritization and planning of data architect responsibilities across the five tiers of the five-tier logical data architecture model.
    • Roadmapping of tactics that address the most common business drivers of the organization.
    • Architectural change management.

    Deliverables Completed

    • Data Architecture Driver Pattern Identification Tool
    • Data Architecture Optimization Template
    • Data Architecture Trends Presentation
    • Data Architecture Roadmap Tool
    • Data Architecture Decision Template

    Research contributors and experts

    Photo of Ron Huizenga, Senior Product Manager, Embarcadero Technologies, Inc. Ron Huizenga, Senior Product Manager
    Embarcadero Technologies, Inc.

    Ron Huizenga has over 30 years of experience as an IT executive and consultant in enterprise data architecture, governance, business process reengineering and improvement, program/project management, software development, and business management. His experience spans multiple industries including manufacturing, supply chain, pipelines, natural resources, retail, healthcare, insurance, and transportation.

    Photo of Andrew Johnston, Architect, Independent Consultant. Andrew Johnston, Architect Independent Consultant

    An independent consultant with a unique combination of managerial, commercial, and technical skills, Andrew specializes in the development of strategies and technical architectures that allow businesses to get the maximum benefit from their IT resources. He has been described by clients as a "broad spectrum" architect, summarizing his ability to engage in many problems at many levels.

    Research contributors

    Internal Contributors
    Logo for Info-Tech Research Group.
    • Steven J. Wilson, Senior Director, Research & Advisory Services
    • Daniel Ko, Research Manager
    • Bernie Gilles, Senior Director, Research & Advisory Services
    External Contributors
    Logo for Embarcadero.
    Logo for Questa Computing. Logo for Geha.
    • Ron Huizenga, Embercardo Technologies
    • Andrew Johnston, Independent Consultant
    • Darrell Enslinger, Government Employees Health Association
    • Anonymous Contributors

    Bibliography

    Allen, Mark. “Get the ETL Out of Here.” MarkLogic. Sep, 2016. Web. 25 Apr 2017.[http://www.marklogic.com/blog/get-the-etl-out-of-here/]

    Anadiotis, George. “Streaming hot: Real-time big data architecture matters.” ZDNet. Jan, 2017. Web. 25 Apr 2017. [http://www.zdnet.com/article/streaming-hot-real-time-big-data-architecture-matters/]

    Aston, Dan. “The Economic value of Enterprise Architecture and How to Show It.” Erwin. Aug, 2016. Web. 20 Apr 2017. [http://erwin.com/blog/economic-value-enterprise-architecture-show/]

    Baer, Tony. “2017 Trends to Watch: Big Data.” Ovum. Nov, 2016. Web. 25 Apr 2017.

    Bmc. “Benefits & Advantages of Hadoop.” Bmc. Web. 25 Apr 2017. [http://www.bmcsoftware.ca/guides/hadoop-benefits-business-case.html]

    Boyd, Ryan, et al. “Relational vs. Graph Data Modeling” DZone. Mar 2016. Web. 25 Apr 2017. [https://dzone.com/articles/relational-vs-graph-data-modeling]

    Brahmachar, Satya. “Theme To Digital Transformation - Journey to Data Driven Enterprise” Feb, 2015. Web. 20 Apr 2017. [http://satyabrahmachari-thought-leader.blogspot.ca/2015/02/i-smac-theme-to-digital-transformation.html]

    Capsenta. “NoETL.” Capsenta. Web. 25 Apr 2017. [https://capsenta.com/wp-content/uploads/2015/03/Capsenta-Booklet.pdf]

    Connolly, Shaun. “Implementing the Blueprint for Enterprise Hadoop” Hortonworks. Apr, 2014. Web. 25 Apr 2017. https://hortonworks.com/blog/implementing-the-blue...

    Forbes. “Cloud 2.0: Companies Move From Cloud-First To Cloud-Only.” Forbes. Apr, 2017. Web. 25 Apr 2017. [https://www.forbes.com/sites/vmware/2017/04/07/cloud-2-0-companies-move-from-cloud-first-to-cloud-only/#5cd9d94a4d5e]

    Forgeat, Julien. “Lambda and Kappa.” Ericsson. Nov 2015. Web 25 Apr 2017. [https://www.ericsson.com/research-blog/data-knowledge/data-processing-architectures-lambda-and-kappa/]

    Grimes, Seth. “Is It Time For NoETL?” InformationWeek. Mar, 2010. Web. 25 Apr 2017. [http://www.informationweek.com/software/information-management/is-it-time-for-noetl/d/d-id/1087813]

    Gupta, Manav. et al. “How IB‹ leads in building big data analytics solutions in the cloud.” IBM. Feb, 2016. Web. 25 Apr 2017. [https://www.ibm.com/developerworks/cloud/library/cl-ibm-leads-building-big-data-analytics-solutions-cloud-trs/index.html#N102DE]

    “How To Build A Roadmap.” Hub Designs Magazine. Web 25 Apr 2017. [https://hubdesignsmagazine.com/2011/03/05/how-to-build-a-roadmap/]

    IBM. “Top industry use cases for stream computing.” IBM. Oct, 2015. Web. 25 Apr 2017. [https://www-01.ibm.com/common/ssi/cgi-bin/ssialias?htmlfid=IMW14704USEN]

    Mateos-Garcia, Juan, et al. “Skills Of The Datavores.” Nesta. July. 2015. Web. 8 Aug 2016. [https://www.nesta.org.uk/sites/default/files/skills_of_the_datavores.pdf].

    Maynard, Steven. “Analytics: Don’t Forget The Human Element” Forbes. 2015. Web. 20 Apr. 2017. [http://www.ey.com/Publication/vwLUAssets/EY-Forbes-Insights-Data-and-Analytics-Impact-Index-2015/$FILE/EY-Forbes-Insights-Data-and-Analytics-Impact-Index-2015.pdf]

    Neo4j. “From Relational to Neo4j.” Neo4j. Web. 25 Apr 2017. [https://neo4j.com/developer/graph-db-vs-rdbms/#_from_relational_to_graph_databases]

    NoETL “NoETL.” NoETL. Web. 25 Apr 2017. [http://noetl.org/]

    Nolan, Roger. “Digital Transformation: Is Your Data Management Ready?” Informatica. Jun, 2016. Web. 20 Apr 2017. [https://blogs.informatica.com/2016/06/10/digital-transformation-data-management-ready/#fbid=hmBYQgS6hnm]

    OpsClarity. “2016 State of Fast Data & Streaming Applications.” OpsClarity. Web. 25 Apr 2017. [https://www.opsclarity.com/wp-content/uploads/2016/07/2016FastDataSurvey.pdf]

    Oracle. “A Relational Database Overview.” Oracle. Web. 25 Apr 2017. [https://docs.oracle.com/javase/tutorial/jdbc/overview/database.html]

    Ponemon Institute LLC. “Big Data Cybersecurity Analytics Research Repor.t” Cloudera. Aug, 2016. Web. 25 Apr 2017. [https://www.cloudera.com/content/dam/www/static/documents/analyst-reports/big-data-cybersecurity-analytics-research-report.pdf]

    Sanchez, Jose Juan. “Data Movement Killed the BI Star.” DV Blog. May, 2016. Web. 20 Apr. 2017. [http://www.datavirtualizationblog.com/data-movement-killed-the-bi-star/]

    SAS. “Hadoop; What it is and why does it matter?” SAS. Web. 25 Apr 2017. [https://www.sas.com/en_ca/insights/big-data/hadoop.html#hadoopusers]

    Schumacher, Robin. “A Quick Primer on graph Databases for RDBMS Professionals.” Datastax. Jul, 2016. Web. 25 Apr 2017. [http://www.datastax.com/2016/07/quick-primer-on-graph-databases-for-rdbms-professionals]

    Swoyer, Steve. “It’s the End of the Data Warehouse as We Know It.” TDWI. Jan, 2017. Web. 20 Apr. 2017. [https://upside.tdwi.org/articles/2017/01/11/end-of-the-data-warehouse-as-we-know-it.aspx]

    Webber, Jim, and Ian Robinson. “The Top 5 Use Cases of Graph Databases.” Neo4j. 2015. Web. 25 Apr 2017. [http://info.neo4j.com/rs/773-GON-065/images/Neo4j_Top5_UseCases_Graph%20Databases.pdf]

    Zachman Framework. [https://www.zachman.com/]

    Zupan, Jane. “Survey of Big Data Decision Makers.” Attiv/o. May, 2016. Web. 20 Apr 2017. [https://www.attivio.com/blog/post/survey-big-data-decision-makers]

    Optimize Lead Generation With Lead Scoring

    • Buy Link or Shortcode: {j2store}557|cart{/j2store}
    • member rating overall impact: N/A
    • member rating average dollars saved: N/A
    • member rating average days saved: N/A
    • Parent Category Name: Marketing Solutions
    • Parent Category Link: /marketing-solutions
    • Prospective buyer traffic into digital marketing platforms has exploded.
    • Many freemium/low-cost digital marketing platforms lack lead scoring and nurturing functionality.
    • As a result, the volume of unqualified leads being delivered to outbound sellers has increased dramatically.
    • This has reduced sales productivity, frustrated prospective buyers, and raised the costs of lead generation.

    Our Advice

    Critical Insight

    • Lead scoring is a must-have capability for high-tech marketers.
    • Without lead scoring, marketers will see increased costs of lead generation and decreased SQL-to-opportunity conversion rates.
    • Lead scoring increases sales productivity and shortens sales cycles.

    Impact and Result

    • Align Marketing, Sales, and Inside Sales on your ideal customer profile.
    • Re-evaluate the assets and activities that compose your current lead generation engine.
    • Develop a documented methodology to ignore, nurture, or contact right away the leads in your marketing pipeline.
    • Deliver more qualified leads to sellers, raising sales productivity and marketing/lead-gen ROI.

    Optimize Lead Generation With Lead Scoring Research & Tools

    Start here – read the Executive Brief

    Read our concise Executive Brief to find out why you should optimize lead generation with lead scoring, review SoftwareReviews Advisory’s methodology, and understand the four ways we can support you in completing this project.

    Besides the small introduction, subscribers and consulting clients within this management domain have access to:

    1. Drive aligned vision for lead scoring

    Outline your plan, form your team, and plan marketing tech stack support.

    • Optimize Lead Generation With Lead Scoring – Phase 1: Drive an Aligned Vision for Lead Scoring

    2. Build and test your lead scoring model

    Set lead flow thresholds, define your ideal customer profile and lead generation engine components, and weight, score, test, and refine them.

    • Optimize Lead Generation With Lead Scoring – Phase 2: Build and Test Your Lead Scoring Model
    • Lead Scoring Workbook

    3. Apply your model to marketing apps and go live with better qualified leads

    Apply your lead scoring model to your lead management app, test it, validate the results with sellers, apply advanced methods, and refine.

    • Optimize Lead Generation With Lead Scoring – Phase 3: Apply Your Model to Marketing Apps and Go Live With Better Qualified Leads
    [infographic]

    Workshop: Optimize Lead Generation With Lead Scoring

    Workshops offer an easy way to accelerate your project. If you are unable to do the project yourself, and a Guided Implementation isn't enough, we offer low-cost delivery of our project workshops. We take you through every phase of your project and ensure that you have a roadmap in place to complete your project successfully.

    1 Drive Aligned Vision for Lead Scoring

    The Purpose

    Drive an aligned vision for lead scoring.

    Key Benefits Achieved

    Attain an aligned vision for lead scoring.

    Identify the steering committee and project team and clarify their roles and responsibilities.

    Provide your team with an understanding of how leads score through the marketing funnel.

    Activities

    1.1 Outline a vision for lead scoring.

    1.2 Identify steering committee and project team members.

    1.3 Assess your tech stack for lead scoring and seek advice from Info-Tech analysts to modernize where needed.

    1.4 Align on marketing pipeline terminology.

    Outputs

    Steering committee and project team make-up

    Direction on tech stack to support lead generation

    Marketing pipeline definitions alignment

    2 Buyer Journey and Lead Generation Engine Mapping

    The Purpose

    Define the buyer journey and map the lead generation engine.

    Key Benefits Achieved

    Align the vision for your target buyer and their buying journey.

    Identify the assets and activities that need to compose your lead generation engine.

    Activities

    2.1 Establish a buyer persona.

    2.2 Map your buyer journey.

    2.3 Document the activities and assets of your lead generation engine.

    Outputs

    Buyer persona

    Buyer journey map

    Lead gen engine assets and activities documented

    3 Build and Test Your Lead Scoring Model

    The Purpose

    Build and test your lead scoring model.

    Key Benefits Achieved

    Gain team alignment on how leads score and, most importantly, what constitutes a sales-accepted lead.

    Develop a scoring model from which future iterations can be tested.

    Activities

    3.1 Understand the Lead Scoring Grid and set your thresholds.

    3.2 Identify your ideal customer profile, attributes, and subattribute weightings – run tests.

    Outputs

    Lead scoring thresholds

    Ideal customer profile, weightings, and tested scores

    Test profile scoring

    4 Align on Engagement Attributes

    The Purpose

    Align on engagement attributes.

    Key Benefits Achieved

    Develop a scoring model from which future iterations can be tested.

    Activities

    4.1 Weight the attributes of your lead generation engagement model and run tests.

    4.2 Apply weightings to activities and assets.

    4.3 Test engagement and profile scenarios together and make any adjustments to weightings or thresholds.

    Outputs

    Engagement attributes and weightings tested and complete

    Final lead scoring model

    5 Apply Model to Your Tech Platform

    The Purpose

    Apply the model to your tech platform.

    Key Benefits Achieved

    Deliver better qualified leads to Sales.

    Activities

    5.1 Apply model to your marketing management/campaign management software and test the quality of sales-accepted leads in the hands of sellers.

    5.2 Measure overall lead flow and conversion rates through your marketing pipeline.

    5.3 Apply lead nurturing and other advanced methods.

    Outputs

    Model applied to software

    Better qualified leads in the hands of sellers

    Further reading

    Optimize Lead Generation With Lead Scoring

    In today’s competitive environment, optimizing Sales’ resources by giving them qualified leads is key to B2B marketing success.

    EXECUTIVE BRIEF

    Analyst Perspective

    Improve B2B seller win rates with a lead scoring methodology as part of your modern lead generation engine.

    The image contains a picture of Jeff Golterman.

    As B2B organizations emerge from the lowered demands brought on by COVID-19, they are eager to convert marketing contacts to sales-qualified leads with even the slightest signal of intent, but many sales cycles are wasted when sellers receive unqualified leads. Delivering highly qualified leads to sellers is still more art than science, and it is especially challenging without a way to score a contact profile and engagement. While most marketers capture some profile data from contacts, many will pass a contact over to Sales without any engagement data or schedule a demo with a contact without any qualifying profile data. Passing unqualified leads to Sales suboptimizes Sales’ resources, raises the costs per lead, and often results in lost opportunities. Marketers need to develop a lead scoring methodology that delivers better qualified leads to Field Sales scored against both the ideal customer profile (ICP) and engagement that signals lower-funnel buyer interest. To be successful in building a compelling lead scoring solution, marketers must work closely with key stakeholders to align the ICP asset/activity with the buyer journey. Additionally, working early in the design process with IT/Marketing Operations to implement lead management and analytical tools in support will drive results to maximize lead conversion rates and sales wins.

    Jeff Golterman

    Managing Director

    SoftwareReviews Advisory

    Executive Summary

    Your Challenge

    The affordability and ease of implementation of digital marketing tools have driven global adoption to record levels. While many marketers are fine-tuning the lead generation engine components of email, social media, and web-based advertising to increase lead volumes, just 32% of companies pass well-qualified leads over to outbound marketers or sales development reps (SDRs). At best, lead gen costs stay high, and marketing-influenced win rates remain suboptimized. At worst, marketing reputation suffers when poorly qualified leads are passed along to sellers.

    Common Obstacles

    Most marketers lack a methodology for lead scoring, and some lack alignment among Marketing, Product, and Sales on what defines a qualified lead. In their rush to drive lead generation, marketers often fail to “define and align” on the ICP with stakeholders, creating confusion and wasted time and resources. In the rush to adopt B2B marketing and sales automation tools, many marketers have also skipped the important steps to 1) define the buyer journey and map content types to support, and 2) invest in a consistent content creation and sourcing strategy. The wrong content can leave prospects unmotivated to engage further and cause them to seek alternatives.

    Info-Tech’s Approach

    To employ lead scoring effectively, marketers need to align Sales, Marketing, and Product teams on the definition of the ICP and what constitutes a Sales-accepted lead. The buyer journey needs to be mapped in order to identify the engagement that will move a lead through the marketing lead generation engine. Then the project team can score prospect engagement and the prospect profile attributes against the ICP to arrive at a lead score. The marketing tech stack needs to be validated to support lead scoring, and finally Sales needs to sign off on results.

    SoftwareReviews Advisory Insight:

    Lead scoring is a must-have capability for high-tech marketers. Without lead scoring, marketers will see increased costs of lead gen, decreased SQL to opportunity conversion rates, decreased sales productivity, and longer sales cycles.

    Who benefits from a lead scoring project?

    This Research Is Designed for:

    • Marketers and especially campaign managers who are:
      • Looking for a more precise way to score leads and deploy outbound marketing resources to optimize contacts-to-MQL conversion rates.
      • Looking for a more effective way to profile contacts raised by your lead gen engine.
      • Looking to use their lead management software to optimize lead scoring.
      • Starting anew to strengthen their lead generation engine and want examples of a typical engine, ways to identify buyer journey, and perform lead nurturing.

    This Research Will Help You:

    • Explain why having a lead scoring methodology is important.
    • Identify a methodology that will call for identifying an ICP against which to score prospect profiles behind each contact that engages your lead generation engine.
    • Create a process of applying weightings to score activities during contact engagement with your lead generation engine. Apply both scores to arrive at a contact/lead score.
    • Compare your current lead gen engine to a best-in-class example in order to identify gaps and areas for improvement and exploration.

    This Research Will Also Assist:

    • CMOs, Marketing Operations leaders, heads of Product Marketing, and regional Marketing leads who are stakeholders in:
      • Finding alternatives to current lead scoring approaches.
        • Altering current or evaluating new marketing technologies to support a refreshed lead scoring approaches.

    This Research Will Help Them:

    • Align stakeholders on an overall program of identifying target customers, building common understanding of what constitutes a qualified lead, and determining when to use higher-cost outbound marketing resources.
    • Deploy high-value applications that will improve core marketing metrics.

    Insight summary

    Continuous adjustment and improvement of your lead scoring methodology is critical for long-term lead generation engine success.

    • Building a highly functioning lead generation engine is an ongoing process and one that requires continual testing of new asset types, asset design, and copy variations. Buyer profiles change over time as you launch new products and target new markets.
    • Pass better qualified leads to Field Sales and improve sales win rates by taking these crucial steps to implement a better lead generation engine and a lead scoring methodology:
      • Make the case for lead scoring in your organization.
      • Establish trigger points that separate leads to ignore, nurture, qualify, or outreach/contact.
      • Identify your buyer journey and ICP through collaboration among Sales, Marketing, and Product.
      • Assess each asset and activity type across your lead generation engine and apply a weighting for each.
      • Test lead scenarios within our supplied toolkit and with stakeholders. Adjust weightings and triggers that deliver lead scores that make sense.
      • Work with IT/Marketing Operations to emulate your lead scoring methodology within your marketing automation/campaign management application.
      • Explore advanced methods including nurturing.
    • Use the Lead Scoring Workbook collaboratively with other stakeholders to design your own methodology, test lead scenarios, and build alignment across the team.

    Leading marketers who successfully implement a lead scoring methodology develop it collaboratively with stakeholders across Marketing, Sales, and Product Management. Leaders will engage Marketing Operations, Sales Operations, and IT early to gain support for the evaluation and implementation of a supporting campaign management application and for analytics to track lead progress throughout the Marketing and Sales funnels. Leverage the Marketing Lead Scoring Toolkit to build out your version of the model and to test various scenarios. Use the slides contained within this storyboard and the accompanying toolkit as a means to align key stakeholders on the ICP and to weight assets and activities across your marketing lead generation engine.

    What is lead scoring?

    Lead scoring weighs the value of a prospect’s profile against the ICP and renders a profile score. The process then weighs the value of the prospects activities against the ideal call to action (CTA) and renders an activity score. Combining the profile and activity scores delivers an overall score for the value of the lead to drive the next step along the overall buyer journey.

    EXAMPLE: SALES MANAGEMENT SOFTWARE

    • For a company that markets sales management software the ideal buyer is the head of Sales Operations. While the ICP is made up of many attributes, we’ll just score one – the buyer’s role.
    • If the prospect/lead that we wish to score has an executive title, the lead’s profile scores “High.” Other roles will score lower based on your ICP. Alongside role, you will also score other profile attributes (e.g. company size, location).
    • With engagement, if the prospect/lead clicked on our ideal CTA, which is “request a proposal,” our engagement would score high. Other CTAs would score lower.
    The image contains a screenshot of two examples of lead scoring. One example demonstrates. Profile Scoring with Lead Profile, and the second image demonstrates Activity Scoring and Lead Engagement.

    SoftwareReviews Advisory Insight:

    A significant obstacle to quality lead production is disagreement on or lack of a documented definition of the ideal customer profile. Marketers successful in lead scoring will align key stakeholders on a documented definition of the ICP as a first step in improving lead scoring.

    Use of lead scoring is in the minority among marketers

    The majority of businesses are not practicing lead scoring!

    Up to 66% of businesses don’t practice any type of lead scoring.

    Source: LeadSquared, 2014

    “ With lead scoring, you don’t waste loads of time on unworthy prospects, and you don’t ignore people on the edge of buying.”

    Source: BigCommerce

    “The benefits of lead scoring number in the dozens. Having a deeper understanding of which leads meet the qualifications of your highest converters and then systematically communicating with them accordingly increases both ongoing engagement and saves your internal team time chasing down inopportune leads.”

    – Joey Strawn, Integrated Marketing Director, in IndustrialMarketer.com

    Key benefit: sales resource optimization

    Many marketing organizations send Sales too many unqualified leads

    • Leads – or, more accurately, contacts – are not all qualified. Some are actually nothing more than time-wasters for sellers.
    • Leading marketers peel apart a contact into at least two dimensions – “who” and “how interested.”
      • The “who” is compared to the ICP and given a score.
      • The “how interested” measures contact activity – or engagement – within our lead gen engine and gives it a score.
    • Scores are combined; a contact with a low score is ignored, medium is nurtured, and high is sent to sellers.
    • A robust ICP, together with engagement scoring and when housed within your lead management software, prioritizes for marketers which contacts to nurture and gets hot leads to sellers more quickly.

    Optimizing Sales Resources Using Lead Scoring

    The image contains a screenshot of a graph to demonstrate optimizing sales resources with lead scoring.

    Lead scoring drives greater sales effectiveness

    When contacts are scored as “qualified leads” and sent to sellers, sales win rates and ROI climb

    • Contacts can be scored properly once marketers align with Sales on the ICP and work closely with colleagues in areas like product marketing and field marketing to assign weightings to lead gen activities.
    • When more qualified leads get into the hands of the salesforce, their win rates improve.
    • As win rates improve, and sellers are producing more wins from the same volume of leads, sales productivity improves and ROI on the marketing investment increases.

    “On average, organizations that currently use lead scoring experience a 77% lift in lead generation ROI, over organizations that do not currently use lead scoring.”

    – MarketingSherpa, 2012

    Average Lead Generation ROI by Use of Lead Scoring

    The image contains a screenshot of a graph to demonstrate the average lead generation ROI by using of lead scoring. 138% are currenting using lead scoring, and 78% are not using lead scoring.
    Source: 2011 B2B Marketing Benchmark Survey, MarketingSherpa
    Methodology: Fielded June 2011, N=326 CMOs

    SoftwareReviews’ Lead Scoring Approach

    1. Drive Aligned Vision for Lead Scoring

    2. Build and Test Your Lead Scoring Model

    3. Apply to Your Tech Platform and Validate, Nurture, and Grow

    Phase
    Steps

    1. Outline a vision for lead scoring and identify stakeholders.
    2. Assess your tech stack for lead scoring and seek advice from Info-Tech analysts to modernize where needed.
    3. Align on marketing pipeline terminology, buyer persona and journey, and lead gen engine components.
    1. Understand the Lead Scoring Grid and establish thresholds.
    2. Collaborate with stakeholders on your ICP, apply weightings to profile attributes and values, and test your model.
    3. Identify the key activities and assets of your lead gen engine, weight attributes, and run tests.
    1. Apply model to your marketing management software.
    2. Test quality of sales-accepted leads by sellers and measure conversion rates through your marketing pipeline.
    3. Apply advanced methods such as lead nurturing.

    Phase Outcomes

    1. Steering committee and stakeholder selection
    2. Stakeholder alignment
    3. Team alignment on terminology
    4. Buyer journey map
    5. Lead gen engine components and asset types documented
    1. Initial lead-stage threshold scores
    2. Ideal customer profile, weightings, and tested scores
    3. Documented activities/assets across your lead generation engine
    4. Test results to drive adjusted weightings for profile attributes and engagement
    5. Final model to apply to marketing application
    1. Better qualified leads in the hands of sellers
    2. Advanced methods to nurture leads

    Key Deliverable: Lead Scoring Workbook

    The workbook walks you through a step-by-step process to:

    • Identify your team.
    • Identify the lead scoring thresholds.
    • Define your IPC.
    • Weight the activities within your lead generation engine.
    • Run tests using lead scenarios.

    Tab 1: Team Composition

    Consider core functions and form a cross-functional lead scoring team. Document the team’s details here.

    The image contains a screenshot of the Lead Scoring Workbook, Tab 1.

    Tab 2: Threshold Setting

    Set your initial threshold weightings for profile and engagement scores.

    The image contains a screenshot of the Lead Scoring Workbook, Tab 2.

    Tab 3:

    Establish Your Ideal Customer Profile

    Identify major attributes and attribute values and the weightings of both. You’ll eventually score your leads against this ICP.

    Record and Weight Lead Gen Engine Activities

    Identify the major activities that compose prospect engagement with your lead gen engine. Weight them together as a team.

    Test Lead Profile Scenarios

    Test actual lead profiles to see how they score against where you believe they should score. Adjust threshold settings in Tab 2.

    Test Activity Engagement Scores

    Test scenarios of how contacts navigate your lead gen engine. See how they score against where you believe they should score. Adjust thresholds on Tab 2 as needed.

    Review Combined Profile and Activity Score

    Review the combined scores to see where on your lead scoring matrix the lead falls. Make any final adjustments to thresholds accordingly.

    The image contains screenshots of the Lead Scoring Workbook, Tab 3.

    Several ways we help you build your lead scoring methodology

    DIY Toolkit Guided Implementation Workshop Consulting

    "Our team has already made this critical project a priority, and we have the time and capability, but some guidance along the way would be helpful."

    "Our team knows that we need to fix a process, but we need assistance to determine where to focus. Some check-ins along the way would help keep us on track."

    "We need to hit the ground running and get this project kicked off immediately. Our team has the ability to take this over once we get a framework and strategy in place."

    "Our team does not have the time or the knowledge to take this project on. We need assistance through the entirety of this project."

    • Begin your project using the step-by-step process outlined in this blueprint.
    • Leverage the accompanying workbook.
    • Launch inquiries with the analyst who wrote the research.
    • Kick off your project with an inquiry with the authoring analyst and your engagement manager.
    • Additional inquiries will guide you through each step.
    • Leverage the blueprint and toolkit.
    • Reach out to your engagement manager.
    • During a half-day workshop the authoring analyst will guide you and your team to complete your lead scoring methodology.
    • Reach out to your engagement manager.
    • We’ll lead the engagement to structure the process, gather data, interview stakeholders, craft outputs, and organize feedback and final review.

    Guided Implementation

    What does a typical GI on this topic look like?

    Phase 1

    Phase 2

    Phase 3

    Call #1: Collaborate on vision for lead scoring and the overall project.

    Call #2: Identify the steering committee and the rest of the team.

    Call #3: Discuss app/tech stack support for lead scoring. Understand key marketing pipeline terminology and the buyer journey.

    Call #4: Discuss your ICP, apply weightings, and run test scenarios.

    Call #5: Discuss and record lead generation engine components.

    Call #6: Understand the Lead Scoring Grid and set thresholds for your model.

    Call #7: Identify your ICP, apply weightings to attributes, and run tests.

    Call #8: Weight the attributes of engagement activities and run tests. Review the application of the scoring model on lead management software.

    Call #9: Test quality of sales-accepted leads in the hands of sellers. Measure lead flow and conversion rates through your marketing pipeline.

    Call #10: Review progress and discuss nurturing and other advanced topics.

    A Guided Implementation (GI) is series of calls with a SoftwareReviews Advisory analyst to help implement our best practices in your organization. For guidance on marketing applications, we can arrange a discussion with an Info-Tech analyst. Your engagement managers will work with you to schedule analyst calls.

    Workshop Overview

    Accelerate your project with our facilitated SoftwareReviews Advisory workshops

    Day 1

    Day 2

    Day 3

    Day 4

    Day 5

    Drive Aligned Vision for Lead Scoring

    Buyer Journey and Lead Gen Engine Mapping

    Build and Test Your Lead Scoring Model

    Align on Engagement Attributes

    Apply to Your Tech Platform

    Activities

    1.1 Outline a vision for lead scoring.

    1.2 Identify steering committee and project team members.

    1.3 Assess your tech stack for lead scoring and seek advice from Info-Tech analysts to modernize where needed.

    1.4 Align on marketing pipeline terminology.

    2.1 Establish a buyer persona (if not done already).

    2.2 Map your buyer journey.

    2.3 Document the activities and assets of your lead gen engine.

    3.1 Understand Lead Scoring Grid and set your thresholds.

    3.2 Identify ICP attribute and sub-attribute weightings. Run tests.

    4.1 Weight the attributes of your lead gen engagement model and run tests.

    4.2 Apply weightings to activities and assets.

    4.3 Test engagement and profile scenarios together and adjust weightings and thresholds as needed.

    5.1 Apply model to your campaign management software and test quality of sales-accepted leads in the hands of sellers.

    5.2. Measure overall lead flow and conversion rates through your marketing pipeline.

    5.3 Apply lead nurturing and other advanced methods.

    Deliverables

    1. Steering committee & project team composition
    2. Direction on tech stack to support lead gen
    3. Alignment on marketing pipeline definitions
    1. Buyer (persona if needed) journey map
    2. Lead gen engine assets and activities documented
    1. Lead scoring thresholds
    2. ICP, weightings, and tested scores
    3. Test profile scoring
    1. Engagement attributes and weightings tested and complete
    2. Final lead scoring model
    1. Model applied to your marketing management/ campaign management software
    2. Better qualified leads in the hands of sellers

    Phase 1

    Drive an Aligned Vision for Lead Scoring

    Phase 1

    Phase 2

    Phase 3

    1.1 Establish a cross-functional vision for lead scoring

    1.2 Asses your tech stack for lead scoring (optional)

    1.3 Catalog your buyer journey and lead gen engine assets

    2.1 Start building your lead scoring model

    2.2 Identify and verify your IPC and weightings

    2.3 Establish key lead generation activities and assets

    3.1 Apply model to your marketing management software

    3.2 Test the quality of sales-accepted leads

    3.3 Apply advanced methods

    This phase will walk you through the following activities:

    • Solidify your vision for lead scoring.
    • Achieve stakeholder alignment.
    • Assess your tech stack.

    This phase involves the following stakeholders:

    • Field Marketing/Campaign Manager
    • CMO
    • Product Marketing
    • Product Management
    • Sales Leadership/Sales Operations
    • Inside Sales leadership
    • Marketing Operations/IT
    • Digital Platform leadership

    Step 1.1

    Establish a Cross-Functional Vision for Lead Scoring

    Activities

    1.1.1 Identify stakeholders critical to success

    1.1.2 Outline the vision for lead scoring

    1.1.3 Select your lead scoring team

    This step will walk you through the following activities:

    • Discuss the reasons why lead scoring is important.
    • Review program process.
    • Identify stakeholders and team.

    This step involves the following participants:

    • Stakeholders
    • Project sponsors and leaders

    Outcomes of this step

    • Stakeholder alignment on vision of lead scoring
    • Stakeholders described and team members recorded
    • A documented buyer journey and map of your current lead gen engine

    1.1.1 Identify stakeholders critical to success

    1 hour

    1. Meet to identify the stakeholders that should be included in the project’s steering committee.
    2. Finalize selection of steering committee members.
    3. Contact members to ensure their willingness to participate.
    4. Document the steering committee members and the milestone/presentation expectations for reporting project progress and results
    Input Output
    • Stakeholder interviews
    • List of business process owners (lead management, inside sales lead qualification, sales opportunity management, marketing funnel metric measurement/analytics)
    • Lead generation/scoring stakeholders
    • Steering committee members
    Materials Participants
    • N/A
    • Initiative Manager
    • CMO, Sponsoring Executive
    • Departmental Leads – Sales, Marketing, Product Marketing, Product Management (and others)
    • Marketing Applications Director
    • Senior Digital Business Analyst

    SoftwareReviews Advisory Insight:

    B2B marketers that lack agreement among Marketing, Sales, Inside Sales, and lead management supporting staff of what constitutes a qualified lead will squander precious time and resources throughout the customer acquisition process.

    1.1.2 Outline the vision for lead scoring

    1 hour

    1. Convene a meeting of the steering committee and initiative team members who will be involved in the lead scoring project.
    • Using slides from this blueprint, understand the definition of lead scoring, the value of lead scoring to the organization, and the overall lead scoring process.
    • Understand the teams’ roles and responsibilities and help your Marketing Operations/IT colleagues understand some of the technical requirements needed to support lead scoring.
    • This is important because as the business members of the team are developing the lead scoring approach on paper, the technical team can begin to evaluate lead management apps within which your lead scoring model will be brought to life.
    Input Output
    • Slides to explain lead scoring and the lead scoring program
    • An understanding of the project among key stakeholders
    Materials Participants
    • Slides taken from this blueprint. We suggest slides from the Executive Brief (slides 3-16) and any others depending on the team’s level of familiarity.
    • Initiative Manager
    • CMO, Sponsoring Executive
    • Departmental leads from Sales, Marketing, Product Marketing, Product Management (and others)
    • Marketing Applications Director
    • Senior Digital Business Analyst

    SoftwareReviews Advisory Insight:

    While SMBs can implement some form of lead scoring when volume is very low and leads can be scored by hand, lead scoring and effective lead management cannot be performed without investment in digital platforms and lead management software and integration with customer relationship management (CRM) applications in the hands of inside and field sales staff. Marketers should plan and budget for the right combination of applications and tools to be in place for proper lead management.

    Lead scoring stakeholders

    Developing a common stakeholder understanding of the ICP, the way contact profiles are scored, and the way activities and asset engagement in your lead generation engine are scored will strengthen alignment between Marketing, Sales and Product Management.

    Title

    Key Stakeholders Within a Lead Generation/Scoring Initiative

    Lead Scoring Sponsor

    • Owns the project at the management/C-suite level
    • Responsible for breaking down barriers and ensuring alignment with organizational strategy
    • CMO, VP of Marketing, CEO (in SMB providers)

    Lead Scoring Initiative Manager

    • Typically a senior member of the marketing team
    • Responsible for preparing and managing the project plan and monitoring the project team’s progress
    • Marketing Manager or a field marketing team member who has strong program management skills, has run large-scale B2B generation campaigns, and is familiar with the stakeholder roles and enabling technologies

    Business Leads

    • Works alongside the lead scoring initiative manager to ensure that the strategy is aligned with business needs
    • In this case, likely to be a marketing lead
    • Marketing Director

    Digital, Marketing/Sales Ops/IT Team

    • Composed of individuals whose application and technology tools knowledge and skills are crucial to lead generation success
    • Responsible for understanding the business requirements behind lead generation and the requirements in particular to support lead scoring and the evaluation, selection, and implementation of the supporting tech stack – apps, website, analytics, etc.
    • Project Manager, Business Lead, CRM Manager, Integration Manager, Marketing Application SMEs, Sales Application

    Steering Committee

    • Composed of C-suite/management-level individuals who act as the lead generation process decision makers
    • Responsible for validating goals and priorities, defining the scope, enabling adequate resourcing, and managing change especially among C-level leaders in Sales & Product
    • Executive Sponsor, Project Sponsor, CMO, Business Unit SMEs

    SoftwareReviews Advisory Insight:

    Marketers managing the lead scoring initiative must include Product Marketing, Sales, Inside Sales, and Product Management. And given that world-class B2B lead generation engines cannot run without technology enablement, Marketing Operations/IT – those that are charged with enabling marketing and sales – must also be part of the decision making and implementation process of lead scoring and lead generation.

    1.1.3 Select your lead scoring team

    30 minutes

    1. The CMO and other key stakeholders should discuss and determine who will be involved in the lead scoring project.
    • Business leaders in key areas – Product Marketing, Field Marketing, Digital Marketing, Inside Sales, Sales, Marketing Ops, Product Management, and IT – should be involved.
  • Document the members of your lead scoring team in tab 1 of the Lead Scoring Workbook.
    • The size of the team will vary depending on your initiative and size of your organization.
    InputOutput
    • Stakeholders
    • List of lead scoring team members
    MaterialsParticipants
    • Lead Scoring Workbook
    • Initiative Manager
    • CMO, Sponsoring Executive
    • Departmental Leads – Sales, Marketing, Product Marketing, Product Management (and others)
    • Marketing Applications Director
    • Senior Digital Business Analyst

    Download the Lead Scoring Workbook

    Lead scoring team

    Consider the core team functions when composing the lead scoring team. Form a cross-functional team (i.e. across IT, Marketing, Sales, Service, Operations) to create a well-aligned lead management/scoring strategy. Don’t let your core team become too large when trying to include all relevant stakeholders. Carefully limit the size of the team to enable effective decision making while still including functional business units.

    Required Skills/Knowledge

    Suggested Team Members

    Business

    • Understanding of the customer
    • Understanding of brand
    • Understanding of multichannel marketing: email, events, social
    • Understanding of lead qualification
    • Field Marketing/Campaign Lead
    • Product Marketing
    • Sales Manager
    • Inside Sales Manager
    • Content Marketer/Copywriter

    IT

    • Campaign management application capabilities
    • Digital marketing
    • Marketing and sales funnel Reporting/metrics
    • Marketing Application Owners
    • CRM/Sales Application Owners
    • Marketing Analytics Owners
    • Digital Platform Owners

    Other

    • Branding/creative
    • Social
    • Change management
    • Creative Director
    • Social Media Marketer

    Step 1.2 (Optional)

    Assess Your Tech Stack for Lead Scoring

    Our model assumes you have:

    1.2.1 A marketing application/campaign management application in place that accommodates lead scoring.

    1.2.2 Lead management software integrated with the sales automation/CRM tool in the hands of Field Sales.

    1.2.3 Reporting/analytics that spans the entire lead generation pipeline/funnel.

    Refer to the following three slides if you need guidance in these areas.

    This step will walk you through the following activities:

    • Confirm that you have your tech stack in place.
    • Set up an inquiry with an Info-Tech analyst should you require guidance on evaluating lead pipeline reporting, CRM, or analytics applications.

    This step involves the following participants:

    • Stakeholders
    • Project sponsors and leaders

    Outcomes of this step

    • Understanding of what new application and technology support is required to support lead scoring.

    SoftwareReviews Advisory Insight:

    Marketers that collaborate closely with Marketing Ops/IT early in the process of lead scoring design will be best able to assess whether current marketing applications and tools can support a full lead scoring capability.

    1.2.1 Plan technology support for marketing management apps

    Work with Marketing Ops and IT early to evaluate application enablement for lead management, including scoring

    A thorough evaluation takes months – start early

    • Work closely with Marketing Operations (or the team that manages the marketing apps and digital platforms) as early as possible to socialize your approach to lead scoring.
    • Work with them on a set of updated requirements for selecting a marketing management suite or for changes to existing apps and tools to support your lead scoring approach that includes lead tracking and marketing funnel analytics.
    • Access the Info-Tech blueprint Select a Marketing Management Suite, along with analyst inquiry support during the requirements definition, vendor evaluation, and vendor selection phases. Use the SoftwareReviews Marketing Management Data Quadrant during vendor evaluation and selection.

    SoftwareReviews Marketing Management Data Quadrant

    The image contains a screenshot of the Marketing Management Data Quadrant.

    1.2.2 Plan technology support for sales opportunity management

    Work with Marketing Ops and IT early to evaluate applications for sales opportunity management

    A thorough evaluation takes months – start early

    • Work closely with Sales Operations as early as possible to socialize your approach to lead scoring and how lead management must integrate with sales opportunity management to manage the entire marketing and sales funnel management process.
    • Work with them on a set of updated requirements for selecting a sales opportunity management application that integrates with your marketing management suite or for changes to existing apps and tools to support your lead management and scoring approach that support the entire marketing and sales pipeline with analytics.

    Access the Info-Tech blueprint Select and Implement a CRM Platform, along with analyst inquiry support during the requirements definition, vendor evaluation, and vendor selection phases. Use the SoftwareReviews CRM Data Quadrant during vendor evaluation and selection.

    SoftwareReviews Customer Relationship Management Data Quadrant

    The image contains a screenshot of the SoftwareReviews Customer Relationship Management Data Quadrant.

    1.2.3 Plan analytics support for marketing pipeline analysis

    Work with Marketing Ops early to evaluate analytics tools to measure marketing and sales pipeline conversions

    A thorough evaluation takes weeks – start early

    • Work closely with Marketing and Sales Operations as early as possible to socialize your approach to measuring the lifecycle of contacts through to wins across the entire marketing and sales funnel management process.
    • Work with them on a set of updated requirements for selecting tools that can support the measurement of conversion ratios from contact to MQL, SQL, and opportunity to wins. Having this data enables you to measure improvement in component parts to your lead generation engine.
    • Access the Info-Tech blueprint Select and Implement a Reporting and Analytics Solution, along with analyst inquiry support during the requirements definition, vendor evaluation and vendor selection phases. Use the SoftwareReviews Best Business intelligence & Analytics Software Data Quadrant as well during vendor evaluation and selection.

    SoftwareReviews Business Intelligence Data Quadrant

    The image contains a screenshot of the Software Reviews Business Intelligent Quadrant.

    Step 1.3

    Catalog Your Buyer Journey and Lead Gen Engine Assets

    Activities

    1.3.1 Review marketing pipeline terminology

    1.3.2 Describe your buyer journey

    1.3.3 Describe your awareness and lead generation engine

    This step will walk you through the following activities:

    • Discuss marketing funnel terminology.
    • Describe your buyer journey.
    • Catalog the elements of your lead generation engine.

    This step involves the following participants:

    • Stakeholders

    Outcomes of this step

    • Stakeholder alignment on terminology, your buyer journey, and elements of your lead generation engine

    1.3.1 Review marketing pipeline terminology

    30 minutes

    1. We assume for this model the following:
      1. Our primary objective is to deliver more, and more-highly qualified, sales-qualified leads (SQLs) to our salesforce. The salesforce will accept SQLs and after further qualification turn them into opportunities. Sellers work opportunities and turn them into wins. Wins that had first/last touch attribution within the lead gen engine are considered marketing-influenced wins.
      2. This model assumes the existence of sales development reps (SDRs) whose mission it is to take marketing-qualified leads (MQLs) from the lead generation engine and further qualify them into SQLs.
      3. The lead generation engine takes contacts – visitors to activities, website, etc. – and scores them based on their profile and engagement. If the contact scores at or above the designated threshold, the lead generation engine rates it as an MQL and passes it along to Inside Sales/SDRs. If the contact scores above a certain threshold and shows promise, it is further nurtured. If the contact score is low, it is ignored.
    2. If an organization does not possess a team of SDRs or Inside Sales, you would adjust your version of the model to, for example, raise the threshold for MQLs, and when the threshold is reached the lead generation engine would pass the lead to Field Sales for further qualification.

    Stage

    Characteristics

    Actions

    Contact

    • Unqualified
    • No/low activity

    Nurture

    SDR Qualify

    Send to Sales

    Close

    MQL

    • Profile scores high
    • Engagement strong

    SQL

    • Profile strengthened
    • Demo/quote/next step confirmed

    Oppt’y

    • Sales acceptance
    • Sales opportunity management

    Win

    • Deal closed

    SoftwareReviews Advisory Insight:

    Score leads in a way that makes it crystal clear whether they should be ignored, further nurtured, further qualified, or go right into a sellers’ hands as a super hot lead.

    1.3.2 Describe your buyer journey

    1. Understand the concept of the buyer journey:
      1. Typically Product Marketing is charged with establishing deep understanding of the target buyer for each product or solution through a complete buyer persona and buyer journey map. The details of how to craft both are covered in the upcoming SoftwareReviews Advisory blueprint Craft a More Comprehensive Go-to-Market Strategy. However, we share our Buyer Journey Template here (on the next slide) to illustrate the connection between the buyer journey and the lead generation and scoring processes.
      2. Marketers and campaigners developing the lead scoring methodology will work closely with Product Marketing, asking them to document the buyer journey.
      3. The value of the buyer journey is to guide asset/content creation, nurturing strategy and therefore elements of the lead generation engine such as web experience, email, and social content and other elements of engagement.
      4. The additional value of having a buyer persona is to also inform the ICP, which is an essential element of lead scoring.
      5. For the purposes of lead scoring, use the template on the next slide to create a simple form of the buyer journey. This will guide lead generation engine design and the scoring of activities later in our blueprint.

    2 hours

    On the following slide:

    1. Tailor this template to suit your buyer journey. Text in green is yours to modify. Text in black is instructional.
    2. Your objective is to use the buyer journey to identify asset types and a delivery channel that once constructed/sourced and activated within your lead gen engine will support the buyer journey.
    3. Keep your buyer journey updated based on actual journeys of sales wins.
    4. Complete different buyer journeys for different product areas. Complete these collaboratively with stakeholders for alignment.

    SoftwareReviews Advisory Insight:

    Establishing a buyer journey is one of the most valuable tools that, typically, Product Marketing produces. Its use helps campaigners, product managers, and Inside and Field Sales. Leading marketers keep journeys updated based on live deals and characteristics of wins.

    Buyer Journey Template

    Personas: [Title] e.g. “BI Director”

    The image contains a screenshot of the describe persona level as an example.

    [Persona name] ([levels it includes from arrows above]) Buyer’s Journey for [solution type] Vendor Selection

    The image contains a screenshot of the Personas Type example to demonstrate a specific IT role, end use in a relevant department.

    1.3.3 Describe Your Awareness and Lead Gen Engine

    1. Understand the workings of a typical awareness and lead generation engine. Reference the image of a lead gen engine on the following slide when reviewing our guidance below:
      1. In our lead scoring example found in the Lead Scoring Workbook, tab 3, “Weight and Test,” we use a software company selling a sales automation solution, and the engagement activities match with the Typical Awareness and Lead Gen Engine found on the following slide. Our goal is to match a visual representation of a lead gen and awareness engine with the activity scoring portion of lead scoring.
      2. At the top of the Typical Awareness and Lead Generation Engine image, the activities are activated by a team of various roles: digital manager (new web pages), campaign manager (emails and paid media), social media marketer (organic and paid social), and events marketing manager (webinars).
      3. “Awareness” – On the right, the slide shows additional awareness activities driven by the PR/Corporate Comms and Analyst Relations teams.*
      4. The calls to action (CTAs) found in the outreach activities are illustrated below the timeline. The CTAs are grouped and are designed to 1) drive profile capture data via a main sales form fill, and 2) drive engagement that corresponds to the Education, Solution, and Selection buyer journey phases outlined on the prior slide. Ensure you have fast paths to get a hot lead – request a demo – directly to Field Sales when profiles score high.

    * For guidance on best practices in engaging industry analysts, contact your engagement manager to schedule an inquiry with our expert in this area. during that inquiry, we will share best practices and recommended analyst engagement models.

    Lead Scoring Workbook

    2 hours

    On the following slide:

    1. Tailor the slide to describe your lead generation engine as you will use it when you get to latter steps to describe the activities in your lead gen engine and weight them for lead scoring.
    2. Use the template to see what makes up a typical lead gen and awareness building engine. Record your current engine parts and see what you may be missing.
    3. Note: The “Goal” image in the upper right of the slide is meant as a reminder that marketers should establish a goal for SQLs delivered to Field Sales for each campaign.

    SoftwareReviews Advisory Insight:

    Marketing’s primary mission is to deliver marketing-influenced wins (MIWs) to the company. Building a compelling awareness and lead gen engine must be done with that goal in mind. Leaders are ruthless in testing – copy, email subjects, website navigation, etc. – to fine-tune the engine and staying highly collaborative with sellers to ensure high value lead delivery.

    Typical Awareness and Lead Gen Engine

    Understand how a typical lead generation engine works. Awareness activities are included as a reference. Use as a template for campaigns.

    The image contains a screenshot of a diagram to demonstrate how a lead generation engine works.

    Phase 2

    Build and Test Your Lead Scoring Model

    Phase 1

    Phase 2

    Phase 3

    1.1 Establish a cross-functional vision for lead scoring

    1.2 Asses your tech stack for lead scoring (optional)

    1.3 Catalog your buyer journey and lead gen engine assets

    2.1 Start building your lead scoring model

    2.2 Identify and verify your IPC and weightings

    2.3 Establish key lead generation activities and assets

    3.1 Apply model to your marketing management software

    3.2 Test the quality of sales-accepted leads

    3.3 Apply advanced methods

    This phase will walk you through the following activities:

    1. Understand the Lead Scoring Grid and establish thresholds.
    2. Collaborate with stakeholders on your ICP, apply weightings to profile attributes and values, and test.
    3. Identify the key activities and assets of your lead gen engine, weight attributes, and run tests.

    This phase involves the following participants:

    • Field Marketing/Campaign Manager
    • Product Marketing
    • Sales Leadership/Sales Operations
    • Inside Sales leadership
    • Marketing Operations/IT
    • Digital Platform leadership

    Step 2.1

    Start Building Your Lead Scoring Model

    Activities

    2.1.1 Understand the Lead Scoring Grid

    2.1.2 Identify thresholds

    This step will walk you through the following activities:

    • Discuss the concept of the thresholds for scoring leads in each of the various states – “ignore,” “nurture,” “qualify,” “send to sales.”
    • Open the Lead Scoring Workbook and validate your own states to suit your organization.
    • Arrive at an initial set of threshold scores.

    This step involves the following participants:

    • Stakeholders

    Outcomes of this step

    • Stakeholder alignment on stages
    • Stakeholder alignment on initial set of thresholds

    2.1.1 Understand the Lead Scoring Grid

    30 minutes

    1. Understand how lead scoring works and our grid is constructed.
    2. Understand the two important areas of the grid and the concept of how the contact’s scores will increase as follows:
      1. Profile – as the profile attributes of the contact approaches that of the ICP we want to score the contact/prospect higher. Note: Step 1.3 walks you through creating your ICP.
      2. Engagement – as the contact/prospect engages with the activities (e.g. webinars, videos, events, emails) and assets (e.g. website, whitepapers, blogs, infographics) in our lead generation engine, we want to score the contact/prospect higher. Note: You will describe your engagement activities in this step.
    3. Understand how thresholds work:
      1. Threshold percentages, when reached, trigger movement of the contact from one state to the next – “ignore,” “nurture,” “qualify with Inside Sales,” and “send to sales.”
    The image contains a screenshot of an example of the lead scoring grid, as described in the text above.

    2.1.2 Identify thresholds

    30 minutes

    We have set up a model Lead Scoring Grid – see Lead Scoring Workbook, tab 2, “Identify Thresholds.”

    Set your thresholds within the Lead Scoring Workbook:

    • Set your threshold percentages for ”Profile” and “Engagement.”
    • You will run test scenarios for each in later steps.
    • We suggest you start with the example percentages given in the Lead Scoring Workbook and plan to adjust them during testing in later steps.
    • Define the “Send to Sales,” “Qualify With Inside Sales,” “Nurture,” and “Ignore” zones.

    SoftwareReviews Advisory Insight:

    Clarify that all-important threshold for when a lead passes to your expensive and time-starved outbound sellers.

    The image contains a screenshot of the Lead Scoring Workbook, tab 2 demonstrating the Lead Scoring Grid.

    Lead Scoring Workbook

    Step 2.2

    Identify and Verify Your Ideal Customer Profile and Weightings

    Activities

    2.2.1 Identify your ideal customer profile

    2.2.2 Run tests to validate profile weightings

    This step will walk you through the following activities:

    • Identify the attributes that compose the ICP.
    • Identify the values of each attribute and their weightings.
    • Test different contact profile scenarios against what actually makes sense.
    • Adjust weightings if needed.

    This step involves the following participants:

    • Stakeholders

    Outcomes of this step

    • Stakeholder alignment on ICP
    • Stakeholder alignment on weightings given to attributes
    • Tested results to verify thresholds and cores

    2.2.1 Identify your ideal customer profile

    Collaborate with stakeholders to understand what attributes best describe your ICP. Assign weightings and subratings.

    2 hours

    1. Choose attributes such as job role, organization type, number of employees/potential seat holders, geographical location, interest area, etc., that describe the ideal profile of a target buyer. Best practice sees marketers choosing attributes based on real wins.
    2. Some marketers compare the email domain of the contact to a target list of domains. In the Lead Scoring Workbook, tab 3, “Weight and Test,” we provide an example profile for a “Sales Automation Software” ICP.
    3. Use the workbook as a template, remove our example, and create your own ICP attributes. Then weight the attributes to add up to 100%. Add in the attribute values and weight them. In the next step you will test scenarios.

    SoftwareReviews Advisory Insight:

    Marketers who align with colleagues in areas such as Product Marketing, Sales, Inside Sales, Sales Training/Enablement, and Product Managers and document the ICP give their organizations a greater probability of lead generation success.

    The image contains a screenshot of tab 3, demonstrating the weight and test with the example profile.

    Lead Scoring Workbook

    2.2.2 Run tests to validate profile weightings

    Collaborate with stakeholders to run different profile scenarios. Validate your model including thresholds.

    The image contains a screenshot of tab 3 to demonstrate the next step of running tests to validate profile weightings.

    SoftwareReviews Advisory Insight:

    Keep your model simple in the interest of fast implementation and to drive early learnings. The goal is not to be perfect but to start iterating toward success. You will update your scoring model even after going into production.

    2 hours

    1. Choose scenarios of contact/lead profile attributes by placing a “1” in the “Attribute” box shown at left.
    2. Place your estimate of how you believe the profile should score in the box to the right of “Estimated Profile State.” How does the calculated state, beneath, compare to the estimated state?
    3. In cases where the calculated state differs from your estimated state, consider weighting the profile attribute differently to match.
    4. If you find estimates and calculated states off dramatically, consider changing previously determined thresholds in tab 2, “Identify Thresholds.” Test multiple scenarios with your team.

    Lead Scoring Workbook

    Step 2.3

    Establish Key Lead Generation Activities and Assets

    Activities

    2.3.1 Establish activities, attribute values, and weights

    2.3.2 Run tests to evaluate activity ratings

    This step will walk you through the following activities:

    • Identify the activities/asset types in your lead gen engine.
    • Weight each attribute and define values to score for each one.
    • Run tests to ensure your model makes sense.

    This step involves the following participants:

    • Stakeholders
    • Project sponsors and leaders

    Outcomes of this step

    • Final stakeholder alignment on which assets compose your lead generation engine
    • Scoring model tested

    2.3.1 Establish activities, attribute values, and weights

    2 hours

    1. Catalog the assets and activities that compose your lead generation engine outlined in Activity 1.3.3. Identify their attribute values and weight them accordingly.
    2. Consider weighting attributes and values according to how close that asset gets to conveying your ideal call to action. For example, if your ideal CTA is “schedule a demo” and the “click” was submitted in the last seven days, it scores 100%. Take time decay into consideration. If that same click was 60 days ago, it scores less – maybe 60%.
    3. Different assets convey different intent and therefore command different weightings; a video comparing your offering against the competition, considered a down funnel asset, scores higher than the company video, considered a top-of-the-funnel activity and “awareness.”
    The image contains a screenshot of the next step of establishing activities, attribute values, and weights.

    Lead Scoring Workbook

    2.3.2 Run tests to validate activity weightings

    Collaborate with stakeholders to run different engagement scenarios. Validate your model including thresholds.

    The image contains a screenshot of activity 2.3.2: run tests to validate activity weightings.

    SoftwareReviews Advisory Insight:

    Use data from actual closed deals and the underlying activities to build your model – nothing like using facts to inform your key decisions. Use common sense and keep things simple. Then update further when data from new wins appears.

    2 hours

    1. Test scenarios of contact engagement by placing a “1” in the “Attribute” box shown at left.
    2. Place your estimate of how you believe the engagement should score in the box to the right of “Estimated Engagement State.” How does the calculated state, beneath, compare to the estimated state?
    3. In cases where the calculated state differs from your estimated state, consider weighting the activity attribute differently to match.
    4. If you find that the estimates and calculated states are off dramatically, consider changing previously determined thresholds in tab 2, “Identify Thresholds.” Test multiple scenarios with your team.

    Lead Scoring Workbook

    Phase 3

    Apply Your Model to Marketing Apps and Go Live With Better Qualified Leads

    Phase 1

    Phase 2

    Phase 3

    1.1 Establish a cross-functional vision for lead scoring

    1.2 Asses your tech stack for lead scoring (optional)

    1.3 Catalog your buyer journey and lead gen engine assets

    2.1 Start building your lead scoring model

    2.2 Identify and verify your IPC and weightings

    2.3 Establish key lead generation activities and assets

    3.1 Apply model to your marketing management software

    3.2 Test the quality of sales-accepted leads

    3.3 Apply advanced methods

    This phase will walk you through the following activities:

    1. Apply model to your marketing management/campaign management software.
    2. Get better qualified leads in the hands of sellers.
    3. Apply lead nurturing and other advanced methods.

    This phase involves the following participants:

    • Field Marketing/Campaign Manager
    • Sales Leadership/Sales Operations
    • Inside Sales leadership
    • Marketing Operations/IT
    • Digital Platform leadership

    Step 3.1

    Apply Model to Your Marketing Management Software

    Activities

    3.1.1 Apply final model to your lead management software

    This step will walk you through the following activities:

    • Apply the details of your scoring model to the lead management software.

    This step involves the following participants:

    • Stakeholders
    • Project sponsors and leaders

    Outcomes of this step

    • Marketing management software or campaign management application is now set up/updated with your lead scoring approach.

    3.1.1 Apply final model to your lead management software

    Now that your model is complete and ready to go into production, input your lead scoring parameters into your lead management software.

    The image contains a screenshot of activity 3.1.1 demonstrating tab 4 of the Lead Scoring Workbook.

    3 hours

    1. Go to the Lead Scoring Workbook, tab 4, “Model Summary” for a formatted version of your lead scoring model. Double-check print formatting and print off a copy.
    2. Use the copy of your model to show to prospective technology providers when asking them to demonstrate their lead scoring capabilities.
    3. Once you have finalized your model, use the printed output from this tab to ease your process of transposing the corresponding model elements into your lead management software.

    Lead Scoring Workbook

    Step 3.2

    Test the Quality of Sales-Accepted Leads

    Activities

    3.2.1 Achieve sales lead acceptance

    3.2.2 Measure and optimize

    This step will walk you through the following activities:

    • Suggest that the Inside Sales and Field Sales teams should assess whether to sign off on quality of leads received.
    • Campaign managers and stakeholders should now be able to track lead status more effectively.

    This step involves the following participants:

    • Stakeholders
    • Project sponsors and leaders

    Outcomes of this step

    • Sales leadership should be able to sign off that leads are better qualified.
    • With marketing pipeline analytics in place, campaigners can start to measure lead flow and conversion rates.

    3.2.1 Achieve sales lead acceptance

    Collaborate with sellers to validate your lead scoring approach.

    1 hour

    1. Gather a set of SQLs – leads that have been qualified by Inside Sales and delivered to Field Sales. Have Field Sales team members convey whether these leads were properly qualified.
    2. Where leads are deemed not properly qualified, determine if the issue was a) a lack of proper qualification by the Inside Sales team, or b) the lead generation engine, which should have further nurtured the lead or ignored it outright.
    3. Work collaboratively with Inside Sales to update your lead scoring model and/or Inside Sales practice.

    Stage

    Characteristics

    Actions

    Contact

    • Unqualified
    • No/low activity

    Nurture

    SDR Qualify

    Send to Sales

    Close

    MQL

    • Profile scores high
    • Engagement strong

    SQL

    • Profile strengthened
    • Demo/quote/next step confirmed

    Oppt’y

    • Sales acceptance
    • Sales opportunity management

    Win

    • Deal closed

    SoftwareReviews Advisory Insight:

    Marketers that collaborate with Sales – and in this case, a group of sellers as a sales advisory team – well in advance of sales acceptance to design lead scoring will save time during this stage, build trust with sellers, and make faster decisions related to lead management/scoring.

    3.2.2 Measure and optimize

    Leverage analytics that help you optimize your lead scoring methodology.

    Ongoing

    1. Work with Marketing Ops/IT team to design and implement analytics that enable you to:
    2. Meet frequently with your stakeholder team to review results.
    3. Learn from the wins: see how they actually scored and adjust thresholds and/or asset/activity weightings.
    4. Learn from losses: fix ineffective scoring, activities, assets, form-fill strategies, and engagement paths.
    5. Test from both wins and losses if demographic weightings are delivering accurate scores.
    6. Analyze those high scoring leads that went right to sellers but did not close. This could point to a sales training or enablement challenge.
    The image contains a screenshot of the lead scoring dashboard.

    Analytics will also drive additional key insights across your lead gen engine:

    • Are volumes increasing or decreasing? What percentage of leads are in what status (A1-D4)?
    • What nurturing will re-engage stalled leads that score high in profile but low in engagement (A3, B3)?
    • Will additional profile data capture further qualify leads with high engagement (C1, C2)?
    • And beyond all of the above, what leads move to Inside Sales and convert to SQLs, opportunities, and eventually marketing-influenced wins?

    Step 3.3

    Apply Advanced Methods

    Activities

    3.3.1 Employ lead nurturing strategies

    3.3.2 Adjust your model over time to accommodate more advanced methods

    This step will walk you through the following activities:

    • Apply lead nurturing to your lead gen engine.
    • Adjust your engine over time with more advanced methods.

    This step involves the following participants:

    • Stakeholders
    • Project sponsors and leaders

    Outcomes of this step

    • Marketers can begin to test lead nurturing strategies and other advanced methods.

    3.3.1 Employ lead nurturing strategies

    A robust content marketing competence with compelling assets and the capture of additional profile data for qualification are key elements of your nurturing strategy.

    The image contains a screenshot of the Lead Scoring Grid with a focus on Nurture.

    SoftwareReviews Advisory Insight:

    Nurturing success combines the art of crafting engaging copy/experiences and the science of knowing just where a prospect is within your lead gen engine. Great B2B marketers demonstrate the discipline of knowing when to drive engagement and/or additional profile attribute capture using intent while not losing the prospect to over-profiling.

    Ongoing

    1. The goal of lead nurturing is to move the collection of contacts/leads that are scoring, for example, in the A3, B3, C1, C2, and C3 cells into A2, B2, and B1 cells.
    2. How is this best done? To nurture leads that are A3 and B3, entice the prospect with engagement that leads to the bottom of funnel – e.g. “schedule a demo” or “schedule a consultation” via a compelling asset. See the example on the following slide.
    3. To nurture C1 and C2, we need to qualify them further, so entice with an asset that leads to deeper profile knowledge.
    4. For C3 leads, we need both profile and activity nurturing.

    Lead nurturing example

    The image contains an example of a lead nurturing example.

    SoftwareReviews Advisory Insight:

    When nurturing, choose/design content as to what “intent” it satisfies. For example, a head-to-head comparison with a key competitor signals “Selection” phase of the buyer journey. Content that helps determine what app-type to buy signals “Solution”. A company video, or a webinar replay, may mean your buyer is “educating themselves.

    3.3.2 Adjust your model over time to accommodate more advanced methods

    When getting started or within a smaller marketing team, focus on the basics outlined thus far in this blueprint. Larger and/or more experienced teams are able to employ more advanced methods.

    Ongoing

    Advanced Methods

    • Invest in technologies that interpret lead scores and trigger next-step actions, especially outreach by Inside and/or Field Sales.
    • Use the above to route into nurturing environments where additional engagement will raise scores and trigger action.
    • Recognize that lead value decays with time to time additional outreach/activities and to reduce lead scores over time.
    • Always be testing different engagement, copy, and subsequent activities to optimize lead velocity through your lead gen engine.
    • Build intent sensitivity into engagement activities; e.g. test if longer demo video engagement times imply ”contact me for a demo” via a qualification outreach. Update scores manually to drive learnings.
    • Vary engagement paths by demographics to deliver unique digital experiences. Use firmographics/email domain to drive leads through a more tailored account-based marketing (ABM) experience.
    • Reapply learnings from closed opportunities/wins to drive updates to buyer journey mapping and your ICP.

    Frequently used acronyms

    ABM

    Account-Based Marketing

    B2B

    Business to Business

    CMO

    Chief Marketing Officer

    CRM

    Customer Relationship Management

    ICP

    Ideal Customer Profile

    MIW

    Marketing-Influenced Win

    MQL

    Marketing-Qualified Lead

    SDR

    Sales Development Representative

    SQL

    Sales-Qualified Lead

    Works cited

    Arora, Rajat. “Mining the Real Gems from you Data – Lead Scoring and Engagement Scoring.” LeadSquared, 27 Sept. 2014. Web.

    Doyle, Jen. “2012 B2B Marketing Benchmark Report: Research and insights on attracting and converting the modern B2B buyer.” MarketingSherpa, 2012. Web.

    Doyle, Jen, and Sergio Balegno. “2011 MarketingSherpa B2B Marketing Benchmark Survey: Research and Insights on Elevating Marketing Effectiveness from Lead Generation to Sales Conversion.” MarketingSherpa, 2011.

    Kirkpatrick, David. “Lead Scoring: CMOs realize a 138% lead gen ROI … and so can you.” marketingsherpa blog, 26 Jan 2012. Web.

    Moser, Jeremy. “Lead Scoring Is Important for Your Business: Here’s How to Create Scoring Model and Hand-Off Strategy.” BigCommerce, 25 Feb. 2019. Web.

    Strawn, Joey. “Why Lead Scoring Is Important for B2Bs (and How You Can Implement It for Your Company.” IndustrialMarketer.com, 17 Aug. 2016. Web.

    Drive Business Value With Off-the-Shelf AI

    • Buy Link or Shortcode: {j2store}205|cart{/j2store}
    • member rating overall impact: N/A
    • member rating average dollars saved: N/A
    • member rating average days saved: N/A
    • Parent Category Name: Business Intelligence Strategy
    • Parent Category Link: /business-intelligence-strategy
    • Understanding the impact of the machine learning/AI component that is built into most of the enterprise products and tools and its role in the implementation of the solution.
    • Understanding the most important aspects that the organization needs to consider while planning the implementation of the AI-powered product.

    Our Advice

    Critical Insight

    • Organizations are faced with multiple challenges trying to adopt AI solutions. Challenges include data issues, ethics and compliance considerations, business process challenges, and misaligned leadership goals.
    • When choosing the right product to meet business needs, organizations need to know what questions to ask vendors to ensure they fully understand the implications of buying an AI/ML product.
    • To guarantee the success of your off-the-shelf AI implementation and ensure it delivers value, you must start with a clear definition of the business case and an understanding of your data.

    Impact and Result

    To guarantee success of the off-the-shelf AI implementation and deliver value, in addition to formulating a clear definition of the business case and understanding of data, organizations should also:

    • Know what questions to ask vendors while evaluating AI-powered products.
    • Measure the impact of the project on business and IT processes.

    Drive Business Value With Off-the-Shelf AI Research & Tools

    Besides the small introduction, subscribers and consulting clients within this management domain have access to:

    1. Drive Business Value With Off-the-Shelf AI Deck – A step-by-step approach that will help guarantee the success of your Off-the-Shelf AI implementation and ensure it delivers business value

    Use this practical and actionable framework that will guide you through the planning of your Off-the-Shelf AI product implementation.

    • Drive Business Value With Off-the-Shelf AI Storyboard

    2. Off-the-Shelf AI Analysis – A tool that will guide the analysis and planning of the implementation

    Use this analysis tool to ensure the success of the implementation.

    • Off-the-Shelf AI Analysis

    Infographic

    Further reading

    Drive Business Value With Off-the-Shelf AI

    A practical guide to ensure return on your Off-the-Shelf AI investment

    Executive Summary

    Your Challenge
    • Understanding the impact of the machine learning/AI component that is built into most of the enterprise products and tools and its role in the implementation of the solution.
    • What are the most important aspects that organizations needs to consider while planning the implementation of the AI-powered product?
    Common Obstacles
    • Organizations are faced with multiple challenges trying to adopt an AI solution. Challenges include data issues, ethics and compliance considerations, business process challenges, and misaligned leadership goals.
    • When choosing the right product to meet business needs, organizations need to know what questions to ask vendors to ensure they fully understand the implications of buying an AI/ML product.
    Info-Tech’s Approach

    Info-Tech’s approach includes a framework that will guide organizations through the process of the Off-the-Shelf AI product selection.

    To guarantee success of the Off-the-Shelf AI implementation and deliver value, organization should start with clear definition of the business case and an understanding of data.

    Other steps include:

    • Knowing what questions to ask vendors to evaluate AI-powered products.
    • Measuring the impact of the project on your business and IT processes.
    • Assessing impact on the organization and ensure team readiness.

    Info-Tech Insight

    To guarantee the success of your Off-the-Shelf AI implementation and ensure it delivers value, you must start with a clear definition of the business case and an understanding of your data.

    Info-Tech offers various levels of support to best suit your needs

    DIY Toolkit

    Guided Implementation

    Workshop

    Consulting

    "Our team has already made this critical project a priority, and we have the time and capability, but some guidance along the way would be helpful." "Our team knows that we need to fix a process, but we need assistance to determine where to focus. Some check-ins along the way would help keep us on track." "We need to hit the ground running and get this project kicked off immediately. Our team has the ability to take this over once we get a framework and strategy in place." "Our team does not have the time or the knowledge to take this project on. We need assistance through the entirety of this project."

    Diagnostics and consistent frameworks used throughout all four options

    Getting value out of AI and machine learning investments

    92.1%

    of companies say they are achieving returns on their data and AI investments

    91.7%

    said they were increasing investments in data and AI

    26.0%

    of companies have AI systems in widespread production
    However, CIO Magazine identified nine main hurdles to AI adoption based on the survey results:
    • Data issues
    • Business process challenges
    • Implementation challenges and skill shortages
    • Costs of tools and development
    • Misaligned leadership goals
    • Measuring and proving business value
    • Legal and regulatory risks
    • Cybersecurity
    • Ethics
    • (Source: CIO, 2019)
    “Data and AI initiatives are becoming well established, investments are paying off, and companies are getting more economic value from AI.” (Source: NewVantage, 2022.)

    67% of companies are currently using machine learning, and 97% are using or planning to use it in the next year.” (Source: Deloitte, 2020)

    AI vs. ML

    Machine learning systems learn from experience and without explicit instructions. They learn patterns from data then analyze and make predictions based on past behavior and the patterns learned.

    Artificial intelligence is a combination of technologies and can include machine learning. AI systems perform tasks mimicking human intelligence such as learning from experience and problem solving. Most importantly, AI is making its own decisions without human intervention.

    The AI system can make assumptions, test these assumptions, and learn from the results.

    (Level of decision making required increases from left to right)
    Statistical Reasoning
    Infer relationships between variables

    Statistical models are designed to find relationships between variables and the significance of those relationships.

    Machine Learning:
    Making accurate predictions

    Machine learning is a subset of AI that discovers patterns from data without being explicitly programmed to do so.

    Artificial Intelligence
    Dynamic adaptation to novelty

    AI systems choose the optimal combination of methods to solve a problem. They make assumptions, reassess the model, and reevaluate the data.

    “Machine learning is the study of computer algorithms that improve automatically through experience.” (Tom Mitchell, 1997)

    “At its simplest form, artificial intelligence is a field, which combines computer science and robust datasets, to enable problem-solving.” (IBM, “What is artificial intelligence?”)

    Types of Off-the-Shelf AI products and solutions

    ML/AI-Powered Products Off-the-Shelf Pre-built and Pre-trained AI/ML Models
    • AI/ML capabilities built into the product and might require training as part of the implementation.
    • Off-the-Shelf ML/AI Models, pre-built, pre-trained, and pre-optimized for a particular task. For example, language models or image recognition models that can be used to speed up and simplify ML/AI systems development.
    Examples of OTS tools/products: Examples of OTS models:

    The data inputs for these models are defined, the developer has to conform to the provided schema, and the data outputs are usually fixed due to the particular task the OTS model is built to solve.

    Insight summary

    Overarching insight:

    To guarantee the success of your Off-the-Shelf AI implementation and ensure it delivers value, you must start with a clear definition of the business case and an understanding of your data.

    Business Goals

    Question the value that AI adds to the tool you are evaluating. Don’t go after the tool simply because it has an AI label attached to it. AI/ML capabilities might add little value but increase implementation complexity. Define the problem you are solving and document business requirements for the tool or a model.

    Data

    Know your data. Determine data requirements to:

    • Train the model during the implementation and development.
    • Run the model in production.

    People/Skills

    Define the skills required for the implementation and assemble the team that will support the project from requirements to deployment and support, through its entire lifecycle. Don’t forget about production support and maintenance.

    Choosing an AI-Powered Tool

    No need to reinvent the wheel and build a product you can buy, but be prepared to work around tool limitations, and make sure you understand the data and the model the tool is built on.

    Choosing an AI/ML Model

    Using Off-the-Shelf-AI models enables an agile approach to system development. Faster POC and validation of ideas and approaches, but the model might not be customizable for your requirements.

    Guaranteeing Off-the-Shelf AI Implementation Success

    Info-Tech Insight

    To guarantee the success of your Off-the-Shelf AI implementation and ensure it delivers value, you must start with a clear definition of the business case and an understanding of your data.

    Why do you need AI in your toolset?
    Business Goals

    Clearly defined problem statement and business requirements for the tool or a model will help you select the right solution that will deliver business value even if it does not have all the latest bells and whistles.

    Small chevron pointing right.
    Do you know the data required for implementation?
    Data

    Expected business outcome defines data requirements for implementation. Do you have the right data required to train and run the model?

    Large chevron pointing right.
    Is your organization ready for AI?
    People/Team/ Skills

    New skills and expertise are required through all phases of the implementation: design, build, deployment, support, and maintenance, as well as post-production support, scaling, and adoption.

    Data Architecture/ Infrastructure

    New tool or model will impact your cloud and integration strategy. It will have to integrate with the existing infrastructure, in the cloud or on prem.

    Large chevron pointing right.
    What questions do you need to ask when choosing the solution?
    Product/ Tool or Model Selection

    Do you know what model powers the AI tool? What data was used to train the tool and what data is required to run it? Ask the right questions.

    Small chevron pointing right.
    Are you measuring impact on your processes?
    Business and IT Processes

    Business processes need to be defined or updated to incorporate the output of the tool back into the business processes to deliver value.

    IT governance and support processes need to accommodate the new AI-powered tool.

    Small chevron pointing right.
    Realize and measure business value of your AI investment
    Value

    Do you have a clear understanding of the value that AI will bring to your organization?Optimization?Increased revenue?Operational efficiency?

    Introduction of Off-the-Shelf AI Requires a Strategic Approach

    Business Goals and Value Data People/Team/ Skills Infrastructure Business and IT Processes
    AI/ML–powered tools
    • Define a business problem that can be solved with either an AI-powered tool or an AI/ML pre-built model that will become part of the solution.
    • Define expectations and assumptions around the value that AI can bring.
    • Document business requirements for the tool or model.
    • Define the scope for a prototype or POC.
    • Define data requirements.
    • Define data required for implementation.
    • Determine if the required data can be acquired or captured/generated.
    • Document internal and external sources of data.
    • Validate data quality (define requirements and criteria for data quality).
    • Define where and how the data is stored and will be stored. Does it have to be moved or consolidated?
    • Define all stakeholders involved in the implementation and support.
    • Define skills and expertise required through all phases of the implementation: design, build, deployment, support, and maintenance.
    • Define skills and expertise required to grow AI practice and achieve the next level of adoption, scaling, and development of the tool or model POC.
    • Define infrastructure requirements for either Cloud, Software-as-a-Service, or on-prem deployment of a tool or model.
    • Define how the tool is integrated with existing systems and into existing infrastructure.
    • Determine the cost to deploy and run the tool/model.
    • Define processes that need to be updated to accommodate new functionality.
    • Define how the outcome of the tool or a model (e.g. predictions) are incorporated back into the business processes.
    • Define new business and IT processes that need to be defined around the tool (e.g. chatbot maintenance; analysis of the data generated by the tool).
    Off-the-shelf AI/ML pre-built models
    • Define the business metrics and KPIs to measure success of the implementation against.
    • Determine if there are requirements for a specific data format required for the tool or a model.
    • Determine if there is a need to classify/label the data (supervised learning).
    • Define privacy and security requirements.
    • Define requirements for employee training. This can be vendor training for a tool or platform training in the case of a pre-built model or service.
    • Define if ML/AI expertise is required.
    • Is the organization ready for ML/AI? Conduct an AI literacy survey and understand team’s concerns, fears, and misconceptions and address them.
    • Define requirements for:
      • Data migration.
      • Security.
      • AI/ML pipeline deployment and maintenance.
    • Define requirements for operation and maintenance of the tool or model.
    • Confirm infrastructure readiness.
    • How AI and its output will be used across the organization.

    Define Business Goals and Objectives

    Why do you need AI in your toolset? What value will AI deliver? Have a clear understanding of business benefits and the value AI delivers through the tool.

    • Define a business problem that can be solved with either an AI-powered tool or AI/ML pre-built model.
    • Define expectations and assumptions around the value that AI can bring.
    • Document business requirements for a tool or model.
    • Start with the POC or a prototype to test assumptions, architecture, and components of the solution.
    • Define business metrics and KPIs to measure success of the implementation.

    Info-Tech Insight

    Question the value that AI adds to the tool you are evaluating. Don’t go after the tool simply because it has an AI label attached to it. AI/ML capabilities might add little value but increase implementation complexity. Define the problem you are solving and document business requirements for the tool or a model.

    Venn diagram of 'Applied Artificial Intelligence (AAI)' with a larger circle at the top, 'Machine Learning (ML)', and three smaller ovals intersecting, 'Computer Vision', 'Natural Language Processing (NLP)', and 'Robotic Process Automation (RPA)'.

    AAI solutions and technologies are helping organizations make faster decisions and predict future outcomes such as:

    • Business process automation
    • Intelligent integration
    • Intelligent insights
    • Operational efficiency improvement
    • Increase revenue
    • Improvement of existing products and services
    • Product and process innovation

    1. Use Info-Tech’s Off-the-Shelf AI Analysis Tool to define business drivers and document business requirements

    2-3 hours
    Screenshot of the Off-the-Shelf AI Analysis Tool's Business Drivers tab, a table with columns 'AI/ML Tool or Model', 'Use Case', 'Business problem / goal for AI/ML use case', 'Description', 'Business Owner (Primary Stakeholder)', 'Priority', 'Stakeholder Groups Impacted', 'Requirements Defined? Yes/No', 'Related Data Domains', and 'KPIs'. Use the Business Drivers tab to document:
    • Business objectives of the initiative that might drive the AI/ML use case.
    • The business owner or primary stakeholder who will help to define business value and requirements.
    • All stakeholders who will be involved or impacted.
    • KPIs that will be used to assess the success of the POC.
    • Data required for the implementation.
    • Use the Business Requirements tab to document high-level requirements for a tool or model.
    • These requirements will be used while defining criteria for a tool selection and to validate if the tool or model meets your business goals.
    • You can use either traditional BRD format or a user story to document requirements.
    Screenshot of the Off-the-Shelf AI Analysis Tool's Business Requirements tab, a table with columns 'Requirement ID', 'Requirement Description / user story', 'Requirement Category', 'Stakeholder / User Role', 'Requirement Priority', and 'Complexity (point estimates)'.

    Download the Off-the-Shelf AI Analysis Tool

    1. Define business drivers and document business requirements

    Input

    • Strategic plan of the organization
    • Data strategy that defines target data capabilities required to support enterprise strategic goals
    • Roadmap of business and data initiatives to support target state of data capabilities

    Output

    • Prioritized list of business use cases where an AI-powered tool or AI/ML can deliver business value
    • List of high-level requirements for the selected use case

    Materials

    • Whiteboard/Flip Charts
    • Off-the-Shelf-AI Analysis Tool, “Business Drivers” and “Business Requirements” tabs

    Participants

    • CIO
    • Senior business and IT stakeholders
    • Data owner(s)
    • Data steward(s)
    • Enterprise Architect
    • Data Architect
    • Data scientist/Data analyst

    Understand data required for implementation

    Do you have the right data to implement and run the AI-powered tool or AI/ML model?

    Info-Tech Insight

    Know your data. Determine data requirements to:

    • Train the model during the implementation and development, and
    • Run the model in production
    AvailabilityArrow pointing rightQualityArrow pointing rightPreparationArrow pointing rightBias, Privacy, SecurityArrow pointing rightData Architecture
    • Define what data is required for implementation, e.g. customer data, financial data, product sentiment.
    • If the data is not available, can it be acquired, gathered, or generated?
    • Define the volume of data required for implementation and production.
    • If the model has to be trained, do you have the data required for training (e.g. dictionary of terms)? Can it be created, gathered, or acquired?
    • Document internal and external sources of data.
    • Evaluate data quality for all data sources based on the requirements and criteria defined in the previous step.
    • For datasets with data quality issues, determine if the data issues can be resolved (e.g. missing values are inferred). If not, can this issue be resolved by using other data sources?
    • Engage a Data Governance organization to address any data quality concerns.
    • Determine if there are requirements for a specific data format required for the tool or model.
    • Determine if there is a need to classify/label or tag the data. What are the metadata requirements?
    • Define whether or not the implementation team needs to aggregate or transform the data before it can be used.
    • Define privacy requirements, as these might affect the availability of the data for ML/AI.
    • Define data bias concerns and considerations. Do you have datasheets for datasets that will be used in this project? What datasets cannot be used to prevent bias?
    • What are the security requirements and how will they affect data storage, product selection, and infrastructure requirements for the tool and overall solution?
    • Define where and how the data is currently stored and will be stored.
    • Does it have to be migrated or consolidated? Does it have to be moved to the cloud or between systems?
    • Is a data lake or data warehouse a requirement for this implementation as defined by the solution architecture?

    2. Use Info-Tech’s Off-the-Shelf AI Analysis Tool to document data requirements

    2-3 hours

    Use the Data tab to document the following for each data source or dataset:
    • Data Domain – e.g. Customer data
    • Data Concept – e.g. Customer
    • Data Internally Accessible – Identify datasets that are required for the implementation even if the data might not be available internally. Work on determining if the data ca be acquired externally or collected internally.
    • Source System – define the primary source system for the data, e.g. Salesforce
    • Target System (if applicable) – Define if the data needs to be migrated/transferred. For example, you might use a datalake or data warehouse for the AI/ML solution or migrate data to the cloud.
    • Classification/Taxonomy/Ontology
    • Data Steward
    • Data Owner
    • Data Quality – Data quality indicator
    • Refresh Rate – Frequency of data refresh. Indicate if the data can be accessed in real time or near-real time

    Screenshot of the Off-the-Shelf AI Analysis Tool's Data tab, a spreadsheet table with the columns listed to the left and below.
    • Retention – Retention policy requirements
    • Compliance Requirements – Define if data has to comply with any of the regulatory requirements, e.g. GDPR
    • Privacy, Bias, and Ethics Considerations – Privacy Act, PIPEDA, etc. Identify if the dataset contains sensitive information that should be excluded from the model, such as gender, age, race etc. Indicate fairness metrics, if applicable.

    Download the Off-the-Shelf AI Analysis Tool

    2. Document data requirements

    Input

    • Documented business use cases from Step 1.
    • High-level business requirements from Step 1.
    • Data catalog, data dictionaries, business glossary
    • Data flows and data architecture

    Output

    • High-level data requirements
    • List of data sources and datasets that can be used for the implementation
    • Datasets that need to be collected or acquired externally

    Materials

    • Whiteboard/Flip Charts
    • Off-the-Shelf AI Analysis Tool, “Data” tab

    Participants

    • CIO
    • Business and IT stakeholders
    • Data owner(s)
    • Data steward(s)
    • Enterprise Architect
    • Data Architect
    • Data scientist/Data analyst

    Is Your Organization Ready for AI?

    Assess organizational readiness and define stakeholders impacted by the implementation. Build the team with the right skillset to drive the solution.

    • Implementation of the AI/ML-powered Off-the-Shelf Tool or an AI/ML model will require a team with a combination of skills through all phases of the project, from design of the solution to build, production, deployment, and support.
    • Document the skillsets required and determine the skills gap. Before you start hiring, depending on the role, you might find talent within the organization to join the implementation team with little to no training.
    • AI/ML resources that may be needed on your team driving AI implementation (you might consider bringing part-time resources to fill the gaps or use vendor developers) are:
      • Data Scientist
      • Machine Learning Engineer
      • Data Engineer
      • Data Architect
      • AI/ML Ops engineer
    • Define training requirements. Consider vendor training for a tool or platform.
    • Plan for future scaling and the growing of the solution and AI practice. Assess the need to apply AI in other business areas. Work with the team to analyze use cases and prioritize AI initiatives. As the practice grows, grow your team expertise.
    • Identify the stakeholders who will be affected by the AI implementation.
    • Work with them to understand and address any concerns, fears, or misconceptions around the role of AI and the consequences of bringing AI into the organization.
    • Develop a communication and change management plan to educate everyone within the organization on the application and benefits of using AI and machine learning.

    Info-Tech Insight:

    Define the skills required for the implementation and assemble the team that will support the project through its entire lifecycle. Don’t forget about production, support, and maintenance.

    3. Build your implementation team

    1-2 hours

    Input: Solution conceptual design, Current resource availability

    Output: Roles required for the implementation of the solution, Resources gap analysis, Training and hiring plan

    Materials: Whiteboard/Flip charts, Off-the-Shelf AI Analysis Tool, “People and Team” tab

    Participants: Project lead, HR, Enterprise Architect

    1. Review your solution conceptual design and define implementation team roles.
    2. Document requirements for each role.
    3. Review current org chart and job descriptions and identify skillset gaps. Draft an action plan to fill in the roles.
    4. Use Info-Tech’s Off-the-Shelf AI Analysis Tool's People and Team tab to document team roles for the entire implementation, including design, build/implement, deployment, support and maintenance, and future development.

    Screenshot of the Off-the-Shelf AI Analysis Tool's People and Team tab, a table with columns 'Design', 'Implement', 'Deployment', 'Support and Maintenance', and 'Future Development'.

    Download the Off-the-Shelf AI Analysis Tool

    Cloud, SaaS or On Prem – what are my options and what is the impact?

    Depending on the architecture of the solution, define the impact on the current infrastructure, including system integration, AI/ML pipeline deployment, maintenance, and data storage

    • Data Architecture: use the current data architecture to design the architecture for an AI-powered solution. Assess changes to the data architecture with the introduction of a new tool to make sure it is scalable enough to support the change.
    • Define infrastructure requirements for either Cloud, Software-as-a-Service, or on-prem deployment of a tool or model.
    • Define how the tool will be integrated with existing systems and into existing infrastructure.
    • Define requirements for:
      • Data migration and data storage
      • Security
      • AI/ML pipeline deployment, production monitoring, and maintenance
    • Define requirements for operation and maintenance of the tool or model.
    • Work with your infrastructure architect and vendor to determine the cost of deploying and running the tool/model.
    • Make a decision on the preferred architecture of the system and confirm infrastructure readiness.

    Download the Create an Architecture for AI blueprint

    4. Use Info-Tech’s Off-the-Shelf AI Analysis Tool to document infrastructure decisions

    2-3 hours

    Input: Solution conceptual design

    Output: Infrastructure requirements, Infrastructure readiness assessment

    Materials: Whiteboard/Flip charts, Off-the-Shelf AI Analysis Tool, “Infrastructure” tab

    Participants: Infrastructure Architect, Solution Architect, Enterprise Architect, Data Architect, ML/AI Ops Engineer

    1. Work with Infrastructure, Data, Solution, and Enterprise Architects to define your conceptual solution architecture.
    2. Define integration and storage requirements.
    3. Document security requirements for the solution in general and the data specifically.
    4. Define MLOps requirements and tools required for ML/AI pipeline deployment and production monitoring.
    5. Use Info-Tech’s Off-the-Shelf AI Analysis Tool's Infrastructure tab to document requirements and decisions around Data and Infrastructure Architecture.

    Screenshot of the Off-the-Shelf AI Analysis Tool's Infrastructure tab, a table with columns 'Cloud, SaaS or On-Prem', 'Data Migration Requirements', 'Data Storage Requirements', 'Security Requirements', 'Integrations Required', and 'AI/ML Pipeline Deployment and Maintenance Requirements'.

    Download the Off-the-Shelf AI Analysis Tool

    What questions do you need to ask vendors when choosing the solution?

    Take advantage of Info-Tech’s Rapid Application Selection Framework (RASF) to guide tool selection, but ask vendors the right questions to understand implications of having AI/ML built into the tool or a model

    Data Model Implementation and Integration Deployment Security and Compliance
    • What data (attributes) were used to train the model?
    • Do you have datasheets for the data used?
    • How was data bias mitigated?
    • What are the data labeling/classification requirements for training the model?
    • What data is required for production? E.g. volume; type of data, etc.
    • Were there any open-source libraries used in the model? If yes, how were vulnerabilities and security concerns addressed?
    • What algorithms are implemented in the tool/model?
    • Can model parameters be configured?
    • What is model accuracy?
    • Level of customization required for the implementation to meet our requirements.
    • Does the model require training? If yes, can you provide details? Can you estimate the effort required?
    • Integration capabilities and requirements.
    • Data migration requirements for tool operation and development.
    • Administrator console – is this functionality available?
    • Implementation timeframe.
    • Is the model or tool deployable on premises or in the cloud? Do you support hybrid cloud and multi-cloud deployment?
    • What cloud platforms are your product/model integrated with (AWS, Azure, GCP)?
    • What are the infrastructure requirements?
    • Is the model containerized/ scalable?
    • What product support and product updates are available?
    • Regulatory compliance (GDPR, PIPEDA, HIPAA, PCI DSS, CCPA, SOX, etc.)?
    • How are data security risks addressed?

    Use Info-Tech’s Off-the-Shelf AI Analysis Tool, “Vendor Questionnaire” tab to track vendor responses to these questions.

    Are you measuring impact on your processes?

    Make sure that you understand the impact of the new technology on the existing business and IT processes.

    And make sure your business processes are ready to take advantage of the benefits and new capabilities enabled by AI/ML.

    Process automation, optimization, and improvement enabled by the technology and AI/ML-powered tools allow organizations to reduce manual work, streamline existing business processes, improve customer satisfaction, and get critical insights to assist decision making.

    To take full advantage of the benefits and new capabilities enabled by the technology, make sure that business and IT processes reflect these changes:

    • Processes that need to be updated.
    • How the outcome of the tool or a model (e.g. predictions) is incorporated into the existing business processes and the processes that will monitor the accuracy of the outcome and monitor performance of the tool or model.
    • New business and IT processes that need to be defined for the tool (e.g. chatbot maintenance, analysis of the data generated by the tool, etc.).

    5. Document the Impact on Business and IT Processes

    2-3 hours

    Input: Solution design, Existing business and IT processes

    Output: Documented updates to the existing processes, Documented new business and IT processes

    Materials: Whiteboard/Flip charts, Off-the-Shelf AI Analysis Tool, “Business and IT Processes” tab

    Participants: Project lead, Business stakeholders, Business analyst

    1. Review current business processes affected by the implementation of the AI/ML- powered tool or model. Define the changes that need to be made. The changes might include simplification of the process due to automation of some of the steps. Some processes will need to be redesigned and some processes might become obsolete.
    2. Document high-level steps for any new processes that need to be defined around the AI/ML-powered tool. An example of such a process would be defining new IT and business processes to support a new chatbot.
    3. Use Info-Tech’s Off-the-Shelf AI Analysis Tool's Business and IT Processes tab, to document process changes.

    Screenshot of the Off-the-Shelf AI Analysis Tool's Business and IT Processes tab, a table with columns 'Existing business process affected', 'New business process', 'Stakeholders involved', 'Changes to be made', and 'New Process High-Level Steps'.

    Download the Off-the-Shelf AI Analysis Tool

    AI-powered Tools – Considerations

    PROS:
    • Enhanced functionality, allows the power of AI without specialized skills (e.g., Mathematica – recognizing patterns in data).
    • Might be a cheaper option compared to building a solution in-house (chatbot, for ex.).

    Info-Tech Insight:

    No need to reinvent the wheel and build the product you can buy, but be prepared to work around tool limitations, and make sure you understand the data and the model the tool is built on.

    CONS:
    • Dependency on the service provider.
    • The tool might not meet all the business requirements without customization.
    • Bias can be built into the tool:
      • Work with the vendor to understand what data was used to train the model.
      • From the perspective of ethics and bias, learn what model is implemented in the tool and what data attributes the model uses.

    Pre-built/pre-trained models – what to keep in mind when choosing

    PROS:
    • Lower cost and less time to development compared to creating and training models from scratch (e.g. using image recognition models or pre-trained language models like BERT).
    • If the pre-trained and optimized model perfectly fits your needs, the model accuracy might be high and sufficient for your scenario.
    • Off-the-Shelf AI models are useful for creating prototypes or POCs, for testing a hypothesis, and for validating ideas and requirements.
    • Usage of Off-the-Shelf models shortens the development cycle and reduces investment risks.
    • Language models are particularly useful if you don’t have data to train your own model (a “small data” scenario).
    • Infrastructure and model training cost reduction.
    CONS:
    • Might be a challenge to deploy and maintain the system in production.
    • Lack of flexibility: you might not be able to configure input or output parameters to your requirements. For example, a pre-built sentiment analysis model might return four values (“positive,” “negative,” “neutral,” and “mixed”), but your solution will require only two or three values.
    • Might be a challenge to comply with security and privacy requirements.
    • Compliance with privacy and fairness requirements and considerations: what data was used to pretrain the model?
    • If open-source libraries were used to create the model, how will vulnerabilities, risks, and security concerns be addressed?

    Info-Tech Insight:

    Using Off-the-Shelf AI models enables an agile approach to system development – faster POC and validation of ideas and approaches, but the model might not be customizable for your requirements.

    Metrics

    Metrics and KPIs for this project will depend on the business goals and objectives that you will identify in Step 1 of the tool selection process.

    Metrics might include:

    • Reduction of time spent on a specific business process. If the tool is used to automate certain steps of a business process, this metric will measure how much time was saved, in minutes/hours, compared to the process time before the introduction of the tool.
    • Accuracy of prediction. This metric would measure the accuracy of estimations or predictions compared to the same estimations done before the implementation of the tool. It can be measured by generating the same prediction or estimation using the AI-powered tool or using any methods used before the introduction of the tool and comparing the results.
    • Accuracy of the search results. If the AI-powered tool is a search engine, compare a) how much time it would take a user to find an article or a piece of content they were searching for using new tool vs. previous techniques, b) how many steps it took the user to locate the required article in the search results, and c) the location of the correct piece of content in the search result list (at the top of the search result list or on the tenth page).
    • Time spent on manual tasks and activities. This metric will measure how much time, in minutes/hours, is spent by the employees or users on manual tasks if the tool automates some of these tasks.
    • Reduction of business process steps (if the steps are being automated). To derive this metric, create a map of the business process before the introduction of the AI-powered tool and after, and determine if the tool helped to simplify the process by reducing the number of process steps.

    Bibliography

    Adryan, Boris. “Is it all machine learning?” Badryan, Oct. 20, 2015. Accessed Feb. 2022.

    “AI-Powered Data Management Platform.” Informatica, N.d. Accessed Feb 2022.

    Amazon Rekognition. “Automate your image and video analysis with machine learning.” AWS. N.d. Accessed Feb 2022.

    “Artificial Intelligence (AI).” IBM Cloud Education, 3 June 2020. Accessed Feb 2022.

    “Artificial intelligence (AI) vs machine learning (ML).” Microsoft Azure Documentation. Accessed Feb. 2022.

    “Avante Garde in the Realm of AI” SearchUnify Cognitive Platform. Accessed Feb 2022.

    “Azure Cognitive Services.” Microsoft. N.d. Accessed Feb 2022.

    “Becoming an AI-fueled organization. State of AI in the enterprise, 4th edition,” Deloitte, 2020. Accessed Feb. 2022.

    “Coveo Predictive Search.” Coveo, N.d. Accessed Feb 2022.

    ”Data and AI Leadership. Executive Survey 2022. Executive Summary of Findings.” NewVantage Partners. Accessed Feb 2022.

    “Einstein Discovery in Tableau.” Tableau, N.d. Accessed Feb 2022.

    Korolov, Maria. “9 biggest hurdles to AI adoption.” CIO, Feb 26, 2019. Accessed Feb 2022.

    Meel, Vidushi. “What Is Deep Learning? An Easy to Understand Guide.” visio.ai. Accessed Feb. 2022.

    Mitchell, Tom. “Machine Learning,” McGraw Hill, 1997.

    Stewart, Matthew. “The Actual Difference Between Statistics and Machine Learning.” Towards Data Science, Mar 24, 2019. Accessed Feb 2022.

    “Sentiment analysis with Cognitive Services.” Microsoft Azure Documentation. Accessed February 2022.

    “Three Principles for Designing ML-Powered Products.” Spotify Blog. Oct 2019, Accessed Feb 2022.

    “Video Intelligence API.” Google Cloud Platform. N.d. Accessed Feb 2022

    Resilience, It's about your business

    • member rating overall impact: N/A
    • member rating average dollars saved: N/A
    • member rating average days saved: N/A

    January 17th, 2025 is when your ability to serve clients without interruption is legislated. At least when you are in the financial services sector, or when you supply such firms.  If you are not active in the financial arena, don’t click away. Many of these requirements can just give you an edge over your competition.

    Many firms underestimated the impact of the legislation, but let’s be honest, so did the European Union. The last pieces of the puzzle are still not delivered only two days before the law comes into effect.

    What is DORA all about again? It is the Digital Operational Resilience Act. In essence, it is about your ability to withstand adverse events that may impact your clients or the financial system.

    Aside from some nasty details, this really is just common sense. You need to be organized so that the right people know what is expected of them, from the accountable top to the staff executing the day to day operations. You need to know what to do when things go wrong. You need to know your suppliers, especially those who supply services to your critical business services. You need to test your defenses and your IT. You may want to share intelligence around cyber-attacks.

    There, all of the 45 business-relevant DORA articles and technical standards in a single paragraph. The remaining articles deal with the competent authorities and make for good reading as they provide some insights into the workings of the regulatory body. The same goes for the preamble of the law. No less than 104 “musings” that elaborate on the operating environment and intent of the law.

    If you’re firm is still in the thick of things trying to become compliant, you are not alone. I have seen at least one regulator indicating that they will be understanding of that situation, but you must have a clear roadmap to compliance in the near future. Your regulator may or may not be in line with that position. In the eastern-most countries of the EU, signals are that the regulator will take a much tougher stance.

    (This kind of negates one of the musings of the law; the need for a single view on what financial services firms must adhere to to be considered compliant and resilient. But I think this is an unavoidable byproduct of having culturally diverse member states.)

    I dare to say that firms typically have the governance in place as well as the IM processes and testing requirements. The biggest open items seem to be in the actual IT hard operational resilience, monitoring and BCM.

    Take a look at your own firm and make an honest assessment in those areas. They key resilience (DORA-related or not) is knowing how your service works and is performing from a client perspective.

    You need to know how a client achieves all their interaction goals with your company. Typically this is mapped in the client journey. Unfortunately, this usually only maps the business flow, not the technical flow. And usually you look at it from the client UX perspective. This is obviously very important, but it does not help you to understand the elements that ensure you that your clients can always complete that journey.

    The other day, I had a customer journey with an online ski-shop. I had bought two ski helmets in size M, the same size my adult son and I had. When the helmets arrived it turned out they were too small. So, ok, no worries, I start the return process online. Once we complete the initial steps, after a few days I notice that the price for only one helmet is shown on the site. This, despite the indicators that both helmets are approved to be returned. Later both helmets are shown as effectively returned. Refund still shows one helmet’s price. What gives? I give it some more time, but after ten days, I decide to enquire. The site still shows refund for one helmet.

    Then I receive an email that both helmets will be refunded as they accepted the state of the helmets (unused) and amount of the refund is now correct. Site still shows the wrong amount.

    This is obviously a small inconvenience, but it does show that the IT team does not have a full view of the entire customer journey and systems interactions. You need to fix this.

    Suppose this is not about two ski helmets, but about ski or home insurance. Or about the sale of a car or a B2B transaction involving tens or hundreds of thousands of dollars or euro, or any other currency? Does your system show the real-time correct status of the transaction? If not, I would, as a consumer, decide to change provider. Why? Because the trust is gone.

    Resilience is about withstanding events that threaten your service to your clients. Events are nit just earthquakes or floods. Events are also wrong or missing information. To protect against that, you need to know what the (value) chain is that leads to you providing that service. Additionally, you need to know if that service chain has any impediments at any moment in time. Aka, you need to know that any service request can be fulfilled at any given time. And to have the right processes and resources in place to fix whatever is not working at that time.

    And that is in my opinion the biggest task still outstanding with many companies to ensure true resilience and customer service.

    Exploit Disruptive Infrastructure Technology

    • Buy Link or Shortcode: {j2store}298|cart{/j2store}
    • member rating overall impact: N/A
    • member rating average dollars saved: N/A
    • member rating average days saved: N/A
    • Parent Category Name: Disruptive & Emerging Technologies
    • Parent Category Link: /disruptive-emerging-technologies
    • New technology can hit like a meteor. Not only disruptive to IT, technology provides opportunities for organization-wide advantage.
    • Your role is endangered. If you don’t prepare for the most disruptive technologies, you could be overshadowed. Don’t let the Chief Marketing Officer (CMO) set the technological innovation agenda
    • Predicting the future isn’t easy. Most IT leaders fail to realize how quickly technology increases in capability. Even for the tech savvy, predicting which specific technologies will become disruptive is difficult.
    • Communication is difficult when the sky is falling. Even forward-looking IT leaders struggle with convincing others to devote time and resources to monitoring technologies with a formal process.

    Our Advice

    Critical Insight

    • Establish the core working group, select a leader, and select a group of visionaries to help brainstorm emerging technologies.
    • Brainstorm about creating a better future, begin brainstorming an initial longlist.
    • Train the group to think like futurists.
    • Evaluate the shortlist.
    • Define your PoC list and schedule.
    • Finalize, present the plan to stakeholders and repeat.

    Impact and Result

    • Create a disruptive technology working group.
    • Produce a longlist of disruptive technologies.
    • Evaluate the longlist to produce a shortlist of disruptive technologies.
    • Develop a plan for a proof-of-concept project for each shortlisted technology.

    Exploit Disruptive Infrastructure Technology Research & Tools

    Besides the small introduction, subscribers and consulting clients within this management domain have access to:

    1. Exploit Disruptive Infrastructure Technology – A guide to help IT leaders make the most of disruptive impacts.

    As a CIO, there is a need to move beyond day-to-day technology management with an ever-increasing need to forecast technology impacts. Not just from a technical perspective but to map out the technical understandings aligned to potential business impacts and improvements. Technology transformation and innovation is moving more quickly than ever before and as an innovation champion, the CIO or CTO should have foresight in specific technologies with the understanding of how the company could be disrupted in the near future.

    • Exploit Disruptive Infrastructure Technology – Phases 1-3

    2. Disruptive Technology Exploitation Plan Template – A guide to develop the plan for exploiting disruptive technology.

    The Disruptive Technology Exploitation Plan Template acts as an implementation plan for developing a long-term strategy for monitoring and implementing disruptive technologies.

    • Disruptive Technology Exploitation Plan Template

    3. Disruptive Technology Look to the Past Tool – A tool to keep track of the missed technology disruption from previous opportunities.

    The Disruptive Technology Look to the Past Tool will assist you to collect reasonability test notes when evaluating potential disruptive technologies.

    • Disruptive Technology Look to the Past Tool

    4. Disruptive Technology Research Database Tool – A tool to keep track of the research conducted by members of the working group.

    The Disruptive Technology Research Database Tool will help you to keep track of the independent research that is conducted by members of the disruptive technology exploitation working group.

    • Disruptive Technology Research Database Tool

    5. Disruptive Technology Shortlisting Tool

    The Disruptive Technology Shortlisting Tool will help you to codify the results of the disruptive technology working group's longlist winnowing process.

    • Disruptive Technology Shortlisting Tool

    6. Disruptive Technology Value-Readiness and SWOT Analysis Tool – A tool to systematize notional evaluations of the value and readiness of potential disruptive technologies.

    The Disruptive Technology Value Readiness & SWOT Analysis Tool will assist you to systematize notional evaluations of the value and readiness of potential disruptive technologies.

    • Disruptive Technology Value-Readiness and SWOT Analysis Tool

    7. Proof of Concept Template – A handbook to serve as a reference when deciding how to proceed with your proposed solution.

    The Proof of Concept Template will guide you through the creation of a minimum-viable proof-of-concept project.

    • Proof of Concept Template

    8. Disruptive Technology Executive Presentation Template – A template to help you create a brief progress report presentation summarizing your project and program progress.

    The Disruptive Technology Executive Presentation Template will assist you to present an overview of the disruptive technology process, outlining the value to your company.

    • Disruptive Technology Executive Presentation Template

    Infographic

    Workshop: Exploit Disruptive Infrastructure Technology

    Workshops offer an easy way to accelerate your project. If you are unable to do the project yourself, and a Guided Implementation isn't enough, we offer low-cost delivery of our project workshops. We take you through every phase of your project and ensure that you have a roadmap in place to complete your project successfully.

    1 Pre-work: Establish the Disruptive Tech Process

    The Purpose

    Discuss the general overview of the disruptive technology exploitation process.

    Develop an initial disruptive technology exploitation plan.

    Key Benefits Achieved

    Stakeholders are on board, the project’s goals are outlined, and the working group is selected.

    Activities

    1.1 Get execs and stakeholders on board.

    1.2 Review the process of analyzing disruptive tech.

    1.3 Select members for the working group.

    1.4 Choose a schedule and time commitment.

    1.5 Select a group of visionaries.

    Outputs

    Initialized disruptive tech exploitation plan

    Meeting agenda, schedule, and participants

    2 Hold the Initial Meeting

    The Purpose

    Understand how disruption will affect the organization, and develop an initial list of technologies to explore.

    Key Benefits Achieved

    Knowledge of how to think like a futurist.

    Understanding of organizational processes vulnerable to disruption.

    Outline of potentially disruptive technologies.

    Activities

    2.1 Start the meeting with introductions.

    2.2 Train the group to think like futurists.

    2.3 Brainstorm about disruptive processes.

    2.4 Brainstorm a longlist.

    2.5 Research and brainstorm separate longlists.

    Outputs

    List of disruptive organizational processes

    Initial longlist of disruptive tech

    3 Create a Longlist and Assess Shortlist

    The Purpose

    Evaluate the specific value of longlisted technologies to the organization.

    Key Benefits Achieved

    Defined list of the disruptive technologies worth escalating to the proof of concept stage.

    Activities

    3.1 Converge the longlists developed by the team.

    3.2 Narrow the longlist to a shortlist.

    3.3 Assess readiness and value.

    3.4 Perform a SWOT analysis.

    Outputs

    Finalized longlist of disruptive tech

    Shortlist of disruptive tech

    Value-readiness analysis

    SWOT analysis

    Candidate(s) for proof of concept charter

    4 Create an Action Plan

    The Purpose

    Understand how the technologies in question will impact the organization.

    Key Benefits Achieved

    Understanding of the specific effects of the new technology on the business processes it is intended to disrupt.

    Business case for the proof-of-concept project.

    Activities

    4.1 Build a problem canvas.

    4.2 Identify affected business units.

    4.3 Outline and map the business processes likely to be disrupted.

    4.4 Map disrupted business processes.

    4.5 Recognize how the new technology will impact business processes.

    4.6 Make the case.

    Outputs

    Problem canvas

    Map of business processes: current state

    Map of disrupted business processes

    Business case for each technology

    Further reading

    Analyst Perspective

    The key is in anticipation.

    “We all encounter unexpected changes and our responses are often determined by how we perceive and understand those changes. We react according to the unexpected occurrence. Business organizations are no different.

    When a company faces a major technology disruption in its markets – one that could fundamentally change the business or impact its processes and technology – the way its management perceive and understand the disruption influences how they describe and plan for it. In other words, the way management sets the context of a disruption – the way they frame it – shapes the strategy they adopt. Technology leaders can vastly influence business strategy by adopting a proactive approach to understanding disruptive and innovative technologies by simply adopting a process to review and evaluate technology impacts to the company’s lines of business.”

    This is a picture of Troy Cheeseman

    Troy Cheeseman
    Practice Lead, Infrastructure & Operations Research
    Info-Tech Research Group

    Executive Summary

    Your Challenge

    • New technology can hit like a meteor. Not only disruptive to IT, technology provides opportunities for organization-wide advantage.
    • Your role is endangered. If you don’t prepare for the most disruptive technologies, you could be overshadowed. Don’t let the chief marketing officer (CMO) set the technological innovation agenda.

    Common Obstacles

    • Predicting the future isn’t easy. Most IT leaders fail to realize how quickly technology increases in capability. Even for the tech savvy, predicting which specific technologies will become disruptive is difficult.
    • Communication is difficult when the sky is falling. Even forward-looking IT leaders struggle with convincing others to devote time and resources to monitoring technologies with a formal process.

    Info-Tech’s Approach

    • Identify, resolve, and evaluate. Use an annual process as described in this blueprint: a formal evaluation of new technology that turns analysis into action.
    • Lead the analysis from IT. Establish a team to carry out the annual process as a cure for the causes of “airline magazine syndrome” and to prevent it from happening in the future.
    • Train your team on the patterns of progress, track technology over time in a central database, and read Info-Tech’s analysis of upcoming technology.
    • Create your KPIs. Establish your success indicators to create measurable value when presenting to your executive.
    • Produce a comprehensive proof-of-concept plan that will allow your company to minimize risk and maximize reward when engaging with new technology.

    Info-Tech Insight

    Proactively monitoring, evaluating, and exploiting disruptive tech isn’t optional.
    This will protect your role, IT’s role, and the future of the organization.

    A diverse working group maximizes the insight brought to bear.
    An IT background is not a prerequisite.

    The best technology is only the best when it brings immediate value.
    Good technology might not be ready; ready technology might not be good.

    Review

    We help IT leaders make the most of disruptive impacts.

    This research is designed for:

    Target Audience: CIO, CTO, Head of Infrastructure

    This research will help you:

    • Develop a process for anticipating, analyzing, and exploiting disruptive technology.
    • Communicate the business case for investing in disruptive technology.
    • Categorize emerging technologies to decide what to do with them.
    • Develop a plan for taking action to exploit the technology that will most affect your organization.

    Problem statement:

    As a CIO, there is a need to move beyond day-to-day technology management with an ever-increasing need to forecast technology impacts. Not just from a technical perspective but to map out the technical understandings aligned to potential business impacts and improvements. Technology transformation and innovation is moving more quickly than ever before and as an innovation champion, the CIO or CTO should have foresight in specific technologies with the understanding of how the company could be disrupted in the near future. Foresight + Current Technology + Business Understanding = Understanding the Business Disruption. This should be a repeatable process, not an exception or reactionary response.

    Insight Summary

    Establish the core working group, select a leader, and select a group of visionaries to help brainstorm emerging technologies.

    The right team matters. A core working group will keep focus through the process and a leader will keep everyone accountable. Visionaries are out-of-the-box thinkers and once they understand how to think like a "futurists," they will drive the longlist and shortlist actions.

    Train the group to think like futurists

    To keep up with exponential technology growth you need to take a multi-threaded approach.

    Brainstorm about creating a better future; begin brainstorming an initial longlist

    Establish the longlist. The longlist helps create a holistic view of most technologies that could impact the business. Assigning values and quadrant scoring will shortlist the options and focus your PoC option.

    Converge everyone’s longlists

    Long to short...that's the short of it. Using SWOT, value readiness, and quadrant mapping review sessions will focus the longlist, creating a shortlist of potential POC candidates to review and consider.

    Evaluate the shortlist

    There is no such thing as a risk-free endeavor. Use a systematic process to ensure that the risks your organization takes have the potential to produce significant rewards.

    Define your PoC list and schedule

    Don’t be afraid to fail! Inevitably, some proof-of-concept projects will not benefit the organization. The projects that are successful will more than cover the costs of the failed projects. Roll out small scale and minimize losses.

    Finalize, present the plan to stakeholders, and repeat!

    Don't forget the C-suite. Effectively communicate and present the working group’s finding with a well-defined and succinct presentation. Start the process again!

    This is a screenshot of the Thought map for Exploit disruptive infrastructure Technology.
    1. Identify
      • Establish the core working group and select a leader; select a group of visionaries
      • Train the group to think like futurists
      • Hold your initial meeting
    2. Resolve
    • Create and winnow a longlist
    • Assess and create the shortlist
  • Evaluate
    • Create process maps
    • Develop proof of concept charter
  • The Key Is in Anticipation!

    Use Info-Tech’s approach for analyzing disruptive technology in your own disruptive tech working group

    Phase 1: Identify Phase 2: Resolve Phase 3: Evaluate

    Phase Steps

    1. Establish the disruptive technology working group
    2. Think like a futurist (Training)
    3. Hold initial meeting or create an agenda for the meeting
    1. Create and winnow a longlist
    2. Assess shortlist
    1. Create process maps
    2. Develop proof of concept charter

    Phase Outcomes

    • Establish a team of subject matter experts that will evaluate new, emerging, and potentially disruptive technologies.
    • Establish a process for including visionaries from outside of the working group who will provide insight and direction.
    • Introduce the core working group members.
    • Gain a better understanding of how technology advances.
    • Brainstorm a list of organizational processes.
    • Brainstorm an initial longlist.
    • Finalized longlist
    • Finalized shortlist
    • Initial analysis of each technology on the shortlist
    • Finalized shortlist
    • Initial analysis of each technology on the shortlist
    • Business process maps before and after disruption
    • Proof of concept charter
    • Key performance indicators
    • Estimation of required resources
    • Executive presentation

    Four key challenges make it essential for you to become a champion for exploiting disruptive technology

    1. New technology can hit like a meteor. It doesn’t only disrupt IT; technology provides opportunities for organization-wide advantage.
    2. Your role is endangered. If you don’t prepare for the most disruptive technologies, you could be overshadowed. Don’t let the CMO rule technological innovation.
    3. Predicting the future isn’t easy. Most IT leaders fail to realize how quickly technology increases in capability. Even for the tech savvy, predicting which specific technologies will become disruptive is difficult.
    4. Communication is difficult when the sky is falling. Even forward-looking IT leaders struggle with convincing others to devote time and resources to monitoring emerging technologies with a formal process.

    “Look, you have never had this amount of opportunity for innovation. Don’t forget to capitalize on it. If you do not capitalize on it, you will go the way of the dinosaur.”
    – Dave Evans, Co-Founder and CTO, Stringify

    Technology can hit like a meteor

    “ By 2025:

    • 38.6 billion smart devices will be collecting, analyzing, and sharing data.
    • The web hosting services market is to reach $77.8 billion in 2025.
    • 70% of all tech spending is expected to go for cloud solutions.
    • There are 1.35 million tech startups.
    • Global AI market is expected to reach $89.8 billion.”

    – Nick Gabov

    IT Disruption

    Technology disrupts IT by:

    • Affecting the infrastructure and applications that IT needs to use internally.
    • Affecting the technology of end users that IT needs to support and deploy, especially for technologies with a consumer focus.
    • Allowing IT to run more efficiently and to increase the efficiency of other business units.
    • Example: The rise of the smartphone required many organizations to rethink endpoint devices.

    Business Disruption

    Technology disrupts the business by:

    • Affecting the viability of the business.
    • Affecting the business’ standing in relation to competitors that better deal with disruptive technology.
    • Affecting efficiency and business strategy. IT should have a role in technology-related business decisions.
    • Example: BlackBerry failed to anticipate the rise of the apps ecosystem. The company struggled as it was unable to react with competitive products.

    Senior IT leaders are expected to predict disruptions to IT and the business, while tending to today’s needs

    You are expected to be both a firefighter and a forecaster

    • Anticipating upcoming disruptions is part of your job, and you will be blamed if you fail to anticipate future business disruptions because you are focusing on the present.
    • However, keeping IT running smoothly is also part of your job, and you will be blamed if today’s IT environment breaks down because you are focusing on the future.

    You’re caught between the present and the future

    • You don’t have a process that anticipates future disruptions but runs alongside and integrates with operations in the present.
    • You can’t do it alone. Tending to both the present and the future will require a team that can help you keep the process running.

    Info-Tech Insight

    Be prepared when disruptions start coming down, even though it isn’t easy. Use this research to reduce the effort to a simple process that can be performed alongside everyday firefighting.

    Make disruptive tech analysis and exploitation part of your innovation agenda

    A scatter plot graph is depicted, plotting IT Innovative Leadership (X axis), and Satisfaction with IT(Y axis). IT innovative leadership explains 75% of variation in satisfaction with IT

    Organizations without high satisfaction with IT innovation leadership are only 20% likely to be highly satisfied with IT

    “You rarely see a real-world correlation of .86!”
    – Mike Battista, Staff Scientist, Cambridge Brain Sciences, PhD in Measurement

    There is a clear relationship between satisfaction with IT and the IT department’s innovation leadership.

    Prevent “airline magazine syndrome” by proactively analyzing disruptive technologies

    “The last thing the CIO needs is an executive saying ‘I don’t what it is or what it does…but I want two of them!”
    – Tim Lalonde

    Airline magazine syndrome happens to IT leaders caught between the business and IT. It usually occurs in this manner:

    1. While on a flight, a senior executive reads about an emerging technology that has exciting implications for the business in an airline magazine.
    2. The executive returns and approaches IT, demanding that action be taken to address the disruptive technology – and that it should have been (ideally) completed already.

    Without a Disruptive Technology Exploitation Plan:

    “I don’t know”

    With a Disruptive Technology Exploitation Plan:

    “Here in IT, we have already considered that technology and decided it was overhyped. Let me show you our analysis and invite you to join our working group.”

    OR

    “We have already considered that technology and have started testing it. Let me show you our testing lab and invite you to join our working group.”

    Info-Tech Insight

    Airline magazine syndrome is a symptom of a wider problem: poor CEO-CIO alignment. Solve this problem with improved communication and documentation. Info-Tech’s disruptive tech iterative process will make airline magazine syndrome a thing of the past!

    IT leaders who do not keep up with disruptive technology will find their roles diminished

    “Today’s CIO dominion is in a decaying orbit with CIOs in existential threat mode.”
    – Ken Magee

    Protect your role within IT

    • IT is threatened by disruptive technology:
      • Trends like cloud services, increased automation, and consumerization reduce the need for IT to be involved in every aspect of deploying and using technology.
      • In the long term, machines will replace even intellectually demanding IT jobs, such as infrastructure admin and high-level planning.
    • Protect your role in IT by:
      • Anticipating new technology that will disrupt the IT department and your place within it.
      • Defining new IT roles and responsibilities that accurately reflect the reality of technology today.
      • Having a process for the above that does not diminish your ability to keep up with everyday operations that remain a priority today.

    Protect your role against other departments

    • Your role in the business is threatened by disruptive technology:
      • The trends that make IT less involved with technology allow other executives – such as the CMO – to make IT investments.
      • As the CMO gains the power and data necessary to embrace new trends, the CIO and IT managers have less pull.
    • Protect your role in the business by:
      • Being the individual to consult about new technology. It isn’t just a power play; IT leaders should be the ones who know technology thoroughly.
      • Becoming an indispensable part of the entire business’ innovation strategy through proposing and executing a process for exploiting disruptive technology.

    IT leaders who do keep up have an opportunity to solidify their roles as experts and aggregators

    “The IT department plays a critical role in [innovation]. What they can do is identify a technology that potentially might introduce improvements to the organization, whether it be through efficiency, or through additional services to constituents.”
    – Michael Maguire, Management Consultant

    The contemporary CIO is a conductor, ensuring that IT works in harmony with the rest of the business.

    The new CIO is a conductor, not a musician. The CIO is taking on the role of a business engineer, working with other executives to enable business innovation.

    The new CIO is an expert and an aggregator. Conductor CIOs increasingly need to keep up on the latest technologies. They will rely on experts in each area and provide strategic synthesis to decide if, and how, developments are relevant in order to tune their IT infrastructure.

    The pace of technological advances makes progress difficult to predict

    “An analysis of the history of technology shows that technological change is exponential, contrary to the common-sense ‘intuitive linear’ view. So we won’t experience 100 years of progress in the 21st century – it will be more like 20,000 years of progress (at today’s rate).”
    – Ray Kurzweil

    Technology advances exponentially. Rather than improving by the same amount of capability each year, it multiplies in capability each year.

    Think like a futurist to anticipate technology before it goes mainstream.

    Exponential growth happens much faster than linear growth, especially when it hits the knee of the curve. Even those who acknowledge exponential growth underestimate how capabilities can improve.

    To predict new advances, turn innovation into a process

    “We spend 70 percent of our time on core search and ads. We spend 20 percent on adjacent businesses, ones related to the core businesses in some interesting way. Examples of that would be Google News, Google Earth, and Google Local. And then 10 percent of our time should be on things that are truly new.”
    – Eric Schmidt, Google

    • Don’t get caught in the trap of refining your core processes to the exclusion of innovation. You should always be looking for new processes to improve, new technology to pilot, and where possible, new businesses to get into.
    • Devote about 10% of your time and resources to exploring new technology: the potential rewards are huge.

    You and your team need to analyze technology every year to predict where it’s going.

    A bar graph is shown which depicts the proportion of technology use from 2018-2022. the included devices are: Tablets; PCs; TVs; Non-smartphones; Smartphones; M2M
    • Foundational technologies, such as computing power, storage, and networks, are improving exponentially.
    • Disruptive technologies are specific manifestations of foundational advancements. Advancements of greater magnitude give rise to more manifestations; therefore, there will be more disruptive technologies every year.
    • There is a lot of noise to cut through. Remember Google Glasses? As technology becomes ubiquitous and consumerization reigns, everybody is a technology expert. How do you decide which technologies to focus on?

    Protect IT and the business from disruption by implementing a simple, repeatable disruptive technology exploitation process

    “One of the most consistent patterns in business is the failure of leading companies to stay at the top of their industries when technologies or markets change […] Managers must beware of ignoring new technologies that can’t initially meet the needs of their mainstream customers.”
    – Joseph L. Bower and Clayton M. Christensen

    Challenge

    Solution

    New technology can hit like a meteor, but it doesn’t have to leave a crater:

    Use the annual process described in this blueprint to create a formal evaluation of new technology that turns analysis into action.

    Predicting the future isn’t easy, but it can be done:

    Lead the analysis from the office of the CIO. Establish a team to carry out the annual process as a cure for airline magazine syndrome.

    Your role is endangered, but you can survive:

    Train your team on the patterns of progress, track technology over time in a central database, and read Info-Tech’s analysis of upcoming technology.

    Communication is difficult when the sky is falling, so have a simple way to get the message across:

    Track metrics that communicate your progress, and summarize the results in a single, easy-to-read exploitation plan.

    Info-Tech Insight

    Use Info-Tech’s tools and templates, along with this storyboard, to walk you through creating and executing an exploitation process in six steps.

    Create measurable value by using Info-Tech’s process for evaluating the disruptive potential of technology

    This image contains a bar graph with the following Title: Which are the primary benefits you've either realized or expect to realize by deploying hyperconverged infrastructure in the near term.

    No business process is perfect.

    • Use Info-Tech’s Proof of Concept Template to create a disruptive technology proof of concept implementation plan.
    • Harness your company’s internal wisdom to systematically vet new technology. Engage only in calculated risk and maximize potential benefit.

    Info-Tech Insight

    Inevitably, some proof of concept projects will not benefit the organization. The projects that are successful will more than cover the costs of the failed projects. Roll out small scale and minimize losses.

    Establish your key performance indicators (KPIs)

    Key performance indicators allow for rigorous analysis, which generates insight into utilization by platform and consumption by business activity.

    • Brainstorm metrics that indicate when process improvement is actually taking place.
    • Have members of the group pitch KPIs; the facilitator should record each suggestion on a whiteboard.
    • Make sure to have everyone justify the inclusion of each metric: how does it relate to the improvement that the proof of concept project is intended to drive? How does it relate to the overall goals of the business?
    • Include a list of KPIs, along with a description and a target (ensuring that it aligns with SMART metrics).
    Key Performance Indicator Description Target Result

    Number of Longlist technologies

    Establish a range of Longlist technologies to evaluate 10-15
    Number of Shortlist technologies Establish a range of Shortlist technologies to evaluate 5-10
    number of "look to the past" likes/dislikes Minimum number of testing characteristics 6
    Number of POCs Total number of POCs Approved 3-5

    Communicate your plan with the Disruptive Technology Exploitation Plan Template

    Use the Disruptive Technology Exploitation Plan Template to summarize everything that the group does. Update the report continuously and use it to show others what is happening in the world of disruptive technology.

    Section Title Description
    1 Rationale and Summary of Exploitation Plan A summary of the current efforts that exist for exploring disruptive technology. A summary of the process for exploiting disruptive technology, the resources required, the team members, meeting schedules, and executive approval.
    2 Longlist of Potentially Disruptive Technologies A summary of the longlist of identified disruptive technologies that could affect the organization, shortened to six or less that have the largest potential impact based on Info-Tech’s Disruptive Technology Shortlisting Tool.
    3 Analysis of Shortlist Individually analyze each technology placed on the shortlist using Info-Tech’s Disruptive Technology Value-Readiness and SWOT Analysis Tool.
    4 Proof of Concept Plan Use the results from Section 3 to establish a plan for moving forward with the technologies on the shortlist. Determine the tasks required to implement the technologies and decide who will complete them and when.
    5 Hand-off Pass the project along to identified stakeholders with significant interest in its success. Continue to track metrics and prepare to repeat the disruptive technology exploitation process annually.

    Whether you need a process for exploiting disruptive technology, or an analysis of current trends, Info-Tech can help

    Two sets of research make up Info-Tech’s disruptive technology coverage:

    This image contains four screenshots from each of the following Info-Tech Blueprints: Exploit disruptive Infrastructure Technology; Infrastructure & operations priorities 2022

    This storyboard, and the associated tools and templates, will walk you through creating a disruptive technology working group of your own.

    Blueprint deliverables

    Each step of this blueprint is accompanied by supporting deliverables to help you accomplish your goals:

    Key deliverable:

    Disruptive Technology Exploitation Plan Template

    The Disruptive Technology Exploitation Plan Template acts as an implementation plan for developing a long-term strategy for monitoring and implementing disruptive technologies.

    Proof of Concept Template

    The Proof of Concept Template will guide you through the creation of a minimum-viable proof-of-concept project.

    Executive Presentation

    The Disruptive Technology Executive Presentation Template will assist you to present an overview of the disruptive technology process, outlining the value to your company.

    Disruptive Technology Value Readiness & SWOT Analysis Tool

    The Disruptive Technology Value Readiness & SWOT Analysis Tool will assist you to systematize notional evaluations of the value and readiness of potential disruptive technologies.

    Disruptive Technology Research Database Tool

    The Disruptive Technology Research Database Tool will help you to keep track of the independent research that is conducted by members of the disruptive technology exploitation working group.

    Disruptive Technology Shortlisting Tool

    The Disruptive Technology Shortlisting Tool will help you to codify the results of the disruptive technology working group's longlist winnowing process.

    Disruptive Technology Look to the Past Tool

    The Disruptive Technology Look to the Past Tool will assist you to collect reasonability test notes when evaluating potential disruptive technologies.

    Info-Tech offers various levels of support to best suit your needs

    DIY Toolkit

    “Our team has already made this critical project a priority, and we have the time and capability, but some guidance along the way would be helpful.”

    Guided Implementation

    “Our team knows that we need to fix a process, but we need assistance to determine where to focus. Some check-ins along the way would help keep us on track.”

    Workshop

    “We need to hit the ground running and get this project kicked off immediately. Our team has the ability to take this over once we get a framework and strategy in place.”

    Consulting

    “Our team does not have the time or the knowledge to take this project on. We need assistance through the entirety of this project.”

    Diagnostics and consistent frameworks used throughout all four options

    Guided Implementation

    What does a typical GI on this topic look like?

    Phase 1 Phase 2 Phase 3

    Call #1: Explore the need for a disruptive technology working group.

    Call #3: Review the agenda for the initial meeting.

    Call #5: Review how you’re brainstorming and your sources of information.

    Call #7: Review the final shortlist and assessment.

    Call #9: Review the progress of your team.

    Call #2: Review the team name, participants, and timeline.

    Call #4: Assess the results of the initial meeting.

    Call #6: Review the final longlist and begin narrowing it down.

    Call #8: Review the next steps.

    Call #10: Review the communication plan.

    A Guided Implementation (GI) is a series of calls with an Info-Tech analyst to help implement our best practices in your organization.

    A typical GI is 8 to 12 calls over the course of 4 to 6 months.

    Workshop Overview

    Contact your account representative for more information.
    workshops@infotech.com 1-888-670-8889

    Pre-Work Day 1 Day 2 Day 3 Day 4
    Establish the Disruptive Tech Process Hold Your Initial Meeting Create a Longlist and Assess Shortlist Create Process Maps Develop a Proof of Concept Charter

    Activities

    1.1.a Get executives and stakeholders on board.

    1.1.b Review the process of analyzing disruptive tech.

    1.1.c Select members for the working group.

    1.1.d Choose a schedule and time commitment.

    1.1.e Select a group of visionaries.

    1.2.a Start the meeting with introductions.

    1.2.b Train the group to think like futurists.

    1.2.c Brainstorm about disruptable processes.

    1.2.d Brainstorm a longlist.

    1.2.e Research and brainstorm separate longlists.

    2.1.a Converge the longlists developed by the team.

    2.2.b Narrow the longlist to a shortlist.

    2.2.c Assess readiness and value.

    2.2.d Perform a SWOT analysis.

    3.1.a Build a problem canvas.

    3.1.b Identify affected business units.

    3.1.c Outline and map the business processes likely to be disrupted.

    3.1.d Map disrupted business processes.

    3.1.e Recognize how the new technology will impact business processes.

    3.1.f Make the case.

    3.2.a Develop key performance indicators (KPIs).

    3.2.b Identify key success factors.

    3.2.c Outline project scope.

    3.2.d Identify responsible team.

    3.2.e Complete resource estimation.

    Deliverables

    1. Initialized Disruptive Tech Exploitation Plan
    1. List of Disruptable Organizational Processes
    2. Initial Longlist of Disruptive Tech
    1. Finalized Longlist of Disruptive Tech
    2. Shortlist of Disruptive Tech
    3. Value-Readiness Analysis
    4. SWOT Analysis
    5. Candidate(s) for Proof of Concept Charter
    1. Problem Canvas
    2. Map of Business Processes: Current State
    3. Map of Disrupted Business Processes
    4. Business Case for Each Technology
    1. Completed Proof of Concept Charter

    Exploit Disruptive Infrastructure Technology

    Disrupt or be disrupted.

    Identify

    Create your working group.

    PHASE 1

    Use Info-Tech’s approach for analyzing disruptive technology in your own disruptive tech working group

    1. Identify
      1. Establish the core working group and select a leader; select a group of visionaries
      2. Train the group to think like futurists
      3. Hold your initial meeting
    2. Resolve
      1. Create and winnow a longlist
      2. Assess and create the shortlist
    3. Evaluate
      1. Create process maps
      2. Develop proof of concept charter

    The Key Is in Anticipation!

    Phase 1: Identify

    Create your working group.

    Activities:

    Step 1.1: Establish the core working group and select a leader; select a group of visionaries
    Step 1.2: Train the group to think like futurists
    Step 1.3: Hold the initial meeting

    This step involves the following participants:

    IT Infrastructure Manager

    CIO or CTO

    Potential members and visionaries of the working group

    Outcomes of this step:

    • Establish a team of subject matter experts that will evaluate new, emerging, and potentially disruptive technologies.
    • Establish a process for including visionaries from outside of the working group who will provide insight and direction.
    • Introduce the core working group members.
    • Gain a better understanding of how technology advances.
    • Brainstorm a list of organizational processes.
    • Brainstorm an initial longlist.

    Step 1.1

    Establish the core working group and select a leader; select a group of visionaries.

    Activities:

    • Articulate the long- and short-term benefits and costs to the entire organization
    • Gain support by articulating the long- and short-term benefits and costs to the IT department
    • Gain commitment from key stakeholders and executives
    • Help stakeholders understand what goes into formally exploiting disruptive tech by reviewing this process
    • Establish the core working group and select a leader
    • Create a schedule with a time commitment appropriate to your organization’s size; it doesn’t need to take long
    • Select a group of visionaries external to IT to help the working group brainstorm disruptive technologies

    This step involves the following participants:

    • IT Infrastructure Manager
    • CIO or CTO
    • Potential members and visionaries of the working group

    Outcomes of this step

    • Establish a team of subject matter experts that will evaluate new, emerging, and potentially disruptive technologies.
    • Establish a process for including visionaries from outside of the working group that will provide insight and direction.

    1.1.A Articulate the long- and short-term benefits and costs to the entire organization

    A cost/benefit analysis will give stakeholders a picture of how disruptive technology could affect the business. Use the chart as a starting point and customize it based on your organization.

    Disruptive Technology Affects the Organization

    Benefits Costs

    Short Term

    • First-mover advantage from implementing new technology in the business before competitors – and before start-ups.
    • Better brand image as an organization focused on innovation.
    • Increased overall employee satisfaction by implementing new technology that increases employee capabilities or lowers effort.
    • Possibility of increased IT budget for integrating new technology.
    • Potential for employees to reject wide-scale use of unfamiliar technology.
    • Potential for technology to fail in the organization if it is not sufficiently tested.
    • Executive time required for making decisions about technology recommended by the team.

    Long Term

    • Increased internal business efficiencies from the integration of new technology (e.g. energy efficiency, fewer employees needed due to automation).
    • Better services or products for customers, resulting in increased long-term revenue.
    • Lowered costs of services or products and potential to grow market share.
    • Continued relevance of established organizations in a world changed by disruptive technologies.
    • Technology may not reach the capabilities initially expected, requiring waiting for increased value or readiness.
    • Potential for customers to reject new products resulting from technology.
    • Lack of focus on current core capabilities if technology is massively disruptive.

    1.1.B Gain support by articulating the long- and short-term benefits and costs to the IT department

    A cost/benefit analysis will give stakeholders a picture of how disruptive technology could affect the business. Use the chart as a starting point and customize it based on your organization.

    Disruptive Technology Affects IT

    BenefitsCosts

    Short Term

    • Perception of IT as a core component of business practices.
    • Increase IT’s capabilities to better serve employees (e.g. faster network speeds, better uptime, and storage and compute capacity that meet demands).
    • Cost for acquiring or implementing new technology and updating infrastructure to integrate with it.
    • Cost for training IT staff and end users on new IT technology and processes.
    • Minor costs for initial setup of disruptive technology exploitation process and time taken by members.

    Long Term

    • More efficient and powerful IT infrastructure that capitalizes on emerging trends at the right time.
    • Lower help desk load due to self-service and automation technology.
    • Increased satisfaction with IT due to implementation of improved enterprise technology and visible IT influence on improvements.
    • Increased end-user satisfaction with IT due to understanding and support of consumer technology that affects their lives.
    • New technology may result in lower need for specific IT roles. Cultural disruptions due to changing role of IT.
    • Perception of failure if technology is tested and never implemented.
    • Expectation that IT will continue to implement the newest technology available, even when it has been dismissed as not having value.

    1.1.C Gain commitment from key stakeholders and executives

    Gaining approval from executives and key stakeholders is the final obstacle. Ensure that you cover the following items to have the best chance for project approval.

    • Use a sample deck similar to this section for gaining buy-in, ensuring that you add/remove information to make it specific to your organization. Cover this section, including:
      • Who: Who will lead the team and who will be on it (working group)?
      • What: What resources will be required by the team (costs)?
      • Where/When: How often and where will the team meet (meeting schedule)?
      • Why: Why is there a need to exploit disruptive technology (benefits and examples)?
      • How: How is the team going to exploit disruptive technology (the process)?
    • Go through this blueprint prior to presenting the plan to stakeholders so that you have a strong understanding of the details behind each process and tool.
    • Frame the first iteration of the cycle as a pilot program. Use the completed results of the pilot to establish exploiting disruptive technology as a necessary company initiative.

    Insert the resources required by the disruptive tech exploitation team into Section 1.5 of the Disruptive Technology Exploitation Plan Template. Have executives sign-off on the project in Section 1.6.

    Disruption has undermined some of the most successful tech companies

    “The IT department plays a critical role in [innovation]. What they can do is identify a technology that potentially might introduce improvements to the organization, whether it be through efficiency or through additional services to constituents.”
    - Michael Maguire, Management Consultant

    VoIP’s transformative effects

    Disruptive technology:
    Voice over Internet Protocol (VoIP) is a modern means of making phone calls through the internet by sending voice packets using data, as opposed to the traditional circuit transmissions of the PSTN.

    Who won:
    Organizations that realized the cost savings that VoIP provided for businesses with a steady internet connection saved as much as 60% on telephony expenses. Even in the early stages, with a few more limitations, organizations were able to save a significant amount of money and the technology has continued to improve.

    Who lost?
    Telecom-related companies that failed to realize VoIP was a potential threat to their market, and organizations that lacked the ability to explore and implement the disruptive technology early.

    Digital photography — the new norm

    Disruptive technology:
    Digital photography refers to the storing of photographs in a digital format, as opposed to traditional photography, which exposes light to sensitive photographic film.

    Who won:
    Photography companies and new players that exploited the evolution of data storage and applied it to photography succeeded. Those that were able to balance providing traditional photography and exploiting and introducing digital photography, such as Nikon, left competitors behind. Smartphone manufacturers also benefited by integrating digital cameras.

    Who lost?
    Photography companies, such as Kodak, that failed to respond to the digital revolution found themselves outcompeted and insolvent.

    1.1.D Help stakeholders understand what goes into formally exploiting disruptive tech by reviewing this process

    There are five steps to formally exploiting disruptive technology, each with its own individual outputs and tools to take analysis to the next level.

    Step 1.2:
    Hold Initial Meeting

    Output:

    • Initial list of disruptable processes;
    • Initial longlist

    Step 2.1:

    Brainstorm Longlist

    Output:

    • Finalized longlist;
    • Shortlist

    Step 2.2:

    Assess Shortlist

    Output:

    • Final shortlist;
    • SWOT analysis;
    • Tech categorization

    Step 3.1:
    Create Process Maps

    Output:

    • Completed process maps

    Step 3.2:
    Develop a proof of concept charter

    Output:

    • Proof-of-concept template with KPIs

    Info-Tech Insight

    Before going to stakeholders, complete the entire blueprint to better understand the tools and outputs of the process.

    1.1.E Establish the core working group and select a leader

    • Selecting your core membership for the working group is a critical step to the group’s success. Ensure that you satisfy the following criteria:
      • This is a team of subject matter experts. They will be overseeing the learning and piloting of disruptive technologies. Their input will also be valuable for senior executives and for implementing these technologies.
      • Choose members that can take time away from firefighting tasks to dedicate time to meetings.
      • It may be necessary to reach outside of the organization now or in the future for expertise on certain technologies. Use Info-Tech as a source of information.
    Organization Size Working Group Size
    Small 02-Jan
    Medium 05-Mar
    Large 10-May
    • Once the team is established, you must decide who will lead the group. Ensure that you satisfy the following criteria:
      • A leader should be credible, creative, and savvy in both technology and business.
      • The leader should facilitate, acting as both an expert and an aggregator of the information gathered by the team.

    Choose a compelling name

    The working group needs a name. Be sure to select one with a positive connotation within your organization.

    Section 1.3 of the Disruptive Technology Exploitation Plan Template

    1.1.F Create a schedule with a time commitment appropriate to your organization’s size; it doesn’t need to take long

    Time the disruptive technology working group’s meetings to coincide and integrate with your organization’s strategic planning — at least annually.

    Size Meeting Frequency Time per Meeting Example Meeting Activities
    Small Annually One day A one-day meeting to run through phase 2 of the project (SWOT analysis and shortlist analysis).
    Medium Two days A two-day meeting to run through the project. The additional meeting involves phase 3 of this deck, developing a proof-of-concept plan.
    Large Two+ days Two meetings, each two days. Two days to create and winnow the longlist (phase 2), and two further days to develop a proof of concept plan.

    “Regardless of size, it’s incumbent upon every organization to have some familiarity of what’s happening over the next few years, [and to try] to anticipate what some of those trends may be. […] These trends are going to accelerate IT’s importance in terms of driving business strategy.”
    – Vern Brownell, CEO, D-Wave

    Section 1.4 of the Disruptive Technology Exploitation Plan Template

    1.1.G Select a group of visionaries external to IT to help the working group brainstorm disruptive technologies

    Selecting advisors for your group is an ongoing step, and the roster can change.

    Ensure that you satisfy the following criteria:

    • Look beyond IT to select a team representing several business units.
    • Check for self-professed “geeks” and fans of science fiction that may be happy to join.
    • Membership can be a reward for good performance.

    This group does not have to meet as regularly as the core working group. Input from external advisors can occur between meetings. You can also include them on every second or third iteration of the entire process.

    However, the more input you can get into the group, the more innovative it can become.

    “It is … important to develop design fictions based on engagement with directly or indirectly implicated publics and not to be designed by experts alone.”
    – Emmanuel Tsekleves, Senior Lecturer in Design Interactions, University of Lancaster

    Section 1.3 of the Disruptive Technology Exploitation Plan Template

    The following case study illustrates the innovative potential that is created when you include a diverse group of people

    INDUSTRY - Chip Manufacturing
    SOURCE - Clayton Christensen, Intel

    To achieve insight, you need to collaborate with people from outside of your department.

    Challenge

    • Headquartered in California, through the 1990s, Intel was the largest microprocessor chip manufacturer in the world, with revenue of $25 billion in 1997.
    • All was not perfect, however. Intel faced a challenge from Cyrix, a manufacturer of low-end chips. In 18 months, Cyrix’s share of the low-margin entry-level chip manufacturing business mushroomed from 10% to 70%.

    Solution

    • Troubled by the potential for significant disruption of the microprocessor market, Intel brought in external consultants to hold workshops to educate managers about disruptive innovation.
    • Managers would break into groups and discuss ways Intel could facilitate the disruption of its competitors. In one year, Intel hosted 18 workshops, and 2,000 managers went through the process.

    Results

    • Intel launched the Celeron chip to serve the lower end of the PC market and win market share back from Cyrix (which no longer exists as an independent company) and other competitors like AMD.
    • Within one year, Intel had captured 35% of the market.

    “[The models presented in the workshops] gave us a common language and a common way to frame the problem so that we could reach a consensus around a counterintuitive course of action.” – Andy Grove, then-CEO, Intel Corporation

    Phase 1: Identify

    Create your working group.

    Activities:

    Step 1.1: Establish the core working group and select a leader; select a group of visionaries
    Step 1.2: Train the group to think like futurists
    Step 1.3: Hold the initial meeting

    This step involves the following participants:

    • IT Infrastructure Manager
    • CIO or CTO
    • Potential members and visionaries of the working group

    Outcomes of this phase:

    • Establish a team of subject matter experts that will evaluate new, emerging, and potentially disruptive technologies.
    • Establish a process for including visionaries from outside of the working group who will provide insight and direction.
    • Introduce the core working group members.
    • Gain a better understanding of how technology advances.
    • Brainstorm a list of organizational processes.
    • Brainstorm an initial longlist.

    Step 1.2

    Train the group to think like futurists

    Activities:

    1. Look to the past to predict the future:
      • Step 1: Review the technology opportunities you missed
      • Step 2: Review and record what you liked about the tech
      • Step 3: Review and record your dislikes
      • Step 4: Record and test the reasonability
    2. Crash course on futurology principles
    3. Peek into the future

    This step involves the following participants:

    • IT Infrastructure Manager
    • CIO or CTO
    • Core working group members
    • Visionaries

    Outcomes of this step

    • Team members thinking like futurists
    • Better understanding of how technology advances
    • List of past examples and characteristics

    Info-Tech Insight

    Business buy-in is essential. Manage your business partners by providing a summary of the EDIT methodology and process. Validate the process value, which will allow you create a team of IT and business representatives.

    1.2 Train the group to think like futurists

    1 hour

    Ensure the team understands how technology advances and how they can identify patterns in upcoming technologies.

    1. Lead the group through a brainstorming session.
    2. Follow the next phases and steps.
    3. This session should be led by someone who can facilitate a thought-provoking discussion.
    4. This training deck finishes with a video.

    Input

    • Facilitated creativity
    • Training deck [following slides]

    Output

    • Inspiration
    • Anonymous ideas

    Materials

    • Futurist training “steps”
    • Pen and paper

    Participants

    • Core working group
    • Visionaries
    • Facilitator

    1.2.A Look to the past to predict the future

    30 minutes

    Step 1

    Step 2 Step 3 Step 4

    Review what you missed.

    What did you like?

    What did you dislike?

    Test the reasonability.

    Think about a time you missed a technical disruptive opportunity.

    Start with a list of technologies that changed your business and processes.

    Consider those specifically you could have identified with a repeatable process.

    What were the most impactful points about the technology?

    Define a list of “characteristics” you liked.

    Create a shortlist of items.

    Itemize the impact to process, people, and technology.

    Why did you pass on the tech?

    Define a list of “characteristics” you did not like.

    Create a shortlist of items.

    Itemize the impact to process, people, and technology.

    Avoid the “arm chair quarterback” view.

    Refer to the six positive and negative points.

    Check against your data points at the end of each phase.

    Record the list of missed opportunities

    Record 6 characteristics

    Record 6 characteristics

    Completed “Think like a Futurists” tool

    Use the Disruptive Technology Research Look to the Past Tool to record your output.

    Input

    • Facilitated creativity
    • Speaker’s notes

    Output

    • Inspiration
    • Anonymous ideas
    • Recorded missed opportunities
    • Recorded positive points
    • Recorded dislikes
    • Reasonability test list

    Materials

    • Futurist training “steps”
    • Pen and paper
    • “Look to the Past” tool

    Participants

    • Core working group
    • Visionaries
    • Facilitator

    Understand how the difference between linear and exponential growth will completely transform many organizations in the next decade

    “The last ten years have seen exponential growth in research on disruptive technologies and their impact on industries, supply chains, resources, training, education and employment markets … The debate is still open on who will be the winners and losers of future industries, but what is certain is that change has picked up pace and we are now in a new technology revolution whose impact is potentially greater than the industrial revolution.”
    – Gary L. Evans

    Exponential advancement will ensure that life in the next decade will be very different from life today.

    • Linear growth happens one step at a time.
    • The difference between linear and exponential is hard to notice, at first.
    • We are now at the knee of the curve.

    What about email?

    • Consider the amount of email you get daily
    • Double it
    • Triple it

    Exponential growth happens much faster than linear growth, especially when it hits the knee of the curve. Technology grows exponentially, and we are approaching the knee of the curve.

    This graph is adapted from research by Ray Kurzweil.

    Growth: Linear vs. Exponential

    This image contains a graph demonstrating examples of exponential and linear trends.

    1.2.B Crash course on futurology principles

    1 hour

    “An analysis of the history of technology shows that technological change is exponential, contrary to the common-sense ‘intuitive linear’ view. So we won’t experience 100 years of progress in the 21st century — it will be more like 20,000 years of progress (at today’s rate).”
    - Ray Kurzweil

    Review the differences between exponential and linear growth

    The pace of technological advances makes progress difficult to predict.

    Technology advances exponentially. Rather than improving by the same amount of capability each year, it multiplies in capability each year.

    Think like a futurist to anticipate technology before it goes mainstream.

    Exponential growth happens much faster than linear growth, especially when it hits the knee of the curve. Even those who acknowledge exponential growth underestimate how capabilities can improve.

    The following case study illustrates the rise of social media providers

    “There are 7.7 billion people in the world, with at least 3.5 billion of us online. This means social media platforms are used by one in three people in the world and more than two-thirds of all internet users.”
    – Esteban Ortiz-Ospina

    This graph depicts the trend of the number of people using social media platforms between 2005 and 2019

    The following case study illustrates the rapid growth of Machine to Machine (M2M) connections

    A bar graph is shown which depicts the proportion of technology use from 2018-2022. the included devices are: Tablets; PCs; TVs; Non-smartphones; Smartphones; M2M

    Ray Kurzweil’s Law of Accelerating Returns

    “Ray Kurzweil has been described as ‘the restless genius’ by The Wall Street Journal, and ‘the ultimate thinking machine’ by Forbes. He was ranked #8 among entrepreneurs in the United States by Inc Magazine, calling him the ‘rightful heir to Thomas Edison,’ and PBS included Ray as one of 16 ‘revolutionaries who made America,’ along with other inventors of the past two centuries.”
    Source: KurzweilAI.net

    Growth is linear?

    “Information technology is growing exponentially. That’s really my main thesis, and our intuition about the future is not exponential, it’s really linear. People think things will go at the current pace …1, 2, 3, 4, 5, and 30 steps later, you’re at 30.”

    Better IT strategy enables future business innovation

    “The reality of information technology like computers, like biological technologies now, is it goes exponentially … 2, 4, 8, 16. At step 30, you’re at a billion, and this is not an idle speculation about the future.” [emphasis added]

    “When I was a student at MIT, we all shared a computer that cost tens of millions of dollars. This computer [pulling his smartphone out of his pocket] is a million times cheaper, a thousand times more powerful — that’s a billion-fold increase in MIPS per dollar, bits per dollar… and we’ll do it again in 25 years.”
    Source: “IT growth and global change: A conversation with Ray Kurzweil,” McKinsey & Company

    1.2.C Peak into the future

    1 hour

    Leverage industry roundtables and trend reports to understand the art of the possible

    • Uncover important business and industry trends that can inform possibilities for technology disruption.
    • Market research is critical in identifying factors external to your organization and identifying technology innovation that will provide a competitive edge. It’s important to evaluate the impact each trend or opportunity will have in your organization and market.

    Visit Info-Tech’s Trends & Priorities Research Center

    Visit Info-Tech’s Industry Coverage Research to get started.

    Phase 1: Identify

    Create your working group

    Activities:

    Step 1.1: Establish the core working group and select a leader; select a group of visionaries
    Step 1.2: Train the group to think like futurists
    Step 1.3: Hold the initial meeting

    This step involves the following participants:

    • IT Infrastructure Manager
    • CIO or CTO
    • Potential members and visionaries of the working group

    Outcomes of this phase:

    • Establish a team of subject matter experts that will evaluate new, emerging, and potentially disruptive technologies.
    • Establish a process for including visionaries from outside of the working group who will provide insight and direction.
    • Introduce the core working group members.
    • Gain a better understanding of how technology advances.
    • Brainstorm a list of organizational processes.
    • Brainstorm an initial longlist.

    Info-Tech Insight

    Establish the longlist. The longlist help create a holistic view of most technologies that could impact the business. Assigning values and quadrant scoring will shortlist the options and focus your PoC option.

    Step 1.3

    Hold the initial meeting

    Activities:

    1. Create an agenda for the meeting
    2. Start the kick-off meeting with introductions and a recap
    3. Brainstorm about creating a better future
    4. Begin brainstorming an initial longlist
    5. Have team members develop separate longlists for their next meeting

    This step involves the following participants:

    • IT Infrastructure Manager
    • CIO or CTO
    • Core working group members
    • Visionaries

    Outcomes of this step

    • Introduce the core working group members
    • Gain a better understanding of how technology advances
    • Brainstorm a list of organizational processes
    • Brainstorm an initial longlist

    1.3.A Create an agenda for the meeting

    1 hour

    Kick-off this cycle of the disruptive technology process by welcoming your visionaries and introducing your core working group.

    The purpose of the initial meeting is to brainstorm where new technology will be the most disruptive within the organization. You’ll develop two longlists: one of business processes and one of disruptive technology. These longlists are in addition to the independent research your core working group will perform before Phase 2.

    • Find an outgoing facilitator. Sitting back will let you focus more on ideating, and an engaging presenter will help bring out ideas from your visionaries.
    • The training deck (see step 1.2c) includes presenting a video. We’ve included some of our top choices for you to choose from.
      • Feel free to find your own video or bring in a keynote speaker.
      • The object of the video is to get the group thinking about the future.
      • Customize the training deck as needed.
    • If a cycle has been completed, present your findings and all of the group’s completed deliverables in the first section.
    • This session is the only time you have with your visionaries. Get their ideas on what technologies will be disruptive to start forming a longlist.

    Info-Tech Insight

    The disruptive tech team is prestigious. If your organization is large enough or has the resources, consider having this meeting in an offsite location. This will drive excitement to join the working group if the opportunity arises and incentivize good work.

    Meeting Agenda (Sample)

    Time

    Activity

    8:00am-8:30am Introductions and previous meeting recap
    8:30am-9:30am Training deck
    9:30 AM-10:00am Brainstorming
    10:00am-10:15am Break
    10:15am-10:45am Develop good research techniques
    10:45am-12:00pm Begin compiling your longlist

    Info-Tech Insight

    The disruptive tech team is prestigious. If your organization is large enough or has the resources, consider having this meeting in an offsite location. This will drive excitement to join the working group if the opportunity arises and incentivize good work.

    1.3.B Start the kick-off meeting with introductions and a summary of what work has been done so far

    30 minutes

    1. Start the meeting off with an icebreaker activity. This isn’t an ordinary business meeting – or even group – so we recommend starting off with an activity that will emphasize this unique nature. To get the group in the right mindset, try this activity:
      1. Go around the group and have people present:
      2. Their names and roles
      3. Pose some or all of the following questions/prompts to the group:
        • “Tell me about something you have created.”
        • “Tell me about a time you created a process or program considered risky.”
        • “Tell me about a situation in which you had to come up with several new ideas in a hurry. Were they accepted? Were they successful?”
        • “Tell me about a time you took a risk.”
        • “Tell me about one of your greatest failures and what you learned from it.”
    2. Once everyone has been introduced, present any work that has already been completed.
      1. If you have already completed a cycle, give a summary of each technology that you investigated and the results from any piloting.
      2. If this is the first cycle for the working group, present the information decided in Step 1.1.

    Input

    • Disruptive technology exploitation plan

    Output

    • Networking
    • Brainstorming

    Materials

    • Meeting agenda

    Participants

    • Core working group
    • Visionaries
    • Facilitator

    1.3.C Brainstorm about creating a better future for the company, the stakeholders, and the employees

    30 minutes

    Three sticky notes are depicted, at the top of each note are the following titles: What can we do better; How can we make a better future; How can we continue being successful

    1. Have everyone put up at least two ideas for each chart paper.
    2. Go around the room and discuss their ideas. You may generate some new ideas here.

    These generated ideas are organizational processes that can be improved or disrupted with emerging technologies. This list will be referenced throughout Phases 2 and 3.

    Input

    • Inspiration
    • Anonymous ideas

    Output

    • List of processes

    Materials

    • Chart paper and markers
    • Pen and paper

    Participants

    • Core working group
    • Visionaries

    1.3.D Begin brainstorming a longlist of future technology, and discuss how these technologies will impact the business

    30 minutes

    • Use the Disruptive Technology Research Database Tool to organize technologies and ideas. Longstanding working groups can track technologies here over the course of several years, updating the tool between meetings.
    • Guide the discussion with the following questions, and make sure to focus on the processes generated from Step 1.2.d.

    Focus on

    The Technology

    • What is the technology and what does it do?
    • What processes can it support?

    Experts and Other Organizations

    • What are the vendors saying about the technology?
    • Are similar organizations implementing the technology?

    Your Organization

    • Is the technology ready for wide-scale distribution?
    • Can the technology be tested and implemented now?

    The Technology’s Value

    • Is there any indication of the cost of the technology?
    • How much value will the technology bring?

    Download the Disruptive Technology Database Tool

    Input

    • Inspiration
    • List of processes

    Output

    • Initial longlist

    Materials

    • Chart paper and markers
    • Pen and paper
    • Disruptive Technology Research Database Tool

    Participants

    • Core working group
    • Visionaries

    1.3.E Explore these sources to generate your disruptive technology longlist for the next meeting

    30 Minutes

    There are many sources of information on new and emerging technology. Explore as many sources as you can.

    Science fiction is a valid source of learning. It drives and is influenced by disruptive technology.

    “…the inventor of the first liquid-fuelled rocket … was inspired by H.G. Wells’ science fiction novel War of the Worlds (1898). More recent examples include the 3D gesture-based user interface used by Tom Cruise’s character in Minority Report (2002), which is found today in most touch screens and the motion sensing capability of Microsoft’s Kinect. Similarly, the tablet computer actually first appeared in Stanley Kubrick’s 2001: A Space Odyssey (1968) and the communicator – which we’ve come to refer today as the mobile phone – was first used by Captain Kirk in Star Trek (1966).”
    – Emmanuel Tsekleves, senior lecturer, University of Lancaster

    Right sources: blogs, tech news sites, tech magazines, the tech section of business sites, popular science books about technology, conferences, trade publications, and vendor announcements

    Quantity over quality: early research is not the time to dismiss ideas.

    Discuss with your peers: spark new and innovative ideas

    Insert a brief summary of how independent research is conducted in Section 2.1 of the Disruptive Technology Exploitation Plan Template.

    1.3.E (Cont.) Explore these sources to generate your disruptive technology longlist for the next meeting

    30 Minutes

    There are many sources of information on new and emerging technology. Use this list to kick-start your search.

    Connect with practitioners that are worth their weight in Reddit gold. Check out topic-based LinkedIn groups and subreddits such as r/sysadmin and r/tech. People experienced with technology frequent these groups.

    YouTube is for more than cat videos. Many vendors use YouTube for distributing their previous webinars. There are also videos showcasing various technologies that are uploaded by lecturers, geeks, researchers, and other technology enthusiasts.

    Test your reasonability. Check your “Think Like a Futurist” Tool

    Resolve

    Evaluate Disruptive Technologies

    PHASE 2

    Phase 2: Resolve

    Evaluate disrupted technologies

    Activities:

    Step 2.1: Create and Winnow a Longlist
    Step 2.2: Assess Shortlist

    Info-Tech Insight

    Long to short … that’s the short of it. Using SWOT, value readiness, and quadrant mapping review sessions will focus the longlist, creating a shortlist of potential PoC candidates to review and consider.

    This step involves the following participants:

    • Core working group
    • Infrastructure Management

    Outcomes of this step:

    • Finalized longlist
    • Finalized shortlist
    • Initial analysis of each technology on the shortlist

    Step 2.1

    Create and winnow a longlist

    Activities:

    1. Converge everyone’s longlists
    2. Narrow technologies from the longlist down to a shortlist using Info-Tech’s Disruptive Technology Shortlisting Tool
    3. Use the shortlisting tool to help participants visualize the potential
    4. Input the technologies on your longlist into the Disruptive Technology Shortlisting Tool to produce a shortlist

    This step involves the following participants:

    • Core working group members

    Outcomes of this step:

    • Finalized longlist
    • Finalized shortlist
    • Initial analysis of each technology on the shortlist

    2.1 Organize a meeting with the core working group to combine your longlists and create a shortlist

    1 hour

    Plan enough time to talk about each technology on the list. Each technology was included for a reason.

    • Start with the longlist. Review the longlist compiled at the initial meeting, and then have everyone present the lists that they independently researched.
    • Focus on the company’s context. Make sure that the working group analyzes these disruptive technologies in the context of the organization.
    • Start to compile the shortlist. Begin narrowing down the longlist by excluding technologies that are not relevant.

    Meeting Agenda (Sample)

    TimeActivity
    8:00am-9:30amConverge longlists
    9:30am-10:00amBreak
    10:00am-10:45amDiscuss tech in organizational context
    10:45am-11:15amBegin compiling the shortlist

    Disruptive Technology Exploitation Plan Template

    2.1.A Converge the longlists developed by your team

    90 minutes

    • Start with the longlist developed at the initial meeting. Write this list on the whiteboard.
    • If applicable, have a member present the longlist that was created in the last cycle. Remove technologies that:
      • Are no longer disruptive (e.g. have been implemented or rejected).
      • Have become foundational.
    • Eliminate redundancy: remove items that are very similar.
    • Have members “pitch” items on their lists:
      • Explain why their technologies will be disruptive (2-5 minutes maximum)
      • Add new technologies to the whiteboard
    • Record the following for metrics:
      • Each presented technology
      • Reasons the technology could be disruptive
      • Source of the information
    • Use Info-Tech’s Disruptive Technology Research Database Tool as a starting point.

    Insert the final longlist into Section 2.2 of your Disruptive Technology Exploitation Plan Template.

    Input

    • Longlist developed at first meeting
    • Independent research
    • Previous longlist

    Output

    • Finalized longlist

    Materials

    • Disruptive Technology Research Database Tool
    • Whiteboard and markers
    • Virtual whiteboard

    Participants

    • Core working group

    Review the list of processes that were brainstormed by the visionary group, and ask for input from others

    • IT innovation is most highly valued by the C-suite when it improves business processes, reduces costs, and improves core products and services.
    • By incorporating this insight into your working group’s analysis, you help to attract the attention of senior management and reinforce the group’s necessity.
    • Any input you can get from outside of IT will help your group understand how technology can be disruptive.
      • Visionaries consulted in Phase 1 are a great source for this insight.
    • The list of processes that they helped to brainstorm in Step 1.2 reflects processes that can be impacted by technology.
    • Info-Tech’s research has shown time and again that both CEOs and CIOs want IT to innovate around:
      • Improving business processes
      • Improving core products and services
      • Reducing costs

    Improved business processes

    80%

    Core product and service improvement

    48%

    Reduced costs

    48%

    Increased revenues

    23%

    Penetration into new markets

    21%

    N=364 CXOs & CIOs from the CEO-CIO Alignment Diagnostic Questions were asked on a 7-point scale of 1 = Not at all to 7 = Very strongly. Results are displayed as percentage of respondents selecting 6 or 7.

    Info-Tech Insight

    The disruptive tech team is prestigious. If your organization is large enough or has the resources, consider having this meeting in an offsite location. This will drive excitement to join the working group if the opportunity arises and incentivize good work.

    2.1.B Narrow technologies from the longlist down to a shortlist using Info-Tech’s Disruptive Technology Shortlisting Tool

    90 minutes

    To decide which technology has potential for your organization, have the working group or workshop participants evaluate each technology:

    1. Record each potentially disruptive technology in the longlist on a whiteboard.
    2. Making sure to carefully consider the meaning of the terms, have each member of the group evaluate each technology as “high” or “low” along each of the axes, innovation and transformation, on a piece of paper.
    3. The facilitator collects each piece of paper and inputs the results by technology into the Disruptive Technology Shortlisting Tool.
    Technology Innovation Transformation
    Conversational Commerce High High

    Insert the final shortlist into Section 2.2 of your Disruptive Technology Exploitation Plan Template.

    Input

    • Longlist
    • Futurist brainstorming

    Output

    • Shortlist

    Materials

    • Disruptive Technology Research Database Tool
    • Whiteboard and markers
    • Virtual whiteboard

    Participants

    • Core working group

    Disruptive technologies are innovative and transformational

    Innovation

    Transformation

    • Elements:
      • Creative solution to a problem that is relatively new on the scene.
      • It is different, counterintuitive, or insightful or has any combination of these qualities.
    • Questions to Ask:
      • How new is the technology?
      • How different is the technology?
      • Have you seen anything like it before? Is it counterintuitive?
      • Does it offer an insightful solution to a persistent problem?
    • Example:
      • The sharing economy: Today, simple platforms allow people to share rides and lodgings cheaply and have disrupted traditional services.
    • Elements:
      • Positive change to the business process.
      • Highly impactful: impacts a wide variety of roles in a company in a nontrivial way or impacts a smaller number of roles more significantly.
    • Questions to Ask:
      • Will this technology have a big impact on business operations?
      • Will it add substantial value? Will it change the structure of the company?
      • Will it impact a significant number of employees in the organization?
    • Example:
      • Flash memory improved storage technology incrementally by building on an existing foundation.

    Info-Tech Insight

    Technology can be transformational but not innovative. Not every new technology is disruptive. Even where technology has improved the efficiency of the business, if it does this in an incremental way, it might not be worth exploring using this storyboard.

    2.1.C Use the shortlisting tool to help participants visualize the potential

    1 hour

    Use the Disruptive Technology Shortlisting Tool, tabs 2 and 3.

    Assign quadrants

    • Input group members’ names and the entire longlist (up to 30 technologies) into tab 2 of the Disruptive Technology Shortlisting Tool.
    • On tab 3 of the Disruptive Technology Shortlisting Tool, input the quadrant number that corresponds to the innovation and transformation scores each participant has assigned to each technology.

    Note

    This is an assessment meant to serve as a guide. Use discretion when moving forward with a proof-of-concept project for any potentially disruptive technology.

    Participant Evaluation Quadrant
    High Innovation, High Transformation 1
    High Innovation, Low Transformation 2
    Low Innovation, Low Transformation 3
    Low Innovation, High Transformation 4

    four quadrants are depicted, labeled 1-4. The quadrants are coloured as follows: 1- green; 2- yellow; 3; red; 4; yellow

    2.1.D Use the Disruptive Technology Shortlisting Tool to produce a shortlist

    1 hour

    Use the Disruptive Technology Shortlisting Tool, tabs 3 and 4.

    Use the populated matrix and the discussion list to arrive at a shortlist of four to six potentially disruptive technologies.

    • The tool populates each quadrant based on how many votes it received in the voting exercise.
    • Technologies selected for a particular quadrant by a majority of participants are placed in the quadrant on the graph. Where there was no consensus, the technology is placed in the discussion list.
    • Technologies in the upper right quadrant – high transformation and high innovation – are more likely to be good candidates for a proof-of-concept project. Those in the bottom left are likely to be poor candidates, while those in the remaining quadrants are strong on one of the axes and are unlikely candidates for further systematic evaluation.

    This image contains a screenshot from tab 3 of the Disruptive Technology Shortlisting Tool.

    Input the results of the vote into tab 3 of the Disruptive Technology Shortlisting Tool.

    This image contains a screenshot from tab 4 of the Disruptive Technology Shortlisting Tool.

    View the results on tab 4.

    Phase 2: Resolve

    Evaluate disrupted technologies

    Activities:

    Step 2.1: Create and Winnow a Longlist
    Step 2.2:- Assess Shortlist

    This step involves the following participants:

    • Core working group
    • Infrastructure Management

    Outcomes of this step:

    • Finalized longlist
    • Finalized shortlist
    • Initial analysis of each technology on the shortlist

    Assess Shortlist

    Activities:

    1. Assess the value of each technology to your organization by breaking it down into quality and cost
    2. Investigate the overall readiness of the technologies on the shortlist
    3. Interpret each technology’s value score
    4. Conduct a SWOT analysis for each technology on the shortlist
    5. Use Info-Tech’s disruptive technology shortlist analysis to visualize the tool’s outputs
    6. Select the shortlisted technologies you would like to move forward with

    This step involves the following participants:

    • Core working group members
    • IT Management

    Outcomes of this step:

    • Finalized shortlist
    • Initial analysis of each technology on the shortlist

    2.2 Evaluate technologies based on their value and readiness, and conduct a SWOT analysis for each one

    Use the Disruptive Technology Value-Readiness and SWOT Analysis Tool

    • A technology monitor diagram prioritizes investment in technology by analyzing its readiness and value.
      • Readiness: how close the technology is to being practical and implementable in your industry and organization.
      • Value: how worthwhile the technology is, in terms of its quality and its cost.
    • Value and readiness questionnaires are included in the tool to help determine current and future values for each, and the next four slides explain the ratings further.
    • Categorize technology by its value-readiness score, and evaluate how much potential value each technology has and how soon your company can realize that value.
    • Use a SWOT analysis to qualitatively evaluate the potential that each technology has for your organization in each of the four categories (strengths, weaknesses, opportunities, and threats).

    The technology monitor diagram appears in tab 9 of the Disruptive Technology Value-Readiness and SWOT Analysis Tool

    This image depicts tab 9 of the Disruptive Technology Value-Readiness and SWOT Analysis Tool

    2.2.A Assess the value of each technology to your organization by breaking it down into quality and cost

    1 hour

    Update the Disruptive Technology Value-Readiness and SWOT Analysis Tool, tab 4.

    Populate the chart to produce a score for each technology’s overall value to the company conceptualized as the interaction of quality and cost.

    Overall Value

    Quality Cost

    Each technology, if it has a product associated with it, can be evaluated along eight dimensions of quality. Consider how well the product performs, its features, its reliability, its conformance, its durability, its serviceability, its aesthetics, and its perceived quality.

    IT budgets are broken down into capital and operating expenditures. A technology that requires a significant investment along either of these lines is unlikely to produce a positive return. Also consider how much time it will take to implement and operate each technology.

    The value assessment is part of the Disruptive Technology Value-Readiness and SWOT Analysis Tool

    This image contains a screenshot from tab 4 of the Disruptive Technology Value-Readiness and SWOT Analysis Tool.

    Info-Tech Insight

    Watch your costs: Technology that seems cheap at first can actually be expensive over time. Be sure to account for operational and opportunity costs as well.

    2.2.B Investigate the overall readiness of the technologies on the shortlist

    1 hour

    Update the Disruptive Technology Value-Readiness and SWOT Analysis Tool, tab 4.

    Overall Readiness

    Age

    How much time has the technology had to mature? Older technology is more likely to be ready for adoption.

    Venture Capital

    The amount of venture capital gathered by important firms in the space is an indicator of market faith.

    Market Size

    How big is the market for the technology? It is more difficult to break into a giant market than a niche market.

    Market Players

    Have any established vendors (Microsoft, Facebook, Google, etc.) thrown their weight behind the technology?

    Fragmentation

    A large number of small companies in the space indicates that the market has yet to reach equilibrium.

    The readiness assessment is part of the Disruptive Technology Value-Readiness and SWOT Analysis Tool

    This image contains a screenshot of the Readiness Scoring tab of the Disruptive Technology Value-Readiness and SWOT Analysis Tool.

    Use a variety of sources to populate the chart

    Google is your friend: search each shortlisted technology to find details about its development and important vendors.

    Websites like Crunchbase, VentureBeat, and Mashable are useful sources for information on the companies involved in a space and the amount of money they have each raised.

    2.2.C Interpret each technology’s value score

    1 hour

    Insert the result of the SWOT analysis into tab 7 of Info-Tech’s Disruptive Technology Value-Readiness and SWOT Analysis Tool.

    Visualize the results of the quality-cost analysis

    • Quality and cost are independently significant; it is essential to understand how each technology stacks up on the axes.
    • Use tab 6 of the Disruptive Technology Value-Readiness and SWOT Analysis Tool for an illustration of how quality and cost interact to produce each technology’s final position on the tech monitor graph.
    • Remember: the score is notional and reflects the values that you have assigned. Be sure to treat it accordingly.

    This image contains a screenshot of the Value Analysis tab of the Disruptive Technology Value-Readiness and SWOT Analysis Tool

    Green represents a technology that scores extremely high on one axis or the other, or quite high on both. These technologies are the best candidates for proof-of-concept projects from a value perspective.

    Red represents a technology that has scored very low on both axes. These technologies will be expensive, time consuming, and of poor quality.

    Yellow represents the fuzzy middle ground. These technologies score moderately on both axes. Be especially careful when considering the SWOT analysis of these technologies.

    2.2.D Conduct a SWOT analysis for each technology on the shortlist

    1 hour

    Use tab 6 of the Disruptive Technology Value-Readiness and SWOT Analysis Tool.

    A formal process for analyzing disruptive technology is the only way to ensure that it is taken seriously.

    Write each technology as a heading on a whiteboard. Spend 10-15 minutes on each technology conducting a SWOT analysis together.

    Consider four categories for each technology:

    • Strengths: Current uses of the technology or supporting technology and ways in which it helps your organization.
    • Weaknesses: Current limitations of the technology and challenges or barriers to adopting it in your organization.
    • Opportunities: Potential uses of the technology, especially as it advances or improves.
    • Threats: Potential negative disruptions resulting from the technology, especially as it advances or improves.

    The list of processes generated at the cycle’s initial meeting is a great source for opportunities and threats.

    Disruptive Technology Value-Readiness and SWOT Analysis Tool

    This image contains screenshots of the technology tab of the Disruptive Technology Value-Readiness and SWOT Analysis Tool.

    2.2.E Use Info-Tech’s disruptive technology shortlist analysis to visualize the tool’s outputs

    1 hour

    Disruptive Technology Value-Readiness and SWOT Analysis Tool, tab 9

    The tool’s final tab displays the results of the value-readiness analysis and the SWOT analysis in a single location.

    This image contains a screenshot from tab 9 of the Disruptive Technology Value-Readiness and SWOT Analysis Tool

    Insert the shortlist analysis report into Section 3 of your Disruptive Technology Exploitation Plan Template.

    2.2.F Select the shortlisted technologies you would like to move forward with

    1 hour

    Present your findings to the working group.

    • The Disruptive Technology Value-Readiness and SWOT Analysis Tool aggregates your inputs in an easy-to-read, consistent way.
    • Present the tool’s outputs to members of the core working group.
    • Explain the scoring and present the graphic to the group. Go over each technology’s strengths and weaknesses as well as the opportunities and threats it presents/poses to the organization.
    • Go through the proof-of-concept planning phase before striking any technologies from the list.

    This image contains a screenshot of the disruptive technology shortlist analysis from the Disruptive Technology Value-Readiness and SWOT Analysis Tool

    Info-Tech Insight

    A technology’s exceptional value and immediate usability make it the best. A technology can be promising and compelling, but it is unsuitable unless it can bring immediate and exceptional value to your organization. Don’t get caught up in the hype.

    Evaluate

    Create an Action Plan to Exploit Disruptive Technologies

    PHASE 3

    Phase 3: Evaluate

    Create an Action Plan to Exploit Disruptive Technologies

    Activities:

    Step 3.1: Create Process Maps
    Step 3.2: Develop Proof of Concept Charter

    This step involves the following participants:

    • Core working group
    • Infrastructure Management
    • Working group leader
    • CIO

    Outcomes of this step:

    • Business process maps before and after disruption
    • Proof of concept charter
    • Key performance indicators
    • Estimation of required resources

    Step 3.1

    Create Process Maps

    Activities:

    1. Creating a problem canvas by identifying stakeholders, jobs, pains, and gains
    2. Clarify the problem the proof-of-concept project will solve
    3. Identify jobs and stakeholders
    4. Outline how disruptive technology will solve the problem
    5. Map business processes
    6. Identify affected business units
    7. Outline and map the business processes likely to be disrupted
    8. Recognize how the new technology will impact business processes
    9. Make the case: Outline why the new business process is superior to the old

    This step involves the following participants:

    • Working group leader
    • CIO

    Outcomes of this step:

    • Business process maps before and after disruption

    3.1 Create an action plan to exploit disruptive technologies

    Clarify the problem in order to make the case. Fill in section 1.1 of Info-Tech’s Proof of Concept Template to clearly outline the problem each proof of concept is designed to solve.

    Establish roles and responsibilities. Use section 1.2 of the template to outline the roles and responsibilities that fall to each member of the team. Ensure that clear lines of authority are delineated and that the list of stakeholders is exhaustive: include the executives whose input will be required for project approval, all the way to the technicians on the frontline responsible for implementing it.

    Outline the solution to the problem. Demonstrate how each proof-of-concept project provides a solution to the problem outlined in section 1.1. Be sure to clarify what makes the particular technology under investigation a potential solution and record the results in section 1.3.

    This image contains a screenshot of the Proof of concept project template

    Use the Proof of Concept Project Template to track the information you gather throughout Phase 3.

    3.1.A Creating a problem canvas by identifying stakeholders, jobs, pains, and gains

    2 hours

    Instructions:

    1. On a whiteboard, draw the visual canvas supplied below.
    2. Select your issue area, and list jobs, pains, and gains in the associated sections.
    3. Record the pains, jobs, and gains in sections 1.1-1.3 of the Proof of Concept Template.

    Gains

    1. More revenue

    2. Job security

    3. ……

    Jobs

    1. Moving product

    2. Per sale value

    3. ……

    Pains

    1. Clunky website

    2. Bad site navigation

    3. ……

    Input

    • Inspiration
    • Anonymous ideas

    Output

    • List of processes

    Materials

    • Chart paper and markers
    • Pen and paper

    Participants

    • Core working group
    • Visionaries

    3.1.B Clarify the problem the proof-of-concept project will solve

    2 hours

    What is the problem?

    • Every technology is designed to solve a problem faced by somebody somewhere. For each technology that your team has decided to move forward with, identify and clearly state the problem it would solve.
    • A clear problem statement is a crucial part of a new technology’s business case. It is impossible to earn buy-in from the rest of the organization without demonstrating the necessity of a solution.
    • Perfection is impossible to achieve: during the course of their work, everyone encounters pain points. Identify those pain points to arrive at the problem that needs to be solved.

    Example:

    List of pains addressed by conversational commerce:

    • Search functions can be clunky and unresponsive.
    • Corporate websites can be difficult to navigate.
    • Customers are uncomfortable in unfamiliar internet environments.
    • Customers do not like waiting in a long queue to engage with customer service representatives when they have concerns.

    “If I were given one hour to solve a problem, I would spend 59 minutes defining the problem and one minute resolving it.”
    – Albert Einstein

    Input the results of this exercise into Section 1.1 of the Proof of Concept Template.

    3.1.C Identify jobs and stakeholders

    1 hour

    Jobs

    Job: Anything that the “customer” (the target of the solution) needs to get done but that is complicated by a pain.

    Examples:
    The job of the conversational commerce interface is to make selling products easier for the company.
    From the customer perspective, the job of the conversational interface is to make the act of purchasing a product simpler and easier.

    Stakeholders

    Stakeholder: Anyone who is impacted by the new technology and who will end up using, approving, or implementing it.

    Examples:
    The executive is responsible for changing the company’s direction and approving investment in a new sales platform.
    The IT team is responsible for implementing the new technology.
    Marketing will be responsible for selling the change to customers.
    Customers, the end users, will be the ones using the conversational commerce user interface.

    Input the results of this exercise into Section 1.2 of the Proof of Concept Template.

    Info-Tech Insight

    Process deconstruction reveals strengths and weaknesses. Promising technology should improve stakeholders’ abilities to do jobs.

    3.1.D Outline how disruptive technology will solve the problem

    1 hour

    How will the technology in question make jobs easier?

    • How will the disruptive technology you have elected to move forward with create gains for the organization?
    • First, identify the gains that are supposed to come with the project. Consider the benefits that the various stakeholders expect to derive from the jobs identified.
    • Second, make note of how the technology in question facilitates the gains you have noted. Be sure to articulate the exclusive features of the new technology that make it an improvement over the current state.

    Note: The goal of this exercise is to make the case for a particular technology. Sell it!

    Expected Gain: Increase in sales.

    Conversational Commerce’s Contribution: Customers are more likely to purchase products using interfaces they are comfortable with.

    Expected Gain: Decrease in costs.

    Conversational Commerce’s Contribution: Customers who are satisfied with the conversational interface are less likely to interact with live agents, saving labor costs.

    Input the results of this exercise into Section 1.3 of the Proof of Concept Template.

    3.1.E Map business processes

    1 hour

    Map the specific business processes the new technology will impact.

    • Disruptive technologies will impact a wide variety of business processes.
    • Map business processes to visualize what parts of your organization (departments, silos, divisions) will be impacted by the new technology, should it be adopted after the proof of concept.
    • Identify how the disruption will take place.
    • Demonstrate the value of each technology by including the results of the Disruptive Technology Value-Readiness and SWOT Analysis Tool with your process map.

    This image contains a screenshot of the Proof of concept project template

    Use the Proof of Concept Project Template to track the information you gather throughout Phase 3.

    3.1.F Identify affected business units

    30 minutes per technology

    Disruptive technology will impact business units.

    • Using the stakeholders identified earlier in the project, map each technology to the business units that will be affected.
    • Make your list exhaustive. While some technologies will have a limited impact on the business as a whole, others will have ripple effects throughout the organization.
    • Examine affected units at all scales: How will the technology impact operations at the team level? The department level? The division level?

    “The disruption is not just in the technology. Sometimes a good business model can be the disruptor.”
    – Jason Hong, Associate Professor, Carnegie Mellon

    Example:

    • Customer service teams: Conversational commerce will replace some of the duties of the customer service representative. They will have to reorganize to account for this development.
    • IT department: The IT department will be responsible for building/maintaining the conversational interface (or, more likely, they will be responsible for managing the contract with the vendor).
    • Sales analytics: New data from customers in natural language might provide a unique opportunity for the analytics team to develop new initiatives to drive sales growth.

    Input the results of this exercise into Section 2.1 of the Proof of Concept Template.

    3.1.G Outline and map the business processes likely to be disrupted

    15 minutes per technology

    Leverage the insights of the diverse working group.

    • Processes are designed to transform inputs into outputs. All business activities can be mapped into processes.
    • A process map illustrates the sequence of actions and decisions that transform an input into an output.
    • Effective mapping gives managers an “aerial” view of the company’s processes, making it easier to identify inefficiencies, reduce waste, and ultimately, streamline operations.
    • To identify business processes, have group members familiar with the affected business units identify how jobs are typically accomplished within those units.

    “To truly understand a business process, we need information from both the top-down and bottom-up points of view. Informants higher in the organizational hierarchy with a strategic focus are less likely to know process details or problems. But they might advocate and clearly articulate an end-to-end, customer-oriented philosophy that describes the process in an idealized form. Conversely, the salespeople, customer service representatives, order processors, shipping clerks, and others who actually carry out the processes will be experts about the processes, their associated documents, and problems or exception cases they encounter.”
    – Robert J. Glushko, Professor at UC Berkeley and Tim McGrath, Business Consultant

    Info-Tech Insight

    Opinions gathered from a group that reflect the process in question are far more likely to align with your organization’s reality. If you have any questions about a particular process, do not be afraid to go outside of the working group to ask someone who might know.

    3.1.G Outline and map the business processes likely to be disrupted (continued)

    15 minutes per technology

    Create a simple diagram of identified processes.

    • Use different shapes to identify different points in the process.
    • Rectangles represent actions, diamonds represent decisions.
    • On a whiteboard, map out the actions and decisions that take place to transform an input into an output.
    • Input the result into section 2.2 of the Proof of Concept Template.

    This image contains a screenshot of the Software Service Cross-Function Process tab from Edraw Visualization Solutions.

    Source: Edraw Visualization Solutions

    Example: simplified process map

    1. User: visits company website
    2. User: engages search function or browses links
    3. User: selects and purchases product from a menu
    4. Company: ships product to customer

    3.1.H Recognize how the new technology will impact business processes

    15 minutes per technology

    Using the information gleaned from the previous activities, develop a new process map that takes the new technology into account.

    Identify the new actions or decisions that the new technology will affect.

    User: visits company website; User: engages conversational; commerce platform; User: engages search function or browses links; User: makes a natural language query; User: selects and purchases product from a menu</p data-verified=

    User: selects and purchases product from a menu; Company: ships product to customer; Company: ships product to customer">

    Info-Tech Insight

    It’s ok to fail! The only way to know you’re getting close to the “knee of curve" is from multiple failed PoC tests. The more PoC options you have, the more likely it will be that you will have two to three successful results.

    3.1.I Make the case: Outline why the new business process is superior to the old

    15 minutes per technology

    Articulate the main benefits of the new process.

    • Using the revised process map, make the case for each new action.
    • Questions to consider: How does the new technology relieve end-user/customer pains? How does the new technology contribute to the streamlining of the business process? Who will benefit from the new action? What are the implications of those benefits?
    • Record the results of this exercise in section 2.4 of the Proof of Concept Template.

    This image contains an example of an outline comparing the benefits of new and the old business processes.

    Info-Tech Insight

    If you cannot articulate how a new technology will benefit a business process, reconsider moving forward with the proof-of-concept project.

    Phase 3: Evaluate

    Create an Action Plan to Exploit Disruptive Technologies

    Activities:

    Step 3.1: Create Process Maps
    Step 3.2: Develop Proof of Concept Charter

    Develop Proof of Concept Charter

    This step involves the following participants:

    • Core working group
    • Infrastructure Management
    • Working group leader
    • CIO

    Outcomes of this step:

    • Business process maps before and after disruption
    • Proof of concept charter
    • Key performance indicators
    • Estimation of required resources

    Step 3.2

    Develop Proof of Concept Charter

    Activities:

    1. Use SMART success metrics to define your objectives
    2. Develop key performance indicators (KPIs)
    3. Identify key success factors for the project
    4. Outline the project’s scope
    5. Identify the structure of the team responsible for the proof-of-concept project
    6. Estimate the resources required by the project
    7. Be aware of common IT project concerns
    8. Communicate your working group’s findings and successes to a wide audience
    9. Hand off the completed proof-of-concept project plan
    10. Disruption is constant: Repeat the evaluation process regularly to protect the business

    This step involves the following participants:

    • Working group leader
    • CIO

    Outcomes of this step:

    • Proof of concept charter
    • Key performance indicators
    • Estimation of required resources

    3.2 Develop a proof of concept charter

    Keep your proof of concept on track by defining five key dimensions.

    1. Objective: Giving an overview of the planned proof of concept will help to focus and clarify the rest of this section. What must the proof of concept achieve? Objectives should be: specific, measurable, attainable, relevant, and time bound. Outline and track key performance indicators.
    2. Key Success Factors: These are conditions that will positively impact the proof of concept’s success.
    3. Scope: High-level statement of scope. More specifically, state what is in scope and what is out of scope.
    4. Project Team: Identify the team’s structure, e.g. sponsors, subject-matter experts.
    5. Resource Estimation: Identify what resources (time, materials, space, tools, expertise, etc.) will be needed to build and socialize your prototype. How will they be secured?

    Input the results of this exercise into Section 3.0 of the Proof of Concept Template.

    3.2.A Use SMART success metrics to define your objectives

    Specific

    Measurable

    Actionable

    Realistic

    Time Bound

    Make sure the objective is clear and detailed.

    Objectives are measurable if there are specific metrics assigned to measure success. Metrics should be objective.

    Objectives become actionable when specific initiatives designed to achieve the objective are identified.

    Objectives must be achievable given your current resources or known available resources.

    An objective without a timeline can be put off indefinitely. Furthermore, measuring success is challenging without a timeline.

    Who, what, where, why?

    How will you measure the extent to which the goal is met?

    What is the action-oriented verb?

    Is this within my capabilities?

    By when: deadline, frequency?

    Examples:

    1. Increase in sales by $40,000 per month by the end of next quarter.
    2. Immediate increase in web traffic by 600 unique page views per day.
    3. Number of pilots approved per year.
    4. Number of successfully deployed solutions per year.

    Input the results of this exercise into Section 3.0 of the Proof of Concept Template.

    3.2.B Develop key performance indicators (KPIs)

    30 minutes per technology

    Key performance indicators allow for rigorous analysis, which generates insight into utilization by platform and consumption by business activity.

    • Use the process improvements identified in step 3.1 to brainstorm metrics that indicate when process improvement is actually taking place.
    • Have members of the group pitch KPIs; the facilitator should record each suggestion on a whiteboard.
    • Make sure to have everyone justify the inclusion of each metric: How does it relate to the improvement that the proof of concept project is intended to drive? How does it relate to the overall goals of the business?
    • Include a list of KPIs, along with a description and a target (ensuring that it aligns with SMART metrics) in section 3.1 of the Proof of Concept Template.

    “An estimated 70% of performance measurement systems fail after implementation. Carefully select your KPIs and avoid this trap!”
    Source: Collins et al. 2016

    Key Performance Indicator Description Target

    Result

    Conversion rate What percentage of customers who visit the site/open the conversational interface continue on to make a purchase? 40%
    Average order value

    How much does each customer spend per visit to the website?

    $212
    Repeat customer rate What percentage of customers have made more than one purchase over time? 65%
    Lifetime customer value Over the course of their interaction with the company, what is the typical value each customer brings? $1566

    Input the results of this exercise into Section 3.1 of the Proof of Concept Template.

    3.2.C Identify key success factors for the project

    30 minutes per technology

    Effective project management involves optimizing four key success factors (Clarke, 1999)

    • Communication: Communicate the expected changes to stakeholders, making sure that everyone who needs to know does know. Example: Make sure customer service representatives know their duties will be impacted by the conversational UI well before the proof-of-concept project begins.
    • Clarity: All involved in the project should be apprised of what the project is intended to accomplish and what the project is not intended to accomplish. Example: The conversational commerce project is not intended to be rolled out to the entire customer base all at once; it is not intended to disrupt normal online sales.
    • Compartmentalization: The working group should suggest some ways that the project can be broken down to facilitate its effective implementation. Example: Sales provides details of customers who might be amenable to a trial, IT secures a vendor, customer service writes a script.
    • Flexibility: The working group’s final output should not be treated as gospel. Ensure that the document can be altered to account for unexpected events. Example: The conversational commerce platform might drive sales of a particular product more than others, necessitating adjustments at the warehouse and shipping level.

    Input the results of this exercise into Section 3.0 of the Proof of Concept Template.

    3.2.D Outline the project’s scope

    10 minutes per technology

    Create a high-level outline of the project’s scope.

    • Questions to consider: Broadly speaking, what are the project’s goals? What is the desired future state? Where in the company will the project be rolled out? What are some of the company’s goals that the project is not designed to cover?
    • Be sure to avoid scope creep! Remember: The goal of the proof-of-concept project is to produce a minimum case for viability in a carefully defined area. Reserve a detailed accounting of costs and benefits for the post-proof-of-concept stage.
    • Example: The conversational user interface will only be rolled out in an e-commerce setting. Other business units (HR, for example) are beyond the scope of this particular project.

    “Although scope creep is not the only nemesis a project can have, it does tend to have the farthest reach. Without a properly defined project and/or allowing numerous changes along the way, a project can easily go over budget, miss the deadline, and wreak havoc on project success.”
    – University Alliance, Villanova University

    Input the results of this exercise into Section 3.0 of the Proof of Concept Template.

    3.2.E Identify the structure of the team responsible for the proof-of-concept project

    10 minutes per technology

    Brainstorm who will be involved in project implementation.

    • Refer back to the list of stakeholders identified in 3.1.a. Which stakeholders should be involved in implementing the proof-of-concept plan?
    • What business units do they represent?
    • Who should be accountable for the project? At a high level, sketch the roles of each of the participants. Who will be responsible for doing the work? Who will approve it? Who needs to be informed at every stage? Who are the company’s internal subject matter experts?

    Example

    Name/Title Role
    IT Manager Negotiate the contract for the software with vendor
    CMO Promote the conversational interface to customers

    Input the results of this exercise into Section 3.0 of the Proof of Concept Template.

    3.2.F Estimate the resources required by the project

    10 minutes per technology

    Time and Money

    • Recall: Costs can be operational, capital, or opportunity.
    • Revisit the Disruptive Technology Value-Readiness and SWOT Analysis Tool. Record the capital and operational expenses expected to be associated with each technology, and add detail where possible (use exact figures from particular vendors instead of percentages).
    • Write the names and titles of each expected participant in the project on a whiteboard. Next to each name, write the number of hours they are expected to devote to the project and include a rough estimate of the cost of their participation to the company. Use full-time employee equivalent (FTE measures) as a base.
    • Outline how other necessary resources (space, tools, expertise, etc.) will be secured.

    Example: Conversational Commerce

    • OpEx: $149/month + 2.9¢/transaction* (2,000 estimated transactions)
    • CapEx: $0!
    • IT Manager: 5 hours at $100/hour
    • IT Technician: 40 hours at $45/hour
    • CMO: 1 hour at $300/hour
    • Customer Service Representative: 10 hours at $35/hour
    • *Estimated total cost for a one-month proof-of-concept project: $3,157

    *This number is a sample taken from the vendor Rhombus

    Input the results of this exercise into Section 3.0 of the Proof of Concept Template.

    3.2.G Be aware of common IT project concerns

    Of projects that did not meet business expectations or were cancelled, how significant were the following issues?

    A bar graph is depicted, comparing small, medium, and large businesses for the following datasets: Over budget; Project failed to be delivered on time; Breach of scope; Low quality; Failed to deliver expected benefit or value

    This survey data did not specifically address innovation projects.

    • Disruptive technology projects will be under increased scrutiny in comparison to other projects.
    • Be sure to meet deadlines and stay within budget.
    • Be cognizant that your projects can go out of scope, and there will be projects that may have to be cancelled due to low quality. Remember: Even a failed test is a learning opportunity!

    Info-Tech’s CIO-CEO Alignment Survey, N=225

    Organization size was determined by the number of IT employees within the organization

    Small = 10 or fewer IT staff, medium = 11 to 25 IT staff, and large/enterprise = 26 or greater IT staff

    3.2.H Communicate your working group’s findings and successes to a wide audience

    Advertise the group’s successes and help prevent airline magazine syndrome from occurring.

    • Share your group’s results internally:
      • Run your own analysis by senior management and then share it across the organization.
      • Maintain a list of technologies that the working group has analyzed and solicit feedback from the wider organization.
      • Post summaries of the technologies in a publicly available repository. The C-suite may not read it right away, but it will be easy to provide when they ask.
      • If senior management has declined to proceed with a certain technology, avoid wasting time and resources on it. However, include notes about why the technology was rejected.
    • These postings will also act as an advertisement for the group. Use the garnered interest to attract visionaries for the next cycle.
    • These postings will help to reiterate the innovative value of the IT department and help bring you to the decision-making table.

    “Some CIOs will have to battle the bias that they belong in the back office and shouldn’t be included in product architecture planning. CIOs must ‘sell’ IT’s strength in information architecture.”
    – Chris Curran, Chief Technologist, PwC (Curran, 2014)

    Info-Tech Insight

    Cast a wide net. By sharing your results with as many people as possible within your organization, you’ll not only attract more attention to your working group, but you will also get more feedback and ideas.

    3.2.I Hand off the completed proof-of-concept project plan

    The proof of concept template is filled out – now what?

    • The core working group is responsible for producing a vision of the future and outlining new technology’s disruptive potential. The actual implementation of the proof of concept (purchasing the hardware, negotiating the SLA with the vendor) is beyond the working group’s responsibilities.
    • If the proof of concept goes ahead, the facilitator should block some time to evaluate the completed project against the key performance indicators identified in the initial plan.
    • A cure for airline magazine syndrome: Be prepared when executives ask about new technology. Present them with the results of the shortlist analysis and the proof-of-concept plan. A clear accounting of the value, readiness, strengths, weaknesses, opportunities, and threats posed by each technology, along with its impact on business processes, is an invaluable weapon against poor technology choices.

    Use section 3.2.b to identify the decision-making stakeholder who has the most to gain from a successful proof-of-concept project. Self-interest is a powerful motivator – the project is more likely to succeed in the hands of a passionate champion.

    Info-Tech Insight

    Set a date for the first meeting of the new iteration of the disruptive technology working group before the last meeting is done. Don’t risk pushing it back indefinitely.

    3.2.J Hand off the completed proof-of-concept project plan

    Record the results of the proof of concept. Keep track of what worked and what didn’t.

    Repeat the process regularly.

    • Finalize the proof of concept template, but don’t stop there: Keep your ear to the ground; follow tech developments using the sources identified in step 1.2.
    • Continue expanding the potential longlist with independent research: Be prepared to expand your longlist. Remember, the more technologies you have on the longlist, the more potential airline magazine syndrome cures you have access to.
    • Have the results of the previous session’s proof of concept plan on hand: At the start of each new iteration, conduct a review. What technologies were successful beyond the proof of concept phase? Which parts of the process worked? Which parts did not? How could they be improved?

    Info-Tech Insight

    The key is in anticipation. This is not a one-and-done exercise. Technology innovation operates at a faster pace than ever before, well below the Moores Law "18 month" timeline as an example. Success is in making EDIT a repeatable process.

    Related Info-Tech Research

    Define Your Digital Business Strategy
    After a major crisis, find your place in the digital economy.

    Develop a Project Portfolio Management Strategy
    Drive project throughput by throttling resource capacity.

    Adopt Design Thinking in Your Organization
    Innovation needs design thinking.

    Digital Maturity Improvement Service
    Prepare your organization for digital transformation – or risk falling behind.

    Research contributors and experts

    Nitin Babel

    Nitin Babel, Co-Founder, niki.ai

    Nitin Babel, MSc, co-created conversational commerce platform niki.ai in early 2015. Since then, the technology has been featured on the front page of the Economic Times, and has secured the backing of Ratan Tata, former chairman of the Tata Group, one of the largest companies in the world.

    Mark Hubbard

    Mark Hubbard, Senior Vice President, FirstOnSite

    Mark is the SVP for Information Technology in Canada with FirstOnSite, a full service disaster recovery and property restoration company. Mark has over 25 years of technology leadership guiding global organizations through the development of strategic and tactical plans to strengthen their technology platforms and implement business aligned technology strategies.

    Chris Green

    Chris Green, Enterprise Architect, Boston Private
    Chris is an IT architect with over 15 years’ experience designing, building, and implementing solutions. He is a results-driven leader and contributor, skilled in a broad set of methods, tools, and platforms. He is experienced with mobile, web, enterprise application integration, business process, and data design.

    Andrew Kope

    Andrew Kope, Head of Data Analytics
    Big Blue Bubble
    Andrew Kope, MSc, oversees a team that develops and maintains a user acquisition tracking solution and a real-time metrics dashboard. He also provides actionable recommendations to the executive leadership of Big Blue Bubble – one of Canada’s largest independent mobile game development studios.

    Jason Hong

    Jason Hong, Associate Professor, School of Computer Science, Human-Computer Interaction Institute, Carnegie Mellon University

    Jason Hong is a member of the faculty at Carnegie Mellon’s School of Computer Science. His research focus lies at the intersection of human-computer interaction, privacy and security, and systems. He is a New America National Cyber Security Fellow (2015-2017) and is widely published in academic and industry journals.

    Tim Lalonde

    Tim Lalonde, Vice President, Mid-Range

    Tim Lalonde is the VP of Technical Operations at Mid-Range. He works with leading-edge companies to be more competitive and effective in their industries. He specializes in developing business roadmaps leveraging technology that create and support change from within — with a focus on business process re-engineering, architecture and design, business case development and problem-solving. With over 30 years of experience in IT, Tim’s guiding principle remains simple: See a problem, fix a problem.

    Jon Mavor

    Jon Mavor, Co-Founder and CTO, Envelop VR
    Jon Mavor is a programmer and entrepreneur, whose past work includes writing the graphics engine for the PC game Total Annihilation. As Chief Technology Officer of Envelop VR, a virtual reality start-up focused on software for the enterprise, Jon has overseen the launch of Envelop for Windows’s first public beta.

    Dan Pitt

    Dan Pitt, President, Palo Alto Innovation Advisors
    Dan Pitt is a network architect who has extensive experience in both the academy and industry. Over the course of his career, Dan has served as Executive Director of the Open Networking Foundation, Dean of Engineering at Santa Clara University, Vice President of Technology and Academic Partnerships at Nortel, Vice President of the Architecture Lab at Bay Networks, and, currently, as President of Palo Alto Innovation Advisors, where he advises and serves as an executive for technology start-ups in the Palo Alto area and around the world.

    Courtney Smith

    Courtney Smith, Co-Founder, Executive Creative Director
    PureMatter

    Courtney Smith is an accomplished creative strategist, storyteller, writer, and designer. Under her leadership, PureMatter has earned hundreds of creative awards and been featured in the PRINT International Design Annual. Courtney has juried over 30 creative competitions, including Creativity International. She is an invited member of the Academy of Interactive and Visual Arts.

    Emmanuel Tsekleves

    Emmanuel Tsekleves, Senior Lecturer in Design Interactions, University of Lancaster
    Dr. Emmanuel Tsekleves is a senior lecturer and writer based out of the United Kingdom. Emmanuel designs interactions between people, places, and products by forging creative design methods along with digital technology. His design-led research in the areas of health, ageing, well-being, and defence has generated public interest and attracted media attention by the national press, such as the Daily Mail, Daily Mirror, The Times, the Daily Mail, Discovery News, and several other international online media outlets.

    Bibliography

    Airini Ab Rahman. “Emerging Technologies with Emerging Effects; A Review”. Universiti Teknologi Malaysia. PERINTIS eJournal, June 2017. Web.

    Anthony, Scott. “Kodak’s Downfall Wasn’t About Technology.” Harvard Business Review, 15 July 2016. Web.

    ARM. The Intelligent Flexible Cloud. 26 Feb. 2015. Web.

    Association of Computing Machinery. Communications of the ACM, n.d. Web.

    Barnett, Thomas. “Three Mobile Trends to Watch.” Cisco Blogs, 3 Feb. 2015. Web.

    Batelle, John. “The 70 Percent Solution.” CNN, 1 Dec 2005. Web.

    Booz Allen Hamilton. Managing Technological Change: 7 Ways to Talk Tech with Management, n.d. Web.

    Brynjolfsson, Erik, and Andrew McAfee. The Second Machine Age: Work, Progress, and Prosperity in a Time of Brilliant Technologies. W. W. Norton, 2014. Print.

    Christensen, Clayton M. “What is Disruptive Innovation?” Harvard Business Review, Dec 2015. Web.

    Christensen, Clayton M. and James Euchner. “Managing Disruption: An Interview With Clayton Christensen.” Research-Technology Management, 22 Dec 2015. vol. 54, no. 1. Web.

    Christensen, Clayton M., Rory McDonald, and Elizabeth J. Altman. “Disruptive Innovation: An Intellectual History and Directions for Future Research”. Wiley Online Library. Web.

    Christensen, Clayton M., Taddy Hall, Karen Dillon, and David S. Duncan. “Know Your Customers’ Jobs to be Done.” Harvard Business Review, Sept. 2016. Web.

    Cisco. “Cisco Annual Internet Report.” n.d. Web.

    Cisco. Cisco Visual Networking Index: Forecast and Methodology, 2014-2019, 27 May 2015. Web.

    Clark, Steven. “Elon Musk hopes SpaceX will send humans to Mars in 2024.” Spaceflight Now, 2 June 2016. Web.

    Clarke, Angela. “A practical use of key success factors to improve the effectiveness of project management,” International Journal of Project Management, June 1999 (17): 139-145.

    Collins, Andrew L., Patrick Hester, Barry Ezell, and John Horst. “An improvement selection methodology for key performance indicators.” Environmental Systems and Decisions, June 2016, 36 (2): 196-208.

    Computer Sciences Corporation. CSC Global CIO Survey: 2014-2015: CIOs Emerge as Disruptive Innovators: An Annual Barometer of Global CIOs’ Plans, Priorities, Threats, and Opportunities, 2014. Web.

    Constine, John. “Voice is Chat’s Next Battleground.” TechCrunch, 19 Sept. 2016. Web.

    Cressman, Daryl. “Disruptive Innovation and the Idea of Technology”. Maastricht University, June 2019. Web.

    Crown Prosecution Service. A Guide to Process Mapping and Improvement. n.d. Web.

    Curran, Chris. “The CIO’s Role in the Internet of Things.” PwC, 13 Mar. 2014. Web.

    Darbha, Sheta, Mike Shevenell, and Jason Normandin. “Impact of Software-Defined Networking on Infrastructure Management.” CA Technology Exchange, 4.3, Nov. 2013, pp. 33-43. Web.

    Denecken, Sven. Conquering Disruption Through Digital Transformation: Technologies, Leadership Strategies, and Best Practices to Create Opportunities for Innovation. SAP, 2014. Web.

    DHL Trend Research and Cisco Consulting Services. Internet of Things in Logistics: A Collaborative Report by DHL and Cisco on Implications and Use Cases for the Logistics Industry, 2015. Web.

    Dirican, Cüneyt. “The Impacts of Robotics, Artificial Intelligence on Business and Economics.” Procedia: Social and Behavioral Sciences, vol. 195, 2015, pp. 564-573. Web.

    Edraw Visualization Solutions. Examples of Flowcharts, Org Charts and More. “Cross-Function Flowchart Examples – Service Flowchart.”

    Emerson. Data Center 2025: Exploring the Possibilities, 2014. Web.

    Ericsson. Next-Generation Data Center Infrastructure, Feb. 2015. Web.

    Eurotech. Connecting M2M Applications to the Cloud to Bolster Hardware Sales, 2014. Web.

    Evans Gary, Llewellyn. “Disruptive Technology and the Board: The Tip of the Iceberg”. Economics and Business Review, n.d. Web.

    Evans Gary, Llewellyn. “Disruptive Technology and the Board: The Tip of the Iceberg”. Economics and Business Review, n.d. Web.

    Gage, Deborah. “The Venture Capital Secret: 3 Out of 4 Start-Ups Fail.” Wall Street Journal, 20 Sept. 2012. Web.

    Garvin, David A. “Competing on the Eight Dimensions of Quality.” Harvard Business Review, November 1987. Web.

    Gibbs, Colin. Augmented Reality in the Enterprise: Opportunities and Challenges. Gigaom Research, 26 Jan. 2015. Web.

    Glushko, Robert J. and Tim McGrath. Document Engineering: Analyzing and Designing Documents for Business Informatics and Web Services. MIT Press, 2005.

    Hadfield, Tom. “Facebook’s Messenger Bot Store could be the most important launch since the App Store.” TechCrunch, 17 March 2016. Web.

    Healey, Nic. “Microsoft's mixed reality vision: 80 million devices by 2020.” CNET, 1 June 2016. Web.

    Hewlett-Packard. Go Beyond Cost Reduction: Use Robotic Process Automation, Oct. 2015. Web.

    Hewlett-Packard. HP Composable Infrastructure: Bridging Traditional IT with the New Style of Business, June 2015. Web.

    Hewlett-Packard. HP Labs, n.d. Web.

    Hong, Jason. “Inside the Great Wall.” Communications of the ACM, 25 May 2016. Web.

    IBM Institute for Value. Your Cognitive Future: How Next-Gen Computing Changes the Way We Live and Work, 2015. Web.

    IBM. A New Way to Work: Futurist Insights to 2025 and Beyond, Jan. 2015. Web.

    Infinity. The Evolution of the Data Centre [sic], 2015. Web.

    Intel Corporation. Intel Annual Report, 1997. Web.

    Isaac, Mike. “Facebook Bets on Bots for its Messenger App.” New York Times, 12 April 2016. Web.

    ISACA. COBIT 5: Enabling Processes. ISACA, 2012. Print.

    K-12 Blueprint. “Planning a Proof of Concept.” 2014. Web.

    Kaushik Rukmini, Meenakshi. “The Impact of Pandemic COVID -19 in Workplace.” European Journal of Business Management and Research, May 2020. Web.

    Knight, Will. “Conversational Interfaces Powerful speech technology from China’s leading Internet company makes it much easier to use a smartphone.” MIT Technology Review, n.d. Web.

    Kostoff, Ronald N., Robert Boylan, and Gene R. Simons. “Disruptive Technology Roadmaps.” Technological Forecasting and Social Change, 2004. Vol. 71. Web.

    Kurzweil, Ray. “The Accelerating Power of Technology.” TED, Feb. 2005. Web.

    Kurzweil, Ray. Kurzweil: Accelerating Intelligence, 2015. Web.

    MacFarquhar, Larissa. “When Giants Fall: What Business Has Learned From Clayton Christensen,” New Yorker, 14 May 2012. Web.

    McClintock, Cat. “2016: The Year for Augmented Reality in the Enterprise.” PTC, n.d. Web.

    McKinsey & Company. IT Growth and Global Change: A Conversation with Ray Kurzweil. 29 Feb. 2012, YouTube. Web.

    Messina, Chris. “2016 Will be the Year of Conversational Commerce.” Medium, 19 Jan 2016. Web.

    Microsoft. Microsoft Research, n.d. Web.

    Miller, Ron. “Forget the Apple Watch, Think Drones in the Enterprise.” TechCrunch, 10 Sep. 2015. Web.

    Nokia Networks. FutureWorks [sic]: Teaching Networks to be Self-Aware: Technology Vision 2020. 2014. Web.

    Nokia Networks. Internet of Things. n.d. Web.

    O’Reilly, Charles, and Andrew J. M. Binns, “The Three Stages of Disruptive Innovation: Idea Generation, Incubation, and Scaling”. Sage Journals, n.d. Web.

    Pew Research Center. AI, Robotics, and the Future of Jobs: Experts Envision Automation and Intelligent Digital Agents Permeating Vast Areas of Our Work and Personal Lives by 2025, but they are Divided on Whether these Advances will Displace More Jobs than they Create. Aug. 2014. Web.

    Ramiller, Neil. “Airline Magazine Syndrome: Reading a Myth of Mismanagement.” Information Technology & People, Sept 2001. Print.

    Raymond James & Associates. The Internet of Things: A Study in Hype, Reality, Disruption, and Growth. 2014. Web.

    Richter, Felix. “No Growth in Sight for Global PC Market.” Statista, 14 March 2016. Web.

    Roy, Mekhala. “4 Examples of Digital Transformation Success in Business”. TechTarget, n.d. Web.

    Simon Weinreich, “How to Manage Disruptive Innovation - a conceptional methodology for value-oriented portfolio planning,” Sciencedirect. 31st CIRP Design Conference 2021.

    Spice Works. The Devices are Coming! How the “Internet of Things” will affect IT… and why resistance is futile. May 2014. Web.

    Spradlin, Dwayne. “Are You Solving the Right Problem?” Harvard Business Review, Sept. 2012. Web.

    Statista. “Number of smartphones sold to end users worldwide from 2007 to 2015 (in million units).” N.d. Web.

    Statista. “Worldwide tablet shipments from 2nd quarter 2010 to 2nd quarter 2016 (in million units).” N.d. Web.

    Sven Schimpf, “Disruptive Field Study; How Companies Identify, Evaluate, Develop and Implement Disruptive Technologies.” Fraunhofer Group for Innovation Research, 2020. Web.

    Tsekleves, Emmanuel. “Science fiction as fact: how desires drive discoveries.” The Guardian. 13 Aug. 2015. Web.

    Tsekleves, Emmanuel. “Science fiction as fact: how desires drive discoveries.” The Guardian, 13 Aug. 2015. Web.

    United States Department of Transportation. “National Motor Vehicle Crash Causation Survey: Report to Congress.” National Highway Traffic Safety Administration, July 2008. Web.

    United States Department of Transportation. “National Motor Vehicle Crash Causation Survey: Report to Congress.” National Highway Traffic Safety Administration, July 2008. Web.

    University Alliance (Villanova U). Managing Scope Creep in Project Management. N.d. Web.

    Vavoula, Giasemi N., and Mike Sharples. “Future Technology Workshop: A Collaborative Method for the Design of New Learning Technologies and Activities.” International Journal of Computer Supported Collaborative Learning, Dec 2007. Vol. 2 no. 4. Web.

    Walraven Pieter. “It’s Operating Systems Vs. Messaging Apps In The Battle For Tech’s Next Frontier.” TechCrunch, 11 Aug 2015. Web.

    Webb, Amy. “The Tech Trends You Can’t Ignore in 2015.” Harvard Business Review, 5 Jan. 2015. Web.

    Wenger, Albert. “The Great Bot Rush of 2015-16.” Continuations, 16 Dec 2015. Web.

    White, Chris. “IoT Tipping Point Propels Digital Experience Era.” Cisco Blogs, 12 Nov. 2014. Web.

    World Economic Forum and Accenture. Industrial Internet of Things: Unleashing the Potential of Connected Products and Services. 2015. Web.

    Yu Dan and Hang Chang Chieh, "A reflective review of disruptive innovation theory," PICMET '08 - 2008 Portland International Conference on Management of Engineering & Technology, 2008, pp. 402-414, doi: 10.1109/PICMET.2008.4599648.

    Ransomware Cyber Attack. The real Disaster Recovery Scenario

    Cyber-ransomware criminals need to make sure that you cannot simply recover your encrypted data via your backups. They must make it look like paying is your only option. And if you do not have a strategy that takes this into account, unfortunately, you may be up the creek without a paddle. because how do they make their case? Bylooking for ways to infect your backups, way before you find out you have been compromised.

    That means your standard disaster recovery scenarios provide insufficient protection against this type of event. You need to think beyond DRP and give consideration to what John Beattie and Michael Shandrowski call "Cyber Incident Recovery Risk management" (CIR-RM).

    incident, incident management, cybersecurity, cyber, disaster recovery, drp, business continuity, bcm, recovery

    Register to read more …

    Develop an IT Strategy to Support Customer Service

    • Buy Link or Shortcode: {j2store}528|cart{/j2store}
    • member rating overall impact: N/A
    • member rating average dollars saved: N/A
    • member rating average days saved: N/A
    • Parent Category Name: Customer Relationship Management
    • Parent Category Link: /customer-relationship-management
    • Customer expectations regarding service are rapidly evolving. As your current IT systems may be viewed as ineffective at delivering upon these expectations, a transformation is called for.
    • It is unclear whether IT has the system architecture/infrastructure to support modern Customer Service channels and technologies.
    • The relationship between Customer Service and IT is strained. Strategic system-related decisions are being made without the inclusions of IT, and IT is only engaged post-purchase to address integration or issues as they arise.
    • Scope: An ABPM-centric approach is taken to model the desired future state, and retrospectively look into the current state to derive gaps and sequential requirements. The requirements are bundled into logical IT initiatives to be plotted on a roadmap and strategy document.
    • Challenge: The extent to which business processes can be mapped down to task-based Level 5 can be challenging depending on the maturity of the organization.
    • Pain/Risk: The health of the relationship between IT and Customer Service may determine project viability. Poor collaboration and execution may strain the relationship further.

    Our Advice

    Critical Insight

    • When transformation is called for, start with future state visioning. Current state analysis can impede your ability to see future needs and possibilities.
    • Solve your own problems by enhancing core or “traditional” Customer Service functionality first, and then move on to more ambitious business enabling functionality.
    • The more rapidly businesses can launch applications in today’s market, the better positioned they are to improve customer experience and reap the associated benefits. Ensure that technology is implemented with a solid strategy to support the initiative.

    Impact and Result

    • The right technology is established to support current and future Customer Service needs.
    • Streamlined and optimized Customer Service processes that drive efficiency and improve Customer Service quality are established.
    • The IT and Customer Service functions are both transformed from a cost center into a competitive advantage.

    Develop an IT Strategy to Support Customer Service Research & Tools

    Besides the small introduction, subscribers and consulting clients within this management domain have access to:

    1. Structure the project

    Identify project stakeholders, define roles, and create the project charter.

    • Develop an IT Strategy to Support Customer Service Storyboard
    • Project RACI Chart
    • Project Charter

    2. Define vision for future state

    Identify and model the future state of key business processes.

    • Customer Service Business Process Shortlisting Tool
    • Customer Service Systems Strategy Tool

    3. Document current state and assess gaps

    Model the current state of key business processes and assess gaps.

    4. Evaluate solution options

    Review the outputs of the current state architecture health assessment and adopt a preliminary posture on architecture.

    5. Evaluate application options

    Evaluate the marketplace applications to understand the “art of the possible.”

    6. Frame desired state and develop roadmap

    Compile and score a list of initiatives to bridge the gaps, and plot the initiatives on a strategic roadmap.

    • Customer Service Initiative Scoring and Roadmap
    [infographic]

    Workshop: Develop an IT Strategy to Support Customer Service

    Workshops offer an easy way to accelerate your project. If you are unable to do the project yourself, and a Guided Implementation isn't enough, we offer low-cost delivery of our project workshops. We take you through every phase of your project and ensure that you have a roadmap in place to complete your project successfully.

    1 Define Vision for Future State

    The Purpose

    Discuss Customer Service-related organizational goals and align goals with potential strategies for implementation.

    Score level 5 Customer Service business processes against organizational goals to come up with a shortlist for modeling.

    Create a future state model for one of the shortlisted business processes.

    Draft the requirements as they relate to the business process.

    Key Benefits Achieved

    Preliminary list of Customer Service-related business goals

    List of Customer Service business processes (Task Level 5)

    Pre-selected Customer Service business process for modeling

    Activities

    1.1 Outline and prioritize your customer goals and link their relevance and value to your Customer Service processes with the Customer Service Business Process Shortlisting Tool.

    1.2 Score customer service business processes against organizational goals with the Customer Service Systems Strategy Tool.

    Outputs

    Initial position on viable Customer Service strategies

    Shortlist of key business processes

    Documented future state business process model

    Business/functional/non-functional requirements

    2 Document Current State and Assess Gaps

    The Purpose

    Create a current state model for the shortlisted business processes.

    Score the functionality and integration of current supporting applications.

    Revise future state model and business requirements.

    Key Benefits Achieved

    Inventory of Customer Service supporting applications

    Inventory of related system interfaces

    Activities

    2.1 Holistically assess multiple aspects of Customer Service-related IT assets with the Customer Service Systems Strategy Tool.

    Outputs

    Documented current state business process model

    Customer Service systems health assessment

    3 Adopt an Architectural Posture

    The Purpose

    Review the Customer Service systems health assessment results.

    Discuss options.

    Key Benefits Achieved

    Completed Customer Service systems health assessment

    Application options

    Activities

    3.1 Analyze CS Systems Strategy and review results with the Customer Service Systems Strategy Tool

    Outputs

    Posture on system architecture

    4 Frame Desired State and Develop Roadmap

    The Purpose

    Draft a list of initiatives based on requirements.

    Score and prioritize the initiatives.

    Plot the initiatives on a roadmap.

    Key Benefits Achieved

    Business/functional/non-functional requirements

    Activities

    4.1 Help project and management stakeholders visualize the implementation of Customer Service IT initiatives with the Customer Service Initiative Scoring and Roadmap Tool.

    Outputs

    Scored and prioritized list of initiatives

    Customer Service implementation roadmap

    Further reading

    Develop an IT Strategy to Support Customer Service

    E-commerce is accelerating, and with it, customer expectations for exceptional digital service.

    Analyst Perspective

    The future of Customer Service is digital. Your organization needs an IT strategy to meet this demand.

    The image contains a picture of Thomas E. Randall.

    As the pandemic closed brick-and-mortar stores, the acceleration of ecommerce has cemented Customer Service’s digital future. However, the pandemic also revealed severe cracks in the IT strategy of organizations’ Customer Service – no matter the industry. These cracks may include low resolution and high wait times through the contact center, or a lack of analytics that fuel a reactive environment. Unfortunately, organizations have no time to waste in resolving these issues. Customer patience for poor digital service has only decreased since March 2020, leaving organizations with little to no runway for ramping up their IT strategy.

    Organizations that quickly mature their digital Customer Service will come out the other side of COVID-19 more competitive and with a stronger reputation. This move necessitates a concrete IT strategy for coordinating what the organization’s future state should look like and agreeing on the technologies and software required to meet this state across the entire organization.

    Thomas E. Randall, Ph.D.

    Senior Research Analyst, Info-Tech Research Group

    Executive Summary

    Your Challenge

    Common Obstacles

    Info-Tech’s Solution

    • COVID-19 has accelerated ecommerce, rapidly evolving customer expectations about the service they should receive. Without a robust IT strategy for enabling remote, contactless points of service, your organization will quickly fall behind.
    • The organization would like to use modern channels and technologies to enhance customer service, but it is unclear whether IT has the infrastructure to support them.
    • The relationship between Customer Service and IT is strained. Strategic system-related decisions are being made without the inclusion of IT.
    • IT is in a permanent reactive state, only engaged post-purchase to fix issues as they arise and to offer workarounds.
    • Use Info-Tech’s methodology to produce an IT strategy for Customer Service:
      • Phase 1: Define Project and Future State
      • Phase 2: Evaluate Current State
      • Phase 3: Build a Roadmap to Future State
    • Each phase contributes toward this blueprint’s key deliverable: the Strategic Roadmap.

    Info-Tech Insight

    IT must proactively engage with the organization to define what good customer service should look like. This ensures IT has a fair say in what kinds of architectural solutions are feasible for any projected future state. In this proactive scenario, IT can help build the roadmap for implementing and maintaining customer service infrastructure and operations, reducing the time and resources spent on putting out preventable fires or trying to achieve an unworkable goal set by the organization.

    Key insights

    Develop an IT Strategy to Support Customer Service

    Ecommerce growth has increased customer expectations

    Despite the huge obstacles that organizations are having to overcome to meet accelerating ecommerce from the pandemic, customers have not increased their tolerance for organizations with poor service. Indeed, customer expectations for excellent digital service have only increased since March 2020. If organizations cannot meet these demands, they will become uncompetitive.

    The future of customer service is tied up in analytics

    Without a coordinated IT strategy for leveraging technology and data to improve Customer Service, the organization will quickly be left behind. Analytics and reporting are crucial for proactively engaging with customers, planning marketing campaigns, and building customer profiles. Failing to do so leaves the organization blind to customer needs and will constantly be in firefighting mode.

    Meet the customer wherever they are – no matter the channel

    Providing an omnichannel experience is fast becoming a table stakes offering for customers. To maximize customer engagement and service, the organization must connect with the customer on whatever channel the customer prefers – be it social media, SMS, or by phone. While voice will continue to dominate how Customer Service connects with customers, demographics are shifting toward a digital-first generation. Organizations must be ready to capture this rapidly expanding audience.

    This blueprint will achieve:

    Increased customer satisfaction

    • An IT strategy for Customer Service that proactively meets customer demand, improving overall customer satisfaction with the organization’s services.
    • A process for identifying the organization’s future state of Customer Service and developing a concrete gap analysis.

    Time saved

    • Ready-to-use deliverables that analyze and provide a roadmap toward the organization’s desired future state.
    • Market analyses and rapid application selection through SoftwareReviews to streamline project time-to-completion.

    Increased ROI

    • A modernization process that aids Customer Service digital transformation, with a view to achieve high ROI.
    • Save costs through an effective requirements gathering method.
    • Building and expanding the organization’s customer base to increase revenues by meeting the customers where they are – no matter what channel.

    An IT strategy for customer service is imperative for a post-COVID world

    COVID-19 has accelerated ecommerce, rapidly evolving customer expectations for remote, contactless service.

    59% Of customers agree that the pandemic has raised their standards for service (Salesforce, 2020).

    • With COVID-19, most customer demand and employment moved online and turned remote.
    • Retailers had to rapidly respond, meeting customer demand through ecommerce. This not only entailed a complete shift in how customers could buy their goods but how retailers could provide a remote customer journey from discovery to post-purchase support.

    Info-Tech Insight

    The pandemic did not improve customer tolerance for bad service – instead, the demand for good service increased dramatically. Organizations need an IT strategy to meet customer support demands wherever the customer is located.

    The technology to provide remote customer support is surging

    IT needs to be at the forefront of learning about and suggesting new technologies, working with Customer Service to deliver a consistent, business-driven approach.

    78%

    Of decision makers say they’ve invested in new technology as a result of the pandemic (Salesforce, 2020).

    OMNICHANNEL SUPPORT

    Rapidly changing demographics and modes of communications require an evolution toward omnichannel engagement. Agents need customer information synced across each channel they use, meeting the customer’s needs where they are.

    78%

    Of customers have increased their use of self-service during the pandemic (Salesforce, 2020).

    INTELLIGENT SELF-SERVICE PORTALS

    Customers want their issues resolved as quickly as possible. Machine-learning self-service options deliver personalized customer experiences, which also reduce both agent call volume and support costs for the organization.

    90%

    Of global executives who use data analytics report that they improved their ability to deliver a great customer experience (Gottlieb, 2019).

    LEVERAGING ANALYTICS

    The future of customer service is tied up with analytics: from AI-driven capabilities that include agent assist and using biometric data (e.g., speech) for security, to feeding real insights about how customers and agents are doing and performing.

    Executive Brief – Case Study

    Self-service options improve quality of service and boost organization’s competitiveness in a digital marketspace.

    INDUSTRY: Financial Services

    SOURCE: TSB

    Situation

    Solution

    Results

    • The pandemic increased pressure on TSB’s Customer Service, with higher call loads from their five million customers who were anxious about their financial situation.
    • TSB needed to speed up its processing times to ensure loan programs and other assistances were provided as quickly as possible.
    • As meeting in-person became impossible due to the lockdown, TSB had to step up its digital abilities to serve their customers.
    • TSB sought to boost its competitiveness by shifting as far as possible to digital services.
    • TSB launched government loan programs in 36 hours, ahead of its competitors.
    • TSB created and released 21 digital self-service forms for customers to complete without needing to interact with bank staff.
    • TSB processed 140,000 forms in three months, replacing 15,000 branch visits.
    • TSB increased digital self-service rate by nine percent.

    IT can demonstrate its value to business by enhancing remote customer service

    IT must engage with Customer Service – otherwise, IT risks being perennially reactive and dictated to as remote customer service needs increase.

    IT benefits

    Customer Service benefits

    • The right technology is established to support Customer Service.
    • IT is viewed as a strategic partner and innovator, not just a cost center and support function.
    • Streamlined and optimized Customer Service processes that drive efficiency and improve Customer Service quality.
    • Transformation of the Customer Service function into a competitive advantage.

    Info-Tech Insight

    Change to how Customer Service will operate is inevitable. This is an opportunity for IT to establish their value to the business and improve their autonomy in how new technologies should be onboarded and utilized.

    Customer Service and IT need to work together to mitigate their pain points

    IT and Customer Service have an opportunity to reinforce and build their organization’s customer base by working together to streamline operations.

    IT pain points

    Customer Service pain points

    • IT lacks understanding of Customer Service challenges and pain points.
    • IT has technical debt or constrained technology funding.
    • The IT department is viewed as a cost center and support organization, not an engine of innovation, growth, and service delivery performance.
    • Processes supporting Customer Service delivery may be sub-optimal.
    • The existing technology cannot support the increasingly advanced needs of Customer Service functions.
    • Customer Service isn’t fully aware of what your customers think of your service quality. There is little to no monitoring of customer sentiment.
    • There is a lack of value-based segmentation of customers and information on their channel usage and preferences.
    • Competitor actions are not actively monitored.

    IT often cannot spark a debate with Customer Service on whether a decision made without IT is misaligned with corporate direction. It’s almost always an uphill battle for IT.

    Sahri Lava, Research Director, IDC

    Develop an IT Strategy to Support Customer Service

    DON’T FALL BEHIND

    70% of companies either have a digital transformation strategy in place or are working on one (Tech Pro Research, 2018). Unless IT can enable technology that meets the customer where they are, the organization will quickly fall behind in an age of accelerating ecommerce.

    DEVELOP FUTURE STATES

    Many customer journeys are now exclusively digital – 63% of customers expect to receive service over social media (Ringshall, 2020). Organization’s need an IT strategy to develop the future of their customer service – from leveraging analytics to self-service AI portals.

    BUILD GAP ANALYSIS

    73% of customers prefer to shop across multiple channels (Sopadjieva et al., 2017). Assess your current state’s application integrations and functionality to ensure your future state can accurately sync customer information across each channel.

    SHORTLIST SOLUTIONS

    Customer relationship management software is one of the world's fastest growing industries (Kuligowski, 2022). Choosing a best-fit solution requires an intricate analysis of the market, future trends, and your organization’s requirements.

    ADVANCE CHANGE

    95% of customers cite service as key to their brand loyalty (Microsoft, 2019). Build out your roadmap for the future state to retain and build your customer base moving forward.

    Use Info-Tech’s method to produce an IT strategy for Customer Service:

    PHASE 1: Define Project and Future State

    Output: Project Charter and Future State Business Processes

    1.1 Structure the Project

    1.2 Define a Vision for Future State

    1.3 Document Preliminary Requirements

    KEY DELIVERABLE:

    Strategic Roadmap

    The image contains a screenshot of the strategic roadmap.

    PHASE 2: Evaluate Current State

    Output: Requirements Identified to Bridge Current to Future State

    2.1 Document Current State Business Processes

    2.2 Assess Current State Architecture

    2.3 Review and Finalize Requirements for Future State

    PHASE 3: Build a Roadmap to Future State

    Output: Initiatives and Strategic Roadmap

    3.1 Evaluate Architectural and Application Options

    3.2 Understand the Marketplace

    3.3 Score and Plot Initiatives Along Your Strategic Roadmap

    Key deliverable and tools outline

    Each step of this blueprint is accompanied by supporting materials to help you accomplish your goals.

    Project RACI Chart

    Activity 1.1a Organize roles and responsibilities for carrying out project steps.

    The image contains a screenshot of the Project RACI Chart.

    Key Deliverable:

    Strategic Roadmap

    Develop, prioritize, and implement key initiatives for your customer service IT strategy, plotting and tracking them on an easy-to-read timeline.

    The image contains a screenshot of the Strategic Roadmap.

    Business Process Shortlisting Tool

    Activities 1.2a, 1.2b, and 2.1aOutline and prioritize customer service goals.

    The image contains a screenshot of the Business Process Shortlisting Tool.

    Project Charter Template

    Activity 1.1b Define the project, its key deliverables, and metrics for success.

    The image contains a screenshot of the Project Charter Template.

    Systems Strategy Tool

    Activities 1.3a, Phase 2, 3.1a Prioritize requirements, assess current state customer service functions, and decide what to do with your current systems going forward.

    .The image contains a screenshot of the Systems Strategy Tool.

    Looking ahead: defining metrics for success

    Phase 1 of this blueprint will help solidify how to measure this project’s success. Start looking ahead now.

    For example, the metrics below show the potential business benefits for several stakeholders through building an IT strategy for Customer Service. These stakeholders include agents, customers, senior leadership, and IT. The benefits of this project are listed to the right.

    Metric Description

    Current Metric

    Future Goal

    Number of channels for customer contact

    1

    6

    Customer self-service resolution

    0%

    50%

    % ROI

    - 4%

    11%

    Agent satisfaction

    42%

    75%

    As this project nears completion:

    1. Customers will have more opportunities for self-service resolution.
    2. Agents will experience higher satisfaction, improving attrition rates.
    3. The organization will experience higher ROI from its digital Customer Service investments.
    4. Customers can engage the contact center via a communication channel that suits them.

    Info-Tech offers various levels of support to best suit your needs

    DIY Toolkit

    Guided Implementation

    Workshop

    Consulting

    “Our team has already made this critical project a priority, and we have the time and capability, but some guidance along the way would be helpful.”“Our team knows that we need to fix a process, but we need assistance to determine where to focus. Some check-ins along the way would help keep us on track.”“We need to hit the ground running and get this project kicked off immediately. Our team has the ability to take this over once we get a framework and strategy in place.”“Our team does not have the time or the knowledge to take this project on. We need assistance through the entirety of this project.”

    Diagnostics and consistent frameworks used throughout all four options

    Guided Implementation

    What does a typical Guided Implementation on this topic look like?

    Define Project and Future StateDocument and Assess Current StateEvaluate Architectural and Application OptionsBuild Roadmap to Future State

    Call #1: Introduce project, defining its vision and metrics of success.

    Call #2: Review environmental scan to define future state vision.

    Call #3: Examine future state business processes to compile initial requirements.

    Call #4: Document current state business processes.

    Call #5: Assess current customer service IT architecture.

    Call #6: Refine and prioritize list of requirements for future state.

    Call #7: Evaluate architectural options.

    Call #8: Evaluate application options.

    Call #9:Develop and score initiatives to future state.

    Call #10: Develop timeline and roadmap.

    Call #11: Review progress and wrap-up project.

    A Guided Implementation is a series of calls with an Info-Tech analyst to help implement our best practices in your organization.

    A typical Guided Implementation is two to 12 calls over the course of four to six months.

    Workshop Overview

    Contact your account representative for more information.
    workshops@infotech.com1-888-670-8889

    Day 1Day 2Day 3Day 4Day 5

    Define Your Vision for Future State

    Document Current State and Assess Gaps

    Adopt an Architectural Posture

    Frame Desired State and Develop Roadmap

    Communicate and Implement

    Activities

    1.1 Outline and prioritize your customer goals.

    1.2 Link customer service goals’ relevance and value to your Customer Service processes.

    1.3 Score Customer Service business processes against organizational goals.

    2.1 Holistically assess multiple aspects of Customer Service-related IT assets with Customer Service Systems Strategy Tool.

    3.1 Analyze Customer Service Systems Strategy and review results with the Customer Service Systems Strategy Tool.

    4.1 Help project management stakeholders visualize implementation of Customer Service IT initiatives.

    4.2 Build strategic roadmap and plot initiatives.

    5.1 Finalize deliverables.

    5.2 Support communication efforts.

    5.3 Identify resources in support of priority initiatives.

    Deliverables

    1. Initial position on viable Customer Service strategies.
    2. Shortlist of key business processes.
    3. Documented future-state business process model.
    4. Business/functional/non-functional requirements.
    1. Documented current state business process model.
    2. Customer Service systems health assessment.
    3. Inventory of Customer Service supporting applications.
    4. Inventory of related system interfaces.
    1. Posture on system architecture.
    2. Completed Customer Service systems health assessment.
    3. List of application options.
    1. Scored and prioritized list of initiatives.
    2. Customer Service implementation roadmap.
    1. Customer Service IT Strategy Roadmap.
    2. Mapping of Info-Tech resources against individual initiatives.

    Phase 1

    Define Project and Future State

    Phase 1

    Phase 2

    Phase 3

    1.1 Structure the Project

    1.2 Define Vision for Future State

    1.3 Document Preliminary Requirements

    2.1 Document Current State Business Processes

    2.2 Assess Current State Architecture

    2.3 Review and Finalize Requirements for Future State

    3.1 Evaluate Architectural and Application Options

    3.2 Understand the Marketplace

    3.3 Score and Plot Initiatives Along Strategic Roadmap

    This phase will guide you through the following activities:

    1.1a Create your project’s RACI chart to establish key roles throughout the timeline of the project.

    1.1b Finalize your project charter that captures the key goals of the project, ready to communicate to stakeholders for approval.

    1.2a Begin documenting business processes to establish potential future states.

    1.2b Model future state business processes for looking beyond current constraints and building the ideal scenario.

    1.3a Document your preliminary requirements for concretizing a future state and performing a gap analysis.

    Participants required for Phase 1:

    • Applications Director
    • Customer Service Director
    • IT and Customer Service Representatives

    1.1 Identify process owners early for successful project execution

    IT and Customer Service must work in tandem throughout the project. Both teams’ involvement ensures all stakeholders are heard and support the final decision.

    Customer Service Perspective

    IT Perspective

    • Customer Service is the victim of pain points resulting from suboptimal systems and it stands to gain the most benefits from a well-planned systems strategy.
    • Looking to reduce pain points, Customer Service will likely initiate, own, and participate heavily in the project.
    • Customer Service must avoid the tendency to make IT-independent decisions. This could lead to disparate systems that contribute little to the overall organizational goals.
    • IT owns the application and back-end support of all Customer Service business processes. Any technological aspect of processes will need IT involvement.
    • IT may or may not have the mandate to run the Customer Service strategy project. Responsibility for systems decisions remains with IT.
    • IT should own the task of filtering out unnecessary or infeasible application and technology decisions. IT capabilities to support such acquisitions and post-purchase maintenance must be considered.

    Info-Tech Insight

    While involving management is important for high-level strategic decisions, input from those who interact day-to-day with the systems is a crucial component to a well-planned strategy.

    1.1 Define project roles and responsibilities to improve progress tracking

    Assign responsibilities, accountabilities, and other project involvement roles using a RACI chart.

    • IT should involve Customer Service from the beginning of project planning to implementation and execution. The project requires input and knowledge from both functions to succeed.
    • Do not let the tasks be forgotten within inter-functional communication. Define roles and responsibilities for the project as early as possible.
    • Each member of the project team should be given a RACI designation, which will vary for each task to ensure clear ownership, execution, and progress tracking.
    • Assigning RACI early can:
      • Improve project quality by assigning the right people to the right tasks.
      • Improve chances of project task completion by assigning clear accountabilities.
      • Improve project buy-in by ensuring that stakeholders are kept informed of project progress, risks, and successes.

    R – Responsibility

    A – Accountability

    C – Consulted

    I – Informed

    1.1 Use Info-Tech’s recommended process owners and roles for this blueprint

    Customer Service Head

    Customer Service Director

    CIO

    Applications Director*

    CEO/COO

    Marketing Head

    Sales Head

    Determine Project Suitability

    ARCCCII

    Phase 1.1

    CCARIII

    Phases 1.2 – 1.3

    ARCCICC

    Phase 2

    ARICIII

    Phase 3.1

    (Architectural options)

    CCARIII

    Phase 3.1

    (Application options)

    ACIRICC

    Phases 3.2 – 3.3

    CCARCII

    * The Applications Director is to compile a list of Customer Service systems; the Customer Service Director is responsible for vetting a list and mapping it to Customer Service functions.

    ** The Applications Director is responsible for technology-related decisions (e.g. SaaS or on-premise, integration issues); the Customer Service Director is responsible for functionality-related decisions.

    1.1a Create your project’s RACI chart

    1 hour

    1. The Applications Director and Customer Service Head should identify key participants and stakeholders of the project.
    2. Use Info-Tech’s Project RACI Chart to identify ownership of tasks.
    3. Record roles in the Project RACI Chart.
    The image contains a screenshot of the project RACI chart.
    InputOutput
    • Identification of key project participants and stakeholders.
    • Identification of key project participants and stakeholders.

    Materials

    Participants

    • Project RACI Chart
    • Applications Director
    • Customer Service Director

    Download the Project RACI Chart

    1.1 Start developing the project charter

    A project charter should address the following:

    • Executive Summary and Project Overview
      • Goals
      • Benefits
      • Critical Success Factors
    • Scope
    • Key Deliverables
    • Stakeholders and RACI
    • Risk Assessment
      • What are some risks you may encounter during project execution?
    • Projected Timeline and Key Milestones
    • Review and Approval Process

    What is a project charter?

    • The project charter defines the project and lays the foundation for all subsequent project planning.
    • Once approved by the business, the charter gives the project lead formal authority to initiate the project.

    Why create a project charter?

    • The project charter allows all parties involved to reach an agreement and document major aspects of the project.
    • It also supports the decision-making process and can be used as a communication tool.

    Stakeholders must:

    • Understand and agree on the objectives and important characteristics of the project charter before the project is initiated.
    • Be given the opportunity to adjust the project charter to better address their needs and concerns.

    1.1b Finalize the project charter

    1-2 hours

    1. Request relevant individuals and parties to complete sections of Info-Tech’s Project Charter Template.
    2. Input the simplified RACI output from tab 3 in Info-Tech’s Project RACI Chart tool into the RACI section of the charter.
    3. Send the completed template to the CIO and Customer Service Head for approval.
    4. Communicate the document to stakeholders for changes and finalization.
    The image contains a screenshot of the Project Charter Template.

    Input

    Output

    • Customer Service and IT strategies
    • Justification of impetus to begin this project
    • Timeline estimates
    • A completed project charter that captures the key goals of the project, ready to communicate to stakeholders for approval.

    Materials

    Participants

    • Project RACI Chart
    • Project Charter Template
    • Applications Director
    • Customer Service Director

    Download the Project Charter Template

    1.2 IT must play a role shaping Customer Service’s future vision

    IT is only one or two degrees of separation from the end customer – their involvement can significantly impact the customer experience.

    IT

    Customer Service

    Customer

    Customer Service-Facing Application

    Customer-Facing Application

    • IT enables, supports, and maintains the applications used by the Customer Service organization to service customers. IT provides the infrastructural and technical foundation to operate the function.
    • IT supports customer-facing interfaces and channels for Customer Service interaction.
    • Channel examples include web pages, mobile device applications and optimization, and interactive voice response for callers.

    1.2 Establish a vision for Customer Service excellence

    Info-Tech has identified three prominent Customer Service strategic patterns. Evaluate which fits best with your situation and organization.

    Retention

    Efficiency

    Cross-Sell/Up-Sell

    Ensuring customers remain customers by providing proactive customer service and a seamless omnichannel strategy.

    Reducing costs by diverting customers to lower cost channels and empowering agents to solve problems quickly.

    Maximizing the value of existing customers by capitalizing on cross-sell and up-sell opportunities.

    1.2 Let profitability goals help reveal which strategy to pursue

    Profitability goals are tied to the enabling of customer service strategies.

    • If looking to drive cost decreases across the organization, pursue cost efficiency strategies such as customer volume diversion in order to lower cost channels and avoid costly escalations for customer complaints and inquiries.
    • Ongoing Contribution Margin is positive only once customer acquisition costs (CAC) have been paid back. For every customer lost, another customer has to be acquired in order to experience no loss. In this way, customer retention strategies help decrease your overall costs.
    • Once cost reduction and customer retention measures are in place, look to increase overall revenue through cross-selling and up-selling activities with your customers.
    The image contains a screenshot of a diagram to demonstrate the relationship between goals and enabling strategies.

    Info-Tech Insight

    Purely driving efficiency is not the goal. Create a balance that does not compromise customer satisfaction.

    Customer Service strategies: Case studies

    Efficiency

    • Volume diversion to lower cost channels
    • Agent empowerment

    MISS DIG 811 – a utility notification system – sought to make their customer service more efficient by moving to softphones. Using the Cisco Customer Journey Platform, Miss Dig saw a 9% YoY increase in agent productivity and 83% reduction in phone equipment costs. Source: (Cisco, 2018).

    Retention

    • Proactive Customer Service
    • Seamless omnichannel strategy

    VoiceSage worked with Home Retail Group – a general merchandise retailer – to proactively increase customer outreach, reducing the number of routine customer order and delivery queries received. In four weeks, Home Retail Group increased their 30-40% answer rate from customers to 100%, with 90% of incoming calls answered and 60% of contacts made via SMS. Source: (VoiceSage, 2018)

    Cross-Sell/

    Up-Sell

    • Cross-Sell and Up-Sell opportunities

    A global brand selling language-learning software utilized Callzilla to help improve their call conversion rate of 2%. After six months of agent and supervisor training, this company increased their call conversion rate to 16% and their upsell rate to 40%. Their average order value increased from < $300 to $465. Source: (Callzilla, n.d.)

    1.2 Performing an environmental scan can help IT optimize Customer Service support

    Though typically executed by Customer Service, IT can gain valuable insights for best supporting infrastructure, applications, and operations from an environmental scan.

    An environmental scan seeks to understand your organization’s customers from multiple directions. It considers:

    • Customers’ value-based segmentations.
    • The interaction channels customers prefer to use.
    • Customers’ likes and dislikes.
    • The general sentiment of your customer service quality.
    • What your competitors are doing in this space.
    The image contains a screenshot of a diagram to demonstrate how performing an environmental scan can help IT optimize Customer Service support.

    Info-Tech Insight

    Business processes must directly relate to customer service. Failing to correlate customer experience with business performance outcomes overlooks the enormous cost of negative sentiment.

    1.2 The environmental scan results should drive IT’s strategy and resource spend

    Insights derived from this scan can help frame IT’s contributions to Customer Service’s future vision.

    Why IT should care:

    Implications:

    Each customer experience, from product/service selection to post-transaction support, can have a significant impact on business performance.

    It is not just IT or Customer Service that should care; rather, it should be an organizational responsibility to care about what customers say.

    Customers have little tolerance for mediocrity or poor service and simply switch their allegiances to those that can satisfy their expectations.

    Do not ignore your competitors; they may be doing something well in Customer Service technology which may serve as your organization’s benchmark.

    With maturing mobile and social technologies, customers want to be treated as individuals rather than as a series of disconnected accounts

    Do not ignore your customers’ plea for individuality through mobile and social. Assess your customers’ technology channel preferences.

    Customer service’s perception of service quality may be drastically different than what is expected by the customers.

    Prevent your organization from investing in technology that will have no positive impact on your customer experience.

    Some customers may not provide your organization the business value that surpasses your cost to serve them.

    Focus on enhancing the technology and customer service experience for your high-value customers.

    1.2 Have Customer Service examine feedback across channels for a holistic view

    Your method of listening needs to evolve to include active listening on social and mobile channels.

    Insights and Implications for Customer Service

    Limitations of conventional listening:

    • Solicited customer feedback, such as surveys, do not provide an accurate feedback method since customers only have one channel to express their views.
    • Sentiment, voice, and text analytics within social media channels provide the most accurate and timely intelligence.

    How IT Can Help

    IT can help facilitate the customer feedback process by:

    • Conducting customer feedback with voice recognition software.
    • Monitoring customer sentiment on mobile and social channels.
    • Utilizing customer data analytic engines on social media management platforms.
    • Referring Customer Service to customer advisory councils and their databases.

    1.2 Benchmark IT assets by examining your competitors’ Customer Service capabilities

    The availability of the internet means almost complete transparency between your products and services, and those of your competitors.

    Insights and implications from Customer Service

    How IT can help

    Competitor actions are crucial. Watch your competitors to learn how they use Customer Service as a competitive differentiator and a customer acquisition tool.

    Do not learn about a competitor’s actions because your customers are already switching to them. Track your competitors before getting a harsh surprise from your customers.

    View the customer service experience from the outside in. Assessing from the inside out gives an internal perspective on how good the service is, rather than what customers are experiencing.

    Take a data and analytics-driven approach to mine insights on what customers are saying about your competitors. Negative sentiment and specific complaints can be used as reference for IT and Customer Service to:

    • Avoid repeating the competitor’s mistakes.
    • Utilize sentiment as a benchmark for goal setting and improvements.
    • Duplicate successful technology initiatives to realize business value.

    Info-Tech Insight

    Look to your competitors for comparative models but do not pursue to solely replicate what they currently have. Aim higher and attempt to surpass their capabilities and brand value.

    1.2 Collaborate with Customer Service to understand customer value segments

    Let segmentation help you gain intelligence on customers’ expectations.

    Insights and implications from customer service

    • Segment your customers based on their value relative to the cost to serve. The easiest way to do so is with channel preference categorization.
    • If the cost for retention attempts are higher than the value that those customers provide, there is little business case to pursue retention action.

    How IT can help

    • Couple value-based segmentation with channel preference and satisfaction levels of your most-valued customers to effectively target IT investments in channels that maximize service customization and quality.
    • Correlate the customers’ channel and technology usage with their business value to see which IT assets are delivering on their investments.

    The image contains a screenshot of a graph to demonstrate the relationship between cost of retention and value.

    “If you're developing a Customer Service strategy, it has to start with who your clients are, what [they are] trying to do, and through what channels […] and then your decision around processes have to fall out of that. If IT is trying to lead the conversation, or bring people together to lead the conversation, then marketing and whoever does segmentation has to be at the table as a huge component of this.”

    Lisa Woznica, Director of Client Experience, BMO Financial Group

    1.2 Be mindful of trends in the consumer and technology landscape

    Building a future vision of customer service requires knowing what upcoming technologies can aid the organization.

    OMNICHANNEL SUPPORT

    Rapidly changing demographics and modes of communication requires an evolution toward omnichannel engagement. 63% of customers now expect to communicate with contact centers over their social media (Ringshall 2020). Agents need customer information synced across each channel they use, meeting the customer’s needs where they are.

    INTELLIGENT SELF-SERVICE PORTALS

    Customers want their issues resolved as quickly as possible. Machine learning self-service options deliver personalized customer experiences, which also reduce both agent call volume and support costs for the organization. 60% of contact centers are using or plan to use AI in the next 12 months to improve their customer (Canam Research 2020).

    LEVERAGING ANALYTICS

    The future of customer service is tied up with analytics. This not only entails AI-driven capabilities that fetch the agent relevant information, but it finds skills-based routing and uses biometric data (e.g., speech) for security. It also feeds operations leaders’ need for easy access to real insights about how their customers and agents are doing.

    Phase 1 – Case Study

    Omnichannel support delivers a financial services firm immediate customer service results.

    INDUSTRY: Financial Services

    SOURCE: Mattsen Kumar

    Situation

    Solution

    Results

    • A financial services firm’s fast growth began to show cracks in their legacy customer service system.
    • Costs to support the number of customer queries increased.
    • There was a lack of visibility into incoming customer communications and their resolutions.
    • Business opportunities were lost due to a lack of information on customers’ preferences and challenges. Customer satisfaction was decreasing, negatively impacting the firm’s brand.
    • Mattsen Kumar diagnosed that the firm’s major issue was that their customer service processes required a high percentage of manual interventions.
    • Mattsen Kumar developed an omnichannel strategy, including a mix of social channels joined together by a CRM.
    • A key aspect of this omnichannel experience was designing automated processes with minimal manual intervention.
    • 25% reduction in callbacks from customers.
    • $50,000 reduction in operational costs.
    • Two minutes wait time reduction for chat process.
    • 14% decrease in average handle time.
    • Scaled up from 6000 to 50,000 monthly calls that could be handled by the current team.
    • Enabled more than 10,000 customer queries over chats.

    1.2 Construct your future state using a business process management approach

    Documenting and evaluating your business processes serves as a good starting point for defining the overall Customer Service strategy.

    • Examining key Customer Service business processes can unlock clues around the following:
      • Driving operational effectiveness.
      • Identifying, implementing, and maintaining reusable enterprise systems.
      • Identifying gaps that can be addressed by acquisition of additional systems.
    • Business process modeling facilitates the collaboration between business and IT, recording the sequence of events, tasks performed, by whom they are performed, and the levels of interaction with the various supporting applications.
    • By identifying the events and decision points in the process, and overlaying the people that perform the functions and technologies that support them, organizations are better positioned to identify gaps that need to be bridged.
    • Encourage the analysis by compiling the inventory of Customer Service business processes that are relevant to the organization.

    Info-Tech Insight

    A process-oriented approach helps organizations see the complete view of the system by linking strategic requirements to business requirements, and business requirements to system requirements.

    1.2 Use the APQC Framework to define your Customer Service-related processes

    • APQC’s Process Classification Framework (PCF) is a taxonomy of cross-functional business processes intended to allow the objective comparison of organizational performance within and among organizations.
    • Section 5 of the PCF details various levels of Customer Service business processes, useful for mapping on to your own organization’s current state.
    • The APQC Framework can be accessed through the following link: APQC’s Process Classification Framework.

    The APQC Framework serves as a high-level, industry-neutral enterprise model that allows organizations to see activities from a cross-industry process perspective.

    The image contains a screenshot example of the APQC Process Classification Framework.
    Source: (Ziemba and Eisenbardt 2015)

    Info-Tech Caution

    The APQC framework does not list all processes within a specific organization, nor are the processes which are listed in the framework present in every organization. It is designed as a framework and global standard to be customized for use in any organization.

    1.2 Each APQC process has five levels that represent its logical components

    The image contains a screenshot of the APQC five levels. The levels include: category, process group, process, and activity.

    The PCF provides L1 through 4 for the Customer Service Framework.

    L5 processes are task- and industry-specific and need to be defined by the organization.

    Source: (APQC 2020)
    This Industry Process Classification Framework was jointly developed by APQC and IBM to facilitate improvement through process management and benchmarking. ©2018 APQC and IBM. ALL RIGHTS RESERVED.

    1.2a Begin documenting business processes

    4 hours

    1. Using Info-Tech’s Customer Service Business Process Shortlisting Tool, list the Customer Service goals and rank them by importance.
    2. Score the APQC L4 processes by relevance to the defined goals and perceived satisfaction index.
    3. Define the L5 processes for the top scoring L4 process.
    4. Leave Tab 5, Columns G – I for now. These columns will be revisited in activities 1.2b and 2.1a.
    The image contains a screenshot of the Customer Service Process Shortlisting Tool.

    Input

    Output

    • List of Customer Service goals
    • A detailed prioritization of Customer Service business processes to model for future states

    Materials

    Participants

    • Whiteboard
    • Writing materials
    • Customer Service Business Process Shortlisting Tool
    • Applications Director
    • Customer Service Director
    • IT and Customer Service Representatives

    Download the Customer Service Business Process Shortlisting Tool

    1.2 Start designing the future state of key business processes

    If Customer Service transformation is called for, start with your future-state vision. Don’t get stuck in current state and the “art of the possible” within its context.

    Future-State Analysis

    Start by designing your future state business processes (based on the key processes shortlisting exercise). Design these processes as they would exist as your “ideal scenario.” Next, analyze your current state to help better your understanding of:

    • The gaps that exist and must be bridged to achieve the future-state vision.
    • Whether or not any critical functions that support your business were omitted accidentally from the future-state processes.
    • Whether or not any of the supporting applications or architecture can be salvaged and used toward delivery of your future-state vision.

    Though it’s a commonly used approach, documenting your current-state business processes first can have several drawbacks:

    • Current-state analysis can impede your ability to see future possibility.
    • Teams will spend a great deal of time and effort on documenting current state and inevitably succumb to “analysis paralysis.”
    • Current state assessment, when done first, limits the development of the future (or target) state, constraining thinking to the limitations of the current environment rather than the requirements of the business strategy.

    Current-State Analysis

    “If you're fairly immature and looking for a paradigm shift or different approach [because] you recognize you're totally doing it wrong today, then starting with documenting current state doesn't do a lot except make you sad. You don't want to get stuck in [the mindset of] ‘Here's the current state, and here’s the art of the possible.’”

    Trevor Timbeck, Executive Coach, Parachute Executive Coaching

    1.2 Start modeling future-state processes

    Build buy-in and accountability in process owners through workshops and whiteboarding – either in-person or remotely.

    Getting consensus on the process definition (who does what, when, where, why, and how) is one of the hardest parts of BPM.

    Gathering process owners for a process-defining workshop isn’t easy. Getting them to cooperate can be even harder. To help manage these difficulties during the workshop, make sure to:

    • Keep the scope contained to the processes being defined in order to make best use of everyone’s time, as taking time away from employees is a cost too.
    • Prior to the workshop, gather information about the processes with interviews, questionnaires, and/or system data gathering and analysis.
    • Use the information gathered to have real-life examples of the processes in question so that time isn’t wasted.

    Info-Tech Insight

    Keep meetings short and on task as tangents are inevitable. Set ground rules at the beginning of any brainstorming or whiteboarding session to ensure that all participants are aligned.

    1.2 Use the five W’s to help map out your future-state processes

    Define the “who, what, why, where, when, and how” of the process to gain a better understanding of individual activities.

    Owner

    Who

    What

    When

    Where

    Why

    How

    Record Claim

    Customer Service

    Customer Service Rep.

    Claim

    Accident

    Claims system

    Customer notification

    Agent enters claim into the system and notifies claims department

    Manage Claim

    Claims Department

    Claims Clerk

    Claim

    Agent submitted the claim

    Claims system

    Agent notification

    Clerk enters claim into the claims system

    Investigate Claim

    Claims Investigation

    Adjuster

    Claim

    Claim notification

    Property where claim is being made

    Assess damage

    Evaluation and expert input

    Settle Claim

    Claims Department

    Claim Approver

    Claim and Adjuster’s evaluation

    Receipt of Adjuster’s report

    Claims system

    Evaluation

    Approval or denial

    Administer Claim

    Finance Department

    Finance Clerk

    Claim amount

    Claim approval notification

    Finance system

    Payment required

    Create payment voucher and cut check

    Close Claim

    Claims Department

    Claims Clerk

    Claim and all supporting documentation

    Payment issued

    Claims system

    Claim processed

    Close the claim in the system

    Info-Tech Insight

    It’s not just about your internal processes. To achieve higher customer retention and satisfaction, it’s also useful to map the customer service process from the customer perspective to identify customer pain points and disconnects.

    1.2 Use existing in-house software as a simplistic entry point to process modeling

    A diagramming tool like Visio enables you to plot process participants and actions using dedicated symbols and connectors that indicate causality.

    • Models can use a stick-figure format, a cross-functional workflow format, or BPMN notation.
    • Plot the key activities and decision points in the process using standard flowcharting shapes. Identify the data that belongs to each step in a separate document or as call-outs on the diagram.
    • Document the flow control between steps, i.e., what causes one step to finish and another to start?

    The image contains a screenshot of the sample cross-functional diagram using the claims process.

    Info-Tech Best Practice

    Diagramming tools can force the process designer into a specific layout: linear or cross-functional/swim lane.

    • A linear format is recommended for single function and system processes.
    • A swim lane format is recommended for cross-functional and cross-departmental processes.

    1.2 Introduce low investment alternatives for process modeling for modeling disciplines

    SaaS and low-cost modeling tools are emerging to help organizations with low to medium BPM maturity visualize their processes.

    • Formal modeling tools allow a designer to model in any view and easily switch to other views to gain new perspectives on the process.
    • Subscription-based, best-of-breed SaaS tools provide scalable and flexible process modeling capabilities.
    • Open source and lower cost tools also exist to help distribute BPM modeling discipline and standards.
    • BPMS suites incorporate advanced modeling tools with process execution engines for end-to-end business process management. Integrate process discovery with modeling, process simulation, and analysis. Deploy, monitor, and measure process models in process automation engines.

    The image contains a screenshot of a diagram of the claims process.

    Explore SoftwareReviews’ Business Process Management market analysis by clicking here.

    1.2b Model future state business processes

    4 hours

    1. Model the future state of the most critical business processes.
    2. Use Tab 5, Columns G – H of Info-Tech’s Customer Service Business Process Shortlisting Tool to keep stock of what processes are targeted for modeling, and whether the models have been completed.
    The image contains a screenshot of the Customer Service Business Process Shortlisting Tool.

    Input

    Output

    • Modeled future Customer Service business processes
    • An inventory of modeled future states for critical Customer Service business processes

    Materials

    Participants

    • Whiteboard
    • Writing materials
    • Customer Service Business Process Shortlisting Tool
    • Applications Director
    • Customer Service Director

    Download the Customer Service Business Process Shortlisting Tool

    1.3 Start a preliminary inventory of your requirements

    Use the future state business process models as a source for software requirements.

    • Business process modeling deals with business requirements that can be used as the foundation for elicitation of system (functional and non-functional) requirements.
    • Modeling creates an understanding of the various steps and transfers in each business process, as well as the inputs and outputs of the process.
    • The future state models form an understanding of what information is needed and how it flows from one point to another in each process.
    • Understand what technologies are (or can be) leveraged to facilitate the exchange of information and facilitate the process.

    For each task or event in the process, ask the following questions:

    • What is the input?
    • What is the output?
    • What are the underlying risks and how can they be mitigated?
    • What conditions should be met to mitigate or eliminate each risk?
    • What are the improvement opportunities?
    • What conditions should be met to enable these opportunities?

    Info-Tech Insight

    Incorporate future considerations into the requirements. How will the system need to adapt over time to accommodate additional processes, process variations, introduction of additional channels and capabilities, etc. Do not overreach by identifying system capabilities that cannot possibly be met.

    1.3 Understand the four different requirements to document

    Have a holistic view for capturing the various requirements the organization has for a Customer Service strategy.

    Business requirements

    High-level requirements that management would typically understand.

    User requirements

    High-level requirements on how the tool should empower users’ lives.

    Non-functional requirements

    Criteria that can be used to judge the operation of a contact center. It defines how the system should perform for the organization.

    Functional requirements

    Outline the technical requirements for the desired contact center.

    1.3 Extract requirements from the business process models

    To see how, let us examine our earlier example for the Claims Process, extracting requirements from the “Record Claim” task.

    The image contains an example of the claims process, and focuses on the record claim task.

    1.3a Document your preliminary requirements

    4 hours

    1. The Applications Director and Customer Service Head are to identify participants based on the business processes that will be reviewed.
    2. They are to conduct a workshop to gather all requirements that can be taken from the business process models.
    3. Use Tab 4 of Info-Tech’s Customer Service Systems Strategy Tool to document your preliminary requirements.
    The image contains a screenshot of the Customer Service Systems Strategy Tool.
    InputOutput
    • Half-day workshop to review the proposed future-state diagrams and distill from them the business, functional, and non-functional requirements
    • Future state business process models from activities 1.2a and 1.2b
    • An inventory of preliminary requirements for modeled future states
    MaterialsParticipants
    • Whiteboard
    • Writing materials
    • Customer Service Systems Strategy Tool
    • Results of activities 1.2a and 1.2b
    • Applications Director
    • Customer Service Director
    • IT and Customer Service Representatives

    Download the Customer Service Systems Strategy Tool

    Phase 2

    Evaluate Current State

    Phase 1

    Phase 2

    Phase 3

    1.1 Structure the Project

    1.2 Define Vision for Future State

    1.3 Document Preliminary Requirements

    2.1 Document Current State Business Processes

    2.2 Assess Current State Architecture

    2.3 Review and Finalize Requirements for Future State

    3.1 Evaluate Architectural and Application Options

    3.2 Understand the Marketplace

    3.3 Score and Plot Initiatives Along Strategic Roadmap

    This phase will guide you through the following activities:

    2.1a Model current-state business processes for an inventory to compare against future-state models.

    2.1b Compare future and current business states for a preliminary gap analysis.

    2.1c Begin compiling an inventory of CS Systems by function for an overview of your current state map.

    2.2a Rate your functional and integration quality to assess the performance of your application portfolio.

    2.3a Compare states and propose action to bridge current business processes with viable future alternatives.

    2.3b Document finalized requirements, ready to enact change.

    Participants required for Phase 2:

    • Applications Director
    • Customer Service Director
    • IT and Customer Service Representatives
    • IT Managers

    2.1 Document the current state of your key business processes

    Doing so will solidify your understanding of the gaps, help identify any accidental omissions from the future state vision, and provide clues as to what can be salvaged.

    • Analysis of the current state is important in the context of gap analysis. It aids in understanding the discrepancies between your baseline and the future-state vision, and ensuring that these gaps are recorded as part of the overall requirements.
    • By analyzing the current state of key business processes, you may identify critical functions that are in place today that were not taken into consideration during the future-state business process visioning exercise.
    • By overlaying the current state process models with the applications that support them, the current state models will indicate what systems and interfaces can be salvaged.
    • The baseline feeds the business case, allowing the team to establish proposed benefits and improvements from implementing the future-state vision. Seek to understand the following:
      • The volumes of work
      • Major exceptions
      • Number of employees involved
      • Amount of time spent in each area of the process

    2.1 Assess the current state to drive the gap analysis

    Before you choose any solution, identify what needs to be done to your current state in order to achieve the vision you have defined.

    • By beginning with the future state in mind, you have likely already envisioned some potential solutions.
    • By reviewing your current situation in contrast with your desired future state, you can deliberate what needs to be done to bridge the gap. The differences between the models allow you to define a set of changes that must be enacted in sequence or in parallel. These represent the gaps.
    • The gaps, once identified, translate themselves into additional requirements.

    Assessment Example

    Future State

    Current Situation

    Next Actions/ Proposals

    Incorporate social channels for responding to customer inquiries.

    No social media monitoring or channels for interaction exist at present.

    1. Implement a social media monitoring platform tool and integrate it with the current CSM.
    2. Recruit additional Customer Service representatives to monitor and respond to inquiries via social channels.
    3. Develop report(s) for analyzing volumes of inquiries received through social channels.

    Info-Tech Insight

    It is important to allot time for the current-state analysis, confine it to the minimum effort required to understand the gaps, and identify any missing pieces from your future-state vision. Make sure the work expended is proportional to the benefit derived from this exercise.

    2.1a Model current-state business processes

    2 hours

    1. Model the current state of the most critical business processes, using the work done in activities 1.2a and 1.2b to help identify these processes.
    2. Use Tab 5, Column I of Info-Tech’s Customer Service Business Process Shortlisting Tool to keep stock of what models have been completed.
    3. This tool is now complete.
    The image contains a screenshot of the Customer Service Business Process Shortlisting Tool.
    InputOutput
    • Modeled current-state Customer Service business processes
    • An inventory of modeled current states for critical Customer Service business processes
    MaterialsParticipants
    • Whiteboard
    • Writing materials
    • Customer Service Business Process Shortlisting Tool
    • Results of activities 1.2a and 1.2b.
    • Applications Director
    • Customer Service Director

    Download the Customer Service Business Process Shortlisting Tool

    2.1b Compare future and current business states

    2 hours

    1. Use Tab 9 of Info-Tech’s Customer Service Systems Strategy Tool to record a summary of the future state, current state, and actions proposed in order to bridge the gaps.
      • Fill out the desired future state of the business processes and IT architecture.
      • Fill out the current state of the business processes and IT architecture.
      • Fill out the actions required to mitigate the gaps between the future and current state.
    The image contains a screenshot of thr Customer Service Systems Strategy Tool.
    InputOutput
    • The results of activities 1.2a, 1.2b, and 2.1a.
    • Modeled future- and current-state business processes
    • An overview and analysis of how to reach certain future states from the current state.
    • A preliminary list of next steps through bridging the gap between current and future states.
    MaterialsParticipants
    • Whiteboard
    • Writing materials
    • Customer Service Business Process Shortlisting Tool
    • Applications Director
    • Customer Service Director

    Download the Customer Service Systems Strategy Tool

    2.1 Assess whether Customer Service architecture can meet future-state vision

    Approach your CS systems holistically to identify opportunities for system architecture optimization.

    • Organizations often do not have a holistic view of their Customer Service systems. These systems are often cobbled together from disparate parts, such as:
      • Point solutions (both SaaS and on-premise).
      • Custom interfaces between applications and databases.
      • Spreadsheets and other manual workarounds.
    • A high degree of interaction between multiple systems can cause distention in the application portfolio and databases, creating room for error and more work for CS and IT staff. Mapping your systems and architectural landscape can help you:
      • Identify the number of manual processes you currently employ.
      • Eliminate redundancies.
      • Allow for consolidation and/or integration.

    Consider the following metrics when tracking your CS systems:

    Time needed to perform core tasks (i.e., resolving a customer complaint)

    Accuracy of basic information (customer history, customer product portfolio)

    CSR time spent on manual process/workarounds

    Info-Tech Insight

    There is a two-step process to document the current state of your Customer Service systems:

    1. Compile an inventory of systems by function
    2. Identify points of integration across systems

    2.1c Begin compiling an inventory of CS systems by function

    2 hours

    1. Using Tab 2 of Info-Tech’s Customer Service Systems Strategy Tool, request that the CS managers fill in the application inventory template with all the CS systems that they use.
    2. Questions to trigger exercise:
      • Which applications am I using?
      • Which CS function does the application support?
      • How many applications support the same function?
      • What spreadsheets or manual workarounds do I use to fill in system gaps?
    3. Send the filled-in template to IT Managers to validate and fill in missing system information.
    InputOutput
    • Applications Directors’ knowledge of the current state
    • IT Managers’ validation of this state
    • A corroborated inventory of the current state for Customer Service systems
    MaterialsParticipants
    • Customer Service Systems Strategy Tool
    • Applications Director
    • IT managers

    Download the Customer Service Systems Strategy Tool

    2.1 Use activity 2.1c for an overview of your current state map

    The image contains a screenshot of activity 2.1.

    Info-Tech Insight

    A current-state map of CS systems can offer insight on:

    • Coverage, i.e. whether all functional areas are supported by systems.
    • Redundancies, i.e. functional areas with multiple systems. If a customer’s records are spread across multiple systems, it may be difficult to obtain a single source of truth.

    2.2 Assess current state with user interface architecture diagrams

    Understand a high-level overview of how your current state integrates together to rate its overall quality.

    • If IT already has an architecture diagram, use this in conjunction with your application inventory for the basis of current state discussions.
    • If your organization does not already have an architecture diagram for review and discussion, consider creating one in its most simplistic form using the following guidelines (see illustrative example on next slide):

    Represent each of your systems as a labelled shape with a unique number (this number can be referenced in other artifacts that can provide more detail).

    Color coding can also be applied to differentiate these objects, e.g., to indicate an internal system (where development is owned by your organization) vs. an external system (where development is outside of your organization’s control).

    2.2 Example: Current state with user interface architecture diagrams

    The image contains a screenshot of an example of current state with user interface architecture diagrams.

    2.2 Evaluate application functionality and functional coverage

    Use this documentation of the current state as an opportunity to spot areas for rationalizing your application portfolio.

    If an application is well-received by the organization and is an overall good platform, consider acquiring more modules from the same vendor application.

    The image contains a screenshot of a diagram to demonstrate functionality and functional coverage.

    If you have more than one application for a function, consider why that is and how you might consolidate into a single application.

    Measure the effectiveness of applications under consideration. For example, consider the number of failures when an application attempts a function (by ticket numbers), and overall satisfaction/ease of use.

    The above steps will reveal capability overlaps and application pain points and show how the overall portfolio could be made more efficient.

    2.2 Determine the degree of integration between systems

    Data and system integration are key components of an effective CS system portfolio.

    The needed level of integration will depend on three major factors:

    Integration between systems helps facilitate reporting. The required reports will vary from organization to organization:

    How many other systems benefit from the data of the application?

    Large workforces will benefit from more detailed WFM reports for optimizing workforce planning and talent acquisition.

    Will automating the integration between systems alleviate a significant amount of manual effort?

    Organizations with competitive sales and incentives will want to strategize around talent management and compensation.

    What kind of reports will your organization require in order to perform core and business-enabling functions?

    Aging workforces or organizations with highly specialized skills can benefit from detailed analysis around succession planning.

    Phase 2 – Case Study

    Integrating customer relationship information streamlines customer service and increases ROI for the organization.

    INDUSTRY: Retail and Wholesale

    SOURCE: inContact

    Situation

    Solution

    Results

    • Hall Automotive – a group of 14 multi-franchise auto dealerships located throughout Virginia and North Carolina – had customer information segmented throughout their CRM system at each dealership.
    • Call center agents lacked the technology to synthesize this information, leading customers to receive multiple and unrelated service calls.
    • Hall Automotive wanted to avoid embarrassing information gaps, integrate multiple CRM systems, and help agents focus on customers.
    • Hall Automotive utilized an inContact solution that included Automated Call Distributor, Computer Telephony Integration, and IVR technologies.
    • This created a complete customer-centric system that interfaced with multiple CRM and back-office systems.
    • The inContact solution simplified intelligent call flows, routed contacts to the right agent, and provided comprehensive customer information.
    • Call time decreased from five minutes to one minute and 23 seconds.
    • 350% increase in production.
    • Market response time down from three months to one day.
    • Cost per call cut from 83 cents to 23 cents.
    • Increased agents’ calls-per-hour from 12 to 43.
    • Scalability matched seasonal fluctuations in sales.

    2.2a Rate your functional and integration quality

    2 hours

    1. Using Tab 5 of Info-Tech’s Customer Service Systems Strategy Tool, evaluate the functionality of your applications.
    2. Then, use Tab 6 of the Customer Service Systems Strategy Tool to evaluate the integration of your applications.
    The image contains screenshots of the Customer Service Systems Strategy Tool.
    InputOutput
    • Applications Directors’ knowledge of the current state
    • IT Managers’ validation of this state
    • A documented evaluation of the organization’s application portfolio regarding functional and integration quality
    MaterialsParticipants
    • Customer Service Systems Strategy Tool
    • Applications Director
    • IT managers

    Download the Customer Service Systems Strategy Tool

    2.3 Revisit and refine the future-state business processes and list of requirements

    With a better understanding of the current state, determine whether the future-state models hold up. Ensure that the requirements are updated accordingly to reflect the full set of gaps identified.

    • Future-state versus current-state modeling is an iterative process.
    • By assessing the gaps between target state and current state, you may decide that:
      • The future state model was overly ambitious for what can reasonably be delivered in the near-term.
      • Core functions that exist today were accidentally omitted from the future state models and need to be incorporated.
      • There are systems or processes that your organization would like to salvage, and they must be worked into the future-state model.
    • Once the future state vision is stabilized, ensure that all gaps have been translated into business requirements.
      • If possible, categorize all gaps by functional and non-functional requirements.

    2.3a Compare states and propose action

    3 hours

    • Revisit Tab 9 of Info-Tech’s Customer Service Systems Strategy Tool to more accurately compare your organization’s current- and future-state business processes.
    • Ensure that gaps in the system architecture have been captured.
    The image contains a screenshot of the Customer Service Systems Strategy Tool.
    InputOutput
    • Modeled future- and current-state business processes
    • Refined and prioritized list of requirements
    • An accurate list of action steps for bridging current and future state business processes
    MaterialsParticipants
    • Whiteboard
    • Writing materials
    • Customer Service Systems Strategy Tool
    • Applications Director
    • IT managers

    Download the Customer Service Systems Strategy Tool

    2.3 Prioritize and finalize the requirements

    Prioritizing requirements will help to itemize initiatives and the timing with which they need to occur.

    Requirements are to be prioritized based on relative important and the timing of the respective initiatives.

    Prioritize the full set of requirements by assigning a priority to each:

    1. High/Critical: A critical requirement; without it, the product is not acceptable to the stakeholders.
    2. Medium/Important: A necessary but deferrable requirement that makes the product less usable but still functional.
    3. Low/Desirable: A nice feature to have if there are resources, but the product can function well without it.

    Requirements prioritization must be completed in collaboration with all key stakeholders (business and IT).

    Consider the following criteria when assigning the priority:

    • Business value
    • Business or technical risk
    • Implementation difficulty
    • Likelihood of success
    • Regulatory compliance
    • Relationship to other requirements
    • Urgency
    • Unified stakeholder agreement

    Stakeholders must ask themselves:

    • What are the consequences to the business objectives if this requirement is omitted?
    • Is there an existing system or manual process/workaround that could compensate for it?
    • Why can’t this requirement be deferred to the next release?
    • What business risk is being introduced if a particular requirement cannot be implemented right away?

    2.3b Document finalized requirements

    4 hours

    1. Using Tab 4 of Info-Tech’s Customer Service Systems Strategy Tool, evaluate your applications’ functionality, review, refine, prioritize, and finalize your requirements.
    2. Review the proposed future state diagrams in activity 2.3a and distill from them the business, functional, and non-functional requirements.
    3. The Applications Director and Customer Service Head are to identify participants based on the business processes that will be reviewed. They are to conduct a workshop to gather all the requirements that can be taken from the business process models.
    The image contains a screenshot of the Customer Service Systems Strategy Tool.
    InputOutput
    • Modeled future- and current-state business processes
    • Refined and prioritized list of requirements
    • A documented finalized list of requirements to achieve future state business processes
    MaterialsParticipants
    • Whiteboard
    • Writing materials
    • Customer Service Systems Strategy Tool
    • IT Applications Director
    • Customer Service Director
    • IT and Customer Service Representatives

    Download the Customer Service Systems Strategy Tool

    Phase 3

    Build Roadmap to Future State

    Phase 1

    Phase 2

    Phase 3

    1.1 Structure the Project

    1.2 Define Vision for Future State

    1.3 Document Preliminary Requirements

    2.1 Document Current State Business Processes

    2.2 Assess Current State Architecture

    2.3 Review and Finalize Requirements for Future State

    3.1 Evaluate Architectural and Application Options

    3.2 Understand the Marketplace

    3.3 Score and Plot Initiatives Along Strategic Roadmap

    This phase will guide you through the following activities:

    3.1a Analyze future architectural posture to understand how applications within the organization ought to be arranged.

    3.3a Develop a Customer Service IT Systems initiative roadmap to reach your future state.

    Participants required for Phase 3:

    • Applications Director
    • CIO
    • Customer Service Director
    • Customer Service Head
    • IT and Customer Service Representatives
    • IT Applications Director

    3.1a Analyze future architectural posture

    1 hour

    Review Tab 8 of the Customer Service Systems Strategy Tool.

    This tab plots each system that supports Customer Service on a 2x2 framework based on its functionality and integration scores. Where these systems plot on each 2x2 provides clues as to whether they should be considered for retention, functional enhancement (upgrade), increased system integration, or replacement.

    • Integrate: The application is functionally rich, so integrate it with other modules by building or enhancing interfaces.
    • Retain: The application satisfies both functionality and integration requirements, so it should be considered for retention.
    • Replace: The application neither offers the functionality sought, nor is it integrated with other modules.
    • Replace/Enhance: The module offers poor functionality but is well integrated with other modules. If enhancing for functionality is easy (e.g., through configuration or custom development), consider enhancement or replace it altogether.
    The image contains a screenshot of tab 8 of the Customer Service Systems Strategy Tool.
    InputOutput
    • Review Tab 8 of the Customer Service Systems Strategy Tool
    • An overview of how different applications in the organization ought to be assessed
    MaterialsParticipants
    • Customer Service Systems Strategy Tool
    • IT Applications Director
    • Customer Service Director
    • IT and Customer Service Representatives

    Download the Customer Service Systems Strategy Tool

    3.1 Interpret 3.1a’s results for next steps

    Involving both sales and marketing in these discussions will provide a 360-degree view on what the modifications should accomplish.

    If the majority of applications are plotted in the “Integrate” quadrant:

    The applications are performing well in terms of functionality but have poor integration. Determine what improvements can be made to enhance integration between the systems where required (e.g. re-working existing interfaces to accommodate additional data elements, automating interfaces, or creating brand new custom interfaces where warranted).

    If the applications are spread across “Integrate,” “Retain,” and “Replace/Enhance”:

    There is no clear recommended direction in this case. Weigh the effort required to replace/enhance/integrate specific applications critical for supporting processes. If resource usage for piecemeal solutions is too high, consider replacement with suite.

    If the majority of applications are plotted in the “Retain” quadrant:

    All applications satisfy both functionality and integration requirements. There is no evidence that significant action is required.

    If the application placements are split between the “Retain” and “Replace/Enhance” quadrants:

    Consider whether or not IT has the capabilities to execute application replacement procedures. If considering replacement, consider the downstream impact on applications that the system in question is currently integrated with. Enhancing an application usually implies upgrading or adding a module to an existing application. Consider the current satisfaction with the application vendor and whether the upgrade or additional module will satisfy your customer service needs.

    3.1 Work through architectural considerations to narrow future states

    Best-of-breeds vs. suite

    Integration and consolidation

    Deployment

    Does the organization only need a point solution or an entire platform of solutions?

    Does the current state enable interoperability between software? Is there room for rationalization?

    Should any new software be SaaS-based, on-premises, or a hybrid?

    Info-Tech Insight

    Decommissioning and replacing entire applications can put well-functioning modules at risk. Make sure to drill down into the granular features to assess if the feature level performance prompts change. The goal is to make the architecture more efficient for Customer Service and easier to manage for IT. If integration has been chosen as a course of action, make sure that the spend on resources and effort is less than that on system replacement. Also make sure that the intended architecture streamlines usability for agents.

    3.1 Considerations: Best-of-breeds vs. suite

    If requirements extend beyond the capabilities of a best-of-breed solution, a suite of tools may be required.

    Best-of-breed

    Suite

    Benefits

    • Features may be more advanced for specific functional areas and a higher degree of customization may be possible.
    • If a potential delay in real-time customer data transfer is acceptable, best-of-breeds provide a similar level of functionality to suites for a lower price.
    • Best-of-breeds allow value to be realized faster than suites, as they are easier and faster to implement and configure.
    • Rip and replace is easier and vendor updates are relatively quick to market.

    Benefits

    • Everyone in the organization works from the same set of customer data.
    • There is a “lowest common denominator” for agent learning as consistent user interfaces lower learning curves and increase efficiency in usage.
    • There is a broader range of functionality using modules.
    • Integration between functional areas will be strong and the organization will be in a better position to enable version upgrades without risking invalidation of an integration point between separate systems.

    Challenges

    • Best-of-breeds typically cover less breadth of functionality than suites.
    • There is a lack of uniformity in user experience across best-of-breeds.
    • Data integrity risks are higher.
    • Variable infrastructure may be implemented due to multiple disparate systems, which adds to architecture complexity and increased maintenance.
    • There is potential for redundant functionality across multiple best-of-breeds.

    Challenges

    • Suites exhibit significantly higher costs compared to point solutions.
    • Suite module functionality may not have the same depth as point solutions.
    • Due to high configuration availability and larger-scale implementation requirements, the time to deploy is longer than point solutions.

    3.1 Considerations: Integration and consolidation

    Use Tab 7 of Info-Tech’s Customer Service Systems Strategy Tool to gauge the need for consolidation.

    IT benefits

    • Decreased spend on infrastructure, application acquisition, and development.
    • Reduced complexity in vendor management.
    • Less resources and effort spent on internal integration and functional customization.

    Customer Service benefits

    • Reduced user confusion and application usage efficiency.
    • Increased operational visibility and ease process mapping.
    • Improved data management and integrity.

    Theoretical scenarios and recommendations

    The image contains a screenshot of an example of a customer service functional purpose.

    Problem:

    • Large Redundancy – multiple applications address the same function, but one application performs better than others.

    Recommendation:

    • Consolidate the functions into Application 1 and consider decommissioning Applications 2 to 4.
    The image contains a screenshot of an example of a customer service functional purpose.

    Problem:

    • Large Redundancy – multiple applications address the same function, but none of them do it well.

    Recommendation:

    • None of the applications perform well in functional support. Consider replacing with suite or leveraging the Application 3 vendor for functional module expansion, if feasible.

    3.1 Considerations: Deployment

    SaaS is typically recommended as it reduces IT support needs. However, customization limitations and higher long-term TCO values continue to be a challenge for SaaS.

    On-premises deployment

    Hybrid deployment

    Public cloud deployment

    Benefits

    • Solution and deployment are highly customizable.
    • There are fewer compliance and security risks because customer data is kept on premises.

    Challenges

    • There is slower physical deployment.
    • Physical hardware and software are required.
    • There are higher upfront costs.

    Benefits

    • Pick-and-mix which aspects to keep on premises and which to outsource.
    • Benefits of scaling and flexibility for outsourced solution.

    Challenges

    • Expensive to maintain.
    • Requires in-house skillset for on-premises option.
    • Some control is lost over outsourced customization.

    Benefits

    • Physical hardware is not required.
    • There is rapid deployment, vendor managed product updates, and server maintenance.
    • There are lower upfront costs.

    Challenges

    • There is higher TCO over time.
    • There are perceived security risks.
    • There are service availability and reliability risks.
    • There is limited customization.

    3.1 Considerations: Public cloud deployment

    Functionality is only one aspect of a broader range of issues to narrow down the viability of a cloud-based architecture.

    Security/Privacy Concerns:

    Whether the data is stored on premise or in the cloud, it is never 100% safe. The risk increases with a multi-tenant cloud solution where a single vendor manages the data of multiple clients. If your data is particularly sensitive, heavily scrutinize the security infrastructure of potential vendors or store the data internally if internal security is deemed stronger than that of a vendor.

    Location:

    If there are individuals that need to access the system database and work in different locations, centralizing the system and its database in the cloud may be an effective approach.

    Compatibility:

    Assess the compatibility of the cloud solutions with your internal IT systems. Cloud solutions should be well-integrated with internal systems for data flow to ensure efficiency in service operations.

    Cost/Budget Constraints:

    SaaS allows conversion of up-front CapEx to periodic OpEx. It assists in bolstering a business case as costs in the short-run are much more manageable. On-premise solutions have a much higher upfront TCO than cloud solutions. However, the TCO for the long-term usage of cloud solutions under the licensing model will exceed that of an on-premise solution, especially with a growing business and user base.

    Functionality/Customization:

    Ensure that the function or feature that you need is available on the cloud solution market and that the feature is robust enough to meet service quality standards. If the available cloud solution does not support the processes that fit your future-state vision and gaps, it has little business value. If high levels of customization are required to meet functionality, the amount of effort and cost in dealing with the cloud vendor may outweigh the benefits.

    Maintenance/Downtime:

    For most organizations, lapses in cloud-service availability can become disastrous for customer satisfaction and service quality. Organizations should be prepared for potential outages since customers require constant access to customer support.

    3.2 Explore the customer service technology marketplace

    Your requirements, gap analysis, and assessment of current applications architecture may have prompted the need for a new solutions purchase.

    • Customer service technology has come a long way since PABX in 1960s call centers. Let Info-Tech give you a quick overview of the market and the major systems that revolve around Customer Service.
    • The image contains a screenshot of a timeline of the market and major systems that revolve  around customer service.

    Info-Tech Insight

    While Customer Relationships Management systems interlock several aspects of the customer journey, best-of-breed software for specific aspects of this journey could provide a better ROI if the organization’s coverage of these aspects are only “good enough” and need boosting.

    3.2 The CRM software market will continue to grow at an aggressive rate

    • In recent years, CRM suite solutions have matured significantly in their customer support capabilities. Much of this can be attributed to their acquisitions of smaller best-of-breed Customer Service vendors.
    • Many of the larger CRM solutions (like those offered by Salesforce) have now added social media engagement, knowledge bases, and multi-channel capabilities into their foundational offering.
    • CRM systems are capable of huge sophistication and integration with the core ERP, but they also have heavy license and implementation costs, and therefore may not be for everyone.
    • In some cases, customers are looking to augment upon very specific capabilities that are lacking from their customer service foundation. In these cases, best-of-breed solutions ought to be integrated with a CRM, ERP, or with one another through API integration.
    The image contains a screenshot of a graph that demonstrates the CRM global market growth, 2019-2027.

    3.2 Utilize SoftwareReviews to focus on which CS area needs enhancing

    Contact Center as a Service (CCaaS)

    Cloud-based customer experience solution that allows organizations to utilize a provider’s software to administer incoming support or inquiries from consumers in a hosted, subscription model.

    Customer Service Management (CSM)

    Supports an organization's interaction with current and potential customers. It uses data-driven tools designed to help organizations drive sales and deliver exceptional customer experiences.

    Customer Intelligence Platform

    Gather and analyze data from both structured and unstructured sources regarding your customers, including their demographic/firmographic details and activities, to build deeper and more effective customer relationships and improve business outcomes.

    Enterprise Social Media Management

    Software for monitoring social media activity with the goal of gaining insight into user opinion and optimizing social media campaigns.

    Customer Relationship Management (CRM)

    Consists of applications designed to automate and manage the customer life cycle. CRM software optimizes customer data management, lead tracking, communication logging, and marketing campaigns.

    Virtual Assistants and Chatbots

    interactive applications that use Artificial Intelligence (AI) to engage in conversation via speech or text. These applications simulate human interaction by employing natural language input and feedback.

    3.2 SoftwareReviews’ data accelerates and improves the software selection process

    SoftwareReviews collects and analyzes detailed reviews on enterprise software from real users to give you an unprecedented view into the product and vendor before you buy.

    With SoftwareReviews:

    • Access premium reports to understand the marketspace of 193 software categories.
    • Compare vendors with SoftwareReviews’ Data Quadrant Reports.
    • Discover which vendors have better customer relations management with SoftwareReviews’ Emotional Footprint Reports.
    • Explore the Product Scorecards of single vendors for a detailed analysis of their software offerings.
    The image contains a screenshot of the Software Reviews offerings.

    3.2 Speak with category experts to dive deeper into the vendor landscape

    Fact-based reviews of business software from IT professionals.

    Product and category reports with state-of-the-art data visualization.

    Top-tier data quality backed by a rigorous quality assurance process.

    User-experience insight that reveals the intangibles of working with a vendor.

    CLICK HERE to access SoftwareReviews

    Comprehensive software reviews to make better IT decisions.

    We collect and analyze the most detailed reviews on enterprise software from real users to give you an unprecedented view into the product and vendor before you buy.

    SoftwareReviews is powered by Info-Tech.

    Technology coverage is a priority for Info-Tech, and SoftwareReviews provides the most comprehensive unbiased data on today’s technology. The insights of our expert analysts provide unparalleled support to our members at every step of their buying journey.

    3.2 Leverage Info-Tech’s Rapid Application Selection Framework

    Improve your key software selection metrics for best-of-breed customer service software.

    The image contains a screenshot of an example of Info-Tech's Rapid Application Selection Framework.

    A simple measurement of the number of days from intake to decision.

    Use our Project Satisfaction Tool to measure stakeholder project satisfaction.

    Use our Application Portfolio Assessment Tool annually to measure application satisfaction.

    Use our Contract Review Service to benchmark and optimize your technology spending.

    Learn more about Info-Tech’s The Rapid Application Selection Framework

    The Rapid Application Selection Framework (RASF) is best geared toward commodity and mid-tier enterprise applications

    Not all software selection projects are created equal – some are very small, some span the entire enterprise. To ensure that IT is using the right framework, understand the cost and complexity profile of the application you’re looking to select. The RASF approach is best for commodity and mid-tier enterprise applications; selecting complex applications is better handled by the methodology described in Implement a Proactive and Consistent Vendor Selection Process.

    RASF Methodology

    Commodity & Personal Applications

    • Simple, straightforward applications (think OneNote vs. Evernote)
    • Total application spend of up to $10,000; limited risk and complexity
    • Selection done as a single, rigorous, one-day session

    Complex Mid-Tier Applications

    • More differentiated, department-wide applications (Marketo vs. Pardot)
    • Total application spend of up to $100,000; medium risk and complexity
    • RASF approach done over the course of an intensive 40-hour engagement

    Consulting Engagement

    Enterprise Applications

    Sophisticated, enterprise-wide applications (Salesforce vs. Dynamics)

    Total application spend of over $100,000; high risk and complexity

    Info-Tech can assist with tailored, custom engagements

    3.3 Translate gathered requirements and gaps into project-based initiatives

    Identify initiatives that can address multiple requirements simultaneously.

    The Process

    • You now have a list of requirements from assessing business processes and the current Customer Service IT systems architecture.
    • With a viable architecture and application posture, you can now begin scoring and plotting key initiatives along a roadmap.
    • Group similar requirements into categories of need and formulate logical initiatives to fulfill the requirements.
    • Ensure that all requirements are related to business needs, measurable, sufficiently detailed, and prioritized, and identify initiatives that meet the requirements.

    Consider this case:

    Paul’s organization, a midsize consumer packaged goods retailer, needs to monitor social media for sentiment, use social analytics to gain intelligence, and receive and respond to inquiries made over Twitter.

    The initiative:

    Implement a social media management platform (SMMP): A SMMP is able to deliver on all of the above requirements. SMMPs are highly capable platforms that have social listening modules and allow costumer service representatives to post to and monitor social media.

    3.3 Prioritize your initiatives and plan the order of rollout

    Initiatives should not and cannot be tackled all at once. There are three key factors that dictate the prioritization of initiatives.

    1. Value
      • What is the monetary value/perceived business value?
      • Are there regulatory or security related impacts if the initiative is not undertaken?
      • What is the time to market and is it an easily achievable goal?
      • How well does it align with the strategic direction?
    2. Risk
      • How technically complex is it?
      • Does it impact existing business processes?
      • Are there ample resources and right skillsets to support it?
    3. Dependencies
      • What initiatives must be undertaken first?
      • Which subsequent initiatives will it support?

    Example scenario using Info-Tech’s Initiative Scoring and Roadmap Tool

    An electronics distributor wants to implement social media monitoring and response. Its existing CRM does not have robust channel management functions. The organization plans to replace its CRM in the future, but because of project size and impact and budgetary constraints, the replacement project has been scheduled to occur two years from now.

    • The SMMP solution proposed for implementation has a high perceived value and is low risk.
    • The CRM replacement has higher value, but also carries significantly more risk.
    • Option 1: Complete the CRM replacement first, and overlay the social media monitoring component afterward (as the SMMP must be integrated with the CRM).
    • Option 2: Seize the easily achievable nature of the SMMP initiative. Implement it now and plan to re-work the CRM integration later.
    The image contains a screenshot of an example scenario using Info-Tech's Initiative Scoring and Roadmap Tool.

    3.3a Develop a Customer Service IT Systems initiative roadmap

    1 hour

    • Complete the tool as a team during a one-hour meeting to collaborate and agree on criteria and weighting.
      1. Input initiative information.
      2. Determine value and risk evaluation criteria.
      3. Evaluate each initiative to determine its priority.
      4. Create a roadmap of prioritized initiatives.
    The image contains a screenshot of the Customer Service Initiative Scoring and Roadmap Tool.
    InputOutput
    • Input the initiative information including the start date, end date, owner, and dependencies
    • Adjust the evaluation criteria, i.e., the value and risk factors
    • A list of initiatives and a roadmap toward the organization’s future state of Customer Service IT Systems
    MaterialsParticipants
    • Customer Service Initiative Scoring and Roadmap Tool
    • Applications Director
    • CIO
    • Customer Service Head

    Download the Customer Service Initiative Scoring and Roadmap Tool

    Document and communicate the strategy

    Leverage the artifacts of this blueprint to summarize your findings and communicate the outcomes of the strategy project to the necessary stakeholders.

    Document Section

    Proposed Content

    Leverage the Following Artifacts

    Executive Summary

    • Introduction
    • The opportunity
    • The scope
    • The stakeholders
    • Project success measures

    Project Charter section:

    • 1.1 Project Overview
    • 1.2 Project Objectives
    • 1.3 Project Benefits
    • 2.0 Scope

    Project RACI Chart Tool:

    • Tab 3. Simplified Output
    The image contains screenshots from the Project Charter, and the RACI Chart Tool.

    Background

    • The project approach
    • Current situation overview
    • Results of the environmental scan

    Blueprint slides:

    • Info-Tech’s methodology to develop your IT Strategy for CS Systems
    The image contains a screenshot from the blueprint slides.

    Future-State Vision

    • Customer service goals
    • Future-state modeling findings

    Customer Service Business Process Shortlisting Tool:

    • Tab 2. Customer Service Goals
    • Tab 5. Level 5 Process Inventory

    Future State Business Process Models

    The image contains screenshots from the Customer Service Business Process Shortlisting Tool.

    Current Situation

    • Current-state modeling findings
    • Current-state architecture findings
    • Gap assessment
    • Requirements

    Customer Service Systems Strategy Tool:

    • Tab 2. Inventory of Applications
    • Tab 7. Systems Health Heat Map
    • Tab 8. Systems Health Dashboard
    • Tab 9. Future vs. Current State
    • Tab 4. Requirements Collection
    The image contains screenshots from the Customer Service Systems Strategy Tool.

    Summary of Recommendations

    • Optimization opportunities
    • New capabilities

    N/A

    IT Strategy Implementation Plan

    • Implementation plan
    • Business case

    Customer Service Initiative Scoring and Roadmap Tool:

    • Tab 2. CS Initiative Definition
    • Tab 4. CS Technology Roadmap
    The image contains screenshots from the Customer Service Initiative Scoring and Roadmap Tool.

    Summary of Accomplishment

    Develop an IT Strategy to Support Customer Service

    With ecommerce accelerating and customer expectations rising with it, organizations must have an IT strategy to support Customer Service.

    The deliverable you have produced from this blueprint provides a solution to this problem: a roadmap to a desired future state for how IT can ground an effective customer service engagement. From omnichannel to self-service, IT will be critical to enabling the tools required to digitally meet customer needs.

    Begin implementing your roadmap!

    If you would like additional support, have our analysts guide you through other phases as part of an Info-Tech workshop.

    Contact your account representative for more information.

    workshops@infotech.com

    1-888-670-8889

    Related Info-Tech Research

    Deliver a Customer Service Training Program to Your IT Department

    • One training session is not enough to make a change. Leaders must embed the habits, create a culture of engagement and positivity, provide continual coaching and development, regularly gather customer feedback, and seek ways to improve.

    Build a Chatbot Proof of Concept

    • When implemented effectively, chatbots can help save costs, generate new revenue, and ultimately increase customer satisfaction for both external- and internal-facing customers.

    The Rapid Application Selection Framework

    • Application selection is a critical activity for IT departments. Implement a repeatable, data-driven approach that accelerates application selection efforts.

    Bibliography (1/2)

    • Callzilla. "Software Maker Compares Call Center Companies, Switches to Callzilla After 6 Months of Results." Callzilla. N.d. Accessed: 4 Jul. 2022.
    • Cisco. “Transforming Customer Service.” Cisco. 2018. Accessed: 8 Feb. 2021.
    • Gottlieb, Giorgina. “The Importance of Data for Superior Customer Experience and Business Success.” Medium. 23 May 2019. Accessed: 8 Feb. 2021.
    • Grand View Research. “Customer Relationship Management Market Size, Share & Trends Analysis Report By Solution, By Deployment, By Enterprise Size, By End Use, By Region, And Segment Forecasts, 2020 – 2027.” Grand View Research. April 2020. Accessed: 17 Feb. 2021.
    • inContact. “Hall Automotive Accelerates Customer Relations with inContact.” inContact. N.d. Accessed: 8 Feb. 2021.
    • Kulbyte, Toma. “37 Customer Experience Statistics to Know in 2021.” Super Office. 4 Jan. 2021. Accessed: 5 Feb. 2021.
    • Kuligowski, Kiely. "11 Benefits of CRM Systems." Business News Daily. 29 Jun. 2022. Accessed: 4 Jul. 2022.
    • Mattsen Kumar. “Ominchannel Support Transforms Customer Experience for Leading Fintech Player in India.” Mattsen Kumar. 4 Apr. 2020. Accessed: 8 Feb. 2021.
    • Microsoft. “State of Global Customer Service Report.” Microsoft. Mar. 2019. Accessed: 8 Feb. 2021.
    • Ringshall, Ben. “Contact Center Trends 2020: A New Age for the Contact Center.” Fonolo. 20 Oct. 2020. Accessed 2 Nov. 2020.
    • Salesforce. “State of Service.” Salesforce. 4th ed. 2020. Accessed: 8 Feb. 2021.
    • Sopadjieva, Emma, Utpal M. Dholakia, and Beth Benjamin. “A Study of 46,000 Shoppers Shows That Omnichannel Retailing Works.” Harvard Business Review. 3 Jan. 2017. Accessed: 8 Feb. 2021.

    Bibliography (2/2)

    • Tech Pro Research. “Digital Transformation Research Report 2018: Strategy, Returns on Investment, and Challenges.” Tech Pro Research. 29 Jul. 2018. Accessed: 5 Feb. 2021.
    • TSB. “TSB Bank Self-Serve Banking Increases 9% with Adobe Sign.” TSB. N.d. Accessed: 8 Feb. 2021.
    • VoiceSage. “VoiceSage Helps Home Retail Group Transform Customer Experience.” VoiceSage. 4 May 2018. Accessed: 8 Feb. 2021.

    Optimize the Service Desk With a Shift-Left Strategy

    • Buy Link or Shortcode: {j2store}478|cart{/j2store}
    • member rating overall impact: 9.4/10 Overall Impact
    • member rating average dollars saved: $21,171 Average $ Saved
    • member rating average days saved: 11 Average Days Saved
    • Parent Category Name: Service Desk
    • Parent Category Link: /service-desk
    • Tier 2 and 3 specialists lose time and resources working on tickets instead of more complex projects.
    • The service desk finds themselves resolving the same incidents over and over, wasting manual work on tasks that could be automated.
    • Employees expect modern, consumer-like experiences when they need help; they want to access information and resources from wherever they are and have the tools to solve their problems themselves without waiting for help.

    Our Advice

    Critical Insight

    • It can be difficult to overcome the mindset that difficult functions need to be escalated. Shift left involves a cultural change to the way the service desk works, and overcoming objections and getting buy-in up front is critical.
    • Many organizations have built a great knowledgebase but fail to see the value of it over time as it becomes overburdened with overlapping and out-of-date information. Knowledge capture, updating, and review must be embedded into your processes if you want to keep the knowledgebase useful.
    • Similarly, the self-service portal is often deployed out of the box with little input from end users and fails to deliver its intended benefits. The portal needs to be designed from the end user’s point of view with the goal of self-resolution if it will serve its purpose of deflecting tickets.

    Impact and Result

    • Embrace a shift-left strategy by moving repeatable service desk tasks and requests into lower-cost delivery channels such as self-help tools and automation.
    • Shift work from Tier 2 and 3 support to Tier 1 through good knowledge management practices that empower the first level of support with documented solutions to recurring issues and free up more specialized resources for project work and higher value tasks.
    • Shift knowledge from the service desk to the end user by enabling them to find their own solutions. A well-designed and implemented self-service portal will result in fewer logged tickets to the service desk and empowered, satisfied end users.
    • Shift away manual repetitive work through the use of AI and automation.
    • Successfully shifting this work left can reduce time to resolve, decrease support costs, and increase end-user satisfaction.

    Optimize the Service Desk With a Shift-Left Strategy Research & Tools

    Start here – read the Executive Brief

    Read our concise Executive Brief to understand why a shift-left strategy can help to optimize your service desk, review Info-Tech's methodology, and understand the four ways we can support you in completing this project.

    Besides the small introduction, subscribers and consulting clients within this management domain have access to:

    1. Prepare to shift left

    Assess whether you’re ready to optimize the service desk with a shift-left strategy, get buy-in for the initiative, and define metrics to measure success.

    • Optimize the Service Desk With a Shift-Left Strategy – Phase 1: Prepare to Shift Left
    • Shift-Left Prerequisites Assessment
    • Shift-Left Strategy
    • Shift-Left Stakeholder Buy-In Presentation

    2. Design shift-left model

    Build strategy and identify specific opportunities to shift service support left to Level 1 through knowledge sharing and other methods, to the end-user through self-service, and to automation and AI.

    • Optimize the Service Desk With a Shift-Left Strategy – Phase 2: Design Shift Left Model
    • Shift-Left Action Plan
    • Knowledge Management Workflows (Visio)
    • Knowledge Management Workflows (PDF)
    • Self-Service Portal Checklist
    • Self-Service Resolution Workflow (Visio)
    • Self-Service Resolution Workflow (PDF)

    3. Implement and communicate

    Identify, track, and implement specific shift-left opportunities and document a communications plan to increase adoption.

    • Optimize the Service Desk With a Shift-Left Strategy – Phase 3: Implement & Communicate
    • Incident Management Workflow (Visio)
    • Incident Management Workflow (PDF)
    [infographic]

    Workshop: Optimize the Service Desk With a Shift-Left Strategy

    Workshops offer an easy way to accelerate your project. If you are unable to do the project yourself, and a Guided Implementation isn't enough, we offer low-cost delivery of our project workshops. We take you through every phase of your project and ensure that you have a roadmap in place to complete your project successfully.

    1 Prepare to Shift Left

    The Purpose

    Define how shift left would apply in your organization, get buy-in for the initiative, and define metrics to measure success.

    Key Benefits Achieved

    Defined scope and objectives for the shift-left initiative

    Buy-in for the program

    Metrics to keep the project on track and evaluate success

    Activities

    1.1 Review current service desk structure

    1.2 Discuss challenges

    1.3 Review shift-left model and discuss how it would apply in your organization

    1.4 Complete the Shift-Left Prerequisites Assessment

    1.5 Complete a RACI chart for the project

    1.6 Define and document objectives

    1.7 Review the stakeholder buy-in presentation

    1.8 Document critical success factors

    1.9 Define KPIs and metrics

    Outputs

    Shift-left scope

    Completed shift-left prerequisites assessment

    RACI chart

    Defined objectives

    Stakeholder buy-in presentation

    Critical success factors

    Metrics to measure success

    2 Plan to Shift to Level 1

    The Purpose

    Build strategy and identify specific opportunities to shift service support left to Level 1 through knowledge sharing and other methods.

    Key Benefits Achieved

    Identified initiatives to shift work to Level 1

    Documented knowledge management process workflows and strategy

    Activities

    2.1 Identify barriers to Level 1 resolution

    2.2 Discuss knowledgebase challenges and areas for improvement

    2.3 Optimize KB input process

    2.4 Optimize KB usage process

    2.5 Optimize KB review process

    2.6 Discuss and document KCS strategy and roles

    2.7 Document knowledge success metrics

    2.8 Brainstorm additional methods of increasing FLR

    Outputs

    KB input workflow

    KB usage workflow

    KB review workflow

    KCS strategy and roles

    Knowledge management metrics

    Identified opportunities to shift to Level 1

    3 Plan to Shift to End User and Automation

    The Purpose

    Build strategy and identify specific opportunities to shift service support left to the end user through self-service and to automation and AI.

    Key Benefits Achieved

    Identified initiatives to shift work to self-service and automation

    Evaluation of self-service portal and identified opportunities for improvement

    Activities

    3.1 Review existing self-service portal and discuss vision

    3.2 Identify opportunities to improve portal accessibility, UI, and features

    3.3 Evaluate the user-facing knowledgebase

    3.4 Optimize the ticket intake form

    3.5 Document plan to improve, communicate, and evaluate portal

    3.6 Map the user experience with a workflow

    3.7 Document your AI strategy

    3.8 Identify candidates for automation

    Outputs

    Identified opportunities to improve portal

    Improvements to knowledgebase

    Improved ticket intake form

    Strategy to communicate and measure success of portal

    Self-service resolution workflow

    Strategy to apply AI and automation

    Identified opportunities to shift tasks to automation

    4 Build Implementation and Communication Plan

    The Purpose

    Build an action plan to implement shift left, including a communications strategy.

    Key Benefits Achieved

    Action plan to track and implement shift-left opportunities

    Communications plan to increase adoption

    Activities

    4.1 Examine process workflows for shift-left opportunities

    4.2 Document shift-left-specific responsibilities for each role

    4.3 Identify and track shift-left opportunities in the action plan

    4.4 Brainstorm objections and responses

    4.5 Document communications plan

    Outputs

    Incident management workflow with shift-left opportunities

    Shift left responsibilities for key roles

    Shift-left action plan

    Objection handling responses

    Communications plan

    Measure and Manage Customer Satisfaction Metrics That Matter the Most

    • member rating overall impact: N/A
    • member rating average dollars saved: N/A
    • member rating average days saved: N/A
    • Parent Category Name: Marketing Solutions
    • Parent Category Link: /marketing-solutions
    • Lack of understanding of what is truly driving customer satisfaction or dissatisfaction.
    • Lack of insight into who our satisfied and dissatisfied customers are.
    • Lack of a system for early detection of declines in satisfaction.
    • Lack of clarity on what to improve and how resources should be allocated.

    Our Advice

    Critical Insight

    • All software companies measure satisfaction in some way, but many lack understanding of what’s truly driving customers to stay or leave. By understanding the true drivers of satisfaction, solution providers can measure and monitor satisfaction more effectively, pull actionable insights and feedback, and make changes to products and services that customers really care about and will keep them coming back to you to have their needs met.
    • Obstacles:
      • Use of metrics that don’t provide the insight needed to make impactful changes that will boost satisfaction and ultimately, retention and profit.
      • Lack of a clear definition of what satisfaction means to customers, metric definitions and/or standard methods of measurement, and a consistent monitoring cadence.

    Impact and Result

    • Understanding of who your satisfied and dissatisfied customers are.
    • Understanding of the true drivers of satisfaction and dissatisfaction among your customer segments.
    • Establishment of a repeatable process and cadence for effective satisfaction measurement and monitoring.
    • Development of an executable customer satisfaction improvement plan that identifies customer journey pain points and areas of dissatisfaction, and outlines how to improve them.
    • Knowledge of where money, time, and other resources are needed most to improve satisfaction levels and ultimately increase retention.

    Measure and Manage Customer Satisfaction Metrics That Matter the Most Research & Tools

    Besides the small introduction, subscribers and consulting clients within this management domain have access to:

    1. Measure and Manage the Customer Satisfaction Metrics that Matter the Most Deck – An overview of how to understand what drives customer satisfaction and how to measure and manage it for improved business outcomes.

    Understand the true drivers of customer satisfaction and build a process for managing and improving customer satisfaction.

    [infographic]

    Further reading

    Measure and Manage the Customer Satisfaction Metrics that Matter the Most

    Understand what truly keeps your customer satisfied. Start to measure what matters to improve customer experience and increase satisfaction and advocacy. 

    EXECUTIVE BRIEF

    Analyst perspective

    Understanding and measuring the true drivers of satisfaction enable the delivery of real customer value

    The image contains a picture of Emily Wright.

    “Healthy customer relationships are the paramount to long-term growth. When customers are satisfied, they remain loyal, spend more, and promote your company to others in their network. The key to high satisfaction is understanding and measuring the true drivers of satisfaction to enable the delivery of real customer value.

    Most companies believe they know who their satisfied customers are and what keeps them satisfied, and 76% of B2B buyers expect that providers understand their unique needs (Salesforce Research, 2020). However, on average B2B companies have customer experience scores of less than 50% (McKinsey, 2016). This disconnect between customer expectations and provider experience indicates that businesses are not effectively measuring and monitoring satisfaction and therefore are not making meaningful enhancements to their service, offerings, and overall experience.

    By focusing on the underlying drivers of customer satisfaction, organizations develop a truly accurate picture of what is driving deep satisfaction and loyalty, ensuring that their company will achieve sustainable growth and stay competitive in a highly competitive market.”

    Emily Wright

    Senior Research Analyst, Advisory

    SoftwareReviews

    Executive summary

    Your Challenge

    Common Obstacles

    SoftwareReviews’ Approach

    Getting a truly accurate picture of satisfaction levels among customers, and where to focus efforts to improve satisfaction, is challenging. Providers often find themselves reacting to customer challenges and being blindsided when customers leave. More effective customer satisfaction measurement is possible when providers self-assess for the following challenges:

    • Lack of understanding of what is truly driving customer satisfaction or dissatisfaction.
    • Lack of insight into who our satisfied and dissatisfied customers are.
    • Lack of a system for early detection of declines in satisfaction.
    • Lack of clarity of what needs to be improved and how resources should be allocated.
    • Lack of reliable internal data for effective customer satisfaction monitoring.

    What separates customer success leaders from developing a full view of their customers are several nagging obstacles:

    • Use of metrics that don’t provide the insight needed to make impactful changes that will boost satisfaction and ultimately, retention and profit.
    • Friction from customers participating in customer satisfaction studies.
    • Lack of data, or integrated databases from which to track, pull, and analyze customer satisfaction data.
    • Lack a clear definition of what satisfaction means to customers, metric definitions, and/or standard methods of measurement and a consistent monitoring cadence.
    • Lack of time, resources, or technology to uncover and effectively measure and monitor satisfaction drivers.

    Through the SoftwareReviews’ approach, customer success leaders will:

    • Understand who your satisfied and dissatisfied customers are.
    • Understand the true drivers of satisfaction and dissatisfaction among your customer segments.
    • Establish a repeatable process and cadence for effective satisfaction measurement and monitoring.
    • Develop an executable customer satisfaction improvement plan that identifies customer journey pain points and areas of dissatisfaction, and outlines how to improve them.
    • Know where money, time, and resources are needed most to improve satisfaction levels and ultimately retention.

    Overarching SoftwareReviews Advisory Insight:

    All companies measure satisfaction in some way, but many lack understanding of what’s truly driving customers to stay or leave. By understanding the true drivers of satisfaction, solution providers can measure and monitor satisfaction more effectively, pull actionable insights and feedback, and make changes to products and services that customers really care about. This will keep them coming back to you to have their needs met.

    Healthy Customer Relationships are vital for long-term success and growth

    Measuring customer satisfaction is critical to understanding the overall health of your customer relationships and driving growth.

    Through effective customer satisfaction measurement, organizations can:

    Improve Customer Experience

    Increase Retention and CLV

    Increase Profitability

    Reduce Costs

    • Provide insight into where and how to improve.
    • Enhance experience, increase loyalty.
    • By providing strong CX, organizations can increase revenue by 10-15% (McKinsey, 2014).
    • Far easier to retain existing customers than to acquire new ones.
    • Ensuring high satisfaction among customers increases Customer Lifetime Value (CLV) through longer tenure and higher spending.
    • NPS Promoter score has a customer lifetime value that's 600%-1,400% higher than a Detractor (Bain & Company, 2015).
    • Highly satisfied customers spend more through expansions and add-ons, as well as through their long tenure with your company.
    • They also spread positive word of mouth, which brings in new customers.
    • “Studies demonstrate a strong correlation between customer satisfaction and increased profits — with companies with high customer satisfaction reporting 5.7 times more revenue than competitors.” (Matthew Loper, CEO and Co-Founder of WELLTH, 2022)
    • Measuring, monitoring, and maintaining high satisfaction levels reduces costs across the board.
    • “Providing a high-quality customer experience can save up to 33% of customer service costs” (Deloitte, 2018).
    • Satisfied customers are more likely to spread positive word of mouth which reduces acquisition / marketing costs for your company.

    “Measuring customer satisfaction is vital for growth in any organization; it provides insights into what works and offers opportunities for optimization. Customer satisfaction is essential for improving loyalty rate, reducing costs and retaining your customers.”

    -Ken Brisco, NICE, 2019

    Poor customer satisfaction measurement is costly

    Virtually all companies measure customer satisfaction, but few truly do it well. All too often, customer satisfaction measurement consists of a set of vanity metrics that do not result in actionable insight for product/service improvement. Improper measurement can result in numerous consequences:

    Direct and Indirect Costs

    Being unaware of true drivers of satisfaction that are never remedied costs your business directly through customer churn, service costs, etc.

    Tarnished Brand

    Tarnished brand through not resolving issues drives dissatisfaction; dissatisfied customers share their negative experiences, which can damage brand image and reputation.

    Waste Limited Resources

    Putting limited resources towards vanity programs and/or fixes that have little to no bearing on core satisfaction drivers wastes time and money.

    “When customer dissatisfaction goes unnoticed, it can slowly kill a company. Because of the intangible nature of customer dissatisfaction, managers regularly underestimate the magnitude of customer dissatisfaction and its impact on the bottom line.”

    - Lakshmiu Tatikonda, “The Hidden Costs of Customer Dissatisfaction”, 2013

    SoftwareReviews Advisory Insight:

    Most companies struggle to understand what’s truly driving customers to stay or leave. By understanding the true satisfaction drivers, tech providers can measure and monitor satisfaction more effectively, avoiding the numerous harmful consequences that result from average customer satisfaction measurement.

    Does your customer satisfaction measurement process need improvement?

    Getting an accurate picture of customer satisfaction is no easy task. Struggling with any of the following means you are ready for a detailed review of your customer satisfaction measurement efforts:

    • Not knowing who your most satisfied customers are.
    • Lacking early detection for declining satisfaction – either reactive, or unaware of dissatisfaction as it’s occurring.
    • Lacking a process for monitoring changes in satisfaction and lack ability to be proactive; you feel blindsided when customers leave.
    • Inability to fix the problem and wasting money on the wrong areas, like vanity metrics that don’t bring value to customers.
    • Spending money and other resources towards fixes based on a gut feeling, without quantifying the real root cause drivers and investing in their improvement.
    • Having metrics and data but lacking context; don’t know what contributed to the metrics/results, why people are dissatisfied or what contributes to satisfaction.
    • Lacking clear definition of what satisfaction means to customers / customer segments.
    • Difficulty tying satisfaction back to financial results.

    Customers are more satisfied with software vendors who understand the difference between surface level and short-term satisfaction, and deep or long-term satisfaction

    Surface-level satisfaction

    Surface-level satisfaction has immediate effects, but they are usually short-term or limited to certain groups of users. There are several factors that contribute to satisfaction including:

    • Novelty of new software
    • Ease of implementation
    • Financial savings
    • Breadth of features

    Software Leaders Drive Deep Satisfaction

    Deep satisfaction has long-term and meaningful impacts on the way that organizations work. Deep satisfaction has staying power and increases or maintains satisfaction over time, by reducing complexity and delivering exceptional quality for end-users and IT alike. This report found that the following capabilities provided the deepest levels of satisfaction:

    • Usability and intuitiveness
    • Quality of features
    • Ease of customization
    • Vendor-specific capabilities

    The above solve issues that are part of everyday problems, and each drives satisfaction in deep and meaningful ways. While surface-level satisfaction is important, deep and impactful capabilities can sustain satisfaction for a longer time.

    Deep Customer Satisfaction Among Software Buyers Correlates Highly to “Emotional Attributes”

    Vendor Capabilities and Product Features remain significant but are not the primary drivers

    The image contains a graph to demonstrate a correlation to Satisfaction, all Software Categories.
    Source: SoftwareReviews buyer reviews (based on 82,560 unique reviews).

    Driving deep satisfaction among software customers vs. surface-level measures is key

    Vendor capabilities and product features correlate significantly to buyer satisfaction

    Yet, it’s the emotional attributes – what we call the “Emotional Footprint”, that correlate more strongly

    Business-Value Created and Emotional Attributes are what drives software customer satisfaction the most

    The image contains a screenshot of a graph to demonstrate Software Buyer Satisfaction Drivers and Emotional Attributes are what drives software customer satisfaction.

    Software companies looking to improve customer satisfaction will focus on business value created and the Emotional Footprint attributes outlined here.

    The essential ingredient is understanding how each is defined by your customers.

    Leaders focus on driving improvements as described by customers.

    SoftwareReviews Insight:

    These true drivers of satisfaction should be considered in your customer satisfaction measurement and monitoring efforts. The experience customers have with your product and brand is what will differentiate your brand from competitors, and ultimately, power business growth. Talk to a SoftwareReviews Advisor to learn how users rate your product on these satisfaction drivers in the SoftwareReviews Emotional Footprint Report.

    Benefits of Effective Customer Satisfaction Measurement

    Our research provides Customer Success leaders with the following key benefits:

    • Ability to know who is satisfied, dissatisfied, and why.
    • Confidence in how to understand or uncover the factors behind customer satisfaction; understand and identify factors driving satisfaction, dissatisfaction.
    • Ability to develop a clear plan for improving customer satisfaction.
    • Knowledge of how to establish a repeatable process for customer satisfaction measurement and monitoring that allows for proactivity when declines in satisfaction are detected.
    • Understanding of what metrics to use, how to measure them, and where to find the right information/data.
    • Knowledge of where money, time, and other resources are needed most to drive tangible customer value.

    “81% of organizations cite CX as a competitive differentiator. The top factor driving digital transformation is improving CX […] with companies reporting benefits associated with improving CX including:

    • Increased customer loyalty (92%)
    • An uplift in revenue (84%)
    • Cost savings (79%).”

    – Dan Cote, “Advocacy Blooms and Business Booms When Customers and Employees Engage”, Influitive, 2021

    The image contains a screenshot of a thought model that focuses on Measure & Manage the Customer Satisfaction Metrics That Matter the Most.

    Who benefits from improving the measurement and monitoring of customer satisfaction?

    This Research Is Designed for:

    • Customer Success leaders and marketers who are:
      • Responsible for understanding how to benchmark, measure, and understand customer satisfaction to improve satisfaction, NPS, and ROI.
      • Looking to take a more proactive and structured approach to customer satisfaction measurement and monitoring.
      • Looking for a more effective and accurate way to measure and understand how to improve customer satisfaction around products and services.

    This Research Will Help You:

    • Understand the factors driving satisfaction and dissatisfaction.
    • Know which customers are satisfied/dissatisfied.
    • Know where time, money, and resources are needed the most in order to improve or maintain satisfaction levels.
    • Develop a formal plan to improve customer satisfaction.
    • Establish a repeatable process for customer satisfaction measurement and monitoring that allows for proactivity when declines in satisfaction are detected.

    This Research Will Also Assist:

    • Customer Success Leaders, Marketing and Sales Directors and Managers, Product Marketing Managers, and Advocacy Managers/Coordinators who are responsible for:
      • Product improvements and enhancements
      • Customer service and onboarding
      • Customer advocacy programs
      • Referral/VoC programs

    This Research Will Help Them:

    • Coordinate and align on customer experience efforts and actions.
    • Gather and make use of customer feedback to improve products, solutions, and services provided.
    • Provide an amazing customer experience throughout the entirety of the customer journey.

    SoftwareReviews’ methodology for measuring the customer satisfaction metrics that matter the most

    1. Identify true customer satisfaction drivers

    2. Develop metrics dashboard

    3. Develop customer satisfaction measurement and management plan

    Phase Steps

    1. Identify data sources, documenting any gaps in data
    2. Analyze all relevant data on customer experiences and outcomes
    3. Document top satisfaction drivers
    1. Identify business goals, problems to be solved / define business challenges and marketing/customer success goals
    2. Use SR diagnostic to assess current state of satisfaction measurement, assessing metric alignment to satisfaction drivers
    3. Define your metrics dashboard
    4. Develop common metric definitions, language for discussing, and standards for measuring customer satisfaction
    1. Determine committee structure to measure performance metrics over time
    2. Map out gaps in satisfaction along customer journey/common points in journey where customers are least dissatisfied
    3. Build plan that identifies weak areas and shows how to fix using SR’s emotional footprint, other measures
    4. Create plan and roadmap for CSat improvement
    5. Create communication deck

    Phase Outcomes

    1. Documented satisfaction drivers
    2. Documented data sources and gaps in data
    1. Current state customer satisfaction measurement analysis
    2. Common metric definitions and measurement standards
    3. Metrics dashboard
    1. Customer satisfaction measurement plan
    2. Customer satisfaction improvement plan
    3. Customer journey maps
    4. Customer satisfaction improvement communication deck
    5. Customer Satisfaction Committee created

    Insight summary

    Understanding and measuring the true drivers of satisfaction enable the delivery of real customer value

    All software companies measure satisfaction in some way, but many lack understanding of what’s truly driving customers to stay or leave. By understanding the true drivers of satisfaction, solution providers can measure and monitor satisfaction more effectively, pull actionable insights and feedback, and make changes to products and services that customers really care about and which will keep them coming back to you to have their needs met.

    Positive experiences drive satisfaction more so than features and cost

    According to our analysis of software buyer reviews data*, the biggest drivers of satisfaction and likeliness to recommend are the positive experiences customers have with vendors and their products. Customers want to feel that:

    1. Their productivity and performance is enhanced, and the vendor is helping them innovate and grow as a company.
    2. Their vendor inspires them and helps them to continually improve.
    3. They can rely on the vendor and the product they purchased.
    4. They are respected by the vendor.
    5. They can trust that the vendor will be on their side and save them time.
    *8 million data points across all software categories

    Measure Key Relationship KPIs to gauge satisfaction

    Key metrics to track include the Business Value Created score, Net Emotional Footprint, and the Love/Hate score (the strength of emotional connection).

    Orient the organization around customer experience excellence

    1. Arrange staff incentives around customer value instead of metrics that are unrelated to satisfaction.
    2. Embed customer experience as a core company value and integrate it into all functions.
    3. Make working with your organization easy and seamless for customers.

    Have a designated committee for customer satisfaction measurement

    Best in class organizations create customer satisfaction committees that meet regularly to measure and monitor customer satisfaction, resolve issues quickly, and work towards improved customer experience and profit outcomes.

    Use metrics that align to top satisfaction drivers

    This will give you a more accurate and fulsome view of customer satisfaction than standard satisfaction metrics alone will.

    Guided Implementation

    What is our GI on measuring and managing the customer satisfaction metrics that matter most?

    Identify True Customer Satisfaction Drivers

    Develop Metrics Dashboard Develop Customer Satisfaction Measurement and Management Plan

    Call #1: Discuss current pain points and barriers to successful customer satisfaction measurement, monitoring and maintenance. Plan next call – 1 week.

    Call #2: Discuss all available data, noting any gaps. Develop plan to fill gaps, discuss feasibility and timelines. Plan next call – 1 week.

    Call #3: Walk through SoftwareReviews reports to understand EF and satisfaction drivers. Plan next call – 3 days.

    Call #4: Segment customers and document key satisfaction drivers. Plan next call – 2 week.

    Call #5: Document business goals and align them to metrics. Plan next call – 1 week.

    Call #6: Complete the SoftwareReviews satisfaction measurement diagnostic. Plan next call – 3 days.

    Call #7: Score list of metrics that align to satisfaction drivers. Plan next call – 2 days.

    Call #8: Develop metrics dashboard and definitions. Plan next call – 2 weeks.

    Call #9: Finalize metrics dashboard and definitions. Plan next call – 1 week.

    Call #10: Discuss committee and determine governance. Plan next call – 2 weeks.

    Call #11: Map out gaps in satisfaction along customer journey as they relate to top satisfaction drivers. Plan next call –2 weeks.

    Call #12: Develop plan and roadmap for satisfaction improvement. Plan next call – 1 week.

    Call #13: Finalize plan and roadmap. Plan next call – 1 week.

    Call # 14: Review and coach on communication deck.

    A Guided Implementation (GI) is series of calls with a SoftwareReviews Advisory analyst to help implement our best practices in your organization.

    For guidance on marketing applications, we can arrange a discussion with an Info-Tech analyst.

    Your engagement managers will work with you to schedule analyst calls.

    Software Reviews offers various levels of support to best suit your needs

    DIY Toolkit

    Guided Implementation

    Workshop

    Consulting

    “Our team has already made this critical project a priority, and we have the time and capability, but some guidance along the way would be helpful.” “Our team knows that we need to fix a process, but we need assistance to determine where to focus. Some check-ins along the way would help keep us on track.” “We need to hit the ground running and get this project kicked off immediately. Our team has the ability to take this over once we get a framework and strategy in place.” “Our team does not have the time or the knowledge to take this project on. We need assistance through the entirety of this project.”
    Included within Advisory Membership Optional add-ons

    Bibliography

    “Are you experienced?” Bain & Company, Apr. 2015. Accessed 6 June. 2022.

    Brisco, Ken. “Measuring Customer Satisfaction and Why It’s So Important.” NICE, Feb. 2019. Accessed 6 June. 2022.

    CMO.com Team. “The Customer Experience Management Mandate.” Adobe Experience Cloud Blog, July 2019. Accessed 14 June. 2022.

    Cote, Dan. “Advocacy Blooms and Business Booms When Customers and Employees Engage.” Influitive, Dec. 2021. Accessed 15 June. 2022.

    Fanderl, Harald and Perrey, Jesko. “Best of both worlds: Customer experience for more revenues and lower costs.” McKinsey & Company, Apr. 2014. Accessed 15 June. 2022.

    Gallemard, Jeremy. “Why – And How – Should Customer Satisfaction Be Measured?” Smart Tribune, Feb. 2020. Accessed 6 June. 2022.

    Kumar, Swagata. “Customer Success Statistics in 2021.” Customer Success Box, 2021. Accessed 17 June. 2022.

    Lakshmiu Tatikonda, “The Hidden Costs of Customer Dissatisfaction”, Management Accounting Quarterly, vol. 14, no. 3, 2013, pp 38. Accessed 17 June. 2022.

    Loper, Matthew. “Why ‘Customer Satisfaction’ Misses the Mark – And What to Measure Instead.” Newsweek, Jan. 2022. Accessed 16 June. 2022.

    Maechler, Nicolas, et al. “Improving the business-to-business customer experience.” McKinsey & Company, Mar. 2016. Accessed 16 June.

    “New Research from Dimension Data Reveals Uncomfortable CX Truths.” CISION PR Newswire, Apr. 2017. Accessed 7 June. 2022.

    Sheth, Rohan. 75 Must-Know Customer Experience Statistics to move Your Business Forward in 2022.” SmartKarrot, Feb. 2022. Accessed 17 June. 2022.

    Smith, Mercer. “111 Customer Service Statistics and Facts You Shouldn’t Ignore.” HelpScout, May 2022. Accessed 17 June. 2022.

    “State of the Connected Customer.” Salesforce, 2020. Accessed 14 June. 2022

    “The true value of customer experiences.” Deloitte, 2018. Accessed 15 June. 2022.

    Skills Development on the Mainframe Platform

    • Buy Link or Shortcode: {j2store}336|cart{/j2store}
    • member rating overall impact: N/A
    • member rating average dollars saved: N/A
    • member rating average days saved: N/A
    • Parent Category Name: Strategy and Organizational Design
    • Parent Category Link: /strategy-and-organizational-design

    Mainframes remain a critical part of an organization’s infrastructure and will need to support these platforms for the foreseeable future. Despite the importance, it can be a challenge for organizations to find qualified resources to support them. Meanwhile, companies are unsure of where to find help to train and develop their teams on mainframe technologies and are at risk of a skills gap within their teams.

    Our Advice

    Critical Insight

    • Mainframes continue to have wide usage, particularly in enterprise organizations. The complexity of moving or replatforming many of these applications means these platforms will be around for a long time still.
    • Companies need to be proactive about developing their teams to support their mainframe systems.

    Impact and Result

    • Companies can protect their assets by cultivating a pipeline of qualified resources to support their mainframe infrastructure.
    • There is a robust training ecosystem headed by large, reputable organizations to help develop and support companies' resources. You don’t have to do it alone.

    Skills Development on the Mainframe Platform Research & Tools

    Besides the small introduction, subscribers and consulting clients within this management domain have access to:

    1. Skills Development on the Mainframe Platform Storyboard – An overview of the solutions available to support your mainframe training and skills development needs.

    Your mainframes are not going to disappear overnight. These systems often support the most critical operations in your organization. You need to ensure you have the right qualified resources to support your platforms.

    • Skills Development on the Mainframe Platform Storyboard
    [infographic]

    Build a Better Manager

    • Buy Link or Shortcode: {j2store}603|cart{/j2store}
    • member rating overall impact: N/A
    • member rating average dollars saved: N/A
    • member rating average days saved: N/A
    • Parent Category Name: Train & Develop
    • Parent Category Link: /train-and-develop
    • Management skills training is needed, but organizations are struggling to provide training that makes a long-term difference in the skills managers actually use in their day to day.
    • Many training programs are ineffective because they offer the wrong content, deliver it in a way that is not memorable, and are not aligned with the IT department’s business objectives.

    Our Advice

    Critical Insight

    • More of the typical manager training is not enough to solve the problem of underprepared first-time IT managers.
    • You must overcome the key pitfalls of ineffective training to deliver training that is better than the norm.
    • Offer tailored training that focuses on skill building and is aligned with measurable business goals to make your manager training a tangible success.

    Impact and Result

    Use Info-Tech’s tactical, practical training materials to deliver training that is:

    • Specifically tailored to first-time IT managers.
    • Designed around practical application of new skills.
    • Aligned with your department’s business goals.

    Build a Better Manager Research & Tools

    Besides the small introduction, subscribers and consulting clients within this management domain have access to:

    1. Build a Better Manager Capstone Deck – This deck will guide you through identifying the critical skills your managers need to succeed and planning out a training program tailored to your team and organization.

    This deck presents a behind-the-scenes explanation for the training materials, enabling a facilitator to deliver the training.

    • Build a Better Manager – Phases 1-3

    2. Facilitation Guides – These ready-to-deliver presentation decks span 8 modules. Each module covers a key management skill. The modules can be delivered independently or as a series.

    The modules are complete with presentation slides, speaker’s notes, and accompanying participant workbooks and provide everything you need to deliver the training to your team.

    • Accountability Facilitation Guide
    • Coaching and Feedback Facilitation Guide
    • Communicate Effectively Facilitation Guide
    • Manage Conflict Constructively Facilitation Guide
    • Your Role in Decision Making Facilitation Guide
    • Master Time Facilitation Guide
    • Performance Management Facilitation Guide
    • Your Role in the Organization Facilitation Guide

    3. Participant Workbooks and Supporting Materials – Each training module comes with a corresponding participant workbook to help trainees record insights and formulate individual skill development plans.

    Each workbook is tailored to the presentation slides in its corresponding facilitation guide. Some workbooks have additional materials, such as role play scenarios, to aid in practice. Every workbook comes with example entries to help participants make the most of their training.

    • Communicate Effectively Participant Workbook
    • Performance Management Participant Workbook
    • Coaching and Feedback Participant Workbook
    • Effective Feedback Training Role Play Scenarios
    • Your Role in the Organization Participant Workbook
    • Your Role in Decision Making Participant Workbook
    • Decision Making Case Study
    • Manage Conflict Constructively Participant Workbook
    • Conflict Resolution Role Play Scenarios
    • Master Time Participant Workbook
    • Accountability Participant Workbook
    [infographic]

    Workshop: Build a Better Manager

    Workshops offer an easy way to accelerate your project. If you are unable to do the project yourself, and a Guided Implementation isn't enough, we offer low-cost delivery of our project workshops. We take you through every phase of your project and ensure that you have a roadmap in place to complete your project successfully.

    1 Build a Better Manager

    The Purpose

    Attend training on the specific topics necessary for each individual management team.

    Each workshop consists of four days, one 3-hour training session per day. One module is delivered per day, selecting from the following pool of topics:

    Master Time

    Accountability

    Your Role in the Organization

    Your Role in Decision Making

    Manage Conflict Constructively

    Effective Communication

    Performance Management

    Coaching & Feedback

    Key Benefits Achieved

    Managers learn about best practices, practice their application, and formulate individual skill development plans.

    Activities

    1.1 Training on one topic per day, for four days (selected from a pool of eight possible topics)

    Outputs

    Completed workbook and action plan

    Further reading

    Build a Better Manager

    Support IT success with a solid management foundation.

    Analyst Perspective

    Training that delivers results.

    Jane Koupstova.

    Ninety-eight percent of managers say they need more training, but 93% of managers already receive some level of manager training. Unfortunately, the training typically provided, although copious, is not working. More of the same will never get you better outcomes.

    How many times have you sat through training that was so long, you had no hope of implementing half of it?

    How many times have you been taught best practices, with zero guidance on how to apply them?

    To truly support our managers, we need to rethink manager training. Move from fulfilling an HR mandate to providing truly trainee-centric instruction. Teach only the right skills – no fluff – and encourage and enable their application in the day to day.

    Jane Kouptsova
    Research Director, People & Leadership
    Info-Tech Research Group

    Executive Summary

    Your Challenge

    Common Obstacles

    Info-Tech’s Approach

    IT departments often promote staff based on technical skill, resulting in new managers feeling unprepared for their new responsibilities in leading people.

    The success of your organization hinges on managers’ ability to lead their staff; by failing to equip new managers adequately, you are risking the productivity of your entire department.

    Despite the fact that $14 billion is spent annually on leadership training in the US alone (Freedman, 2016), only one in ten CIOs believe their department is very effective at leadership, culture, and values (Info-Tech, 2019).

    Training programs do not deliver results due to trainee overwhelm, ineffective skill development, and a lack of business alignment.

    Use Info-Tech’s tactical, practical approach to management training to deliver training that:

    • Is specifically tailored to first-time IT managers.
    • Is designed around practical application of new skills.
    • Is aligned with your department’s business goals.
    • Equips your new managers with essential skills and foundational competencies

    Info-Tech Insight

    When it comes to manager training, more is not more. Attending training is not equal to being trained. Even good information is useless when it doesn’t get applied. If your role hasn’t required you to use your training within 48 hours, you were not trained on the most relevant skills.

    Effective managers drive effective departments by engaging their teams

    The image contains a screenshot to demonstrate effective managers.

    Engaged teams are:

    • 52% more willing to innovate*
    • 70% more likely to be at the organization a year from now**
    • 57% more likely to exceed their role’s expectations**

    Engaged teams are driven by managers:

    • 70% of team-level engagement is accounted for by managers***
    *McLean & Company; N=3,395; **McLean & Company; N=5,902; ***Gallup, 2018

    Despite the criticality of their role, IT organizations are failing at supporting new managers

    87% of middle managers wish they had more training when they were first promoted

    98% of managers say they need more training

    Source: Grovo, 2016

    IT must take notice:

    IT as an industry tends to promote staff on the basis of technical skill. As a result, new managers find themselves suddenly out of their comfort zone, tasked with leading teams using management skills they have not been trained in and, more often than not, having to learn on the job. This is further complicated because many new IT managers must go from a position of team member to leader, which can be a very complex transition.

    The truth is, many organizations do try and provide some degree of manager training, it just is not effective

    99% of companies offer management training*

    93% of managers attend it*

    $14 billion spent annually in the US on leadership training**

    Fewer than one in ten CIOs believe their IT department is highly effective at leadership, culture, and values.

    The image contains a screenshot of a pie chart that demonstrates the effectiveness of the IT department at leadership, culture, and values.

    *Grovo, 2016; **Chief Executive, 2016
    Info-Tech’s Management & Governance Diagnostic, N=337 CIOs

    There are three key reasons why manager training fails

    1. Information Overload

    Seventy-five percent of managers report that their training was too long to remember or to apply in their day to day (Grovo, 2016). Trying to cover too much useful information results in overwhelm and does not deliver on key training objectives.

    2. Limited Implementation

    Thirty-three percent of managers find that their training had insufficient follow-up to help them apply it on the job (Grovo, 2016). Learning is only the beginning. The real results are obtained when learning is followed by practice, which turns new knowledge into reliable habits.

    3. Lack of departmental alignment

    Implementing training without a clear link to departmental and organizational objectives leaves you unable to clearly communicate its value, undermines your ability to secure buy-in from attendees and executives, and leaves you unable to verify that the training is actually improving departmental effectiveness.

    Overcome those common training pitfalls with tactical solutions

    MOVE FROM

    TO

    1. Information Overload

    Timely, tailored topics

    The more training managers attend, the less likely they are to apply any particular element of it. Combat trainee overwhelm by offering highly tactical, practical training that presents only the essential skills needed at the managers’ current stage of development.

    2. Limited Implementation

    Skills-focused framework

    Many training programs end when the last manager walks out of the last training session. Ensure managers apply their new knowledge in the months and years after the training by relying on a research-based framework that supports long-term skill building.

    3. Lack of Departmental Alignment

    Outcome-based measurement

    Setting organizational goals and accompanying metrics ahead of time enables you to communicate the value of the training to attendees and stakeholders, track whether the training is delivering a return on your investment, and course correct if necessary.

    This research combats common training challenges by focusing on building habits, not just learning ideas

    Manager training is only useful if the skills it builds are implemented in the day-to-day.

    Research supports three drivers of successful skill building from training:

    Habits

    Organizational Support

    The training modules include committing to implementing new skills on the job and scheduling opportunities for feedback.

    Learning Structure

    Training activities are customizable, flexible, and accompanied by continuous learning self-evaluation.

    Personal Commitment

    Info-Tech’s methodology builds in activities that foster accountability and an attitude of continuous improvement.

    Learning

    Info-Tech Insight

    When it comes to manager training, stop thinking about learning, and start thinking about practice. In difficult situations, we fall back on habits, not theoretical knowledge. If a manager is only as good as their habits, we need to support them in translating knowledge into practice.

    This research focuses on building good management habits to drive enterprise success

    Set up your first-time managers for success by leveraging Info-Tech’s training to focus on three key areas of management:

    • Managing people as a team
    • Managing people as individuals
    • Managing yourself as a developing leader

    Each of these areas:

    • Is immediately important for a first-time manager
    • Includes practical, tactical skills that can be implemented quickly
    • Translates to departmental and organizational benefits

    Info-Tech Insight

    There is no such thing as “effective management training.” Various topics will be effective at different times for different roles. Delivering only the highest-impact learning at strategic points in your leadership development program will ensure the learning is retained and translates to results.

    This blueprint covers foundational training in three key domains of effective management

    Effective Managers

    • Self
      • Conflict & Difficult Conversations
      • Your Role in the Organization
      • Your Role in Decisions
    • Team
      • Communication
      • Feedback & Coaching
      • Performance Management
    • People
      • Master Time
      • Delegate
      • Accountability

    Each topic corresponds to a module, which can be used individually or as a series in any order.

    Choose topics that resonate with your managers and relate directly to their day-to-day tasks. Training on topics that may be useful in the future, while interesting, is less likely to generate lasting skill development.

    Info-Tech Best Practice

    This blueprint is not a replacement for formal leadership or management certification. It is designed as a practical, tactical, and foundational introduction to key management capabilities.

    Info-Tech’s training tools guide participants through successful skill building

    Practical facilitation guides equip you with the information, activities, and speaker’s notes necessary to deliver focused, tactical training to your management team.

    The participant’s workbook guides trainees through applying the three drivers of skill building to solidify their training into habits.

    Measure the effectiveness of your manager training with outcomes-focused metrics

    Linking manager training with measurable outcomes allows you to verify that the program is achieving the intended benefits, course correct as needed, and secure buy-in from stakeholders and participants by articulating and documenting value.

    Use the metrics suggested below to monitor your training program’s effectiveness at three key stages:

    Program Metric

    Calculation

    Program enrolment and attendance

    Attendance at each session / Total number enrolled in session

    First-time manager (FTM) turnover rate

    Turnover rate: Number of FTM departures / Total number of FTMs

    FTM turnover cost

    Number of departing FTMs this year * Cost of replacing an employee

    Manager Effectiveness Metric

    Calculation

    Engagement scores of FTM's direct reports

    Use Info-Tech's Employee Engagement surveys to monitor scores

    Departures as a result of poor management

    Number of times "manager relationships" is selected as a reason for leaving on an exit survey / Total number of departures

    Cost of departures due to poor management

    Number of times "manager relationships" is selected as a reason for leaving on an exit survey * Cost associated with replacing an employee

    Organizational Outcome Metric

    Calculation

    On-target delivery

    % projects completed on-target = (Projects successfully completed on time and on budget / Total number of projects started) * 100

    Business stakeholder satisfaction with IT

    Use Info-Tech’s business satisfaction surveys to monitor scores

    High-performer turnover rate

    Number of permanent, high-performing employee departures / Average number of permanent, high-performing employees

    Info-Tech offers various levels of support to best suit your needs

    DIY Toolkit

    Guided Implementation

    Workshop

    Consulting

    “Our team has already made this critical project a priority, and we have the time and capability, but some guidance along the way would be helpful.” “Our team knows that we need to fix a process, but we need assistance to determine where to focus. Some check-ins along the way would help keep us on track.” “We need to hit the ground running and get this project kicked off immediately. Our team has the ability to take this over once we get a framework and strategy in place.” “Our team does not have the time or the knowledge to take this project on. We need assistance through the entirety of this project.”

    Diagnostics and consistent frameworks used throughout all four options

    Guided Implementation

    What does a typical GI on this topic look like?

    Phase 1 Phase 2 Phase 3

    Call #1: Scope requirements, objectives, and your specific challenges.

    Call #2: Review selected modules and discuss training delivery.

    Call #3: Review training delivery, discuss lessons learned. Review long-term skill development plan.

    A Guided Implementation (GI) is a series

    of calls with an Info-Tech analyst to help implement our best practices in your organization.

    A typical GI is 1 to 3 calls over the course of several months, depending on training schedule.

    Workshop Overview

    Contact your account representative for more information.
    workshops@infotech.com 1-888-670-8889

    Day 1 Day 2 Day 3 Day 4

    3-Hour Training Session

    3-Hour Training Session

    3-Hour Training Session

    3-Hour Training Session

    Activities

    Training on topic 1 (selected from a pool of 8 possible topics)

    Training on topic 2 (selected from a pool of 8 possible topics)

    Training on topic 3 (selected from a pool of 8 possible topics)

    Training on topic 4 (selected from a pool of 8 possible topics)

    Deliverables

    Completed workbook and action plan

    Completed workbook and action plan

    Completed workbook and action plan

    Completed workbook and action plan

    Pool of topics:

    • Master Time
    • Accountability
    • Your Role in the Organization
    • Your Role in Decision Making
    • Manage Conflict Constructively
    • Effective Communication
    • Performance Management
    • Coaching & Feedback

    Phase 1

    Prepare to facilitate training

    Phase 1 Phase 2 Phase 3
    • Select training topics
    • Customize the training facilitation guide for your organization
    • Deliver training modules
    • Confirm skill development action plan with trainees
    • Secure organizational support from trainees' supervisors

    Outcomes of this phase:

    • Training facilitation deck customized to organizational norms
    • Training workbook distributed to participants
    • Training dates and facilitator finalized

    1.1 Select training modules

    1-3 hours

    1. Review the module descriptions on the following slides.
    2. Identify modules that will address managers’ most pressing development needs.
      To help make this decision, consult the following:
      • Trainees’ development plans
      • Trainees’ supervisors
    Input Output
    • Module descriptions
    • Trainees’ development goals and needs
    • Prioritized list of training modules
    Materials Participants
    • Prioritized list of training modules
    • Training sponsor
    • Trainees’ supervisors

    Effective Communication

    Effective communication is the cornerstone of good management

    Effective communication can make or break your IT team’s effectiveness and engagement and a manager’s reputation in the organization. Effective stakeholder management and communication has a myriad of benefits – yet this is a key area where IT leaders continue to struggle.

    There are multiple ways in which you communicate with your staff. The tactics you will learn in this section will help you to:

    1. Understand communication styles. Every staff member has a predisposition in terms of how they give, receive, and digest information. To drive effective communication new managers need to understand the profiles of each of their team members and adjust their communicate style to suit.
    2. Understand what your team members want communicated to them and how. Communication is highly personal, and a good manager needs to clearly understand what their team wants to be informed about, their desired interactions, and when they need to be involved in decision making. They also must determine the appropriate channels for communication exchanges.
    3. Make meetings matter. Many new managers never receive training on what differentiates a good and bad meeting. Effective meetings have a myriad of benefits, but more often than not meetings are ineffective, wasting both the participants’ and organizer’s time. This training will help you to ensure that every team meeting drives a solid outcome and gets results.

    Benefits:

    • Better buy-in, understanding, and communication.
    • Improved IT reputation with the organization.
    • Improved team engagement.
    • Improved stakeholder satisfaction.
    • Better-quality decision making.
    • Improved transparency, trust, and credibility.
    • Less waste and rework.
    • Greater ability to secure support and execute the agenda.
    • More effective cooperation on activities, better quality information, and greater value from stakeholder input.
    • Better understanding of IT performance and contribution.

    Effective Communication

    Effective manager communication has a direct impact on employee engagement

    35% Of organizations say they have lost an employee due to poor internal communication (project.co, 2021).

    59% Of business leaders lose work time to mistakes caused by poor communication (Grammarly, 2022).

    $1.2 trillion Lost to US organizations as a result of poor communication (Grammarly, 2022).

    Effective Communication

    Effective communication is crucial to all parts of the business

    Operations

    Human Resources

    Finance

    Marketing

    Increases production by boosting revenue.

    Reduces the cost of litigation and increases revenue through productivity improvements.

    Reduces the cost of failing to comply with regulations.

    Increases attraction and retention of key talent.

    Effective Communication

    The Communicate Effectively Facilitation Guide covers the following topics:

    • Understand Communication Styles
    • Tailor Communication Methods to Activities
    • Make Meetings Matter

    Learning outcomes:

    Main goal: Become a better communicator across a variety of personal styles and work contexts.

    Key objectives:

    • Reaffirm why effective communication matters.
    • Work with people with different communication styles.
    • Communicate clearly and effectively within a team.
    • Make meetings more effective.

    Info-Tech Insight

    First-time IT managers face specific communication challenges that come with managing people for the first time: learning to communicate a greater variety of information to different kinds of people, in a variety of venues. Tailored training in these areas helps managers focus and fast-track critical skill development.

    Performance Management

    Meaningful performance measures drive employee engagement, which in turn drives business success

    Meaningful performance measures help employees understand the rationale behind business decisions, help managers guide their staff, and clarify expectations for employees. These factors are all strong predictors of team engagement:

    The image contains a screenshot to demonstrate the relationship and success between performance measures and employee engagement.

    Performance Management

    Clear performance measures benefit employees and the organization

    Talent Management Outcomes

    Organizational Outcomes

    Performance measure are key throughout the talent management process.

    Candidates:

    • Want to know how they will be assessed
    • Rely on measures to become productive as soon as possible

    Employees:

    • Benefit from training centered on measures that are aligned with business outcomes
    • Are rewarded, recognized, and compensated based on measurable guidelines

    Promotions and Evaluations:

    • Are more effective when informed by meaningful performance measures that align with what leadership believes is important

    Performance measures benefit the organization by:

    • Helping employees know the steps to take to improve their performance
    • Ensuring alignment between team objectives and organizational goals
    • Providing a standardized way to support decision making related to compensation, promotions, and succession planning
    • Reducing “gaming” of metrics, when properly structured, thereby reducing risk to the organization
    • Affording legal defensibility by providing an objective basis for decision making

    Performance Management

    The Performance Management Facilitation Guide covers the following topics:

    • Develop Meaningful Goals
    • Set Meaningful Metrics

    Learning outcomes:

    Main goal: Become proficient in setting, tracking, and communicating around performance management goals.

    Key objectives:

    • Understand the role of managers and employees in the performance management process.
    • Learn to set SMART, business-aligned goals for your team.
    • Learn to help employees set useful individual goals.
    • Learn to set meaningful, holistic metrics to track goal progression.
    • Understand the relationship between goals, metrics, and feedback.

    Info-Tech Insight

    Goal and metric development holds special significance for first-time IT managers because it now impacts not only their personal performance, but that of their employees and their team collectively. Training on these topics with a practical team- and employee-development approach is a focused way to build these skills.

    Coaching & Feedback

    Coaching and feedback are effective methods to influence employees and drive business outcomes

    COACHING is a conversation in which a manager asks an employee questions to guide them to solve problems themselves, instead of just telling them the answer.

    Coaching increases employee happiness, and decreases turnover.1

    Coaching promotes innovation.2

    Coaching increases employee engagement, effort and performance.3

    FEEDBACK is information about the past, given in the present, with the goal of influencing behavior or performance for the future. It includes information given for reinforcement and redirection.

    Honest feedback enhances team psychological safety.4

    Feedback increases employee engagement.5

    Feedback boosts feelings of autonomy and drives innovation.6

    1. Administrative Sciences, 2022
    2. International Review of Management and Marketing, 2020
    3. Current Psychology, 2021
    4. Quantum Workplace, 2021
    5. Issues and Perspectives in Business and Social Sciences, 2022
    6. Sustainability, 2021

    Coaching & Feedback

    The Coaching & Feedback Facilitation Guide covers the following topics:

    • The 4 A’s of Coaching
    • Effective Feedback

    Learning outcomes:

    Main goal: Get prepared to coach and offer feedback to your staff as appropriate.

    Key objectives:

    • Understand the difference between coaching and feedback and when to apply each one.
    • Learn the importance of a coaching mindset.
    • Learn effective coaching via the 4 A’s framework.
    • Understand the actions that make up feedback and the factors that make it successful.
    • Learn to deal with resistance to feedback.

    Info-Tech Insight

    First-time managers often shy away from giving coaching and feedback, stalling their team’s performance. A focused and practical approach to building these skills equips new managers with the tools and confidence to tackle these challenges as soon as they arise.

    Your Role in the Organization

    IT managers who understand the business context provide more value to the organization

    Managers who don’t understand the business cannot effect positive change. The greater understanding that IT managers have of business context, the more value they provide to the organization as seen by the positive relationship between IT’s understanding of business needs and the business’ perception of IT value.

    The image contains a screenshot of a scatter plot grid demonstrating business satisfaction with IT Understanding of Needs across Overall IT Value.

    Source: Info-Tech Research Group

    Your Role in the Organization

    Knowing your stakeholders is key to understanding your role in the business and providing value to the organization

    To understand your role in the business, you need to know who your stakeholders are and what value you and your team provide to the organization. Knowing how you help each stakeholder meet their wants needs and goals means that you have the know-how to balance experience and outcome-based behaviors. This is the key to being an attentive leader.

    The tactics you will learn in this section will help you to:

    1. Know your stakeholders. There are five key stakeholders the majority of IT managers have: management, peers, direct reports, internal users, and external users or customers. Managers need to understand the goals, needs, and wants of each of these groups to successfully provide value to the organization.
    2. Understand the value you provide to each stakeholder. Stakeholder relationship management requires IT managers to exhibit drive and support behaviors based on the situation. By knowing how you drive and support each stakeholder, you understand how you provide value to the organization and support its mission, vision, and values.
    3. Communicate the value your team provides to the organization to your team. Employees need to understand the impact of their work. As an IT manager, you are responsible for communicating how your team provides value to the organization. Mission statements on how you provide value to each stakeholder is an easy way to clearly communicate purpose to your team.

    Benefits:

    • Faster and higher growth.
    • Improved team engagement.
    • Improved stakeholder satisfaction.
    • Better quality decision making.
    • More innovation and motivation to complete goals and tasks.
    • Greater ability to secure support and execute on goals and tasks.
    • More effective cooperation on activities, better quality information, and greater value from stakeholder input.
    • Better understanding of IT performance and contribution.

    Your Role in the Organization

    The Your Role in the Organization Facilitation Guide covers the following topics:

    • Know Your Stakeholders
    • Understand the Value You Provide to the Organization
    • Develop Learnings Into Habits

    Learning outcomes:

    Main goal: Understand how your role and the role of your team serves the business.

    Key objectives:

    • Learn who your stakeholders are.
    • Understand how you drive and support different stakeholder relationships.
    • Relate your team’s tasks back to the mission, vision, and values of the organization.
    • Create a mission statement for each stakeholder to bring back to your team.

    Info-Tech Insight

    Before training first-time IT managers, take some time as the facilitator to review how you will serve the wants and needs of those you are training and your stakeholders in the organization.

    Decision Making

    Bad decisions have tangible costs, so managers must be trained in how to make effective decisions

    To understand your role in the decision-making process, you need to know what is expected of you and you must understand what goes into making a good decision. The majority of managers report they have no trouble making decisions and that they are good decision makers, but the statistics say otherwise. This ease at decision making is due to being overly confident in their expertise and an inability to recognize their own ignorance.1

    The tactics you will learn in this section will help you to:

    1. Effectively communicate decisions. Often, first-time managers are either sharing their decision recommendations with their manager or they are communicating a decision down to their team. Managers need to understand how to have these conversations so their recommendations provide value to management and top-down decisions are successfully implemented.
    2. Provide valuable feedback on decisions. Evaluating decisions is just as critical as making decisions. If decisions aren’t reviewed, there is no data or feedback to discover why a decision was a success or failure. Having a plan in place before the decision is made facilitates the decision review process and makes it easier to provide valuable feedback.
    3. Avoid common decision-making mistakes. Heuristics and bias are common decision pitfalls even senior leaders are susceptible to. By learning what the common decision-making mistakes are and being able to recognize them when they appear in their decision-making process, first-time managers can improve their decision-making ability.

    20% Of respondents say their organizations excel at decision making (McKinsey, 2018).

    87% “Diverse teams are 87% better at making decisions” (Upskillist, 2022).

    86% of employees in leadership positions blame the lack of collaboration as the top reason for workplace failures (Upskillist, 2022).

    Decision Making

    A decision-making process is imperative, even though most managers don’t have a formal one

    1. Identify the Problem and Define Objectives
    2. Establish Decision Criteria
    3. Generate and Evaluate Alternatives
    4. Select an Alternative and Implement
    5. Evaluate the Decision

    Managers tend to rely on their own intuition which is often colored by heuristics and biases. By using a formal decision-making process, these pitfalls of intuition can be mitigated or avoided. This leads to better decisions.

    First-time managers are able to apply this framework when making decision recommendations to management to increase their likelihood of success, and having a process will improve their decisions throughout their career and the financial returns correlated with them.

    Decision Making

    Recognizing personal heuristics and bias in the decision-making process improves more than just decision results

    Employees are able to recognize bias in the workplace, even when management can’t. This affects everything from how involved they are in the decision-making process to their level of effort and productivity in implementing decisions. Without employee support, even good decisions are less likely to have positive results. Employees who perceive bias:

    Innovation

    • Hold back ideas and solutions
    • Intentionally fail to follow through on important projects and tasks

    Brand Reputation

    • Speak negatively about the company on social media
    • Do not refer open positions to qualified persons in their network

    Engagement

    • Feel alienated
    • Actively seek new employment
    • Say they are not proud to work for the company

    Decision Making

    The Decision Making Facilitation Guide covers the following topics:

    • Effectively Communicate Decisions
    • Provide Valuable Feedback on Decisions
    • Avoid Common Decision-Making Mistakes

    Learning outcomes:

    Main goal: Understand how to successfully perform your role in the decision process.

    Key objectives:

    • Understand the decision-making process and how to assess decisions.
    • Learn how to communicate with your manager regarding your decision recommendations.
    • Learn how to effectively communicate decisions to your team.
    • Understand how to avoid common decision-making errors.

    Info-Tech Insight

    Before training a decision-making framework, ensure it is in alignment with how decisions are made in your organization. Alternatively, make sure leadership is on board with making a change.

    Manage Conflict Constructively

    Enable leaders to resolve conflicts while minimizing costs

    If you are successful in your talent acquisition, you likely have a variety of personalities and diverse individuals within your IT organization and in the business, which means that conflict is inevitable. However, conflict does not have to be negative – it can take on many forms. The presence of conflict in an organization can actually be a very positive thing: the ability to freely express opinions and openly debate can lead to better, more strategic decisions being made.

    The effect that the conflict is having on individuals and the work environment will determine whether the conflict is positive or counterproductive.

    As a new manager you need to know how to manage potential negative outcomes of conflict by managing difficult conversations and understanding how to respond to conflict in the workplace.

    The tactics you will learn in this section will help you to:

    1. Apply strategies to prepare for and navigate through difficult conversations.
    2. Expand your comfort level when handling conflict, and engage in constructive conflict resolution approaches.

    Benefits:

    • Relieve stress for yourself and your co-workers.
    • Save yourself time and energy.
    • Positively impact relationships with your employees.
    • Improve your team dynamic.
    • Remove roadblocks to your work and get things done.
    • Save the organization money.
    • Improve performance.
    • Prevent negative issues from reoccurring.

    Manage Conflict Constructively

    Addressing difficult conversations is beneficial to you, your people, and the organization

    When you face a difficult conversation you…

    • Relieve stress on you and your co-workers.
    • Save yourself time and energy.
    • Positively impact relationships with your employees.
    • Improve your team dynamic.
    • Remove roadblocks to your work
    • Save the organization money.
    • Improve performance.
    • Prevent negative issues from reoccurring.

    40% Of employees who experience conflict report being less motivated as a result (Acas, 2021).

    30.6% Of employees report coming off as aggressive when trying to resolve a conflict
    (Niagara Institute, 2022).

    Manage Conflict Constructively

    The Manage Conflict Constructively Facilitation Guide covers the following topics:

    • Know Your Ideal Time Mix
    • Calendar Diligence
    • Effective Delegation
    • Limit Interruptions

    Learning outcomes:

    Main goal: Effectively manage your time and know which tasks are your priority and which tasks to delegate.

    Key objectives:

    • Understand common reasons for difficult conversations.
    • Learn Info-Tech’s six-step process to best to prepare for difficult conversations.
    • Follow best practices to approach difficult conversations.
    • Learn the five approaches to conflict management.
    • Practice conflict management skills.

    Info-Tech Insight

    Conflict does not have to be negative. The presence of conflict in an organization can actually be a very positive thing: the ability to freely express opinions and openly debate can lead to better, more strategic decisions being made.

    Master Time

    Effective leaders spend their time in specific ways

    How effective leaders average their time spent across the six key roles:

    Leaders with effective time management skills spend their time across six key manager roles: strategy, projects, management, operations, innovation, and personal. While there is no magic formula, providing more value to the business starts with little practices like:

    • Spending time with the right stakeholders and focusing on the right priorities.
    • Evaluating which meetings are important and productive.
    • Benchmarking yourself against your peers in the industry so you constantly learn from them and improve yourself.

    The keys to providing this value is time management and delegation. The tactics in this section will help first-time managers to:

    1. Discover your ideal time. By analyzing how you currently spend your time, you can see which roles you are under/over using and, using your job description and performance metrics, discover your ideal time mix.
    2. Practice calendar diligence. Time blocking is an effective way to use your time, see your week, and quickly understand what roles you are spending your time in. Scheduling priority tasks first gives insight into which tasks should be delegated.
    3. Effectively delegation. Clear expectations and knowing the strengths of your team are the cornerstone to effective delegation. By understanding the information you need to communicate and identifying the best person on your team to delegate to, tasks and goals will be successfully completed.
    4. Limit interruptions. By learning how to limit interruptions from your team and your manager, you are better able to control your time and make sure your tasks and goals get completed.

    Strategy

    23%

    Projects

    23%

    Management

    19%

    Operations

    19%

    Innovation

    13%

    Personal

    4%

    Source: Info-Tech, N=85

    Master Time

    Signs you struggle with time management

    Too many interruptions in a day to stay focused.

    Too busy to focus on strategic initiatives.

    Spending time on the wrong things.

    The image contains a screenshot of a bar graph that demonstrates struggle with time management.

    Master Time

    The Master Time Facilitation Guide covers the following topics:

    • Understand Communication Styles
    • Tailor Communication Methods to Activities
    • Make Meetings Matter

    Learning outcomes:

    Main goal: Become a better communicator across a variety of personal styles and work contexts.

    Key objectives:

    • Understand how you spend your time.
    • Learn how to use your calendar effectively.
    • Understand the actions to take to successfully delegate.
    • Learn how to successfully limit interruptions.

    Info-Tech Insight

    There is a right and wrong way to manage your calendar as a first-time manager and it has nothing to do with your personal preference.

    Accountability

    Accountability creates organizational and team benefits

    Improves culture and innovation

    Improves individual performance

    Increases employee engagement

    Increases profitability

    Increases trust and productivity

    Enables employees to see how they contribute

    Increases ownership employees feel over their work and outcomes

    Enables employees to focus on activities that drive the business forward

    Source: Forbes, 2019

    Accountability

    Accountability increases employee empowerment

    Employee empowerment is the number one driver of employee engagement. The extent to which you can hold employees accountable for their own actions and decisions is closely related to how empowered they are and how empowered they feel; accountability and empowerment go hand in hand. To feel empowered, employees must understand what is expected of them, have input into decisions that affect their work, and have the tools they need to demonstrate their talents.

    The image contains a screenshot to demonstrate how accountability increases employee empowerment.

    Source: McLean & Company Engagement Database, 2018; N=71,794

    Accountability

    The Accountability Facilitation Guide covers the following topics:

    • Create Clarity and Transparency
    • Articulate Expectations and Evaluation
    • Help Your Team Remove Roadblocks
    • Clearly Introduce Accountability to Your Team

    Learning outcomes:

    Main goal: Create a personal accountability plan and learn how to hold yourself and your team accountable.

    Key objectives:

    • Understand why accountability matters.
    • Learn how to create clarity and transparency.
    • Understand how to successfully hold people accountable through clearly articulating expectations and evaluation.
    • Know how to remove roadblocks to accountability for your team.

    Info-Tech Insight

    Accountability is about focusing on the results of a task, rather than just completing the task. Create team accountability by keeping the team focused on the result and not “doing their jobs.” First-time managers need to clearly communicate expectations and evaluation to successfully develop team accountability.

    Use the Build a Better Manager Participant Workbooks to help participants set accountabilities and track their progress

    A key feature of this blueprint is built-in guidance on transferring your managers’ new knowledge into practical skills and habits they can fall back on when their job requires it.

    The Participant Workbooks, one for each module, are structured around the three key principles of learning transfer to help participants optimally structure their own learning:

    • Track your learning. This section guides participants through conducting self-assessments, setting learning goals, recording key insights, and brainstorming relapse-prevention strategies
    • Establish your personal commitment. This section helps participants record the actions they personally commit to taking to continually practice their new skills
    • Secure organizational support. This section guides participants in recording the steps they will take to seek out support from their supervisor and peers.

    The image contains a screenshot of the Build a Better Manager Participant Workbooks.

    Info-Tech Insight

    Participants should use this workbook throughout their training and continue to review it for at least three months after. Practical skills take an extended amount of time to solidify, and using the workbook for several months will ensure that participants stay on track with regular practice and check-ins.

    Set your trainees up for success by reviewing these training best practices

    Cultural alignment

    It is critical that the department leadership team understand and agree with the best practices being presented. Senior team leads should be comfortable coaching first-time managers in implementing the skills developed through the training. If there is any question about alignment with departmental culture or if senior team leads would benefit from a refresher course, conduct a training session for them as well.

    Structured training

    Ensure the facilitator takes a structured approach to the training. It is important to complete all the activities and record the outputs in the workbook where appropriate. The activities are structured to ensure participants successfully use the knowledge gained during the workshop to build practical skills.

    Attendees

    Who should attend the training? Although this training is designed for first-time IT managers, you may find it helpful to run the training for the entire management team as a refresher and to get everyone on the same page about best practices. It is also helpful for senior leadership to be aware of the training because the attendees may come to their supervisors with requests to discuss the material or coaching around it.

    Info-Tech Insight

    Participants should use this workbook throughout their training and continue to review it for at least three months after. Practical skills take an extended amount of time to solidify, and using the workbook for several months will ensure that participants stay on track with regular practice and check-ins.

    1.2 Customize the facilitation guides

    1-3 hours

    Prior to facilitating your first session, ensure you complete the following steps:

    1. Read through all the module content, including the speaker’s notes, to familiarize yourself with the material and ensure the tactics presented align with your department’s culture and established best practices.
    2. Customize the slides with a pencil icon with information relevant to your organization.
    3. Ensure you are comfortable with all material to be presented and are prepared to answer questions. If you require clarification on any of the material, book a call with your Info-Tech analyst for guidance.
    4. Ensure you do not delete or heavily customize the self-assessment activities and the activities in the Review and Action Plan section of the module. These activities are structured around a skill building framework and designed to aid your trainees in applying their new knowledge in their day to day. If you have any concerns about activities in these sections, book a call with your Info-Tech analyst for guidance.
    Input Output
    • List of selected modules
    • Customized facilitation guides
    Materials Participants
    • Facilitation guides from selected modules
    • Training facilitator

    1.3 Prepare to deliver training

    1-3 hours

    Complete these steps in preparation for delivering the training to your first-time managers:

    1. Select a facilitator.
      • The right person to facilitate the meeting depends on the dynamics within your department. Having a senior IT leader can lend additional weight to the training best practices but may not be feasible in a large department. In these cases, an HR partner or external third party can be asked to facilitate.
    2. Distribute the workbooks to attendees before the first training session.
      • Change the header on the workbook templates to your own organization’s, if desired.
      • Email the workbooks to attendees prior to the first session. There is no pre-work to be completed.
    Input Output
    • List of selected modules
    • Facilitator selected
    • Workbook distributed
    Materials Participants
    • Workbooks from selected modules
    • Training sponsor
    • Training facilitator

    Phase 2

    Deliver training

    Phase 1 Phase 2 Phase 3
    • Select training topics
    • Customize the training facilitation guide for your organization
    • Deliver training modules
    • Confirm skill development action plan with trainees
    • Secure organizational support from trainees' supervisors

    Outcomes of this phase:

    • Training delivered
    • Development goals set by attendees
    • Action plan created by attendees

    2.1 Deliver training

    3 hours

    When you are ready, deliver the training. Ensure you complete all activities and that participants record the outcomes in their workbooks.

    Tips for activity facilitation:

    • Encourage and support participation from everyone. And be sure no one on the team dismisses anyone’s thoughts or opinions – they present the opportunity for further discussion and deeper insight.
    • Debrief after each activity, outlining any lessons learned, action items, and next steps.
    • Encourage participants to record all outcomes, key insights, and action plans in their workbooks.
    Input Output
    • Facilitation guides and workbooks for selected modules
    • Training delivered
    • Workbooks completed
    Materials Participants
    • Facilitation guides and workbooks for selected modules
    • Training facilitator
    • Trainees

    Phase 3

    Enable long-term skill development

    Phase 1Phase 2Phase 3
    • Select training topics
    • Customize the training facilitation guide for your organization
    • Deliver training modules
    • Confirm skill development action plan with trainees
    • Secure organizational support from trainees' supervisors

    Outcomes of this phase:

    • Attendees reminded of action plan and personal commitment
    • Supervisors reminded of the need to support trainees' development

    3.1 Email trainees with action steps

    0.5 hours

    After the training, send an email to attendees thanking them for participating and summarizing key next steps for the group. Use the template below, or write your own:

    “Hi team,

    I want to thank you personally for attending the Communicate Effectively training module. Our group led some great discussion.

    A reminder that the next time you will reconvene as a group will be on [Date] to discuss your progress and challenges to date.

    Additionally, your manager is aware and supportive of the training program, so be sure to follow through on the commitments you’ve made to secure the support you need from them to build your new skills.

    I am always open for questions if you run into any challenges.

    Regards,

    [Your name]”

    InputOutput
    • The date of participants’ next discussion meeting
    • Attendees reminded of next meeting date and encouraged to follow through on action plan
    MaterialsParticipants
    • Training facilitator

    3.2 Secure support from trainees’ supervisors

    0.5 hours

    An important part of the training is securing organizational support, which includes support from your trainees’ supervisors. After the trainees have committed to some action items to seek support from their supervisors, it is important to express your support for this and remind the supervisors of their role in guiding your first-time managers. Use the template below, or write your own, to remind your trainees’ supervisors of this at the end of training (if you are going through all three modules in a short period of time, you may want to wait until the end of the entire training to send this email):

    “Hi team,

    We have just completed Info-Tech’s first-time manager training with our new manager team. The trainees will be seeking your support in developing their new skills. This could be in the form of coaching, feedback on their progress, reviewing their development plan, etc.

    Supervisor support is a crucial component of skill building, so I hope I can count on all of you to support our new managers in their learning. If you are not sure how to handle these requests, or would like a refresher of the material our trainees covered, please let me know.

    I am always open for questions if you run into any challenges.

    Regards,

    [Your name]”

    InputOutput
    • List of trainees’ direct supervisors
    • Supervisors reminded to support trainees’ skill practice
    MaterialsParticipants
    • Training facilitator

    Contributors

    Brad Armstrong

    Brad Armstrong, Senior Engineering Manager, Code42 Software

    I am a pragmatic engineering leader with a deep technical background, now focused on building great teams. I'm energized by difficult, high-impact problems at scale and with the cloud technologies and emerging architectures that we can use to solve them. But it's the power of people and organizations that ultimately lead to our success, and the complex challenge of bringing all that together is the work I find most rewarding.

    We thank the expert contributors who chose to keep their contributions anonymous.

    Bibliography

    360Solutions, LLC. “The High Cost of Poor Communication: How to Improve Productivity and Empower Employees Through Effective Communication.” 360Solutions, 2009. Web.

    Ali, M., B. Raza, W. Ali, and N. Imtaiz. Linking Managerial Coaching with Employees’ Innovative Work Behaviors through Affective Supervisory Commitment: Evidence from Pakistan. International Review of Management and Marketing, vol. 10, no. 4, 2020, pp. 11-16.

    Allen, Frederick E. “The Terrible Management Technique That Cost Microsoft Its Creativity.” Forbes.com, 3 July 2012. Web.

    Allen, Renee. “Generational Differences Chart.” West Midland Family Center, n.d. Web.

    American Management Association. “Leading the Four Generations at Work.” American Management Association, Sept. 2014. Web.

    Aminov, Iskandar, Aaron De Smet, Gregor Jost, and David Mendelsohn. “Decision making in the age of urgency.” McKinsey & Company, 30 April 2019. Web.

    AON Hewitt. “Aon Hewitt Study Reveals Strong Link Between Employee Engagement and Employee Perceptions of Total Rewards. Honest Leader Communication Also Influences Engagement.” PR Newswire, 8 April 2015. Web.

    Armstrong, Brad. “How to Fail as a New Engineering Manager.” Noteworthy - The Journal Blog, 19 Feb. 2018. Web.

    Asmus, Mary Jo. “Coaching vs. Feedback.” Aspire-CS, 9 Dec. 2009. Web.

    Baldwin, Timothy T., et al. “The State of Transfer of Training Research: Moving Toward More Consumer-Centric Inquiry.” Human Resource Development Quarterly, vol. 28, no. 1, March 2017, pp. 17-28. Crossref, doi:10.1002/hrdq.21278.

    Batista, Ed. “Building a Feedback-Rich Culture from the Middle.” Ed Batista, April 2015. Web.

    Bilalic, Merim, Peter McLeod, and Fernand Gobet. Specialization Effect and Its Influence on Memory and Problem Solving in Expert Chess Players. Wiley Online Journal, 23 July 2009, doi: https://doi.org/10.1111/j.1551-6709.2009.01030.x

    Blume, Brian D., et al. “Transfer of Training: A Meta-Analytic Review.” Journal of Management, vol. 36, no. 4, July 2010, pp. 1065-105. Crossref, doi:10.1177/0149206309352880.

    BOH Training Guide. Wild Wing, Jan. 2017. Web.

    Bosler, Shana. “9 Strategies to Create Psychological Safety at Work.” Quantum Workplace, 3 June 2021. Web.

    Building Communication Skills. ACQUIRE Project/EngenderHealth, n.d. Web.

    Bucaro, Frank C. “The real issue in conflict is never about things…” Frank Bucaro blog, 7 March 2014. Web.

    Burke, Lisa A., and Holly M. Hutchins. “Training Transfer: An Integrative Literature Review.” Human Resource Development Review, vol. 6, no. 3, Sept. 2007, pp. 263-96. Crossref, doi:10.1177/1534484307303035.

    Caprino, Kathy. “Separating Performance Management from Compensation: New Trend for Thriving Organizations.” Forbes, 13 Dec. 2016. Web.

    Caprino, Kathy. “Why the Annual Review Process Damages Employee Engagement.” Forbes, 1 March 2016. Web.

    Carpineanu, Silvana. “7 Mistakes You Might Be Making When Writing A Meeting Agenda.” Time Doctor, 12 January 2021. Web.

    Cecchi-Dimeglio, Paola. “How Gender Bias Corrupts Performance Reviews, and What to Do About It.” Harvard Business Review, 12 April 2017. Web.

    Chartered Institute of Personnel and Development (CIPD). “PESTLE Analysis.” Chartered Institute of Personnel and Development, 2010. Web.

    Chiaburu, Dan S., et al. “Social Support in the Workplace and Training Transfer: A Longitudinal Analysis: Social Support and Training Transfer.” International Journal of Selection and Assessment, vol. 18, no. 2, June 2010, pp. 187-200. Crossref, doi:10.1111/j.1468-2389.2010.00500.x.

    Christensen, Ulrik Juul. “How to Teach Employees Skills They Don’t Know They Lack.” Harvard Business Review, 29 Sept. 2017. Web.

    CIPD. “Rapid evidence assessment of the research literature on the effect of goal setting on workplace performance.” Charted Institute of Personnel and Development, Dec. 2016. Web.

    CIPD. Annual Survey Report: Learning & Development 2015. Charted Institute of Personnel and Development, 2015. Web.

    Communication and Organizational Skills: NPHW Training Manual. Population Health Research Institute (PHRI), 17 Sept. 2015. Web.

    Cookson, Phil. “It’s time to see performance management as a benefit, not a burden.” CIPD. 17 March 2017. Web.

    Communication Statistics 2021. Project.co, 2021. Web.

    Connors, Roger. “Why Accountability?” The Oz Principle, Partners In Leadership, 2014.

    Coutifaris, Constantinos G. V., and Adam M. Grant “Taking Your Team Behind the Curtain: The Effects of Leader Feedback-Sharing and Feedback-Seeking on Team Psychological Safety.” Organization Science, vol. 33,
    no. 4, 2021, pp. 1574-1598. https://doi.org/10.1287/orsc.2021.1498

    Coy, Charles. “Peer Feedback: 6 Tips for Successful Crowdsourcing.” Rework, 25 June 2014. Web.

    “CQ Learn What Really Matters.” CQ Evidence-Based Management Learning Platform, n.d. Web.

    Darwant, Sarah. Coaching Training Course Book. Elite Training, 2012. Web.

    De Smet, Aaron, et al. How Companies Manage the Front Line Today: McKinsey Survey Results. McKinsey, Feb. 2010. Web.

    DeNault, Charles. “Employee Coaching Survey Results: Important and Engaging.” Saba, 22 April 2015. Web.

    Dermol, Valerij, and Tomaž Čater. “The Influence of Training and Training Transfer Factors on Organisational Learning and Performance.” Personnel Review, vol. 42, no. 3, April 2013, pp. 324–48. Crossref, doi:10.1108/00483481311320435.

    dgdotto. “Fail to Plan, Plan to Fail.” visual.ly, 30 April 2013. Web.

    Duggan, Kris. “Why the Annual Performance Review is Going Extinct.” Fast Company, 20 Oct. 2015. Web.

    Duhigg, Charles. “What Google Learned From Its Quest to Build the Perfect Team.” The New York Times, 25 Feb. 2016. Web.

    Earley, P. Christopher, and Randall S. Peterson. “The Elusive Cultural Chameleon: Cultural Intelligence as a New Approach to Intercultural Training for the Global Manager.” Academy of Management Learning & Education, vol. 3, no. 1, March 2004, pp. 100-15. Crossref, doi:10.5465/amle.2004.12436826.

    Edmondson, Amy. “Psychological Safety and Learning Behavior in Work Teams.” Administrative Science Quarterly, vol. 44, no. 2, June 1999, pp. 350-383. Web.

    “Effective Employee Communications Fosters Corporate Reputation.” The Harris Poll, 10 June 2015. Web.

    Eichenwald, Kurt. “How Microsoft Lost its Mojo: Steve Ballmer and Corporate American’s Most Spectacular Decline.” Vanity Fair, 24 July 2012. Web.

    Essential Supervisory Skills. University of Washington, 2016. Web.

    “Estimating the Costs of Workplace Conflict.” Acas, 11 May 2021. Web.

    Falcone, Paul. “Viewpoint: How to Redesign Your Performance Appraisal Template.” Society for Human Resource Management, 7 June 2017. Web.

    Fermin, Jeff. “Statistics On The Importance Of Employee Feedback.” Officevibe, 7 Oct. 2014. Web.

    Filipkowski, Jenna, et al. Building a Coaching Culture with Millennial Leaders. Human Capital Institute, 18 Sept. 2017. Web.

    First Time Manager Training to Help New Managers Develop Essential Skills. The Ken Blanchard Companies, n.d. Web.

    Fisher, Dan. Feedback vs. Coaching, What’s the Difference? Menemsha Group, 28 June 2018. Web.

    Freedman, Erica. “How to Build an Internal Leadership Development Program.” Chief Executive, 2016. Web.

    "Futureproof Your Organization with These 8 Manager Effectiveness Metrics.” Visier Inc., 8 Aug. 2017. Web.

    Gallo, Amy. “How to Manage Your Former Peers.” Harvard Business Review, Dec. 2012. Web.

    Gandhi, Vipula. “Want to Improve Productivity? Hire Better Managers.” Gallup, 3 Aug. 2018. Web.

    Gallup. State of the Global Workplace. 1st edition, Gallup Press, 2017. Web.

    Global Workplace Analytics. “Latest Telecommuting Statistics.” Global Workplace Analytics. Sept. 2013. Web.

    Goldsmith, Marshall. “Try Feedforward Instead of Feedback.” Leader to Leader Institute, 5 April 2011. Web.

    Goldsmith, Marshall. "11 Guidelines for Influencing Top Decision Makers." Marshall Goldsmith, n.d. Web.

    Goldsmith, Marshall. "I Know Less Than You Do – and It’s Okay!" Marshall Goldsmith, n.d. Web.

    Goldsmith, Marshall. "Is It Worth It to Add Value? Not Always." Marshall Goldsmith, n.d. Web.

    Goler, L., J. Gale, and A. Grant. “Let’s Not Kill Performance Evaluations Yet.” Harvard Business Review, Nov. 2016. Web.

    Good Manager, Bad Manager. Grovo, 2016. Web.

    Google People Operations. “Guide: Understand Team Effectiveness.” Google, n.d. Web.

    Google’s New Manager Student Workbook. re:Work with Google, n.d. Web.

    Google’s New Manager Training Facilitator Guide. re:Work with Google, n.d. Web.

    Gossen, Paul. A Coaching Culture Transformation ~ Case Study. Athena Training and Consulting, 1 April 2011. Web.

    Goudreau, Jenna. “How to Communicate in the New Multi-Generational Office.” Forbes Magazine, Feb. 2013. Web.

    Govaerts, Natalie, and Filip Dochy. “Disentangling the Role of the Supervisor in Transfer of Training.” Educational Research Review, vol. 12, June 2014, pp. 77-93. Crossref, doi:10.1016/j.edurev.2014.05.002.

    Grenchus, Gabrielle. “Keep employees engaged with clear priorities and crowdsourced recognition.” IBM thinkLeaders. 8 June 2015. Web.

    Grossman, Rebecca, and Eduardo Salas. “The Transfer of Training: What Really Matters: The Transfer of Training.” International Journal of Training and Development, vol. 15, no. 2, June 2011, pp. 103-20. Crossref, doi:10.1111/j.1468-2419.2011.00373.x.

    Grote, Dick. “3 Popular Goal-Setting Techniques Managers Should Avoid.” Harvard Business Review. 2 Jan. 2017. Web.

    Hall, John. “Why Accountability Is Vital To Your Company.” Forbes, 6 Oct. 2019. Web.

    Hancock, Bryan, et al. “The Fairness Factor in Performance Management.” McKinsey, 5 April 2018. Web.

    Harkins, Phil. “10 Leadership Techniques for Building High-Performing Teams.” Linkage Inc., 2014. Web.

    HCI. Building a Coaching Culture with Managers and Leaders. Human Capital Institute, 2016. Web.

    Heathfield, Susan M. “Tips to Create Successful Performance Appraisal Goals.” The Balance, Aug. 2016. Web.

    Hills, Jan. Brain-Savvy Business: 8 Principles From Neuroscience and How to Apply Them. Head Heart + Brain, 2016. Print.

    Hoffman, Mitchell, and Steven Tadelis. People Management Skills, Employee Attrition, and Manager Rewards: An Empirical Analysis. p. 96.

    “How to Create an Effective Feedback Culture.” eXplorance Inc. Feb. 2013. Web.

    “Importance of Performance Management Process & Best Practices To Optimize Monitoring Performance Work Reviews/Feedback and Goal Management.” SAP Success Factors, n.d. Web.

    Jacobson, Darcy. “How Bad Performance Management Killed Microsoft’s Edge.” Globoforce Blog, 5 July 2012. Web.

    Jaidev, Uma Pricilda, and Susan Chirayath. Pre-Training, During-Training and Post-Training Activities as Predictors of Transfer of Training. no. 4, 2012, p. 18.

    Jensen, Michael C. “Paying People to Lie: The Truth about the Budgeting Process.” European Financial Management, vol. 9, no. 3, 2003, pp. 379-406. Print.

    Kahneman, Daniel, and Ram Charan. HBR's 10 Must Reads on Making Smart Decisions. Harvard Business Review, 26 March 2013. Ebook.

    Kirkpatrick, J., and W. Kirkpatrick. “The Kirkpatrick Four Levels: A Fresh Look After 50 Years 1959-2009.” Kirkpatrickpartners.com, 2009. Web.

    Kirwan, Cyril. Improving Learning Transfer. Routledge, 2016.

    Kline, Theresa J.B., and Lorne M. Sulsky. “Measurement and Assessment Issues in Performance Appraisal.” Canadian Psychology, vol. 50, no. 3, 2009, pp. 161-171. Proquest. Web.

    Kowalski, Kyle. “Create a Daily Routine with Calendar Time Blocking (+ 7 Pro Tips).” Sloww, 29 May 2018. Web.

    Krentz, Susanna E., et al. ”Staying on Course with Strategic Metrics.” Healthcare Financial Management, vol. 60, no. 5, 2006, pp. 86-94. Proquest. Web.

    Kuligowski, Kiely. Tips for First-Time Managers. 15 Feb. 2019. Web.

    Laker, Dennis R., and Jimmy L. Powell. “The Differences between Hard and Soft Skills and Their Relative Impact on Training Transfer.” Human Resource Development Quarterly, vol. 22, no. 1, March 2011, pp. 111-22. Crossref, doi:10.1002/hrdq.20063.

    Lawrence, Paul. “Managerial coaching – A literature review.” International Journal of Evidence Based Coaching and Mentoring, vol. 15, no. 2, 2017, pp. 43-66. Web.

    Ledford, Gerald E. Jr., George Benson, and Edward E. Lawler III. “Cutting-Edge Performance Management.” WorldatWork Research, Aug. 2016. Web.

    Lee, W.R.; Choi, S.B.; Kang, S.-W. How Leaders’ Positive Feedback Influences Employees’ Innovative Behavior: The Mediating Role of Voice Behavior and Job Autonomy. Sustainability, vol. 13, no. 4, 2021, pp. 1901. https://doi.org/10.3390/su13041901

    Leopold, Till Alexander, Vesselina Ratcheva, and Saadia Zahidi. The Future of Jobs. World Economic Forum, 2016. Web.

    Levy, Dan. “How to Build a Culture That Embraces Feedback.” Inc. Magazine, March 2014. Web.

    Lighthouse Research & Advisory. “Insights from the CHRO Panel at Workhuman 2017.” Lighthouse Research & Advisory, June 2017. Web.

    Lipman, Victor. “For New Managers, Boundaries Matter (A Lot).” Forbes, 19 March 2018. Web.

    Lipman, Victor. “The Hardest Thing For New Managers.” Forbes, 1 June 2016. Web.

    Lipman, Victor. “The Move To New Manager May Be The Hardest Transition In Business.” Forbes, 2 Jan. 2018. Web.

    Lyons, Rich. “Feedback: You Need To Lead It.” Forbes, 10 July 2017. Web.

    “Managing Email Effectively.” MindTools, n.d. Web.

    Managing Performance Workbook. Trainer Bubble, 16 Feb. 2013. Web.

    Mayfield, Clifton, et al. “Psychological Collectivism and Team Effectiveness: Moderating Effects of Trust and Psychological Safety.” Journal of Organizational Culture, Communications and Conflict, vol. 20, no. 1, Jan. 2016, pp. 78-94. Web.

    McAlpin, Kevin and Hans Vaagenes. “Critical Decision Making.” Performance Coaching International. 17 Nov. 2017. Web.

    McCoy, Jim. “How to Align Employee Performance with Business Strategy.” Workforce Management, vol. 86, no. 12, 2007, pp. S5. Proquest. Web.

    “Measuring Time-To-Full Productivity.” FeverBee, n.d. Web.

    Meister, Jeanne. The 2020 Workplace: How Innovative Companies Attract, Develop, and Keep Tomorrow's Employees Today. HarperBusiness, 2010. Print.

    Meyer, Erin. “The Four Keys To Success With Virtual Teams.” Forbes Magazine, 19 Aug. 2010. Web.

    Morris, Donna. “Death to the Performance Review: How Adobe Reinvented Performance Management and Transformed Its Business.” WorldatWork, 2016, p. 10. Web.

    Myers-Briggs Company. “New Research: Time Spent on Workplace Conflict Has Doubled Since 2008.” Yahoo! Finance, 18 Oct. 2022. Web.

    Murdoch, Elisabeth. “Elisabeth Murdoch's MacTaggart lecture: full text.” The Guardian, 23 Aug. 2012. Web.

    NASA Governance and Strategic Management Handbook (NPD 1000.0B). NASA, June 2014. Web.

    NASA Space Flight Program and Project Management Handbook (NASA/SP-2014-3705). NASA, Sept. 2014. Web.

    New Manager Training: Management & Leadership Skills. Schulich School of Business, n.d. Web.

    O’Hanlon, Margaret. “It’s a Scandal! Manager Training Exposed! [Implementation Part 4].” Compensation Cafe, 16 Feb. 2012. Web.

    Ordonez, Lisa D., et al. “Goals Gone Wild: The Systematic Side Effects of Over-Prescribing Goal Setting.” Social Science Research Network. Harvard Business School, 11 Feb. 2009. Web.

    Paczka, Nina. “Meeting in the Workplace | 2023 Statistics.” LiveCareer, 25 July 2022. Web.

    Pavlou, Christina. “How to Calculate Employee Turnover Rate | Workable.” Recruiting Resources: How to Recruit and Hire Better, 13 July 2016. Web.

    Performance Management 101 Workbook. Halogen Software, 2015. Web.

    Personal Development and Review. Oxford Learning Institute, n.d. Web.

    Personal Development Plan. MindTools, 2014. Web.

    Porath, Christine, et al. “The Effects of Civility on Advice, Leadership, and Performance.” Journal of Applied Psychology, vol. 44, no. 5, Sept. 2015, pp. 1527-1541. Web.

    Project Management Institute. “PMI’s Pulse of The Profession: In-Depth Report.” PMI, May 2013. Web. June 2015.

    Quay, C. C., and A. Yusof. “The influence of employee participation, rewards and recognition, job security, and performance feedback on employee engagement.” Issues and Perspectives in Business and Social Sciences, vol. 2, no. 1, 2022, pp. 20. https://doi.org/10.33093/ipbss.2022.2.1.3

    Quinn, R. E., and J. Rohrbaugh. “A spatial model of effectiveness criteria: Towards a competing values approach to organizational analysis.” Management Science, vol. 29, 1983, pp. 363–377.

    Re:Work Guide: Develop and Support Managers. re:Work with Google, n.d. Web.

    Reardon, Kathleen Kelley. “7 Things to Say When a Conversation Turns Negative.” Harvard Business Review, 11 May 2016. Web.

    Reh, F. John. “Here Is a List of Mistakes New Managers Make and How to Avoid Them.” The Balance Careers, 30 Dec. 2018. Web.

    Richards, Leigh. “Why Is Employee Empowerment a Common Cornerstone of Organizational Development & Change Programs?” Houston Chronicle, Hearts Newspapers, LLC. 5 July 2013. Web.

    Robson, Fiona. Southwood School – A Case Study: Performance Management Systems. Society for Human Resource Management, 2009. Crossref, doi:10.4135/9781473959552.

    Rock, David, and Beth Jones. “Why More and More Companies are Ditching Performance Ratings.” Harvard Business Review, 8 Sept. 2015. Web.

    Rock, David. “SCARF: A Brain-Based Model for Collaborating With and Influencing Others.” NeuroLeadership Journal, 2008. Web..

    Romão, Soraia, Neuza Ribeiro, Daniel Roque Gomes, and Sharda Singh. “The Impact of Leaders’ Coaching Skills on Employees’ Happiness and Turnover Intention.” Administrative Sciences, vol. 12, no. 84, 2022. https://doi.org/10.3390/ admsci12030084

    Romero, Joseluis. “Yes - you can build a feedback culture.” Skills 2 Lead, Aug. 2014. Web.

    Runde, Craig E., and Tim A. Flanagan. “Conflict Competent Leadership.” Leader to Leader, Executive Forum, Winter 2008. PDF.

    Saks, Alan M., and Lisa A. Burke-Smalley. “Is Transfer of Training Related to Firm Performance?: Transfer and Firm Performance.” International Journal of Training and Development, vol. 18, no. 2, June 2014, pp. 104–15. Crossref, doi:10.1111/ijtd.12029.

    Saks, Alan M., et al. “The Transfer of Training: The Transfer of Training.” International Journal of Training and Development, vol. 18, no. 2, June 2014, pp. 81–83. Crossref, doi:10.1111/ijtd.12032.

    Salomonsen, Summer. Grovo’s First-Time Manager Microlearning® Program Will Help Your New Managers Thrive in 2018. Grovo, 2018. Web.

    Schwartz, Dan. “3 Topics Every New Manager Training Should Include.” Training Industry, 12 April 2017. Web.

    Scott, Dow, Tom McMullen, and Mark Royal. “Retention of Key Talent and the Role of Rewards.” WorldatWork, June 2012. Web.

    “Seeking Agility in Performance Management.” Human Resource Executive, 2016. Web.

    “Should You Always Involve Your Team in Decision Making?” Upskillist, 25 April 2022. Web.

    “SHRM Workplace Forecast.” The Top Workplace Trends According to HR Professionals, May 2013. Web.

    Singhal, Nikhyl. “Eight Tips for First Time Managers.” Medium, 20 Aug. 2017. Web.

    Singhania, Prakriti, et al. “2020 Global Marketing Trends.” Deloitte, 2019. Web.

    SMART Goals: A How to Guide. University of California, n.d. Web.

    Smith, Benson, and Tony Rutigliano. “Scrap Your Performance Appraisal System.” Gallup, 2002. Article.

    “State of the Modern Meeting 2015.” BlueJeans, Aug. 2015. Web.

    Sternberg, Larry, and Kim Turnage. “Why Make Managers A Strategic Priority?” Great Leadership, 12 Oct. 2017. Web.

    Sullivan, Dr. John. “Facebook’s Difference: A Unique Approach For Managing Employees.”TLNT, Sept. 2013. Web.

    Tal, David. “A 'Culture of Coaching' Is Your Company's Most Important Ingredient for Success.” Entrepreneur, 27 Sept. 2017. Web.

    Tenut, Jeff. “How Management Development Training Reduces Turnover.” DiscoverLink, 3 July 2018. Web.

    “The 5 Biggest Biases That Affect Decision-Making.” NeuroLeadership Institute, 2 August 2022. Web.

    “The Different Impact of Good and Bad Leadership.” Barna Group, 2015. Web.

    “The Engaged Workplace.” Gallup, 2017. Web.

    “The Individual Development Plan Guide.” Wildland Fire Leadership Development Program, April 2010, p. 15.

    The State of Business Communication. Grammarly, 2022. Web.

    Thomas, Kenneth. “Conflict and Conflict Management.” The Handbook of Industrial and Organizational Psychology, Rand McNally, 1976. In “The Five Conflict-Handling Modes.” The Myers Briggs Company, n.d. PDF.

    Thompson, Rachel. “What Is Stakeholder Management?” MindTools, n.d. Web.

    Tollet, Francoise. “Distracted? Learn how to (re)focus.” Business Digest, 12 July 2021. Podcast.

    Tonhauser, Cornelia, and Laura Buker. Determinants of Transfer of Training: A Comprehensive Literature Review, p. 40.

    Towers Watson. “Clear Direction in a Complex World: How Top Companies Create Clarity, Confidence and Community to Build Sustainable Performance.” Change and Communication ROI Study Report, 2011-2012. Web.

    Trudel, Natalie. “Improve Your Coaching Skills by Understanding the Psychology of Feedback.” TLNT, 12 July 2017. Web.

    “Understanding When to Give Feedback.” Harvard Business Review, Dec. 2014. Web.

    Vacassin, Daniel. “There are no 'good' performance management systems – there are just good line managers.” LinkedIn, 4 Oct. 2016. Web.

    van der Locht, Martijn, et al. “Getting the Most of Management Training: The Role of Identical Elements for Training Transfer.” Personnel Review, vol. 42, no. 4, May 2013, pp. 422–39. Crossref, doi:10.1108/PR-05-2011-0072.

    Vaughan, Liam. “Banks Find New Ways to Measure Staff.” Financial News, 10 Jan. 2011. Web.

    Watkins, Michael, et al. “Hit the Ground Running:Transitioning to New Leadership Roles.” IMD Business School, May 2014. Web.

    Whitney, Kelley. “Kimberly-Clark Corp.: Redesigning Performance Management.” Talent Management Magazine, vol. 2, no. 1, 2006. Web.

    “Whole Foods 2015 Report.” The Predictive Index, n.d. Web.

    “Whole Foods Market Reports Fourth Quarter and Fiscal Year 2016 Results.” Whole Foods, 2 Feb. 2016. Web.

    Wisniewski, Dan. “Here's why everybody hates meetings.” HR Morning, 14 Dec. 2012. Web.

    Woolum, Janet, and Brent Stockwell. Aligning Performance Measurement to Mission, Goals, and Strategy Workbook. Arizona State University, Jan. 2016. Web.

    Worall, Les, et al. The Quality of Working Life. Chartered Management Institute, 2016. Web.

    “Workplace Conflict Statistics: How We Approach Conflict at Work.” Niagara Institute, 11 Aug. 2022. Web.

    “You Waste a Lot of Time at Work Infographic.” Atlassian, 23 August 2012. Web.

    Zenger, Jack, and Joe Folkman. “Feedback: The Leadership Conundrum.” Talent Quarterly: The Feedback Issue, 2015. Web.

    Zuberbühler, P., et al. “Development and validation of the coaching-based leadership scale and its relationship with psychological capital, work engagement, and performance.” Current Psychology, vol. 42, no. 10, 2021, pp. 1-22.

    Digital Data Ethics

    • Download01-Title: Tech Trend Update: If Digital Ethics Then Data Equity
    • Download-01: Visit Link
    • member rating overall impact: 9/10
    • member rating average dollars saved: N/A
    • member rating average days saved: N/A
    • Parent Category Name: Innovation
    • Parent Category Link: /innovation

    In the past two years, we've seen that we need quick technology solutions for acute issues. We quickly moved to homeworking and then to a hybrid form. We promptly moved many of our offline habits online.

    That necessitated a boost in data collection from us towards our customers and employees, and business partners.
    Are you sure how to approach this structurally? What is the right thing to do?

    Impact and Results

    • When you partner with another company, set clear expectations
    • When you are building your custom solution, invite constructive criticism
    • When you present yourself as the authority, consider the most vulnerable in the relationship

    innovation

    AI Trends 2023

    • Buy Link or Shortcode: {j2store}207|cart{/j2store}
    • member rating overall impact: N/A
    • member rating average dollars saved: N/A
    • member rating average days saved: N/A
    • Parent Category Name: Business Intelligence Strategy
    • Parent Category Link: /business-intelligence-strategy

    As AI technologies are constantly evolving, organizations are looking for AI trends and research developments to understand the future applications of AI in their industries.

    Our Advice

    Critical Insight

    • Understanding trends and the focus of current and future AI research helps to define how AI will drive an organization’s new strategic opportunities.
    • Understanding the potential application of AI and its promise can help plan the future investments in AI-powered technologies and systems.

    Impact and Result

    Understanding AI trends and developments enables an organization’s competitive advantage.

    AI Trends 2023 Research & Tools

    Besides the small introduction, subscribers and consulting clients within this management domain have access to:

    1. AI Trends 2023 – An overview of trends that will continue to drive AI innovation.

    • AI Trends Report 2023
    [infographic]

    Further reading

    AI Trends Report 2023

    The eight trends:

    1. Design for AI
    2. Event-Based Insights
    3. Synthetic Data
    4. Edge AI
    5. AI in Science and Engineering
    6. AI Reasoning
    7. Digital Twin
    8. Combinatorial Optimization
    Challenges that slowed the adoption of AI

    To overcome the challenges, enterprises adopted different strategies

    Data Readiness

    • Lack of unified systems and unified data
    • Data quality issues
    • Lack of the right data required for machine learning
    • Improve data management capabilities, including data governance and data initiatives
    • Create data catalogs
    • Document data and information architecture
    • Solve data-related problems including data quality, privacy, and ethics

    ML Operations Capabilities

    • Lack of tools, technologies, and methodologies to operationalize models created by data scientists
    • Increase availability of cloud platforms, tools, and capabilities
    • Develop and grow machine learning operations (MLOps) tools, platforms, and methodologies to enable model operationalizing and monitoring in production

    Understanding of AI Role and Its Business Value

    • Lack of understanding of AI use cases – how AI/ML can be applied to solve specific business problems
    • Lack of understanding how to define the business value of AI investments
    • Identify AI C-suite toolkits (for example, Empowering AI Leadership from the World Economic Forum, 2022)
    • Document industry use cases
    • Use frameworks and tools to define business value for AI investments

    Design for AI

    Sustainable AI system design needs to consider several aspects: the business application of the system, data, software and hardware, governance, privacy, and security.

    It is important to define from the beginning how AI will be used by and for the application to clearly articulate business value, manage expectations, and set goals for the implementation.

    Design for AI will change how we store and manage data and how we approach the use of data for development and operation of AI systems.

    An AI system design approach should cover all stages of AI lifecycle, from design to maintenance. It should also support and enable iterative development of an AI system.

    To take advantage of different tools and technologies for AI system development, deployment, and monitoring, the design of an AI system should consider software and hardware needs and design for seamless and efficient integrations of all components of the system and with other existing systems within the enterprise.

    AI in Science and Engineering

    AI helps sequence genomes to identify variants in a person’s DNA that indicate genetic disorders. It allows researchers to model and calculate complicated physics processes, to forecast the genesis of the universe’s structure, and to understand planet ecosystem to help advance the climate research. AI drives advances in drug discovery and can assist with molecule synthesis and molecular property identification.

    AI finds application in all areas of science and engineering. The role of AI in science will grow and allow scientists to innovate faster.

    AI will further contribute to scientific understanding by assisting scientists in deriving new insights, generating new ideas and connections, generalizing scientific concepts, and transferring them between areas of scientific research.

    Using synthetic data and combining physical and machine learning models and other advances of AI/ML – such as graphs, use of unstructured data (language models), and computer vision – will accelerate the use of AI in science and engineering.

    Event- and Scenario-Driven AI

    AI-driven signal-gathering systems analyze a continuous stream of data to generate insights and predictions that enable strategic decision modeling and scenario planning by providing understanding of how and what areas of business might be impacted by certain events.

    AI enables the scenario-based approach to drive insights through pattern identification in addition to familiar pattern recognition, helping to understand how events are related.

    A system with anticipatory capabilities requires an event-driven architecture that enables gathering and analyzing different types of data (text, video, images) across multiple channels (social media, transactional systems, news feeds, etc.) for event-driven and event-sequencing modeling.

    ML simulation-based training of the model using advanced techniques under the umbrella of Reinforcement Learning in conjunction with statistically robust Bayesian probabilistic framework will aid in setting up future trends in AI.

    AI Reasoning

    Most of the applications of machine learning and AI today is about predicting future behaviors based on historical data and past behaviors. We can predict what product the customer would most likely buy or the price of a house when it goes on sale.

    Most of the current algorithms use the correlation between different parameters to make a prediction, for example, the correlation between the event and the outcome can look like “When X occurs, we can predict that Y will occur.” This, however, does not translate into “Y occurred because of X.”

    The development of a causal AI that uses causal inference to reason and identify the root cause and the causal relationships between variables without mistaking correlation and causation is still in its early stages but rapidly evolving.

    Some of the algorithms that the researchers are working with are casual graph models and algorithms that are at the intersection of causal inference with decision making and reinforcement learning (Causal Artificial Intelligence Lab, 2022).

    Synthetic Data

    Synthetic data is artificially generated data that mimics the structure of real-life data. It should also have the same mathematical and statistical properties as the real-world data that it is created to replicate.

    Synthetic data is used to train machine learning models when there is not enough real data or the existing data does not meet specific needs. It allows users to remove contextual bias from data sets containing personal data, prevent privacy concerns, and ensure compliance with privacy laws and regulations.

    Another application of synthetic data is solving data-sharing challenges.

    Researchers learned that quite often synthetic data sets outperform real-world data. Recently, a team of researchers at MIT built a synthetic data set of 150,000 video clips capturing human actions and used that data set to train the model. The researchers found that “the synthetically trained models performed even better than models trained on real data for videos that have fewer background objects” (MIT News Office, 2022).

    Today, synthetic data is used in language systems, in training self-driving cars, in improving fraud detection, and in clinical research, just to name a few examples.

    Synthetic data opens the doors for innovation across all industries and applications of AI by enabling access to data for any scenario and technology and business needs.

    Digital Twins

    Digital twins (DT) are virtual replicas of physical objects, devices, people, places, processes, and systems. In Manufacturing, almost every product and manufacturing process can have a complete digital replica of itself thanks to IoT, streaming data, and cheap cloud storage.

    All this data has allowed for complex simulations of, for example, how a piece of equipment will perform over time to predict future failures before they happen, reducing costly maintenance and extending equipment lifetime.

    In addition to predictive maintenance, DT and AI technologies have enabled organizations to design and digitally test complex equipment such as aircraft engines, trains, offshore oil platforms, and wind turbines before physically manufacturing them. This helps to improve product and process quality, manufacturing efficiency, and costs. DT technology also finds applications in architecture, construction, energy, infrastructure industries, and even retail.

    Digital twins combined with the metaverse provide a collaborative and interactive environment with immersive experience and real-time physics capabilities (as an example, Siemens presented an Immersive Digital Twin of a Plant at the Collision 2022 conference).

    Future trends include enabling autonomous behavior of a DT. An advanced DT can replicate itself as it moves into several devices, hence requiring the autonomous property. Such autonomous behavior of the DT will in turn influence the growth and further advancement of AI.

    Edge AI

    A simple definition for edge AI: A combination of edge computing and artificial intelligence, it enables the deployment of AI applications in devices of the physical world, in the field, where the data is located, such as IoT devices, devices on the manufacturing floor, healthcare devices, or a self-driving car.

    Edge AI integrates AI into edge computing devices for quicker and improved data processing and smart automation.

    The main benefits of edge AI include:

    • Real-time data processing capabilities to reduce latency and enable near real-time analytics and insights.
    • Reduced cost and bandwidth requirements as there is no need to transfer data to the cloud for computing.
    • Increased data security as the data is processed locally, on the device, reducing the risk of loss of sensitive data.
    • Improved automation by training machines to perform automated tasks.

    Edge AI is already used in a variety of applications and use cases including computer vision, geospatial intelligence, object detection, drones, and health monitoring devices.

    Combinatorial Optimization

    “Combinatorial optimization is a subfield of mathematical optimization that consists of finding an optimal object from a finite set of objects” (Wikipedia, retrieved December 2022).

    Applications of combinatorial optimization include:

    • Supply chain optimization
    • Scheduling and logistics, for example, vehicle routing where the trucks are making stops for pickup and deliveries
    • Operations optimization

    Classical combinatorial optimization (CO) techniques were widely used in operations research and played a major role in earlier developments of AI.

    The introduction of deep learning algorithms in recent years allowed researchers to combine neural network and conventional optimization algorithms; for example, incorporating neural combinatorial optimization algorithms in the conventional optimization framework. Researchers confirmed that certain combinations of these frameworks and algorithms can provide significant performance improvements.

    The research in this space continues and we look forward to learning how machine learning and AI (backtracking algorithms, reinforcement learning, deep learning, graph attention networks, and others) will be used for solving challenging combinatorial and decision-making problems.

    References

    “AI Can Power Scenario Planning for Real-Time Strategic Insights.” The Wall Street Journal, CFO Journal, content by Deloitte, 7 June 2021. Accessed 11 Dec. 2022.
    Ali Fdal, Omar. “Synthetic Data: 4 Use Cases in Modern Enterprises.” DATAVERSITY, 5 May 2022. Accessed
    11 Dec. 2022.
    Andrews, Gerard. “What Is Synthetic Data?” NVIDIA, 8 June 2021. Accessed 11 Dec. 2022.
    Bareinboim, Elias. “Causal Reinforcement Learning.” Causal AI, 2020. Accessed 11 Dec. 2022.
    Bengio, Yoshua, Andrea Lodi, and Antoine Prouvost. “Machine learning for combinatorial optimization: A methodological tour d’horizon.” European Journal of Operational Research, vol. 290, no. 2, 2021, pp. 405-421, https://doi.org/10.1016/j.ejor.2020.07.063. Accessed 11 Dec. 2022.
    Benjamins, Richard. “Four design principles for developing sustainable AI applications.” Telefónica S.A., 10 Sept. 2018. Accessed on 11 Dec. 2022.
    Blades, Robin. “AI Generates Hypotheses Human Scientists Have Not Thought Of.” Scientific American, 28 October 2021. Accessed 11 Dec. 2022.
    “Combinatorial Optimization.” Wikipedia article, Accessed 11 Dec. 2022.
    Cronholm, Stefan, and Hannes Göbel. “Design Principles for Human-Centred Artificial Intelligence.” University of Borås, Sweden, 11 Aug. 2022. Accessed on 11 Dec. 2022
    Devaux, Elise. “Types of synthetic data and 4 real-life examples.” Statice, 29 May 2022. Accessed 11 Dec. 2022.
    Emmental, Russell. “A Guide to Causal AI.” ITBriefcase, 30 March 2022. Accessed 11 Dec. 2022.
    “Empowering AI Leadership: AI C-Suite Toolkit.” World Economic Forum, 12 Jan. 2022. Accessed 11 Dec 2022.
    Falk, Dan. “How Artificial Intelligence Is Changing Science.” Quanta Magazine, 11 March 2019. Accessed 11 Dec. 2022.
    Fritschle, Matthew J. “The Principles of Designing AI for Humans.” Aumcore, 17 Aug. 2018. Accessed 8 Dec. 2022.
    Garmendia, Andoni I., et al. Neural Combinatorial Optimization: a New Player in the Field.” IEEE, arXiv:2205.01356v1, 3 May 2022. Accessed 11 Dec. 2022.
    Gülen, Kerem. “AI Is Revolutionizing Every Field and Science is no Exception.” Dataconomy Media GmbH, 9 Nov. 9, 2022. Accessed 11 Dec. 2022
    Krenn, Mario, et al. “On scientific understanding with artificial intelligence.” Nature Reviews Physics, vol. 4, 11 Oct. 2022, pp. 761–769. https://doi.org/10.1038/s42254-022-00518-3. Accessed 11 Dec. 2022.
    Laboratory for Information and Decision Systems. “The real promise of synthetic data.” MIT News, 16 Oct. 2020. Accessed 11 Dec. 2022.
    Lecca, Paola. “Machine Learning for Causal Inference in Biological Networks: Perspectives of This Challenge.” Frontiers, 22 Sept. 2021. Accessed 11 Dec. 2022. Mirabella, Lucia. “Digital Twin x Metaverse: real and virtual made easy.” Siemens presentation at Collision 2022 conference, Toronto, Ontario. Accessed 11 Dec. 2022. Mitchum, Rob, and Louise Lerner. “How AI could change science.” University of Chicago News, 1 Oct. 2019. Accessed 11 Dec. 2022.
    Okeke, Franklin. “The benefits of edge AI.” TechRepublic, 22 Sept. 2022, Accessed 11 Dec. 2022.
    Perlmutter, Nathan. “Machine Learning and Combinatorial Optimization Problems.” Crater Labs, 31 July 31, 2019. Accessed 11 Dec. 2022.
    Sampson, Ovetta. “Design Principles for a New AI World.” UX Magazine, 6 Jan. 2022. Accessed 11 Dec. 2022.
    Sgaier, Sema K., Vincent Huang, and Grace Charles. “The Case for Causal AI.” Stanford Social Innovation Review, Summer 2020. Accessed 11 Dec. 2022.
    “Synthetic Data.” Wikipedia article, Accessed 11 Dec. 2022.
    Take, Marius, et al. “Software Design Patterns for AI-Systems.” EMISA Workshop 2021, CEUR-WS.org, Proceedings 30. Accessed 11 Dec. 2022.
    Toews, Rob. “Synthetic Data Is About To Transform Artificial Intelligence.” Forbes, 12 June 2022. Accessed
    11 Dec. 2022.
    Zewe, Adam. “In machine learning, synthetic data can offer real performance improvements.” MIT News Office, 3 Nov. 2022. Accessed 11 Dec. 2022.
    Zhang, Junzhe, and Elias Bareinboim. “Can Humans Be out of the Loop?” Technical Report, Department of Computer Science, Columbia University, NY, June 2022. Accessed 11 Dec. 2022.

    Contributors

    Irina Sedenko Anu Ganesh Amir Feizpour David Glazer Delina Ivanova

    Irina Sedenko

    Advisory Director

    Info-Tech

    Anu Ganesh

    Technical Counselor

    Info-Tech

    Amir Feizpour

    Co-Founder & CEO

    Aggregate Intellect Inc.

    David Glazer

    VP of Analytics

    Kroll

    Delina Ivanova

    Associate Director, Data & Analytics

    HelloFresh

    Usman Lakhani

    DevOps

    WeCloudData

    Implement Software Asset Management

    • Buy Link or Shortcode: {j2store}313|cart{/j2store}
    • member rating overall impact: 9.3/10 Overall Impact
    • member rating average dollars saved: $107,154 Average $ Saved
    • member rating average days saved: 39 Average Days Saved
    • Parent Category Name: Asset Management
    • Parent Category Link: /asset-management
    • Organizations are aware of the savings that result from implementing software asset management (SAM), but are unsure of where to start the process.
    • Poor data capture procedures and lack of a centralized repository produce an incomplete picture of software assets and licenses, preventing accurate forecasting and license optimization.
    • Audit protocols are ad hoc, resulting in sloppy reporting and time-consuming work and lack of preparedness for external software audits.

    Our Advice

    Critical Insight

    • A strong SAM program will benefit all aspects of the business. Data and reports gained through SAM will enable data-driven decision making for all areas of the business.
    • Don’t just track licenses; manage them to create value from data. Gathering and monitoring license data is just the beginning. What you do with that data is the real test.
    • Win the audit battle without fighting. Conduct internal audits to minimize surprises when external audits are requested.

    Impact and Result

    • Conduct a current state assessment of existing SAM processes to form an appropriate plan for implementing or improving your SAM program.
    • Define standard policies, processes, and procedures for each stage of the software asset lifecycle, from procurement through to retirement.
    • Develop an internal audit policy to mitigate the risk of costly external audits.

    Implement Software Asset Management Research & Tools

    Start here – read the Executive Brief

    Read our concise Executive Brief to find out why you should implement software asset management, review Info-Tech’s methodology, and understand the four ways we can support you in completing this project.

    Besides the small introduction, subscribers and consulting clients within this management domain have access to:

    1. Assess & plan

    Assess current state and plan the scope of the SAM program, team, and budget.

    • Implement Software Asset Management – Phase 1: Assess & Plan
    • SAM Maturity Assessment
    • SAM Standard Operating Procedures
    • SAM Budget Workbook

    2. Procure, receive & deploy

    Define processes for software requests, procurement, receiving, and deployment.

    • Implement Software Asset Management – Phase 2: Procure, Receive & Deploy
    • SAM Process Workflows (Visio)
    • SAM Process Workflows (PDF)

    3. Manage, redeploy & retire

    Define processes for software inventory, maintenance, harvest and redeployment, and retirement.

    • Implement Software Asset Management – Phase 3: Manage, Redeploy & Retire
    • Patch Management Policy

    4. Build supporting processes

    Build processes for audits and plan the implementation.

    • Implement Software Asset Management – Phase 4: Build Supporting Processes & Tools
    • Software Audit Scoping Email Template
    • Software Audit Launch Email Template
    • SAM Communication Plan
    • SAM FAQ Template
    • Software Asset Management Policy
    [infographic]

    Workshop: Implement Software Asset Management

    Workshops offer an easy way to accelerate your project. If you are unable to do the project yourself, and a Guided Implementation isn't enough, we offer low-cost delivery of our project workshops. We take you through every phase of your project and ensure that you have a roadmap in place to complete your project successfully.

    1 Assess & Plan

    The Purpose

    Assess current state and plan the scope of the SAM program, team, and budget.

    Key Benefits Achieved

    Current state assessment

    Defined roles and responsibilities

    SAM budget plan

    Activities

    1.1 Outline SAM challenges and objectives.

    1.2 Assess current state.

    1.3 Identify roles and responsibilities for SAM team.

    1.4 Identify metrics and reports.

    1.5 Identify SAM functions to centralize vs. decentralize.

    1.6 Plan SAM budget process.

    Outputs

    Current State Assessment

    RACI Chart

    Defined metrics and reports

    SAM Budget Workbook

    2 Procure, Receive & Deploy

    The Purpose

    Define processes for software requests, procurement, receiving, and deployment.

    Key Benefits Achieved

    Defined standards for software procurement

    Documented processes for software receiving and deployment

    Activities

    2.1 Determine software standards.

    2.2 Define procurement process for new contracts.

    2.3 Define process for contract renewals and additional procurement scenarios.

    2.4 Design process for receiving software.

    2.5 Design deployment workflow.

    2.6 Define process for non-standard software requests.

    Outputs

    Software standards

    Standard Operating Procedures

    SAM Process Workflows

    3 Manage, Redeploy & Retire

    The Purpose

    Define processes for software inventory, maintenance, harvest and redeployment, and retirement.

    Key Benefits Achieved

    Defined process for conducting software inventory

    Maintenance and patch policy

    Documented workflows for software harvest and redeployment as well as retirement

    Activities

    3.1 Define process for conducting software inventory.

    3.2 Define policies for software maintenance and patches.

    3.3 Map software license harvest and reallocation process.

    3.4 Define policy for retiring software.

    Outputs

    Standard Operating Procedures

    Patch management policy

    SAM Process Workflows

    4 Build Supporting Processes & Tools

    The Purpose

    Build processes for audits, identify tool requirements, and plan the implementation.

    Key Benefits Achieved

    Defined process for internal and external audits

    Tool requirements

    Communication and implementation plan

    Activities

    4.1 Define and document the internal audit process.

    4.2 Define and document the external audit process.

    4.3 Document tool requirements.

    4.4 Develop a communication plan.

    4.5 Prepare an FAQ list.

    4.6 Identify SAM policies.

    4.7 Develop a SAM roadmap to plan your implementation.

    Outputs

    Audit response templates

    Tool requirements

    Communication plan

    End-user FAQ list

    Software Asset Management Policy

    Implementation roadmap

    Further reading

    Implement Software Asset Management

    Go beyond tracking licenses to proactively managing software throughout its lifecycle.

    Table of contents

    1. Title
    2. Executive Brief
    3. Execute the Project/DIY Guide
    4. Next Steps
    5. Appendix

    Analyst Perspective

    “Organizations often conflate software asset management (SAM) with license tracking. SAM is not merely knowing how many licenses you require to be in compliance; it’s asking the deeper budgetary questions to right-size your software spend.

    Software audits are a growing concern for businesses, but proactive reporting and decision making supported by quality data will mitigate audit risks. Value is left on the table through underused or poor-quality data, so active data management must be in play. A dedicated ITAM tool can assist with extracting value from your license data.

    Achieving an optimized SAM program is a transformative effort, but the people, processes, and technology need to be in place before that can happen.” (Sandi Conrad, Senior Director, Infrastructure & Operations Practice, Info-Tech Research Group)

    Software license complexity and audit frequency are increasing: are you prepared to manage the risk?

    This Research Is Designed For:

    • CIOs that want to improve IT’s reputation with the business.
    • CIOs that want to eliminate the threat of a software audit.
    • Organizations that want proactive reporting that benefits the entire business.
    • IT managers who want visibility into their software usage.

    This Research Will Help You:

    • Establish a standardized software management process.
    • Track and manage software throughout its lifecycle, from procurement through to retirement or redeployment.
    • Rationalize your software license estate.
    • Improve your negotiations with software vendors.
    • Improve the quality of your SAM data gathering and reporting.

    Executive summary

    Situation

    • Organizations are aware of the savings that result from implementing software asset management (SAM), but are unsure of where to start the process. With no formal standards in place for managing licenses, organizations are constantly at risk for costly software audits and poorly executed software spends.

    Complication

    • Poor data-capture procedures produce an incomplete picture of software lifecycles.
    • No centralized repository exists, resulting in fragmented reporting.
    • Audit protocols are ad hoc, resulting in sloppy reporting and time-consuming work.

    Resolution

    • Conduct a current state assessment of existing SAM processes to form an appropriate plan for implementing or improving your SAM program.
    • Build and involve a SAM team in the process from the beginning to help embed the change.
    • Define standard policies, processes, and procedures for each stage of the software asset lifecycle, from procurement through to retirement. Pace yourself; a staged implementation will make your ITAM program a success.
    • Develop an internal audit program to mitigate the risk of costly audits.
    • Once a standardized SAM program and data are in place, you will be able to use the data to optimize and rationalize your software licenses.

    Info-Tech Insight

    A strong SAM program will benefit all aspects of the business.
    Data and reports gained through SAM will enable data-driven decision making for all areas of the business.

    Don’t just track licenses; manage them to create value from data.
    Gathering and monitoring license data is just the beginning. What you do with that data is the real test.

    Win the audit battle without fighting.
    Conduct internal audits to minimize surprises when external audits are requested.

    Build the business case for SAM on cost and risk avoidance

    You can estimate the return even without tools or data.

    Benefit Calculate the return
    Compliance

    How many audits did you have in the past three years?

    How much time did you spend in audit response?

    Suppose you had two audits each year for the last three years, each with an average $250,000 in settlements.

    A team of four with an average salary of $75,000 each took six months to respond each year, allocating 20% of their work time to the audit.

    You could argue annual audits cost on average $530,000. Increasing ITAM maturity stands to reduce that cost significantly.

    Efficiency

    How much do you spend on software and maintenance by supplier?

    Suppose you spent $1M on software last year. What if you could reduce the spend by just 10% through better practices?

    SAM can help reduce the annual spend by simplifying support, renegotiating contracts based on asset data, reducing redundancy, and reducing spend.

    The Business Benefits of SAM

    • Compliance: Managing audits and meeting legal, contractual, and regulatory obligations.
    • Efficiency: Reducing costs and making the best use of assets while maintaining service.
    • Agility: Anticipate requirements using asset data for business intelligence and analytics.

    Poor software asset management practices increase costs and risks

    Failure to implement SAM can lead to:

    High cost of undiscovered IT assets
    • Needless procurement of software for new hires can be costly.
    Licensing, liability, and legal violations
    • Legal actions and penalties that result from ineffective SAM processes and license incompliance can severely impact an organization’s financial performance and corporate brand image.
    Compromised security
    • Not knowing what assets you have, who is using them and how, can compromise the security of sensitive information.
    Increased management costs
    • Not having up-to-date software license information impacts decision making, with many management teams failing to respond quickly and efficiently to operational demands.
    Increased disruptions
    • Vendors seek out organizations who don’t manage their software assets effectively; it is likely that you could be subject to major operational disruptions as a result of an audit.
    Poor supplier/vendor relationship
    • Most organizations fear communicating with vendors and are anxious about negotiating new licenses.

    54% — A study by 1E found that only 54% of organizations believe they can identify all unused software in their organization.

    28% — On average, 28% of deployed software is unused, with a wasted cost of $224 per PC on unused software (1E, 2014).

    53% — Express Metrix found that 53% of organizations had been audited within the past two years. Of those, 72% had been audited within the last 12 months.

    SAM delivers cost savings beyond the procurement stage

    SAM delivers cost savings in several ways:

    • Improved negotiating position
      • Certainty around software needs and licensing terms can put the organization in a better negotiating position for new contracts or contract renewals.
    • Improved purchasing position
      • Centralized procurement can allow for improved purchasing agreements with better pricing.
    • More accurate forecasting and spend
      • With accurate data on what software is installed vs. used, more accurate decisions can be made around software purchasing needs and budgeting.
    • Prevention of over deployment
      • Deploy software only where it is needed based on what end users actively use.
    • Software rationalization
      • SAM data may reveal multiple applications performing similar functions that can be rationalized into a single standard software that is used across the enterprise.
    • License harvesting
      • Identify unused licenses that can be harvested and redeployed to other users rather than purchasing new licenses.

    SAM delivers many benefits beyond cost savings

    Manage risk. If licensing terms are not properly observed, the organization is at risk of legal and financial exposure, including illegal software installation, loss of proof of licenses purchased, or breached terms and conditions.

    Control and predict spend. Unexpected problems related to software assets and licenses can significantly impact cash flow.

    Less operational interruptions. Poor software asset management processes could lead to failed deployments, software update interruptions, viruses, or a shutdown of unlicensed applications.

    Avoid security breaches. If data is not secure through software patches and security, confidential information may be disclosed.

    More informed decisions. More accurate data on software assets improves transparency and informs decision making.

    Improved contract management. Automated tools can alert you to when contracts are up for renewal to allow time to plan and negotiate, then purchase the right amount of licenses.

    Avoid penalties. Conduct internal audits and track compliance to avoid fees or penalties if an external audit occurs.

    Reduced IT support. Employees should require less support from the service desk with proper, up to date, licensed software, freeing up time for IT Operations to focus on other work.

    Enhanced productivity. By rationalizing and standardizing software offerings, more staff should be using the same software with the same versioning, allowing for better communication and collaboration.

    Asset management is especially correlated with the following processes

    Being highly effective at asset management means that you are more likely to be highly effective at almost all IT processes, especially:

    Icon for process 'BAI10 Configuration Management'. Configuration Management
    76% more effective
    Icon for process 'ITRG03 Manage Service Catalogs'. Service Catalog
    74% more effective
    Icon for process 'APO11 Quality Management'. Quality Management
    63% more effective
    Icon for process 'ITRG08 Data Quality'. Data Quality
    62% more effective
    Icon for process 'MEA01 Performance Measurement'. Performance Measurement
    61% more effective
    Icon for process 'BAI05 Organizational Change Management'. Organizational Change Management
    60% more effective
    Icon for process 'APO05 Portfolio Management'. Portfolio Management
    59% more effective
    Icon for process 'APO03 Enterprise Architecture'. Enterprise Architecture
    58% more effective

    Why? Good SAM processes are integral to both service management and configuration management

    (Source: Info-Tech Research Group, IT Management and Governance Diagnostic; N=972 organizations) (High asset management effectiveness was defined as those organizations with an effectiveness score of 8 or above.)

    To accelerate progress, Info-Tech Research Group parses software asset management into its essential processes

    Focus on software asset management essentials

    Software Procurement:

    • Define procurement standards for software and related warranties and support options.
    • Develop processes and workflows for purchasing and work out financial implications to inform budgeting later.

    Software Deployment and Maintenance:

    • Define policies, processes, and workflows for software receiving, deployment, and maintenance practices.
    • Develop processes and workflows for managing imaging, harvests and redeployments, service requests, and large-scale rollouts.

    Software Harvest and Retirement:

    • Manage the employee termination and software harvest cycle.
    • Develop processes, policies, and workflows for software security and retirement.

    Software Contract and Audit Management:

    • Develop processes for data collection and validation to prepare for an audit.
    • Define metrics and reporting processes to keep asset management processes on track.
    A diagram that looks like a tier circle with 'Implement SAM' at the center. The second ring has 'Request & Procure', 'Receive & Deploy', 'Manage & Maintain', and 'Harvest & Retire'. The third ring seems to be a cycle beginning with 'Plan', 'Request', 'Procure', 'Deploy', 'Manage', 'Retire', and back to 'Plan'.

    Asset management is a key piece of Info-Tech’s COBIT-based IT Management and Governance Framework

    The Info-Tech / COBIT5 IT Management & Governance Framework, a number of IT process icons arranged like a periodic table. A magnifying glass highlights process 'BAI09 Asset Management' in the 'Infrastructure & Operations' category.

    Follow Info-Tech's methodology to build a plan to implement software asset management

    Phase 1
    Assess & Plan
    Phase 2
    Procure, Receive & Deploy
    Phase 3
    Manage, Redeploy & Retire
    Phase 4
    Build supporting processes

    1.1

    Assess current state

    2.1

    Request & procure

    3.1

    Manage & maintain contracts

    4.1

    Compliance & audits

    1.2

    Build team and define metrics

    2.2

    Receive & deploy

    3.2

    Harvest or retire

    4.2

    Communicate & build roadmap

    1.3

    Plan & budget
    Deliverables
    Standard Operating Procedures (SOP)
    SAM maturity assessment Process workflows Process workflows Audit response templates
    RACI chart Software standards Patch management policy Communication plan & FAQ template
    SAM metrics SAM policies
    SAM budget workbook

    Thanks to SAM, Visa saved $200 million in three years

    Logo for VISA.

    Case Study

    Industry: Financial Services
    Source: International Business Software Managers Association

    Visa, Inc.

    Visa, Inc. is the largest payment processing company in the world, with a network that can handle over 40,000 transactions every minute.

    Software Asset Management Program

    In 2006, Visa launched a formal IT asset management program, but it was not until 2011 that it initiated a focus on SAM. Joe Birdsong, the SAM director, first addressed four major enterprise license agreements (ELAs) and compliance issues. The SAM team implemented a few dedicated SAM tools in conjunction with an aggressive approach to training.

    Results

    The proactive approach taken by Visa used a three-pronged strategy: people, process, and tools. The process included ELA negotiations, audit responses, and software license rationalization exercises.

    According to Birdsong, “In the past three years, SAM has been credited with saving Visa over $200 million.”

    An timeline arrow with benchmarks, in order: 'Tool purchases', 'ELA negotiations', 'License rationalization', 'Audit responses', '$200 million in savings in just three years thanks to optimized SAM processes'.

    Info-Tech delivers: Use our tools and templates to accelerate your project to completion

    Thumbnail of Info-Tech's 'SAM Standard Operating Procedures (SOP)'.
    SAM Standard Operating Procedures (SOP)
    Thumbnail of Info-Tech's 'SAM Maturity Assessment'.
    SAM Maturity Assessment
    Thumbnail of Info-Tech's 'SAM Visio Process Workflows'.
    SAM Visio Process Workflows
    Thumbnail of Info-Tech's 'SAM Budget Workbook'.
    SAM Budget Workbook
    Thumbnail of Info-Tech's 'Additional SAM Policy Templates'.
    Additional SAM Policy Templates
    Thumbnail of Info-Tech's 'Software Asset Management Policy'.
    Software Asset Management Policy
    Thumbnail of Info-Tech's 'SAM Communication Plan'.
    SAM Communication Plan
    Thumbnail of Info-Tech's 'SAM FAQ Template'.
    SAM FAQ Template

    Use these insights to help guide your understanding of the project

    • SAM provides value to other processes in IT.
      Data, reports, and savings gained through SAM will enable data-driven decision making for all areas of the business.
    • Don’t just track licenses; manage them to create value from data.
      Gathering and monitoring license data is just the beginning. What you do with that data is the real test.
    • SAM isn’t about managing costs; it’s about understanding your environment to make better decisions.
      Capital tied up in software can impact the progress of other projects.
    • Managing licenses can impact the entire organization.
      Gain project buy-in from stakeholders by articulating the impact that managing licenses can have on other projects and the prevalence of shadow IT.

    Measure the value of a guided implementation (GI)

    Engaging in GIs doesn’t just offer valuable project advice, it also results in significant cost savings.

    GI Measured Value (Assuming 260 workdays in a year)
    Phase 1: Assess & Plan
    • Time, value, and resources saved by using Info-Tech’s methodology to assess current state and create a defined SAM team with actionable metrics
    • For example, 2 FTEs * 5 days * $80,000/year = $6,400
    Phase 2: Procure, Receive & Deploy
    • Time, value, and resources saved by using Info-Tech’s methodology to streamline request, procurement, receiving, and deployment processes for software assets.
    • For example, 2 FTEs * 5 days * $80,000/year = $6,400
    Phase 3: Manage, Redeploy & Retire
    • Time, value, and resources saved by using Info-Tech’s methodology to streamline the maintenance, inventory, license redeployment, and software retiring processes.
    • For example, 2 FTEs * 5 days * $80,000/year = $6,400
    Phase 4: Build Supporting Processes and Tools
    • Time, resources, and potential audit fines saved by using Info-Tech’s methodology to improve audit defense processes ($298,325 average audit penalty (Based on the results of Cherwell Software’s 2013 Software Audit Industry Report)) and design a communication and implementation plan.
    • For example, 2 FTEs * 5days * $80,000/year = $6,400 + $298,325 = $304,725
    Total savings $330,325

    Info-Tech offers various levels of support to best suit your needs

    DIY Toolkit

    Guided Implementation

    Workshop

    Consulting

    "Our team has already made this critical project a priority, and we have the time and capability, but some guidance along the way would be helpful." "Our team knows that we need to fix a process, but we need assistance to determine where to focus. Some check-ins along the way would help keep us on track." "We need to hit the ground running and get this project kicked off immediately. Our team has the ability to take this over once we get a framework and strategy in place." "Our team does not have the time or the knowledge to take this project on. We need assistance through the entirety of this project."

    Diagnostics and consistent frameworks used throughout all four options

    Implement Software Asset Management – project overview

    Phase 1: Assess & plan Phase 2: Procure, receive & deploy Phase 3: Manage, redeploy & retire Phase 4: Build supporting processes
    Supporting Tool icon Best-Practice Toolkit

    Step 1.1: Assess current state

    Step 1.2: Build team and define metrics

    Step 1.3: Plan and budget

    Step 2.1: Request and procure

    Step 2.2: Receive and deploy

    Step 3.1: Manage and maintain contracts

    Step 3.2: Harvest, redeploy, or retire

    Step 4.1: Compliance and audits

    Step 4.2: Communicate and build roadmap

    Guided Implementations
    • Assess current state and challenges.
    • Define roles and responsibilities as well as metrics.
    • Discuss SAM budgeting.
    • Define software standards and procurement process.
    • Build processes for receiving software and deploying software.
    • Define process for conducting software inventory and maintenance and patches.
    • Build software harvest and redeployment processes and retirement.
    • Define process for internal and external audits.
    • Develop communication and implementation plan.
    Associated Activity icon Onsite Workshop Module 1:
    Assess & Plan
    Module 2:
    Map Core Processes: Procure, Receive & Deploy
    Module 3:
    Map Core Processes: Manage, Redeploy & Retire
    Module 4:
    Prepare for audit, build roadmap and communications

    Workshop Overview

    Contact your account representative or email Workshops@InfoTech.com for more information.

    Workshop Day 1 Workshop Day 2 Workshop Day 3 Workshop Day 4
    Activities
    Assess & Plan

    1.1 Outline SAM challenges and objectives

    1.2 Assess current state

    1.3 Identify roles and responsibilities for SAM team

    1.4 Identify metrics and reports

    1.5 Identify SAM functions to centralize vs. decentralize

    1.6 Plan SAM budget process

    Map Core Processes: Procure, Receive & Deploy

    2.1 Determine software standards

    2.2 Define procurement process for new contracts

    2.3 Define process for contract renewals and additional procurement scenarios

    2.4 Design process for receiving software

    2.5 Design deployment workflow

    2.6 Define process for non-standard software requests

    Map Core Processes: Manage, Redeploy & Retire

    3.1 Define process for conducting software inventory

    3.2 Define policies for software maintenance and patches

    3.3 Map software license harvest and reallocation process

    3.4 Define policy for retiring software

    Build Supporting Processes

    4.1 Define and document the internal audit process

    4.2 Define and document the external audit process

    4.3 Develop a communication plan

    4.4 Prepare an FAQ list

    4.5 Identify SAM policies

    4.6 Develop a SAM roadmap to plan your implementation

    Deliverables
    • SAM maturity assessment
    • RACI chart
    • Defined metrics and reports
    • Budget workbook
    • Process workflows
    • Software standards
    • Process workflows
    • Patch management policy
    • Standard operating procedures
    • Audit response templates
    • Communication plan
    • FAQ template
    • Additional policy templates
    • Roadmap of initiatives

    Use these icons to help direct you as you navigate this research

    Use these icons to help guide you through each step of the blueprint and direct you to content related to the recommended activities.

    A small monochrome icon of a wrench and screwdriver creating an X.

    This icon denotes a slide where a supporting Info-Tech tool or template will help you perform the activity or step associated with the slide. Refer to the supporting tool or template to get the best results and proceed to the next step of the project.

    A small monochrome icon depicting a person in front of a blank slide.

    This icon denotes a slide with an associated activity. The activity can be performed either as part of your project or with the support of Info-Tech team members, who will come onsite to facilitate a workshop for your organization.

    Phase 1: Assess Current State

    VISA fought fire with fire to combat costly software audits

    Logo for VISA.

    Case Study

    Industry: Financial Services
    Source: SAM Summit 2014

    Challenge

    Visa implemented an IT asset management program in 2006. After years of software audit teams from large firms visiting and leaving expensive software compliance bills, the world’s leading payment processing company decided it was time for a change.

    Upper management recognized that it needed to combat audits. It had the infrastructure in place and the budget to purchase SAM tools that could run discovery and tracking functions, but it was lacking the people and processes necessary for a mature SAM program.

    Solution

    Visa decided to fight fire with fire. It initially contracted the same third-party audit teams to help build out its SAM processes. Eventually, Visa formed a new SAM team that was led by a group of former auditors.

    The former auditors recognized that their role was not technology based, so a group of technical individuals were hired to help roll out various SAM tools.

    The team rolled out tools like BDNA Discover and Normalize, Flexera FlexNet Manager, and Microsoft SCCM.

    Results

    To establish an effective SAM team, diverse talent is key. Visa focused on employees that were consultative but also technical. Their team needed to build relationships with teams within the organization and externally with vendors.

    Most importantly, the leaders of the team needed to think like auditors to better prepare for audits. According to Joe Birdsong, SAM Director at Visa, “we want to be viewed as a team that can go in and help right-size their environment and better understand licensing to help teams make better decisions.”

    The SAM team was only the beginning.

    Step 1.1 Assess current state and plan scope

    Phase 1:
    Assess & Plan
    This step will walk you through the following activities:This step involves the following participants:

    1.1

    Assess current state
    • 1.1.1 Outline the organization’s SAM challenges
    • 1.1.2 Identify objectives of SAM program
    • 1.1.3 Determine the maturity of your SAM program
    • Project Sponsor
    • IT Director, CIO
    • IT Managers and SAM Manager

    1.2

    Build team and define metrics

    1.3

    Plan & budget

    Step Outcomes

    • An outline of the challenges related to SAM
    • A clear direction for the program based on drivers, anticipated benefits, and goals
    • A completed maturity assessment of current SAM processes

    Sketch out challenges related to software asset management to shape the direction of the project

    Common SAM challenges

    • Audits are disruptive, time-consuming, and costly
    • No audit strategy and response in place
    • Software non-compliance risk is too high
    • Lacking data to forecast software needs
    • No central repository of software licenses
    • Untracked or unused software licenses results in wasted spend
    • Software license and maintenance costs account for a large percentage of the budget
    • Lacking data to know what software is purchased and deployed across the organization
    • Lack of software standards make it difficult to collect consistent information about software products
    • New software licenses are purchased when existing licenses remain on the shelf or multiple similar software products are purchased
    • Employees or departments make ad hoc purchases, resulting in overspending and reduced purchasing power
    • License renewal dates come up unexpectedly without time for adequate decision making
    • No communication between departments to coordinate software purchasing
    • Difficult to stay up to date with software licensing rule changes to remain in compliance
    • Processes and policies are unstandardized and undocumented

    Outline the organization’s SAM challenges

    Associated Activity icon 1.1.1 Brainstorm SAM challenges

    Participants: CIO/CFO, IT Director, Asset Manager, Purchasing, Service Desk Manager, Security (optional), Operations (optional)

    1. Distribute sticky notes to participants. Have everyone start by identifying challenges they face as a result of poor software asset management.
    2. As group, discuss and outline the software asset management challenges facing the organization. These may be challenges caused by poor SAM processes or simply by a lack of process. Group the challenges into key pain points to inform the current state discussion and assessment to follow.

    To be effective with software asset management, understand the drivers and potential impact to the organization

    Drivers of effective SAM Results of effective SAM
    Contracts and vendor licensing programs are complex and challenging to administer without data related to assets and their environment. Improved access to accurate data on contracts, licensing, warranties, installed software for new contracts, renewals, and audit requests.
    Increased need to meet compliance requires a formal approach to tracking and managing assets. Encryption, software application controls, and change notifications all contribute to better asset controls and data security.
    Cost cutting is on the agenda, and management is looking to reduce overall IT spend in the organization in any possible way. Reduction of software spend through data for better forecasting, planning, and licensing rationalization and harvesting.
    Audits are time consuming, disruptive to project timelines and productivity, and costly. Respond to audits with a formalized process, accurate data, and minimal disruption using always-available reporting.

    Determine goals to focus the direction of your SAM program

    Associated Activity icon 1.1.2 Identify objectives of the SAM program

    Participants: CIO/CFO, IT Director, Asset Manager, Service Manager (optional)

    Document: Document in the Standard Operating Procedures.

    1. Identify the drivers behind the software asset management implementation or improvement project. List on a whiteboard or flip chart.
    2. Using the project drivers as input, brainstorm the goals of the SAM project. Discuss the goals as a group and finalize into a list of objectives for the SAM program.
    3. Record the objectives in the SOP and keep them in mind as you work through the rest of the project.

    Sample Objectives:

    1. A single data repository to efficiently manage assets for their entire lifecycle.
    2. Formalizing a methodology for documenting assets to make data retrieval easy and accurate.
    3. Defining and documenting processes to determine where improvements can be made.
    4. Improving customer experience in accessing, using, and maintaining assets.
    5. Centralizing contract information.
    6. Providing access to information for all technical teams as needed.

    Implementing SAM processes will support other IT functions

    By improving how you manage your licenses and audit requests, you will not only provide benefits through a mature SAM program, you will also improve your service desk and disaster recovery functions.

    Service Desk Disaster Recovery
    • Effective service desk tickets require a certain degree of technical detail for completion that a SAM program often provides.
    • Many tools are available that can handle both ITSM and ITAM functions. Your SAM data can be integrated into many of your service desk functions.
    • For example, if a particular application is causing a high number of tickets, SAM data could show the application’s license is almost expired and its usage has decreased due to end-user frustrations. The SAM team could review the application and decide to purchase software that better meets end-user needs.
    • If you don’t know what you have, you don’t know what needs to be back online first.
    • The ability to restore system functionality is heavily dependent on the ability to locate or reproduce master media documentation and system configuration information.
    • If systems/software are permanently lost, the ability to recover software licensing information is crucial to preserving compliance.
    • License agreement and software are needed to demonstrate software ownership. Unless the proof of ownership is present, there is no proof of compliance.
    Short description of Info-Tech blueprint 'Standardize the Service Desk'. Short description of Info-Tech blueprint 'Create a Right-Sized Disaster Recovery Plan'.

    Each level of SAM maturity comes with its own unique challenges

    Maturity People & Policies Processes Technology
    Chaos
    • No dedicated staff
    • No policies published
    • Procedures not documented or standardized
    • Licenses purchased randomly
    • Help desk images machines, but users can buy and install software
    • Minimal tracking tools in place
    Reactive
    • Semi-focused SAM manager
    • No policies published
    • Reliance on suppliers to provide reports for software purchases
    • Buy licenses as needed
    • Software installations limited to help desk
    • Discovery tools and spreadsheets used to manage software
    Controlled
    • Full-time SAM manager
    • End-user policies published and requiring sign-off
    • License reviews with maintenance and support renewals
    • SAM manager involved in budgeting and planning sessions
    • Discovery and inventory tools used to manage software
    • Compliance reports run as needed
    Proactive
    • Extended SAM team, including help desk and purchasing
    • Corporate anti-piracy statement in place and enforced
    • Quarterly license reviews
    • Centralized view into software licenses
    • Software requests through service catalog with defined standard and non-standard software
    • Product usage reports and alerts in place to harvest and reuse licenses
    • Compliance and usage reports used to negotiate software contracts
    Optimized
    • SAM manager trained and certified
    • Working with HR, Legal, Finance, and IT to enforce policies
    • Full support and maintenance analysis for all license reviews
    • Quarterly meetings with SAM team to review policies, procedures, upcoming contracts, and rollouts
    • Software deployed automatically through service catalog/apps store
    • Detailed savings reports provided to executive team annually
    • Automated policy enforcement and process workflows

    Determine the maturity of your SAM program

    Supporting Tool icon 1.1.3 Use the SAM Maturity Assessment Tool
    1. Download the SAM Maturity Assessment Tool and go to tab 2.
    2. Complete the self-assessment in all seven categories:
      1. Control Environment
      2. Roles & Responsibilities
      3. Policies & Procedures
      4. Competence
      5. Planning & Implementation Process
      6. Monitoring & Review
      7. Inventory Processes
    3. Go to tab 3 and examine the graphs produced. Identify the areas in your SAM program that require the most attention and which are already relatively mature.
    4. Use the results of this maturity assessment to focus the efforts of the project moving forward. Return to the assessment after a pre-determined time (e.g. one year later) to track improvement in maturity over time.
    Screenshot of the results page from the SAM Maturity Assessment Tool. Screenshot of the processes page from the SAM Maturity Assessment Tool.

    Step 1.2 Build team and define metrics

    Phase 1:
    Assess & Plan
    This step will walk you through the following activities:This step involves the following participants:

    1.1

    Assess current state
    • 1.2.1 Identify roles and responsibilities for SAM team
    • 1.2.2 Identify metrics and KPIs to track the success of your SAM program
    • 1.2.3 Define SAM reports to track metrics
    • CIO/CFO
    • IT Director
    • SAM Manager
    • SAM Team
    • Service Desk Manager

    1.2

    Build team and define metrics

    1.3

    Plan & budget

    Step Outcomes

    • A description of the roles and responsibilities of IT staff involved in SAM
    • A list of metrics and reports to track to measure the success of the software asset management program

    Define roles and responsibilities for the SAM program

    Roles and responsibilities should be adapted to fit specific organizational requirements based on its size, structure, and distribution and the scope of the program. Not all roles are necessary and in small organizations, one or two people may fulfill multiple roles.

    Senior Management Sponsor – Ensures visibility and support for the program.

    IT Asset Manager – Responsible for management of all assets and maintaining asset database.

    Software Asset Manager – Responsible for management of all software assets (a subset of the overall responsibility of the IT Asset Manager).

    SAM Process Owner – Responsible for overall effectiveness and efficiency of SAM processes.

    Asset Analyst – Maintains up-to-date records of all IT assets, including software version control.

    Additional roles that interact with SAM:

    • Security Manager
    • Auditors
    • Procurement Manager
    • Legal Council
    • Change Manager
    • Configuration Manager
    • Release and Deployment Manager
    • Service Desk Manager

    Form a software asset management team to drive project success

    Many organizations simply do not have a large enough staff to hire a full-time software asset manager. The role will need to be championed by an internal employee.

    Avoid filling this position with a temporary contract; one of the most difficult operational factors in SAM implementation and continuity is constant turnover and organizational shifts. Hiring a software asset manager on contract might get the project going faster, but without the knowledge gained by doing the processes, the program won’t have enough momentum to sustain itself.

    Software Asset Manager Duties

    • Gather proof of license.
    • Record and track all assets within the SAM repository.
    • Produce compliance reports.
    • Preparation of budget requests.
    • Administration of software renewal process.
    • Contract and support analysis.
    • Document procedures.
    • Ensure project is on track.

    SAM Team Member Duties

    • Record license and contract data in SAM tool.
    • Assist in production of SAM reports.
    • Data analysis.
    • Match tickets to SAM data.
    • Assist in documentation.
    • Assist in compliance reports.
    • Gather feedback from end users.

    Info-Tech Best Practice

    Make sure your SAM team is diverse. The SAM team will need to be skilled at achieving compliance, but there is also a need for technically skilled individuals to maximize the function of the SAM tool(s) at your organization.

    Identify roles and responsibilities for SAM

    Associated Activity icon 1.2.1 Complete a RACI chart for your organization

    Participants: CIO/CFO, IT Director, SAM Manager, SAM Team, Service Desk Manager

    Document: Document in the Standard Operating Procedures.

    Determine the roles and responsibilities for your SAM program. Record the results in a RACI (responsible, accountable, consulted, informed) chart such as the example below.

    SAM Processes and Tasks CIO CFO SAM Manager IT Director Service Management Team IT Ops Security Finance Legal Project Manager
    Policies/Governance A C R R I I C I R I
    Strategy A C R R I I I I C
    Risk Management/Asset Security A C R R C R C C C
    Data Entry/Quality I I A R R
    Compliance Auditing R C A R I I I I
    Education & Training R I A C I I
    Contract Lifecycle Management R R A R C C C C R C
    Workflows R C A R I I I R I C/I
    Budgeting R R R A C R
    Software Acquisition R I A R I C R C C
    Controls/Reporting R I A R I I C I
    Optimize License Harvesting I I A R I C C

    Identify metrics to form the framework of the project

    Trying to achieve goals without metrics is like trying to cook without measuring your ingredients. You might succeed, but you’ll have no idea how to replicate it.

    SAM metrics should measure one of five categories:

    • Quantity → How many do we have? How many do we want?
    • Compliance → What is the level of compliance in a specific area?
    • Duration → How long does it take to achieve the desired result?
    • Financial → What is the cost/value? What is our comparative spend?
    • Quality → How good was the end result? E.g. Completeness, accuracy, timeliness

    The metrics you track depend on your maturity level. As your organization shifts in maturity, the metrics you prioritize for tracking will shift to reflect that change. Example:

    Metric category Low maturity metric High maturity metric
    Compliance % of software installed that is unauthorized % of vendors in effective licensing position (ELP) report
    Quantity % of licenses documented in ITAM tool % of requests made through unauthorized channels

    Associate KPIs and metrics with SAM goals

    • Identify the critical success factors (CSFs) for your software asset management program based on strategic goals.
    • For each success factor, identify the key performance indicators (KPIs) to measure success, as well as specific metrics that will be tracked and reported on.
    • Sample metrics are below:

    CSF = Goal, or what success looks like

    KPI = How achievement of goal will be defined

    Metric = Numerical measure to determine if KPI has been achieved

    CSF/Goal KPI Metrics
    Improve accuracy of software budget and forecasting
    • Reduce software spend by 5%
    • Total software asset spending
    • Budgeted software spend vs. actual software spend
    Avoid over purchasing software licenses and optimize use of existing licenses
    • Reduce number of unused and underused licenses by 10%
    • Number of unused licenses
    • Money saved from harvesting licenses instead of purchasing new ones
    Improve accuracy of data
    • Data in SAM tool matches what is deployed with 95% accuracy
    • Percentage of entitlements recorded in SAM tool
    • Percentage of software titles recognized by SAM tool
    Improved service delivery
    • Reduce time to deploy new software by 10%
    • Mean time to purchase new software
    • Mean time to fulfill new software requests

    Identify metrics and KPIs to track the success of your SAM program

    Associated Activity icon 1.2.2 Brainstorm metrics and KPIs

    Participants: CIO, IT Director, SAM Manager, SAM Team

    Document: Document in the Standard Operating Procedures.

    1. Discuss the goals and objectives of implementing or improving software asset management, based on challenges identified earlier.
    2. From the goals, identify the critical success factors for the SAM program.
    3. For each CSF, identify one to three key performance indicators (KPIs) to evaluate achievement of the success factor.
    4. For each KPI, identify one to three metrics that can be tracked and reported on to measure success. Ensure that the metrics are tangible and measurable.

    Use the table below as an example.

    Goal/CSF KPI Metric
    Improve license visibility Increase accuracy and completeness of SAM data
    • % of total titles included in ITAM tool
    • % of licenses documented in ITAM tool
    Reduce software costs Reduce number of unused software licenses by 20%
    • % of licenses assigned to ex-employees
    • % of deployed licenses that have not been used in the past six months
    Reduce shadow IT Reduce number of unauthorized software purchases and installations by 10%
    • % of software requests made through unauthorized channels
    • % of software installed that is unauthorized

    Tailor metrics and reports to specific stakeholders

    Asset Managers

    Asset managers require data to manage how licenses are distributed throughout the organization. Are there multiple versions of the same application deployed? What proportion of licenses deployed are assigned to employees who are no longer at the organization? What are the usage patterns for applications?

    Service Desk Technicians

    Service desk technicians need real-time data on licenses currently available to deploy to machines that need to be imaged/updated, otherwise there is a risk of breaching a vendor agreement.

    Business Managers and Executives

    Business managers and executives need reports to make strategic decisions. The reports created for business stakeholders need to help them align business projects or business processes with SAM metrics. To determine which reports will provide the most value, start by looking at business goals and determining the tactical data that will help inform and support these goals and their progress.

    Additional reporting guidelines:

    • Dashboards should provide quick-glance information for daily maintenance.
    • Alerts should be set for all contract renewals to provide enough advanced notice (e.g. 90 days).
    • Reports should be automated to provide actionable information to appropriate stakeholders as needed.

    Define SAM reports to track metrics

    Associated Activity icon 1.2.3 Identify reports and metrics to track regularly

    Participants: CIO, IT Director, SAM Manager, SAM Team

    Document: Document in the Standard Operating Procedures.

    1. Identify key stakeholders requiring SAM reports. For each audience, identify their goals and requirements from reporting.
    2. Using the list of metrics identified previously, sort metrics into reports for each audience based on their requirements and goals. Add any additional metrics required.
    3. Identify a reporting frequency for each report.

    Example:

    Stakeholder Purpose Report Frequency
    Asset Manager
    • Manage budget
    • Manage contracts and cash flow
    • Ensure processes are being followed
    Operational budget spent to date Monthly
    Capital budget spent to date Monthly
    Contracts coming due for renewal Quarterly
    Software harvested for redeployment Quarterly
    Number of single applications being managed Annually
    CFO
    • Manage budget
    • Manage cash flow
    Software purchased, operational & capital Monthly
    Software accrued for future purchases Monthly
    Contracts coming due for renewal
    • Include dollar value, savings/spend
    Quarterly
    CIO
    • Resource planning
    • Progress reporting
    Software deployments and redeployments Monthly
    Software rollouts planned Quarterly
    % of applications patched Quarterly
    Money saved Annually
    Number of contracts & apps managed Quarterly

    Step 1.3 Plan the SAM program and budget

    Phase 1:
    Assess & Plan
    This step will walk you through the following activities:This step involves the following participants:

    1.1

    Assess current state
    • 1.3.1 Identify SAM functions to centralize vs. decentralize
    • 1.3.2 Complete the SAM budget tool
    • Project Sponsor
    • IT Director, CIO
    • IT Managers and SAM Manager
    • CFO

    1.2

    Build team and define metrics

    1.3

    Plan & budget

    Step Outcomes

    • Defined scope for the SAM program in terms of the degree of centralization of core functions and contracts
    • A clearer picture of software spend through the use of a SAM budgeting tool.

    Asset managers need to be involved in infrastructure projects at the decision-making stage

    Ensure that your software asset manager is at the table when making key IT decisions.

    Many infrastructure managers and business managers are unaware of how software licensing can impact projects. For example, changes in core infrastructure configuration can have big impacts from a software licensing perspective.

    Mini Case Study

    • When a large healthcare organization’s core infrastructure team decided to make changes to their environment, they failed to involve their asset manager in the decision-making process.
    • When the healthcare organization decided to make changes to their servers, they were running Oracle software on their servers, but the licenses were not being tracked.
    • When the change was being made to the servers, the business contacted Oracle to notify them of the change. What began as a tech services call quickly devolved into a licensing error; the vendor determined that the licenses deployed in the server environment were unauthorized.
    • For breaching the licensing agreement, Oracle fined the healthcare organization $250,000.
    • Had the asset manager been involved in the process, they would have understood the implications that altering the hardware configuration would have on the licensing agreement and a very expensive mistake could have been avoided.

    Decide on the degree of centralization for core SAM functions

    • Larger organizations with multiple divisions or business units will need to decide which SAM functions will be centralized and which, if any, will be decentralized as they plan the scope of their SAM program. Generally, certain core functions should be centralized for the SAM program to deliver the greatest benefits.
    • The degree of centralization may also be broken down by contract, with some contracts centralized and some decentralized.
    • A centralized SAM database gives needed visibility into software assets and licenses across the organization, but operation of the database may also be done locally.

    Centralization

    • Allows for more strategic planning
    • Visibility into software licenses across the organization promotes rationalization and cost savings
    • Ensure common products are used
    • More strategic sourcing of vendors and resellers
    • Centrally negotiate pricing for better deals
    • Easier to manage risk and prepare for audits
    • Greater coordination of resources

    Decentralization

    • May allow for more innovation
    • May be easier to demonstrate local compliance if the organization is geographically decentralized
    • May be easier to procure software if offices are in different countries
    • Deployment and installation of software on user devices may be easier

    Identify SAM functions to centralize vs. decentralize

    Associated Activity icon 1.3.1 Identify functions for centralization

    Participants: CIO, IT Director, SAM Manager, SAM Team

    Document: Document in the Standard Operating Procedures.

    1. If applicable, identify SAM functions that will need to be centralized and evaluate the implications of centralization to ensure it is feasible.
    2. If applicable, identify SAM functions that will be decentralized, if resources are available to manage those functions locally.

    Example:

    Centralized Functions
    • Operation of SAM database
    • SAM budget
    • Vendor selection
    • Contract negotiation and purchasing
    • Data analysis
    • Software receiving and inventory
    • Audits and risk management
    Decentralized functions
    • Procurement
    • Deployment and installation

    Software comprises the largest part of the infrastructure and operations budget

    After employee salaries (38%), the four next largest spend buckets have historically been infrastructure related. Adding salaries and external services, the average annual infrastructure and operations spend is over 50% of all IT spend.

    The largest portion of that spend is on software license and maintenance. As of 2016, software accounted for the roughly the same budget total as voice communications, data communications, and hardware combined. Managing software contracts is a crucial part of any mature budgeting process.

    Graph showing the percentage of all IT spend used for 'Ongoing software license and maintenance' annually. In 2010 it was 17%; in 2018 it was 21%. Graph showing the percentage of all IT spend used for 'Hardware maintenance / upgrades' annually. In 2010 it was 7%; in 2018 it was 8%. Graph showing the percentage of all IT spend used for 'Data communications' annually. In 2010 it was 7%; in 2018 it was 7%. Graph showing the percentage of all IT spend used for 'Voice communications' annually. In 2010 it was 5%; in 2018 it was 7%.

    Gain control of the budget to increase the success of SAM

    A sophisticated software asset management program will be able to uncover hidden costs, identify opportunities for rationalization, save money through reharvesting unused licenses, and improve forecasting of software usage to help control IT spending.

    While some asset managers may not have experience managing budgets, there are several advantages to the ITAM function owning the budget:

    • Be more involved in negotiating pricing with vendors.
    • Build better relationships with stakeholders across the business.
    • Gain greater purchasing power and have a greater influence on purchasing decisions.
    • Forecast software requirements more accurately.
    • Inform benchmarks and metrics with more data.
    • Directly impact the reduction in IT spend.
    • Manage the asset database more easily and have a greater understanding of software needs.
    • Identify opportunities for cost savings through rationalization.

    Examine your budget from a SAM perspective to optimize software spend

    How does examining your budget from a SAM perspective benefit the business?

    • It provides a chance to examine vendor contracts as they break down contracts by projects and services, which gives a clearer picture of where software fits into the budget.
    • It also gives organizations a chance to review vendor agreements and identify any redundancies present in software supporting services.

    Review the budget:

    • When reviewing your budget, implement a contingency fund to mitigate risk from a possible breach of compliance.
    • If your organization incurs compliance issues that relate to specific services, these fines may be relayed back to the departments that own those services, affecting how much money each department has.
    • The more sure you are of your compliance position, the less likely you are to need a contingency fund, and vice versa.

    Info-Tech Best Practice

    Finance needs to be involved. Their questions may cover:

    • Where are the monthly expenditures? Where are our financial obligations? Do we have different spending amounts based on what time of year it is?

    Use the SAM Budget Workbook to uncover insights about your software spend

    Supporting Tool icon 1.3.2 Complete the SAM budget tool

    The SAM Budget Workbook is designed to assist in developing and justifying the budget for software assets for the upcoming year.

    Instructions

    1. Work through tabs 2-6, following the instructions as you go.
    2. Tab 2 involves selecting software vendors and services provided by software.
    3. Tab 3 involves classifying services by vendor and assigning a cost to them. Tab 3 also allows you to classify the contract status.
    4. Tab 4 is a cost variance tracking sheet for software contracts.
    5. Tabs 5 and 6 are monthly budget sheets that break down software costs by vendor and service, respectively.
    6. Tab 7 provides graphs to analyze the data generated by the tool.
    7. Use the results found on tab 7 to analyze your budget: are you spending too much with one service? Is there vendor overlap based on what project or service that software is reporting?
    Screenshots of the 'Budget of Services Supported by Software Vendors' and 'Software Expense cashflow reports by Vendor' pages from the SAM Budget Workbook. Screenshot of the 'Analysis of Data' page from the SAM Budget Workbook.

    If you want additional support, have our analysts guide you through this phase as part of an Info-Tech Workshop Associated Activity icon

    Book a workshop with our Info-Tech analysts:

    Photo of an Info-Tech analyst.
    • To accelerate this project, engage your IT team in an Info-Tech workshop with an Info-Tech analyst team.
    • Info-Tech analyst will join you and your team onsite at your location or welcome you to Info-Tech's historic Toronto office to participate in an innovative onsite workshop.
    • Contact your account manager (www.infotech.com/account), or email Workshops@InfoTech.com for more information.

    The following are sample activities that will be conducted by Info-Tech analysts with your team:

    1.1.3

    Sample of activity 1.1.3 'Determine the maturity of your SAM program'. Determine the maturity of your SAM program

    Using the SAM Maturity Assessment Tool, fill out a series of questions in a survey to assess the maturity of your current SAM program. The survey assesses seven categories that will allow you to align your strategy to your results.

    1.2.3

    Sample of activity 1.2.3 'Define SAM reports to track metrics'. Define SAM reports to track metrics

    Identify key stakeholders with reporting needs, metrics to track to fulfill reporting requirements, and a frequency for producing reports.

    Phase 1 outline

    Associated Activity icon Call 1-888-670-8889 or email GuidedImplementations@InfoTech.com for more information.

    Complete these steps on your own, or call us to complete a guided implementation. A guided implementation is a series of 2-3 advisory calls that help you execute each phase of a project. They are included in most advisory memberships.

    Guided Implementation 1: Assess and Plan

    Proposed Time to Completion (in weeks): 4
    Step 1.1: Assess current state Step 1.2: Build team and define metrics Step 1.3: Plan and budget
    Start with an analyst kick-off call:
    • Outline SAM challenges
    • Overview of the project
    • Assess current maturity level
    Review findings with analyst:
    • Define roles and responsibilities of SAM staff
    • Identify metrics and reports to track
    Review findings with analyst:
    • Plan centralization of SAM program
    • Discuss SAM budgeting
    Then complete these activities…
    • Identify challenges
    • Identify objectives of SAM program
    • Assess maturity of current state
    Then complete these activities…
    • Define roles and responsibilities
    • Identify metrics and KPIs
    • Plan reporting
    Then complete these activities…
    • Identify SAM functions to centralize
    • Complete the SAM budgeting tool
    With these tools & templates:
    • SAM Maturity Assessment
    • Standard Operating Procedures
    With these tools & templates:
    • Standard Operating Procedures
    With these tools & templates:
    • SAM Budget Workbook

    Phase 2: Procure, Receive, and Deploy

    VISA used high-quality SAM data to optimize its software licensing

    Logo for VISA.

    Case Study

    Industry: Financial Services
    Source: SAM Summit 2014

    Challenge

    Visa formed a SAM team in 2011 to combat costly software audits.

    The team’s first task was to use the available SAM data and reconcile licenses deployed throughout the organization.

    Organizations as large as Visa constantly run into issues where they are grossly over or under licensed, causing huge financial risk.

    Solution

    Data collection and analysis were used as part of the license rationalization process. Using a variety of tools combined with a strong team allowed Visa to perform the necessary steps to gather license data and analyze usage.

    One of the key exercises was uniting procurement and deployment data and the teams responsible for each.

    End-to-end visibility allowed the data to be uniform. As a result, better decisions about license rationalization can be made.

    Results

    By improving its measurement of SAM data, Visa was able to dedicate more time to analyze and reconcile its licenses. This led to improved license management and negotiations that reflected actual usage.

    By improving license usage through rationalization, Visa reduced the cost of supporting additional titles.

    The SAM team also performed license reclamation to harvest and redistribute licenses to further improve usage. The team’s final task was to optimize audit responses.

    Step 2.1 Request and procure software

    Phase 2:
    Procure, Receive & Deploy
    This step will walk you through the following activities:This step involves the following participants:

    2.1

    Request & Procure
    • 2.1.1 Determine which software contracts should be centralized vs. localized
    • 2.1.2 Determine your software standards
    • 2.1.3 Define procurement policy
    • 2.1.4 Identify approvals and requests for authorization thresholds
    • 2.1.5 Build software procurement workflow for new contracts
    • 2.1.6 Define process for contract renewals and additional procurement scenarios
    • IT Director, CIO
    • IT Managers and SAM Manager
    • SAM Team

    2.2

    Receive & Deploy

    Step Outcomes

    • Defined standards for software requests
    • A documented policy for software procurement including authorization thresholds
    • Documented process workflows for new contracts and contract renewals

    Procurement and SAM teams must work together to optimize purchasing

    Procurement and SAM must collaborate on software purchases to ensure software purchases meet business requirements and take into account all data on existing software and licenses to optimize the purchase and contract. Failure to work together can lead to unnecessary software purchases, overspending on purchases, and undesirable contract terms.

    SAM managers must collaborate with Procurement when purchasing software.

    SAM managers should:

    • Receive requests for software licenses
    • Ensure a duplicate license isn’t already purchased before going through with purchase
    • Ensure the correct license is purchased for the correct individuals
    • Ensure the purchasing information is tracked in the ITAM/SAM tool
    • Report on software usage to inform purchases
    Two cartoon people in work attire each holding a piece of a puzzle that fits with the other. Procurement must commit to be involved in the asset management process.

    Procurement should:

    • Review requests and ensure all necessary approvals have been received before purchasing
    • Negotiate optimal contract terms
    • Track and manage purchasing information and invoices and handle financial aspects
    • Use data from SAM team on software usage to decide on contract terms and optimize value

    Centralize procurement to decrease the likelihood of overspending

    Centralized negotiation and purchasing of software can ensure that the SAM team has visibility and control over the procurement process to help prevent overspending and uncontrolled agreements.

    Benefits of centralized procurement

    • Ability to easily manage software demand.
    • Provides capability to effectively manage your relationships with suppliers.
    • Allows for decreased contract processing times.
    • Provides easy access to data with a single consolidated system for tracking assets at an early stage.
    • Reduces number of rogue purchases by individual departments.
    • Efficiency through automation and coordinated effort to examine organization’s compliance and license position.
    • Higher degree of visibility and transparency into asset usage in the organization.

    Info-Tech Insights

    It may be necessary to procure some software locally if organizations have multiple locations, but try to centrally procure and manage the biggest contracts from vendors that are likely to audit the organization. Even with a decentralized model, ensure all teams communicate and that contracts remain visible centrally even if managed locally.

    Standards for software procurement help prevent overspending

    Software procurement is often more difficult for organizations than hardware procurement because:

    • Key departments that need to be involved in the purchasing process do not communicate or interact enough.
    • A fear of software auditing causes organizations to overspend to mitigate risk.
    • Standards are often not in place, with most purchases being made outside of the gold imaging standard.
    • A lack of discovery results in gross overspending on software licenses that are already present and underused.

    Info-Tech Insight

    One of the major challenges involved in implementing SAM is uniting multiple datasets and data sources across the enterprise. A conversation with each major business unit will help with the creation of software procurement standards that are acceptable to all.

    Determine which software contracts should be centralized vs. localized (optional)

    Associated Activity icon 2.1.1 Identify central standard enterprise offerings

    Participants: CIO, IT Director, SAM Manager, SAM Team

    Document: Document in the Standard Operating Procedures.

    1. As a group, list as many software contracts that are in place across the organization as can easily be identified, focusing on top vendors.
    2. Identify which existing software contracts are standard enterprise offerings that are procured and managed centrally and which are non-standard or localized applications.
    3. Looking at the list of non-standard software, identify if any can or should be rationalized or replaced with a standard offering.
    Standard enterprise offerings
    • Microsoft
    • IBM
    • Adobe
    • Dell
    • Cisco
    • VMware
    • Barracuda
    Localized or non-standard software

    Classify your approved software into tiers to improve workflow efficiency

    Not all titles are created equal; classifying your pre-approved and approved software titles into a tiered system will provide numerous benefits for your SAM program.

    The more prestigious the asset tier, the higher the degree of data capture, support, and maintenance required.

    • Mission-critical, high-priority applications are classified as gold standard.
    • Secondary applications or high priority are silver standard.
    • Low-usage applications or normal priority are bronze standard.

    E.g. An enterprise application that needs to be available 24/7, such as a learning management system, should be classified as a gold tier to ensure it has 24/7 support.

    Creating tiers assists stakeholders in justifying the following set of decision points:

    • Which assets will require added maintenance (e.g. software assurance for Microsoft)
    • Technical support requirements to meet business requirements
    • Lifecycle and upgrade cycle of the software assets.
    • Monitoring usage to determine whether licenses can be harvested
    • Authorizations required for purchase requests

    Determine your software standards

    Associated Activity icon 2.1.2 Identify standard software images for your organization

    Participants: Asset Manager, Purchasing, Service Desk Manager, Operations (optional)

    Document: Document in the Standard Operating Procedures.

    1. As a group, discuss and identify the relevant software asset tiers and number of tiers.
    2. For each tier, define:
      • Support requirements (hours and payments)
      • Maintenance requirements (mandatory or optional)
      • Lifecycle (when to upgrade, when to patch)
      • Financial requirements (CapEx/OpEx expenses)
      • Request authorizations (requestors and approvers)
    3. Sort the software contracts identified in the previous category into tiers, for example:
      • Mission-critical software (gold tier)
      • High-priority software (silver tier)
      • Normal-priority software (bronze tier)
    4. Use the SOP as an example.

    Determine which licensing options and methodologies fit into future IT strategy

    Not everyone is ready to embrace the cloud for all solutions; make sure to align cloud strategy to business requirements. Work closely with IT executives to determine appropriate contract terms, licensing options, and tracking processes.

    Vendors make changes to bundles and online services terms on a regular basis. Ensure you document your agreed upon terms to save your required functionality as vendor standard offerings change.

    • Any contracts getting moved to the cloud will need to undergo a contract comparison first.
    • The contract you signed last month could be completely different this month. Many cloud contracts are dynamic in nature.
    • Keep a copy of the electronic contract that you signed in a secure, accessible location.
    • Consider reaching a separate agreement with the vendor that they will ensure you maintain the results of the original agreement to prevent scope creep.

    Not all on-premises to cloud options transition linearly:

    • Features of perpetual licenses may not map to subscriptions
    • Product terms may differ from online services terms
    • Licensing may change from per device to per user
    • Vendor migrations may be more complex than anticipated

    Download the Own the Cloud: Strategy and Action Plan blueprint for more guidance

    Understand the three primary models of software usage agreements

    Licensed Open Source Shareware
    License Structure A software supplier is paid for the permission to use their software. The software is provided free of charge, but is still licensed. The software is provided free of charge, but is still licensed. Usage may be on a trial basis, with full usage granted after purchase.
    Source Code The source code is still owned by the supplier. Source code is provided, allowing users to change and share the software to suit their needs. Source code is property of the original developer/supplier.
    Technical Support Technical support is included in the price of the contract. Technical support may be provided, often in a community-based format from other developers of the open-source software in question. Support may be limited during trial of software, but upgraded once a purchase is made.

    Info-Tech Insight

    Open-source software should be managed in the same manner as commercial software to understand licensing requirements and be aware of any changes to these agreements, such as commercialization of such products, as well as any rules surrounding source code.

    Coordinate with purchasing department to define software procurement policy

    Associated Activity icon 2.1.3 Define procurement policy

    Participants: Asset Manager, Purchasing, Service Desk Manager, Operations (optional)

    Document: Document in the Standard Operating Procedures.

    Define and document policies that will apply to IT software purchases, including policies around:

    • Software purchase approvals
    • Licenses for short-term contractors
    • On-premises vs. SaaS purchases
    • Shareware and freeware fees
    • Open-source software

    Use the example below as guidance and document in the SOP.

    • Software will not be acquired through user corporate credit cards, office supply, petty cash, or personal expense budgets. Purchases made outside of the acceptable processes will not be reimbursed and will be removed from company computers.
    • Contractors who are short term and paid through vendor contracts and invoices will supply their own licenses.
    • Software may be purchased as on-premises or as-a-service solutions as IT deems appropriate for the solution.
    • Shareware and freeware authors will be paid the fee they specify for use of their products.
    • Open-source software will be managed in the same manner as commercial software to understand licensing requirements and be aware of any changes to these agreements, such as commercialization of such products.

    Identify approvals and requests for authorization thresholds

    Associated Activity icon 2.1.4 Identify financial thresholds for approvals and requests

    Participants: Asset Manager, Purchasing, CIO, CFO, IT Director

    Document: Document in the Standard Operating Procedures.

    Identify and classify financial thresholds for contracts requiring approval. For each category of contract value, identify who needs to authorize the request. Discuss and document any other approvals necessary. An example is provided below.

    Example:
    Requests for authorization will need to be directed based on the following financial thresholds:

    Contract value Authorization
    <$50,000 IT Director
    $50,000 to $250,000 CIO
    $250,000 to $500,000 CIO and CFO
    >$500,000 Legal review

    Develop a defined process for software procurement

    A poorly defined software procurement workflow can result in overspending on unnecessary software licensing throughout the year. This can impact budgeting and any potential software refreshes, as businesses will often rely on purchasing what they can afford, not what they need.

    Benefits of a defined workflow

    • Standardized understanding of the authorization processes results in reduced susceptibility to errors and quicker processing times.
    • Compliance with legal regulations.
    • Protection from compliance violations.
    • Transparency with the end user by communicating the process of software procurement to the business.

    Elements to include in procurement workflows:

    • RFP
    • Authorizations and approvals
    • Contract review
    • Internal references to numbers, cost centers, locations, POs, etc.

    Four types of procurement workflows:

    1. New contract – Purchasing brand new software
    2. Add to contract – Adding new POs or line items to an existing contract
    3. Contract renewal – Renewing an existing contract
    4. No contract required – Smaller purchases that don’t require a signed contract

    Outline the procurement process for new contracts

    The procurement workflow may involve the Service Desk, procurement team, and asset manager.

    The following elements should be accounted for:

    • Assignee
    • Requestor
    • Category
    • Type
    • Model or version
    • Requisition number
    • Purchase order number
    • Unit price
    A flowchart outlining the procurement process for new contracts. There are three levels, at the top is 'Tier 2 or Tier 3', the middle is 'IT Procurement', the bottom is 'Asset Manager'. It begins in 'Tier 2 or Tier 3' with 'Approved request received', and if it is not declined it moves on to 'Purchasing request forwarded to Procurement' on the 'IT Procurement' level. If an RFP is required, it eventually moves to 'Receives contract' on the 'Asset Manager' level and ends with 'Document license requirements, notify IT Product Owner'.

    Build software procurement workflow for new contracts

    Associated Activity icon 2.1.5 Build new contract procurement workflow

    Participants: Asset Manager, Purchasing, Service Desk Manager, Operations (optional)

    Document: Document in the Standard Operating Procedures.

    1. As a team, outline each of the tasks in the process of procuring a new software asset using cue cards, sticky notes, or a whiteboard.
    2. Use the sample procurement workflow on the previous slide as an example if needed.
    3. Ensure the following elements required for the asset procurement process have been accounted for:
      • Assignee
      • Requestor
      • Category
      • Type
      • Model or version
      • Requisition number
      • Purchase order number
      • Unit price
    4. Review the workflow and make any adjustments necessary to improve the process. Document using Visio and add to the SOP.

    Review vendor contracts to right-size licensing procurement

    Many of your applications come from the same vendor, and a view into the business services provided by each software vendor contract will prove beneficial to the business.

    • You may uncover overlaps in services provided by software across departments.
    • The same service may be purchased from different vendors simply because two departments never compared notes!
    • This leaves a lot of money on the table from a lack of volume discounts.
    A graphic depicting a Venn diagram in which the 'Software' and 'Services' circles overlap, both of which stem from a 'Vendor Contract'.
    • Be cautious about approaching license budgeting strictly from a cost perspective. SAM is designed to right-size your licenses to properly support your organization.
    • One trap organizations often fall into is bundling discounts. Vendors will offer steep discounts if clients purchase multiple titles. On the surface, this might seem like a great offer.
    • However, what often happens is that organizations will bundle titles to get a steep discount on their prize title of the group.
    • The other titles become shelfware, and when the time comes to renew the contract, the maintenance fees on the shelfware titles will often make the contract more expensive than if only the prize title was purchased.

    Additionally, information regarding what licenses are being used for certain services may yield insight into potential redundancies. For example, two separate departments may have each have a different application deployed that supports the same service. This presents an opportunity for savings based on bulk licensing agreements, not to mention a simplified support environment by reducing the number of titles deployed in your environment.

    Define a procedure for tracking and negotiating contract renewals

    Participants: IT Director/CIO, Asset Manager, Purchasing, Service Desk Manager, Operations (optional)

    Document: Document in the Standard Operating Procedures.

    Discuss and document a policy for tracking and negotiating contract renewals. Answer the following questions as guides:

    • How will renewal dates be tracked and monitored?
    • How soon should contracts be reviewed prior to renewal to determine appropriateness for use and compliance?
    • What criteria will be used to determine if the product should be renewed?
    • Who will be consulted for contract renewal decisions for major contracts?
    • How will licensing and support decisions be made?

    Optional contract review:

    1. Take a sample contract to renew. Create a list of services that are supported by the software. Look for overlaps, redundancies, shelfware, and potential bundling opportunities. Recall the issues outlined when purchasing bundled software.
    2. Create a list of action items to bring into the next round of contract negotiations with that vendor and identify a start date to begin reviewing these items.

    Define process for contract renewals and additional procurement scenarios

    Associated Activity icon 2.1.6 Build additional procurement workflows

    Participants: Asset Manager, Purchasing, Service Desk Manager, Operations (optional)

    Document: Document in the Standard Operating Procedures.

    Build procurement workflows and define policies and procedures for additional purchasing scenarios beyond new contracts.

    This may include:

    1. Contract renewals
    2. Single purchase, non-contract procurement
    3. Adding to contracts

    Use the sample workflows in the Standard Operating Procedures as a guide.

    A flowchart outlining the procurement process for 'Software Contract Renewal'.

    A flowchart outlining the procurement process for 'Software single purchase, non-contract'.

    Negotiate for value to ensure quality license agreements

    Approach negotiating from a value-first, price-second perspective.

    Contract negotiations too often come down to a question of price. While you want to avoid overpaying for licenses, a worse offense is getting a steep discount for a bundle of applications where the majority will go unused.

    Vendors will try to sell a full stack of software at a steep discount to give the illusion of value. Often organizations bite off more than they can chew. When auditors come knocking, the business may be in compliance, but being over-licensed is a dangerous state to be in. Organizations end up over-licensed and in possession of numerous “shelfware” apps that sit on the proverbial shelf collecting dust while drawing expensive maintenance and licensing fees from the business.
    • Pressure from the business is also an issue. Negotiations can be rushed in an effort to fulfill an immediate need.
    • Make sure you clearly outline the level of compliance expected from the vendor.
    • Negotiate reduced-fee software support services. Your Service Desk can already handle the bulk of requests, and investing in a mature Service Desk will provide more lasting value than paying for expensive maintenance and support services that largely go unused.

    Learn to negotiate effectively to optimize contract renewals

    Leverage Info-Tech’s research, Master Contract Review and Negotiation for Software Agreements, to review your software contracts to leverage your unique position during negotiations and find substantial cost savings.

    This blueprint includes the following tools and templates:

    • RASCI Chart
    • Vendor Communication Management Plan
    • Software Business Use Case Template
    • SaaS TCO Calculator
    • Software Terms & Conditions Evaluation Tool
    • Software Buyer’s Checklist
    • Controlled Vendor Communications Letter
    • Key Vendor Fiscal Year End Calendar
    • Contract Negotiation Tactics Playbook

    Step 2.2 Receive and deploy software

    Phase 2:
    Procure, Receive & Deploy
    This step will walk you through the following activities:This step involves the following participants:

    2.1

    Request & Procure
    • 2.2.1 Identify storage locations for software information and media
    • 2.2.2 Design the workflow for receiving software
    • 2.2.3 Design and document the deployment workflow(s)
    • 2.2.4 Create a list of pre-approved, approved, and unapproved software titles
    • 2.2.5 Document the request and deployment process for non-standard software requests
    • IT Director, CIO
    • IT Managers and SAM Manager
    • SAM Team
    • Purchasing (optional)
    • Service Desk Manager (optional)
    • Operations (optional)
    • Release & Deployment manager (optional)

    2.2

    Receive & Deploy

    Step Outcomes

    • A strategy for storing software information and media in the ITAM database and DML
    • A documented workflow for the software receiving process
    • Documented process workflows for software requests and deployment, including for large quantities of software
    • A list of pre-approved, approved, and unapproved software titles for deployment
    • A process for responding to non-standard software requests

    Verify product and information upon receipt

    Upon receipt of procured software:

    • Verify that the product is correct
    • Reconcile with purchase record to ensure the order has been completed
    • Verify that the invoice is correct
    • Update financial information such as budget and accounting records
    • Update ITAM database to show status as received
    • Record/attach license keys and software codes in ITAM database
    • Attach relevant documents to record in the ITAM database (license reports, invoices, end-user agreement, etc.)
    • Download and store any installation files, DVDs, and CDs
    • Once software has been installed, verify license is matched to discovered installed software within the ITAM database

    Info-Tech Best Practice

    While most software will be received through email and download, in some cases physical software may be received through courier or mail. Ensure processes and procedures are defined for both cases.

    Establish a secure repository for licenses and documentation

    All licenses, documentation, and digital media for authorized and supported software should be collected and stored in a central, secure location to minimize risk of theft, loss, or unauthorized installation or duplication of software.

    Where to store software data?

    The ITAM database should contain an up-to-date record of all software assets, including their associated:

    • Serial numbers
    • License keys and codes
    • Contracts and agreements

    The database allows you to view software that is installed and associated licenses.

    A definitive media library (DML) is a single logical storage area, which may consist of one or more locations in which definitive authorized versions of all software configuration items are securely stored and protected.

    The DML consists of file storage as well as physical storage of CDs and DVDs and must be continually updated to contain the latest information about each configuration item.

    The DML is used to organize content and link to automated deployment to easily install software.

    Use a definitive media library (DML) to assist in storage of software packages for deployment

    The DML will usually contain the most up-to-date versions to minimize errors created by having unauthorized, old, or problematic software releases being deployed into the live IT environment. The DML can be used for both full-packed product (FPP) software and in-house developed software, providing formalized data around releases of in-house software.

    The DML should consist of two main storage areas:

    1. Secure file storage
    2. Secure physical storage for any master CD/DVDs

    Additional Recommendations:

    • The process of building, testing, adapting, and final pre-production testing should provide your IT department with a solid final deployment package, but the archive will enable you to quickly pull in a previous version if necessary.
    • When upgrading software packages to include new patches or configurations, use the DML to ensure you're referencing a problem-free version.
    • Include the DML in your disaster recovery plan (DRP) and include testing of the DML as part of your DRP testing. If you need to rebuild servers from these files, offsite, you'll want to know your backup DML is sound.

    Ensure you have a strategy to create and update your DML

    Your DML should have a way to separate archived, new, and current software to allow for optimal organization of files and code, to ensure the correct software is installed, and to prepare for automated deployment through the service catalog.

    New software hasn’t been tested yet. Make it available for testing, but not widely available.

    Keep a record for archived software, but do not make it available for install.

    Current software is regularly used and should be available for install.

    Deployment

    • Are you using tools to integrate with the DML for deployment?
    • Store files that are ready for automated deployment in a separate location.

    Identify storage locations for software information and media

    Associated Activity icon 2.2.1 Identify software storage locations

    Participants: Asset Manager, IT Director

    Document: Document in the Standard Operating Procedures.

    1. Identify storage locations for asset data that is received (i.e. ITAM database, DML).
    2. Identify information that should be stored with each asset (i.e. license, serial number, invoice, end-user license agreement) and where this information should be stored.
    3. Identify fields that should be populated in the DML for each record:
      • Product name
      • Version
      • Description
      • Authorized by
      • Received by/date
      • Configuration item on which asset is installed
      • Media
      • Physical and backup locations
      • Verified by/date

    Define the standard process for receiving software

    Define the following in your receiving process:

    • Process for software received by email/download
    • Process for physical material received at Service Desk
    • Information to be recorded and where
    • Process following discrepancy of received software
    A flowchart outlining the standard process for receiving software. There are two levels, at the top is 'Desktop Support Team' and the bottom is 'Procurement'. It begins in 'Desktop Support Team' with 'Received at Service Desk' or 'Receive by email/download'. If the reconciliation is correct it eventually moves on to 'Fulfill service request, deliver and close ticket'. If the reconciliation is not correct it moves to 'Contact vendor with discrepancy details' in 'Procurement'. If a return is required 'Repackage and ship', or if not 'Notify Desktop Support Team of resolution'.

    Design the workflow for receiving software

    Associated Activity icon 2.2.2 Design the workflow for receiving software

    Participants: Asset Manager, Purchasing, Service Desk Manager, Operations (optional)

    Document: Document in the Standard Operating Procedures.

    Option 1: Whiteboard

    1. Discuss the workflow and draw it on the whiteboard.
    2. Assess whether you are using the best workflow. Modify it if necessary.
    3. Use the sample workflow from this step as a guide if starting from scratch.
    4. Engage the team in refining the process workflow.
    5. Transfer data to Visio and add to the SOP.

    Option 2: Tabletop Exercise

    1. Distribute index cards to each member of the team.
    2. Have each person write a single task they perform on the index card. Be granular. Include the title or the name of the person responsible.
    3. Mark cards that are decision points. Use a card of a different color or use a marker to make a colored dot.
    4. Arrange the index cards in order, removing duplicates.
    5. Assess whether you are using the best workflow. Engage the team to refine it if necessary.
    6. Transfer data to Visio and add to the SOP.

    Build release management into your software deployment process

    A sound software deployment process is tied to sound release management practices.

    Releases: A collection of authorized changes to an IT service. Releases are divided into:

    • Major software releases/upgrades: Normally containing large areas of new functionality, some of which may make intervening fixes to redundant problems.
    • Minor software releases/upgrades: Normally containing small enhancements and fixes, some of which may have already been issued as emergency fixes.
    • Emergency software fixes: Contain the corrections to a small number of known problems.

    Ensure that release management processes work with SAM processes:

    • If a release will impact licensing, the SAM manager must be made aware to make any necessary adjustments.
    • Deployment models should be in line with SAM strategy (i.e. is software rolled out to everyone or individually when upgrades are needed?).
    • How will user requests for upgrades be managed?
    • Users should be on the same software version to ensure file compatibility and smooth patch management.
    • Ideally, software should be no more than two versions back.

    Document the process workflow for software deployment

    Define the process for deploying software to users.

    Include the following in your workflow:

    • All necessary approvals
    • Source of software
    • Process for standard vs. non-standard software requests
    • Update ITAM database once software has been installed with license data and install information
    A flowchart outlining the process workflow for software deployment. There are four levels, at the top is 'Business', then 'Desktop Support Team', 'Procurement', and the bottom is 'Asset Manager'. It begins in 'Business' with 'Request for software', and if it is approved by the manager it moves to 'Check DB: Can a volume serial # be used?' in 'Desktop Support Team'. If yes, it eventually moves on to 'Close ticket' on the same level, if not it eventually moves to 'Initiate procurement process' in 'Procurement', 'Initiate receiving process' in 'Asset Manager', and finally to 'Run quarterly license review to purchase volume licenses'.

    Large-scale software rollouts should be run as projects

    Rollouts or upgrades of large quantities of software will likely be managed as projects.

    These projects should include project plans, including resources, timelines, and detailed procedures.

    Define the process for large-scale deployment if it will differ from the regular deployment process.

    A flowchart outlining large-scale software rollouts. There are three levels, at the top is 'IT Procurement', then 'Asset Manager', and the bottom is 'Software Packager'. It begins in 'IT Procurement' with 'Project plan approved', and if a bid is not required it skips to 'Sign contract/Create purchase order'. This eventually moves to 'Receive access to eLicense site/receive access to new product' in 'Asset Manager', and either to 'Approve invoice for payment, forward to accounting' on the same level or to 'Download software, license keys' in 'Software Packager' then eventually to 'Deploy'.

    Design and document the deployment workflow(s)

    Associated Activity icon 2.2.3 Document deployment workflows for desktop and large-scale deployment

    Participants: Asset Manager, Service Desk Manager, Release & Deployment Manager

    Document: Document in the Standard Operating Procedures.

    1. Outline each step in the process of software deployment using notecards or on a whiteboard. Be as granular as possible. On each card, describe the step and the individual responsible for each step.
      • Be sure to identify the type of release for standard software releases and patches.
      • Additionally, identify how additional software outside the scope of the base image will be addressed.
    2. When you are satisfied that each step is accurately captured, use a second color of notecard to document any challenges, inefficiencies, or pains associated with each step. Consider further documenting the time on each task.
    3. Examine each challenge or pain point. Discuss whether there is a clear solution to the problem. If so, document the solution and amend the workflow. If not, engage in a broader discussion of possible solutions, considering people, processes, and available technology.
    4. Document separately the process for large-scale software deployment if required.

    Develop standards to streamline your software estate

    Software should be approved and deployed based on approved standards to minimize over-deployed software and manage costs appropriately. A list of standard software improves the efficiency of the software approval process.

    • Pre-approved titles include basic platforms like Office or Adobe Reader that are often available in enterprise-wide license packages.
    • Approved titles include popular titles with license numbers that need to be managed on a role-by-role basis. For example, if most of your marketing team uses the Adobe Creative Suite, a user still needs to get approval before they can get a license.
    • Unapproved titles are managed on a case-by-case basis and are up to the discretion of the asset manager and other involved parties.

    Additionally, create a list of unauthorized software including titles not to be installed under any circumstances. This list should be designed with feedback from your end users and technical support staff. Front-line knowledge is crucial to identifying which titles are causing major problems.

    Create a list of pre-approved, approved, and unapproved software titles

    Associated Activity icon 2.2.4 Determine software categories for deployment

    Participants: IT Director, Asset Manager, Purchasing (optional), Service Desk Manager (optional), Release & Deployment Manager (optional)

    Document: Document in the Standard Operating Procedures.

    1. Define software categories that will be used to build software standards.
    2. Include definitions of each category.
    3. Add examples of software to each category to begin building list of approved software titles for deployment.

    Use the following example as a guide.

    Category Definition Software titles
    Pre-approved/standard
    • Supported and approved for install for all end users
    • Included on most, if not all devices
    • Typically installed as a base image
    • Microsoft Office (Outlook, Word, Excel, PowerPoint)
    • Adobe Reader
    • Windows
    Approved by role
    • Supported and approved for install, but only for certain groups of end users
    • Popular titles with license numbers that need to be managed on a role-by-role basis
    • Pre-approved for purchase with business manager’s approval
    • Adobe Creative Cloud Suite
    • Adobe Acrobat Pro
    • Microsoft Visio
    Unapproved/requires review
    • Not previously approved or installed by IT
    • Special permission required for installation based on demonstrable business need
    • Managed on a case-by-case basis
    • Up to the discretion of the asset manager and other involved parties
    • Dynamics
    • Zoom Text
    • Adaptive Insights
    Unauthorized
    • Not to be installed under any circumstances
    • Privately owned software
    • Pirated copies of any software titles
    • Internet downloads

    Define the review and approval process for non-standard software

    Software requiring review will need to be managed on a case-by-case basis, with approval dependent on software evaluation and business need.

    The evaluation and approval process may require input from several parties, including business analysts, Security, technical team, Finance, Procurement, and the manager of the requestor’s department.

    A flowchart outlining the review and approval process for non-standard software. There are five levels, at the top is 'Business Analyst/Project Manager', then 'Security Team', 'Technical Team', 'Financial & Contract Review' and the bottom is 'Procurement'. It begins in 'Business Analyst/Project Manager' with 'Request for non-standard software', and if the approved product is available it moves to 'Evaluate tool for security, data, and privacy compliance' in 'Security Team'. If more evaluation is necessary it moves to 'Evaluate tool for infrastructure and integration requirements' in 'Technical Team', and then 'Evaluate terms and conditions' in 'Financial & Contract Review'. At any point in the evaluation process it can move back to the 'Business Analyst/Project Manager' level for 'Assemble requirements details', and finally down to the 'Procurement' level for 'Execute purchase'.

    Document the request and deployment process for non-standard software

    Associated Activity icon 2.2.5 Document process for non-standard software requests

    Participants: Asset Manager, Service Desk Manager, Release & Deployment Manager

    Document: Document in the Standard Operating Procedures.

    Define the review and approval process for non-standard software requests.

    Use the workflow on the previous slide as a guide to map your own workflow process and document the steps in the Standard Operating Procedures.

    The following assessments may need to be included in the process:

    • Functionality and use requirements: May include suggestion back to the business before proceeding any further to see if similar, already approved software could be used in its place.
    • Technical specifications: Cloud, data center, hardware, backups, integrations (Active Directory, others), file, and program compatibility.
    • Security: Security team may need to assess to ensure nothing will install that will compromise data or systems security.
    • Privacy policy: Security and compliance team may need to evaluate the solution to ensure data will be secured and accessed only by authorized users.
    • Terms and conditions: The contracts team may evaluate terms and conditions to ensure contracts and end-user agreements do not violate existing standards.
    • Accessibility and compliance: Software may be required to meet accessibility requirements in accordance with company policies.

    BMW deployed a global data centralization program to achieve 100% license visibility

    Logo for BMW.

    Case Study

    Industry: Financial Services
    Source: SAM Summit 2014

    Challenge

    BMW is a large German automotive manufacturer that employs over 100,000 people. It has over 7,000 software products deployed across 106,000 clients and servers in over 150 countries.

    When the global recession hit in 2008, the threat of costly audits increased, so BMW decided to boost its SAM program to cut licensing costs. It sought to centralize inventory data from operations across the globe.

    Solution

    A new SAM office was established in 2009 in Germany. The SAM team at BMW began by processing all the accumulated license and installation data from operations in Germany, Austria, and the UK. Within six months, the team had full visibility of all licenses and software assets.

    Compliance was also a priority. The team successfully identified where they could make substantial reductions in support and maintenance costs as well as remove surplus costs associated with duplicate licensing.

    Results

    BMW overcame a massive data centralization project to achieve 100% visibility of its global licensing estate, an incredible achievement given the scope of the operation.

    BMW experienced efficiency gains due to transparency and centralized management of licenses through the new SAM office.

    Additionally, internal investment in training and technical knowledge has helped BMW continuously improve the program. This has resulted in ongoing cost reductions for the manufacturer.

    If you want additional support, have our analysts guide you through this phase as part of an Info-Tech Workshop Associated Activity icon

    Book a workshop with our Info-Tech analysts:

    Photo of an Info-Tech analyst.
    • To accelerate this project, engage your IT team in an Info-Tech workshop with an Info-Tech analyst team.
    • Info-Tech analyst will join you and your team onsite at your location or welcome you to Info-Tech's historic Toronto office to participate in an innovative onsite workshop.
    • Contact your account manager (www.infotech.com/account), or email Workshops@InfoTech.com for more information.

    The following are sample activities that will be conducted by Info-Tech analysts with your team:

    2.1.5

    Sample of activity 2.1.5 'Build software procurement workflow for new contracts'. Build software procurement workflow for new contracts

    Use the sample workflow to document your own process for procurement of new software contracts.

    2.2.4

    Sample of activity 2.2.4 'Create a list of pre-approved, approved, and unapproved software titles'. Create a list of pre-approved, approved, and unapproved software titles

    Build definitions of software categories to inform software standards and brainstorm examples of each category.

    Phase 2 outline

    Associated Activity icon Call 1-888-670-8889 or email GuidedImplementations@InfoTech.com for more information.

    Complete these steps on your own, or call us to complete a guided implementation. A guided implementation is a series of 2-3 advisory calls that help you execute each phase of a project. They are included in most advisory memberships.

    Guided Implementation 2: Procure, receive, and deploy

    Proposed Time to Completion (in weeks): 6
    Step 2.1: Request and procureStep 2.2: Receive and deploy
    Start with an analyst kick-off call:
    • Define standards for software requests
    • Build procurement policy
    • Define procurement processes
    Review findings with analyst:
    • Build processes for software receiving
    • Build processes for software requests and deployment
    • Define process for non-standard requests
    Then complete these activities…
    • Determine software standards
    • Define procurement policy
    • Identify authorization thresholds
    • Build procurement workflows for new contracts and renewals
    Then complete these activities…
    • Identify storage locations for software information
    • Design workflow for receiving software
    • Design workflow for software deployment
    • Create a list of approved and non-standard requests
    • Define process for non-standard requests
    With these tools & templates:
    • Standard Operating Procedures
    With these tools & templates:
    • Standard Operating Procedures

    Phase 3: Manage, Redeploy, and Retire

    Step 3.1 Manage and maintain software contracts

    Phase 3:
    Manage, Redeploy & Retire
    This step will walk you through the following activities:This step involves the following participants:

    3.1

    Manage & Maintain Software
    • 3.1.1 Define process for conducting software inventory
    • 3.1.2 Define policies for software maintenance and patches
    • 3.1.3 Document your patch management policy
    • IT Director, CIO
    • IT Managers and SAM Manager
    • SAM Team
    • Release Manager (optional)
    • Security (optional)

    3.2

    Harvest, Redeploy, or Retire

    Step Outcomes

    • A process for conducting regular software inventory checks and analyzing the data to continually manage software assets and license compliance.
    • An understanding of software maintenance requirements
    • A policy for conducting regular software maintenance and patching
    • A documented patch management policy

    Manage your software licenses to decrease your risk of overspending

    Many organizations fail to track their software inventory effectively; the focus often remains on hardware due to its more tangible nature. However, annual software purchases often account for a higher IT spend than annual hardware purchases, so it’s important to track both.

    Benefits of managing software licenses

    • Better control of the IT footprint. Many companies already employ hardware asset management, but when they employ SAM, there is potential to save millions of dollars through optimal use of all technology assets.
    • Better purchasing decisions and negotiating leverage. Enhanced visibility into actual software needs means not only can companies procure and deploy the right increments of software in the right areas, but they can also do so more cost-effectively through tools such as volume purchase agreements or bundled services.
    • No refund policy combined with shelfware (software that sits unused “on the shelf”) is where software companies make their money.
    • Managing licenses will help prevent costly audit penalties. Special attention should be paid to software purchased from large vendors such as Microsoft, Oracle, Adobe, SAP, or IBM.

    Maintain a comprehensive, up-to-date software inventory to manage licenses effectively

    A clearly defined process for inventory management will reduce the risk of over buying licenses and falling out of compliance.

    • A detailed software inventory and tracking system should act as a single point of contact for all your license data.
    • Maintain a comprehensive inventory of installed software through complete and accurate records of all licenses, certifications, and software purchase transactions, storing these in a secure repository.
    • Periodically review installed software and accompanying licenses to ensure only legal and supported software is in use and to ensure ongoing compliance with the software management policy.

    Info-Tech Best Practice

    Have and maintain a list of supported software to guide what new software will be approved for purchase and what current software should be retained on the desktops, servers, and other processing devices.

    Conduct a baseline inventory of deployed software to know what you have

    You have to know what you have before you can manage it.

    A baseline inventory tells you exactly what software you have deployed and where it is being used. This can help to determine how to best optimize software and license usage.

    A software inventory will allow you to:

    • Identify all software residing on computers.
    • Compare existing software to the list of supported software.
    • Identify and delete illegal or unsupported software.
    • Identify and stop software use that violates license agreements, copyright law, or organizational policies.

    Two methods for conducting a software inventory:

    1. If you have several computers to analyze, use automated tools to conduct inventory for greater accuracy and efficiency. Software inventory or discovery tools scan installed software and generate inventory reports, while asset management tools will help you manage that data.
    2. Manual inventory may be possible if your organization has few computers.

    How to conduct a manual software inventory:

    1. Record serial number of device being analyzed.
    2. Record department and employee to whom the computer is assigned.
    3. Inspect contents of hard drive and/or server to identify software as well as hidden files and directories.
    4. Record licensing information for software found on workstation and server.
    5. Compare findings with list of supported software and licenses stored in repository.

    Keep the momentum going through regular inventory and licensing checks

    Take preventive action to avoid unauthorized software usage through regular software inventory and license management:

    • Regularly update the list of supported software and authorized use.
    • Monitor and optimize software license usage.
    • Continually communicate with and train employees around software needs and policies.
    • Maintain a regular inventory schedule to keep data up to date and remain compliant with licensing requirements – your specific schedule will depend on the size of the company and procurement schedule.
    • Conduct random spot inventories – even if you are using a tool, periodic spot checks should still be performed to ensure accuracy of inventory.
    • Periodically review software procurement records and ensure procurement process is being followed.
    • Continuously monitor software installations on networked computers through automated tools.
    • Ensure software licensing documentation and data is secure.

    Define process for conducting software inventory

    Associated Activity icon 3.1.1 Define process for regular software inventory

    Participants: IT Director, Asset Manager

    Document: Document in the Standard Operating Procedures.

    1. If a baseline software inventory has not been conducted, discuss and document a plan for completing the inventory.
      • Will the inventory be conducted manually or through automated tools?
      • If manually, what information will be collected and recorded? Which devices will be analyzed? Where will data be stored?
      • If automatically, which tools will be used? Will any additional information need to be collected? Who will have access to the inventory?
      • When will the inventory be conducted and by whom?
        • Monthly inventory may be required if there is a lot of change and movement, otherwise quarterly is usually sufficient.
    2. Document how inventory data will be analyzed.
      • How will data be compared against supported software?
      • How will software violations be addressed?
    3. Develop a plan for continual inventory spot checks and maintenance.
      • How often will inventory be conducted and/or analyzed?
      • How often will spot checks be performed?

    Don’t forget that software requires maintenance

    While maintenance efforts are typically focused around hardware, software maintenance – including upgrades and patches – must be built into the software asset management process to ensure software remains compliant with security and regulatory requirements.

    Software maintenance guidelines:

    • Maintenance agreements should be stored in the ITAM database.
    • Software should be kept as current as possible. It is recommended that software remain no more than two versions off.
    • Unsupported software should be uninstalled or upgraded as required.
    • Upgrades should be tested, especially for high-priority or critical applications or if integrated with other applications.
    • Change and release management best practices should be applied for all software upgrades and patches.
    • A process should be defined for how often patches will be applied to end-user devices.

    Integrate patch management with your SAM practice to improve security and reduce downtime

    The integration between patch management and asset management is incredibly valuable from a technology point of view. IT asset management (ITAM) tools create reports on the characteristics of deployed software. By combining these reports with a generalized software updater, you can automate most simple patches to save your team’s efforts for more-critical incidents. Usage reports can also help determine which applications should be reviewed and removed from the environment.

    • In recent years, patch management has grown in popularity due to widespread security threats, the resultant downtime, and expenses associated with them.
    • The main objective of patch management is to create a consistently configured environment that is secure against known vulnerabilities in operating systems and application software.

    Assessing new patches should include questions such as:

    • What’s the risk of releasing the patch? What is the criticality of the system? What end users will be affected?
    • How will we manage business disruption during an incident caused by a failed patch deployment?
    • In the event of service outage as a result of a failed patch deployment, how will we recover services effectively in business priority order?
    • What’s the risk of expediting the patch? Of not releasing the patch at all?

    Define policies for software maintenance and patches

    Associated Activity icon 3.1.2 Define software maintenance and patching policies

    Participants: IT Director, Asset Manager, Release Manager (optional), Security (optional)

    Document: Document in the Standard Operating Procedures.

    Software maintenance:

    Review the software maintenance guidelines in this section and in the SOP template. Discuss each policy and revise and document in accordance with your policies.

    Patch management:

    Discuss and document patch management policies:

    1. How often will end-user devices receive patches?
    2. How often will servers be patched?
    3. How will patches be prioritized? See example below.
      • Critical patches will be applied within two days of release, with testing prioritized to meet this schedule.
      • High-priority patches will be applied within 30 days of release, with testing scheduled to meet this requirement.
      • Normal-priority patches will be evaluated for appropriateness and will be installed as needed.

    Document your patch management policy

    Supporting Tool icon 3.1.3 Use the Patch Management Policy template to document your policy

    The patch management policy helps to ensure company computers are properly patched with the latest appropriate updates to reduce system vulnerability and to enhance repair application functionality. The policy aids in establishing procedures for the identification of vulnerabilities and potential areas of functionality enhancements, as well as the safe and timely installation of patches. The patch management policy is key to identifying and mitigating any system vulnerabilities and establishing standard patch management practices.

    Use Info-Tech’s Patch Management Policy template to get started.

    Sample of the 'Patch Management Policy' template.

    Step 3.2 Harvest, Redeploy, or Retire Software

    Phase 3:
    Manage, Redeploy & Retire
    This step will walk you through the following activities:This step involves the following participants:

    3.1

    Manage & Maintain Software
    • 3.2.1 Map your software license harvest and reallocation process
    • 3.2.2 Define the policy for retiring software
    • IT Director, CIO
    • IT Managers and SAM Manager
    • SAM Team

    3.2

    Harvest, Redeploy, or Retire

    Step Outcomes

    • A defined process for harvesting and reallocating unused software licenses
    • A defined policy for how and when to retire unused or outdated software

    Harvest and reallocate software to optimize license usage

    Using a defined process for harvesting licenses will yield a crop of savings throughout the organization.

    Unused software licenses are present in nearly every organization and result in wasted resources and software spend. Recycling and reharvesting licenses is a critical process within software asset management to save your organization money.

    Licensing Recycling

    When computers are no longer in use and retired, the software licenses installed on the machines may be able to be reused.

    License recycling involves reusing these licenses on machines that are still in use or for new employees.

    License Harvesting

    License harvesting involves more actively identifying machines with licenses that are either not in use or under utilized, and recovering them to be used elsewhere, thus reducing overall software spend on new licenses.

    Use software monitoring data to identify licenses for reallocation in alignment with policies and agreements

    1. Monitor software usage
      Monitor and track software license usage to gain a clear picture of where and how existing software licenses are being used and identify any unused or underused licenses.
    2. Identify licenses for reharvesting
      Identify software licenses that can be reharvested and reallocated according to your policy.
    3. Uninstall software
      Notify user, schedule a removal time if approved, uninstall software, and confirm it has been removed.
    4. Reallocate license when needed

    Sources of surplus licenses for harvest:

    • Projects that required a license during a particular time period, but now do not require a license (i.e. the free version of the software will suffice)
    • Licenses assigned to users no longer with the organization
    • Software installed on decommissioned hardware
    • Installed software that hasn’t been used by the user in the last 90 days (or other defined period)
    • Over-purchased software due to poorly controlled software request, approval, or provisioning processes

    Info-Tech Insight

    Know the stipulations of your end-user license agreement (EULA) before harvesting and reallocating licenses. There may be restrictions on how often a license can be recycled in your agreement.

    Create a defined process for software license harvesting

    Define a standard reharvest timeline. For example, every 90 days, your SAM team can perform an internal audit using your SAM tool to gather data on software usage. If a user has not used a title in that time period, your team can remove that title from that user’s machine. Depending on the terms and conditions of the contract, the license can either be retired or harvested and reallocated.

    Ensure you have exception rules built in for software that’s cyclical in its usage. For example, Finance may only use tax software during tax season, so there’s no reason to lump it under the same process as other titles.

    It’s important to note that in addition to this process, you will need a software usage policy that supports your license harvest process.

    The value of license harvesting

    • Let’s say you paid for 1,000 licenses of a software title at a price of $200 per license.
    • Of this total, 950 have been deployed, and of that total, 800 are currently being used.
    • This means that 16% of deployed licenses are not in use – at a cost of $30,000.
    • With a defined license harvest process, this situation would have been prevented.

    Build a workflow to document the software harvest process

    Include the following in your process:

    • How will unused software be identified?
    • How often will usage reports be reviewed?
    • How will the user be notified of software to be removed?
    • How will the software be removed?
    A flowchart documenting the software harvest process. There are two levels, at the top is 'IT Asset Manager', and the bottom is 'Desktop Support Team'. It begins in 'IT Asset Manager' with 'Create/Review Usage Report', and if the client agrees to removal it moves to 'License deactivation required?' in 'Desktop Support Team'. Eventually you 'Close ticket' and it moves back up to 'Discovery tool will register change automatically' in 'IT Asset Manager'.

    Map your software license harvest and reallocation process

    Associated Activity icon 3.2.1 Build license harvest and reallocation workflow

    Participants: IT Director, Asset Manager, Service Desk Manager

    Document: Document in the Standard Operating Procedures.

    1. Outline each step in the process of software harvest and reallocation using notecards or a whiteboard. Be as granular as possible. On each card, describe the step and the individual responsible for each step.
    2. When you are satisfied that each step is accurately captured, use a second color of notecard to document any challenges, inefficiencies, or pains associated with each step. Consider further documenting the time on each task.
    3. Examine each challenge or pain point. Discuss whether there is a clear solution to the problem. If so, document the solution and amend the workflow. If not, engage in a broader discussion of possible solutions, considering people, processes, and available technology.
    4. Use the sample workflow on the previous slide as a guide if needed.

    The same flowchart documenting the software harvest process from the previous section.

    Improve your software retirement process to drive savings for the whole business

    Business Drivers for Software Disposal

    • Cost Reduction
      • Application retirement allows the application and the supporting hardware stack to be decommissioned.
      • This eliminates recurring costs such as licensing, maintenance, and application administration costs, representing potentially significant savings
    • Consolidation
      • Many legacy applications are redundant systems. For example, many companies have ten or more legacy financial systems from mergers/acquisitions.
      • Systems can be siloed, running incompatible software. Moving data to a common accessible repository streamlines research, audits, and reporting.
    • Compliance
      • An increased focus on regulations places renewed emphasis on e-discovery policies. Keeping legacy applications active just to retain data is an expensive proposition.
      • During application retirement, data is classified, assigned retention policies, and disposed of according to data/governance initiatives.
    • Risk Mitigation
      • Relying on IT to manage legacy systems is problematic. The lack of IT staff familiar with the application increases the potential risk of delayed responses to audits and e-discovery.
      • Retiring application data to a common platform lets you leverage skills you have current investments in. This enables you to be responsive to audit or litigation results.

    Retire your outdated software to decrease IT spend on redundant applications

    Benefits of software retirement:

    1. Assists the service desk in not having to support every release, version, or edition of software that your company might have used in the past.
    2. Stay current with product releases so your company is better placed to take advantage of improvements built-in to such products, rather than being limited by the lack of a newly introduced function.
    3. Removing software that is no longer of commercial benefit can offer a residual value through assets.

    Consequences of continuing to support outdated software:

    • Budgets are tied up to support existing applications and infrastructure, which leaves little room to invest in new technologies that would otherwise help grow business.
    • Much of this software includes legacy systems that were acquired or replaced when new applications were deployed. The value of these outdated systems decreases with every passing year, yet organizations often continue to support these applications.
      • Fear of compliance and data access are the most common reasons.
    • Unfortunately, the cost of doing so can consume over 50% of an overall IT budget.

    The solution to this situation is to retire outdated software.

    “Time and time again, I keep hearing stories from schools on how IT budgets are constantly being squeezed, but when I dig a little deeper, little or no effort is being made on accounting for software that might be on the kit we are taking away.” (Phil Goldsmith, Managing Director – ScrumpyMacs)

    Define the policy for retiring software

    Associated Activity icon 3.2.2 Document process for software retirement

    Participants: IT Director, Asset Manager, Operations

    Document: Document in the Standard Operating Procedures.

    1. Discuss and document the process for retiring software that has been deemed redundant due to changing business needs or an improvement in competitive options.
    2. Consider the following:
      • What criteria will determine when software is suited for retirement?
      • The contract should always be reviewed before making a decision to ensure proper notice is given to the vendor.
      • Notice should be provided as soon as possible to ensure no additional billing arrives for renewals.
      • How will software be removed from all devices? How soon must the software be replaced, if applicable?
      • How long will records be archived in the ITAM database?
    3. Document decisions in the Standard Operating Procedures.

    If you want additional support, have our analysts guide you through this phase as part of an Info-Tech Workshop Associated Activity icon

    Book a workshop with our Info-Tech analysts:

    Photo of an Info-Tech analyst.
    • To accelerate this project, engage your IT team in an Info-Tech workshop with an Info-Tech analyst team.
    • Info-Tech analyst will join you and your team onsite at your location or welcome you to Info-Tech's historic Toronto office to participate in an innovative onsite workshop.
    • Contact your account manager (www.infotech.com/account), or email Workshops@InfoTech.com for more information.

    The following are sample activities that will be conducted by Info-Tech analysts with your team:

    3.1.2

    Sample of activity 3.1.2 'Define policies for software maintenance and patches'. Define policies for software maintenance and patches

    Discuss best practices and define policies for conducting regular software maintenance and patching.

    3.2.1

    Sample of activity 3.3.1 'Assess the maturity of audit management processes and policies'. Map your software license harvest and reallocation process

    Build a process workflow for harvesting and reallocating unused software licenses.

    Phase 3 outline

    Associated Activity icon Call 1-888-670-8889 or email GuidedImplementations@InfoTech.com for more information.

    Complete these steps on your own, or call us to complete a guided implementation. A guided implementation is a series of 2-3 advisory calls that help you execute each phase of a project. They are included in most advisory memberships.

    Guided Implementation 3: Manage, redeploy, and retire

    Proposed Time to Completion (in weeks): 4
    Step 3.1: Manage and maintain softwareStep 3.2: Harvest, redeploy, or retire
    Start with an analyst kick-off call:
    • Define a process for conducting software inventory
    • Define a policy for software maintenance
    • Build a patch management policy
    Review findings with analyst:
    • Build a process for harvesting and reallocating software licenses
    • Define a software retirement policy
    Then complete these activities…
    • Define process for conducting software inventory
    • Define policies for software maintenance
    • Document patch management policy
    Then complete these activities…
    • Map software harvest and reallocation process
    • Define software retirement policy
    With these tools & templates:
    • Standard Operating Procedures
    • Patch Management Policy
    With these tools & templates:
    • Standard Operating Procedures

    Phase 4: Build Supporting Processes & Tools

    Visa used an internal SAM strategy to win the audit battle

    Logo for VISA.

    Case Study

    Industry: Financial Services
    Source: SAM Summit 2014

    Challenge

    The overarching goal of any SAM program is compliance to prevent costly audit fines. The SAM team at Visa was made up of many individuals who were former auditors.

    To deal with audit requests from vendors, “understand how auditors do things and understand their approach,” states Joe Birdsong, SAM Director at Visa.

    Vendors are always on the lookout for telltale signs of a lucrative audit. For Visa, the key was to understand these processes and learn how to prepare for them.

    Solution

    Vendors typically look for the following when evaluating an organization for audit:

    1. A recent decrease in customer spend
    2. How easy the licensed software is to audit
    3. Organizational health

    Ultimately, an audit is an attack on the relationship between the vendor and organization. According to Birdsong: “Maybe they haven’t really touched base with your teams and had good contact and relationship with them, and they don’t really know what’s going on in your enterprise.”

    Results

    By understanding the motivations behind potential audits, Visa was able to form a strategy to increase transparency with the vendor.

    Regular data collection, almost real-time reporting, and open, quick communication with the vendor surrounding audits made Visa a low-risk client for vendors.

    Buy-in from management is also important, and the creation of an official SAM strategy helps maintain support. Thanks to its proactive SAM program, Visa saved $200 million in just three years.

    Step 4.1 Ensure compliance for audits

    Phase 4:
    Build supporting processes & tools
    This step will walk you through the following activities:This step involves the following participants:

    4.1

    Compliance & audits
    • 4.1.1 Define and document the internal audit process
    • 4.1.2 Define and document the external audit process
    • 4.1.3 Prepare an audit scoping email template
    • 4.1.4 Prepare an audit launch email template
    • IT Director, CIO
    • IT Managers and SAM Manager
    • SAM Team

    4.2

    Communicate & build roadmap

    Step Outcomes

    • An understanding of the audit process and importance of audit preparation
    • A defined process for conducting regular internal audits to prepare for and defend against external audits
    • A strategy and documented process for responding to external audit requests

    Take a lifecycle approach to your software compliance process

    Internal audits are an effective way for organizations to regularly assess their licensing position in preparation for an audit.

    1. Gather License Data
      Use your SAM tool to run a discovery check to determine the current state of your software estate.
    2. Improve Data Quality
      Scan the data for red flags. Improve its completeness, consistency, and quality.
    3. Identify Audit Risks
      Using corrected license data, examine your reports and identify areas of risk within the organization.
    4. Identify priority titles
      Determine which titles need attention first by using the output of the license rationalization step.
    5. Reconcile to eliminate gaps
      Ensure that the correct number of licenses are deployed for each title.
    6. Draft Vendor Response
      Prepare response to vendor for when an audit has been requested.

    Improve audit response maturity by leveraging technology and contract data

    By improving your software asset management program’s maturity, you will drive savings for the business that go beyond the negotiating table.

    Recognize the classic signs of each stage of audit response maturity to identify where your organization currently stands and where it can go.

    • Optimized: Automated tools generate compliance, usage, and savings reports. Product usage reports and alerts in place to harvest and reuse licenses. Detailed savings reports provided to executive team.
    • Proactive: Best practices enforced. Compliance positions are checked quarterly, and compliance reports are used to negotiate software contracts.
    • Reactive: Best practices identified but unused. Manual tools still primarily in use. Compliance reports are time-consuming and often inaccurate.
    • Chaotic: Purchases are ad hoc and transaction based. Minimal tracking in place, leading to time-consuming manual processes.

    Implement a proactive internal audit strategy to defend against external audits

    Audits – particularly those related to software – have been on the rise as vendors attempt to recapture revenue.

    Being prepared for an audit is critical. Internal preparation will not only help your organization reduce the risk associated with an audit but will also improve daily operations through focusing on diligent documentation and data collection.

    Conducting routine internal audits will help prepare your organization for the real deal and may even prevent the audit from happening altogether. Hundreds of thousands of dollars can be saved through a proactive audit strategy with routine documentation in place.

    In addition to the fines incurred from a failed audit, numerous other negative consequences can arise:

    • Multiple audits: Failing an audit makes the organization more likely to be audited again.
    • Poor perception of IT: Unless non-compliance was previously disclosed to the business, IT can be deemed responsible.
    • Punitive injunctions: If a settlement is not reached, vendors will apply for an injunction, inhibiting use of their software.
    • Inability to justify purchases: IT can have difficulty justifying the purchase of additional resources after a failed audit.
    • Disruption to business: Precious time and resources will be spent dealing with the results of the audit.

    Perform routine internal compliance reports to decrease audit risk

    The intent of an internal audit is to stop the battle from happening before it starts. Waiting for a knock at the door from a vendor can be stressful, and it can do harm beyond a costly fine.

    • Internal audits help to ensure you’re keeping track of any software changes to keep your data and licensing up to date and avoid costly surprises if an external audit is requested.
    • Identify areas where processes are breaking down and address them before there’s a potential negative impact.
    • Identify control points in processes ahead of time to more easily identify access points where information should be verified.

    “You want to get [the] environment to a level where you’re comfortable sharing information with [a] vendor. Inviting them in to have a chat and exposing numbers means there’s no relationship there where they’re coming to audit you. They only come to audit you when they know there’s a gain to be had, otherwise what’s the point of auditing?
    I want customers to get comfortable with licensing and what they’re spending, and then there’s no problem exposing that to vendors. Vendors actually appreciate that.”
    (Ben Brand, SAM Practice Manager, Insight)

    Info-Tech Insight

    “The supreme art of war is to subdue the enemy without fighting.” – Sun Tzu

    Performing routine checks on your license compliance will drastically reduce the risk that your organization gets hit with a costly fine. Maintaining transparency and demonstrating compliance will fend off audit-hungry vendors.

    Define and document the internal audit process

    Associated Activity icon 4.1.1 Document process and procedures for internal audits

    Participants: CIO and/or IT Director, Asset Manager, IT Managers

    Document: Document in the Standard Operating Procedures.

    Define and document a process for conducting internal software audits.
    Include the following:

    1. How often will audits be completed for each software published?
    2. When will audits be conducted?
    3. Who will conduct the audit? Who will be consulted?
    4. What will be included in the scope of the audit?

    Example:

    • Annual audits will be completed for each software publisher, scheduled as part of the license or maintenance agreement renewals.
    • Where annual purchases are not required, vendor audits for compliance will be conducted annually, with a date predetermined based on minimizing scheduling conflicts with larger audits.
    • Audit will be completed with input from product managers.
    • Audit will include:
      • Software compliance review: Licenses owned compared to product installed.
      • Version review: Determine if installed versions match company standards. If there is a need for upgrades, does the license permit upgrading?
      • Maintenance review: Does the maintenance match requirements for the next year’s plans and licenses in use?
      • Support review: Is the support contract appropriate for use?
      • Budget: Has budget been allocated; is there an adjustment required due to increases?

    Identify organizational warning signs to decrease audit risk

    Being prepared for an audit is critical. Internal preparation will not only help your organization reduce the risk associated with an audit but will also improve daily operations through focusing on diligent documentation and data collection.

    Certain triggers exist that indicate a higher risk of an audit occurring. It is important to recognize these warning signs so you can prepare accordingly.

    Health of organization
    If your organization is putting out fires and a vendor can sense it, they’ll see an audit as a highly lucrative exercise.

    Decrease in customer spend
    A decrease in spend means that an organization has a high chance of being under-licensed.

    License complexity
    The more complex the license, the harder it is to remain in compliance. Some vendors are infamous for their complex licensing agreements.

    Audit Strategy

    • Audits should neither be feared nor embraced.
    • An audit is an attack on your relationship with your vendor; your vendor needs to defend its best interests, but it would also rather maintain a satisfied relationship with its client.
    • A proactive approach to audits through routine reporting and transparency with vendors will alleviate all fear surrounding the audit process. It provides your vendor with compliance assurance and communicates that an audit won’t net the vendor enough revenue to justify the effort.

    Focus on three key tactics for success before responding to an audit

    Taking these due diligence steps will pay dividends downstream, reducing the risk of negative results such as release of confidential information.

    Form an Audit Team

    • Once an audit letter is received from a vendor or third party, a virtual team needs to be formed.
    • The team should be cross-functional, representing various core areas of the business.
    • Don’t forget legal counsel: they will assist in the review of audit provision(s) to determine your contractual rights and obligations with respect to the audit.

    Sign an NDA

    • An NDA should be signed by all parties, the organization, the vendor, and the auditor.
    • Don’t wait on a vendor to provide its NDA. The organization should have its own and provide it to both parties.
    • If the auditor is a third party, negotiate a three-way NDA. This will prevent data being shared with other third parties.

    Examine Contract History

    • Vendors will attempt to alter terms of contracts when new products are purchased.
    • Maintain your current agreement if they are more favorable by “grandfathering” your original agreement.
    • Oracle master level agreements are an example: master level agreements offer more favorable terms than more recent versions.

    Info-Tech Insight

    Even if you cannot get a third-party NDA signed, the negotiation process should delay the overall audit process by at least a month, buying your organization valuable time to gather license data.

    Be prepared for external audit requests with a defined process for responding

    1. Vendor-initiated audit request received and brought to attention of IT Asset Manager and CIO.
    2. Acknowledge receipt of audit notice.
    3. Negotiate timing and scope of the audit (including software titles, geographic locations, entities, and completion date).
    4. Notify staff not to remove or acquire licenses for software under audit.
    5. Gather documentation and create report of all licensed software within audit scope.
      • Include original contract, most recent contract, and any addendums, purchase receipts, or reseller invoices, and publisher documentation such as manuals or electronic media.
    6. Compare documentation to installed software according to ITAM database.
    7. Validate any unusual or non-compliant software.
    8. Complete documentation requested by auditor and review results.

    Define and document the external audit process

    Associated Activity icon 4.1.2 Define external audit process

    Participants: CIO and/or IT Director, Asset Manager, IT Managers

    Document: Document in the Standard Operating Procedures.

    Define and document a process for responding to external software audit requests.
    Include the following:

    1. Who must be notified of the audit request when it is received?
    2. When must acknowledgement of the notice be sent and by whom?
    3. What must be defined under the scope of the audit (e.g. software titles, geographic locations, entities, completion date)?
    4. What communications must be sent to IT staff and end users to ensure compliance?
    5. What documentation should be gathered to review?
    6. How will documentation be verified against data?
    7. How will unusual or non-compliant software be identified and validated?
    8. Who needs to be informed of the results?

    Control audit scope with an audit response template

    Supporting Tool icon 4.1.3 Prepare an audit scoping email template

    Use the Software Audit Scoping Email Template to create an email directed at your external (or internal) auditors. Send the audit scoping email several weeks before an audit to determine the audit’s scope and objectives. The email should include:

    • Detailed questions about audit scope and objectives.
    • Critical background information on your organization/program.

    The email will help focus your preparation efforts and initiate your relationship with the auditors.

    Control scope by addressing the following:

    • Products covered by a properly executed agreement
    • Geographic regions
    • User groups
    • Time periods
    • Specific locations
    • A subset of users’ computers
    Sample of the 'Software Audit Scoping Email Template'.

    Keep leadership informed with an audit launch email

    Supporting Tool icon 4.1.4 Prepare an audit launch email template

    Approximately a week before the audit, you should email the internal leadership to communicate information about the start of the audit. Use the Software Audit Launch Email Template to create this email, including:

    • Staffing
    • Functional requirements
    • Audit contact person information
    • Scheduling details
    • Audit report estimated delivery time

    For more guidance on preparing for a software audit, see Info-Tech’s blueprint: Prepare and Defend Against a Software Audit.

    Sample of the 'Software Audit Launch Email Template'.

    A large bank employed proactive, internal audits to experience big savings

    Case Study

    Industry: Banking
    Source: Pomeroy

    Challenge

    A large American financial institution with 1,300 banking centers in 12 states, 28,000 end users, and 108,000 assets needed to improve its asset management program.

    The bank had employed numerous ITAM tools, but IT staff identified that its asset data was still fragmented. There was still incomplete insight into what assets the banked owned, the precise value of those assets, their location, and what they’re being used for.

    The bank decided to establish an asset management program that involved internal audits to gather more-complete data sets.

    Solution

    With the help of a vendor, the bank implemented cradle-to-grave asset tracking and lifecycle management, which provided discovery of almost $80 million in assets.

    The bank also assembled an ITAM team and a dedicated ITAM manager to ensure that routine internal audits were performed.

    The team was instrumental in establishing standardization of IT policies, hardware configuration, and service requirements.

    Results

    • The bank identified and now tracks over 108,000 assets.
    • The previous level of 80% accuracy in inventory tracking was raised to 96%.
    • Nearly $500,000 was saved through asset recovery and repurposing of 600 idle assets.
    • There are hundreds of thousands of dollars in estimated savings as the result of avoiding costly penalties from failed audits thanks to proactive internal audits.

    Step 4.2 Build communication plan and roadmap

    Phase 4:
    Build supporting processes & tools
    This step will walk you through the following activities:This step involves the following participants:

    4.1

    Compliance & audits
    • 4.2.1 Develop a communication plan to convey the right messages
    • 4.2.2 Anticipate end-user questions by preparing an FAQ list
    • 4.2.3 Build a software asset management policy
    • 4.2.4 Build additional SAM policies
    • 4.2.5 Develop a SAM roadmap to plan your implementation
    • IT Director, CIO
    • IT Managers and SAM Manager
    • SAM Team

    4.2

    Communicate & build roadmap

    Step Outcomes

    • A documented communications plan for relevant stakeholders to understand the benefits and changes the SAM program will bring
    • A list of anticipated end-user questions with responses
    • Documented software asset management policies
    • An implementation roadmap

    Communicate SAM processes to gain acceptance and support

    Communication is crucial to the integration and overall implementation of your SAM program. If staff and users do not understand the purpose of processes and policies, they will fail to provide the desired value.

    An effective communication plan will:

    • Gain support from management at the project proposal phase.
    • Create end-user buy-in once the program is set to launch.
    • Maintain the presence of the program throughout the business.
    • Instill ownership throughout the business from top-level management to new hires.

    Communicate the following:

    1. Advertise successes

      • Regularly demonstrate the value of the SAM program with descriptive statistics focused on key financial benefits.
      • Share data with the appropriate personnel; promote success to obtain further support from senior management.
    2. Report and share asset data

      • Sharing detailed asset-related reports frequently gives decision makers useful data to aid in their strategy.
      • These reports can help your organization prepare for audits, adjust budgeting, and detect unauthorized software.
    3. Communicate the value of SAM

      • Educate management and end users about how they fit into the bigger picture.
      • Individuals need to know which behaviors may put the organization at risk or adversely affect data quality.

    Educate staff and end users through SAM training to increase program success

    As part of your communication plan and overall SAM implementation, training should be provided to both staff and end users within the organization.

    • ITAM solutions are complex by nature with both business process and technical knowledge required to use them correctly.
    • All facets of the business, from management to new hires, should be provided with training to help them understand their role in the program’s success.
    • Keep the message appropriate to the audience – end users don’t need to know the complete process, but will need to know policy and how to request.
    • Even after the SAM program has been fully implemented, keep employees up to date with policies and processes through ongoing training sessions for both new hires and existing employees:
      • New hires: Provide new hires with all relevant SAM policies and ensure they understand the importance of software asset management.
      • Existing employees: Continually remind them of how SAM is involved in their daily operations and inform them of any changes to policies.

    Create your communications plan to anticipate challenges, remove obstacles, and ensure buy-in

    Provide separate communications to key stakeholder groups

    Why:
    • What problems are you trying to solve?
    What:
    • What processes will it affect (that will affect me)?
    Who:
    • Who will be affected?
    • Who do I go to if I have issues with the new process?
    Three circular arrows each linking t the next in a downward daisy chain. The type arrow has 'IT Staff' in the middle, the second 'Management', and the third 'End Users' When:
    • When will this be happening?
    • When will it affect me?
    How:
    • How will these changes manifest themselves?
    Goal:
    • What is the final goal?
    • How will it benefit me?

    Develop a communication plan to convey the right messages

    Associated Activity icon 4.2.1 Develop a communication plan to convey the right messages

    Participants: CIO, IT Director, Asset Manager, Service Desk Manager

    Document: Document in the SAM Communication Plan.

    1. Identify the groups that will be affected by the SAM program.
    2. For each group requiring a communication plan, identify the following:
    3. Benefits of SAM for that group of individuals (e.g. more efficient software requests).
    4. The impact the change will have on them (e.g. change in the way a certain process will work).
    5. Communication method (i.e. how you will communicate).
    6. Timeframe (i.e. when and how often you will communicate the changes).
    7. Complete this information in a table like the one below and document in the Communication Plan.
    Group Benefits Impact Method Timeline
    Executives
    • Improved audit compliance
    • Improved budgeting and forecasting
    • Review and sign off on policies
    End Users
    • Streamlined software request process
    • Follow software installation and security policies
    IT
    • Faster access to data and one source of truth
    • Modified processes
    • Ensure audits are completed regularly

    Anticipate end-user questions by preparing an FAQ list

    Associated Activity icon 4.2.2 Prepare an FAQ list

    Document: Document FAQ questions and answers in the SAM FAQ Template.

    ITAM imposes changes to end users throughout the business and it’s normal to expect questions about the new program. Prepare your team ahead of time by creating a list of FAQs.

    Some common questions include:

    • Why are you changing from the old processes?
    • Why now?
    • What are you going to ask me to do differently?
    • Will I lose any of my software?

    The benefits of preparing a list of answers to FAQs include:

    • A reduction in time spent creating answers to questions. If you focus on the most common questions, you will make efficient use of your team’s time.
    • Consistency in your team’s responses. By socializing the answers to FAQs, you ensure that no one on your team is out of the loop and the message remains consistent across the board.

    Include policy design and enforcement in your communication plan

    • Software asset management policies should define the actions to be taken to support software asset management processes and ensure the effective and efficient management of IT software assets across the asset lifecycle.
    • Implementing asset management policies enforces the notion that the organization takes its IT assets and the management of them seriously and will help ensure the benefits of SAM are achieved.
    • Designing, approving, documenting, and adopting one set of standard SAM policies for each department to follow will ensure the processes are enforced equally across the organization.

    Info-Tech Insight

    Use policy templates to jumpstart your policy development and ensure policies are comprehensive, but be sure to modify and adapt policies to suit your corporate culture or they will not gain buy-in from employees. For a policy to be successful, it must be a living document and have participation and involvement from the committees and departments to whom it will pertain.

    Build a software asset management policy

    Supporting Tool icon 4.2.3 Document a SAM policy

    Use Info-Tech’s Software Asset Management Policy template to define and document the purpose, scope, objectives, and roles and responsibilities for your organization's software asset management program.

    The template allows you to customize policy requirements for:

    • Procurement
    • Installation and Removal
    • Maintenance
    • Mergers and Acquisitions
    • Company Divestitures
    • Audits

    …as well as consequences for non-compliance.

    Sample of the 'Software Asset Management Policy' template.

    Use Info-Tech’s policy templates to build additional policies

    Supporting Tool icon 4.2.4 Build additional SAM policies

    Asset Security Policy
    The IT asset security policy will describe your organization's approach to ensuring the physical and digital security of your IT assets throughout their entire lifecycle.

    End-User Devices Acceptable Use Policy
    This policy should describe how business tools provided to employees are to be used in a responsible, ethical, and compliant manner, as well as the consequences of non-compliance.

    Purchasing Policy
    The purchasing policy helps to establish company standards, guidelines, and procedures for the purchase of all information technology hardware, software, and computer-related components as well as the purchase of all technical services.

    Release Management Policy
    Use this policy template to define and document the purpose, scope, objectives, and roles and responsibilities for your organization's release management program.

    Internet Acceptable Use Policy
    Use this template to help keep the internet use policy up to date. This policy template includes descriptions of acceptable and unacceptable use, security provisions, and disclaimers on the right of the organization to monitor usage and liability.

    Samples of additional SAM policies, listed to the left.

    Implement SAM in a phased, constructive approach

    One of the most difficult decisions to make when implementing a SAM program is: “where do we start?”

    It’s not necessary to deploy a comprehensive SAM program to start. Build on the essentials to become more mature as you grow.

    SAM Program Maturity (highest to lowest)

    • Audits and reporting
      Gather and analyze data about software assets to ensure compliance for audits and to continually improve the business.
    • Contracts and budget
      Analyze contracts and licenses for software across the enterprise and optimize planning to enable cost reduction.
    • Lifecycle standardization
      Define standards and processes for all asset lifecycle phases from request and procurement through to retirement and redistribution.
    • Inventory and tracking
      Define assets you will procure, distribute, and track. Know what you have, where it is deployed, and keep track of contracts and all relevant data.

    Integrate your SAM program with the organization to assist its implementation

    SAM cannot perform on its own – it must be integrated with other functional areas of the organization to maintain its stability and support.

    • Effective SAM is supported by a comprehensive set of processes as part of its implementation.
    • For example, integration with the procurement team’s processes and tools is required to track software purchases to mitigate software license compliance risk.
    • Integration with Finance is required to support internal cost allocations and chargebacks.
    • Integration with the service desk is required to track and deploy software requests.

    Info-Tech Best Practice

    To integrate SAM effectively, a clear implementation roadmap needs to be designed. Prioritize “quick wins” to demonstrate success to the business early and to gain buy-in from your team. Short-term gains should be designed to support long-term goals of your SAM program.

    Sample short-term goals
    • Identify inventory classification and tool
    • Create basic SAM policies and processes
    • Implement SAM auto-discovery tools
    Sample long-term goals
    • Software contract data integration
    • Continual improvement through review and revision
    • Software compliance reports, internal audits

    Develop a SAM roadmap to plan your implementation

    Associated Activity icon 4.2.5 Build a project roadmap
    1. Identify and review all initiatives that will be taken to implement or improve the software asset management program. These may fall under people, process, or technology-related tasks.
    2. Assign a priority level to each task (Quick Win, Low, Medium, High).
    3. Use the priority to sort tasks into start dates, breaking down by:
      1. Short, medium, or long-term
      2. 1 month, 3 months, 6 months, 12+ months
      3. Q1, Q2, Q3, Q4
    4. Review tasks and adjust start dates for some, if needed to set realistic and achievable timelines.
    5. Transfer tasks to a project plan or Gantt chart to formalize.
    Examples:
    Q1 Q2 Q3 Q4
    • Hire software asset manager
    • Document SOP
    • Define policies
    • Select a SAM tool
    • Create list of approved services and software
    • Define metrics
    • Inventory existing software and contracts
    • Build a patch policy
    • Build a service catalog
    • Contract renewal alignment
    • Run internal audit
    • Security review

    Review and maintain the SAM program to reach optimal maturity

    • SAM is a dynamic process. It must adapt to keep pace with the direction of the organization. New applications, different licensing needs, and a constant stream of new end users all contribute to complicating the licensing process.
    • As part of your organization’s journey to an optimized SAM program, put in place continual improvement practices to maintain momentum.

    A suggested cycle of review and maintenance for your SAM: 'Plan', 'Do', 'Check', 'Act'.

    Info-Tech Insight

    Advertising the increased revenue that is gained from good SAM practices is a powerful way to gain project buy-in.

    Keep the momentum going:

    • Clearly define ongoing responsibilities for each role.
    • Develop a training and awareness program for new employees to be introduced to SAM processes and policies.
    • Continually review and revise existing processes as necessary.
    • Measure the success of the program to identify areas for improvement and demonstrate successes.
    • Measure adherence to process and policies and enforce as needed.

    Reflect on the outcomes of implementing SAM to target areas for improvement and share knowledge gained within and beyond the SAM team. Some questions to consider include:

    1. How did the data compare to our expectations? Was the project a success?
    2. What obstacles were present that impacted the project?
    3. How can we apply lessons learned through this project to others in the future?

    If you want additional support, have our analysts guide you through this phase as part of an Info-Tech Workshop Associated Activity icon

    Book a workshop with our Info-Tech analysts:

    Photo of an Info-Tech analyst.
    • To accelerate this project, engage your IT team in an Info-Tech workshop with an Info-Tech analyst team.
    • Info-Tech analyst will join you and your team onsite at your location or welcome you to Info-Tech's historic Toronto office to participate in an innovative onsite workshop.
    • Contact your account manager (www.infotech.com/account), or email Workshops@InfoTech.com for more information.

    The following are sample activities that will be conducted by Info-Tech analysts with your team:

    4.2.1

    Sample of activity 4.2.1 'Develop a communication plan to convey the right messages'. Develop a communication plan to convey the right messages

    Identify stakeholders requiring communication and formulate a message and delivery method for each.

    4.2.5

    Sample of activity 4.2.5 'Develop a SAM roadmap to plan your implementation'. Develop a SAM roadmap to plan your implementation

    Outline the tasks necessary for the implementation of this project and prioritize to build a project roadmap.

    Phase 4 outline

    Associated Activity icon Call 1-888-670-8889 or email GuidedImplementations@InfoTech.com for more information.

    Complete these steps on your own, or call us to complete a guided implementation. A guided implementation is a series of 2-3 advisory calls that help you execute each phase of a project. They are included in most advisory memberships.

    Guided Implementation 4: Build supporting processes & tools

    Proposed Time to Completion (in weeks): 4
    Step 4.1: Compliance & audits Step 4.2: Communicate & build roadmap
    Start with an analyst kick-off call:
    • Discuss audit process
    • Define a process for internal audits
    • Define a process for external audit response
    Review findings with analyst:
    • Build communication plan
    • Discuss policy needs
    • Build a roadmap
    Then complete these activities…
    • Document internal audit process
    • Document external audit process
    • Prepare audit templates
    Then complete these activities…
    • Develop communication plan
    • Prepare an FAQ list for end users
    • Build SAM policies
    • Develop a roadmap
    With these tools & templates:
    • Standard Operating Procedures
    • Software Audit Scoping Email Template
    • Software Audit Launch Email Template
    With these tools & templates:
    • SAM Communication Plan
    • Software Asset Management FAQ Template
    • Software Asset Management Policy
    • Additional Policy Templates

    Bibliography

    2013 Software Audit Industry Report.” Express Metrix, 2013. Web.

    7 Vital Trends Disrupting Today’s Workplace: Results and Data from 2013 TINYpulse Employee Engagement Survey.” TINYpulse, 2013. Web.

    Beaupoil, Christof. “How to measure data quality and protect against software audits.” Network World, 6 June 2011.

    Begg, Daniel. “Effective Licence Position (ELP) – What is it really worth?” LinkedIn, 19 January 2016.

    Boehler, Bernhard. “Advanced License Optimization: Go Beyond Compliance for Maximum Cost Savings.” The ITAM Review, 24 November 2014.

    Bruce, Warren. “SAM Baseline – process & best practice.” Microsoft. 2013 Australia Partner Conference.

    Case Study Top 20 U.S. Bank Tackles Asset Management.” Pomeroy, 2012. Web.

    Cherwell Software Software Audit Industry Report.” Cherwell Software, 2015. Web.

    Conrad, Sandi. “SAM starter kit: everything you need to get started with software asset management. Conrad & Associates, 2010.

    Corstens, Jan, and Diederik Van der Sijpe. “Contract risk & compliance software asset management (SAM).” Deloitte, 2012.

    Deas, A., T. Markowitzm and E. Black. “Software asset management: high risk, high reward.” Deloitte, 2014.

    Doig, Chris. “Why you should always estimate ROI before buying enterprise software” CIO, 13 August 2015.

    Fried, Chuck. “America Needs An Education On Software Asset Management (SAM).” LinkedIn. 16 June 2015.

    Lyons, Gwen. “Understanding the Drivers Behind Application Rationalization Critical to Success.” Flexera Software Blog, 31 October 2012.

    Bibliography

    Metrics to Measure SAM Success: eight ways to prove your SAM program is delivering business benefits.” Snow Software White Paper, 2015.

    Microsoft. “The SAM Optimization Model.” Microsoft Corporation White Paper, 2010.

    Miller, D. and M. Oliver. “Engaging Stakeholders for Project Success.” Project Management Institute White Paper, 2015.

    Morrison, Dan. “5 Common Misconceptions of Software Asset Management.” SoftwareOne. 12 May 2015.

    O’Neill, Leslie T. “Visa Case Study: SAM in the 21st Century.” International Business Software Managers Association (IBSMA), 30 July 2014.

    Reducing Hidden Operating Costs Through IT Asset Discovery.” NetSupport Inc., 2011.

    SAM Summit 2014, 23-25 June 2014, University of Chicago Gleacher Center Conference Facilities, Chicago, MI.

    Saxby, Heather. “20 Things Every CIO Needs to Know about Software Asset Management.” Crayon Software Experts, 13 May 2015.

    The 2016 State of IT: Managing the money monsters for the coming year.” Spiceworks, 2016.

    The Hidden Cost of Unused Software.” A 1E Report, 1E.com: 2014. Web.

    What does it take to achieve software license optimization?” Flexera White Paper, 2013.

    Research contributors and experts

    Photo of Michael Dean, Director, User Support Services, Des Moines University Michael Dean
    Director, User Support Services
    Des Moines University
    Simon Leuty
    Co-Founder
    Livingstone Tech
    Photo of Simon Leuty, Co-Founder, Livingstone Tech
    Photo of Clare Walsh, PR Consultant, Adesso Tech Ltd. Clare Walsh
    PR Consultant
    Adesso Tech Ltd.
    Alex Monaghan
    Director, Presales EMEA
    Product Support Solutions
    Photo of Alex Monaghan, Director, Presales EMEA, Product Support Solutions

    Research contributors and experts

    Photo of Ben Brand, SAM Practice Manager, Insight Ben Brand
    SAM Practice Manager
    Insight
    Michael Swanson
    President
    ISAM
    Photo of Michael Swanson, President, ISAM
    Photo of Bruce Aboudara, SVP, Marketing & Business Development, Scalable Software Bruce Aboudara
    SVP, Marketing & Business Development
    Scalable Software
    Will Degener
    Senior Solutions Consultant
    Scalable Software
    Photo of Will Degener, Senior Solutions Consultant, Scalable Software

    Research contributors and experts

    Photo of Peter Gregorowicz, Associate Director, Network & Client Services, Vancouver Community College Peter Gregorowicz
    Associate Director, Network & Client Services
    Vancouver Community College
    Peter Schnitzler
    Operations Team Lead
    Toyota Canada
    Photo of Peter Schnitzler, Operations Team Lead, Toyota Canada
    Photo of David Maughan, Head of Service Transition, Mott MacDonald Ltd. David Maughan
    Head of Service Transition
    Mott MacDonald Ltd.
    Brian Bernard
    Infrastructure & Operations Manager
    Lee County Clerk of Court
    Photo of Brian Bernard, Infrastructure & Operations Manager, Lee County Clerk of Court

    Research contributors and experts

    Photo of Leticia Sobrado, IT Data Governance & Compliance Manager, Intercept Pharmaceuticals Leticia Sobrado
    IT Data Governance & Compliance Manager
    Intercept Pharmaceuticals

    Select and Implement a Web Experience Management Solution

    • Buy Link or Shortcode: {j2store}556|cart{/j2store}
    • member rating overall impact: N/A
    • member rating average dollars saved: N/A
    • member rating average days saved: N/A
    • Parent Category Name: Marketing Solutions
    • Parent Category Link: /marketing-solutions
    • A company’s web presence is its front face to the world. Ensuring you have the right suite of tools for web content management, experience design, and web analytics is critical to putting your best foot forward: failing to do so will result in customer attrition and lost revenue.
    • Web Experience Management (WEM) suites are a rapidly maturing and dynamic market, with a landscape full of vendors with cutting edge solutions and diverse offerings. As a result, finding a solution that is the best fit for your organization can be a complex process.

    Our Advice

    Critical Insight

    • WEM products are not a one-size-fits-all investment: unique evaluations and customization are required in order to deploy a solution that fits your organization.
    • WEM technology often complements core CRM and marketing management products – it does not supplant it, and must augment the rest of your customer experience management portfolio.
    • Phase your WEM implementation: Start with core capabilities such as content management, then add additional capabilities for site analytics and dynamic experience.

    Impact and Result

    • Align marketing needs with identified functional requirements.
    • Implement a best-fit WEM that increases customer acquisition and retention, and provides in-depth capabilities for site analysis.
    • Optimize procurement and operations costs for the WEM platform.

    Select and Implement a Web Experience Management Solution Research & Tools

    Start here – read the Executive Brief

    Read our concise Executive Brief to find out why you should select and implement a WEM solution, review Info-Tech’s methodology, and understand the four ways we can support you in completing this project.

    Besides the small introduction, subscribers and consulting clients within this management domain have access to:

    1. Launch the WEM project and collect requirements

    Conduct a market overview, structure the project, and gather requirements.

    • Select and Implement a Web Experience Management Solution – Phase 1: Launch the WEM Project and Collect Requirements
    • WEM Project Charter Template
    • WEM Use-Case Fit Assessment Tool

    2. Select a WEM solution

    Analyze and shortlist vendors in the space and select a WEM solution.

    • Select and Implement a Web Experience Management Solution – Phase 2: Select a WEM Solution
    • WEM Vendor Shortlist & Detailed Feature Analysis Tool
    • WEM Vendor Demo Script Template
    • WEM RFP Template

    3. Plan the WEM implementation

    Plan the implementation and evaluate project metrics.

    • Select and Implement a Web Experience Management Solution – Phase 3: Plan the WEM Implementation
    • WEM Work Breakdown Structure Template
    [infographic]

    Workshop: Select and Implement a Web Experience Management Solution

    Workshops offer an easy way to accelerate your project. If you are unable to do the project yourself, and a Guided Implementation isn't enough, we offer low-cost delivery of our project workshops. We take you through every phase of your project and ensure that you have a roadmap in place to complete your project successfully.

    1 Launch of the WEM Selection Project

    The Purpose

    Discuss the general project overview for the WEM selection.

    Key Benefits Achieved

    Launch of your WEM selection project.

    Development of your organization’s WEM requirements.

    Activities

    1.1 Facilitation of activities from the Launch the WEM Project and Collect Requirements phase, including project scoping and resource planning.

    1.2 Conduct overview of the WEM market landscape, trends, and vendors.

    1.3 Conduct process mapping for selected marketing processes.

    1.4 Interview business stakeholders.

    1.5 Prioritize WEM functional requirements.

    Outputs

    WEM Procurement Project Charter

    WEM Use-Case Fit Assessment

    2 Plan the Procurement and Implementation Process

    The Purpose

    Plan the procurement and the implementation of the WEM solution.

    Key Benefits Achieved

    Selection of a WEM solution.

    A plan for implementing the selected WEM solution.

    Activities

    2.1 Complete marketing process mapping with business stakeholders.

    2.2 Interview IT staff and project team, identify technical requirements for the WEM suite, and document high-level solution requirements.

    2.3 Perform a use-case scenario assessment, review use-case scenario results, identify use-case alignment, and review the WEM Vendor Landscape vendor profiles and performance.

    2.4 Create a custom vendor shortlist and investigate additional vendors for exploration in the marketplace.

    2.5 Meet with project manager to discuss results and action items.

    Outputs

    Vendor Shortlist

    WEM RFP

    Vendor Evaluations

    Selection of a WEM Solution

    WEM projected work break-down

    Implementation plan

    Framework for WEM deployment and CRM/Marketing Management Suite Integration

    Analyze Your Service Desk Ticket Data

    • Buy Link or Shortcode: {j2store}483|cart{/j2store}
    • member rating overall impact: 10.0/10 Overall Impact
    • member rating average dollars saved: $6,499 Average $ Saved
    • member rating average days saved: 3 Average Days Saved
    • Parent Category Name: Service Desk
    • Parent Category Link: /service-desk
    • Leverage your service desk ticket data to gain insights for your service desk strategy.

    Our Advice

    Critical Insight

    • Properly analyzing ticket data is challenging for the following reasons:
      • Poor ticket hygiene and unclear ticket handling means the data is often inaccurate or incomplete.
      • Service desk personnel are not sure where to start with analysis.
      • Too many metrics are tracked to parse actionable data from the noise.
    • Ticket data won’t give you a silver bullet, but it can help point you in the right direction.

    Impact and Result

    • Create an iterative framework for tracking metrics, keeping data clean, and actioning your data on day-to-day and month-to-month timelines.

    Analyze Your Service Desk Ticket Data Research & Tools

    Start here – read the Executive Brief

    Read our concise Executive Brief to find out why you should analyze your service desk ticket data, review Info-Tech’s methodology, and understand the four ways we can support you in completing this project.

    Besides the small introduction, subscribers and consulting clients within this management domain have access to:

    1. Import your ticket data

    Enter your data into our tool. Compare your own ITSM ticket fields to improve ticket data moving forward.

    • Service Desk Ticket Analysis Tool

    2. Analyze your ticket data

    Use the ticket analysis tool as a guide to build your own operational dashboards to measure metrics over time. Gain actionable insights from your data.

    • Ticket Analysis Report

    3. Action your ticket data

    Use the data to communicate your findings to the business and leadership using the Ticket Analysis Report.

    [infographic]

    Further reading

    INFO-TECH RESEARCH GROUP

    Analyze Your Service Desk Ticket Data

    Take a data-driven approach to service desk optimization.

    EXECUTIVE BRIEF

    Analyst Perspective

    Photo of Benedict Chang, Research Analyst, Infrastructure & Operations, Info-Tech Research Group

    Benedict Chang
    Research Analyst, Infrastructure & Operations
    Info-Tech Research Group

    Photo of Ken Weston ITIL MP, PMP, Cert.APM, SMC, Research Director, Infrastructure & Operations, Info-Tech Research Group

    Ken Weston ITIL MP, PMP, Cert.APM, SMC
    Research Director, Infrastructure & Operations
    Info-Tech Research Group

    The perfect time to start analyzing your ticket data is now

    Service desks improve their services by leveraging ticket data to inform their actions. However, many organizations don’t know where to start. It’s tempting to wait for perfect data, but there’s a lot of value in analyzing your ticket data as it exists today.

    Start small. Track key tension metrics based on the out-of-the-box functionality in your tool. Review the metrics regularly to stay on track.

    By reviewing your ticket data, you’re going to get better organically. You’re going to learn about the state of your environment, the health of your processes, and the quality of your services. Regularly analyze your data to drive improvements.

    Make ticket analysis a weekly habit. Every week, you should be evaluating how the past week went. Every month, you should be looking for patterns and trends.

    Executive Summary

    Your Situation

    Leverage your service desk ticket data to gain insights for improving your operations:

    1. Use a data-based approach to allocate service desk resources.
    2. Design appropriate SLOs and SLAs to better service end users.
    3. Gain efficiencies for your shift-left strategy.
    4. Communicate the current and future value of the service desk to the business.

    Common Obstacles

    Properly analyzing ticket data is challenging for the following reasons:

    • Poor ticket hygiene and unclear ticket handling guidelines can lead to untrustworthy results.
    • Undocumented tickets from various intake channels prevents you from seeing the whole picture.
    • Service desk personnel are not sure where to start with analysis and are too busy to find time.
    • Too many metrics are tracked to parse actionable insights from the noise.

    Info-Tech’s Approach

    Info-Tech’s approach to improvement:

    • To reduce the noise, standardize your ticket data in a format that will ease analysis.
    • Start with common analyses using the cleaned data set.
    • Identify action items based on your ticket data.

    Analyze your ticket data to help continually improve your service desk.

    Slow down. Give yourself time.

    Give yourself time to observe the new metrics and draw enough insights to make recommendations for improvement. Then, execute on those recommendations. Slow and steady improvement of the service desk only adds business value and will have a positive impact on customer satisfaction.

    Your challenge

    This research is designed to help service desk managers analyze their ticket data

    Analyzing ticket data involves:

    • Collecting ticket data and keeping it clean. Based on the metrics you’re analyzing, define ticket expectations and keep the data up to date.
    • Showing the value of the service desk. SLAs are meaningless if they are not met consistently. The prerequisite to implementing proper SLAs is fully understanding the workload of the service desk.
    • Understanding – and improving – the user experience. You cannot improve the user experience without meaningful metrics that allow you to understand the user experience. Different user groups will have different needs and different expectations of the level of service. Your metrics should reflect those needs and expectations.

    36% of organizations are prioritizing ticket handling in IT for 2021 (Source: SDI, 2021)

    12% of organizations are focusing directly on service desk improvement (Source: SDI, 2021)

    Common obstacles

    Many organizations face these barriers to analyzing their ticket data:

    • Finding time to properly analyze ticket data is a challenge. Not knowing where to start can lead to not analyzing the proper data. Service desks end up either tracking too much data or not tracking the proper metrics.
    • Data, even if clean, can be housed in various tools and databases. It’s difficult to aggregate data if the data is stored throughout various tools. Comparisons may also be difficult if the data sets aren’t consistent.
    • Shifting left to move tickets toward self-service is difficult when there is no visibility into which tickets should be shifted left.

    What your peers are saying about why they can’t start analyzing their ticket data:

    • “My technicians do not consistently update and close tickets.”
    • “My ITSM doesn’t have the capabilities I need to make informed decisions on shifting tickets left.”
    • “My tickets are always missing data”
    • “I’m constantly firefighting. I have no time for ticket data analysis.”
    • “I have no idea where to start with the amount of data I have.”
    (Source: Info-Tech survey, 2021; N=20.)

    Common obstacles that prevent effective ticket analysis

    We asked IT service desk managers and teams about their biggest hurdles

    Missing or Inaccurate Information
    • Lack of information in the ticket
    • Categories are too general/specific to draw insights
    • Poor ticket hygiene
    Missing Updates
    • Tickets aren’t updated while being resolved
    Correlating Tickets to Identify Trends
    • Not sure where to start with all the data at hand
    No Time
    • No time to figure out the tool or analyze the data properly
    Ineffective Categorization Schemes
    • Reduces the power of ticket data
    Tool Limitations
    • Can’t be easily customized
    • Too customized to be effective
    • Desired dashboards unavailable
    (Source: Info-Tech survey, 2021; N=20)

    Info-Tech’s approach

    Repeat this analysis every business cycle:

    • Gather Your Data
      Collect your ticket data OR start measuring the right metrics.
    • Extract & Analyze
      Organize and visualize your data to extract insights
    • Action the Results
      Implement low-effort improvements and celebrate quick successes.
    • Implement Larger Changes
      Reference your ticket data while implementing process, tooling, and other changes.
    • Communicate the Results
      Use your data to show the value of your effort.

    Measure the value of this blueprint

    Track these metrics as you improve

    Use the data to tell you which aspects of IT need to be shifted left and which need to be automated

    Your data will show you where you can improve.

    As you act on your data, you should see:

    • Lower costs per ticket
    • Decreased average time to resolve
    • Increased end-user satisfaction
    • Fewer tickets escalated beyond Tier 1

    An illustration of the 'Shift Left Strategy' using three line graphs arranged in a table with the same axes but representing different metrics. The header row is 'Metrics,' then values of the x-axes are 'Auto-Fix,' 'User,' 'Tier 1,' 'Tier2/Tier3,' and 'Vendor.' Under 'Metrics' we see 'Cost,' 'Time,' and 'Satisfaction.' The 'Cost' graph begins 'Low' at 'Auto-Fix' and gradually moves to 'High' at 'Vendor.' The 'Time' graph begins 'Low' at 'Auto-Fix' and gradually moves to 'High' at 'Vendor.' The 'Satisfaction' graph begins 'High' at 'Auto-Fix' and gradually moves to 'Low' at 'Vendor.' Below is an arrow directing us away from the 'Vendor' option and toward the 'Auto-Fix' option, 'Shift Ticket Resolution Left.'

    See Info-Tech’s blueprint Optimize the Service Desk With a Shift-Left Strategy.

    Info-Tech’s methodology for analyzing service desk tickets

    1. Import Your Ticket Data 2. Analyze Your Ticket Data 3. Communicate Your Insights
    Phase Steps
    1. Import Your Ticket Data
    1. Analyze High-Level Ticket Data
    2. Analyze Incidents, Service Requests, and Ticket Categories
    1. Build Recommendations
    2. Action and Communicate Your Ticket Data
    Phase Outcomes Enter your data into our tool. Compare your own ITSM ticket fields to improve ticket data moving forward. Use the Service Desk Ticket Analysis Tool as a guide to build your own operational dashboards to measure metrics over time. Gain actionable insights from your data. Use the data to communicate your findings to the business and leadership using the Ticket Analysis Report.

    Insight summary

    Slow down. Give yourself time.

    Give yourself time to observe the new metrics and draw enough insights to make recommendations for improvement. Then, execute on those recommendations. Slow and steady improvement of the service desk only adds business value and will have a positive impact on customer satisfaction.

    Iterate on what to track rather than trying to get it right the first time.

    Tracking the right data in your ticket can be challenging if you don’t know what you’re looking for. Start with standardized fields and iterate on your data analysis to figure out your gaps and needs.

    If you don’t know where to go, ticket data can point you in the right direction.

    If you have service desk challenges, you will need to allocate time to process improvement. However, prioritizing your initiatives is easier if you have the ticket data to point you in the right direction.

    Start with data from one business cycle.

    Service desks don’t need three years’ worth of data. Focus on gathering data for one business cycle (e.g. three months). That will give you enough information to start generating value.

    Let the data do the talking.

    Leverage the data to drive organizational and process change in your organization by tracking meaningful metrics. Choose those metrics using business-aligned goals.

    Paint the whole picture.

    Single metrics in isolation, even if measured over time, may not tell the whole story. Make sure you design tension metrics where necessary to get a holistic view of your service desk.

    Blueprint deliverables

    This blueprint’s key deliverable is a ticket analysis tool. Many of the activities throughout this blueprint will direct you to complete and interpret this tool. The other main deliverable is a stakeholder presentation template to help you document the outcomes of the project.
    Service Desk Ticket Analysis Tool Ticket Analysis Report
    Use this tool to identify trends and patterns in your ticket data to action improvement initiatives.

    Sample of the Service Desk Ticket Analysis Tool blueprint deliverable.

    Use this template to document the justification for addressing service desk improvement, the results of your analysis, and your next steps.

    Sample of the Ticket Analysis Report blueprint deliverable.

    Blueprint benefits

    IT Benefits

    • Discover and implement the proper metrics to improve your service desk
    • Use a data-based approach to improve your customer service and operational goals
    • Increase visibility with the business and other IT departments using a structured presentation

    Business Benefits

    • Quicker resolutions to incidents and service requests
    • Better expectations for the service desk and IT
    • Better visibility into the current state, challenges, and goals of the service desk
    • More effective support when contacting the service desk

    Info-Tech offers various levels of support to best suit your needs

    DIY Toolkit

    Guided Implementation

    Workshop

    Consulting

    "Our team has already made this critical project a priority, and we have the time and capability, but some guidance along the way would be helpful." "Our team knows that we need to fix a process, but we need assistance to determine where to focus. Some check-ins along the way would help keep us on track." "We need to hit the ground running and get this project kicked off immediately. Our team has the ability to take this over once we get a framework and strategy in place." "Our team does not have the time or the knowledge to take this project on. We need assistance through the entirety of this project."

    Diagnostics and consistent frameworks used throughout all four options

    Guided Implementation

    A Guided Implementation (GI) is a series of calls with an Info-Tech analyst to help implement our best practices in your organization.

    A typical GI is 3-4 calls over the course of 2-3 months.

    What does a typical GI on this topic look like?

      Phase 1

    • Call #1: Scope requirements, objectives, and your specific challenges. Enter your data into the tool.
    • Phase 2

    • Call #2: Assess the current state across the different dashboards.
    • Phase 3

    • Call #3: Identify improvements and insights to include in the communication report.
    • Call #4: Review the service desk ticket analysis report.

    PHASE 1

    Import Your Ticket Data

    This phase will walk you through the following activities:

    • 1.1.1 Define your objectives for analyzing ticket data
    • 1.1.2 Identify success metrics
    • 1.1.3 Import your ticket data into the tool
    • 1.1.4 Update your ticket fields for future analysis

    This phase involves the following participants:

    • Service Desk Manager
    • ITSM Manager
    • Service Desk Technician

    1.1.1 Define your objectives for analyzing ticket data

    Input: Understanding of current service desk process and ticket routing

    Output: Defined objectives for the project

    Materials: Whiteboard/flip charts, Ticket Analysis Report

    Participants: Service Desk Staff, Service Desk Manager, IT Director, CIO

    Use the discussion questions below as a guide
    1. Identify your main objective for analyzing ticket data. Use these three sample objectives as a starting point:
      • Demonstrate value to the business by improving customer service.
      • Improve service desk operations.
      • Reduce the number of recurring incidents.
    2. Answer the following questions as a group:
      • What challenges do you have getting accurate data for this objective?
      • What data is missing for supporting this objective?
      • What kind of issues must be solved for us to make progress on achieving this objective?
      • What decisions are held up from a lack of data?
      • How can better ticket data help us to more effectively manage our services and operations?

    Document in the Ticket Analysis Report.

    1.1.2 Identify success metrics

    Select metrics that will track your progress on meeting the objective identified in Activity 1.1.1.

    Input: Understanding of current service desk process and ticket routing

    Output: Defined objectives for the project

    Materials: Whiteboard/flip charts, Ticket Analysis Report

    Participants: Service Desk Manager, IT Director, CIO

    Use these sample metrics as a starting point:
    Demonstrate value to the business by improving customer service
    Ticket trends by category by month # tickets by business department % SLAs met by IT teams
    Average customer satisfaction rating % incident tickets closed in one day Service request SLAs met by % Annual IT satisfaction survey result
    Improve service desk operations
    Incident tickets assigned, sorted by age and priority Scheduled requests for today and tomorrow Knowledgebase articles due for renewal this month Top 5-10 tickets for the quarter
    Unassigned tickets by age # incident tickets assigned by tech Open tickets by category Backlog summary by age
    Reducing the number of recurring incidents
    # incidents by category and resolution code Number of problem tickets opened and resolved Correlation of ticket volume trends to events Reduction of volume of recurring tickets
    Use of knowledgebase by users Use of self-service for ticket creation Use of service catalog Use of automated features (e.g. password resets)
    Average call hold time % calls abandoned Average resolution time Number of tickets reopened

    Document in the Ticket Analysis Report.

    Inefficient ticket-handling processes lead to SLA breaches and unplanned downtime

    Analyze the ticket data to catch mismanaged or lost tickets that lead to unnecessary escalations and impact business profitability

    • Ticket Category – Are your tickets categorized by type of asset? By service?
    • Average Ticket Times – How long does it take to resolve or fulfill tickets?
    • Ticket Priority – What is the impact and urgency of the ticket?
    • SLA/OLA Violations – Did we meet our SLA objectives? If not, why?
    • Ticket Channel – How was the issue reported or ticket received?
    • Response and Fulfillment – Did we complete first contact resolution? How many times was it transferred?
    • Associated Tasks and Tickets – Is this incident associated with any other tasks like change tickets or problem tickets?

    Encourage proper ticket-handling procedures to enable data quality

    Ensure everyone understands the expectations and the value created from having ticket data that follows these expectations

    • Create and update tickets, but not at the expense of good customer service. Agents can start the ticket but shouldn’t spend five minutes creating the ticket when they should be troubleshooting the problem.
    • Update the ticket when the issue is resolved or needs to be escalated. If agents are escalating, they should make sure all relevant information is passed along within the ticket to the next technician.
    • Update user of ETA if issue cannot be resolved quickly.
    • Ticket templates for common incidents can lead to fast creation, data input, and categorizations. Templates can reduce the time it takes to create tickets from two minutes to 30 seconds.
    • Update categories to reflect the actual issue and resolution.
    • Reference or link to the knowledgebase article as the documented steps taken to resolve the incident.
    • Validate with the client that the incident is resolved; automate this process with ticket closure after a certain time.
    • Close or resolve the ticket on time.

    Info-Tech Insight

    Ticket handling ensures clean handovers, whether it is to higher tiers or back to the customer. When filling the ticket out with information intended for another party, ensure the information is written for their benefit and from their point of view.

    Service Desk Ticket Analysis Tool overview

    The Service Desk Ticket Analysis Tool will help you standardize your ticket data in a meaningful format that will allow you to apply common analyses to identify the actions you need to take to improve service desk operations

    TABS 1 & 2
    INSTRUCTIONS & DATA ENTRY
    TAB 3 : TICKET SUMMARY
    TICKET SUMMARY DASHBOARDS
    TABS 4 to 8: DASHBOARDS
    INCIDENT SERVICE REQUEST CATEGORY
    Sample of the Service Desk Ticket Analysis Tool, tabs 1 & 2.
    Input at least three months of your exported ticket data into the corresponding columns in the tool to feed into the common analysis graphs in the other tabs.
    Sample of the Service Desk Ticket Analysis Tool, tab 3.
    This tab contains multiple dashboards analyzing how tickets come in, who requests them, who resolves them, and how long it takes to resolve them.
    Sample of the Service Desk Ticket Analysis Tool, tabs 4 to 8.
    These tabs each have dashboards outlining analysis on incidents and service requests. The category tab will allow you to dive deeper on commonly reported issues.

    1.1.3 Import your data into our Service Desk Ticket Analysis Tool

    You can still leverage your current data, but use this opportunity to improve your service desk ticket fields down the line

    Input: ITSM data log

    Output: Populated Service Desk Ticket Data Analysis Tool

    Materials: Whiteboard/flip charts, Service Desk Ticket Analysis Tool

    Participants: Service Desk Manager, Service Desk Technicians

    Start here:

    • Extract your ticket data from your ITSM tool in an Excel or text format.
    • Look at the fields on the data entry tab of the Service Desk Ticket Analysis Tool.
    • Fill the fields with your ticket data by copying and pasting relevant sections. It is okay if you don’t have all the fields, but take note of the fields you are missing.
    • With the list of the fields you are missing, run through the following activity to decide if you will need to adopt or add fields to your own service desk ticket tool.
    Fields Captured
    Ticket Number Open Date
    Open Time Closed Date
    Closed Time Intake Channel
    Time to Resolve Site Location
    First Contact Resolution Resolution Code
    Category (I, II, III) Ticket Type (Request or Incident)
    Status of Ticket Resolved by Tier
    Ticket Priority Requestor/Department
    SLA Fulfilled Subject
    Technician

    When entering your data, pay close attention to the following fields:

    • Time to Resolve: This is automatically calculated using data in the Open Date, Open Time, Close Date, and Close Time fields. You have three options for entering your data in these fields:
      1. Enter your data as the fields describe. Ensure your data contain only the field description (e.g. Open Date separated from Open Time). If your data contain Open Date AND Open Time, Excel will not show both.
      2. Enter your data only in Open Date and Close Date. If your ITSM does not separate date and time, you can keep the data in a single cell and enter it in the column. The formula in Time to Resolve will still be accurate.
      3. If your ITSM outputs Time to Resolve, overwrite the formula in the Time to Resolve column.
    • SLA: If your ITSM outputs SLA fulfilled: Y/N, enter that directly into the SLA Fulfilled column.
    • Blank Columns: If you do not have data for all the columns, that is okay. Continue with the following activity. Note that some stock dashboards will be empty if that is the case.
    • Incidents vs. Service Requests: If you separate incidents and service requests, be sure to capture that in the SR/Incident for Tabs 4 and 5. If you do not separate the two, then you will only need to analyze Tab 3.
    Fields Captured
    Ticket Number Open Date
    Open Time Closed Date
    Closed Time Intake Channel
    Time to Resolve Site Location
    First Contact Resolution Resolution Code
    Category (I, II, III) Ticket Type (Request or Incident)
    Status of Ticket Resolved by Tier
    Ticket Priority Requestor/Department
    SLA Fulfilled Subject
    Technician

    Use Info-Tech’s tool instead of building your own. Download the Service Desk Ticket Analysis Tool.

    1.1.4 Update your ticket fields for future analysis

    Input: Populated Service Desk Ticket Data Analysis Tool

    Output: New ticket fields to track

    Materials: Whiteboard/flip charts, Service Desk Ticket Analysis Tool

    Participants: Service Desk Manager, Service Desk Technicians

    As a group, pay attention to the ticket fields populated in the tool as well as the ticket fields that you were not able to populate. Use the example “Fields Captured” table to the right, which lists all fields present in the ticket analysis tool.

    Discuss the following questions:

    1. Consider the fields not captured. Would it be valuable to start capturing that data for future analysis?
    2. If so, does your ITSM support that field?
    3. Can you make the change in-house or do you have to bring in an external ITSM administrator to make the change?
    4. Capture the results in the Ticket Analysis Report.
    Example: Fields Captured - Fields Not Captured
    Ticket Number Open Date
    Open Time Closed Date
    Closed Time Intake Channel
    Time to Resolve Site Location
    First Contact Resolution Resolution Code
    Category (I, II, III) Ticket Type (Request or Incident)
    Status of Ticket Resolved by Tier
    Ticket Priority Requestor/Department
    SLA Fulfilled Subject
    Technician

    Document in the Ticket Analysis Report.

    Info-Tech Insight

    Don’t wait for your ticket quality to be perfect. You can still draw actions from your ticket data. They will likely be process improvements initially, but the exercise of pulling the data is a necessary first step.

    Common ticket fields tracked by your peers

    Which of these metrics do you track and action?

    • Remember you don’t have to track every metric. Only track metrics that are actionable.

    For each metric that you end up tracking:

    • Look for trends over time.
    • Brainstorm reasons why the metric could rise or fall.

    Associate a metric with each improvement you execute.

    • Performing this step will allow you to better see the value from your team’s efforts.
    • It will also give you a quicker response than waiting for spikes in your data.

    A bar chart of 'Metrics tracked by other organizations' with the x-axis populated by different metrics and the y-axis as '% organizations who track the metric'. The highest percentage of businesses track 'Ticket volume', then 'Ticket trends by category', then 'Tickets by business units'. The lowest three shown are 'Reopened tickets', 'Cost per ticket', and 'Other'.(Source: Info-Tech survey, 2021; N=20)

    PHASE 2

    Analyze Your Ticket Data

    This phase will walk you through the following activities:

    • 2.1.1 Review high-level ticket dashboards
    • 2.2.1 Review incident, service request, and ticket category dashboards

    This phase involves the following participants:

    • Service Desk Manager
    • Service Desk Technicians
    • IT Managers

    Visualize your ticket data as a first step to analysis

    Identifying trends is easier when looking at diagrams, graphs, and figures

    Start your analysis with common visuals employed by other service desk professionals

    • Phase 2 will walk you through visualizing your data to get a better understanding of your ticket intake, incident management, and service request management.
    • Each step will walk you through:
      • Common visualizations used by service desks
      • Patterns to look for in your visualizations
      • Actions to take to address negative patterns and to continue positive trends
    • Share diagrams that underscore both the value being provided by the service desk as well as the scope of the pain points. Use Info-Tech’s Ticket Analysis Report template as a starting point.

    “Being able to tell stories with data is a skill that’s becoming ever more important in our world of increasing data and desire for data-driven decision making. An effective data visualization can mean the difference between success and failure when it comes to communicating the findings of your study, raising money for your nonprofit, presenting to your board, or simply getting your point across to your audience.” - Cole Knaflic, Founder and CEO, Storytelling with Data: A Data Visualization Guide for Business Professionals

    Use the detailed dashboards to determine the next steps for improvement

    A single number doesn’t tell the whole picture

    Analyze trends over time:

    • Analyze trends by day, by week, by month, and by year to determine:
      • When are the busy periods? (E.g. Do tickets tend to spike every morning, every Monday, or every September?)
      • When are the slow periods? (E.g. Do tickets drop at the end of the day, at midday, on Fridays, or over the summer?)
    • Are spikes or drops in volume consistent trends or one-time anomalies?

    Then build a plan to address them:

    • How will you handle volume spikes, if they’re consistent?
    • What can your resources work on during slow times, if they are consistent?
    • If you assume no shrinkage, can you handle the peaks in volume if you make all FTEs available to work on tickets at a certain time of day?

    Sample of a bar chart comparing tickets that were 'Backlog versus Closed by Month Opened'.

    Look for seasonal trends. In this example, we see high ticket volumes in May and January, with lower ticket volumes in June and July when many staff are taking holidays. However, also be careful to look at the big picture of how you pulled the data. August through October sees a high volume of open tickets because the data set is pulled in November, not because there’s a seasonal spike on tickets not closing at the end of the fiscal year.

    Track ticket data over time

    Make low-effort adjustments before major changes

    Don’t rush to a decision based off the first numbers you see

    Review ticket summary dashboard

    Ideally, you should track ticket patterns over an entire year to get a full sense of trends within each month of the year. At minimum, track for 30 days, then 60, then 90, and see if anything changes. The longer you can track ticket patterns, the more accurate your picture will be.

    Review additional dashboards

    If you separate incidents and service requests, and you have accurate ticket categories, then you can use these dashboards to further break down the data to identify ticket trends.

    The output of the ticket analysis will only be as accurate as its input.
    To get the most accurate results, first ensure your data is accurate, then analyze it over as much time as possible. Aggregating with accurate data will give you a better picture of the trends in demand that your service desk sees.

    Not separating incidents and service requests? Need to fix your ticket categories? Visit Standardize the Service Desk to get started.

    Analyze incidents and requests separately

    Each type has its own set of customer experiences and expectations

    • Different ticket types are associated with radically different prioritization, routing, and service levels. For instance, most incidents are resolved within a business day, but requests take longer to implement.
    • If you fail to distinguish between ticket types, your metrics will obscure service desk performance.
    • From a ticket analysis standpoint, separating ticket types prior to analysis or, better yet, at intake allows for cleaner data. In turn, this means more structured analyses, better insights, and more meaningful actions. Not separating ticket types may still get you to the same conclusions, but it will be much more difficult to sift through the data.

    Incident

    An unanticipated interruption of a service.
    The goal of incident management is to restore the service as soon as possible, even if the resolution involves a workaround.

    Request

    A generic description for a small change or service access.
    Requests are small, frequent, and low risk. They are best handled by a process distinct from incident, change, and project management.

    Not separating incidents and service requests? Need to fix your ticket categories? Visit Standardize the Service Desk to get started.

    Step 2.1

    Analyze Your High-Level Ticket Data

    Dashboards
    • Ticket Volume
    • Ticket Intake
    • Ticket Handling and Resolution
    • Ticket Categorization

    This step will walk you through the following activities:

    Visualize the current state of your service desk.

    This step involves the following participants:

    • Service Desk Manager
    • Service Desk Technicians
    • IT Managers

    Outcomes of this step

    Build your metrics baseline to compare with future metric results.

    Dashboards: Ticket Volume

    Example of a dashboard for ticket volume with two bar charts, one breaking down volume by month, and the other marking certain days or weeks in each month.

    Analyze your data for insights

    • Analyze volume trends by day, by week, by month, and by year to determine:
      • When are the busy periods? (E.g. Do tickets tend to spike every morning, every Monday, or every September?)
      • When are slow periods? (E.g. Do tickets drop at the end of the day, at midday, on Fridays, or over the summer?)
    • Are spikes or drops in volume consistent trends or one-time anomalies?
    • What can your resources be working on during slow times? Are you able to address ticket backlog?

    Dashboards: Ticket Intake

    Example of a dashboard for ticket intake with three bar charts, one breaking it down by 'Intake Channel', one by 'Requestor/Department', and one by 'Location'.

    Analyze your data for insights

    • Determine how to drive intake to the most appropriate solution for your organization:
      • A web portal is the most efficient intake method, but it must be user friendly to increase its adoption.
      • The phone should be available for urgent requests or incidents. Encourage those who call with a request to submit a ticket through the portal.
      • Discourage use of email if it is unstructured, as users don’t provide enough detail, and often two or three transactions are required for triage.
      • If walk-ups are encouraged, structure and formalize the support so it can be resourced and managed rather than interrupt-driven.

    Dashboard: Ticket Handling and Resolution

    Example of a dashboard for ticket handling and resolution with three bar charts, one breaking down 'Tickets Resolved by Technician', one by 'Tier', and one by 'Average Time to Resolve (Hours)'.

    Analyze your data for insights

    • Look at your ticket load by technician and by tier. This is an essential step to set your baseline to measure your shift-left initiatives. If you are focusing on self-service or Tier 1 training, the ticket load from higher tiers should decrease over time.
    • If Tiers 2 and 3 are handling the majority of the tickets, this could be a red flag indicating tickets are inappropriately escalated or Tier 1 could use more training and support.
    • For average time to resolve and average time to resolve by tier, are you meeting your SLAs? If not, are your SLAs too aggressive? Are tickets left open and not properly closed?

    Dashboard: Ticket Categorization

    Analyze your data for insights

    • Ticket categorization is critical to clean data. Having a categorization scheme with categories that are miscellaneous, too specific, or too general easily leads to inaccurate reporting or confusing workflows for technicians.
    • When looking at your ticket categories, first look for duplicate categories that could be collapsed into one.
    • Also look at your top five to seven categories and see if they make sense. Are these good candidates in your organization for automation or shift-left?
    • Compare your Tier 1 categories. The level of specificity for these categories should be comparable to easily run reports. If they are not, assess the need for a category redesign.

    Example of a dashboard for ticket categorization with one horizontal bar chart, 'Incident Ticket Volume by Level 1 Category'.

    Step 2.2

    Analyze Incidents, Service Requests, and Ticket Categories

    Dashboards
    • Incidents
    • Service Requests
    • Volume by Ticket Category
    • Resolution Times by Priority and/or Category
    • Tabs for More Granular Investigation and Reporting

    This step will walk you through the following activities:

    Visualize your incident and service request ticket load and analyze trends. Use this information and cross reference data sets to gain a holistic view of how the service desk interacts with IT and the business.

    This step involves the following participants:

    • Service Desk Manager
    • Service Desk Technicians
    • IT Managers

    Outcomes of this step

    Gain actionable, data-driven improvements based on your incident and service request data. Show the value of the service desk and highlight improvements needed.

    Incident and Service Requests Dashboard: Priority and SLA

    Example of an Incident and Service Requests dashboard for priority and SLA with three charts, one breaking down 'Incident Priority', one 'Average time to resolve (in hours) by priority', and one '% of SLA met'.

    Analyze your data for insights

    • Your ticket priority distribution for overall load and time to resolve (TTR) should look something like above with low-priority tickets having higher load and TTR and high/critical-priority tickets having a lower load and lower TTR. If it is reversed, that is a good indication that the service desk is too reactive or isn’t properly prioritizing its work.
    • If your SLA has a high failure rate, consider reassessing your targets with SLOs that you can meet before publishing them as achievable SLAs.

    Incident and Service Requests Dashboard: Priority and SLA

    Example of an Incident and Service Requests dashboard for resolution and close with three bar charts, one breaking down 'Incident Volume by Resolution Code', one 'Incidents Resolved by Tier', and one 'Average time to resolve (in hours) by Resolution Code'.

    Analyze your data for insights

    • Examine your ticket handling by looking at ticket status and resolution codes.
      • If you have a lot of blanks, then tickets are not properly handled. Consider reinforcing your standards for close codes and statuses.
      • Alternatively, if tickets are left open, you may have to build follow-ups on stale tickets into your process or introduce proper auto-close processes.

    Category, Resolution Time, and Resolution Code Dashboards

    These PivotCharts allow you to dig deeper

    Investigate whether there are trends in ticket volume and resolution times within specific categories and subcategories

    Tab 6, Category Dashboard; tab 7, Resolution Time Dashboard; and tab 8, Resolution Code Dashboard are PivotCharts. Use these tabs to investigate whether there are trends in ticket volume, resolution times, and resolution codes within specific categories and subcategories.

    Start with the charts that are available. The +/- buttons will allow you to show more granular information. By default, this granularity will be into the levels of the ticket categorization scheme.

    For most categorization schemes, there will be too many categories to properly graph. You can apply a filter to investigate specific categories by clicking on the drop-down buttons.

    Example of dashboards featured on next slide

    Use these tabs for more granular investigation and reporting

    TAB 6
    CATEGORY DASHBOARD
    TAB 7
    RESOLUTION TIME DASHBOARD
    TAB 8
    RESOLUTION TIME DASHBOARD
    Sample of the 'Ticket Volume by Second, Third Level Category' dashboard tab.
    Investigate ticket distributions in first, second, and third levels. Are certain categories overcrowded, suggesting they can be split? Are certain categories not being used?
    Sample of the 'Average Resolution Times' dashboard tab.
    Do average resolution times match your service level agreements? Do certain categories have significantly different resolution times? Are there areas that can benefit from shift-left?
    Sample of the 'Volume of Resolution Codes' dashboard tab.
    Are resolution codes being accurately used? Are there trends in resolution codes? Are these codes providing sufficient information for problem management?

    PHASE 3

    Communicate Your Insights

    This phase will walk you through the following activities:

    • 3.1.1 Review common recommendations
    • 3.2.1 Review ticket reports daily
    • 3.2.2 Incorporate ticket data into retrospectives and team updates
    • 3.2.3 Regularly review trends with business leaders
    • 3.2.4 Tell a story with your data

    This phase involves the following participants:

    • Service Desk Manager
    • Service Desk Technicians
    • IT Managers

    Step 3.1

    Build Recommendations Based on Your Ticket Data

    Activities
    • 3.1.1 Review common recommendations

    This step will walk you through the following activities:

    Review common recommendations as a first step to extracting insights from your own data.

    This step involves the following participants:

    • Service Desk Manager
    • Service Desk Technicians

    Outcomes of this step

    You will gain an understanding of the common challenges with service desks and ticket analysis in general. See which ones apply to you to inform your ticket data analysis moving forward.

    Review these common recommendations

    1. Fix your ticket categories
      Organize your ticket categorization scheme for proper routing and reporting.
    2. Focus more on self-service
      Self-service is essential to enable shift-left strategies. Focus on knowledgebase processes and portal ease of use.
    3. Update your service catalog
      Improve your service catalog, if necessary, to make it easy for end users to request services and for the service desk to provide those services.
    4. Direct volume toward other channels
      Walk-ups make it more difficult to properly log tickets and assign service desk resources. Drive volume to other channels to improve your ticket quality.
    5. Crosstrain Tier 1 on certain topics
      Tier 1 breadth of knowledge is essential to drive up first contact resolution.
    6. Build more automation
      Identify bottlenecks and challenges with your ticket data to streamline ticket handling and resolution.
    7. Revisit service level agreements
      Update your SLAs and/or SLOs to prioritize expectation management for your end users.
    8. Improve your data quality
      You can only analyze data that exists. Revisit your ticket-handling guidelines and more regularly check tickets to ensure they comply with those standards.

    Optimize your processes and look for opportunities for automation

    Leverage Info-Tech research to improve service desk processes

    Review your service desk processes and tools for optimization opportunities:

    • Clearly establish ticket-handling guidelines.
    • Use ticket templates to reduce time spent entering tickets.
    • Document incident management and service request fulfillment workflows and eliminate any unnecessary steps.
    • Automate manual tasks wherever possible.
    • Build or improve a self-service portal with a knowledgebase to allow users to resolve their own issues, reducing incoming ticket volume to the service desk.
    • Optimize your internal knowledgebase to reduce time spent troubleshooting recurring issues.
    • Leverage AI capabilities to speed up ticket processing and resolution.

    Standardize the Service Desk

    This project will help you build and improve essential service desk processes, including incident management, request fulfillment, and knowledge management.

    Optimize the Service Desk With a Shift-Left Strategy

    This project will help you build a strategy to shift service support left to optimize your service desk operations and increase end-user satisfaction.

    Step 3.2

    Action and Communicate Your Ticket Data

    Activities
    • 3.2.1 Review your ticket queues daily
    • 3.2.2 Incorporate ticket data into retrospectives and team status updates
    • 3.2.3 Regularly review trends with business leaders
    • 3.2.4 Tell a story with your data

    This step will walk you through the following activities:

    Organize your scrums to report on the metrics that will inform daily and monthly operations.

    This step involves the following participants:

    • Service Desk Manager
    • Service Desk Technicians
    • IT Managers

    Outcomes of this step

    Use the dashboards and data to inform your daily and monthly scrums.

    3.2.1 Review your ticket queues daily

    Clean data is still useless if not used properly

    • The metrics you’ve chosen to measure and visualize in the previous step are useful for informing your day-to-day, week-to-week, and month-to-month strategies for the service desk and IT. Conduct scrums daily to action your dashboard data to help clear ticket queues.
    • Reference your dashboards daily with each IT team.
    • You need to have a dashboard of open tickets assigned to each team.

    Review Daily

    • Ticket volume over the last day (look for spikes)
    • SLA breach risks/SLA breaches
    • Recurring incidents
    • Tickets open
    • Tickets handed over (confirmation of handover)

    3.2.2 Incorporate ticket data into retrospectives and team status updates

    Explain your metric spikes and trends

    • Hold weekly or monthly meetings to review the ticket trends selected during Phases 1 and 2 of this blueprint.
    • Review ticket spikes, identify seasonal trends, and discuss root causes (e.g. projects/changes going live, onboarding blitz).
    • Discuss any actions associated with spikes and seasonal trends (e.g. resource allocation, hiring, training).
    • You can incorporate other IT leaders or departments in this meeting as needed to discuss action items for improvement, quality assurance concerns, customer service concerns, and/or operating level agreement concerns.

    Review Weekly/Monthly

    • Ticket volume
    • Ticket category by priority level over time
    • Tickets from different business groups, VIP groups, and different vertical levels
    • Tickets escalated, tickets that didn’t need to be escalated, tickets that were incorrectly escalated
    • Ticket priority levels over time
    • Most requested services
    • Tickets resolved by which group over time
    • Ability to meet SLAs and OLAs over time by different groups

    3.2.3 Regularly review trends with business leaders

    Use your data to help improve business relationships

    Review the following with business leaders:

    • Volume of work done this past time cycle for the leader’s group
    • Trends and spikes in the data and possible explanations for them (note: get their input on the potential causes of trends)
    • Improvements you plan to execute within the service desk
    • Action items you need from the business leader

    Use your data to show the value you provide to the group. Schedule quarterly meetings with the heads of different business groups to discuss the work that the service desk does for each group.

    Show trends in incidents and service requests: “I see you have a spike in CRM tickets. I’ve been working with the CRM team to address this issue.”

    3.2.4 Tell a story with your data

    Effectively communicate with the business and leadership

    • With your visualized metrics, organize your story into a presentation for different stakeholder groups. You can use the Ticket Analysis Report as a starting point to provide data about:
      • Value provided by the service desk
      • Successes
      • Opportunities for Improvements
      • Current state of KPIs
    • Include information about the causes of data trends and actions you will take in response to the data.
    • For each of these themes, look at the metrics you’ve chosen to track and see which ones fit to tell the story. Let the data do the talking.
    • Consider supplementing the ticket data with data from other systems. For example, you can include data on transactional customer satisfaction surveys, knowledgebase utilization, and self-service utilization.

    Sample of the Ticket Analysis Report.

    Download the Ticket Analysis Report.

    Ticket Analysis Report

    Include the following information as you build your ticket analysis report:

    • Value Provided by the Service Desk
      Start with the value provided by the service desk to different areas of the business. Include information about first contact resolution, average resolution times, ticket volume (e.g. by category, priority, location, requestor).
    • Successes
      Successes is a general field that can include how process improvements have impacted the service desk or how initiatives have enhanced shift-left opportunities. Highlight any positive trends over time.
    • Opportunities for Improvement
      Let the data guide the conversation to where improvements can be made. Day-to-day ops, self-service tools, shifting work left from Tier 2, Tier 3, standardizing a non-standard service, and staffing adjustments are possibilities for this section.
    • Current State of KPIs
      Mean time to resolve, FCR, ticket volume, and end-user satisfaction are great KPIs to include as a starting point.

    Sample of the Ticket Analysis Report.

    Download the Ticket Analysis Report.

    Summary of Accomplishment

    Problem Solved

    You now have a better understanding of how to action your service desk ticket data, including improvements to your current ticket templates for incidents and service requests.

    You also have the data to craft a story to different stakeholder groups to celebrate the successes of the service desk and highlight possible improvements. Continue this exercise iteratively to continue improving the service desk.

    Remember, ticket analysis is not a single event but an ongoing initiative. As you track, analyze, and action more data, you will find more improvements.

    If you would like additional support, have our analysts guide you through other phases as part of an Info-Tech workshop.

    Contact your account representative for more information.

    workshops@infotech.com 1-888-670-8889

    Additional Support

    If you would like additional support, have our analysts guide you through other phases as part of an Info-Tech workshop.

    Photo of Benedict Chang.

    Contact your account representative for more information.

    workshops@infotech.com 1-888-670-8889

    To accelerate this project, engage your IT team in an Info-Tech workshop with an Info-Tech analyst team. Info-Tech analysts will join you and your team at your location or welcome you to Info-Tech’s historic Toronto office to participate in an innovative onsite workshop.

    The following are sample activities that will be conducted by Info-Tech analysts with your team:

    Sample of dashboards we saw earlier. Sample of the 'Ticket Analysis Report'.
    Analyze your dashboards
    An analyst will walk through the ticket data and dashboards with you and your team to help interpret the data and tailor improvements
    Populate your ticket data report
    Given the action items from this solution set, an analyst will help you craft a report to celebrate the successes and highlight needed improvements in the service desk.

    Related Info-Tech Research

    Optimize the Service Desk With a Shift-Left Strategy

    The best type of service desk ticket is the one that doesn’t exist.

    Incident & Problem Management

    Don’t let persistent problems govern your department.

    Design & Build a User-Facing Service Catalog

    Improve user satisfaction with IT with a convenient menu-like catalog.

    Bibliography

    Bayes, Scarlett. “ITSM: 2021 & Beyond.” Service Desk Institute, 2021. Web.

    “Benchmarking Report v.9.” Service Desk Institute, 17 Jan. 2020. Web.

    Bennett, Micah. “The 9 Help Desk Metrics That Should Guide Your Customer Support.” Zapier, 3 Dec. 2015. Web.

    “Global State of Customer Service: The transformation of customer service from 2015 to present day.” Microsoft Dynamics 365, Microsoft, 2020. Web.

    Goodey, Ben. “How to Manually Analyze Support Tickets.” SentiSum, 26 July 2021. Web.

    Jadhav, Megha. “Four Metrics to Analyze When Using Ticketing Software.” Vision Helpdesk Blog, 21 Mar. 2016. Web.

    Knaflic, Cole Nussbaumer. Storytelling with Data: A Data Visualization Guide for Business Professionals. Wiley, 2015.

    Li, Ta Hsin, et al. “Incident Ticket Analytics for IT Application Management Services.” 2014 IEEE International Conference on Services Computing, 2014. Web.

    Olson, Sarah. “10 Help Desk Metrics for Service Desks and Internal Help Desks.” Zendesk Blog, Sept. 2021. Web.

    Paramesh, S.P., et al. “Classifying the Unstructured IT Service Desk Tickets Using Ensemble of Classifiers.” 2018 3rd International Conference on Computational Systems and Information Technology for Sustainable Solutions (CSITSS), 2018. Web.

    Volini, Erica, et al. “2021 Global Human Capital Trends: Special Report.” Deloitte Insights, 21 July 2021. Web.

    “What Kind of Analysis You Can Perform on a Ticket Management System.” Commence, 3 Dec. 2019. Web.

    INFO-TECH RESEARCH GROUP

    COVID-19 Work Status Tracking Guide

    • Buy Link or Shortcode: {j2store}594|cart{/j2store}
    • member rating overall impact: N/A
    • member rating average dollars saved: N/A
    • member rating average days saved: N/A
    • Parent Category Name: Manage & Coach
    • Parent Category Link: /manage-coach
    • Keeping track of the multiple and frequently changing work arrangements on your team.
    • Ensuring you have a fast and easy way to keep an up-to-date record of where and how employees are working.

    Our Advice

    Critical Insight

    • During these critical times, keeping track of employees’ work status doesn’t have to be complicated – the right tool is one that does the job.
    • Keeping track of your employees is a health and safety issue – deployed well, it is an aid in keeping the business running and an additional communication channel, not a sign of lack of trust.

    Impact and Result

    • An Excel spreadsheet is all you need to ensure you have a way to record work arrangements that can change by the day.
    • An easy-to-use tool means minimal administrative overhead to ensuring you have this critical information at hand.

    COVID-19 Work Status Tracking Guide Research & Tools

    Start here – read the Work Status Tracking Guide

    Read our recommendations and use the accompanying tool to quickly get a handle on your team’s work arrangements.

    Besides the small introduction, subscribers and consulting clients within this management domain have access to:

    • COVID-19 Work Status Tracking Guide Storyboard
    • COVID-19 Work Status Tracking Tool
    [infographic]

    Manage Poor Performance While Working From Home

    • Buy Link or Shortcode: {j2store}599|cart{/j2store}
    • member rating overall impact: 9.0/10 Overall Impact
    • member rating average dollars saved: $1,600 Average $ Saved
    • member rating average days saved: 18 Average Days Saved
    • Parent Category Name: Manage & Coach
    • Parent Category Link: /manage-coach
    • For many, emergency WFH comes with several new challenges such as additional childcare responsibilities, sudden changes in role expectations, and negative impacts on wellbeing. These new challenges, coupled with previously existing ones, can result in poor performance. Owing to the lack of physical presence and cues, managers may struggle to identify that an employee’s performance is suffering. Even after identifying poor performance, it can be difficult to address remotely when such conversations would ideally be held in person.

    Our Advice

    Critical Insight

    • Poor performance must be managed, despite the pandemic. Evaluating root causes of performance issues is more important than ever now that personal factors such as lack of childcare and eldercare for those working from home are complicating the issue.

    Impact and Result

    • Organizations need to have a clear process for improving performance for employees working remotely during the COVID-19 pandemic. Provide managers with resources to help them identify performance issues and uncover their root causes as part of addressing overall performance. This will allow managers to connect employees with the required support while working with them to improve performance.

    Manage Poor Performance While Working From Home Research & Tools

    Besides the small introduction, subscribers and consulting clients within this management domain have access to:

    1. Follow the remote performance improvement process

    Determine how managers can identify poor performance remotely and help them navigate the performance improvement process while working from home.

    • Manage Poor Performance While Working From Home Storyboard
    • Manage Poor Performance While Working From Home: Manager Guide
    • Manage Poor Performance While Working From Home: Infographic

    2. Clarify roles and leverage resources

    Clarify roles and responsibilities in the performance improvement process and tailor relevant resources.

    • Wellness and Working From Home
    [infographic]

    Further reading

    Manage Poor Performance While Working From Home

    Assess and improve remote work performance with our ready-to-use tools.

    Executive Summary

    McLean & Company Insight

    Poor performance must be managed, despite the pandemic. Evaluating root causes of performance issues is more important than ever now that personal factors such as lack of childcare and eldercare for those working from home are complicating the issue.

    Situation

    COVID-19 has led to a sudden shift to working from home (WFH), resulting in a 72% decline in in-office work (Ranosa, 2020). While these uncertain times have disrupted traditional work routines, employee performance remains critical, as it plays a role in determining how organizations recover. Managers must not turn a blind eye to performance issues but rather must act quickly to support employees who may be struggling.

    Complication

    For many, emergency WFH comes with several new challenges such as additional childcare responsibilities, sudden changes in role expectations, and negative impacts on wellbeing. These new challenges, coupled with previously existing ones, can result in poor performance. Owing to the lack of physical presence and cues, managers may struggle to identify that an employee’s performance is suffering. Even after identifying poor performance, it can be difficult to address remotely when such conversations would ideally be held in person.

    Solution

    Organizations need to have a clear process for improving performance for employees working remotely during the COVID-19 pandemic. Provide managers with resources to help them identify performance issues and uncover their root causes as part of addressing overall performance. This will allow managers to connect employees with the required support while working with them to improve performance.

    Manage Poor Performance While Working From Home is made up of the following resources:

    1

    Identify

    2

    Initiate

    3

    Deploy

    4

    a) Follow Up
    b) Decide
    Storyboard

    This storyboard is organized by the four steps of the performance improvement process: identify, initiate, deploy, and follow up/decide. These will appear on the left-hand side of the slides as a roadmap.

    The focus is on how HR can design the process for managing poor performance remotely and support managers through it while emergency WFH measures are in place. Key responsibilities, email templates, and relevant resources are included at the end.

    Adapt the process as necessary for your organization.

    Manager Guide

    The manager guide contains detailed advice for managers on navigating the process and focuses on the content of remote performance discussions.

    It consists of the following sections:

    • Identifying poor performance.
    • Conducting performance improvement discussions.
    • Uncovering and addressing root causes of poor performance.
    Manager Infographic

    The manager infographic illustrates the high-level steps of the performance improvement process for managers in a visually appealing and easily digestible manner.

    This can be used to easily outline the process, providing managers with a resource to quickly reference as they navigate the process with their direct reports.

    In this blueprint, “WFH” and “remote working” are used interchangeably.

    This blueprint will not cover the performance management framework; it is solely focused on managing performance issues.

    For information on adjusting the regular performance management process during the pandemic, see Performance Management for Emergency Work-From-Home.

    Identify how low performance is normally addressed

    A process for performance improvement is not akin to outlining the steps of a performance improvement plan (PIP). The PIP is a development tool used within a larger process for performance improvement. Guidance on how to structure and use a PIP will be provided later in this blueprint.

    Evaluate how low performance is usually brought to the attention of HR in a non-remote situation:
    • Do managers approach HR for an employee transfer or PIP without having prior performance conversations with the employee?
    • Do managers come to HR when they need support in developing an employee in order to meet expectations?
    • Do managers proactively reach out to HR to discuss appropriate L&D for staff who are struggling?
    • Do some departments engage with the process while others do not?
    Poor performance does not signal the immediate need to terminate an employee. Instead, managers should focus on helping the struggling employee to develop so that they may succeed.
    Evaluate how poor performance is determined:
    • Do managers use performance data or concrete examples?
    • Is it based on a subjective assessment by the manager?
    Keep in mind that “poor performance” now might look different than it did before the pandemic. Employees must be aware of the current expectations placed on them before they can be labeled as underperforming – and the performance expectations must be assessed to ensure they are realistic.

    For information on adjusting performance expectations during the pandemic, see Performance Management for Emergency Work-From-Home.

    The process for non-union and union employees will likely differ. Make sure your process for unionized employees aligns with collective agreements.

    Determine how managers can identify poor performance of staff working remotely

    1

    Identify

    2

    Initiate

    3

    Deploy

    4

    a) Follow Up
    b) Decide
    Identify: Determine how managers can identify poor performance.
    In person, it can be easy to see when an employee is struggling by glancing over at their desk and observing body language. In a remote situation, this can be more difficult, as it is easy to put on a brave face for the half-hour to one-hour check-in. Advise managers on how important frequent one-one-ones and open communication are in helping identify issues when they arise rather than when it’s too late.

    Managers must clearly document and communicate instances where employees aren’t meeting role expectations or are showing other key signs that they are not performing at the level expected of them.

    What to look for:
    • PM data/performance-related assessments
    • Continual absences
    • Decreased quality or quantity of output
    • Frequent excuses (e.g. repeated internet outages)
    • Lack of effort or follow-through
    • Missed deadlines
    • Poor communication or lack of responsiveness
    • Failure to improve
    It’s crucial to acknowledge an employee might have an “off week” or need time to adjust to working from home, which can be addressed with performance management techniques. Managers should move into the process for performance improvement when:
    • Performance fluctuates frequently or significantly.
    • Performance has dropped for an extended period of time.
    • Expectations are consistently not being met.

    While it’s important for managers to keep an eye out for decreased performance, discourage them from over-monitoring employees, as this can lead to a damaging environment of distrust.

    Support managers in initiating performance conversations and uncovering root causes

    1

    Identify

    2

    Initiate

    3

    Deploy

    4

    a) Follow Up
    b) Decide
    Initiate: Require that managers have several conversations about low performance with the employee.
    Before using more formal measures, ensure managers take responsibility for connecting with the employee to have an initial performance conversation where they will make the performance issue known and try to diagnose the root cause of the issue.

    Coach managers to recognize behaviors associated with the following performance inhibitors:

    Personal Factors

    Personal factors, usually outside the workplace, can affect an employee’s performance.

    Lack of clarity

    Employees must be clear on performance expectations before they can be labeled as a poor performer.

    Low motivation

    Lack of motivation to complete work can impact the quality of output and/or amount of work an employee is completing.

    Inability

    Resourcing, technology, organizational change, or lack of skills to do the job can all result in the inability of an employee to perform at their best.

    Poor people skills

    Problematic people skills, externally with clients or internally with colleagues, can affect an employee’s performance or the team’s engagement.

    Personal factors are a common performance inhibitor due to emergency WFH measures. The decreased divide between work and home life and the additional stresses of the pandemic can bring up new cases of poor performance or exacerbate existing ones. Remind managers that all potential root causes should still be investigated rather than assuming personal factors are the problem and emphasize that there can be more than one cause.

    Ensure managers continue to conduct frequent performance conversations

    Once an informal conversation has been initiated, the manager should schedule frequent one-on-one performance conversations (above and beyond performance management check-ins).

    1

    Identify

    2

    Initiate

    3

    Deploy

    4

    a) Follow Up
    b) Decide
    Explain to managers the purpose of these discussions is to:
    • Continue to probe for root causes.
    • Reinforce role expectations and performance targets.
    • Follow up on any improvements.
    • Address the performance issue and share relevant resources (e.g. HR or employee assistance program [EAP]).
    Given these conversations will be remote, require managers to:
    • Use video whenever possible to read physical cues and body language.
    • Bookend the conversation. Starting each meeting by setting the context for the discussion and finishing with the employee reiterating the key takeaways back will ensure there are no misunderstandings.
    • Document the conversation and share with HR. This provides evidence of the conversations and helps hold managers accountable.
    What is HR’s role? HR should ensure that the manager has had multiple conversations with the employee before moving to the next step. Furthermore, HR is responsible for ensuring manages are equipped to have the conversations through coaching, role-playing, etc.

    For more information on the content of these conversations or for material to leverage for training purposes, see Manage Poor Performance While Working From Home: Manager Guide.

    McLean & Company Insight

    Managers are there to be coaches, not therapists. Uncovering the root cause of poor performance will allow managers to pinpoint supports needed, either within their expertise (e.g. coaching, training, providing flexible hours) or by directing the employee to proper external resources such as an EAP.

    Help managers use formal performance improvement tools with remote workers

    1

    Identify

    2

    Initiate

    3

    Deploy

    4

    a) Follow Up
    b) Decide
    Deploy: Use performance improvement tools.
    If initial performance conversations were unsuccessful and performance does not improve, refer managers to performance improvement tools:
    • Suggest any other available support and resources they have not yet recommended (e.g. EAP).
    • Explore options for co-creation of a development plan to increase employee buy-in. If the manager has been diligent about clarifying role expectations, invite the employee to put together their own action plan for meeting performance goals. This can then be reviewed and finalized with the manager.
    • Have the manager use a formal PIP for development and to get the employee back on track. Review the development plan or PIP with the manager before they share it with the employee to ensure it is clear and has time bound, realistic goals for improvement.
    Using a PIP solely to avoid legal trouble and terminate employees isn’t true to its intended purpose. This is what progressive discipline is for.In the case of significant behavior problems, like breaking company rules or safety violations, the manager will likely need to move to progressive discipline. HR should advise managers on the appropriate process.

    When does the issue warrant progressive discipline? If the action needs to stop immediately, (e.g. threatening or inappropriate behavior) and/or as outlined in the collective agreement.

    Clarify remote PIP stages and best practices

    1

    Identify

    2

    Initiate

    3

    Deploy

    4

    a) Follow Up
    b) Decide
    Sample Stages:
    1. Written PIP
    • HR reviews and signs off on PIP
    • Manager holds meeting to provide employee with PIP
    • Employee reviews the PIP
    • Manager and employee provide e-signatures
    • Signed PIP is given to HR
    2. Possible Extension
    3. Final Notice
    • Manager provides employee with final notice if there has been no improvement in agreed time frame
    • Copy of signed final notice letter given to HR

    Who is involved?

    The manager runs the meeting with the employee. HR should act as a support by:

    • Ensuring the PIP is clear, aligned with the performance issue, and focused on development, prior to the meeting.
    • Pointing to resources and making themselves available prior to, during, and after the meeting.
      • When should HR be involved? HR should be present in the meeting if the manager has requested it or if the employee has approached HR beforehand with concerns about the manager. Keep in mind that if the employee sees HR has been unexpectedly invited to the video call, it could add extra stress for them.
    • Reviewing documentation and ensuring expectations and the action plan are reasonable and realistic.

    Determine the length of the PIP

    • The length of the initial PIP will often depend on the complexity of the employee’s role and how long it will reasonably take to see improvements. The minimum (before a potential extension) should be 30-60 days.
    • Ensure the action plan takes sustainment into account. Employees must be able to demonstrate improvement and sustain improved performance in order to successfully complete a PIP.

    Timing of delivery

    Help the manager determine when the PIP meeting will occur (what day, time of day). Take into account the schedule of the employee they will be meeting with (e.g. avoid scheduling right before an important client call).

    1

    Identify

    2

    Initiate

    3

    Deploy

    4

    a) Follow Up
    b) Decide

    Follow up: If the process escalated to step 3 and is successful.

    What does success look like? Performance improvement must be sustained after the PIP is completed. It’s not enough to simply meet performance improvement goals and expectations; the employee must continue to perform.

    Have the manager schedule a final PIP review with the employee. Use video, as this enables the employee and manager to read body language and minimize miscommunication/misinterpretation.

    • If performance expectations have been met, instruct managers to document this in the PIP, inform the employee they are off the PIP, and provide it to HR.

    The manager should also continue check-ins with the employee to ensure sustainment and as part of continued performance management.

    • Set a specific timeline, e.g. every two weeks or every month. Choose a cadence that works best for the manager and employee.

    OR

    Decide: Determine action steps if the process is unsuccessful.

    If at the end of step 3 performance has not sufficiently improved, the organization (HR and the manager) should either determine if the employee could/should be temporarily redeployed while the emergency WFH is still in place, if a permanent transfer to a role that is a better fit is an option, or if the employee should be let go.

    See the Complete Manual for COVID-19 Layoffs blueprint for information on layoffs in remote environments.

    Managers, HR, and employees all have a role to play in performance improvement

    Managers
    • Identify the outcomes the organization is looking for and clearly outline and communicate the expectations for the employee’s performance.
    • Diagnose root cause(s) of the performance issue.
    • Support employee through frequent conversations and feedback.
    • Coach for improved performance.
    • Visibly recognize and broadcast employee achievements.
    Employees
    • Have open and honest conversations with their manager, acknowledge their accountability, and be receptive to feedback.
    • Set performance goals to meet expectations of the role.
    • Prepare for frequent check-ins regarding improvement.
    • Seek support from HR as required.
    HR
    • Provide managers with a process, training, and support to improve employee performance.
    • Coach managers to ensure employees have been made aware of their role expectations and current performance and given specific recommendations on how to improve.
    • Reinforce the process for improving employee performance to ensure that adequate coaching conversations have taken place before the formal PIP.
    • Coach employees on how to approach their manager to discuss challenges in meeting expectations.

    HR should conduct checkpoints with both managers and employees in cases where a formal PIP was initiated to ensure the process for performance improvement is being followed and to support both parties in improving performance.

    Email templates

    Use the templates found on the next slides to draft communications to employees who are underperforming while working from home.

    Customize all templates with relevant information and use them as a guide to further tailor your communication to a specific employee.

    Customization Recommendations

    Review all slides and adjust the language or content as needed to suit the needs of the employee, the complexity of their role, and the performance issue.

    • The pencil icon to the left denotes slides requiring customization of the text. Customize text in grey font and be sure to convert all font to black when you are done.

    Included Templates

    1. Performance Discussion Follow-Up
    2. PIP Cover Letter

    This template is not a substitute for legal advice. Ensure you consult with your legal counsel, labor relations representative, and union representative to align with collective agreements and relevant legislation.

    Sample Performance Discussion Follow-Up

    Hello [name],

    Thank you for the commitment and eagerness in our meeting yesterday.

    I wanted to recap the conversation and expectations for the month of [insert month].

    As discussed, you have been advised about your recent [behavior, performance, attendance, policy, etc.] where you have demonstrated [state specific issue with detail of behavior/performance of concern]. As per our conversation, we’ll be working on improvement in this area in order to meet expectations set out for our employees.

    It is expected that employees [state expectations]. Please do not hesitate to reach out to me if there is further clarification needed or you if you have any questions or concerns. The management team and I are committed to helping you achieve these goals.

    We will do a formal check-in on your progress every [insert day] from [insert time] to review your progress. I will also be available for daily check-ins to support you on the right track. Additionally, you can book me in for desk-side coaching outside of my regular desk-side check-ins. If there is anything else I can do to help support you in hitting these goals, please let me know. Other resources we discussed that may be helpful in meeting these objectives are [summarize available support and resources]. By working together through this process, I have no doubt that you can be successful. I am here to provide support and assist you through this.

    If you’re unable to show improvements set out in our discussion by [date], we will proceed to a formal performance measure that will include a performance improvement plan. Please let me know if you have any questions or concerns; I am here to help.

    Please acknowledge this email and let me know if you have any questions.

    Thank you,

    PIP Cover Letter

    Hello [name] ,

    This is to confirm our meeting on [date] in which we discussed your performance to date and areas that need improvement. Please find the attached performance improvement plan, which contains a detailed action plan that we have agreed upon to help you meet role expectations over the next [XX days]. The aim of this plan is to provide you with a detailed outline of our performance expectations and provide you the opportunity to improve your performance, with our support.

    We will check in every [XX days] to review your progress. At the end of the [XX]-day period, we will review your performance against the role expectations set out in this performance improvement plan. If you don’t meet the performance requirements in the time allotted, further action and consequences will follow.

    Should you have any questions about the performance improvement plan or the process outlined in this document, please do not hesitate to discuss them with me.

    [Employee name], it is my personal objective to help you be a fully productive member of our team. By working together through this performance improvement plan, I have no doubt that you can be successful. I am here to provide support and assist you through the process. At this time, I would also like to remind you about the [additional resources available at your organization, for example, employee assistance program or HR].

    Please acknowledge this email and let me know if you have any questions.

    Thank you,

    Prepare and customize manager guide and resources

    Sample of Manage Poor Performance While Working From Home: Manager Guide. Manage Poor Performance While Working From Home: Manager Guide

    This tool for managers provides advice on navigating the process and focuses on the content of remote performance discussions.

    Sample of Set Meaningful Employee Performance Measures. Set Meaningful Employee Performance Measures

    See this blueprint for information on setting holistic measures to inspire employee performance.

    Sample of Manage Poor Performance While Working From Home: Infographic. Manage Poor Performance While Working From Home: Infographic

    This tool illustrates the high-level steps of the performance improvement process.

    Sample of Wellness and Working From Home: Infographic. Wellness and Working From Home: Infographic

    This tool highlights tips to manage physical and mental health while working from home.

    Sample of Build a Better Manager: Team Essentials. Build a Better Manager: Team Essentials

    See this solution set for more information on kick-starting the effectiveness of first-time IT managers with essential management skills.

    Sample of Leverage Agile Goal Setting for Improved Employee Engagement & Performance. Leverage Agile Goal Setting for Improved Employee Engagement & Performance

    See this blueprint for information on dodging the micromanaging foul and scoring with agile short-term goal setting.

    Bibliography

    Arringdale, Chris. “6 Tips For Managers Trying to Overcome Performance Appraisal Anxiety.” TLNT. 18 September 2015. Accessed 2018.

    Borysenko, Karlyn. “What Was Management Thinking? The High Cost of Employee Turnover.” Talent Management and HR. 22 April 2015. Accessed 2018.

    Cook, Ian. “Curbing Employee Turnover Contagion in the Workplace.” Visier. 20 February 2018. Accessed 2018.

    Cornerstone OnDemand. Toxic Employees in the Workplace. Santa Monica, California: Cornerstone OnDemand, 2015. Web.

    Dewar, Carolyn and Reed Doucette. “6 elements to create a high-performing culture.” McKinsey & Company. 9 April 2018. Accessed 2018.

    Eagle Hill. Eagle Hill National Attrition Survey. Washington, D.C.: Eagle Hill, 2015. Web.

    ERC. “Performance Improvement Plan Checklist.” ERC. 21 June 2017. Accessed 2018.

    Foster, James. “The Impact of Managers on Workplace Engagement and Productivity.” Interact. 16 March 2017. Accessed 2018.

    Godwins Solicitors LLP. “Employment Tribunal Statistics for 2015/2016.” Godwins Solicitors LLP. 8 February 2017. Accessed 2018.

    Mankins, Michael. “How to Manage a Team of All-Stars.” Harvard Business Review. 6 June 2017. Accessed 2018.

    Maxfield, David, et al. The Value of Stress-Free Productivity. Provo, Utah: VitalSmarts, 2017. Web.

    Murphy, Mark. “Skip Your Low Performers When Starting Performance Appraisals.” Forbes. 21 January 2015. Accessed 2018.

    Quint. “Transforming into a High Performance Organization.” Quint Wellington Redwood. 16 November 2017. Accessed 2018.

    Ranosa, Rachel. "COVID -19: Canadian Productivity Booms Despite Social Distancing." Human Resources Director, 14 April 2020. Accessed 2020.

    CIO Priorities 2022

    • Buy Link or Shortcode: {j2store}328|cart{/j2store}
    • member rating overall impact: 10.0/10 Overall Impact
    • member rating average dollars saved: $31,499 Average $ Saved
    • member rating average days saved: 9 Average Days Saved
    • Parent Category Name: Innovation
    • Parent Category Link: /innovation
    • Understand how to respond to trends affecting your organization.
    • Determine your priorities based on current state and relevant internal factors.
    • Assign the right amount of resources to accomplish your vision.
    • Consider what new challenges outside of your control will demand a response.

    Our Advice

    Critical Insight

    A priority is created when external factors hold strong synergy with internal goals and an organization responds by committing resources to either avert risk or seize opportunity. These are the priorities identified in the report:

    1. Reduce Friction in the Hybrid Operating Model
    2. Improve Your Ransomware Readiness
    3. Support an Employee-Centric Retention Strategy
    4. Design an Automation Platform
    5. Prepare to Report on New Environmental, Social, and Governance Metrics

    Impact and Result

    Update your strategic roadmap to include priorities that are critical and relevant for your organization based on a balance of external and internal factors.

    CIO Priorities 2022 Research & Tools

    Besides the small introduction, subscribers and consulting clients within this management domain have access to:

    1. CIO Priorities 2022 – A report on the key priorities for competing in the digital economy.

    Discover Info-Tech’s five priorities for CIOs in 2022.

    • CIO Priorities Report for 2022

    2. Listen to the podcast series

    Hear directly from our contributing experts as they discuss their case studies with Brian Jackson.

    • Frictionless hybrid working: How the Harvard Business School did it
    • Close call with ransomware: A CIO recounts a near security nightmare
    • How a financial services company dodged "The Great Resignation"
    • How Allianz took a blockchain platform from pilot to 1 million transactions
    • CVS Health chairman David Dorman on healthcare's hybrid future

    Infographic

    Further reading

    CIO Priorities 2022

    A jumble of business-related words. Info-Tech’s 2022 Tech Trends survey asked CIOs for their top three priorities. Cluster analysis of their open-ended responses shows four key themes:
    1. Business process improvements
    2. Digital transformation or modernization
    3. Security
    4. Supporting revenue growth or recovery

    Info-Tech’s annual CIO priorities are formed from proprietary primary data and consultation with our internal experts with CIO stature

    2022 Tech Trends Survey CIO Demographic N=123

    Info-Tech’s Tech Trends 2022 survey was conducted between August and September 2021 and collected a total of 475 responses from IT decision makers, 123 of which were at the C-level. Fourteen countries and 16 industries are represented in the survey.

    2022 IT Talent Trends Survey CIO Demographic N=44

    Info-Tech’s IT Talent Trends 2022 survey was conducted between September and October 2021 and collected a total of 245 responses from IT decision makers, 44 of which were at the C-level. A broad range of countries from around the world are represented in the survey.

    Internal CIO Panels’ 125 Years Of Combined C-Level IT Experience

    Panels of former CIOs at Info-Tech focused on interpreting tech trends data and relating it to client experiences. Panels were conducted between November 2021 and January 2022.

    CEO-CIO Alignment Survey Benchmark Completed By 107 Different Organizations

    Info-Tech’s CEO-CIO Alignment program helps CIOs align with their supervisors by asking the right questions to ensure that IT stays on the right path. It determines how IT can best support the business’ top priorities and address the gaps in your strategy. In 2021, the benchmark was formed by 107 different organizations.

    Build IT alignment

    IT Management & Governance Diagnostic Benchmark Completed By 320 Different Organizations

    Info-Tech’s Management and Governance Diagnostic helps IT departments assess their strengths and weaknesses, prioritize their processes and build an improvement roadmap, and establish clear ownership of IT processes. In 2021, the benchmark was formed by data from 320 different organizations.

    Assess your IT processes

    The CIO priorities are informed by Info-Tech’s trends research reports and surveys

    Priority: “The fact or condition of being regarded or treated as more important than others.” (Lexico/Oxford)

    Trend: “A general direction in which something is developing or changing.” (Lexico/Oxford)

    A sequence of processes beginning with 'Sensing', 'Hypothesis', 'Validation', and ending with 'Trends, 'Priorities'. Under Sensing is Technology Research, Interviews & Insights, Gathering, and PESTLE. Under Hypothesis is Near-Future Probabilities, Identify Patterns, Identify Uncertainties, and Identify Human Benefits. Under Validation is Test Hypothesis, Case Studies, and Data-Driven Insights. Under Trends is Technology, Talent, and Industry. Under Priorities is CIO, Applications, Infrastructure, and Security.

    Visit Info-Tech’s Trends & Priorities Research Center

    Image called 'Defining the CIO Priorities for 2022'. Image shows 4 columns, Implications, Resource Investment, Amplifiers, and Actions and Outcomes, with 2 dotted lines, labeled External Context and Internal Context, running through all 4 columns and leading to bottom-right label called CIO Priorities Formed

    The Five Priorities

    Priorities to compete in the digital economy

    1. Reduce Friction in the Hybrid Operating Model
    2. Improve Your Ransomware Readiness
    3. Support an Employee-Centric Retention Strategy
    4. Design an Automation Platform
    5. Prepare to Report on New Environmental, Social, and Governance Metrics

    Reduce friction in the hybrid operating model

    Priority 01 | APO07 Human Resources Management

    Deliver solutions that create equity between remote workers and office workers and make collaboration a joy.

    Hybrid work is here to stay

    CIOs must deal with new pain points related to friction of collaboration

    In 2020, CIOs adapted to the pandemic’s disruption to offices by investing in capabilities to enable remote work. With restrictions on gathering in offices, even digital laggards had to shift to an all-remote work model for non-essential workers.

    Most popular technologies already invested in to facilitate better collaboration

    • 24% Web Conferencing
    • 23% Instant Messaging
    • 20% Document Collaboration

    In 2022, the focus shifts to solving problems created by the new hybrid operating model where some employees are in the office and some are working remotely. Without the ease of collaborating in a central hub, technology can play a role in reducing friction in several areas:

    • Foster more connections between employees. Remote workers are less likely to collaborate with people outside of their department and less likely to spontaneously collaborate with their peers. CIOs should provide a digital employee experience that fosters collaboration habits and keeps workers engaged.
    • Prevent employee attrition. With more workers reevaluating their careers and leaving their jobs, CIOs can help employees feel connected to the overall purpose of the organization. Finding a way to maintain culture in the new context will require new solutions. While conference room technology can be a bane to IT departments, making hybrid meetings effortless to facilitate will be more important.
    • Provide new standards for mediated collaboration. Meeting isn’t as easy as simply gathering around the same table anymore. CIOs need to provide structure around how hybrid meetings are conducted to create equity between all participants. Business continuity processes must also consider potential outages for collaboration services so employees can continue the work despite a major outage.

    Three in four organizations have a “hybrid” approach to work. (Tech Trends 2022 Survey)

    In most organizations, a hybrid model is being implemented. Only 14.9% of organizations are planning for almost everyone to return to the office, and only 9.9% for almost everyone to work remotely.

    Elizabeth Clark

    CIO, Harvard Business School

    "I want to create experiences that are sticky. That keep people coming back and engaging with their colleagues."

    Photo of Elizabeth Clark, CIO, Harvard Business School.

    Listen to the Tech Insights podcast:
    Frictionless hybrid working: How the Harvard Business School did it

    Internal interpretation: Harvard Business School

    • March 2020
      The pandemic disrupts in-class education at Harvard Business School. Their case study method of instruction that depends on in-person, high-quality student engagement is at risk. While students and faculty completed the winter semester remotely, the Dean and administration make the goal to restore the integrity of the classroom experience with equity for both remote and in-person students.
    • May 2020
      A cross-functional task force of about 100 people work intensively, conducting seven formal experiments, 80 smaller tests, and hundreds of polling data points, and a technology and facilities solution is designed: two 4K video cameras capturing both the faculty and the in-class students, new ceiling mics, three 85-inch TV screens, and students joining the videoconference from their laptops. A custom Zoom room, combining three separate rooms, integrated all the elements in one place and integrated with the lecture capture system and learning management system.
    • October 2020
      Sixteen classrooms are renovated to install the new solution. Students return to the classroom but in lower numbers due to limits on in-room capacity, but students rotate between the in-person and remote experience.
    • September 2021
      Renovations for the hybrid solution are complete in 26 classrooms and HBS has determined this will be its standard model for the classroom. The case method of teaching is kept alive and faculty and students are thrilled with the results.
    • November 2021
      HBS is adapting its solution for the classroom to its conference rooms and has built out eight different rooms for a hybrid experience. The 4K cameras and TV screens capture all participants in high fidelity as well as the blackboard.

    Photo of a renovated classroom with Zoom participants integrated with the in-person students.
    The renovated classrooms integrate all students, whether they are participating remotely or in person. (Image courtesy of Harvard Business School.)

    Implications: Organization, Process, Technology

    External

    • Organization – About half of IT practitioners in the Tech Trends 2022 survey feel that IT leaders, infrastructure and operations teams, and security teams were “very busy” in 2021. Capacity to adapt to hybrid work could be constrained by these factors.
    • Process – Organizations that want employees to benefit from being back in the office will have to rethink how workers can get more value out of in-person meetings that also require videoconference participation with remote workers.
    • Technology – Fifty-four percent of surveyed IT practitioners say the pandemic raised IT spending compared to the projections they made in 2020. Much of that investment went into adapting to a remote work environment.

    Internal

    • Organization – HBS added 30 people to its IT staff on term appointments to develop and implement its hybrid classroom solutions. Hires included instructional designers, support technicians, coordinators, and project managers.
    • Process – Only 25 students out of the full capacity of 95 could be in the classroom due to COVID-19 regulations. On-campus students rotated through the classroom seats. An app was created to post last-minute seat availability to keep the class full.
    • Technology – A Zoom room was created that combines three rooms to provide the full classroom experience: a view of the instructor, a clear view of each student that enlarges when they are speaking, and a view of the blackboard.

    Resources Applied

    Appetite for Technology

    CIOs and their direct supervisors both ranked internal collaboration tools as being a “critical need to adopt” in 2021, according to Info-Tech’s CEO-CIO Alignment Benchmark Report.

    Intent to Invest

    Ninety-seven percent of IT practitioners plan to invest in technology to facilitate better collaboration between employees in the office and outside the office by the end of 2022, according to Info-Tech’s 2022 Tech Trends survey.

    “We got so many nice compliments, which you don’t get in IT all the time. You get all the complaints, but it’s a rare case when people are enthusiastic about something that was delivered.” (Elizabeth Clark, CIO, Harvard Business School)

    Harvard Business School

    • IT staff were reassigned from other projects to prioritize building a hybrid classroom solution. A cloud migration and other portfolio projects were put on pause.
    • The annual capital A/V investment was doubled. The amount of spend on conference rooms was tripled.
    • Employees were hired to the media services team at a time when other areas of the organization were frozen.

    Outcomes at Harvard Business School

    The new normal at Harvard Business School

    New normal: HBS has found its new default operating model for the classroom and is extending its solution to its operating environment.

    Improved CX: The high-quality experience for students has helped avoid attrition despite the challenges of the pandemic.

    Engaged employees: The IT team is also engaged and feels connected to the mission of the school.

    Photo of a custom Zoom room bringing together multiple view of the classroom as well as all remote students.
    A custom Zoom room brings together multiple different views of the classroom into one single experience for remote students. (Image courtesy of Harvard Business School.)

    From Priorities to Action

    Make hybrid collaboration a joy

    Align with your organization’s goals for collaboration and customer interaction, with the target of high satisfaction for both customers and employees. Invest in capital projects to improve the fidelity of conference rooms, develop and test a new way of working, and increase IT capacity to alleviate pressure points.

    Foster both asynchronous and synchronous collaboration approaches to avoid calendars filling up with videoconference meetings to get things done and to accommodate workers contributing from across different time zones.

    “We’ll always have hybrid now. It’s opened people’s eyes and now we’re thinking about the future state. What new markets could we explore?” (Elizabeth Clark, CIO, Harvard Business School)

    Take the next step

    Run Better Meetings
    Hybrid, virtual, or in person – set meeting best practices that support your desired meeting norms.

    Prepare People Leaders for the Hybrid Work Environment
    Set hybrid work up for success by providing people leaders with the tools they need to lead within the new model.

    Hoteling and Hot-Desking: A Primer
    What you need to know regarding facilities, IT infrastructure, maintenance, security, and vendor solutions for desk hoteling and hot-desking.

    “Human Resources Management” gap between importance and effectiveness
    Info-Tech Research Group Management and Governance Diagnostic Benchmark 2021

    A bar chart illustrating the Human Resources Management gap between importance and effectiveness. The difference is marked as Delta 2.3.

    Improve your ransomware readiness

    Priority 02 | APO13 Security Strategy

    Mitigate the damage of successful ransomware intrusions and make recovery as painless as possible.

    The ransomware crisis threatens every organization

    Prevention alone won’t be enough against the forces behind ransomware.

    Cybersecurity is always top of mind for CIOs but tends to be deprioritized due to other demands related to digital transformation or due to cost pressures. That’s the case when we examine our data for this report.

    Cybersecurity ranked as the fourth-most important priority by CIOs in Info-Tech’s 2022 Tech Trends survey, behind business process improvement, digital transformation, and modernization. Popular ways to prepare for a successful attack include creating offline backups, purchasing insurance, and deploying new solutions to eradicate ransomware.

    CIOs and their direct supervisors ranked “Manage IT-Related Security” as the third-most important top IT priority on Info-Tech’s CEO-CIO Alignment Benchmark for 2021, in support of business goals to manage risk, comply with external regulation, and ensure service continuity.

    Most popular ways for organizations to prepare for the event of a successful ransomware attack:

    • 25% Created offline backups
    • 18% Purchased cyberinsurance
    • 19% New tech to eradicate ransomware

    Whatever priority an organization places on cybersecurity, when ransomware strikes, it quickly becomes a red alert scenario that disrupts normal operations and requires all hands on deck to respond. Sophisticated attacks executed at wide scale demonstrate that security can be bypassed without creating an alert. After that’s accomplished, the perpetrators build their leverage by exfiltrating data and encrypting critical systems.

    CIOs can plan to mitigate ransomware attacks in several constructive ways:

    • Business impact analysis. Determine the costs of an outage for specific periods and the system and data recovery points in time.
    • Engage a partner for 24/7 monitoring. Gain real-time awareness of your critical systems.
    • Review your identity access management (IAM) policies. Use of multi-factor authentication and limiting access to only the roles that need it reduces ransomware risk.

    50% of all organizations spent time and money specifically to prevent ransomware in the past year. (Info-Tech Tech Trends 2022 Survey)

    John Doe

    CIO, mid-sized manufacturing firm in the US

    "I want to create experiences that are sticky. That keep people coming back and engaging with their colleagues."

    Blank photo.

    Listen to the Tech Insights podcast:
    Close call with ransomware: a CIO recounts a near security nightmare

    Internal interpretation: US-based, mid-sized manufacturing firm

    • May 1, 2021
      A mid-sized manufacturing firm (“The Firm”) CIO gets a call from his head of security about odd things happening on the network. A call is made to Microsoft for support. Later that night, the report is that an unwanted crypto-mining application is the culprit. But a couple of hours later, that assessment is proven wrong when it’s realized that hundreds of systems are staged for a ransomware attack. All the attacker has to do is push the button.
    • May 2, 2021
      The Firm disconnects all its global sites to cut off new pathways for the malware to infect. All normal operations cease for 24 hours. It launches its cybersecurity insurance process. The CIO engages a new security vendor, CrowdStrike, to help respond. Employees begin working from home if they can so they can make use of their own internet service. The Firm has cut off its public internet connectivity and is severed from cloud services such as Azure storage and collaboration software.
    • May 4, 2021
      The hackers behind the attack are revealed by security forensics experts. A state-sponsored agency in Russia set up the ransomware and left it ready to execute. It sold the staged attack to a cybercriminal group, Doppel Spider. According to CrowdStrike, the group uses malware to run “big game hunting operations” and targets 18 different countries including the US and multiple industries, including manufacturing.
    • May 10, 2021
      The Firm has totally recovered from the ransomware incident and avoided any serious breach or paying a ransom. The CIO worked more hours than at any other point in his career, logging an estimated 130 hours over the two weeks.
    • November 2021
      The Firm never previously considered itself a ransomware target but has now reevaluated that stance. It has hired a service provider to run a security operations center on a 24/7 basis. It's implemented a more sophisticated detection and response model and implemented multi-factor authentication. It’s doubled its security spend in 2021 and will invest more in 2022.

    “Now we take the approach that if someone does get in, we're going to find them out.” (John Doe, CIO, “The Firm”)

    Implications: Organization, Process, Technology

    External

    • Organization – Organizations must consider how their employees play a role in preventing ransomware and plan for training to recognize phishing and other common traps. They must make plans for employees to continue their work if systems are disrupted by ransomware.
    • Process – Backup processes across multiple systems should be harmonized to have both recent and common points to recover from. Work with the understanding IT will have to take systems offline if ransomware is discovered and there is no time to ask for permission.
    • Technology – Organizations can benefit from security services provided by a forensics-focused vendor. Putting cybersecurity insurance in place not only provides financial protection but also guidance in what to do and which vendors to work with to prevent and recover from ransomware.

    Internal

    • Organization – The Firm was prepared with a business continuity plan to allow many of its employees to work remotely, which was necessary because the office network was incapacitated for ten days during recovery.
    • Process – Executives didn’t seek to assign blame for the security incident but took it as a signal there were some new costs involved to stay in business. It initiated new outsource relationships and hired one more full-time employee to shore up security resources.
    • Technology – New ransomware eradication software was deployed to 2,000 computers. Scripted processes automated much of the work, but in some cases full system rebuilds were required. Backup systems were disconnected from the network as soon as the malware was discovered.

    Resources Applied

    Consider the Alternative

    Organizations should consider how much a ransomware attack on critical systems would cost them if they were down for a minimum of 24-48 hours. Plan to invest an amount at least equal to the costs of that downtime.

    Ask for ID

    Implementing across-the-board multi-factor authentication reduces chances of infection and is cheap, with enterprise solutions ranging from $2 to $5 per user on average. Be strict and deny access when connections don’t authenticate.

    “You'll never stop everything from getting into the network. You can still focus on stopping the bad actors, but then if they do make it in, make sure they don't get far.” (John Doe, CIO, “The Firm”)

    “The Firm” (Mid-Sized Manufacturer)

    • During the crisis, The Firm paused all activities and focused solely on isolating and eliminating the ransomware threat.
    • New outsourcing relationship with a vendor provides a 24/7 Security Operations Center.
    • One more full-time employee on the security team.
    • Doubled investment in security in 2021 and will spend more in 2022.

    Outcomes at “The Firm” (Mid-Sized Manufacturer)

    The new cost of doing business

    Real-time security: While The Firm is still investing in prevention-based security, it is also developing its real-time detection and response capabilities. When ransomware makes it through the cracks, it wants to know as soon as possible and stop it.

    Leadership commitment: The C-suite is taking the experience as a wake-up call that more investment is required in today’s threat landscape. The Firm rates security more highly as an overall organizational goal, not just something for IT to worry about.

    Stock photo of someone using their phone while sitting at a computer, implying multi-factor authentication.
    The Firm now uses multi-factor authentication as part of its employee sign-on process. For employees, authenticating is commonly achieved by using a mobile app that receives a secret code from the issuer.

    From Priorities to Action

    Cybersecurity is everyone’s responsibility

    In Info-Tech’s CEO-CIO Alignment Benchmark for 2021, the business goal of “Manage Risk” was the single biggest point of disagreement between CIOs and their direct supervisors. CIOs rank it as the second-most important business goal, while CEOs rank it as sixth-most important.

    Organizations should align on managing risk as a top priority given the severity of the ransomware threat. The threat actors and nature of the attacks are such that top leadership must prepare for when ransomware hits. This includes halting operations quickly to contain damage, engaging third-party security forensics experts, and coordinating with government regulators.

    Cybersecurity strategies may be challenged to be effective without creating some friction for users. Organizations should look beyond multi-layer prevention strategies and lean toward quick detection and response, spending evenly across prevention, detection, and response solutions.

    Take the next step

    Create a Ransomware Incident Response Plan
    Don’t be the next headline. Determine your current readiness, response plan, and projects to close gaps.

    Simplify Identity and Access Management
    Select and implement IAM and produce vendor RFPs that will contain the capabilities you need, including multi-factor authentication.

    Cybersecurity Series Featuring Sandy Silk
    More from Info-Tech’s Senior Workshop Director Sandy Silk in this video series created while she was still at Harvard University.

    Gap between CIOs and CEOs in points allocated to “Manage risk” as a top business goal

    A bar chart illustrating the gap between CIOs and CEOs in points allocated to 'Manage risk' as a top business goal. The difference is marked as Delta 1.5.

    Support an employee-centric retention strategy

    Priority 03 | ITRG02 Leadership, Culture & Values

    Avoid being a victim of “The Great Resignation” by putting employees at the center of an experience that will engage them with clear career path development, purposeful work, and transparent feedback.

    Defining an employee-first culture that improves retention

    The Great resignation isn’t good for firms

    In 2021, many workers decided to leave their jobs. Working contexts were disrupted by the pandemic and that saw non-essential workers sent home to work, while essential workers were asked to continue to come into work despite the risks of COVID-19. These disruptions may have contributed to many workers reevaluating their professional goals and weighing their values differently. At the same time, 2021 saw a surging economy and many new job opportunities to create a talent-hungry market. Many workers could have been motivated to take a new opportunity to increase their salary or receive other benefits such as more flexibility.

    Annual turnover rate for all us employees on the rise

    • 20% – Jan.-Aug. 2020, Dipped from 22% in 2019
    • 25% Jan.-Aug. 2021, New record high
    • Data from Visier Inc.

    When you can’t pay them, develop them

    IT may be less affected than other departments by this trend. Info-Tech’s 2022 IT Talent Trends Report shows that on average, estimated turnover rate in IT is lower than the rest of the organization. Almost half of respondents estimated their organization’s voluntary turnover rate was 10% or higher. Only 30% of respondents estimate that IT’s voluntary turnover rate is in the same range. However, CIOs working in industries with the highest turnover rates will have to work to keep their workers engaged and satisfied, as IT skills are easily transferred to other industries.

    49% ranked “enabling learning & development within IT” as high priority, more than any other single challenge. (IT Talent Trends 2022 Survey, N=227)

    A bar chart of 'Industries with highest turnover rates (%)' with 'Leisure and Hospitality' at 6.4%, 'Trade, Transportation & Utilities' at 3.6%, 'Professional and Business' at 3.3%, and 'Other Services' at 3.1%. U.S. Bureau of Labor Statistics, 2022.

    Jeff Previte

    Executive Vice-President of IT, CrossCountry Mortgage

    “We have to get to know the individual at a personal level … Not just talking about the business, but getting to know the person."

    Photo of Jeff Previte, Executive Vice-President of IT, CrossCountry Mortgage.

    Listen to the Tech Insights podcast:
    How a financial services company dodged ‘The Great Resignation’

    Internal interpretation: CrossCountry Mortgage

    • May 2019
      Jeff Previte joins Cleveland, Ohio-based CrossCountry Mortgage in the CIO role. The company faces a challenge with employee turnover, particularly in IT. The firm is a sales-focused organization and saw its turnover rate reach as high as 60%. Yet Previte recognized that IT had some meaningful goals to achieve and would need to attract – and retain – some higher caliber talent. His first objective in his new role was to meet with IT employees and business leadership to set priorities.
    • July 2019
      Previte takes a “people-first” approach to leadership and meets his staff face-to-face to understand their personal situations. He sets to work on defining roles and responsibilities in the organization, spending about a fifth of his time on defining the strategy.
    • June 2020
      Previte assigned his leadership team to McLean & Company’s Design an Impactful Employee Development Program. From there, the team developed a Salesforce tool called the Career Development Workbook. “We had some very passionate developers and admins that wanted to build a home-grown tool,” he says. It turns McLean & Company’s process into a digital tool employees can use to reflect on their careers and explore their next steps. It helps facilitate development conversations with managers.
    • January 2021
      CrossCountry Mortgage changes its approach to career development activities. Going to external conferences and training courses is reduced to just 30% of that effort. The rest is by doing hands-on work at the company. Previte aligned with his executives and road-mapped IT projects annually. Based on employee’s interests, opportunities are found to carve out time from usual day-to-day activities to spend time on a project in a new area. When there’s a business need, someone internally can be ready to transition roles.
    • June 2021
      In the two years since joining the company, Previte has reduced the turnover rate to just 12%. The IT department has grown to more adequately meet the needs of the business and employees are engaged with more opportunities to develop their careers. Instead of focusing on compensation, Previte focused more on engaging employees with a developmentally dedicated environment and continuous hands-on learning.

    “It’s come down to a culture shift. Folks have an idea of where we’re headed as an organization, where we’re headed as an IT team, and how their role contributes to that.” (Jeff Previte, EVP of IT, CrossCountry Mortgage)

    Implications: Organization, Process, Technology

    External

    • Organization – A high priority is being placed on improving IT’s maturity through its talent. Enabling learning and development in IT, enabling departmental innovation, and recruiting are the top three highest priorities according to IT Talent Trends 2022 survey responses.
    • Process – Recruiting is more challenging for industries that operate primarily onsite, according to McLean & Company's 2022 HR Trends Report. They face more challenges attracting applications, more rejected offers, and more candidate ghosting compared to remote-capable industries.
    • Technology – Providing a great employee experience through digital tools is more important as many organizations see a mix of workers in the office and at home. These tools can help connect colleagues, foster professional development, and improve the candidate experience.

    Internal

    • Organization – CrossCountry Mortgage faced a situation where IT employees did not have clarity on their roles and responsibilities. In terms of salary, it wasn’t offering at the high end compared to other employers in Cleveland.
    • Process – To foster a culture of growth and development, CrossCountry Mortgage put in place a performance assessment system that encouraged reflection and goal setting, aided by collaboration with a manager.
    • Technology – The high turnover rate was limiting CrossCountry Mortgage from achieving the level of maturity it needed to support the company’s goals. It ingrained its new PA process with a custom build of a Salesforce tool.

    Resources Applied

    Show me the money

    Almost six in ten Talent Trends survey respondents identified salary and compensation as the reason that employees resigned in the past year. Organizations looking to engage employees must first pay a fair salary according to market and industry conditions.

    Build me up

    Professional development and opportunity for innovative work are the next two most common reasons for resignations. Organizations must ensure they create enough capacity to allow workers time to spend on development.

    “Building our own solution created an element of engagement. There was a sense of ownership that the team had in thinking through this.” (Jeff Previte, CrossCountry Mortgage)

    CrossCountry Mortgage

    • Executive time: CIO spends 10-20% of his time on activities related to designing the approach.
    • Leveraged memberships with Info-Tech Research Group and McLean & Company to define professional development process.
    • Internal IT develops automated workflow in Salesforce.
    • Hired additional IT staff to build out overall capacity and create time for development activities.

    Outcomes at CrossCountry Mortgage

    Engaged IT workforce

    The Great Maturation: IT staff turnover rate dropped to 10-12% and IT talent is developing on the job to improve the department’s overall skill level. More IT staff on hand and more engaged workers mean IT can deliver higher maturity level results.

    Alignment achieved: Connecting IT’s initiatives to the vision of the C-suite creates a clear purpose for IT in its initiatives. Staff understand what they need to achieve to progress their careers and can grow while they work.

    Photo of employees from CrossCountry Mortgage assisting with a distribution event.
    Employees from CrossCountry Mortgage headquarters assist with a drive-thru distribution event for the Cleveland Food Bank on Dec. 17, 2021. (Image courtesy of CrossCountry Mortgage.)

    From Priorities to Action

    Staff retention is a leadership priority

    The Great Resignation trend is bringing attention to employee engagement and staff retention. IT departments are busier than ever during the pandemic as they work overtime to keep up with a remote workforce and new security threats. At the same time, IT talent is among the most coveted on the market.

    CIOs need to develop a people-first approach to improve the employee experience. Beyond compensation, IT workers need clarity in terms of their career paths, a direct connection between their work and the goals of the organization, and time set aside for professional development.

    Info-Tech’s 2021 benchmark for “Leadership, Culture & Values” shows that most organizations rate this capability very highly (9) but see room to improve on their effectiveness (6.9).

    Take the next step

    IT Talent Trends 2022
    See how IT talent trends are shifting through the pandemic and understand how themes like The Great Resignation has impacted IT.

    McLean & Company’s Modernize Performance Management
    Customize the building blocks of performance management to best fit organizational needs to impact individual and organizational performance, productivity, and engagement.

    Redesign Your IT Organizational Structure
    Define future-state work units, roles, and responsibilities that will enable the IT organization to complete the work that needs to be done.

    “Leadership, Culture & Values” gap between importance and effectiveness
    Info-Tech Research Group Management and Governance Diagnostic Benchmark 2021

    A bar chart illustrating the 'Leadership, Culture & Values' gap between importance and effectiveness. The difference is marked as Delta 2.1.

    Design an automation platform

    Priority 04 | APO04 Innovation

    Position yourself to buy or build a platform that will enable new automation opportunities through seamless integration.

    Build it or buy it, but platform integration can yield great benefits

    Necessity is the mother of innovation

    When it’s said that digital transformation accelerated during the pandemic, what’s really meant is that processes that were formerly done manually became automated through software. In responses to the Tech Trends survey, CIOs say digital transformation was more of a focus during the pandemic, and eight in ten CIOs also say they shifted more than 20% of their organization’s processes to digital during the pandemic. Automating tasks through software can be called digitalization.

    Most organizations became more digitalized during the pandemic. But how they pursued it depends on their IT maturity. For digital laggards, partnering with a technology services platform is the path of least resistance. For sophisticated innovators, they can consider building a platform to address the specific needs of their business process. Doing so requires the foundation of an existing “digital factory” or innovation arm where new technologies can be tested, proofs of concept developed, and external partnerships formed. Patience is key with these efforts, as not every investment will yield immediate returns and some will fail outright.

    Build it or buy it, platform participants integrate with their existing systems through application programming interfaces (APIs). Organizations should determine their platform strategies based on maturity, then look to integrate the business processes that will yield the most gains.

    What role should you play in the platform ecosystem?

    A table with levels on the maturity ladder laid out as a sprint. Column headers are maturity levels 'Struggle', 'Support', 'Optimize', 'Expand', and 'Transform', row headers are 'Maturity' and 'Role'. Roles are assigned to one or many levels. 'Improve' is solely under Struggle. 'Integrate' spans from Support to Transform. 'Buy' spans Support to Expand. 'Build' begins midway through Expand and all of Transform. 'Partner' spans from Optimize to halfway through Transform.

    68% of CIOs say digital transformation became much more of a focus for their organization during the pandemic (Info-Tech Tech Trends 2022 Survey)

    Bob Crozier

    Chief Architect, Allianz Technology & Global Head of Blockchain, Allianz Technology SE

    "Smart contracts are really just workflows between counterparties."

    Photo of Bob Crozier, Chief Architect, Allianz Technology & Global Head of Blockchain, Allianz Technology SE.

    Listen to the Tech Insights podcast:
    How Allianz took a blockchain platform from pilot to 1 million transactions

    Internal interpretation: Allianz Technology

    • 2015
      After smart contracts are demonstrated on the Ethereum blockchain, Allianz and other insurers recognize the business value. There is potential to use the capability to administer a complex, multi-party contract where the presence of the reinsurer in the risk transfer ecosystem is required. Manual contracts could be turned into code and automated. Allianz organized an early proof of concept around a theoretical pandemic excessive loss contract.
    • 2018
      Allianz Chief Architect Bob Crozier is leading the Global Blockchain Center of Competence for Allianz. They educate Allianz on the value of blockchain for business. They also partner with a joint venture between the Technology University of Munich and the state of Bavaria. A cohort of Masters students is looking for real business problems to solve with open-source distributed ledger technology. Allianz puts its problem statement in front of the group. A student team presents a proof of concept for an international motor insurance claims settlement and it comes in second place at a pitch day competition.
    • 2019
      Allianz brings the concept back in-house, and its business leaders return to the concept. Startup Luther Systems is engaged to build a minimum-viable product for the solution, with the goal being a pilot involving three or four subsidiaries in different countries. The Blockchain Center begins communicating with 25 Allianz subsidiaries that will eventually deploy the platform.
    • 2020
      Allianz is in build mode on its international motor insurance claims platform. It leverages its internal Dev/SecOps teams based in Munich and in India.
    • May 2021
      Allianz goes live with its new platform on May 17, decommissioning its old system and migrating all live claims data onto the new blockchain platform. It sees 400 concurrent users go live across Europe.
    • January 2022
      Allianz mines its one-millionth block to its ledger on Jan. 19, with each block representing a peer-to-peer transaction across its 25 subsidiaries in different countries. The platform has settled hundreds of millions of dollars.

    Stock photo of two people arguing over a car crash.

    Implications: Organization, Process, Technology

    External

    • Organization – To explore emerging technologies like blockchain, organizations need staff that are accountable for innovation and have leeway to develop proofs of concept. External partners are often required to bring in fresh ideas and move quickly towards an MVP.
    • Process – According to the Tech Trends 2022 survey, 84% of CIOs consider automation a high-value digital capability, and 77% say identity verification is a high-value capability. A blockchain platform using smart contracts can deliver those.
    • Technology – The Linux Foundation’s Hyperledger Fabric is an open-source blockchain technology that’s become popular in the financial industry for its method of forming consensus and its modular architecture. It’s been adopted by USAA, MasterCard, and PayPal. It also underpins the IBM Blockchain Platform and is supported by Azure Blockchain.

    Internal

    • Organization – Allianz is a holding company that owns Allianz Technology and 25 operating entities across Europe. It uses the technology arm to innovate on the business process and creates shared platforms that its entities can integrate with to automate across the value chain.
    • Process – Initial interest in smart contracts on blockchain were funneled into a student competition, where a proof of concept was developed. Allianz partnered with a startup to develop an MVP, then developed the platform while aligning with its business units ahead of launch.
    • Technology – Allianz built its blockchain platform on Hyperledger Fabric because it was a permissioned system, unlike other public permissionless blockchains such as Ethereum, and because its mining mechanism was much more energy efficient compared to other blockchains using Proof of Work consensus models.

    Resources Applied

    Time to innovate

    Exploring emerging technology for potential use cases is difficult for staff tasked with running day-to-day operations. Organizations serious about innovation create a separate team that can focus on “moonshot” projects and connect with external partners.

    Long-term ROI

    Automation of new business processes often requires a high upfront initial investment for a long-term efficiency gain. A proof of concept should demonstrate clear business value that can be repeated often and for a long period.

    “My next project has to deliver in the tens of millions of value in return. The bar is high and that’s what it should be for a business of our size.” (Bob Crozier, Allianz)

    Allianz

    • Several operating entities from different countries supplied subject matter expertise and helped with the testing process.
    • Allianz Technology team has eight staff members. It is augmented by Luther Systems and the team at industry group B3i.
    • Funding of less than $5 million to develop. Dev team continues to add improvements.
    • Operating requires just one full-time employee plus infrastructure costs, mostly for public cloud hosting.

    Outcomes at Allianz

    From insurer to platform provider

    Deliver your own SaaS: Allianz Technology built its blockchain-based claims settlement platform and its subsidiaries consume it as software as a service. The platform runs on a distributed architecture across Europe, with each node running the same version of the software. Operating entities can also integrate their own systems to the platform via APIs and further automate business processes such as billing.

    Ready to scale: After processing one million transactions, the international claims settlement platform is proven and ready to add more participants. Crozier sees auto repair shops and auto manufacturers as the next logical users.

    Stock photo of Blockchain.
    Allianz is a shareholder of the Blockchain Insurance Industry Initiative (B3i). It is providing a platform used by a group of insurance companies in the commercial and reinsurance space.

    When should we use blockchain? THREE key criteria:

    • Redundant processes
      Different entities follow the same process to achieve the desired outcome.
    • Audit trail
      Accountability in the decision making must be documented.
    • Reconciliation
      Parties need to be able to resolve disputes by tracing back to the truth.

    From Priorities to Action

    It’s a build vs. buy question for platforms

    Allianz was able to build a platform for its group of European subsidiaries because of its established digital factory and commitment to innovation. Allianz Technology is at the “innovate” level of IT maturity, allowing it to create a platform that subsidiaries can integrate with via APIs. For firms that are lower on the IT maturity scale, buying a platform solution is the better path to automation. These firms will be concerned with integrating their legacy systems to platforms that can reduce the friction of their operating environments and introduce modern new capabilities.

    From Info-Tech’s Build a Winning Business Process Automation Playbook

    An infographic comparing pros and cons of Build versus Buy. On the 'Build: High Delivery Capacity & Capability' side is 'Custom Development', 'Data Integration', 'AI/ML', 'Configuration', 'Native Workflow', and 'Low & No Code'. On the 'Buy: Low Delivery Capacity & Capability' side is 'Outsource Development', 'iPaaS', 'Chatbots', 'iBPMS & Rules Engines', 'RPA', and 'Point Solutions'.

    Take the next step

    Accelerate Your Automation Processes
    Integrate automation solutions and take the first steps to building an automation suite.

    Build Effective Enterprise Integration on the Back of Business Process
    From the backend to the frontlines – let enterprise integration help your business processes fly.

    Evolve Your Business Through Innovation
    Innovation teams are tasked with the responsibility of ensuring that their organizations are in the best position to succeed while the world is in a period of turmoil, chaos, and uncertainty.

    “Innovation” gap between importance and effectiveness Info-Tech Research Group Management and Governance Diagnostic Benchmark 2021

    A bar chart illustrating the 'Innovation' gap between importance and effectiveness. The difference is marked as Delta 2.1.

    Prepare to report on new environmental, social, and governance (ESG) metrics

    Priority 05 | ITRG06 Business Intelligence and Reporting

    Be ready to either lead or support initiatives to meet the criteria of new ESG reporting mandates and work toward disclosure reporting solutions.

    Time to get serious about ESG

    What does CSR or ESG mean to a CIO?

    Humans are putting increasing pressure on the planet’s natural environment and creating catastrophic risks as a result. Efforts to mitigate these risks have been underway for the past 30 years, but in the decade ahead regulators are likely to impose more strict requirements that will be linked to the financial value of an organization. Various voluntary frameworks exist for reporting on environmental, social, and governance (ESG) or corporate social responsibility (CSR) metrics. But now there are efforts underway to unify and clarify those standards.

    The most advanced effort toward a global set of standards is in the environmental area. At the United Nations’ COP26 summit in Scotland last November, the International Sustainability Standards Board (ISSB) announced its headquarters (Frankfurt) and three other international office locations (Montreal, San Francisco, and London) and its roadmap for public consultations. It is working with an array of voluntary standards groups toward a consensus.

    In Info-Tech’s 2022 Tech Trends survey, two-thirds of CIOs say their organization is committed to reducing greenhouse gas emissions, yet only 40% say their organizational leadership is very concerned with reducing those emissions. CIOs will need to consider how to align organizational concern with internal commitments and new regulatory pressures. They may investigate new real-time reporting solutions that could serve as a competitive differentiator on ESG.

    Standards informing the ISSB’s global set of climate standards

    A row of logos of organizations that inform ISSB's global set of climate standards.

    67% of CIOs say their organization is committed to reducing greenhouse gases, with one-third saying that commitment is public. (Info-Tech Tech Trends 2022 Survey)

    40% of CIOs say their organizational leadership is very concerned with reducing greenhouse gas emissions.

    David W. Dorman

    Chairman of the board, CVS Health

    “ESG is a question of what you do in the microcosm of your company to make sure there is a clear, level playing field – that there is a color-blind, gender-blind meritocracy available – that you are aware that not in every case can you achieve that without really focusing on it. It’s not going to happen on its own. That’s why our commitments have real dollars behind them and real focus behind them because we want to be the very best at doing them.”

    Photo of David W. Dorman, Chairman of the Board, CVS Health.

    Listen to the Tech Insights podcast:
    CVS Health chairman David Dorman on healthcare's hybrid future

    Internal interpretation: CVS Health

    CVS Health established a new steering committee of senior leaders in 2020 to oversee ESG commitments. It designs its corporate social responsibility strategy, Transform Health 2030, by aligning company activities in four key areas: healthy people, healthy business, healthy planet, and healthy community. The strategy aligns with the United Nations’ Sustainable Development Goals. In alignment with these goals, CVS identifies material topics where the company has the most ability to make an impact. In 2020, its top three topics were:

    1. Access to quality health care
    2. Patient and customer safety
    3. Data protection and privacy
    Material Topic
    Access to quality health care
    Material Topic
    Patient and customer safety
    Material Topic
    Data protection and privacy
    Technology Initiative
    MinuteClinic’s Virtual Collaboration for Nurses

    CVS provided Apple iPads compliant with the Health Insurance Portability and Accountability Act (HIPAA) to clinics in a phased approach, providing training to more than 700 providers in 26 states by February 2021. Nurses could use the iPads to attend virtual morning huddles and access clinical education. Nurses could connect virtually with other healthcare experts to collaborate on delivering patient care in real-time. The project was able to scale across the country through a $50,000 American Nurses Credentialing Center Pathway Award. (Wolters Kluwer Health, Inc.)

    Technology Initiative
    MinuteClinic’s E-Clinic

    MinuteClinics launched this telehealth solution in response to the pandemic, rolling it out in three weeks. The solution complemented video visits delivered in partnership with the Teladoc platform. Visits cost $59 and are covered by Aetna insurance plans, a subsidiary of CVS Health. It hosted more than 20,000 E-Clinic visits through the end of 2020. CVS connected its HealthHUBs to the solution to increase capacity in place of walk-in appointments and managed patients via phone for medication adherence and care plans. CVS also helped behavioral health providers transition patients to virtual visits. (CVS Health)

    Technology Initiative
    Next Generation Authentication Platform

    CVS patented this solution to authenticate customers accessing digital channels. It makes use of the available biometrics data and contextual information to validate identity without the need for a password. CVS planned to extend the platform to voice channels as well, using voiceprint technology. The solution prevents unauthorized access to sensitive health data while providing seamless access for customers. (LinkedIn)

    Implications: Organization, Process, Technology

    External

    • Organization – Since the mid-2010s, younger investors have demonstrated reliance on ESG data when making investment decisions, resulting in the creation of voluntary standards that offered varied approaches. Organizations in ESG exchange-traded funds are outperforming the overall S&P 500 (S&P Global Market Intelligence).
    • Process – Organizations are issuing ESG reports today despite the absence of clear rules to follow for reporting results. With regulators expected to step in to establish more rigid guidelines, many organizations will need to revisit their approach to ESG reports.
    • Technology – Real-time reporting of ESG metrics will become a competitive advantage before 2030. Engineering a solution that can alert organizations to poor performance on ESG measures and allow them to respond could avert losing market value.

    Internal

    • Organization – CVS Health established an ESG Steering Committee in 2020 composed of senior leaders including its chief governance officers, chief sustainability officer, chief risk officer, and controller and SVP of investor relations. It is supported by the ESG Operating Committee.
    • Process – CVS conducts a materiality assessment in accordance with Global Reporting Initiative standards to determine the most significant ESG impacts it can make and what topics most influence the decisions of stakeholders. It engages with various stakeholder groups on CSR topics.
    • Technology – CVS technology initiatives during the pandemic focused on supporting patients and employees in collaborating on health care delivery using virtual solutions, providing rich digital experiences that are easily accessible while upholding high security and privacy standards.

    Resources Applied

    Lack of commitment

    While 83% of businesses state support for the Sustainable Development Goals outlined by the Global Reporting Initiative (GRI), only 40% make measurable commitments to their goals.

    Show your work

    The GRI recommends organizations not only align their activities with sustainable development goals but also demonstrate contributions to specific targets in reporting on the positive actions they carry out. (GRI, “State of Progress: Business Contributions to the SDGS.”)

    “We end up with a longstanding commitment to diversity because that’s what our customer base looks like.” (David Dorman, CVS Health)

    CVS Health

    • The MinuteClinic Virtual Collaboration solution was piloted in Houston, demonstrated success, and won additional $50,000 funding from the Pathway to Excellence Award to scale the program across the country (Wolters Kluwer Health, Inc.).
    • The Next-Gen Authentication solution is provided by the vendor HYPR. It is deployed to ten million users and looking to scale to 30 million more. Pricing for enterprises is quoted at $1 per user, but volume pricing would apply to CVS (HYPR).

    Outcomes at CVS Health

    Delivering on hybrid healthcare solutions

    iPads for collaboration: Healthcare practitioners in the MinuteClinic Virtual Collaboration initiative agreed that it improved the use of interprofessional teams, working well virtually with others, and improved access to professional resources (Wolters Kluwer Health, Inc.)

    Remote healthcare: Saw a 400% increase in MinuteClinic virtual visits in 2020 (CVS Health).

    Verified ID: The Next Generation Authentication platform allowed customers to register for a COVID-19 vaccination appointment. CVS has delivered more than 50 million vaccines (LinkedIn).

    Stock photo of a doctor with an iPad.
    CVS Health is making use of digital channels to connect its customers and health practitioners to a services platform that can supplement visits to a retail or clinic location to receive diagnostics and first-hand care.

    From Priorities to Action

    Become your organization’s ESG Expert

    The risks posed to organizations and wider society are becoming more severe, driving a transition from voluntary frameworks for ESG goals to a mandatory one that’s enforced by investors and governments. Organizations will be expected to tie their core activities to a defined set of ESG goals and maintain a balance sheet of their positive and negative impacts. CIOs should become experts in ESG disclosure requirements and recommend the steps needed to meet or exceed competitors’ efforts. If a leadership vacuum for ESG accountability exists, CIOs can either seek to support their peers that are likely to become accountable or take a leadership role in overseeing the area. CIOs should start working toward solutions that deliver real-time reporting on ESG goals to make reporting frictionless.

    “If you don’t have ESG oversight at the highest levels of the company, it won’t wind up getting the focus. That’s why we review it at the Board multiple times per year. We have an annual report, we compare how we did, what we intended to do, where did we fall short, where did we exceed, and where we can run for daylight to do more.” (David Dorman, CVS Health)

    Take the next step

    ESG Disclosures: How Will We Record Status Updates on the World We Are Creating?
    Prepare for the era of mandated environmental, social, and governance disclosures.

    Private Equity and Venture Capital Growing Impact of ESG Report
    Learn about how the growing impact of ESG affects both your organization and IT specifically, including challenges and opportunities, with expert assistance.

    “Business Intelligence and Reporting” gap between importance and effectiveness
    Info-Tech Research Group Management and Governance Diagnostic Benchmark 2021

    A bar chart illustrating the 'BI and Reporting' gap between importance and effectiveness. The difference is marked as Delta 2.4.

    The Five Priorities

    Priorities to compete in the digital economy

    1. Reduce Friction in the Hybrid Operating Model
    2. Improve Your Ransomware Readiness
    3. Support an Employee-Centric Retention Strategy
    4. Design an Automation Platform
    5. Prepare to Report on New Environmental, Social, and Governance Metrics

    Contributing Experts

    Elizabeth Clark

    CIO, Harvard Business School
    Photo of Elizabeth Clark, CIO, Harvard Business School.

    Jeff Previte

    Executive Vice-President of IT, CrossCountry Mortgage
    Photo of Jeff Previte, Executive Vice-President of IT, CrossCountry Mortgage.

    Bob Crozier

    Chief Architect, Allianz Technology & Global Head of Blockchain, Allianz Technology SE
    Photo of Bob Crozier, Chief Architect, Allianz Technology & Global Head of Blockchain, Allianz Technology SE.

    David W. Dorman

    Chairman of the Board, CVS Health
    Photo of David W. Dorman, Chairman of the Board, CVS Health.

    Info-Tech’s internal CIO panel contributors

    • Bryan Tutor
    • John Kemp
    • Mike Schembri
    • Janice Clatterbuck
    • Sandy Silk
    • Sallie Wright
    • David Wallace
    • Ken McGee
    • Mike Tweedie
    • Cole Cioran
    • Kevin Tucker
    • Angelina Atkins
    • Yakov Kofner
    Photo of an internal CIO panel contributor. Photo of an internal CIO panel contributor.Photo of an internal CIO panel contributor.
    Photo of an internal CIO panel contributor.Photo of an internal CIO panel contributor.Photo of an internal CIO panel contributor.Photo of an internal CIO panel contributor.
    Photo of an internal CIO panel contributor.Photo of an internal CIO panel contributor.Photo of an internal CIO panel contributor.

    Thank you for your support

    Logo for the Blockchain Research Institute.
    Blockchain Research Institute

    Bibliography – CIO Priorities 2022

    “2020 Corporate Social Responsibility Report.” CVS Health, 2020, p. 127. Web.

    “Adversary: Doppel Spider - Threat Actor.” Crowdstrike Adversary Universe, 2021. Accessed 29 Dec. 2021.

    “Aetna CVS Health Success Story.” HYPR, n.d. Accessed 6 Feb. 2022.

    Baig, Aamer. “The CIO agenda for the next 12 months: Six make-or-break priorities.” McKinsey Digital, 1 Nov. 2021. Web.

    Ball, Sarah, Kristene Diggins, Nairobi Martindale, Angela Patterson, Anne M. Pohnert, Jacinta Thomas, Tammy Todd, and Melissa Bates. “2020 ANCC Pathway Award® winner.” Wolters Kluwer Health, Inc., 2021. Accessed 6 Feb. 2022.

    “Canadian Universities Propose Designs for a Central Bank Digital Currency.” Bank of Canada, 11 Feb. 2021. Accessed 14 Dec. 2021.

    “Carbon Sequestration in Wetlands.” MN Board of Water and Soil Resources, n.d. Accessed 15 Nov. 2021.

    “CCM Honored as a NorthCoast 99 Award Winner.” CrossCountry Mortgage, 1 Dec. 2021. Web.

    Cheek, Catherine. “Four Things We Learned About the Resignation Wave–and What to Do Next.” Visier Inc. (blog), 5 Oct. 2021. Web.

    “Companies Using Hyperledger Fabric, Market Share, Customers and Competitors.” HG Insights, 2022. Accessed 25 Jan. 2022.

    “IFRS Foundation Announces International Sustainability Standards Board, Consolidation with CDSB and VRF, and Publication of Prototype Disclosure Requirements.” IFRS, 3 Nov. 2021. Web.

    “IT Priorities for 2022: A CIO Report.” Mindsight, 28 Oct. 2021. Web.

    “Job Openings and Labor Turnover Survey.” Databases, Tables & Calculators by Subject, U.S. Bureau of Labor Statistics, 2022. Accessed 9 Feb. 2022.

    Kumar, Rashmi, and Michael Krigsman. “CIO Planning and Investment Strategy 2022.” CXOTalk, 13 Sept. 2021. Web.

    Leonhardt, Megan. “The Great Resignation Is Hitting These Industries Hardest.” Fortune, 16 Nov. 2021. Accessed 7 Jan. 2022.

    “Most companies align with SDGs – but more to do on assessing progress.” Global Reporting Initiative (GRI), 17 Jan. 2022. Web.

    Navagamuwa, Roshan. “Beyond Passwords: Enhancing Data Protection and Consumer Experience.” LinkedIn, 15 Dec. 2020.

    Ojo, Oluwaseyi. “Achieving Digital Business Transformation Using COBIT 2019.” ISACA, 19 Aug. 2019. Web.

    “Priority.” Lexico.com, Oxford University Press, 2021. Web.

    Riebold, Jan, and Yannick Bartens. “Reinventing the Digital IT Operating Model for the ‘New Normal.’” Capgemini Worldwide, 3 Nov. 2020. Web.

    Samuels, Mark. “The CIO’s next priority: Using the tech budget for growth.” ZDNet, 1 Sept. 2021. Accessed 1 Nov. 2021.

    Sayer, Peter. “Exclusive Survey: CIOs Outline Tech Priorities for 2021-22.” CIO, 5 Oct. 2021. Web.

    Shacklett, Mary E. “Where IT Leaders Are Likely to Spend Budget in 2022.” InformationWeek, 10 Aug. 2021. Web.

    “Table 4. Quits Levels and Rates by Industry and Region, Seasonally Adjusted - 2021 M11 Results.” U.S. Bureau of Labor Statistics, Economic News Release, 1 Jan. 2022. Accessed 7 Jan. 2022.

    “Technology Priorities CIOs Must Address in 2022.” Gartner, 19 Oct. 2021. Accessed 1 Nov. 2021.

    Thomson, Joel. Technology, Talent, and the Future Workplace: Canadian CIO Outlook 2021. The Conference Board of Canada, 7 Dec. 2021. Web.

    “Trend.” Lexico.com, Oxford University Press, 2021. Web.

    Vellante, Dave. “CIOs signal hybrid work will power tech spending through 2022.” SiliconANGLE, 25 Sept. 2021. Web.

    Whieldon, Esther, and Robert Clark. “ESG funds beat out S&P 500 in 1st year of COVID-19; how 1 fund shot to the top.” S&P Global Market Intelligence, April 2021. Accessed Dec. 2021.

    Establish an Analytics Operating Model

    • Buy Link or Shortcode: {j2store}339|cart{/j2store}
    • member rating overall impact: 9.0/10 Overall Impact
    • member rating average dollars saved: $8,449 Average $ Saved
    • member rating average days saved: 6 Average Days Saved
    • Parent Category Name: Data Management
    • Parent Category Link: /data-management
    • Organizations are struggling to understand what's involved in the analytics developer lifecycle to generate reusable insights faster.
    • Discover what it takes to become a citizen analytics developer. Identify the proper way to enable self-serve analytics.
    • Self-serve business intelligence/analytics is misunderstood and confusing to the business, especially with regards to the roles and responsibilities of IT and the business.
    • End users are dissatisfied due to a lack of access to the data and the absence of a single source of truth.

    Our Advice

    Critical Insight

    Organizations that take data seriously should:

    • Decouple processes in which data is separated from business processes and elevate the visibility of the organization's data assets.
    • Leverage a secure platform where data can be easily exchanged for insights generation.
    • Create density for analytics where resources are mobilized around analytics ideas to generate value.

    Analytics is a journey, not a destination. This journey can eventually result in some level of sophisticated AI/machine learning in your organization. Every organization needs to mobilize its resources and enhance its analytics capabilities to quickly and incrementally add value to data products and services. However, most organizations fail to mobilize their resources in this way.

    Impact and Result

    • Firms become more agile when they realize efficiencies in their analytics operating models and can quickly implement reusable analytics.
    • IT becomes more flexible and efficient in understanding the business' data needs and eliminates redundant processes.
    • Trust in data-driven decision making goes up with collaboration, engagement, and transparency.
    • There is a clear path to continuous improvement in analytics.

    Establish an Analytics Operating Model Research & Tools

    Start here – read the Executive Brief

    Read our concise Executive Brief that outlines Info-Tech’s methodology for assessing the business' analytics needs and aligning your data governance, capabilities, and organizational structure to deliver analytics faster.

    Besides the small introduction, subscribers and consulting clients within this management domain have access to:

    1. Define your analytics needs

    This phase helps you understand your organization's data landscape and current analytics environment so you gain a deeper understanding of your future analytics needs.

    • Establish an Analytics Operating Model – Phase 1: Define Your Analytics Needs

    2. Establish an analytics operating model

    This phase introduces you to data operating model frameworks and provides a step-by-step guide on how to capture the right analytics operating model for your organization.

    • Establish an Analytics Operating Model – Phase 2: Establish an Analytics Operating Model
    • Analytics Operating Model Building Tool

    3. Implement your operating model

    This phase helps you implement your chosen analytics operating model, as well as establish an engagement model and communications plan.

    • Establish an Analytics Operating Model – Phase 3: Implement Your Analytics Operating Model
    [infographic]

    Workshop: Establish an Analytics Operating Model

    Workshops offer an easy way to accelerate your project. If you are unable to do the project yourself, and a Guided Implementation isn't enough, we offer low-cost delivery of our project workshops. We take you through every phase of your project and ensure that you have a roadmap in place to complete your project successfully.

    1 Define Your Analytics Needs

    The Purpose

    Achieve a clear understanding and case for data analytics.

    Key Benefits Achieved

    A successful analytics operating model starts with a good understanding of your analytical needs.

    Activities

    1.1 Review the business context.

    1.2 Understand your analytics needs.

    1.3 Draft analytics ideas and use cases.

    1.4 Capture minimum viable analytics.

    Outputs

    Documentation of analytics products and services

    2 Perform an Analytics Capability Assessment

    The Purpose

    Achieve a clear understanding of your organization's analytics capability and mapping across organizational functions.

    Key Benefits Achieved

    Understand your organization's data landscape and current analytics environment to gain a deeper understanding of your future analytics needs.

    Activities

    2.1 Capture your analytics capabilities.

    2.2 Map capabilities to a hub-and-spoke model.

    2.3 Document operating model results.

    Outputs

    Capability assessment results

    3 Establish an Analytics Operating Model

    The Purpose

    Capture the right analytics operating model for your organization.

    Key Benefits Achieved

    Explore data operating model frameworks.

    Capture the right analytics operating model for your organization using a step-by-step guide.

    Activities

    3.1 Discuss your operating model results.

    3.2 Review your organizational structure’s pros and cons.

    3.3 Map resources to target structure.

    3.4 Brainstorm initiatives to develop your analytics capabilities.

    Outputs

    Target operating model

    4 Implement Your Analytics Operating Model

    The Purpose

    Formalize your analytics organizational structure and prepare to implement your chosen analytics operating model.

    Key Benefits Achieved

    Implement your chosen analytics operating model.

    Establish an engagement model and communications plan.

    Activities

    4.1 Document your target organizational structure and RACI.

    4.2 Establish an analytics engagement model.

    4.3 Develop an analytics communications plan.

    Outputs

    Reporting and analytics responsibility matrix (RACI)

    Analytics engagement model

    Analytics communications plan

    Analytics organizational chart

    Data Architecture

    • Buy Link or Shortcode: {j2store}17|cart{/j2store}
    • Related Products: {j2store}17|crosssells{/j2store}
    • member rating overall impact: 9.5/10
    • member rating average dollars saved: $30,159
    • member rating average days saved: 5
    • Parent Category Name: Data and Business Intelligence
    • Parent Category Link: /data-and-business-intelligence
    Enable the business to achieve operational excellence, client intimacy, and product leadership with an innovative, agile, and fit-for-purpose data architecture practice

    External Compliance

    • Buy Link or Shortcode: {j2store}39|cart{/j2store}
    • Related Products: {j2store}39|crosssells{/j2store}
    • member rating overall impact: N/A
    • member rating average dollars saved: N/A
    • member rating average days saved: N/A
    • Parent Category Name: Security and Risk
    • Parent Category Link: /security-and-risk
    Take Control of Compliance Improvement to Conquer Every Audit

    Improve Email Security

    • Buy Link or Shortcode: {j2store}272|cart{/j2store}
    • member rating overall impact: N/A
    • member rating average dollars saved: N/A
    • member rating average days saved: N/A
    • Parent Category Name: Secure Cloud & Network Architecture
    • Parent Category Link: /secure-cloud-network-architecture

    As the sophistication of malicious attacks increases, it has become more difficult to ensure applications such as email software are properly protected and secured. The increase in usage and traffic of email exacerbates the security risks to the organization.

    Our Advice

    Critical Insight

    Email has changed. Your email security needs to evolve as well to ensure you are protecting your organization’s communication.

    Impact and Result

    • Gain an understanding of the importance of email security and steps to secure your corporate email.
    • Develop holistic guidelines on implementing best practices to modernize your organization’s email security.

    Improve Email Security Research & Tools

    Besides the small introduction, subscribers and consulting clients within this management domain have access to:

    1. Improve Email Security Storyboard – A guide to best practices for improving an organization’s email security.

    This research provides guidelines to assist organizations in identifying controls to secure their emails along with recommendations on the most common and effective controls to secure and protect corporate emails.

    • Improve Email Security Storyboard

    2. Email Security Checklist – A checklist tool that enables organizations to monitor their progress in implementing controls to improve their email security.

    This checklist of common email security categories and their associated controls helps ensure organizations are following best practices.

    • Email Security Checklist
    [infographic]

    Further reading

    Improve Email Security

    Follow the latest best practices for email security to mitigate evolving threats.

    Analyst Perspective

    Protecting your organization’s digital assets begins with securing your email communication.

    As organizations increasingly rely on email communication for day-to-day business operations, threat actors are exploiting the increased traction to develop and implement more sophisticated email-based attacks. Furthermore, the lack of investment in measures, tools, and technologies for an organization’s email security exacerbates the vulnerabilities at hand.

    Effective use of security procedures and techniques can mitigate and minimize email-based threats have been shown to reduce the ability of these attacks to infiltrate the email inbox. These guidelines and best practices will help your organization conduct due diligence to protect the contents of the email, its transit, and its arrival to the authorized recipient.

    Ahmad Jowhar, Research Specialist, Security & Privacy

    Ahmad Jowhar
    Research Specialist, Security & Privacy
    Info-Tech Research Group

    Executive Summary

    Your Challenge Common Obstacles Info-Tech’s Approach
    • As malicious attacks get increasingly sophisticated, it has become more difficult to ensure applications such as email software are properly protected and secured.
    • The increased usage and traffic of emails, as well as their contents, exacerbates security risks to the organization.
    • Given the variety of email security controls, it can be complicated to identify the most important techniques for improving your organization’s email security.
    • Understand the importance of implementing email security for your organization.
    • Develop a holistic guideline for implementing best practices to secure your organization’s emails.

    Info-Tech Insight
    Email has changed. Your email security must evolve to ensure the safety of your organization’s communication.

    Your Challenge

    As a security leader, you need to modernize your email security services so you can protect business communications and prevent security incidents.

    • Various factors must be considered when deciding how best to safeguard your organization’s communication chain. This includes the frequency of email traffic and the contents of emails.
    • The increased number of email-based cyberattacks reveals the sophistication of threat actors in leveraging an organization’s lack of email security to infiltrate their business.
    • As organizations continue to rely heavily on email communication, email-based threats will become increasingly prevalent.

    75% of organizations have experienced an increase in email-based threats.

    97% of security breaches are due to phishing attacks.

    82% of companies reported a higher volume of email in 2022.

    Source: Mimecast, 2023.

    Modern email security controls framework for security leaders

    Email has changed. Your email security must evolve to ensure the safety of your organization’s communication.

    Modern email security controls framework for security leaders

    Understand the best practices in securing your organization’s emails

    Enhance your security posture by modernizing your email security
    Email has changed. Your email security must evolve to ensure the safety of your organization’s communication.

    Deploy an added layer of defense by preventing the contents of your email from being intercepted.

    Encrypting your email communication will provide an additional layer of protection which only allows authorized users to read the email.

    Leverage triple-threat authentication controls to strengthen your email security.

    Leveraging SPF, DKIM, and DMARC enables you to have the proper authentication controls in place, ensuring that only legitimate users are part of the email communication.

    Protect the contents of your email through data classification and data loss prevention.

    Having tools and technologies in place to ensure that data is classified and backed up will enable better storage, analysis, and processing of the email.

    Implement email policies for a holistic email security protection.

    Policies ensure acceptable standards are in place to protect the organization’s assets, including the creation, attachment, sending, and receiving of emails.

    User awareness and training
    Training employees on protecting their corporate emails adds an extra layer of defense by ensuring end users are aware of various email-based threats and can confidently safeguard their organizations from attacks.

    Email encryption

    Deploy an added layer of defense by preventing the contents of your email from being intercepted.

    • Protecting your organization’s emails begins by ensuring only the appropriate recipients can receive and read the email’s contents.
    • This process includes encrypting the email’s contents to protect sensitive information from being read by unauthorized recipients.
    • This protects the contents even if the email is intercepted by anyone besides the intended recipient.
    • Other benefits of email encryption include:
      • Reducing any risks associated with regulatory violations.
      • Enabling business to confidently communicate sensitive information via email.
      • Ensuring protective measures taken to prevent data loss and corporate policy violations.

    Along with the increased use of emails, organizations are seeing an increase in the number of attacks orchestrating from emails. This has resulted in 74% of organizations seeing an increase in email-based threats.

    Source: Mimecast, 2023.

    Info-Tech Insight
    Encrypting your email communication will provide an additional layer of protection which only allows authorized users to read the email.

    Implementing email encryption

    Leverage these protocols and tools to help encrypt your email.

    • The most common email encryption protocols and tools include:
      • Transport Layer Security (TLS): A cryptographic protocol designed to securely deliver data via the internet, which prevents third parties from intercepting and accessing the data.
      • Secure/Multipurpose Internet Mail Extension (S/MIME): A protocol for sending digitally signed and encrypted messages by leveraging public key encryption to provide at-rest and in-transit data protection.
      • Secure Email Gateway: An email security solution that inspects emails for malicious content prior to it reaching the corporate system. The solution is positioned between the public internet and corporate email servers. An email gateway solution would be provided by a third-party vendor and can be implemented on-premises, through the cloud, or hybrid.
    • Email encryption policies can also be implemented to ensure processes are in place when sending sensitive information through emails.
    • Email encryption ensures end-to-end privacy for your email and is especially important when the email requires strict content privacy.

    Email authentication

    Three authentication controls your organization should leverage to stay secure.

    • Along with content encryption, it’s important to authenticate both the sender and recipient of an email to ensure that only legitimate users are able to send and receive it.
    • Implementing email authentication techniques prevents unsolicited email (e.g. spam) from entering your mailbox.
    • This also prevents unauthorized users from sending email on your organization’s behalf.
    • Having these standards in place would safeguard your organization from spam, spoofing, and phishing attacks.
    • The three authentication controls include:
      • Sender Policy Framework (SPF): Email validation control that verifies that the incoming email is from an authorized list of IP addresses provided by the sender’s domain administrator.
      • DomainKeys Identified Mail (DKIM): Enables recipients to verify that an email from a specific domain was authorized by the domain’s owner. This is conducted through cryptographic authentication by adding a digital signature to the message headers of outbound emails.
      • Domain Message Authentication Reporting & Conformance (DMARC): Provides domain-level protection of email channel by publishing DMARC records in the organization’s domain name system (DNS) and creates policies which prompts actions to take if an email fails authentication.

    Although these authentication controls are available for organizations to leverage, the adoption rate remains low. 73% of survey respondents indicated they didn’t deploy email authentication controls within their organization.

    Source: Mimecast, 2023.

    Email authentication controls

    All three authentication controls should be implemented to effectively secure your organization’s email. They ensure the emails you send and receive are securely authorized and legitimate.

    SPF DKIM DMARC

    Creating an SPF record identifies which IP addresses are allowed to send emails from your domain. Steps to implement SPF include the following:

    1. Create an SPF record by identifying the IP addresses that are authorized to send emails.
    2. Publish your SPF record into your DNS by creating a TXT record on your domain.

    Implementing DKIM helps prevent attackers from sending emails that pretend to come from your domain. Steps to implement DKIM include the following:

    1. Identify and enable domains you wish to configure DKIM to create DKIM keys.
    2. Copy the canonical names (CNAMEs) that are provided.
    3. Publish the CNAME records to your DNS service provider.

    Setting up DMARC ensures emails are validated and defines actions to take if an email fails authentication. These include:

    • None: Message is delivered to recipient and a DMARC report is sent to domain owner.
    • Quarantine: Message moved to quarantine folder and recipient is notified.
    • Reject: Message is not delivered to the recipient.
    • Steps to implement DMARC include:
    1. Create a DMARC record by including your organization’s email domain and IP addresses.
    2. Form a DMARC TXT record for your domain to include policies and publish it to your DNS.

    For more information:

    Data classification

    Ensure sensitive data is securely processed, analyzed, and stored.

    • Besides authenticating the legitimacy of an email and its traffic to the recipient, it’s important to have procedures in place to protect the contents of an email.
    • Data classification is found not only in databases and spreadsheets, but also in the email messages being communicated. Examples of data most commonly included in emails:
      • Personal identifiable information (PII): social security number, financial account number, passcodes/passwords
    • Applying data classification to your email can help identify the sensitivity of the information it contains. This ensures any critical data within an email message is securely processed and protected against unauthorized use, theft, and loss.
    • Emails can be classified based on various sensitivity levels. such as:
      • Top secret, public, confidential, internal

    Discover and Classify Your Data

    Leverage this Info-Tech blueprint for guidelines on implementing a data classification program for your organization.

    Info-Tech Insight
    Having tools and technologies in place to ensure that data is classified and backed up will enable better storage, analysis, and processing of the email.

    Data loss prevention (DLP)

    Protect your data from being lost/stolen.

    • Protecting an email’s contents through data classification is only one approach for improving email security. Having a data loss prevention solution would further increase security by minimizing the threat of sensitive information leaving your organization’s email network.
    • Examples of tools embedded in DLP solutions that help monitor an organization's email communication:
      • Monitoring data sent and received from emails: This ensures the data within an email communication is protected with the necessary encryption based on its sensitivity.
      • Detecting suspicious email activity: This includes analyzing users’ email behavior regarding email attachments and identifying irregular behaviors.
      • Flagging or blocking email activities which may lead to data loss: This prevents highly sensitive data from being communicated via email and reduces the risk of information being intercepted.
    • The types of DLP technologies that can be leveraged include:
      • Rule-based: Data that has been tagged by admins as sensitive can be blocklisted, which would flag and/or block data from being sent via email.
      • Machine learning: Data on users’ email behavior is collected, processed, and trained to understand the employee’s normal email behavior and detect/flag suspicious activities.
    • Implementing DLP solutions would complement your data classification techniques by ensuring proper measures are in place to secure your organization’s assets through policies, technology, and tools.

    48% of employees have accidently attached the wrong file to an email.

    39% of respondents have accidently sent emails that contained security information such as passwords and passcodes.

    Source: Tessian, 2021.

    User awareness & training

    A strong security awareness & training program is an important element of strengthening your email security.

    • Having all these tools and techniques in place to improve your email security will not be effective unless you also improve your employees’ awareness.
    • Employees should participate in email security training, especially since the majority utilize this channel of communication for day-to-day operations.
    • User awareness and training should go beyond phishing campaigns and should highlight the various types of email-based threats, the characteristics of these threats, and what procedures they can follow to minimize these threats.
    • 95% of data breaches are caused by human error. It can take nine months to discover and contain them, and they are expected to cost $8 trillion this year (Mimecast, 2023).
    • Investments in employee awareness and training would mitigate these risks by ensuring employees recognize and report suspicious emails, remain mindful of what type of data to share via email, and improve their overall understanding of the importance of email security.

    Develop a Security Awareness and Training Program That Empowers End Users

    Leverage this Info-Tech blueprint for assistance on creating various user training materials and empower your employees to become a main line of defense for your organization.

    64% of organizations conduct formal training sessions (in-person or computer-based).

    74% of organizations only focus on providing phishing-based training.

    Source: Proofpoint, 2021.

    Examples of email-based threats

    Phishing
    Email sent by threat actors designed to manipulate end user into providing sensitive information by posing as a trustworthy source

    Business Email Compromise
    Attackers trick a user into sending money or providing confidential information

    Spam
    Users receive unsolicited email, usually in bulk, some of which contains malware

    Spear Phishing
    A type of phishing attack where the email is sent to specific and targeted emails within the organization

    Whaling
    A type of phishing attack similar to spear phishing, but targeting senior executives within the organization

    Password/Email Exposure
    Employees use organizational email accounts and passwords to sign up for social media, leaving them susceptible to email and/or password exposure in a social media breach

    Email policies

    Having policies in place will enable these controls to be implemented.

    Developing security policies that are reasonable, auditable, enforceable, and measurable ensures proper procedures are followed and necessary measures are implemented to protect the organization. Policies relating to email security can be categorized into two groups:

    • User policy: Policies employees must adhere to when using their corporate email. Examples:
      • User acceptance of technology: Acknowledgment of legitimate and restrictive actions when using corporate email
      • Security awareness and training: Acknowledging completion of email security training
    • Administrator-set policy: Policies that are implemented by IT and/or security admins. Examples:
      • Email backup: Policy on how long emails should be archived and processes for disposing of them
      • Log retention: Policy on how to retain, process, and analyze logs created from email servers
      • Throttling: Policies that limit the number of emails sent by a sender and the number of recipients per email and per day depending on the employee’s grouping

    Develop and Deploy Security Policies

    Leverage this Info-Tech blueprint for assistance on developing and deploying actionable policies and creating an overall policy management lifecycle to keep your policies current, effective, and compliant.

    Info-Tech Insight
    Policies ensure acceptable standards are in place to protect the organization’s assets, including the creation, attachment, sending, and receiving of emails.

    Email security technologies & tools (SoftwareReviews)

    SoftwareReviews, a division of Info-Tech Research Group, provides enterprise software reviews to help organizations make more efficient decisions during the software selection process. Reviews are provided by authenticated IT professionals who have leveraged the software and provide unbiased insights on different vendors and their products.

    Learn from the collective knowledge of real IT professionals.

    • Know the products and features available.
    • Explore modules and detailed feature-level data.
    • Quickly understand the market.

    Evaluate market leaders through vendor rankings and awards.

    • Convince stakeholders with professional reports.
    • Avoid pitfalls with unfiltered data from real users.
    • Choose software with confidence.

    Cut through misleading marketing material.

    • Negotiate contracts based on data.
    • Know what to expect before you sign.
    • Effectively manage the vendor.

    Email security technologies & tools

    Leverage these tools for an enhanced email security solution.

    Email Security Checklist

    Follow these guidelines to ensure you are implementing best practices for securing your organization’s emails.

    • The Email Security Checklist is a tool to assess the current and future state of your organization’s email security and provides a holistic understanding on monitoring your progress within each category and associated controls.
    • The status column allows you to select the feature’s current implementation status, which includes the following options:
      • Enabled: The feature is deployed within the organization’s network.
      • Implemented: The feature is implemented within the organization’s network, but not yet deployed.
      • Not implemented: The feature has not been enabled or implemented.
    • Comments can be added for each feature to provide details such as indicating the progress on enabling/implementing a feature and why certain features are not yet implemented.

    Email Security Checklist

    Download the Email Security Checklist tool

    Related Info-Tech Research

    Discover and Classify Your Data
    Leverage this Info-Tech blueprint for guidelines on implementing a data classification program for your organization.

    Develop a Security Awareness and Training Program That Empowers End Users
    Leverage this Info-Tech blueprint for assistance on creating various user training materials and empower your employees to become a main line of defense for your organization.

    Develop and Deploy Security Policies
    Leverage this Info-Tech blueprint for assistance on developing and deploying actionable policies and creating an overall policy management lifecycle to keep your policies current, effective, and compliant.

    Bibliography

    “10 Best Practices for Email Security in 2022.” TitanFile, 22 Sept. 2022. Web.

    “2021 State of the Phish.” Proofpoint, 2021. Web.

    Ahmad, Summra. “11 Email Security Best Practices You Shouldn't Miss (2023).” Mailmunch, 9 Mar. 2023. Web.

    “Blumira's State of Detection and Response.” Blumira, 18 Jan. 2023. Web.

    Clay, Jon. “Email Security Best Practices for Phishing Prevention.” Trend Micro, 17 Nov. 2022. Web.

    Crane, Casey. “6 Email Security Best Practices to Keep Your Business Safe in 2019.” Hashed Out by The SSL Store™, 7 Aug. 2019. Web.

    Hateb, Seif. “Basic Email Security Guide.” Twilio Blog, Twilio, 5 Dec. 2022. Web.

    “How DMARC Advances Email Security.” CIS, 9 July 2021. Web.

    Pal, Suryanarayan. “10 Email Security Best Practices You Should Know in 2023.” Mailmodo, 9 Feb. 2023. Web.

    Pitchkites, Max. “Email Security: A Guide to Keeping Your Inbox Safe in 2023.” Cloudwards, 9 Dec. 2022. Web.

    Rudra, Ahona. “Corporate Email Security Checklist.” PowerDMARC, 4 July 2022. Web.

    “Sender Policy Framework.” Mimecast, n.d. Web.

    Shea, Sharon, and Peter Loshin. “Top 15 Email Security Best Practices for 2023: TechTarget.” TechTarget, 14 Dec. 2022. Web.

    “The Email Security Checklist: Upguard.” UpGuard, 16 Feb. 2022. Web.

    “The State of Email Security 2023.” Mimecast, 2023. Web.

    Wetherald, Harry. “New Product - Stop Employees Emailing the Wrong Attachments.” Tessian, 16 Sept. 2021. Web.

    “What Is DMARC? - Record, Verification & More: Proofpoint Us.” Proofpoint, 9 Mar. 2023. Web.

    “What Is Email Security? - Defining Security of Email: Proofpoint Us.” Proofpoint, 3 Mar.2023. Web.

    Wilton, Laird. “How to Secure Email in Your Business with an Email Security Policy.” Carbide, 31 Jan. 2022. Web.

    Adopt Design Thinking in Your Organization

    • Buy Link or Shortcode: {j2store}327|cart{/j2store}
    • member rating overall impact: 9.6/10 Overall Impact
    • member rating average dollars saved: $23,245 Average $ Saved
    • member rating average days saved: 13 Average Days Saved
    • Parent Category Name: Innovation
    • Parent Category Link: /innovation
    • End users often have a disjointed experience while interacting with your organization in using its products and services.
    • You have been asked by your senior leadership to start a new or revive an existing design or innovation function within your organization. However, your organization has dismissed design thinking as the latest “management fad” and does not buy into the depth and rigor that design thinking brings.
    • The design or innovation function lives on the fringes of your organization due to its apathy towards design thinking or tumultuous internal politics.
    • You, as a CIO, want to improve the user satisfaction with the IT services your team provides to both internal and external users.

    Our Advice

    Critical Insight

    • A user’s perspective while interacting with the products and services is very different from the organization’s internal perspective while implementing and provisioning those. A design-based organization balances the two perspectives to drive user-satisfaction over end-to-end journeys.
    • Top management must have a design thinker – the guardian angel of the balance between exploration (i.e. discovering new business models) and exploitation (i.e. leveraging existing business models).
    • Your approach to adopt design thinking must consider your organization’s specific goals and culture. There’s no one-size-fits-all approach.

    Impact and Result

    • User satisfaction, with the end-to-end journeys orchestrated by your organization, will significantly increase.
    • Design-centric organizations enjoy disproportionate financial rewards.

    Adopt Design Thinking in Your Organization Research & Tools

    Start here – read the Executive Brief

    Read our concise Executive Brief to find out why you should adopt design thinking in your organization, review Info-Tech’s methodology, and understand the four ways we can support you in completing this project.

    Besides the small introduction, subscribers and consulting clients within this management domain have access to:

    1. What is design thinking?

    The focus of this phase is on revealing what designers do during the activity of designing, and on building an understanding of the nature of design ability. We will formally examine the many definitions of design thinking from experts in this field. At the core of this phase are several case studies that illuminate the various aspects of design thinking.

    • Adopt Design Thinking in Your Organization – Phase 1: What Is Design Thinking?
    • Victor Scheinman's Experiment for Design

    2. How does an organization benefit from design thinking?

    This phase will illustrate the relevance of design in strategy formulation and in service-design. At the core of this phase are several case studies that illuminate these aspects of design thinking. We will also identify the trends impacting your organization and establish a baseline of user-experience with the journeys orchestrated by your organization.

    • Adopt Design Thinking in Your Organization – Phase 2: How Does an Organization Benefit From Design Thinking?
    • Trends Matrix (Sample)

    3. How do you build a design organization?

    The focus of this phase is to:

  • Measure the design-centricity of your organization and subsequently, identify the areas for improvement.
  • Define an approach for a design program that suites your organization’s specific goals and culture.
    • Adopt Design Thinking in Your Organization – Phase 3: How Do You Build a Design Organization?
    • Report on How Design-Centric Is Your Organization (Sample)
    • Approach for the Design Program (Sample)
    • Interview With David Dunne on Design Thinking
    • Interview With David Dunne on Design Thinking (mp3)
    [infographic]

    Workshop: Adopt Design Thinking in Your Organization

    Workshops offer an easy way to accelerate your project. If you are unable to do the project yourself, and a Guided Implementation isn't enough, we offer low-cost delivery of our project workshops. We take you through every phase of your project and ensure that you have a roadmap in place to complete your project successfully.

    1 What Is Design Thinking?

    The Purpose

    The focus of this module is on revealing what designers do during the activity of designing, and on building an understanding of the nature of design ability. We will also review the report on the design-centricity of your organization and subsequently, earmark the areas for improvement.

    Key Benefits Achieved

    An intimate understanding of the design thinking

    An assessment of design-centricity of your organization and identification of areas for improvement

    Activities

    1.1 Discuss case studies on how designers think and work

    1.2 Define design thinking

    1.3 Review report from Info-Tech’s diagnostic: How design-centric is your organization?

    1.4 Earmark areas for improvement to raise the design-centricity of your organization

    Outputs

    Report from Info-Tech’s diagnostic: ‘How design-centric is your organization?’ with identified areas for improvement.

    2 How Does an Organization Benefit From Design Thinking?

    The Purpose

    In this module, we will discuss the relevance of design in strategy formulation and service design. At the core of this module are several case studies that illuminate these aspects of design thinking. We will also identify the trends impacting your organization. We will establish a baseline of user experience with the journeys orchestrated by your organization.

    Key Benefits Achieved

    An in-depth understanding of the relevance of design in strategy formulation and service design

    An understanding of the trends that impact your organization

    A taxonomy of critical customer journeys and a baseline of customers’ satisfaction with those

    Activities

    2.1 Discuss relevance of design in strategy through case studies

    2.2 Articulate trends that impact your organization

    2.3 Discuss service design through case studies

    2.4 Identify critical customer journeys and baseline customers’ satisfaction with those

    2.5 Run a simulation of design in practice

    Outputs

    Trends that impact your organization.

    Taxonomy of critical customer journeys and a baseline of customers’ satisfaction with those.

    3 How to Build a Design Organization

    The Purpose

    The focus of this module is to define an approach for a design program that suits your organization’s specific goals and culture.

    Key Benefits Achieved

    An approach for the design program in your organization. This includes aspects of the design program such as its objectives and measures, its model (one of the five archetypes or a hybrid one), and its governance.

    Activities

    3.1 Identify objectives and key measures for your design thinking program

    3.2 Structure your program after reviewing five main archetypes of a design program

    3.3 Balance between incremental and disruptive innovation

    3.4 Review best practices of a design organization

    Outputs

    An approach for your design thinking program: objectives and key measures; structure of the program, etc.

    Communicate Any IT Initiative

    • Buy Link or Shortcode: {j2store}428|cart{/j2store}
    • member rating overall impact: N/A
    • member rating average dollars saved: N/A
    • member rating average days saved: N/A
    • Parent Category Name: Lead
    • Parent Category Link: /lead

    IT communications are often considered ineffective and unengaging. This is demonstrated by the:

    • Lack of expectation that IT should communicate well. Why develop a skill that no one expects IT to deliver on?
    • Failure to recognize the importance of communication to engage employees and communicate ideas.
    • Perception that communication is a broadcast not a continuous dialogue.
    • Inability to create, monitor, and manage feedback mechanisms.
    • Overreliance on data as the main method of communication instead of as evidence to support a broader narrative.

    Our Advice

    Critical Insight

    • Don't make data your star. It is a supporting character. People can argue about the collection methods or interpretation of the data, but they cannot argue with the story you share.
    • Messages are also non-verbal. Practice using your voice and body to set the right tone and impact your audience.
    • Recognize that communications are essential even in highly technical IT environments.
    • Measure if the communication is being received and resulting in the desired outcome. If not, modify what and how the message is being expressed.

    Impact and Result

    • Develop an actionable plan to deliver consistent, timely messaging for all audiences.
    • Compose and deliver meaningful messages.
    • Consistently deliver the right information and the right time to the right stakeholders.

    Communicate Any IT Initiative Research & Tools

    Besides the small introduction, subscribers and consulting clients within this management domain have access to:

    1. Communicate Any IT Initiative Deck – A step-by-step document that walks you through how to plan, compose, and deliver communications to any stakeholder up, down, or across the organization.

    This blueprint not only provides the tools and techniques for planning, composing, and delivering effective communications, but also walks you through practical exercises. Practice and perfect your communication, composition, and delivery skills for any IT initiative.

    • Communicate Any IT Initiative – Phases 1-3

    2. Communicate Any IT Initiative Facilitation Deck – A step-by-step communications workshop deck suitable for any workshop with a communication component.

    Communication concepts and exercises that teach you how to plan, compose, and deliver effective communications. The deck includes practical tools, techniques, and skills practice.

    • Communicate Any IT Initiative Facilitation Deck

    3. Communications Planner – An communications plan template that includes a section to define a change, a communications plan, communications calendars, and a pitch composition exercise.

    This communications planner is a tool that accompanies the Effective IT Communications blueprint and the Communicate Any IT Initiative Facilitation Deck so that you can plan your communications, view your deliverables, and compose your pitch all in one document.

    • Communications Planner Tool

    4. Stakeholder Analysis Tool – A tool to help ensure that all stakeholders are identified and none are missed.

    A tool for identifying stakeholders and conducting an analysis to understand their degree of influence or impact.

    • Stakeholder Management Analysis Tool
    [infographic]

    Further reading

    Communicate Any IT Initiative

    Plan, compose, and deliver communications that engage your audience.

    Executive Summary

    Your Challenge Common Obstacles Info-Tech’s Approach
    Communicating about your initiative is when the work really begins. Many organizations struggle with:
    • Knowing what target audiences need to be communicated with.
    • Communicating the same message consistently and clearly across target audiences.
    • Communicating to target audiences at the right times.
    • Selecting a channel that will be most effective for the message and practicing to deliver that message.
    Some of the challenges IT faces when it comes to communicating its initiatives includes:
    • Not being given the opportunity or time to practice composing or delivering communications.
    • Coordinating the communications of this initiative with other initiative communications.
    • Forgetting to communicate with key stakeholders.
    Choosing not to communicate because we do not know how it’s leading to initiative failures and lack of adoption by impacted parties.
    For every IT initiative you have going forward, focus on following these three steps:
    1. Create a plan of action around who, what, how, and when communications will take place.
    2. Compose an easy-to-understand pitch for each stakeholder audience.
    3. Practice delivering the message in an authentic and clear manner.
    By following these steps, you will ensure that your audience always understands and feels ready to engage with you.

    Info-Tech Insight
    Every IT employee can be a great communicator; it just takes a few consistent steps, the right tools, and a dedication to practicing communicating your message.

    Info-Tech’s approach

    Effective communications is not a broadcast but a dialogue between communicator and audience in a continuous feedback loop.

    Continuous Feedback Loop

    The Info-Tech difference:

    1. The skills needed to communicate effectively as a front-line employee or CIO are the same. It’s important to begin the development of these skills from the beginning of one's career.
    2. Time is a non-renewable resource. Any communication needs to be considered valuable and engaging by the audience or they will be unforgiving.
    3. Don't make data your star. It is a supporting character. People can argue about the collection methods or interpretation of the data, but they cannot argue about the story you share.

    Poor communication can lead to dissatisfied stakeholders

    27.8% of organizations are not satisfied with IT communications.

    25.8% of business stakeholders are not satisfied with IT communications.

    Source: Info-Tech Diagnostic Programs; n=34,345 business stakeholders within 604 organizations

    The bottom line? Stakeholders for any initiative need to be communicated with often and well. When stakeholders become dissatisfied with IT’s communication, it can lead to an overall decrease in satisfaction with IT.

    Good IT initiative communications can be leverage

    • IT risk mitigation and technology initiative funding are dependent on critical stakeholders comprehending the risk impact and initiative benefit in easy-to-understand terms.
    • IT employees need clear and direct information to feel empowered and accountable to do their jobs well.
    • End users who have a good experience engaging in communications with IT employees have an overall increase in satisfaction with IT.
    • Continuously demonstrating IT’s value to the organization comes when those initiatives are clearly aligned to overall objectives – don’t assume this alignment is being made.
    • Communication prevents assumptions and further miscommunication from happening among IT employees who are usually impacted and fear change the most.

    “Nothing gets done properly if it's not communicated well.”
    -- Nastaran Bisheban, CTO KFC Canada

    Approach to communications

    Introduction
    Review effective communications.

    Plan
    Plan your communications using a strategic tool.

    Compose
    Create your own message.

    Deliver
    Practice delivering your own message.

    Info-Tech’s methodology for effective IT communications

    1. Plan Strategic Communications 2. Compose a Compelling Message 3. Deliver Messages Effectively
    Step Activities
    1. Define the Change
    2. Determine Target Audience
    3. Communication Outcomes
    4. Clarify the Key Message(s)
    5. Identify the Owner and Messenger(s)
    6. Select the Right Channels
    7. Establish a Frequency and Time Frame
    8. Obtain Feedback and Improve
    9. Finalize the Calendar
    1. Craft a Pitch
    2. Revise the Pitch
    1. Deliver Your Pitch
    2. Refine and Deliver Again
    Step Outcomes Establish an easy-to-read view of the key communications that need to take place related to your initiative or change. Practice writing a pitch that conveys the message in a compelling and easy-to-understand way. Practice delivering the pitch. Ensure there is authenticity in the delivery while still maintaining the audience’s attention.

    This blueprint can support communication about any IT initiative

    • Strategy or roadmap
    • Major transformational change
    • System integration
    • Process changes
    • Service changes
    • New solution rollouts
    • Organizational restructuring

    We recommend considering this blueprint a natural add-on to any completed Info-Tech blueprint, whether it is completed in the DIY fashion or through a Guided Implementation or workshop.

    Key deliverable:

    Communication Planner
    A single place to plan and compose all communications related to your IT initiative.

    Blueprint deliverables

    Each step of this blueprint is accompanied by supporting deliverables to help you accomplish your goals.

    Facilitation Guide
    A step-by-step guide to help your IT organization develop a communication plan and practice composing and delivering key messages.

    Stakeholder Analysis
    An ability to assess all stakeholders based on impact, influence, and involvement.

    Workshop Overview

    MorningAfternoon
    ActivitiesPlan Strategic Communications for Your Initiative
    1. Define the Change
    2. Determine Target Audience
    3. Communication Outcomes
    4. Clarify the Key Message(s)
    5. Identify the Owner and Messenger(s)
    6. Select the Right Channels
    7. Establish a Frequency and Time Frame
    8. Obtain Feedback and Improve
    9. Finalize the Calendar
    Compose and Deliver a Compelling Message
    1. Craft a Pitch
    2. Revise the Pitch
    3. Deliver Your Pitch
    4. Refine and Deliver Again
    Deliverables
    1. Communication planner with weekly, monthly, and yearly calendar views to ensure consistent and ongoing engagement with every target audience member
    1. Crafted pitches that can be used for communicating the initiative to different stakeholders
    2. Skills and ability to deliver messages more effectively

    Contact your account representative for more information.
    workshops@infotech.com 1-888-670-8889

    Key KPIs for communication with any stakeholder

    Measuring communication is hard; use these to determine effectiveness:

    Goal Key Performance Indicator (KPI) Related Resource
    Obtain board buy-in for IT strategic initiatives. X% of IT initiatives that were approved to be funded.
    Number of times that technical initiatives were asked to be explained further.
    Using our Board Presentation Review
    Ensure stakeholders feel engaged during initiatives. X% of business leadership satisfied with the statement “IT communicates with your group effectively.” Using the CIO Business Vision Diagnostic
    End users know what IT initiatives are going to impact the products or services they use. X% of end users that are satisfied with communications around changing services or applications. Using the End-User Satisfaction Survey
    Project stakeholders receive sufficient communication throughout the initiative. X% overall satisfaction with the quality of the project communications. Using the PPM Customer Satisfaction Diagnostic
    Employees are empowered to perform on IT initiatives. X% satisfaction employees have with statement “I have all the resources and information I need to do a great job.” Using the Employee Engagement Diagnostic Program

    Phase 1

    Plan Strategic Communications

    Activities
    1.1 Define the Change
    1.2 Determine Target Audience
    1.3 Communication Outcomes
    1.4 Clarify the Key Message(s)
    1.5 Identify the Owner and Messenger(s)
    1.6 Select the Right Channels
    1.7 Establish a Frequency and Time Frame
    1.8 Obtain Feedback and Improve
    1.9 Finalize the Calendar

    Communicate Any IT Initiative Effectively
    Phase1 > Phase 2 > Phase 3

    This step involves the following participants:
    Varies based on those who would be relevant to your initiative.

    Outcomes of this step
    Create an easy-to-follow communications plan to ensure that the right message is sent to the right audience using the right medium and frequency.

    What is an IT change?

    Before communicating, understand the degree of change.

    Incremental Change:
    • Changes made to improve current processes or systems (e.g. optimizing current technology).
    Transitional Change:
    • Changes that involve dismantling old systems and/or processes in favor of new ones (e.g. new product or services added).
    Transformational Change:
    • Significant change in organizational strategy or culture resulting in substantial shift in direction.
    Examples:
    • New or changed policy
    • Switching from on-premises to cloud-first infrastructure
    • Implementing ransomware risk controls
    • Implementing a learning & development plan
    Examples:
    • Moving to an insourced or outsourced service desk
    • Developing a BI & analytics function
    • Integrating risk into organization risk
    • Developing a strategy (technology, architecture, security, data, service, infrastructure, application)
    Examples:
    • Organizational redesign
    • Acquisition or merger of another organization
    • Implementing a digital strategy
    • A new CEO or board taking over the organization's direction

    Consider the various impacts of the change

    Invest time at the start of the project to develop a detailed understanding of the impact of the change. This will help to create a plan that will simplify the change and save time in the end. Evaluate the impact from a people, process, and technology perspective.

    Leverage a design thinking principle: Empathize with the stakeholder – what will change?

    People

    • Team structure
    • Reporting structure
    • Career paths
    • Job skills
    • Responsibilities
    • Company vision/mission
    • Number of FTE
    • Culture
    • Training required

    Process

    • Budget
    • Work location
    • Daily workflow
    • Working conditions
    • Work hours
    • Reward structure
    • Required number of completed tasks
    • Training required

    Technology

    • Required tools
    • Required policies
    • Required systems
    • Training required

    1.1 Define the change

    30 minutes

    1. While different stakeholders will be impacted by the change differently, it’s important to be able to describe what the change is at a higher level.
    2. Have everyone take eight minutes to jot down what the change is and why it is happening in one to two sentences. Tab 2 of the Communication Planner Tool can also be used to house the different ideas.
    3. Present the change statements to one another.
    4. By leveraging one of the examples or consolidating many examples, as a group document:
      • What is the change?
      • Why is it happening?
    5. The goal is to ensure that all individuals involved in establishing or implementing the change have the same understanding.
    Input Output
    • Individual ideas about what change is occurring and why.
    • A single statement that reflects the change occurring and the rationale for why the change is needed.
    Materials Participants
    • Communication Planner Tool
    • Sticky notes
    • Whiteboard
    • Varies based on those who would be relevant to your initiative.

    Download the Communication Planner Tool

    Ensure effective communication by focusing on four key elements

    Audience
    Stakeholders (either groups or individuals) who will receive the communication.

    Message
    Information communicated to impacted stakeholders. Must be rooted in a purpose or intent.

    Messenger
    Person who delivers the communication to the audience. The communicator and owner are two different things.

    Channel
    Method or channel used to communicate to the audience.

    Identify the target audience

    The target audience always includes groups and individuals who are directly impacted by the change and may also include those who are change adjacent.

    Define the target audience: Identify which stakeholders will be the target audience of communications related to the initiative. Stakeholders can be single individuals (CFO) or groups (Applications Team).

    Stakeholders to consider:

    • Who is sponsoring the initiative?
    • Who benefits from the initiative?
    • Who loses from the initiative?
    • Who can make approvals?
    • Who controls resources?
    • Who has specialist skills?
    • Who implements the changes?
    • Who will be adversely affected by potential environmental and social impacts in areas of influence that are affected by what you are doing?
    • At which stage will stakeholders be most affected (e.g. procurement, implementation, operations, decommissioning)?
    • Will other stakeholders emerge as the phases are started and completed?

    1.2a Determine target audience

    20 minutes

    1. Consider all the potential individuals or groups of individuals who will be impacted or can influence the outcome of the initiative.
    2. On tab 3 of the Communication Planner Tool, list each of the stakeholders who will be part of the target audience. If in person, use sticky notes to define the target audiences. The individuals or group of individuals that make up the target audience are all the people who require being communicated with before, during, or after the initiative.
    3. As you list each target audience, consider how they perceive IT. This perception could impact how you choose to communicate with the stakeholder(s).
    InputOutput
    • The change
    • Why the change is needed
    • A list of individuals or group of individuals that will be communicated with.
    MaterialsParticipants
    • Communication Planner Tool
    • Sticky notes
    • Whiteboard
    • Varies based on those who would be relevant to your initiative.

    Download the Communication Planner Tool

    1.2b Conduct a stakeholder analysis (optional)

    1 hour

    1. For each stakeholder identified as a part of the target audience, conduct an analysis to understand their degree of influence or impact.
    2. Based on the stakeholder, the influence or impact of the change, initiative, etc. can inform the type and way of communicating.
    3. This is a great activity for those who are unsure how to frame communications for each stakeholder identified as a target audience.
    InputOutput
    • The change
    • Why the change is needed
    • A list of individuals or group of individuals that will be communicated with
    • The degree of influence or impact each target audience stakeholder has.
    MaterialsParticipants
    • Communication Planner Tool
    • Sticky notes
    • Whiteboard
    • Varies based on those who would be relevant to your initiative.

    Download the Stakeholder Management Analysis Tool

    Determine the desired outcome of communicating with each audience

    For each target audience, there will be an overall goal on why they need to be communicated with. This outcome or purpose is often dependent on the type of influence the stakeholder wields within the organization as well as the type of impact the change or initiative will have. Depending on the target audience, consider each of the communication outcomes listed below.

    Communicating Across the Organization Communicating Up to Board or Executives Communicating Within IT
    • Obtain buy-in
    • Obtain approval
    • Obtain funding
    • Demonstrate alignment to organization objectives
    • Reduce concerns about risk
    • Demonstrate alignment to organization objectives
    • Demonstrate alignment to individual departments or functions
    • Obtain other departments’ buy-in
    • Inform about a crisis
    • Inform about the IT change
    • Obtain adoption related to the change
    • Obtain buy-in
    • Inform about the IT change
    • Create a training plan
    • Inform about department changes
    • Inform about organization changes
    • Inform about a crisis
    • Obtain adoption related to the change
    • Distribute key messages to change agents

    1.3 Communication outcomes

    30 minutes

    1. For each stakeholder, there may be one or more reasons why you need to communicate with them. On tab 3 of the Communication Planner Tool or on a whiteboard, begin to identify the objective or outcome your team is seeking by engaging in each target audience.
    2. As you move through the communication outcomes, it could result in more than one outcome for each target audience.
    3. Ensure there is one line for each target audience desired communication outcome. Many stakeholders might need to be communicated with for several reasons. If using the Communication Planner Tool, add the target audience name in column C for as many different communication outcomes there are in column D related to that stakeholder.
    InputOutput
    • The change
    • A list of individuals or group of individuals that will be communicated with
    • Outcome or objective of communicating with each stakeholder
    MaterialsParticipants
    • Communication Planner Tool
    • Sticky notes
    • Whiteboard
    • Varies based on those who would be relevant to your initiative.

    Download the Communication Planner Tool

    Establish and define key messages based on organizational objectives

    What are key messages?
    • Key messages guide all internal communications to ensure they are consistent, unified, and straightforward.
    • Distill key messages down from organizational objectives and use them to reinforce the organization’s strategic direction. Key messages should inspire employees to act in a way that will help the organization reach its objectives.
    How to establish key messages: Ground key messages in organizational strategy and culture. These should be the first places you look to determine the organization’s key messages:
    • Refer to organizational strategy documents. What needs to be reinforced in internal communications to ensure the organization can achieve its strategy? This is a key message.
    • Look at the organization’s values. How do values guide how work should be done? Do employees need to behave in a certain way or keep a certain value top of mind? This is a key message.

    Key messages should be clear, concise, and consistent (Porter, 2014). The intent is to convey important information in a way that is relatable and memorable, to promote reinforcement, and ultimately, to drive action.

    Info-Tech Insight
    Empathizing with the audience is key to anticipating and addressing objections as well as identifying benefits. Customize messaging based on audience attributes such as work model (e.g. hybrid), anticipated objections, what's in it for me? (WIIFM), and specific expectations.

    1.4 Clarify the key messages

    25 minutes

    1. Divide the number of communication lines up equally amongst the participants.
    2. Based on the outcome expected from engaging that target audience in communications, define one to five key messages that should be expressed.
    3. The key messages should highlight benefits anticipated, concerns anticipated, details about the change, and plan of action or next steps. The goal here is to ensure the target audience is included in the communication process.
    4. The key messages should be focused on how the target audience receives a consistent message, especially if different communication messengers are involved.
    5. Document the key messages on tab 3 of the Communication Planner Tool.
    InputOutput
    • The change
    • Target audience
    • Communication outcomes
    • Key messages to support a consistent approach
    MaterialsParticipants
    • Communication Planner Tool
    • Sticky notes
    • Whiteboard
    • Varies based on those who would be relevant to your initiative.

    Download the Communication Planner Tool

    Understand to how to identify appropriate messengers

    Messages must be communicated by a variety of individuals across the organization. Select the messenger depending on the message characteristics (e.g. audience, message, medium). The same messenger can be used for a variety of messages across different mediums.

    Personal impact messages should be delivered by an employee's direct supervisor.

    Organizational impact messages and rationale should be delivered by senior leaders in the affected areas.

    Chart Preferred Messenger for Change Messages

    Recent research by Prosci found employees prefer to hear personal messages from their direct manager and organizational messages from the executive leadership team.

    Fifty percent of respondents indicated the CEO as the preferred messenger for organizational change messages.

    Select the appropriate messenger

    For each audience, message, and medium, review whether the message is personal or organizational to determine which messengers are best.

    The number and seniority of messengers involved depends on the size of the change:

    • Incremental change
      • Personal messages from direct supervisors
      • Organizational messages from a leader in the audience’s function or the direct supervisor
    • Transitional change
      • Personal messages from direct supervisors or function leaders
      • Organizational messages from a leader in the audience’s function or the C suite
    • Transformational change
      • Personal messages from direct supervisors or function leaders
      • Organizational messages from the CEO or C-suite
      • Cascading messages are critical in this type of change because all levels of the organization will be involved

    Communication owner vs. messenger

    Communication Owner

    Single person
    Accountable for the communication message and activities
    Oversees that the communication does not contradict other communications
    Validates the key messages to be made

    Communication Messenger(s)

    Single person or many people
    Responsible for delivering the intended message
    Engages the target audience in the communication
    Ensures the key messages are made in a consistent and clear manner

    1.5 Identify the owner and messenger(s)

    30 minutes

    1. For every communication, there needs to be a single owner. This is the person who approves the communication and will be accountable for the communication
    2. The messenger(s) can be several individuals or a single individual depending on the target audience and desired outcome being sought through the communications.
    3. Identify the person or role who will be accountable for the communication and document this in the Communication Planner Tool.
    4. Identify the person(s) or role(s) who will be responsible for delivering the communication and engaging the target audience and document this in the Communication Planner Tool.
    Input Output
    • Individual ideas about what change is occurring and why.
    • A single statement that reflects the change occurring and the rationale for why the change is needed.
    Materials Participants
    • Communication Planner Tool
    • Sticky notes
    • Whiteboard
    • Varies based on those who would be relevant to your initiative.

    Download the Communication Planner Tool

    Review appropriate channel for different types of messages

    Communication channels are in-person, paper-based, or tech-enabled. Provide communicators with guidance on which mediums to use in different situations.

    First question: Should the communication be delivered in-person or not?
    Types of channels In-Person Paper-Based or Tech-Enabled
    Questions to consider
    • How is your message likely to be received? Is the message primarily negative?
    • Will the message prompt a lot of dialogue or questions? Will it require significant context or clarification?
    Note: Messages that are important, complex, or negative must be delivered in person. This allows the sender to provide context, clarify questions, and collect feedback.
    • Use paper-based and tech-enabled communications to provide reminders or updates.
    • When deciding which of the two to use, think about your audience: do they have regular access to a computer?
    Two-way interaction Supplement in-person communications with paper-based or tech-enabled communications to provide follow-up and consistency (Government of Nova Scotia). Tech-enabled communications allow the sender to deliver messages when they do not co-locate with the receiver. That said, make sure paper-based communications are provided to those without regular access to a computer.

    Consider accessibility when communicating change – not all employees will have access to the same mediums. To ensure inclusivity, strategically plan which mediums to use to reach the entire audience.

    Select communication channels

    Medium Description Key Messages When to Use
    One-on-One Meetings Individual meetings between managers and their direct reports to ensure they understand the change, can express any concerns, and obtain feedback or recommendations.
    • How the change will impact the employee, what they can expect throughout the change, how they can get support, what the timelines are, etc.
    • Requests for feedback.
    • Responses to feedback.
    • Most applicable for personal messages throughout all stages of change.
    • When real-time feedback is needed.
    • To understand the change’s impact on each employee, understand their emotional reactions and provide support.
    • After a change has been announced and continuing at a regular cadence until after the change has been implemented. Frequency of meetings will vary by employee over the course of the change.
    Team Meeting A meeting of a work unit or department. Can be virtual, in person, or a combination. Led by the work unit or department head/manager.
    • How the change will impact the team – how work gets done, who they work with, etc.
    • Available timelines regarding the change.
    • Support available throughout the change.
    • Most applicable for personal messages throughout all change stages.
    • When real-time communication is needed to keep everyone on the same page and provide an opportunity to ask questions (essential for buy-in).
    • To announce a small change or after a larger change announcement. Continue frequently until the end of adoption, with time reserved for ad hoc meetings.
    Email Electronic communication sent to the audience’s company emails, or in the absence of that, to their personal emails.
    • Overarching details and timelines.
    • Short, easy-to-digest pieces of information that either provide a summary of what to expect or describe actions employees need to take.
    • Applicable for both personal and organizational messages, depending on the messenger. Send personal messages in separate emails from organizational messages.
    • To communicate key details quickly and to a distributed workforce.
    • To reinforce or reiterate information that has been shared in person. Can be used broadly or target specific employees/groups.

    Select communication channels

    Medium Description Key Messages When to Use
    Town Hall Virtual or in-person meeting where senior leadership shares information with a wide audience about the change and answers questions.
    • Messaging that is applicable to a large audience.
    • The strategic decisions of senior leadership.
    • Highlight positive initiative outcomes.
    • Recognize employee efforts.
    • Report on engagement.
    • Most applicable for organizational messages to launch a change or between milestones in a long-term or complex change.
    • To enable senior leaders to explain strategic decisions to employees.
    • To allow employees to ask questions and provide feedback.
    • When support of senior leadership is critical to change success.
    Roadshow A series of meetings where senior leadership or the change champion travels to different geographic locations to hold town halls adapted to each location’s audience.
    • Why the change is happening, when the change is happening, who will be impacted, expectations, and key points of contact.
    • Most applicable for organizational messages to launch a change and between milestones during a long-term, large, or complex change.
    • For a change impacting several locations.
    • When face time with senior leadership is critical to developing understanding and adoption of the change. Satellite locations can often feel forgotten. A roadshow provides access to senior leadership and lends the credibility of the leader to the change.
    • To enable live two-way communication between employees and leadership.

    Select communication channels

    Medium Description Key Messages When to Use
    Intranet An internal company website that a large number of employees can access at any time.
    • Information that has already been communicated to the audience before, so they can access it at any time.
    • FAQs and/or general details about the change (e.g. milestones).
    • Most applicable for organizational messages.
    • To post relevant documentation so the audience can access it whenever they need it.
    • To enable consistency in answers to common questions.
    Training Scheduled blocks of time for the team to learn new skills and behaviors needed to successfully adapt to the change.
    • Reinforce the need for change and the benefits the change will have.
    • Most applicable for organizational messages during the implementation stage.
    • To reduce anxiety over change initiatives, improve buy-in, and increase adoption by helping employees develop skills and behaviors needed to perform effectively.
    Video Message A prerecorded short video clip designed for either simultaneous broadcast or just-in-time viewing. Can be sent over email or mobile or uploaded to a company portal/intranet.
    • Positive messaging to convey enthusiasm for the change.
    • Details about why the organization is changing and what the benefits will be, updates on major milestone achievements, etc.
    • Most applicable for organizational messages, used on a limited basis at any point during the change.
    • Effective when the message needs to appear more personal by putting a face to the message and when it can be presented in a condensed time frame.
    • When a message needs to be delivered consistently across a variety of employees, locations, and time zones.
    • To provide updates and recognize key achievements.

    Select communication channels

    Medium Description Key Messages When to Use
    Shift Turnover Meeting A meeting between teams or departments when a shift changes over; sometimes called a shift report. Used to communicate any relevant information from the outgoing shift to the incoming shift members.
    • Details related to the activities performed during the shift.
    • Most applicable for personal impact messages during the implementation stage to reinforce information shared using other communication mediums.
    • Where change directly impacts role expectations or performance so teams hear the same message at the same time.
    Company Newsletter Electronic or hardcopy newsletter published by the company. Contains timely updates on company information.
    • Overarching change details.
    • Information that has already been communicated through other mediums.
    • Varies with the change stage and newsletter frequency.
    • Most applicable for organizational messages throughout the change.
    • When the change implementation is expected to be lengthy and audiences need to be kept updated.
    • To celebrate change successes and milestone achievements.
    Sign/Poster Digital or paper-based sign, graphic, or image. Includes posters, screensavers, etc.
    • Positive messaging to convey enthusiasm for the change.
    • Key dates and activities.
    • Key contacts.
    • Most applicable for organizational messages throughout the change.
    • As visual reminders in common, highly visible locations (e.g. a company bulletin board, elevator TV monitors).

    1.6 Select the right channels

    20 minutes

    1. Consider the different channels that were described and presented on the previous five slides. Each channel has element(s) to it that will allow it to be more beneficial based on the communication target audience, outcome, and messenger.
    2. Evenly assign the number of communication rows on tab 3 of the Communication Planner Tool and input the channel that should be used.
    3. Consider if the channel will:
      • Obtain the desired outcome of the communication.
      • Be completed by the messenger(s) defined.
      • Support the target audience in understanding the key messages.
    4. If any target audience communication requires several channels, add additional rows to the planner on TAB 3.
    InputOutput
    • Target audience
    • Communication outcome
    • Communication messenger(s)
    • The right channel selected to support the desired communication outcome.
    MaterialsParticipants
    • Communication Planner Tool
    • Sticky notes
    • Whiteboard
    • Varies based on those who would be relevant to your initiative.

    Download the Communication Planner Tool

    Define the communication time frame based on the initiative

    Communication occurs during four of the five stages of an initiative:

    01 Identify and prioritize 02 Prepare for initiative 03 Create a communication plan 04 Implement change 05 Sustain the desired outcome
    Before During After
    • Communication begins with sponsors and the project team.
    • Set general expectations with project team and sponsors.
    • Outline the communication plan for the remaining stages.
    • Set specific expectations with each stakeholder group.
    • Implement the communication plan.
    • Use feedback loops to determine updates or changes to communications.
    • Communication continues as required after the change.
    • Feedback loops continue until change becomes business as usual.
    Where communication needs to happen

    Don’t forget: Cascade messages down through the organization to ensure those who need to deliver messages have time to internalize the change before communicating it to others. Include a mix of personal and organizational messages, but where possible, separate personal and organizational content into different communications.

    Establish a frequency that aligns to the desired communication outcome

    Successful communications are frequent communications.

    • The cadence of a communication is highly dependent on the objective of the communication.
    • Each target requires a different frequency as well:
      • Board Presentations > four times a year is a good frequency
      • Executive Leadership > monthly frequency
      • Organizationally > annually and when necessary
      • Organization Crises > daily, if not hourly
      • IT Initiatives and Projects > weekly
      • IT Teams > weekly, if not daily

    Tech Team Frequency for Discussing Goals

    “When goals are talked about weekly, teams are nearly 3X more likely to feel confident hitting them.”
    – Hypercontext, 2022

    Info-Tech Insight
    Communications made once will always fail. Ensure there is a frequency appropriate for every communication — or do not expect the desired outcome.

    1.7 Establish a frequency and time frame

    30 minutes

    1. For each row in tab 3, determine how frequently that communication needs to take place and when that communication needs to be completed by.
      • Frequency: How often the communication will be delivered to the audience (e.g. one-time, monthly, as needed).
      • Time frame: When the communication will be delivered to the audience (e.g. a planned period or a specific date).
    2. When selecting the time frame, consider what dependencies need to take place prior to that communication. For example, IT employees should not be communicated with on anything that has not yet been approved by the CEO. Also consider when other communications might be taking place so the message is not lost in the noise.
    3. For frequency, the only time that a communication needs to take place once is when presenting up to senior leaders of the organization. And even then it will sometimes require more than one conversation. Be mindful of this.
    InputOutput
    • The change
    • Target audience
    • Communication outcome
    • Communication channel
    • Frequency and time frame of the communication
    MaterialsParticipants
    • Communication Planner Tool
    • Sticky notes
    • Whiteboard
    • Varies based on those who would be relevant to your initiative.

    Download the Communication Planner Tool

    First, ensure feedback mechanisms are in place

    Soliciting and acting on feedback involves employees in the decision-making process and demonstrates to them that their contributions matter.

    Prior to the strategy rollout, make sure you have also established feedback mechanisms to collect feedback on both the messages delivered and how they were delivered. Some ways to collect feedback include:

    • Evaluating intranet comments and interactions (likes, etc.) if this function is enabled.
    • Measuring comprehension and satisfaction through surveys and polls.
    • Looking for themes in the feedback and questions employees bring forward to managers during in-person briefings.

    Feedback Mechanisms:

    • CIO Business Vision Survey
    • Engagement Surveys
    • Focus Groups
    • Suggestion Boxes
    • Team Meetings
    • Random Sampling
    • Informal Feedback
    • Direct Feedback
    • Audience Body Language
    • Repeating the Message Back

    Select metrics to measure progress on key results

    There are two types of metrics that can be used to measure the impact of an internal communications strategy and progress toward strategy goals. These metrics are used to measure both outputs and outcomes.

    Select metrics measuring both:
    Tactical Effectiveness (Outputs) Strategic Effectiveness (Outcomes)
    • Open rate
    • Click-through rate
    • Employee sentiment
    • Participation rates
    • Physical distractions
    • Shift in behavior
    • Manager capability to communicate
    • Organizational ability to meet goals
    • Engagement
    • Turnover

    Pyramid of metrics to measure process on key results

    1.8 Obtain feedback and improve

    20 minutes

    1. Evenly distribute the number of rows in the communication plan to all those involved. Consider a metric that would help inform whether the communication outcome was achieved.
    2. For each row, identify a feedback mechanism (slide 38) that could be used to enable the collection and confirm a successful outcome.
    3. Come back as a group and validate the feedback mechanisms selected.
    4. The important aspect here is not just to measure if the desired outcome was achieved. However, if the desired outcome is not achieved, consider what you might do to change or enable better communication to that target audience.
    5. Every communication can be better. Feedback, whether it is tactical or strategic, will help inform methods to improve future communication activities.
    InputOutput
    • Communication outcome
    • Target audience
    • Communication channel
    • A mechanism to measure communication feedback and adjust future communications when necessary.
    MaterialsParticipants
    • Communication Planner Tool
    • Sticky notes
    • Whiteboard
    • Varies based on those who would be relevant to your initiative.

    Download the Communication Planner Tool

    Example of internal communications survey

    Use and modify the questions below when building an internal communications survey. Use a Likert scale to gauge responses.

    1. I am satisfied with the communications at our organization.
    2. I am kept fully informed of news and updates relevant to our organization.
    3. I receive information that is relevant to me on a regular basis.
    4. I have the information I need to do my job.
    5. I know where to go to find the information I am looking for.
    6. My manager communicates with me in-person on a regular basis.
    7. I feel I can believe the information I receive from the company.
    8. I feel heard by senior leaders and know that they have received my feedback.
    9. The content and information that I receive is interesting to me.

    Create an easy-to-read approach to communication

    Example of an easy-to-read approach to communication

    1.9 Finalize the calendar

    2 hours

    1. Once the information on tabs 2 and 3 of the Communication Planner Tool has been completed, start to organize the information in an easy-to-read view.
    2. Using the annual, monthly, and weekly calendar views on tabs 3 to 5, begin to formalize the dates of when communications will take place.
    3. Following the instructions on each tab, complete one or all of the views of the communication plan. Remember, the stakeholder that makes up the target audience needs to be considered and whether this communication will overlap with any other communications.
    InputOutput
    • Communication Plan on tab 2
    • Yearly, monthly, and weekly communication calendars
    MaterialsParticipants
    • Communication Planner Tool
    • Sticky notes
    • Whiteboard
    • Varies based on those who would be relevant to your initiative.

    Download the Communication Planner Tool

    Phase 2

    Compose a Compelling Message

    Activities

    2.1 Craft a Pitch
    2.2 Revise the Pitch

    This step involves the following participants:
    Varies based on those who would be relevant to your initiative.

    Outcomes of this step
    Ability to create a clear, concise, and consistent message using best practices and a pitch framework.

    Communication Any IT Initiative Effectively

    Phase 1 > Phase 2 > Phase 3

    Include all the following pieces in your message for an effective communication

    Pieces needed in your message for effective communication

    Info-Tech Insight
    Time is a non-renewable resource. The message crafted must be considered a value-add communication to your audience.

    Enable good communication with these components

    Be Consistent Be Clear
    • The core message must be consistent regardless of audience, channel, or medium.
    • Test your communication with your team or colleagues to obtain feedback before delivering to a broader audience.
    • A lack of consistency can be interpreted as an attempt at deception. This can hurt credibility and trust.
    • Say what you mean and mean what you say.
    • Choice of language is important: “Do you think this is a good idea? I think we could really benefit from your insights and experience here.” Or do you mean: “I think we should do this. I need you to do this to make it happen.”
    • Don’t use jargon.
    Be Relevant Be Concise
    • Talk about what matters to the stakeholder.
    • Talk about what matters to the initiative.
    • Tailor the details of the message to each stakeholder’s specific concerns.
    • IT thinks in processes but stakeholders only care about results: talk in terms of results.
    • IT wants to be understood, but this does not matter to stakeholders. Think: “what’s in it for them?”
    • Communicate truthfully; do not make false promises or hide bad news.
    • Keep communication short and to the point so key messages are not lost in the noise.
    • There is a risk of diluting your key message if you include too many other details.
    • If you provide more information than necessary, the clarity and consistency of the message can be lost.

    Draft the core messages to communicate

    Draft core messages communicating information consistent with the high-level communications plan. This includes the overall goal of communications, key messaging, specifics related to the change action, and customizations for each audience. It’s also important to:

    1. Hook your audience: Use a compelling introduction that ensures your target audience cares about the message. Use a statistic or another piece of information that presents the problem in a unique way.
    2. Demonstrate you can help: Let the audience know that based on the unique problem you can help. There is value to engaging and working with you further.
    3. Repeat messages several times and through several messengers and mediums throughout the change stages to ensure all audience members receive and understand the details.
    4. Write for the ear: Use concise and clear sentences, avoid technological language, and when you speak it aloud ensure it sounds like how you would normally speak.
    5. Keep messaging positive but realistic. Avoid continually telling stakeholders that “change is hard.” Instead, communicate messages around change success to positively prime the audience’s mindset (Harvard Business Review).
    6. Communicate what is meaningfully unchanged. Not everything will be impacted by the change. To help reduce fears, include information about meaningful aspects of employees’ work that will not be changing (e.g. employees are moving to report to a new manager on a new team, but the job responsibilities are staying the same).
    7. Finish with a call to action: Your concluding statement should not be a thank-you but a call to action that ignites how your audience will behave after the communication.

    Components of a good pitch

    Key Components of a Good Pitch
    Purpose of the pitch What are you asking for? What is the desired outcome of the conversation? What three things do you want the audience to take away?
    Speak to what matters to them Who is your audience and what are their biggest challenges today? What do they care? What is the “so what”? Humanize it. Start with an example of a real person.
    Sell the improvement How is your solution going to solve that problem? Is your solution a pain killer or vitamin?
    Show real value How will your solution create real value? How can that be measured? Give an example.
    Discuss potential fears Identify and alleviate fears the stakeholder may have in working with you. Think about what they think now and what you want them to think.
    Have a call to action Identify what your ask is. What are you looking for from the stakeholder? Listen and respond.
    Follow up with a thank-you Did you ensure that the participants’ time was respected and appreciated? Be genuine and sincere.

    Key questions to answer with change communication

    To effectively communicate change, answer questions before they’re asked, whenever possible. To do this, outline at each stage of the change process what’s happening next for the audience and answer other anticipated questions. Pair key questions with core messages in change communications.

    Examples of key questions by change stage include:

    What is changing?
    When is the change expected?
    Who will be championing the change?
    What are the change expectations?
    Will I have input into how the change is happening?
    What’s happening next?
    Why are we changing?
    Why is the change happening now?
    What are the risks of not changing?
    What will be new?
    What’s in it for me?
    What training will be available?
    Who will be impacted?
    How will I be impacted?
    How will my team be impacted?
    What’s happening next?
    Who should I contact with questions or concerns?
    How will I be updated?
    How can I access more information?
    Will the previous process be available throughout the new process implementation?
    What needs to be done and what needs to stop to succeed?
    Will I be measured on this change?
    What’s happening next?
    How can I access more information?
    Will this change be added to key performance indicators?
    How did the change implementation go?
    What’s happening next?
    Before change During change After change
    Prepare for change Create change action and communication plan Implement change Sustain the change

    2.1 Craft a pitch

    20 minutes

    1. Using the set of stakeholders identified in activity 1.2, every participant takes one stakeholder.
    2. Open tab 7 of the Communication Planner Tool or use a piece of paper and create a communication message specific to that stakeholder.
    3. Select a topic from your workshop or use something you are passionate about.
    4. Consider the pitch components as a way to create your pitch. Remember to use what you have learned from the planning and composing sections of this training (in bold).
    5. Compose a three-minute pitch that you will deliver to your audience member.
    InputOutput
    • Individual ideas about what change is occurring and why.
    • A single statement that reflects the change occurring and the rationale for why the change is needed.
    MaterialsParticipants
    • Communication Planner Tool
    • Sticky notes
    • Whiteboard
    • Varies based on those who would be relevant to your initiative.

    Download the Communication Planner Tool

    Communication Composition Checklist

    • Did you open the communication with a statistic or other memorable piece of information?
    • Is the topic being communicated in a compelling way that engages the target audience?
    • Are there statistics or data to support the story?
    • Are the statistics and data clear so they cannot be conveyed in any other way than their intended method?
    • Are you writing in clear and concise sentences?
    • Are you avoiding any technical jargon?
    • Is the message only focused on what needs to be said? Have you removed all unnecessary components?
    • Is the content organized in priority order? Could you adapt if the presentation time is shortened?
    • Is the way the communication is written sound like how you would speak normally? Are you writing for the ear?
    • Do you have a clear call to action that the audience will be asked to complete at the end?
    • Does your communication encourage discussion with the target audience? Is the audience a part of the solution?

    2.2 Revise the pitch

    10 minutes

    1. Review the pitch that was created in activity 2.1.
    2. Consider what could be done to make the pitch better:
      • Concise: Identify opportunities to remove unnecessary information.
      • Clear: It uses only terms or language the target audience would understand.
      • Relevant: It matters to the target audience and the problems they face.
      • Consistent: The message could be repeated across audiences.
    3. Validate that when you say the pitch out loud, it sounds like something you would say normally when communicating with other people.
    4. Make updates to the pitch and get ready to present.
    Input Output
    • Individual ideas about what change is occurring and why.
    • A single statement that reflects the change occurring and the rationale for why the change is needed.
    Materials Participants
    • Communication Planner Tool
    • Sticky notes
    • Whiteboard
    • Varies based on those who would be relevant to your initiative.

    Download the Communication Planner Tool

    Phase 3

    Deliver Messages Effectively

    Activities
    3.1 Deliver Your Pitch
    3.2 Refine and Deliver Again

    This step involves the following participants:
    Varies based on those who would be relevant to your initiative.

    Outcomes of this step
    Ability to deliver the pitch in a manner that is clear and would be understood by the specific stakeholder the pitch is intended for.

    Communicate Any IT Initiative Effectively

    Phase 1 > Phase 2 > Phase 3

    Hone presentation skills before meeting with key stakeholders

    Using voice and body

    Think about the message you are trying to convey and how your body can support that delivery. Hands, stance, and frame all have an impact on what might be conveyed.

    If you want your audience to lean in and be eager about your next point, consider using a pause or softer voice and volume.

    Be professional and confident

    State the main points of your presentation confidently. While this should be obvious, it is essential. Your audience should be able to clearly see that you believe the points you are stating.

    Present in a way that is genuine to you and your voice. Whether you have an energetic personality or a calm and composed personality, the presentation should be authentic to you.

    Connect with your audience

    Look each member of the audience in the eye at least once during your presentation. Avoid looking at the ceiling, the back wall, or the floor. Your audience should feel engaged – this is essential to keeping their attention.

    Avoid reading from your slides. If there is text on a slide, paraphrase it while maintaining eye contact.

    Info-Tech Insight
    You are responsible for the response of your audience. If they aren’t engaged, it is on you as the communicator.

    Use clear slides that avoid distracting the audience

    Which slide will be better to present?

    Sample A:

    Sample A

    Sample B:

    Sample B

    3.1 Deliver your pitch

    20 minutes

    1. Take ten minutes to think about how to deliver your pitch. Where will you emphasize words, speak louder, softer, lean in, stand tall, make eye contact, etc.?
    2. Group into pairs. One person is the speaker and the other the audience.
    3. Set a timer on your phone or watch.
    4. Speaker:
      1. Take a few seconds to center yourself and prepare to deliver your pitch.
      2. Deliver your pitch to Person 2. Don’t forget to use your body language and your voice to deliver.
    5. Audience:
      1. Repeats ideas back to Person 1. Are the ideas correct? Are you convinced?
      2. Identifies who the audience is. Are they correct?
    6. Reverse roles and repeat.
    7. Discuss and provide feedback to one another.
    InputOutput
    • Written pitch
    • Best practices for delivering
    • An ability to deliver the pitch in a clear and concise manner that could be understood by the intended stakeholder.
    • Feedback from person 2.
    MaterialsParticipants
    • Pitch framework
    • Communications Plan Tool
    • Piece of paper
    • Varies based on those who would be relevant to your initiative.

    Communication Delivery Checklist

    • Are the slides clean so the audience can focus on your speaking and not on reading the context-heavy slide?
    • Have you practiced delivering the communication to team members or coaches?
    • Have you practiced delivering the communication to someone with little to no technology background?
    • Are you making yourself open to feedback and improvement opportunities?
    • If the communication is derailed from your plan, are you prepared to handle that change?
    • Can you deliver the communication without reading your notes word for word?
    • Have you adapted your voice throughout the communication to highlight specific components you want the audience to focus on?
    • Are you presenting in a way that is genuine to you and your personality?
    • Can you communicate the message within the time allotted?
    • Are you moving in an appropriate manner based on your communication (e.g. toward the screen, across the stage, hand gestures).

    3.2 Refine and deliver again

    1 hour

    1. Go back to what you wrote as your pitch and take ten minutes to eliminate more information to get the pitch down to two minutes based on the feedback from your original partner.
    2. Repeat the last exercise where you deliver your pitch; however, deliver it to the larger group this time.
    3. Focus on ways to adjust body language and voice to make the message more compelling.
    4. Identify if your audience is telling you anything with their body language (e.g. leaning in, leaning back). Use this to adjust as you are presenting.
    5. Have the group provide additional feedback on what was effective about the message and opportunities to further improve the message.
    InputOutput
    • Three-minute pitch
    • Feedback from first delivery
    • An ability to deliver the pitch in a clear and concise manner that could be understood by the intended stakeholder.
    MaterialsParticipants
    • Pitch framework
    • Communications Plan Tool
    • Piece of paper
    • Varies based on those who would be relevant to your initiative.

    Info-Tech Insight
    Whether the CIO or a service desk technician, delivering a presentation is a fear for every role in IT. Prepare your communication to help overcome the fears that are within your control.

    Research Contributors and Experts

    Anuja Agrawal, National Communications Director, PwC

    Anuja Agrawal
    National Communications Director
    PwC

    Anuja is an accomplished global communications professional, with extensive experience in the insurance, banking, financial, and professional services industry in Asia, the US, and Canada. She is currently the National Communications Director at PwC Canada. Her prior work experience includes communication leadership roles at Deutsche Bank, GE, Aviva, and Veritas. Anuja works closely with senior business leaders and key stakeholders to deliver measurable results and effective change and culture building programs. Anuja has experience in both internal and external communications, including strategic leadership communication, employee engagement, PR and media management, digital and social media, M&A/change and crisis management. Anuja believes in leveraging digital tools and technology-enabled solutions combined with in-person engagement to help improve the quality of dialogue and increase interactive communication within the organization to help build an inclusive culture of belonging.

    Nastaran Bisheban, Chief Technology Officer, KFC Canada

    Nastaran Bisheban
    Chief Technology Officer
    KFC Canada

    A passionate technologist and seasoned transformational leader. A software engineer and computer scientist by education, a certified Project Manager that holds an MBA in Leadership with Honors and Distinction from University of Liverpool. A public speaker on various disciplines of technology and data strategy with a Harvard Business School executive leadership program training to round it all. Challenges status quo and conventional practices; is an advocate for taking calculated risk and following the principle of continuous improvement. With multiple computer software and project management publications she is a strategic mentor and board member on various non-profit organizations. Nastaran sees the world as a better place only when everyone has a seat at the table and is an active advocate for diversity and inclusion.

    Heidi Davidson, Co-founder & CEO, Galvanize Worldwide and Galvanize On Demand

    Heidi Davidson
    Co-founder & CEO
    Galvanize Worldwide and Galvanize On Demand

    Dr. Heidi Davidson is the Co-Founder and CEO of Galvanize Worldwide, the largest distributed network of marketing and communications experts in the world. She also is the Co-Founder and CEO of Galvanize On Demand, a tech platform that matches marketing and communications freelancers with client projects. Now with 167 active experts, the Galvanize team delivers startup advisory work, outsourced marketing, training, and crisis communications to organizations of all sizes. Before Galvanize, Heidi spent four years as part of the turnaround team at BlackBerry as the Chief Communications Officer and SVP of Corporate Marketing, where she helped the company move from a device manufacturer to a security software provider.

    Eli Gladstone, Co-founder, Speaker Labs

    Eli Gladstone
    Co-Founder
    Speaker Labs

    Eli is a Co-Founder of Speaker Labs. He has spent over 6 years helping countless individuals overcome their public speaking fears and communicate with clarity and confidence. When he's not coaching others on how to build and deliver the perfect presentation, you'll probably find him reading some weird books, teaching his kids how to ski or play tennis, or trying to develop a good enough jumpshot to avoid being a liability on the basketball court.

    Francisco Mahfuz, Keynote Speaker & Storytelling Coach

    Francisco Mahfuz
    Keynote Speaker & Storytelling Coach

    Francisco Mahfuz has been telling stories in front of audiences for a decade, and even became a National Champion of public speaking. Today, Francisco is a keynote speaker and storytelling coach and offers communication training to individuals and international organisations, and has worked with organisations like Pepsi, HP, the United Nations, Santander and Cornell University. He's the author of Bare: A Guide to Brutally Honest Public Speaking, the host of The Storypowers Podcast, and he’s been part of the IESE MBA communications course since 2020. He's received a BA in English Literature from Birkbeck University in London.

    Sarah Shortreed, EVP & CTO, ATCO Ltd.

    Sarah Shortreed
    EVP & CTO
    ATCO Ltd.

    Sarah Shortreed is ATCO’s Executive Vice President and Chief Technology Officer. Her responsibilities include leading ATCO’s Information Technology (IT) function as it continues to drive agility and collaboration throughout ATCO’s global businesses and expanding and enhancing its enterprise IT strategy, including establishing ATCO’s technology roadmap for the future. Ms. Shortreed's skill and expertise are drawn from her more than 30-year career that spans many industries and includes executive roles in business consulting, complex multi-stakeholder programs, operations, sales, customer relationship management and product management. She was recently the Chief Information Officer at Bruce Power and has previously worked at BlackBerry, IBM and Union Gas. She sits on the Board of Governors for the University of Western Ontario and is the current Chair of the Chief Information Officer (CIO) Committee at the Conference Board of Canada.

    Eric Silverberg, Co-Founder Speaker Labs

    Eric Silverberg
    Co-Founder
    Speaker Labs

    Eric is a Co-Founder of Speaker Labs and has helped thousands of people build their public speaking confidence and become more dynamic and engaging communicators. When he's not running workshops to help people grow in their careers, there's a good chance you'll find him with his wife and dog, drinking Diet Coke and rewatching iconic episodes of the reality TV show Survivor! He's such a die-hard fan, that you'll probably see him playing the game one day.

    Stephanie Stewart, Communications Officer & DR Coordinator, Info Security Services Simon Fraser University

    Stephanie Stewart
    Communications Officer & DR Coordinator
    Info Security Services Simon Fraser University

    Steve Strout, President, Miovision Technologies

    Steve Strout
    President
    Miovision Technologies

    Mr. Strout is a recognized and experienced technology leader with extensive experience in delivering value. He has successfully led business and technology transformations by leveraging many dozens of complex global SFDC, Oracle and/or SAP projects. He is especially adept at leading what some call “Project Rescues” – saving people’s careers where projects have gone awry; always driving "on-time and on-budget.“ Mr. Strout is the current President of Miovision Technologies and the former CEO and board member of the Americas’ SAP Users’ Group (ASUG). His wealth of practical knowledge comes from 30 years of extensive experience in many CxO and executive roles at some prestigious organizations such as Vonage, Sabre, BlackBerry, Shred-it, The Thomson Corporation (now Thomson Reuters) and Morris Communications. Served on Boards including Customer Advisory Boards of Apple, AgriSource Data, Dell, Edgewise, EMC, LogiSense, Socrates.ai, Spiro Carbon Group, and Unifi.

    Info-Tech Research Group Contributors:
    Sanchia Benedict, Research Lead
    Koula Bouloukos, Production Manager
    Antony Chan, Executive Counsellor
    Janice Clatterbuck, Executive Counsellor
    Ahmed Jowar, Research Specialist
    Dave Kish, Practice Lead
    Nick Kozlo, Senior Research Analyst
    Heather Leier Murray, Senior Research Analyst
    Amanda Mathieson, Research Director
    Carlene McCubbin, Practice Lead
    Joe Meier, Executive Counsellor
    Andy Neill, AVP, Research
    Thomas Randall, Research Director

    Plus an additional two contributors who wish to remain anonymous.

    Related Info-Tech Research

    Boardroom Presentation Review

    • You will come away with a clear, concise, and compelling board presentation that IT leaders can feel confident presenting in front of their board of directors.
    • Add improvements to your current board presentation in terms of visual appeal and logical flow to ensure it resonates with your board of directors.
    • Leverage a best-of-breed presentation template.

    Build a Better Manager

    • Management skills training is needed, but organizations are struggling to provide training that makes a long-term difference in the skills managers actually use in their day to day.
    • Many training programs are ineffective because they offer the wrong content, deliver it in a way that is not memorable, and are not aligned with the IT department’s business objectives.

    Crisis Communication Guides

    During a crisis it is important to communicate to employees through messages that convey calm and are transparent and tailored to your audience. Use the Crisis Communication Guides to:

    • Draft a communication strategy.
    • Tailor messages to your audience.
    • Draft employee crisis communications.

    Use this guide to equip leadership to communicate in times of crisis.

    Bibliography

    Gallo, Carmine. "How Great Leaders Communicate." Harvard Business Review. 23 November 2022.

    Gallup. State of the American Workplace Report. Washington, D.C.: Gallup, 6 February 2020.

    Guthrie, Georgina. “Why Good Internal Communications Matter Now More than Ever.” Nulab. 15 Dec. 2021.

    Hypercontext. “The State of High Performing Teams in Tech 2022.” Hypercontext. 2022.

    Lambden, Duncan. “The Importance of Effective Workplace Communication – Statistics for 2022.” Expert Market. 13 June 2022.

    McCreary, Gale & WikiHow. “How to Measure the Effectiveness of Communication: 14 Steps.” WikiHow.

    Nowak, Marcin. “Top 7 Communication Problems in the Workplace.” MIT Enterprise Forum CEE, 2021.

    Nunn, Philip. “Messaging That Works: A Unique Framework to Maximize Communication Success.” iabc.

    Picincu, Andra. “How to Measure Effective Communications.” Small Business Chron. 12 January 2021.

    Price. David A. “Pixar Story Rules.”

    Prosci. “Best Practices in Change Management 2020 Edition.” Prosci, 2020.

    Roberts, Dan. “How CIOs Become Visionary Communicators.” CIO, 2019.

    Schlesinger, Mark. “Why building effective communication skill in IT is incredibly important.”

    Skills Framework for the Information Age, “Mapping SFIA Levels of Responsibilities to Behavioural Factors.” Skills Framework for the Information Age, 2021.

    St. James, Halina. Talk It Out. Podium, 2005.

    TeamState. “Communication in the Workplace Statistics: Importance and Effectiveness in 2022.” TeamStage, 2022.

    Walters, Katlin. “Top 5 Ways to Measure Internal Communication.” Intranet Connections, 30 May 2019.

    Build Your Enterprise Application Implementation Playbook

    • Buy Link or Shortcode: {j2store}605|cart{/j2store}
    • member rating overall impact: N/A
    • member rating average dollars saved: N/A
    • member rating average days saved: N/A
    • Parent Category Name: Selection & Implementation
    • Parent Category Link: /selection-and-implementation
    • Given the increasing complexity of software implementations, you are continually challenged with staying above water with your current team.
    • In addition, rapid changes in the business make maintaining project sponsors’ engagement challenging.
    • Project sprawl across the organization has created a situation where each project lead tracks progress in their own way. This makes it difficult for leadership to identify what was successful – and what wasn’t.

    Our Advice

    Critical Insight

    An effective enterprise application implementation playbook is not just a list of steps, but a comprehensive view of what is necessary to support your implementation. This starts with a people-first approach. Start by asking about sponsors, stakeholders, and goals. Without asking these questions first, the implementation will be set up for failure, regardless of the technology, processes, and tools available.

    Impact and Result

    Follow these steps to build your enterprise application playbook:

    • Define your sponsor, map out your stakeholders, and lay out the vision, goals and objectives for your project.
    • Detail the scope, metrics, and the team that will make it happen.
    • Outline the steps and processes that will carry you through the implementation.

    Build Your Enterprise Application Implementation Playbook Research & Tools

    Besides the small introduction, subscribers and consulting clients within this management domain have access to:

    1. Build Your Enterprise Application Implementation Playbook Deck - Your implementation doesn’t start with technology, but with an effective plan that the team can align on.

    This blueprint provides the steps necessary to build your own enterprise application implementation playbook that can be deployed and leveraged by your implementation teams.

    • Build Your Enterprise Application Implementation Playbook – Phases 1-3

    2. Your Enterprise Application Implementation Playbook – The key output from leveraging this research is a completed implementation playbook.

    This is the main playbook that you build through the exercises defined in the blueprint.

    • Your Enterprise Application Implementation Playbook

    3. Your Enterprise Application Implementation Playbook - Timeline Tool – Supporting tool that captures the project timeline information, issue log, and follow-up dashboard.

    This tool provides input into the playbook around project timelines and planning.

    • Your Enterprise Application Implementation Playbook - Timeline Tool

    4. Light Project Change Request Form Template – This tool will help you record the requested change, allow assess the impact of the change and proceed the approval process.

    This provides input into the playbook around managing change requests

    • Light Project Change Request Form Template

    Infographic

    Workshop: Build Your Enterprise Application Implementation Playbook

    Workshops offer an easy way to accelerate your project. If you are unable to do the project yourself, and a Guided Implementation isn't enough, we offer low-cost delivery of our project workshops. We take you through every phase of your project and ensure that you have a roadmap in place to complete your project successfully.

    1 Understand the Project

    The Purpose

    Lay out the overall objectives, stakeholders, and governance structure for the project.

    Key Benefits Achieved

    Align everyone on the sponsor, key stakeholders, vision, and goals for your project

    Activities

    1.1 Select the project sponsor.

    1.2 Identify your stakeholders.

    1.3 Align on a project vision.

    1.4 List your guiding principles.

    1.5 Confirm your goals and objectives for the implementation project.

    1.6 Define the project governance structure.

    Outputs

    Project sponsor has been selected.

    Project stakeholders have been identified and mapped with their roles and responsibilities.

    Vision has been defined.

    Guiding principles have been defined.

    Articulated goals and objectives.

    Detailed governance structure.

    2 Set up for Success

    The Purpose

    Define the elements of the playbook that provide scope and boundaries for the implementation.

    Key Benefits Achieved

    Align the implementation team on the scope for the project and how the team should operate during the implementation.

    Activities

    2.1 Gather and review requirements, with an agreed to scope.

    2.2 Define metrics for your project.

    2.3 Define and document the risks that can impact the project.

    2.4 Establish team composition and identify the team.

    2.5 Detail your OCM structure, resources, roles, and responsibilities.

    2.6 Define requirements for training.

    2.7 Create a communications plan for stakeholder groups and delivery teams.

    Outputs

    Requirements for enterprise application implementation with an agreed-to scope.

    Metrics to help measure what success looks like for the implementation.

    Articulated list of possible risks during the implementation.

    The team responsible and accountable for implementation is identified.

    Details of your organization’s change management process.

    Outline of training required.

    An agreed-to plan for communication of project status.

    3 Document Your Plan

    The Purpose

    With the structure and boundaries in place, we can now lay out the details on the implementation plan.

    Key Benefits Achieved

    A high-level plan is in place, including next steps and a process on running retrospectives.

    Activities

    3.1 Define your implementation steps.

    3.2 Create templates to enable follow-up throughout the project.

    3.3 Decide on the tracking tools to help during your implementation.

    3.4 Define the follow-up processes.

    3.5 Define project progress communication.

    3.6 Create a Change request process.

    3.7 Define your retrospective process for continuous improvement.

    3.8 Prepare a closure document for sign-off.

    Outputs

    An agreed to high-level implementation plan.

    Follow-up templates to enable more effective follow-ups.

    Shortlist of tracking tools to leverage during the implementation.

    Defined processes to enable follow-up.

    Defined project progress communication.

    A process for managing change requests.

    A process and template for running retrospectives.

    A technique and template for closure and sign-off.

    Further reading

    Build Your Enterprise Application Implementation Playbook

    Your implementation doesn’t start with technology, but with an effective plan that the team can align on.

    Analyst Perspective

    Your implementation is not just about technology, but about careful planning, collaboration, and control.

    Recardo de Oliveira

    A successful enterprise application implementation requires more than great software; it requires a clear line of sight to the people, processes, metrics, and tools that can help make this happen.

    Additionally, every implementation is unique with its own set of challenges. Working through these challenges requires a tailored approach taking many factors into account. Building out your playbook for your implementation is an important initial step before diving head-first into technology.

    Regardless of whether you use an implementation partner, a playbook ensures that you don’t lose your enterprise application investment before you even get started!

    Ricardo de Oliveira

    Research Director,
    Application Delivery and Management
    Info-Tech Research Group

    Executive Summary

    Your Challenge

    • Given the increasing complexity of software implementations, you are continually challenged with staying above water with your current team.
    • Rapid changes in the business make maintaining project sponsors’ engagement challenging.
    • Project sprawl across the organization has created a situation where project leads track progress in their own way. This makes it difficult for leadership to identify what was successful (and what wasn’t).

    Common Obstacles

    • Your best process experts are the same people you need to keep the business running. The business cannot afford to have its best people pulled into the implementation for long periods of time.
    • Enterprise application implementations generate huge organizational changes and the adoption of the new systems and processes resulting from these projects are quite difficult.
    • People are generally resistant to change, especially large, transformational changes that will impact the day-to-day way of doing things.

    Info-Tech's Approach

    • Build your enterprise application implementation playbook. Follow these steps to build your enterprise application playbook:
      • Define your sponsor, map out your stakeholders, and lay out the vision, goals, and objectives for your project.
      • Detail the scope, metrics, and the team that will make it happen.
      • Detail the steps and processes that will carry you through the implementation

    Info-Tech Insight

    An effective enterprise application implementation playbook is not just a list of steps; it is a comprehensive view of what is necessary to support your implementation. This starts with a people-first approach. Start by asking about sponsors, stakeholders, and goals. Without asking these questions first, the implementation will be set up for failure, regardless of the technology, processes, and tools available.

    Enterprise Applications Lifescycle Advisory Services. Strategy, selection, implementation, optimization and operations.

    Insight summary

    Building an effective playbook starts with asking the right questions, not jumping straight into the technical details.

    • This blueprint provides the steps required to lay out an implementation playbook to align the team on what is necessary to support the implementation.
    • Build your Enterprise Application Implementation Playbook by:
      • Aligning and confirming project’s goals, stakeholders, governance and team.
      • Clearly defining what is in and out of scope for the project and the risks involved.
      • Building up a strong change management process.
      • Providing the tools and processes to keep track of the project.
      • Pulling it all together into an actionable playbook.

    Grapsh showing 39%

    Lack of planning is the reason that 39% of projects fail. Poor project planning can be disastrous: The consequences are usually high costs and time overruns.

    Graph showing 20%

    Almost 20% of IT projects can fail so badly that they can become a threat to a company’s existence. Lack of proper planning, poor communication, and poorly defined goals all contribute to the failure of projects.

    Graph showig 2.5%

    A PwC study of over 10,640 projects found that a tiny portion of companies – 2.5% – completed 100% of their projects successfully. These failures extract a heavy cost – failed IT projects alone cost the United States $50-$150B in lost revenue and productivity.

    Source: Forbes, 2020

    Planning and control are key to enterprise project success

    An estimated 70% of large-scale corporate projects fail largely due to a lack of change management infrastructure, proper oversight, and regular performance check-ins to track progress (McKinsey, 2015).

    Table showing that 88% of projects completed on time, 90% completed within budget and 92% meet original goals. 68% of projects have scope creep, 24% deemed failures and 46% experience budget lose when project fails

    “A survey published in HBR found that the average IT project overran its budget by 27%. Moreover, at least one in six IT projects turns into a ‘black swan’ with a cost overrun of 200% and a schedule overrun of 70%. Kmart’s massive $1.2B failed IT modernization project, for instance, was a big contributor to its bankruptcy.”

    Source: Forbes, 2020

    Sponsor commitment directly improves project success.

    Having the right sponsor significantly improves your chances of success across many different dimensions:

    1. On-time delivery
    2. Delivering within budget
    3. Delivered within an agreed-to scope
    4. Delivered with sufficient quality.
    Graph that shows Project success scores versus sponsor involvement in change communication. Shows increase for projects on time, projects on budget, within scope and overall quality.

    Source: Info-Tech, PPM Current State Scorecard Diagnostic

    Executive Brief Case Study

    Chocolate manufacturer implementing a new ERP

    INDUSTRY

    Consumer Products

    SOURCE

    Carlton, 2021

    Challenge

    Not every ERP ends in success. This case study reviews the failure of Hershey, a 147-year-old confectioner, headquartered in Hershey Pennsylvania. The enterprise saw the implementation of an ERP platform as being central to its future growth.

    Solution

    Consequently, rather than approaching its business challenge on the basis of an iterative approach, it decided to execute a holistic plan, involving every operating center in the company. Subsequently, SAP was engaged to implement a $10 million systems upgrade; however, management problems emerged immediately.

    Results

    The impact of this decision was significant, and the company was unable to conduct business because virtually every process, policy, and operating mechanism was in flux simultaneously. The consequence was the loss of $150 million in revenue, a 19% reduction in share price, and the loss of 12% in international market share.

    Remember: Poor management can scupper implementation, even when you have selected the perfect system.

    A successful software implementation provides more than simply immediate business value…

    It can build competitive advantage.

    • When software projects fail, it can jeopardize an organization’s financial standing and reputation, and in some severe cases, it can bring the company down altogether.
    • Rarely do projects fail for a single reason, but by understanding the pitfalls, developing a risk mitigation plan, closely monitoring risks, and self-evaluating during critical milestones, you can increase the probability of delivering on time, on budget, and with the intended benefits.

    Benefits are not limited to just delivering on time. Some others include:

    • Building organizational delivery competence and overall agility.
    • The opportunity to start an inventory of best practices, eventually building them into a center of excellence.
    • Developing a competitive advantage by maximizing software value and continuously transforming the business.
    • An opportunity to develop a competent pool of staff capable of executing on projects and managing organizational change.

    Blueprint deliverables

    Each step of this blueprint is accompanied by supporting deliverables to help you accomplish your goals:

    Your Enterprise Application Implementation Playbook – Timeline Tool

    Supporting template that captures the project timeline information, issue log, and follow-up dashboard.

    Info-Tech: Project Planning and Monitoring Tool.
    Light Project Change Request Form Template

    This tool will help you record the requested change, and allow you to assess the impact of the change and proceed with the approval process.

    Info-Tech: Light change request form template.

    Key deliverable:

    Your Enterprise Application Implementation Playbook

    Record the results from the exercises to define the steps for a successful implementation.

    Build your enterprise application implementation playbook.

    Info-Tech’s methodology for Your Enterprise Application Implementation Playbook

    Phase Steps

    1. Understand the Project

    1. Identify the project sponsor
    2. Define project stakeholders
    3. Review project vision and guiding principles
    4. Review project objectives
    5. Establish project governance

    2. Set up for success

    1. Review project scope
    2. Define project metrics
    3. Prepare for project risks
    4. Identify the project team
    5. Define your change management process

    3. Document your plan

    1. Develop a master project plan
    2. Define a follow-up plan
    3. Define the follow-up process
    4. Understand what’s next
    Phase Outcomes
    • Project sponsor has been selected
    • Project stakeholders have been identified and mapped with their roles and responsibilities.
    • Vision, guiding principles, goals objectives, and governance have been defined
    • Project scope has been confirmed
    • Project metrics to identify successful implementation has been defined
    • Risks have been assessed and articulated.
    • Identified project team
    • An agreed-to change management process
    • Project plan covering the overall implementation is in place, including next steps and retrospectives

    Info-Tech offers various levels of support to best suit your needs

    DIY Toolkit

    "Our team has already made this critical project a priority, and we have the time and capability, but some guidance along the way would be helpful."

    Guided Implementation

    "Our team knows that we need to fix a process, but we need assistance to determine where to focus. Some check-ins along the way would help keep us on track."

    Workshop

    "We need to hit the ground running and get this project kicked off immediately. Our team has the ability to take this over once we get a framework and strategy in place."

    Consulting

    "Our team does not have the time or the knowledge to take this project on. We need assistance through the entirety of this project."

    Diagnostic and consistent frameworks are used throughout all four options.

    Guided Implementation

    What does a typical GI on this topic look like?

    The three phases of guided implementation.

    A Guided Implementation (GI) is a series of calls with an Info-Tech analyst to help implement our best practices in your organization. A typical GI is between 8 to 12 calls over the course of 4 to 6 months.

    Workshop Overview

    Contact your account representative for more information.

    workshops@infotech.com 1-888-670-8889 Activities and deliverables for each module of the workshop. Module 1: understanding the project, Module 2: Set up for success, Modeule 3: Document your plan, and Post Workshop: Next steps and Wrap-up(offsite).

    Phase 1

    Understand the project

    3 phases, phase 1 is highlighted.

    This phase will walk you through the following activities:

    1.1 Identify the project sponsor

    1.2 Identify project stakeholders

    1.3 Review project vision and guiding principles

    1.4 Review project objectives

    1.5 Establish project governance

    This phase involves the following participants:

    • Project team
    • Operations
    • SMEs
    • Team lead and facilitators
    • IT leaders

    Step 1.1

    Identify the project sponsor

    Activities

    1.1.1 Define the project sponsor's responsibilities

    1.1.2 Shortlist potential sponsors

    1.1.3 Select the project sponsor

    This step involves the following participants:

    • Project team
    • Operations
    • SMEs
    • Team lead and facilitators
    • IT leaders

    Outcomes of this step

    Selected sponsor.

    Sponsor commitment directly improves project success.

    Having the right sponsor significantly improves your chances of success across many different dimensions:

    1. On-time delivery
    2. Delivering within budget
    3. Delivered within an agreed-to scope
    4. Delivered with sufficient quality.

    Graph that shows Project success scores versus sponsor involvement in change communication. Shows increase for projects on time, projects on budget, within scope and overall quality.

    Source: Info-Tech, PPM Current State Scorecard Diagnostic

    Typical project sponsor responsibilities

    • Help define the business goals of their projects before they start.
    • Provide guidance and support to the project manager and the project team throughout the project management lifecycle.
    • Ensure that sufficient financial resources are available for their projects.
    • Resolve problems and issues that require authority beyond that of the project manager.
    • Ensure that the business objectives of their projects are achieved and communicated.

    For further discussion on sponsor responsibilities, use Info-Tech’s blueprint, Drive Business Value With a Right-Sized Project Gating Process

    Portrait of head with multiple layers representing the responsibilities of a sponsor. From top down: Define business goals, provide guidance, ensure human ad financial resources, resolve problems and issues.

    1.1.1 Define the project sponsor’s responsibilities

    0.5-1 hour

    1. Discuss the minimum requirements for a sponsor at your organization.
    2. As a group, brainstorm the criteria necessary for an individual to be a project sponsor:
      1. Is there a limit to the number of projects they can sponsor at one time?
      2. Is there a minimum number of hours they must be available to the project team?
      3. Do they have to be at a certain seniority level in the organization?
      4. What is their role at each stage of the project lifecycle?
    3. Document these criteria on a whiteboard.
    4. Record the sponsor’s responsibilities in section 1.1 of Info-Tech’s Your Enterprise Application Implementation Playbook.

    Download Your Enterprise Application Implementation Playbook

    Input

    Output

    • Requirements for a sponsor
    • Your responsibilities as a sponsor

    Materials

    Participants

    • Whiteboard/flip charts
    • Your Enterprise Application Implementation Playbook
    • Project team
    • Operations
    • SMEs
    • Team lead and facilitators
    • IT leaders

    1.1.1 Define the project sponsor’s responsibilities (Continued)

    Example

    Project sponsor responsibilities.

    1.1.2 Shortlist potential sponsors

    0.5-1 hour

    1. Based on the responsibilities defined in Exercise 1.1.1, produce a list of the potential sponsors.
    2. Record the sponsor’s shortlist in section 1.2 of Info-Tech’s Your Enterprise Application Implementation Playbook.

    Download Your Enterprise Application Implementation Playbook

    Input

    Output

    • Characteristics of a sponsor
    • Your list of candidates

    Materials

    Participants

    • Whiteboard/flip charts
    • Your Enterprise Application Implementation Playbook
    • Project team
    • Operations
    • SMEs
    • Team lead and facilitators
    • IT leaders

    1.1.2 Shortlist potential sponsors (Continued)

    Example

    Shortlist of potential sponsors. 6 names listed with checkmarks on criteria ranking.

    Don’t forget, the project team is there to support the sponsor

    Given the burden of the sponsor role, the project team is committed to doing their best to facilitate a successful outcome.

    Project Success: Follow best practices, escalate issues, stay focused, communicate, adapt to change.

    • Follow the framework set out by the governance group at the organization to drive efficiency on the project.
    • Ensure stakeholders with proper authority are notified of issues that occur during the project.
    • Stay focused on the project tasks to drive quality on the deliverables and avoid rework after the project.
    • Communicate within the project team to drive coordination of tasks, complete deliverables, and avoid resource waste.
    • Changes are more common than not; the team must be prepared to adjust plans and stay agile to adapt to changes for the project.

    Seek the key characteristics of a sponsor

    Man walking up stairs denoting characteristics of a good sponsor. First step: Leader, second step: Strong Communicator, third step: knowledgeable, fourth step: problem solver, fifth step: delegator, final step: dedicated.

    1.1.3 Select the project sponsor

    0.5-1 hour

    1. Review the characteristics and the list of potential candidates.
    2. Assess availability, suitability, and desire of the selected sponsor.
    3. Record the selected sponsor in section 1.3 of Info-Tech’s Your Enterprise Application Implementation Playbook.

    Download Your Enterprise Application Implementation Playbook

    Input

    Output

    • List of candidates
    • Characteristics of a sponsor
    • Your selected sponsor

    Materials

    Participants

    • Whiteboard/flip charts
    • Your Enterprise Application Implementation Playbook
    • Project team
    • Operations
    • SMEs
    • Team lead and facilitators
    • IT leaders

    1.1.3 Select the project sponsor (Continued)

    Example

    Name of example sponsor with their key traits listed.

    Step 1.2

    Identify the project stakeholders

    Activities

    1.2.1 Identify your stakeholders

    This step involves the following participants:

    • Project team
    • Operations
    • SMEs
    • Team lead and facilitators
    • IT leaders

    Outcomes of this step

    Stakeholders’ management plan

    How to find the right stakeholders

    Start with the obvious candidates, but keep an open mind.

    How to find stakeholders

    • Talk to your stakeholders and ask who else you should be talking to, to discover additional stakeholders and ensure you don’t miss anyone.
    • Less obvious stakeholders can be found by conducting various types of trace analysis, i.e. following various paths flowing from your initiative through to the path’s logical conclusion.

    Create a stakeholder network map for your application implementation

    Follow the trail of breadcrumbs from your direct stakeholders to their influencers to uncover hidden stakeholders.

    Stakeholder network map showing direction of professional influence as well as bidirectional, informal influence relationships.

    Info-Tech Insight

    Your stakeholder map defines the influence landscape your enterprise application operates in. It is every bit as important as the teams who enhance, support, and operate your applications directly.

    Use connectors to determine who may be influencing your direct stakeholders. They may not have any formal authority within the organization, but they may have substantial informal relationships with your stakeholders.

    Understand how to navigate the complex web of stakeholders

    Identify which stakeholders to include and what their level of involvement should be during requirements elicitation based on relevant topic expertise.

    Graph showing influence vs. interest, divided into 4 quadrants. Low influence and intersest is labeled: Monitor, low influence and high interest is labeled: Keep informed, High influence and low interest is labeled: Keep satisfied, and high influence and high interest is labeled: Involve closely

    Large-scale projects require the involvement of many stakeholders from all corners and levels of the organization, including project sponsors, IT, end users, and business stakeholders. Consider the influence and interest of stakeholders in contributing to the requirements elicitation process and involve them accordingly.

    Map the organization’s stakeholders

    List of various stakeholder titles. As well as a graph showing the influence vs involvement of each stakeholder title. Influence and interest is divided into 4 quadrants: Monitor, Keep informed, keep satisfied, and involve closely.

    1.2.1 Identify your stakeholders

    1-2 hours

    1. As a group, identify all the project stakeholders. A stakeholder may be an individual such as the CEO or CFO, or it may be a group such as front-line employees.
    2. Map each stakeholder on the quadrant based on their expected influence and involvement in the project
    3. Identify stakeholders and add them to the list.
    4. Record the stakeholders list in section 1.4 of Info-Tech’s Your Enterprise Application Implementation Playbook.
    5. Download Your Enterprise Application Implementation Playbook

      Input

      Output

      • Types of stakeholders
      • Your stakeholders initial list

      Materials

      Participants

      • Whiteboard/flip charts
      • Your Enterprise Application Implementation Playbook
      • Project team
      • Operations
      • SMEs
      • Team lead and facilitators
      • IT leaders

    1.2.1 Identify your stakeholders(Continued)

    Example

    Table with rows of stakeholders: Customer, End Users, IT, Vendor and other listed. Columns provide: description, examples, value and involvement level of each stakeholder.

    Step 1.3

    Review project vision and guiding principles

    Activities

    1.3.1 Align on a project vision

    1.3.2 List your guiding principles

    This step involves the following participants:

    • Project team
    • Operations
    • SMEs
    • Team lead and facilitators
    • IT leaders

    Outcomes of this step

    Project vision and guiding principles

    Vision and guiding principles

    GUIDING PRINCIPLES

    Guiding principles are high-level rules of engagement that help to align stakeholders from the outset. Determine guiding principles to shape the scope and ensure stakeholders have the same vision.

    Creating Guiding Principles

    Guiding principles should be constructed as full sentences. These statements should be able to guide decisions.

    EXAMPLES
    • [Organization] is implementing an ERP system to streamline processes and reduce redundancies, saving time and money.
    • [Organization] is implementing an ERP to integrate disparate systems and rationalize the application portfolio.
    • [Organization] is aiming at taking advantage of industry best practices and strives to minimize the level of customization required in solution.

    Questions to Ask

    1. What is a strong statement that will help guide decision making throughout the life of the ERP project?
    2. What are your overarching requirements for business processes?
    3. What do you ultimately want to achieve?
    4. What is a statement that will ensure all stakeholders are on the same page for the project?

    1.3.1 Align on a project vision

    1-2 hours

    1. As a group, discuss whether you want to create a separate project vision statement or restate your corporate vision and/or goals.
      1. A project vision statement will provide project-guiding principles, encompass the project objectives, and give a rationale for the project.
      2. Using the corporate vision/goals will remind the business and IT that the project is to implement an enterprise application that supports and enhances the organizational objectives.
    2. Record the project vision in section 1.5 of Info-Tech’s Your Enterprise Application Implementation Playbook.

    Download Your Enterprise Application Implementation Playbook

    Input

    Output

    • Project vision statement defined during strategy building
    • Your project vision

    Materials

    Participants

    • Whiteboard/flip charts
    • Your Enterprise Application Implementation Playbook
    • Project team
    • Operations
    • SMEs
    • Team lead and facilitators
    • IT leaders

    1.3.1 Align on a project vision (Continued)

    Example

    Project Vision

    We, [Organization], will select and implement an integrated software suite that enhances the growth and profitability of the organization through streamlined global business processes, real-time data-driven decisions, increased employee productivity, and IT investment protection.

    Guiding principles examples

    The guiding principles will help guide your decision-making process. These can be adjusted to align with your internal language.

    • Support business agility: A flexible and adaptable integrated business system providing a seamless user experience.
    • Use best practices: Do not recreate or replicate what we have today; focus on modernization. Exercise customization governance by focusing on those customizations that are strategically differentiating.
    • Automate: Take manual work out where we can, empowering staff and improving productivity through automation and process efficiencies.
    • Stay focused: Focus on scope around core business capabilities. Maintain scope control. Prioritize demand in line with the strategy.
    • Strive for "one source of truth": Unify data model and integrate processes where possible. Assess integration needs carefully.

    1.3.2 List your guiding principles

    1-2 hours

    1. Start with the guiding principles defined during the strategy building.
    2. Review each of the sample guiding principles provided and ask the following questions:
      1. Do we agree with the statement?
      2. Is this statement framed in the language we use internally? Does everyone agree on the meaning of the statement?
      3. Will this statement help guide our decision-making process?
    3. Record the guiding principles in section 1.6 of Info-Tech’s Your Enterprise Application Implementation Playbook.

    Download Your Enterprise Application Implementation Playbook

    Input

    Output

    • Guiding principles defined during strategy building
    • Your guiding principles

    Materials

    Participants

    • Whiteboard/flip charts
    • Your Enterprise Application Implementation Playbook
    • Project team
    • Operations
    • SMEs
    • Team lead and facilitators
    • IT leaders

    1.3.2 List your guiding principles (Continued)

    Example

    Guiding principals: Support business agility, use best practices, automate, stay focused, strive for `one source truth`.

    Step 1.4

    Review project objectives

    Activities

    1.4.1 Confirm your goals and objectives for the implementation project

    This step involves the following participants:

    • Project team
    • Operations
    • SMEs
    • Team lead and facilitators
    • IT leaders

    Outcomes of this step

    The objectives of the implementation project

    Review the elements of the project charter

    Leverage completed deliverables to get project managers started down the path of success.

    Deliverables of project chaters for PMs. Project purpose, scope, logistics and sign-off.

    1.4.1 List your guiding principles

    1-2 hours

    1. Articulate the high-level objectives of the project. (What are the goals of the project?)
    2. Elicit the business benefits the sponsor is committed to achieving. (What are the business benefits of the project?)
    3. Record Project goals and objectives in section 1.7 of Info-Tech’s Your Enterprise Application Implementation Playbook.

    Download Your Enterprise Application Implementation Playbook

    Input

    Output

    • Your BizDevOps objectives and metrics
    • Understanding of various collaboration methods, such as Scrum, Kanban, and Scrumban
    • Your chosen collaboration method

    Materials

    Participants

    • Whiteboard/flip charts
    • Your Enterprise Application Implementation Playbook
    • Project team
    • Operations
    • SMEs
    • Team lead and facilitators
    • IT leaders

    1.4.1 Confirm your goals and objectives for the implementation project (Continued)

    Example:

    Project Objectives: End-user visibility, New business development, employee experience. Business Benefits for each objective listed.

    Step 1.5

    Establish project governance

    Activities

    1.5.1 Define the project governance structure

    This step involves the following participants:

    • Project team
    • Operations
    • SMEs
    • Team lead and facilitators
    • IT leaders

    Outcomes of this step

    Approach to build an effective project governance

    1.5.1 List your guiding principles

    0.5-1 hour

    1. Identify the IT governance structure in place today and document the high-level function of each body (councils, steering committees, review boards, centers of excellence, etc.).
    2. Identify and document the existing enterprise applications governance structure, roles, and responsibilities (if any exist).
    3. Identify gaps and document the desired enterprise applications governance structure, roles, and responsibilities.
    4. Record the project governance structure in section 1.8 of Info-Tech’s Your Enterprise Application Implementation Playbook.

    Download Your Enterprise Application Implementation Playbook

    Input

    Output

    • IT governance structure
    • Your project governance structure

    Materials

    Participants

    • Whiteboard/flip charts
    • Your Enterprise Application Implementation Playbook
    • Project team
    • Operations
    • SMEs
    • Team lead and facilitators
    • IT leaders

    Governance is NOT management

    Three levels of governance: Team Level, Steering Committee Level, and Executive Governance Level.

    Info-Tech Insight

    You won’t get engagement unless there is a sense of accountability. Do not leave this vague. Accountability needs to be assigned to specific individuals in your organization to ensure the system development achieves what was intended by your organization and not what your system integrator (SI) intended.

    Who is accountable?

    Too many assumptions are made that the SI is accountable for all implementation activities and deliverables – this is simply untrue. All activities can be better planned for, and misunderstandings can be avoided, with a clear line of sight on roles and responsibilities and the documentation that will support these assumptions.

    Discuss, define, and document roles and responsibilities:
    • For each role (e.g. executive sponsor, delivery manager, test lead, conversion lead), clearly articulate the responsibilities of the role, who is accountable for fulfillment, and whether it’s a client role, SI role, or both.
    • Articulate the purpose of each deliverable clearly, define which individual or team has responsibility for it, and document who is expected to contribute.
    • Empower the team by granting them the authority to make decisions. Ease their reluctance to think outside the box for fear of stakeholder or user backlash.
    • The implementation cannot and will not be transformative if the wrong people are involved or if the right people have not been given the tools required to succeed in their role.

    1.5.2 List your guiding principles

    0.5-1 hour

    1. Assess the skills necessary for an enterprise implementation. Inventory the competencies required for an enterprise implementation team. Map your internal resources to each competency as applicable.
    2. Select your internal implementation team. Determine who needs to be involved closely with the implementation. Key stakeholders should also be considered as members of your implementation team.
    3. Identify the number of external consultants/support required for implementation. Consider your in-house skills, timeline, integration environment complexity, and cost constraints as you make your resourcing plan.
    4. Record governance team roles and responsibilities in 1.9 section of Info-Tech’s Your Enterprise Application Implementation Playbook.

    Download Your Enterprise Application Implementation Playbook

    Input

    Output

    • Available resources (internal, external, contract)
    • Your governance structure roles and responsibilities

    Materials

    Participants

    • Whiteboard/flip charts
    • Your Enterprise Application Implementation Playbook
    • Project team
    • Operations
    • SMEs
    • Team lead and facilitators
    • IT leaders

    1.5.2 Define governance team roles and responsibilities (Continued)

    Example

    Governance team roles and their responsibilities.

    Phase 2

    Set up for success

    3 phases, phase 2 is highlighted.

    This phase will walk you through the following activities:

    2.1. Review project scope

    2.2. Define project metrics

    2.3. Prepare for project risks

    2.4. Identify the project team

    2.5. Define your change management process

    This phase involves the following participants:

    • Project team
    • Operations
    • SMEs
    • Team lead and facilitators
    • IT leaders

    Step 2.1

    Review project scope

    Activities

    2.1.1 Gather and review requirements

    2.1.2 Confirm your scope for implementation

    2.1.3 Formulate a scope statement

    This step involves the following participants:

    • Project team
    • Operations
    • SMEs
    • Team lead and facilitators
    • IT leaders

    Outcomes of this step

    The project scope

    Requirements are key to defining scope

    Project scope management includes the processes required to ensure that the project includes all and only the work required to complete the project successfully. Therefore, managing project scope is about defining and controlling what is and is not included in the project.

    PMBOK defines requirements as “conditions or capabilities that are to be met by the project or present in the product, service, or result to satisfy an agreement or other formally imposed specification.” Detailed requirements should be gathered and elicited in order to provide the basis for defining the project scope.

    70% of projects fail due to poor requirements, organizations using poor practices spent 62% more, 4th highest correlation to high IT performance is requirements gathering.

    Well-executed requirements gathering results in:

    • Consistent approach from project to project, resulting in more predictable outcomes.
    • Solutions that meet the business need on the surface and under the hood.
    • Reduce risk for fast-tracked projects by establishing a right-sized approach.
    • Requirements team that can drive process improvement and improved execution.
    • Confidence when exploring solution alternatives.

    Poorly executed requirements gathering results in:

    • IT receiving the blame for any project shortcomings or failures.
    • Business needs getting lost in the translation between the initial request and final output.
    • Inadequate solutions or cost overruns and dissatisfaction with IT.
    • IT losing its credibility as stakeholders do not see the value and work around the process.
    • Late projects that tie up IT resources longer than planned, and cost overruns that come out of the IT budget.
    • Inconsistent project execution, leading to inconsistent outcomes.

    Strong stakeholder satisfaction with requirements results in higher satisfaction in other areas

    High stakeholder satisfaction with requirements results in higher satisfaction in other areas.

    Note: “High satisfaction” was classified as a score greater or equal to eight, and “low satisfaction” was every organization that scored below eight on the same questions.

    2.1.1 Gather and review requirements

    1-2 hours

    1. Once existing documentation has been gathered, evaluate the effectiveness of the documentation and decide whether you need additional information to proceed to current-state mapping.
    2. The initiative team should avoid spending too much time on the discovery phase, as the goal of discovery is to obtain enough information to produce a level-one current-state map.
    3. Consider reviewing capabilities, business processes, current applications, integration, and data migration.

    Download Your Enterprise Application Implementation Playbook

    Input

    Output

    • Your requirements, capabilities, business processes, current applications, integration, and/or data migration
    • Your requirements, capabilities, business processes, current applications, integration, and/or data migration revisited

    Materials

    Participants

    • Whiteboard/flip charts
    • Your Enterprise Application Implementation Playbook
    • Project team
    • Operations
    • SMEs
    • Team lead and facilitators
    • IT leaders

    2.1.1 Requirements list

    Example

    Requirements with description, category and priority.

    2.1.2 Confirm your scope for implementation

    1-2 hours

    1. Based on the requirements, write down features of the product or services, as well as dependencies with other interfaces.
    2. Write down exclusions to guard against scope creep.
    3. Validate the scope by asking these questions:
      1. Will this scope provide a common understanding for all stakeholders, including those outside of IT, as to what the project will accomplish and what it excludes?
      2. Should any detail be added to prevent scope creep later?
    4. Record the project scope in section 2.1 of Info-Tech’s Your Enterprise Application Implementation Playbook.

    Download Your Enterprise Application Implementation Playbook

    Input

    Output

    • What’s in scope
    • What’s out of scope
    • What needs to integrate
    • Your scope areas

    Materials

    Participants

    • Whiteboard/flip charts
    • Your Enterprise Application Implementation Playbook
    • Project team
    • Operations
    • SMEs
    • Team lead and facilitators
    • IT leaders

    2.1.2 Scope detail

    Example

    Example of scope detail. Table with scope levels: In scope, out of scope and existing scope. Each scope level has details about it listed.

    Distill your requirements into a scope statement

    Requirements are about the what and the how.
    Scope specifies the features of the product or service – what is in and what is out
    Table showing Requirement document vs. Scope statement. It lists the audience, content, inputs and outputs for each.

    The Build Your Enterprise Application Implementation Playbook 2.2 Project Scope Statement includes:

    • Scope description (features, how it interfaces with other solution components, dependencies).
    • Exclusions (what is not part of scope).
    • Deliverables (product outputs, documentation).
    • Acceptance criteria (what metrics must be satisfied for the deliverable to be accepted).
    • Final sign-off (owner).
    • Project exclusions (scope item, details).

    The scope statement should communicate the breadth of the project

    To assist in forming your scope statement, answer the following questions:
    • What are the major coverage points?
    • Who will be using the systems?
    • How will different users interact with the systems?
    • What are the objectives that need to be addressed?
    • Where do we start?
    • Where do we draw the line?

    2.1.3 Formulate a scope statement

    1-2 hours

    1. Lay out the scope description (features, how it interfaces with other solution components, dependencies).
    2. Record the exclusions (what is not part of scope).
    3. Fill out the scope statement.
    4. Record the scope statement in section 2.2 of Info-Tech’s Your Enterprise Application Implementation Playbook.

    Download Your Enterprise Application Implementation Playbook.

    Input

    Output

    • Your scope areas
    • Your scope statement

    Materials

    Participants

    • Whiteboard/flip charts
    • Your Enterprise Application Implementation Playbook.
    • Scope statement template
    • Project team
    • Operations
    • SMEs
    • Team lead and facilitators
    • IT leaders

    2.1.3 Scope statement

    Example

    Examples of scope statements showing the following: Product or service in scope, project deliverables and acceptance criteria, and project exclusions.

    Step 2.2

    Review project scope

    Activities

    2.2.1 Define metrics for your project

    This step involves the following participants:

    • Project team
    • Operations
    • SMEs
    • Team lead and facilitators
    • IT leaders

    Outcomes of this step

    The project metrics

    Building leading indicators

    Lagging KPIs are relatively simple to identify, whereas leading KPIs can be more elusive.

    For example, take the lagging KPI “Customer Satisfaction.” How do you turn that into a leading KPI? One method is to look at sources of customer complaints. In a retail sales system, backordered items will negatively impact customer satisfaction. As a leading indicator, track the number of orders with backordered lines and the percentage of the total order that was backordered.

    Performance Metrics

    Use leading and lagging metrics, as well as benchmarks, to track the progress of your system.

    Leading KPIs: Input-oriented measures:

    • Number of active users in the system.
    • Time-to-completion for processes that previously experienced efficiency pain points.

    Lagging KPIs: Output-oriented measures:

    • Faster production times.
    • Increased customer satisfaction scores

    Benchmarks: A standard to measure performance against:

    • Number of days to ramp up new users.

    Info-Tech Insight

    Leading indicators make the news; lagging indicators report on the news. Focusing on leading indicators allows you to address challenges before they become large problems with only expensive solutions.

    2.2.1 Define metrics for your project

    1-2 hours

    1. Examine outputs from any feedback mechanisms you have (satisfaction surveys, emails, existing SLAs, burndown charts, resourcing costs, licensing costs per sprint, etc.).
    2. Look at historical trends and figures when available. However, be careful of frequent anomalies, as these may indicate a root cause that needs to be addressed.
    3. Explore the definition of specific metrics across different functional teams to ensure consistency of measurement and reporting.
    4. Record the Project Metrics in section 2.3 of Info-Tech’s Your Enterprise Application Implementation Playbook.

    Download Your Enterprise Application Implementation Playbook.

    Input

    Output

    • Outputs of any feedback mechanism
    • Historical trends
    • Your project tracking metrics

    Materials

    Participants

    • Whiteboard/flip charts
    • Your Enterprise Application Implementation Playbook.
    • Project team
    • Operations
    • SMEs
    • Team lead and facilitators
    • IT leaders

    2.2.1 Metrics

    In addition to delivery metrics and system performance metrics, equip the business with process-based metrics to continuously prove the value of the enterprise software. Review the examples below as a starting point.

    Table showing metrics and desciption. Metrics listed are: Percent of requirements complete, issues found, issues resolved, and percent of processess complete.

    Step 2.3

    Prepare for project risks

    Activities

    2.3.1 Build a risk event menu

    2.3.2 Determine contextual risks

    2.3.3 Determine process risks

    2.3.4 Determine business risks

    2.3.5 Determine change risks

    This step involves the following participants:

    • Project team
    • Operations
    • SMEs
    • Team lead and facilitators
    • IT leaders

    Outcomes of this step

    Steps to create your product canvas and product vision statement

    All risks are not created equal

    Project Risk consists of: Contextual risk, process risk, change risk and business risk.

    For more information on Info-Tech’s Four-Pillar Risk Framework, please see Right-Size Your Project Risk Investment.

    Info-Tech’s Four-Pillar Risk Framework

    Unusual risks should be detected by finding out how each project is different from the norm. Use this framework to start this process by confronting the risks that are more easily anticipated.

    2.3.1 Build a risk event menu

    0.5-1 hour

    1. Build and maintain an active menu of potential risk events across the four risk categories.
    2. Record the risk event menu in section 2.4 of Info-Tech’s Your Enterprise Application Implementation Playbook.

    Download Your Enterprise Application Implementation Playbook.

    Input

    Output

    • Risk events
    • Your risk events menu

    Materials

    Participants

    • Whiteboard/flip charts
    • Your Enterprise Application Implementation Playbook.
    • Project team
    • Operations
    • SMEs
    • Team lead and facilitators
    • IT leaders

    2.3.1 Risk event menu

    Example

    Risk event menu example. A table with: Contextual Risk, process risk, business risk, change risk events with examples for each.

    2.3.2 Determine contextual risks

    0.5-1 hour

    1. Contextual risk factors are those that operate within the context of your department, organization, and/or community.
    2. Fill out contextual risks.
    3. Record the contextual risks in section 2.5 of Info-Tech’s Your Enterprise Application Implementation Playbook.

    Download

    Your Enterprise Application Implementation Playbook.

    Input

    Output

    • Your risk events menu
    • Your list of people involved in risk management
    • Your contextual risks

    Materials

    Participants

    • Project Risk Management Workbook
    • Whiteboard/flip charts
    • Your Enterprise Application Implementation Playbook.
    • Project team
    • Operations
    • SMEs
    • Team lead and facilitators
    • IT leaders

    2.3.2 Contextual risks

    Example

    two tables for Contextual risks. Table 1: Risk identification with event name, risk cause, impact and risk owner. Table 2: shows probability of risk, impact, rating, recommended action, and any mitigations.

    2.3.3 Determine process risks

    0.5-1 hour

    1. Process risks are those that involve project sponsorship, project management, business and functional requirements, work assignment, communication, and/or visibility.
    2. Fill out process risks.
    3. Record the process risks in section 2.6 of Info-Tech’s Your Enterprise Application Implementation Playbook.

    Download

    Your Enterprise Application Implementation Playbook.

    Input

    Output

    • Your risk events menu
    • Your list of people involved in risk management
    • Your process risks

    Materials

    Participants

    • Project Risk Management Workbook
    • Whiteboard/flip charts
    • Your Enterprise Application Implementation Playbook.
    • Project team
    • Operations
    • SMEs
    • Team lead and facilitators
    • IT leaders

    2.3.3 Process risks

    Example

    two tables for Process risks. Table 1: Risk identification with event name, risk cause, impact and risk owner. Table 2: shows probability of risk, impact, rating, recommended action, and any mitigations.

    2.3.4 Determine business risks

    0.5-1 hour

    1. Business risks are those that affect the bottom line of the organization. They usually have implications on revenue, costs, and/or image.
    2. Fill out business risks.
    3. Record the business risks in section 2.7 of Info-Tech’s Your Enterprise Application Implementation Playbook.

    Download

    Your Enterprise Application Implementation Playbook.

    Input

    Output

    • Your risk events menu
    • Your list of people involved in risk management
    • Your business risks

    Materials

    Participants

    • Project Risk Management Workbook
    • Whiteboard/flip charts
    • Your Enterprise Application Implementation Playbook.
    • Project team
    • Operations
    • SMEs
    • Team lead and facilitators
    • IT leaders

    2.3.4 Business risks

    Example

    two tables for Business risks. Table 1: Risk identification with event name, risk cause, impact and risk owner. Table 2: shows probability of risk, impact, rating, recommended action, and any mitigations.

    2.3.5 Determine change risks

    0.5-1 hour

    1. Change risks are those that result from imposing changes on the people and customers of the organization and their daily routines.
    2. Fill change risks.
    3. Record the change risks in section 2.7 of Info-Tech’s Your Enterprise Application Implementation Playbook.

    Download Your Enterprise Application Implementation Playbook.

    Input

    Output

    • Your risk events menu
    • Your list of people involved in risk management
    • Your business risks

    Materials

    Participants

    • Project Risk Management Workbook
    • Whiteboard/flip charts
    • Your Enterprise Application Implementation Playbook.
    • Project team
    • Operations
    • SMEs
    • Team lead and facilitators
    • IT leaders

    2.3.5 Change risks

    Example

    two tables for Change risks. Table 1: Risk identification with event name, risk cause, impact and risk owner. Table 2: shows probability of risk, impact, rating, recommended action, and any mitigations.

    Step 2.4

    Identify the project team

    Activities

    2.4.1 Establish team composition

    2.4.2 Identify the team

    This step involves the following participants:

    • Project team
    • Operations
    • SMEs
    • Team lead and facilitators
    • IT leaders

    Outcomes of this step

    Steps to get your project team ready

    Understand the unique external resource considerations for the implementation

    Organizations rarely have sufficient internal staffing to resource an enterprise software implementation project entirely on their own. Consider the options for closing the gap in internal resource availability.

    The most common project resourcing structures for enterprise projects are:

    1. Management consultant
    2. Vendor consultant
    3. System integrator

    When contemplating a resourcing structure, consider:

    • Availability of in-house implementation competencies and resources.
    • Timeline and cost constraints.
    • Integration environment complexity.

    CONSIDER THE FOLLOWING

    Internal Vs. External Roles and Responsibilities

    Clearly delineate between internal and external team responsibilities and accountabilities and communicate this to your technology partner upfront.

    Internal Vs. External Accountabilities

    Accountability is different than responsibility. Your vendor or SI partner may be responsible for completing certain tasks, but be careful not to outsource accountability for the implementation – ultimately, the internal team will be accountable.

    Partner Implementation Methodologies

    Often vendors and/or SIs will have their own preferred implementation methodology. Consider the use of your partner’s implementation methodology; however, you know what will work for your organization.

    Info-Tech Insight

    Selecting a partner is not just about capabilities, it’s about compatibility! Ensure you select a partner that has a culture compatible with your own.

    2.4.1 Establish team composition

    0.5-1 hour

    1. Assess the skills necessary for an enterprise implementation.
    2. Select your internal implementation team.
    3. Identify the number of external consultants/support required for implementation.
    4. Document the roles and responsibilities, accountabilities, and other expectations as they relate to each step of the implementation.
    5. Record the team composition in section 2.9 of Info-Tech’s Your Enterprise Application Implementation Playbook.

    Download

    Your Enterprise Application Implementation Playbook.

    Input

    Output

    • List of project team skills
    • Your team composition
    • Your business risks

    Materials

    Participants

    • Whiteboard/flip charts
    • Your Enterprise Application Implementation Playbook.
    • Project team
    • Operations
    • SMEs
    • Team lead and facilitators
    • IT leaders

    2.4.1 Team composition

    Example

    Team composition: Role of each team member, and their skills.

    2.4.2 Identify the team

    0.5-1 hour

    1. Identify a candidate for each role and determine their responsibility in the project and their expected time commitment.
    2. The project will require a cross-functional team within IT and business units. Make sure the responsibilities are clearly communicated to the selected project sponsor.
    3. Create a RACI matrix for the project.
    4. Record the team list in section 2.10 of Info-Tech’s Your Enterprise Application Implementation Playbook.

    Download

    Your Enterprise Application Implementation Playbook.

    Input

    Output

    • Your team composition
    • Your team with responsibilities and commitment

    Materials

    Participants

    • Whiteboard/flip charts
    • Your Enterprise Application Implementation Playbook.
    • Project team
    • Operations
    • SMEs
    • Team lead and facilitators
    • IT leaders

    2.4.2 Team list

    Example

    Team list: Role of each team member, candidate, responsibilities, and their commitment in hours per week.

    RACI example

    RACI example. Responsibilities and team member roles that are tasked with each responsibility.

    Step 2.5

    Define your change management process

    Activities

    2.5.1 Define OCM structure and resources

    2.5.2 Define OCM team’s roles and responsibilities

    2.5.3 Define requirements for training

    2.5.4 Create a communications plan for stakeholder groups, and delivery teams

    This step involves the following participants:

    • Project team
    • Operations
    • SMEs
    • Team lead and facilitators
    • IT leaders

    Outcomes of this step

    A structure and procedures for an effective organizational change management

    Define your change management process to improve quality and adoption

    Organizational change management is the practice through which the PMO can improve user adoption rates and maximize project benefits.

    Correlation of change management effectiveness with meeting results.

    “It’s one thing to provide a new technology tool to your end users.

    It’s quite another to get them to use the tool, and still different for them to use the new tool proficiently.

    When your end users fully use a new technology and make it part of their daily work habits, they have ‘adopted’ the new tool.”

    – “End-User Adoption and Change Management Process” (2022)

    Large projects require organizational change management

    Organizational change management (OCM) governs the introduction of new business processes and technologies to ensure stakeholder adoption. The purpose of OCM is to prepare the business to accept the change.

    OCM is a separate body of knowledge. However, as a practice, it is inseparable from project management.

    In IT, project planning tends to fixate on technology, and it underestimates the behavioral and cultural factors that inhibit user adoption. Whether change is project-specific or continuous, it’s more important to instill the desire to change than to apply specific tools and techniques.

    Accountability for instilling this desire should start with the project sponsor. The project manager should support this with effective stakeholder and communication management plans.

    16% of projects with poor change management met or exceeded objectives. 71% of projects with excellent change management finish on or ahead of schedule. 67% of organizations include project change management in their initiatives.

    For further discussion on organizational change, use Info-Tech’s blueprint, Master Organizational Change Management Practices

    Your application implementation will be best served by centralizing OCM

    A centralized approach to OCM is most effective, and the PMO is already a centralized project office and is already accountable for project outcomes.

    What’s more, in organizations where accountabilities for OCM are not explicitly defined, the PMO will likely already be assumed to be the default change leader by the wider organization.

    It makes sense for the PMO to accept this accountability – in the short term at least – and claim the benefits that will come from coordinating and consistently driving successful project outcomes.

    In the long term, OCM leadership will help the PMO become a strategic partner with the executive layer and the business side.

    Short-term gains made by the PMO can be used to spark dialogues with those who authorize project spending and have the implicit fiduciary obligation to drive project benefits.

    Ultimately, it’s their job to explicitly transfer that obligation along with the commensurate resourcing and authority for OCM activities.

    Organizational resistance to change is cited as the #1 challenge to project success that PMOs face. Companies with mature PMOs that effectively manage change meet expectations 90% of the time.

    For further discussion on organizational change, use Info-Tech’s blueprint, Master Organizational Change Management Practices

    2.5.1 Define OCM structure and resources

    0.5-1 hour

    1. Assess the roles and resources that might be needed to help support these OCM efforts.
    2. Record the OCM structure in section 2.11 of Info-Tech’s Your Enterprise Application Implementation Playbook.

    Download

    Your Enterprise Application Implementation Playbook.

    Input

    Output

    • Your project objectives
    • Your OCM structure and resources

    Materials

    Participants

    • Whiteboard/flip charts
    • Your Enterprise Application Implementation Playbook.
    • Project team
    • Operations
    • SMEs
    • Team lead and facilitators
    • IT leaders

    2.5.1 OCM structure and resources

    Example

    OCM structure example. Table showing OCM activity and resources available to support.

    2.5.2 Define OCM team’s roles and responsibilities

    0.5-1 hour

    1. Assess the tasks required for the team.
    2. Determine roles and responsibilities.
    3. Record the results in the RACI matrix in section 2.13 of Info-Tech’s Your Enterprise Application Implementation Playbook.

    Download

    Your Enterprise Application Implementation Playbook.

    Input

    Output

    • Your communications timeline
    • Your OCM structure and resources
    • Your OCM plan and RACI matrix

    Materials

    Participants

    • Whiteboard/flip charts
    • Your Enterprise Application Implementation Playbook.
    • Project team
    • Operations
    • SMEs
    • Team lead and facilitators
    • IT leaders

    OCM team’s roles and responsibilities

    Example

    Responsibilities for OCM team members.

    2.5.3 Define requirements for training

    0.5-1 hour

    1. Analyze HR requirements to ensure efficient use of HR and project stakeholder time.
    2. Outline appropriate HR and training activities.
    3. Define training content and make key logistical decisions concerning training delivery for staff and users.
    4. Record training requirements in section 2.14 of Info-Tech’s Your Enterprise Application Implementation Playbook.

    Download

    Your Enterprise Application Implementation Playbook.

    Input

    Output

    • Your OCM Plan and RACI matrix
    • Your HR training needs

    Materials

    Participants

    • Whiteboard/flip charts
    • Your Enterprise Application Implementation Playbook.
    • Project team
    • Operations
    • SMEs
    • Team lead and facilitators
    • IT leaders

    2.5.3 Training requirements

    Example

    Training requirements example: Project milestones, milestone time frame, hr/training activities, activity timing, and notes.

    Project communication plans must address creation, flow, deposition, and security of project information

    A good communication management plan is like the oil that keeps moving parts going. Ensuring smooth information flow is a fundamental aspect of project management.

    Project communication management is more than keeping track of stakeholder requirements. A communication management plan must address timely and appropriate creation, flow, and deposition of information about the project – as well as the security of the information.

    Create:

    • In addition to standardized status reporting elements discussed for level 1 projects, level 2 and 3 projects may require additional information to be disseminated among key stakeholders and the PMO.

    Flow:

    • The plan must address the methods of communication. Distributed project teams require more careful planning, as they pose additional communication challenges.

    Deposit:

    • As the volume of information continues to grow exponentially, retrieving information becomes a challenge. The plan for depositing project information must be consistent with your organization’s content management policies.

    Security:

    • Preventing unauthorized access and information leaks is important for projectsthat are intended to provide the organization with a competitive edge or for projects that deal with confidential data.
    45% of organizations had established mature communications and engagement processes.

    2.5.4 Create a communications timeline

    0.5-1 hour

    1. Base your change communications on your organization’s cultural appetite for change in general.
    2. Document communications plan requirements.
    3. Create a high-level communications timeline.
    4. Tailor a communications strategy for each stakeholder group.
    5. Record the communications timeline in section 2.12 of Info-Tech’s Your Enterprise Application Implementation Playbook.

    Download

    Your Enterprise Application Implementation Playbook.

    Input

    Output

    • Your OCM structure and resources
    • Your project objectives
    • Your project scope
    • Your stakeholders’ management plan
    • Your communications timeline

    Materials

    Participants

    • Whiteboard/flip charts
    • Your Enterprise Application Implementation Playbook.
    • Project team
    • Operations
    • SMEs
    • Team lead and facilitators
    • IT leaders

    Example of communications timeline

    Project sponsors are the most compelling storytellers to communicate the change

    Example of project communications timeline. Planning, requirements, design, development, QA, deployment, warranty, and benefits/closure.

    Info-Tech Insight

    Communication with stakeholders and sponsors is not a single event, but a continual process throughout the lifecycle of the project implementation – and beyond!

    Phase 3

    Document your plan

    3 phases, phase 3 is highlighted.

    This phase will walk you through the following activities:

    3.1 Develop a master project plan

    3.2. Define a follow-up plan

    3.3. Define the follow-up process

    3.4. Understand what’s next

    This phase involves the following participants:

    • Project team
    • Operations
    • SMEs
    • Team lead and facilitators
    • IT leaders

    Step 3.1

    Develop a master project plan

    Activities

    3.1.1 Define your implementation steps

    This step involves the following participants:

    • Project team
    • Operations
    • SMEs
    • Team lead and facilitators
    • IT leaders

    Outcomes of this step

    Steps to create your resourcing and master plans

    Resources Vs. Demand

    Organizations rarely have sufficient internal staffing to resource an enterprise software implementation project entirely on their own. Consider the options for closing the gap in internal resource availability.

    Project demand: Data classification, cloud strategy, application rationalization, recovery planning etc. must be weighted against the organizations internal staffing resources.

    Competing priorities

    Example

    Table for competing priorities: List of projects, their timeline, priority notes, and their implications.

    3.1.1 Define your implementation steps

    0.5-1 hour

    1. Write each phase of the project on a separate sticky note and add it to the whiteboard. Determine what steps make up each phase. Write each step of the phase on a separate sticky note and add it to the whiteboard.
    2. Determine what tasks make up each step. Write each task of the step on a separate sticky note and add it to the whiteboard.
    3. Record the tasks in the Your Enterprise Application Implementation Playbook – Timeline tool. This tool has an example of a typical list of tasks, to help you start your master plan. Use the timeline for project planning and progress tracking.
    4. Record your project’s basic data and work schedule.

    Download

    Your Enterprise Application Implementation Playbook.

    Input

    Output

    • Project's work breakdown structure
    • Your project master plan

    Materials

    Participants

    • Project team
    • Operations
    • SMEs
    • Team lead and facilitators
    • IT leaders

    Implementation plan – basic data

    Record your project name, project manager, and stakeholders from previous exercises.

    Example project information form: Project name, estimated start date, estimated end date, project manager, stakeholders, and time off of project.

    Implementation plan – work schedule

    Use this template to keep track of all project tasks, dates, owners, dependencies, etc.

    Use this template to keep track of all project tasks, dates, owners, dependencies, etc.

    “Actual Start Date” and “Actual Completion Date” columns must be updated to be reflected in the Gantt chart.

    This information will also be captured as the source for session 3.2.1 dashboards.

    Step 3.2

    Define a follow up plan

    Activities

    3.2.1 Create templates to enable follow-up throughout the project

    3.2.2 Decide on the tracking tools to help during your implementation

    This step involves the following participants:

    • Project team
    • Operations
    • SMEs
    • Team lead and facilitators
    • IT leaders

    Outcomes of this step

    Steps to create the processes and define the tools to track progress

    Leveraging dashboards

    Build a dashboard that reflects the leading metrics you have identified. Call out requirements that represent key milestones in the implementation.

    For further information on monitoring the project, use Info-Tech’s blueprint, Governance and Management of Enterprise Software Implementation

    Build a dashboard that reflects the leading metrics you have identified. Call out requirements that represent key milestones in the implementation.

    3.2.1 Create templates to enable follow-up throughout the project

    0.5-1 hour

    1. Create status report, dashboards/charts, budget control, risk/issues/gaps templates, and change request forms.
    2. Build a dashboard that reflects the leading metrics you have identified.
    3. Call out requirements that represent key milestones in the implementation.

    Download

    Your Enterprise Application Implementation Playbook.

    Input

    Output

    • Your projects master plan
    • Your project follow-up kit

    Materials

    Participants

    • Project team
    • Operations
    • SMEs
    • Team lead and facilitators
    • IT leaders

    Dashboards

    Based on the inputs in session 3.1.1 Define Your Implementation Steps, once the “Actual Start Date” and “Actual Completion Date” columns have been updated, this dashboard will present the project status and progress

    Based on the inputs in session 3.1.1 Define Your Implementation Steps, once the “Actual Start Date” and “Actual Completion Date” columns have been updated, this dashboard will present the project status and progress.

    This executive overview of the project's progress is meant to be used during the status meeting.

    Select the right tools

    Use SoftwareReviews to explore product features, vendor experience, and capability satisfaction.

    SoftwareReviews, Requirements Management, 2023

    SoftwareReviews, Project Management, 2023

    SoftwareReviews, Business Intelligence & Analytics, 2023

    3.2.2 Decide on the tracking tools to help during your implementation

    0.5-1 hour

    1. Based on the standards within your organization, select the appropriate project tracking tools to help you track the implementation project.
    2. If you do not have any tools or wish to change them, please see leverage Info-Tech’s SoftwareReviews to help you in making your decision.
    3. Consider tooling across a number of different categories:
      1. Requirements Management
      2. Project Management
      3. Reporting and Analytics
    4. Record the project tracking tools in section 3.3 of Info-Tech’s Your Enterprise Application Implementation Playbook.

    Download

    Your Enterprise Application Implementation Playbook.

    Input

    Output

    • Your project follow-up kit
    • Your project follow-up kit tools

    Materials

    Participants

    • Project team
    • Operations
    • SMEs
    • Team lead and facilitators
    • IT leaders

    Example: project tools

    Table listing project tools by type, use, and products available.

    Step 3.3

    Define a follow-up process

    Activities

    3.3.1 Define project progress communication

    3.3.2 Create a change request process

    This step involves the following participants:

    • Project team
    • Operations
    • SMEs
    • Team lead and facilitators
    • IT leaders

    Outcomes of this step

    Steps to create your follow-up process

    Project status updates should occur throughout the implementation

    Project status updates can be both formal and informal. Formal status updates provide a standardized means of disseminating information on project progress. It is the lifeblood of project management: Accurate and up-to-date status reporting enables your project manager to ensure that your project can continue to use the resources needed.

    Informal status updates are done over coffee with key stakeholders to address their concerns and discuss key outcomes they want to see. Informal status updates help to build a more personal relationship.

    Ask for feedback during the status update meetings. Use the meeting as an opportunity to align values, goals, and incentives.

    Codify the following considerations:

    • Minimum requirement for a formal status update:
      • Frequency of reporting, as required by the project portfolio
      • Parties to be consulted and informed
      • Recording, producing, and archiving meeting minutes, both formal and informal
    • Procedure for follow-up on feedback generated from status updates:
      • Filing change requests
      • Keeping the change requester/relevant stakeholders in the loop

    3.3.1 Define project progress communication

    0.5-1 hour

    1. Provide a standardized means of disseminating information on project progress.
    2. Create an accurate and up-to-date status report to help keep team engaged and leadership supporting the project.
    3. Record the project progress communication in section 3.5 of Info-Tech’s Your Enterprise Application Implementation Playbook.

    Download

    Your Enterprise Application Implementation Playbook.

    Input

    Output

    • Your project follow-up process
    • Your project progress communication

    Materials

    Participants

    • Whiteboard/flip charts
    • Your Enterprise Application Implementation Playbook.
    • Project team
    • Operations
    • SMEs
    • Team lead and facilitators
    • IT leaders

    Project progress communication

    Example

    Example table of project progress communication. Audience, purpose, delivery/format, communicator, delivery date, and status/notes.

    Manage project scope changes

    1. Change in project scope is unpredictable and almost inevitable regardless of project size. If changes are not properly managed, the project runs the risk of scope creep and loss of progress. Therefore, changes need to be monitored and controlled.
    2. Scope change can be initiated voluntarily by the project sponsor or other stakeholders, or it could be a mandatory reaction to changing project process.
    3. Scope change may also take place due to internal factors such as a stakeholder requiring more extensive insights or external factors such as changing market conditions.
    4. Scope changes have the potential to affect project outcomes either positively or negatively, depending on how the change is managed and implemented. The project manager should take care to maintain focus on the project’s ultimate objectives; consideration needs to be given as to what to do and what to give up.
    5. If changes arise, project managers should ensure that adequate resources and actions are provided so the project can be completed on time and on budget.
    • The project manager needs to use both hard and soft skills: analytical skills for evaluating and quantifying the impact of potential changes and communication skills for communicating and negotiating with stakeholders.
    • Build trust and credibility by taking an evidence-based approach when presenting changes. This gives you room to respectfully push back on certain changes.
    • Assess changes before crossing them off the list, but don’t be afraid to say no. Greater care must be taken when there is very limited budgetary freedom or when scope changes will interfere with the critical path.
    • All change requests must be received by the project manager first so they can make sure that IT project resources are not approached with multiple ad hoc change requests.

    Document your process to manage project change requests

    1 Initial assessment

    Using the scope statement as the reference point:

    • Why do we need the change?
    • Is the change necessary?
    • What is the business value that the change brings to the project?

    Recommend alternative solutions that are easier to implement while consulting the requester.

    2 Minor change

    If the change has been classified as minor, the project manager and the project team can tackle it directly, since it doesn’t affect project budget or schedule in a significant way. Ensure that the change is documented.

    3 conduct an in-depth assessment

    The project manager should bring major changes to the attention of the project sponsor and carry out a detailed assessment of the change and its impact.

    Additional time and resources are required to do the in-depth assessment because the impact on the project can be complex and affect requirements, resources, budget, and schedule.

    4 Obtain approval from the governing body

    Present the results to the governing body. Since a major change significantly affects the project baseline beyond the authorized contingency, it is the responsibility of the governing body to either approve the change with allocation of additional resources or reject the change and maintain course.

    Flow chart to document your process to manage project change requests.

    For further discussion on change requests, use Info-Tech’s blueprint, Begin Your Projects With the End in Mind

    3.3.2 Create a change request process

    0.5-1 hour

    1. Identify any existing processes that you have for addressing changes for projects.
    2. Discuss whether or not the current change request process will suit the project at hand.
    3. Define the agreed-to change request process that fits your organization’s culture.
    4. For a change request template, you can leverage, refer to section 3.6 of Info-Tech’s Your Enterprise Application Implementation Playbook.
    5. Make any changes to the template as necessary.

    Download

    Your Enterprise Application Implementation Playbook.

    Input

    Output

    • Your project scope
    • Your change request

    Materials

    Participants

    • Project team
    • Operations
    • SMEs
    • Team lead and facilitators
    • IT leaders

    3.3.2 Create a change request process (Continued)

    Example of a change request process form.

    Step 3.4

    Understand what's next

    Activities

    3.4.1 Run a “lessons learned” session for continuous improvement

    3.4.2 Prepare a closure document for sign-off

    3.4.3 Document optimization and future release opportunities

    This step involves the following participants:

    • Project team
    • Operations
    • SMEs
    • Team lead and facilitators
    • IT leaders

    Outcomes of this step

    Lessons learned throughout the project-guiding

    Good project planning is key to smooth project closing

    Begin with the end in mind. Without a clear scope statement and criteria for acceptance, it’s anyone’s guess when or how a project will end.

    During the closing process, the project manager should use planning and execution documents, such as the project charter and the scope statement, to assess project completeness and obtain sign-off based on the acceptance criteria.

    Project completion criteria should be clearly defined. For example, the project is defined as finished when costs are in, vendor receipts are received, financials are reviewed and approved, etc.

    However, there are other steps to be taken after completing the project deliverables. These activities include:

    • Transferring project knowledge and operations to support
    • Completing user training
    • Obtaining business sign-off and acceptance
    • Releasing resources
    • Conducting post-mortem meeting
    • Archiving project assets

    The project manager needs to complete all project management processes, including:

    • Risk management (close out risk assessment and action plan)
    • Quality management (test the final deliverables against acceptance criteria)
    • Stakeholder management (decision log, close out issues, plan and assign owners for resolutions of open issues)
    • Project team management (performance evaluation for team members as well as the project manager)

    3.4.1 Define the process for lessons learned

    0.5-1 hour

    1. Determine the reporting frequency for lessons learned.
    2. Consider attributing lessons learned to project phases.
    3. Coordinate lessons learned check-ins with project milestones to review and reflect.
    4. At each reporting session, the project team should identify challenges and successes informally.
    5. The PM and the PMO should transform the reports from each team member into formalized lessons.
    6. Record lessons learned for each project in section 3.7 of Info-Tech’s Your Enterprise Application Implementation Playbook.

    Download

    Your Enterprise Application Implementation Playbook.

    Input

    Output

    • Your project's lessons learned

    Materials

    Participants

    • Project Lessons Learned Template
    • Whiteboard/flip charts
    • Your Enterprise Application Implementation Playbook.
    • Project team
    • Operations
    • SMEs
    • Team lead and facilitators
    • IT leaders

    Lessons learned

    Example

    Form: Project successes, notes, areas of imporvement, impact, solution.

    Watch for these potential problems with project closure

    Don’t leave the door open for stakeholder dissatisfaction. Properly close out your projects.

    Potential problems with project closure.

    For further information on project closure issues, use Info-Tech’s blueprint, Get Started With Project Management Excellence.

    3.4.2 Prepare a closure document for sign-off

    0.5-1 hour

    1. Create a realistic closure and transition process that gains sign-off from the sponsor.
    2. Prepare a project closure checklist.
    3. Transfer accountability to operations, release project resources, and avoid disrupting other projects that are trying to get started.
    4. Record the project closure document in section 3.8 of Info-Tech’s Your Enterprise Application Implementation Playbook.

    Download

    Your Enterprise Application Implementation Playbook.

    Input

    Output

    • Your project objectives
    • Your project scope
    • Your project's closure checklist

    Materials

    Participants

    • Project closure checklist Template
    • Whiteboard/flip charts
    • Your Enterprise Application Implementation Playbook.
    • Project team
    • Operations
    • SMEs
    • Team lead and facilitators
    • IT leaders

    Closure checklist

    Project closure checklist. project management checklist, deliverables, goals, benefits, outstanding action items and issues, handover of technical documents, knowledge transfer, sign-off.

    For further information on closure procedures, use Info-Tech’s blueprint, Begin Your Projects With the End in Mind.

    3.4.3 Document optimization and future release opportunities

    0.5-1 hour

    Consider the future opportunities for improvement post-release:

    1. Product and vendor satisfaction opportunities
    2. Capability and feature optimization opportunities
    3. Process optimization opportunities
    4. Integration optimization opportunities
    5. Data optimization opportunities
    6. Cost-saving opportunities
    7. Record optimization and future release opportunities in section 3.9 of Info-Tech’s Your Enterprise Application Implementation Playbook.

    Download

    Your Enterprise Application Implementation Playbook.

    Input

    Output

    • Your project objectives
    • Your project scope
    • Your optimization opportunities list

    Materials

    Participants

    • Whiteboard/flip charts
    • Your Enterprise Application Implementation Playbook.
    • Project team
    • Operations
    • SMEs
    • Team lead and facilitators
    • IT leaders

    Optimization opportunities

    Example

    Optimization types and opportunities.

    Related Info-Tech Research

    Build upon your foundations

    Build an ERP Strategy and Roadmap

    • A business-led, top-management-supported initiative partnered with IT has the greatest chance of success. This blueprint provides business and IT the methodology for getting the right level of detail for the business processes that the ERP supports thus avoiding getting lost in the details.

    Governance and Management of Enterprise Software Implementation

    • Implementing enterprise software is hard. You need a framework that will greatly improve your chance of success. Traditional Waterfall project implementations have a demonstrated a low success rate for on-time, on-budget delivery.

    Select and Implement a Human Resource Information System

    • Your organization is in the midst of a selection and implementation process for a human resource information system (HRIS), and there is a need to disambiguate the market and arrive at a shortlist of vendors.

    Select and Implement an ERP Solution

    • Selecting and implementing an ERP is one of the most expensive and time-consuming technology transformations an organization can undertake. ERP projects are notorious for time and budget overruns, with only a margin of the anticipated benefits being realized.

    Right-Size Your Project Risk Investment

    • Avoid the all-or-nothing mindset; even modest investments in risk will provide a return. Learn from and record current and historical risk events so lessons learned can easily be embedded into future projects. Assign someone to own the risk topic and make it their job to keep a relevant menu of risks.

    Related Info-Tech Research

    Build upon your foundations

    Drive Business Value With a Right-Sized Project Gating Process

    • Many organizations have implemented gating as part of their project management process. So, what separates those who are successful from those who are not? For starters, successful gating requires that each gate is treated as an essential audit. That means there need to be clear roles and responsibilities in the framework.

    Master Organizational Change Management Practices

    • Organizational change management (OCM) is often an Achilles’ heel for IT departments and business units, putting projects and programs at risk – especially large, complex, transformational projects.

    Get Started With Project Management Excellence

    • Lack of proper scoping at the beginning of the project leads to constant rescoping, rescheduling, and budget overruns.

    ERP Requirements Picklist Tool

    • Use this tool to collect ERP requirements in alignment with the major functional areas of ERP. Review the existing set of ERP requirements as a starting point to compiling your organization's requirements.

    Begin Your Projects With the End in Mind

    • Stakeholders are dissatisfied with IT’s inability to meet or even provide consistent, accurate estimates. The business’ trust in IT erodes every time a project is late, lost, or unable to start.

    Get Started With IT Project Portfolio Management

    • Most companies are struggling to get their project work done. This is due in part to the fact that many prescribed remedies are confusing, disruptive, costly, or ineffective.

    Bibliography

    7 Shocking Project Management Statistics and Lessons We Should Learn.” TeamGantt, Jan. 2017.

    Akrong, Godwin Banafo, et al. "Overcoming the Challenges of Enterprise Resource Planning (ERP): A Systematic Review Approach." IJEIS vol.18, no.1 2022: pp.1-41.

    Andriole, S. “Why No One Can Manage Projects, Especially Technology Projects.” Forbes, 1 Dec. 2020.

    Andriole, Steve. “Why No One Can Manage Projects, Especially Technology Projects.” Forbes, 1 Dec. 2020.

    Beeson, K. “ERP Implementation Plan (ERP Implementation Process Guide).” ERP Focus, 8 Aug. 2022.

    Biel, Justin. “60 Critical ERP Statistics: 2022 Market Trends, Data and Analysis.” Oracle Netsuite, 12 July 2022.

    Bloch, Michael, et al. “Delivering Large-Scale IT Projects on Time, on Budget, and on Value.” McKinsey & Company, 2012.

    Buverud, Heidi. ERP System Implementation: How Top Managers' Involvement in a Change Project Matters. 2019. Norwegian School of Economics, Ph.D. thesis.

    Carlton, R. “Four ERP Implementation Case Studies You Can Learn From.” ERP Focus, 15 July 2015.

    Gopinath, S. Project Management in the Emerging World of Disruption. PMI India Research and Academic Conference 2019. Kozhikode Publishers.

    Grabis, J. “On-Premise or Cloud Enterprise Application Deployment: Fit-Gap Perspective.” Enterprise Information Systems. Edited by Filipe, J., Śmiałek, M., Brodsky, A., Hammoudi, S. ICEIS, 2019.

    Harrin, E. The Definitive Guide to Project Sponsors. RGPM, 13 Dec. 2022.

    Jacobs-Long, Ann. “EPMO’s Can Make A Difference In Your Organization.” 9 May 2012.

    Kotadia, C. “Challenges Involved in Adapting and Implementing an Enterprise Resource Planning (ERP) Systems.” International Journal of Research and Review vol. 7 no. 12 December 2020: 538-548.

    Panorama Consulting Group. "2018 ERP Report." Panorama Consulting Group, 2018. Accessed 12 Oct. 2021.

    Panorama Consulting Group. "2021 ERP Report." Panorama Consulting Group, 2021. Accessed 12 Oct. 2021.

    PM Solutions. (2014). The State of the PMO 2014.

    PMI. Pulse of the Profession. 2017.

    Podeswa, H. “The Business Case for Agile Business Analysis.” Requirements Engineering Magazine, 21 Feb. 2017.

    Project Delivery Performance in Australia. AIPM and KPMG, 2020.

    Prosci. (2020). Prosci 2020 Benchmarking Data from 2007, 2009, 2011, 2013, 2015, 2017, 2019.

    Swartz, M. “End User Adoption and Change Management Process.” Swartz Consulting LLC, 11 July 2022.

    Trammell, H. “28 Important Project Management KPIs (& How To Track Them).” ClearPoint Strategy, 2022.

    “What are Business Requirements?" Requirements.com, 18 Oct. 2018.

    “What Is the Role of a Project Sponsor?” Six Sigma Daily, 18 May 2022.

    “When Will You Think Differently About Programme Delivery?” 4th Global Portfolio and Programme Management Survey. PricewaterhouseCoopers, Sept. 2014.

    Govern Shared Services

    • Buy Link or Shortcode: {j2store}459|cart{/j2store}
    • member rating overall impact: N/A
    • member rating average dollars saved: N/A
    • member rating average days saved: N/A
    • Parent Category Name: Operations Management
    • Parent Category Link: /i-and-o-process-management
    • IT managers have come under increasing pressure to cut costs, and implementing shared services has become a popular demand from the business.
    • Business unit resistance to a shared services implementation can derail the project.
    • Shared services rearranges responsibilities within existing IT departments, potentially leaving no one accountable for project success and causing cost overruns and service performance failures.

    Our Advice

    Critical Insight

    • Over one-third of shared services implementations increase IT costs, due to implementation failures. Ineffective governance plays a major role in the breakdown of shared services, particularly when it does not overcome stakeholder resistance or define clear areas of responsibility.
    • Effective governance of a shared services implementation requires the IT leader to find the optimal combination of independence and centralization for the shared service provider.
    • Three primary models exist for governing shared services: entrepreneurial, mandated, and market-based. Each one occupies a different location in the trade-off of independence and centralization. The optimal model for a specific situation depends on the size of the organization, the number of participants, the existing trend towards centralization, and other factors.

    Impact and Result

    • Find the optimal governance model for your organization by weighing the different likely benefits and costs of each path.
    • Assign appropriate individual responsibilities to participants, so you can effectively scope your service offering and fund your implementation.
    • Support the governance effort effectively using published Info-Tech tools and templates.

    Govern Shared Services Research & Tools

    Besides the small introduction, subscribers and consulting clients within this management domain have access to:

    1. Understand each of the governance models and what each entails

    Build a plan for governing an implementation.

    • Storyboard: Govern Shared Services
    • None

    2. Choose the optimal approach to shared services governance

    Maximize the net benefit conferred by governance.

    • Shared Services Governance Strategy Roadmap Tool
    [infographic]

    IT Project Management Lite

    • Buy Link or Shortcode: {j2store}187|cart{/j2store}
    • member rating overall impact: N/A
    • member rating average dollars saved: N/A
    • member rating average days saved: N/A
    • Parent Category Name: Project Management Office
    • Parent Category Link: /project-management-office
    • Organizations want reliable project reporting and clear, consistent project management standards, but many are unwilling or unable to allocate time for it.
    • Many IT project managers are given project management responsibilities in addition to other full-time roles – without any formal allocation of time, authority, or training.
    • Most IT project managers and stakeholders actually want clear and consistent standards but resist tools and procedures they believe are too time consuming and inflexible.
    • Standard project management procedures must be “light” enough for project managers to adapt to a wide range of projects without increasing the total time required to manage projects successfully.

    Our Advice

    Critical Insight

    • Most IT project management advice is focused on the largest 10-20% of projects – projects with large enough budgets to allocate time to project management. This leaves most IT projects (and most people who manage IT projects) in limbo between high-risk ad hoc management and high-cost project management best practices.
    • Project management success doesn’t equate to project success. While formal methodologies are a key ingredient in the success of large, complex projects, most IT projects do not require the same degree of rigorous record-keeping and planning.
    • Consistent, timely, and accurate reporting is the “linchpin” in any sustainable project and portfolio management practice.

    Impact and Result

    • Maintain timely and accurate project portfolio reporting with right-sized tools and processes.
    • Establish clear and consistent project management standards that make better use of time already spent managing projects.
    • Enable project managers to manage their projects more successfully with a set of flexible and lightweight tools and templates.

    IT Project Management Lite Research & Tools

    Besides the small introduction, subscribers and consulting clients within this management domain have access to:

    1. Assess the value of a minimum-viable PMO strategy

    Perform a measured value assessment for building and managing a minimum-viable PMO.

    • IT Project Management Lite Storyboard

    2. Perform a project and portfolio needs assessment

    Focus on the minimum required to maintain accuracy of portfolio reporting and effectiveness in managing projects.

    • Minimum-Viable PMO Needs Assessment

    3. Establish standards for realistic, accurate, and consistent portfolio reporting

    Emphasize reporting high-level project status as a way to identify and address issues to achieve the best results with the least effort.

    • Minimum-Viable Project and Portfolio Management SOP

    4. Create a standard, right-sized project management toolkit

    Free PMs to focus on actually managing the project while still delivering accurate portfolio metrics.

    • Zero-Allocation Project Management Workbook

    5. Train PMs for zero allocation

    Ensure project manager compliance with the portfolio reporting process by incorporating activities that create value.

    • Zero-Allocation Project Manager Development Plan
    • Zero-Allocation Project Management Survival Guide

    6. Perform a post-implementation assessment

    Evaluate success and identify opportunities for further improvement.

    Infographic

    Workshop: IT Project Management Lite

    Workshops offer an easy way to accelerate your project. If you are unable to do the project yourself, and a Guided Implementation isn't enough, we offer low-cost delivery of our project workshops. We take you through every phase of your project and ensure that you have a roadmap in place to complete your project successfully.

    1 Preparation

    The Purpose

    Define goals and success criteria.

    Finalize agenda.

    Gather information: update project and resource lists (Info-Tech recommends using the Project Portfolio Workbook).

    Key Benefits Achieved

    More efficiently organized and executed workshop.

    Able to better customize and tailor content to your specific needs.

    Activities

    1.1 Discuss specific pain points with regards to project manager allocations

    1.2 Review project lists, tools and templates, and other documents

    1.3 Map existing strategies to Info-Tech’s framework

    Outputs

    Understanding of where efforts must be focused in workshop

    Assessment of what existing tools and templates may need to be included in zero-allocation workbook

    Revisions that need to be made based on existing strategies

    2 Make the Case and Assess Needs

    The Purpose

    Assess current state (including review of project and resource lists).

    Discuss and analyze SWOT around project and portfolio management.

    Define target state.

    Define standards / SOP / processes for project and portfolio management.

    Key Benefits Achieved

    Gain perspective on how well your processes match up with the amount of time your project managers have for their PM duties.

    Determine the value of the time and effort that your project teams are investing in project management activities.

    Begin to define resource optimized processes for zero-allocation project managers.

    Ensure consistent implementation of processes across your portfolio.

    Establish project discipline and best practices that are grounded in actual project capacity.

    Activities

    2.1 Perform and/or analyze Minimum-Viable PMO Needs Assessment

    2.2 SWOT analysis

    2.3 Identify target allocations for project management activities

    2.4 Begin to define resource optimized processes for zero-allocation project managers

    Outputs

    Current state analysis based on Minimum-Viable PMO Needs Assessment

    Overview of current strengths, weaknesses, opportunities and threats

    Target state analysis based on Minimum-Viable PMO Needs Assessment

    A refined Minimum-Viable Project and Portfolio Management SOP

    3 Establish Strategy

    The Purpose

    Select and customize project and portfolio management toolkit.

    Implement (test/pilot) toolkit and processes.

    Customize project manager training plan.

    Evaluate and refine toolkit and processes as needed.

    Key Benefits Achieved

    Ensure consistent implementation of processes across your portfolio.

    Establish project discipline and best practices that are grounded in actual project capacity.

    A customized training session that will suit the needs of your project managers.

    Activities

    3.1 Customize the Zero-Allocation Toolkit to accommodate the needs of your projects

    3.2 Test toolkit on projects currently underway

    3.3 Tweak project manager training to suit the needs of your team

    Outputs

    Customized Zero-Allocation Project Management Workbook

    A tested and standardized copy of the workbook

    A customized training session for your project managers (to take place on Day 4 of Info-Tech’s workshop)

    4 Train Your Zero-Allocation Project Managers

    The Purpose

    Communicate project and portfolio management SOP to Project Managers.

    Deliver project manager training: standards for portfolio reporting and toolkit.

    Key Benefits Achieved

    Equip project managers to improve their level of discipline and documentation without spending more time in record keeping and task management.

    Execute a successful training session that clearly and succinctly communicates your minimal and resource-optimized processes.

    Activities

    4.1 Project Manager Training, including communication of the processes and standard templates and reports that will be adopted by all project managers

    Outputs

    Educated and disciplined project managers, aware of the required processes for portfolio reporting

    5 Assess Strategy and Next Steps

    The Purpose

    Debrief from the training session.

    Plan for ongoing evaluation and improvement.

    Evaluate and refine toolkit and processes if needed.

    Answer any remaining questions.

    Key Benefits Achieved

    Assess portfolio and project manager performance in light of the strategy implemented.

    Understanding of how to keep living documents like the workbook and SOP up to date.

    Clearly defined next steps.

    Activities

    5.1 Review the customized tools and templates

    5.2 Send relevant documentation to relevant stakeholders

    5.3 Schedule review call

    5.4 Schedule follow-up call with analysts to discuss progress in six months

    Outputs

    Finalized workbook and processes

    Satisfied and informed stakeholders

    Scheduled review call

    Scheduled follow-up call

    Build Your Security Operations Program From the Ground Up

    • Buy Link or Shortcode: {j2store}263|cart{/j2store}
    • member rating overall impact: 9.7/10 Overall Impact
    • member rating average dollars saved: $56,299 Average $ Saved
    • member rating average days saved: 43 Average Days Saved
    • Parent Category Name: Security Processes & Operations
    • Parent Category Link: /security-processes-and-operations
    • Analysts cannot monitor and track events coming from multiple tools because they have no visibility into the threat environment.
    • Incident management takes away time from problem management because processes are ad hoc and the continuous monitoring, collection, and analysis of massive volumes of security event data is responsive rather than tactical.
    • Organizations are struggling to defend against and prevent threats while juggling business, compliance, and consumer obligations.

    Our Advice

    Critical Insight

    • Security operations is no longer a center but a process. The need for a physical security hub has evolved into the virtual fusion of prevention, detection, analysis, and response efforts. When all four functions operate as a unified process, your organization will be able to proactively combat changes in the threat landscape.
    • Raw data without correlation is a waste of time, money, and effort. A SIEM on its own will not provide this contextualization and needs configuration. Prevention, detection, analysis, and response processes must contextualize threat data and supplement one another – true value will only be realized once all four functions operate as a unified process.
    • If you are not communicating, then you are not secure. Collaboration eliminates siloed decisions by connecting people, processes, and technologies. You leave less room for error, consume fewer resources, and improve operational efficiency with a transparent security operations process.

    Impact and Result

    • A centralized security operations process actively transforms security events and threat information into actionable intelligence, driving security prevention, detection, analysis, and response processes that address the increasing sophistication of cyberthreats while guiding continuous improvement.
    • This blueprint will walk through the steps of developing a flexible and systematic security operations program relevant to your organization.

    Build Your Security Operations Program From the Ground Up Research & Tools

    Start here – read the Executive Brief

    Read our concise Executive Brief to find out why you should build a security operations program, review Info-Tech’s methodology, and understand the ways we can support you in completing this project.

    Besides the small introduction, subscribers and consulting clients within this management domain have access to:

    1. Establish your foundation

    Determine how to establish the foundation of your security operations.

    • Build Your Security Operations Program From the Ground Up – Phase 1: Establish Your Foundation
    • Information Security Pressure Analysis Tool

    2. Assess your current state

    Assess the maturity of your prevention, detection, analysis, and response processes.

    • Build Your Security Operations Program From the Ground Up – Phase 2: Assess Your Current State
    • Security Operations Roadmap Tool

    3. Design your target state

    Design a target state and improve your governance and policy solutions.

    • Build Your Security Operations Program From the Ground Up – Phase 3: Design Your Target State
    • Security Operations Policy

    4. Develop an implementation roadmap

    Make your case to the board and develop a roadmap for your prioritized security initiatives.

    • Build Your Security Operations Program From the Ground Up – Phase 4: Develop an Implementation Roadmap
    • In-House vs. Outsourcing Decision-Making Tool
    • Security Operations MSSP RFP Template
    • Security Operations Project Charter Template
    • Security Operations RACI Tool
    • Security Operations Metrics Summary Document
    [infographic]

    Workshop: Build Your Security Operations Program From the Ground Up

    Workshops offer an easy way to accelerate your project. If you are unable to do the project yourself, and a Guided Implementation isn't enough, we offer low-cost delivery of our project workshops. We take you through every phase of your project and ensure that you have a roadmap in place to complete your project successfully.

    1 Establish Your Foundation

    The Purpose

    Identify security obligations and the security operations program’s pressure posture.

    Assess current people, process, and technology capabilities.

    Determine foundational controls and complete system and asset inventory.

    Key Benefits Achieved

    Identified the foundational elements needed for planning before a security operations program can be built

    Activities

    1.1 Define your security obligations and assess your security pressure posture.

    1.2 Determine current knowledge and skill gaps.

    1.3 Shine a spotlight on services worth monitoring.

    1.4 Assess and document your information system environment.

    Outputs

    Customized security pressure posture

    Current knowledge and skills gaps

    Log register of essential services

    Asset management inventory

    2 Assess Current Security Operations Processes

    The Purpose

    Identify the maturity level of existing security operations program processes.

    Key Benefits Achieved

    Current maturity assessment of security operations processes

    Activities

    2.1 Assess the current maturity level of the existing security operations program processes.

    Outputs

    Current maturity assessment

    3 Design a Target State

    The Purpose

    Design your optimized target state.

    Improve your security operations processes with governance and policy solutions.

    Identify and prioritize gap initiatives.

    Key Benefits Achieved

    A comprehensive list of initiatives to reach ideal target state

    Optimized security operations with repeatable and standardized policies

    Activities

    3.1 Complete standardized policy templates.

    3.2 Map out your ideal target state.

    3.3 Identify gap initiatives.

    Outputs

    Security operations policies

    Gap analysis between current and target states

    List of prioritized initiatives

    4 Develop an Implementation Roadmap

    The Purpose

    Formalize project strategy with a project charter.

    Determine your sourcing strategy for in-house or outsourced security operations processes.

    Assign responsibilities and complete an implementation roadmap.

    Key Benefits Achieved

    An overarching and documented strategy and vision for your security operations

    A thorough rationale for in-house or outsourced security operations processes

    Assigned and documented responsibilities for key projects

    Activities

    4.1 Complete a security operations project charter.

    4.2 Determine in-house vs. outsourcing rationale.

    4.3 Identify dependencies of your initiatives and prioritize initiatives in phases of implementation.

    4.4 Complete a security operations roadmap.

    Outputs

    Security operations project charter

    In-house vs. outsourcing rationale

    Initiatives organized according to phases of development

    Planned and achievable security operations roadmap

    Data Quality

    • Buy Link or Shortcode: {j2store}19|cart{/j2store}
    • Related Products: {j2store}19|crosssells{/j2store}
    • Teaser Video: Visit Website
    • Teaser Video Title: Big data after pandemic
    • member rating overall impact: 8.3/10
    • member rating average dollars saved: $5,100
    • member rating average days saved: 8
    • Parent Category Name: Data and Business Intelligence
    • Parent Category Link: /data-and-business-intelligence
    Restore trust in your data by aligning your data management approach to the business strategy

    Build your service map: What does your company do for your customers?

    • Large vertical image:
    • member rating overall impact: Large Impact
    • member rating average dollars saved: N/A
    • member rating average days saved: N/A

    After three decades navigating the complexities of organizational resilience, one truth stands clearer than ever: you cannot truly protect what you do not deeply understand. And for any business, especially in today's dynamic landscape, what you do is ultimately about what you do for your customers. There is something that I see insufficiently matured or missing in many companies: building a comprehensive “service map.”

    Think about it. We pour resources into product development, marketing, and sales, yet how often do we collectively pause to articulate, across all departments, exactly what services we provide to our customers? It sounds simple, doesn't it? Yet, the reality is typically a fragmented understanding, siloed information, and a distinct lack of a holistic view, except by a few key people.

    Why is this clear view so critical? Because your customers don't interact with your internal departments; they interact with your services. They don't care about your organizational chart; they care about how seamlessly you meet their needs. Without a clear service map, you have blind spots. You miss opportunities for optimization, you introduce friction into customer journeys, and critically, you compromise your ability to recover when things go wrong. Resilience isn't just about bouncing back; it's about understanding what's truly essential to protect your customer relationships.

    Let's make this real.

    What services do banks offer? It’s far more than just “banking.” They provide:

    • Retail Banking: Current accounts, savings accounts, debit/credit cards, personal loans, mortgages.

    • Investment Services: Wealth management, brokerage, mutual funds, pension products.

    • Business Banking: Corporate loans, treasury services, payroll solutions, trade finance.

    • Digital Services: Online banking platforms, mobile apps, and payment gateways.

    • Advisory Services: Financial planning, retirement planning, and estate planning.

    Let's hone in on an often complex offering: a pension savings product where you contribute monthly. This isn't just a “product” on a shelf; it's a living, breathing service with a distinct customer journey.

    Imagine the customer journey for this:

    1. Customer Initiates Payment (or Automated Process Triggers): On the designated payment date, a SEPA Direct Debit instruction is initiated, pulling funds from the customer's linked bank account.

    2. Funds Transfer & Clearance: The funds travel through interbank networks, cleared and settled between the customer's bank and the financial institution’s holding accounts.

    3. Internal Reconciliation & Allocation: Upon receipt, the funds are reconciled against the customer's pension account number and allocated to their specific pension product.

    4. Investment Instruction: Based on the product's pre-defined investment strategy (e.g., a balanced fund, equity fund), an instruction is generated to purchase units in the underlying investments.

    5. Market Execution: The instruction is sent to the relevant trading desks or automated systems, which execute the purchase of shares, bonds, or other assets on the stock market at prevailing market prices.

    6. Confirmation & Update: Once the trade is settled, the customer's pension account is updated to reflect the new units purchased and the updated total value, often visible via an online portal or statement.

    For every single step in this service, your organization needs robust capabilities to make these steps visible and resilient to all stakeholders who “work around that service.” This isn't just for IT; it's for compliance, operations, customer service, and even marketing.

    Let's look at the same for a realtor company specializing in rental properties:

    • Service Map for property owners and landlords:

      • Property Listing & Marketing: Creating professional listings, photography, virtual tours, and advertising on various platforms (online portals, social media, and local networks).

      • Tenant Sourcing & Vetting: Conducting viewings, screening potential tenants (credit checks, employment verification, previous landlord references), and background checks.

      • Lease Agreement Management: Drafting, negotiating, and executing legally compliant rental contracts.

      • Property Maintenance & Repairs Coordination: Arranging routine maintenance, coordinating emergency repairs with vetted contractors, and overseeing work quality.

      • Property Inspections: Conducting periodic property inspections (move-in, routine, move-out) to ensure property condition and compliance with lease terms.

      • Compliance & Legal Guidance: Advising on landlord-tenant laws, health & safety regulations, and handling eviction processes if necessary.

      • Security Deposit Management: Collecting, holding, and returning security deposits in accordance with legal requirements.

    • Services for tenants:

      • Property Search & Matching: Assisting prospective tenants in finding suitable properties based on their needs and budget.

      • Viewing Scheduling: Arranging property viewings and providing access.

      • Application Processing: Guiding tenants through the application process and necessary documentation.

      • Lease Onboarding: Explaining lease terms, facilitating key handover, and conducting move-in inspections.

      • Maintenance Request Handling: A clear process for tenants to report maintenance issues and track resolution.

      • Emergency Support: Providing contact points and procedures for urgent property-related emergencies.

      • Lease Renewal & Move-out Support: Managing lease renewals, providing guidance on move-out procedures, and facilitating security deposit returns.

    Many of these will require automated systems. The customer-facing ones even more so. You need to understand the customer journeys for each entry in your service map.

    You need:

    • Comprehensive Monitoring & Alerting: Real-time visibility into every step of the journey, flagging anomalies or delays before they become customer-impacting issues. Build monitoring capabilities into the systems and build the operational capability to follow up on alerts and events. There are now products on the market that can do a lot of the heavy lifting for you. Be prepared to open your wallet. This is not cheap. I hear AI already rolling off the tongues: this is not cheap. For smaller service maps and customer journeys, consider using built-in tools and hiring a small team of people that can leverage the next points. For large institutions, let alone manufacturing, automation and continuous testing are key.

    • Centralized Knowledge Management: A single source of truth for service definitions, processes, dependencies, and known issues, accessible to everyone who needs it. No more tribal knowledge. For condensed setups, it can be as simple as a folder on a hard drive that contains your knowledge base articles (aka Word documents that explain the process, how it was set up, what you need to operate it etc.). Most businesses will use some form of knowledge management system that is a bit more sophisticated, perhaps even built-in to the IT Operations Management (ITOM) tooling. It's a shame it's called IT ops tooling, because you can equally use this for business process documentation. Just remember the last bullet below: DR and BCP. Your knowledge system is useless if you cannot get to it!

    • Robust Development & Operations Processes: Seamless collaboration between development, operations, and business teams to make sure services are built, tested, deployed, and managed efficiently and reliably. It does not really matter if you want to use DevOps, or change/run, or scrum and squads, or anything in between. Pick what works in your culture. Also, it is not one-size-fits-all. Some systems are core and require a more strict regimen; others must be able to turn on a dime. But whatever you use: keep your service and the customer journey through it front and center. Build it so that you have clearly separated “stations” where something is done to fulfill the system. Make the mental analogy with a factory. It will keep each station atomic, so that when the time comes to make changes, you can do so without having to re-invent large parts of the value delivery chain.

    • End-to-End Security Protocols: Protect sensitive customer data and financial transactions at every touchpoint throughout the journey. I mean, duh. You must. This is non-negotiable. This includes your backups. Large or small company, you must maintain backups. Use the 321 method: 3 copies of your data and setups on 2 different platforms or data storage carriers and 1 offsite. Your backups should include at least 1 immutable copy. That is a copy that cannot be altered. Large firms partner with their hosting companies to include that in the service offering; small companies have cheap options. I use 2 separate backup providers (total cost around €100/month at the time of writing in 2025) and my own disconnected storage carriers. I even use a backup provider and disconnected storage for my family's data (around €25/month).

    • Effective Disaster Recovery (DR) & Business Continuity Planning (BCP) Capabilities: Understanding critical service components, their recovery time objectives (RTOs), and recovery point objectives (RPOs) to ensure rapid restoration of service even after major disruptions. This isn't a theoretical exercise; it needs to be tested and proven. Your expectations also need to be realistic.

    There are more elements to consider when building your service map and the customer journeys when it comes to resilience. Things like performance metrics, scalability, peak usage management, and so on. McKinsey wrote years ago, design for the storm, not the sunny days. That is right, but keep the design within the commercial service parameters. It is equally bad to overbuild to a $5 million system, if your expected revenue is less than $100,000 a year, than it is to use a $10,000 system to support a $5 million revenue stream. (I remember the Excel sheet from hell that actually supported a macro-economist at a large brokerage.)

    Start mapping your services today. Start with what you feel are the most critical ones. You'll uncover inefficiencies, mitigate risks, and strengthen the very foundation of your customer relationships. You may even save some money.

    Develop Your Agile Approach for a Successful Transformation

    • Buy Link or Shortcode: {j2store}163|cart{/j2store}
    • member rating overall impact: 9.2/10 Overall Impact
    • member rating average dollars saved: $86,469 Average $ Saved
    • member rating average days saved: 16 Average Days Saved
    • Parent Category Name: Development
    • Parent Category Link: /development
    • Your organization wants to shorten delivery time and improve quality by adopting Agile delivery methods.
    • You know that Agile transformations are complex and difficult to implement.
    • Your organization may have started using Agile, but with only limited success.
    • You want to maximize your Agile transformation’s chances of success.

    Our Advice

    Critical Insight

    • Agile transformations are more likely to be successful when the entire organization understands Agile fundamentals, principles, and practices; the “different way of working” that Agile requires; and the role each person plays in its success.

    Impact and Result

    • Understand the “what and why” of Agile.
    • Identify your organization’s biggest Agile pain points.
    • Gain a deeper understanding of Agile principles and practices, and apply these to your Agile pain points.
    • Create a list of action items to address your organization’s Agile challenges.

    Develop Your Agile Approach for a Successful Transformation Research & Tools

    Besides the small introduction, subscribers and consulting clients within this management domain have access to:

    1. Identify common Agile challenges

    Identify your organization's biggest Agile pain points so you can focus attention on those topics that are impacting your Agile capabilities the most.

    • Develop Your Agile Approach for a Successful Transformation – Phases 1-2

    2. Establish a solid foundation for Agile delivery

    Ensure that your organization has a solid understanding of Agile principles and practices to help ensure your Agile transformation is successful. Understand Agile's different way of working and identify the steps your organization will need to take to move from traditional Waterfall delivery to Agile.

    • Roadmap for Transition to Agile

    3. Backlog Management Module: Manage your backlog effectively

    The Backlog Management Module helps teams develop a better understanding of backlog management and user story decomposition. Improve your backlog quality by implementing a three-tiered backlog with quality filters.

    4. Scrum Simulation Module: Simulate effective Scrum practices

    The Scrum Simulation Module helps teams develop a better understanding of Scrum practices and the behavioral blockers affecting Agile teams and organizational culture. This module features two interactive simulations to encourage a deeper understanding of good Scrum practices and Agile principles.

    • Scrum Simulation Exercise (Online Banking App)

    5. Estimation Module: Improve product backlog item estimation

    The Estimation Module helps teams develop a better understanding of Agile estimation practices and how to apply them. Teams learn how Agile estimation and reconciliation provide reliable planning estimates.

    6. Product Owner Module: Establish an Effective Product Owner Role

    The Product Owner Module helps teams understand product management fundamentals and a deeper understanding of the product owner role. Teams define their product management terminology, create quality filters for PBIs moving through the backlog, and develop their product roadmap approach for key audiences.

    7. Product Roadmapping Module: Create effective product roadmaps

    The Product Roadmapping Module helps teams understand product road mapping fundamentals. Teams learn to effectively use the six tools of Product Roadmapping.

    [infographic]

    Further reading

    Develop Your Agile Approach for a Successful Transformation

    Understand Agile fundamentals, principles, and practices so you can apply them effectively in your organization.

    Analyst Perspective

    Understand Agile fundamentals, principles, and practices so you can apply them effectively in your organization.

    Pictures of Alex Ciraco and Hans Eckman

    Alex Ciraco and Hans Eckman
    Application Practice
    Info-Tech Research Group

    Executive Summary

    Your Challenge

    • Your organization wants to shorten delivery time and improve quality by adopting Agile delivery methods.
    • You know that Agile transformations are complex and difficult to implement.
    • Your organization may have started using Agile, but with only limited success.
    • You want to maximize your Agile transformation's chances of success.

    Common Obstacles

    • People seem to have different, conflicting, or inadequate knowledge of Agile principles and practices.
    • Your organization is not seeing the full benefits that Agile promises, and project teams aren't sure they are "doing Agile right."
    • Confusion and misinformation about Agile is commonplace in your organization.

    Info-Tech's Approach

    • Use our Common Agile Challenges Survey to identify your organization's Agile pain points.
    • Leverage this blueprint to level-set the organization on Agile fundamentals.
    • Address your survey's biggest Agile pain points to see immediate benefits and improvements in the way you practice Agile in your organization.

    Info-Tech Insight

    Agile transformations are more likely to be successful when the entire organization genuinely understands Agile fundamentals, principles and practices, as well as the role each person plays in its success. Focus on developing a solid understanding of Agile practices so your organization can "Be Agile", not just "Do Agile".

    Info-Tech's methodology

    1. Identify Common Agile Challenges

    2. Establish a Solid Foundation for Agile Delivery

    3. Agile Modules

    Phase Steps

    1.1 Identify common agile challenges

    2.1 Align teams with Agile fundamentals

    2.2 Interpret your common Agile challenges survey results

    2.3 (Optional) Move stepwise to iterative Agile delivery

    2.4 Identify insights and team feedback

    • Backlog Management Module:
      Manage Your Backlog Effectively
    • Scrum Simulation Module:
      Simulate Effective Scrum Practices
    • Estimation Module:
      Improve Product Backlog Item Estimation
    • Product Owner Module:
      Establish an Effective Product Owner Role
    • Product Roadmapping Module: Create Effective Product Roadmaps
    Phase Outcomes

    Understand common challenges associated with Agile transformations and identify your organization's struggles.

    Establish and apply a uniform understanding of Agile fundamentals and principles.

    Create a roadmap for your transition to Agile delivery and prioritized challenges.

    Foster deeper understanding of Agile principles and practices to resolve pain points.

    Develop your agile approach for a successful transformation

    Everyone's Agile journey is not the same.

    agile journey for a successful transformation

    Application delivery continues to fall short

    78% of IT professionals believe the business is "usually" or "always" out of sync with project requirements.
    Source: "10 Ways Requirements Can Sabotage Your Projects Right From the Start"

    Only 34% of software is rated as both important and effective by users.

    Source: Info-Tech's CIO Business Vision Diagnostic

    Agile DevOps is a progression of cultural, behavioral, and process changes. It takes time.

    An image of the trail to climb Mount Everest, with the camps replaced by the main steps of the agile approach to reaching Nirvana.

    Enhancements and maintenance are misunderstood

    an image showing the relationship between enhancements and maintenance.

    Source: "IEEE Transactions on Software Engineering"

    Why Agile/DevOps? It's about time to value

    Leaders and stakeholders are frustrated with long lead times to implement changes. Agile/DevOps promotes smaller, more frequent releases to start earning value sooner.

    A frequency graph showing the Time to delivering value depends on Frequency of Releases

    Time to delivering value depends on Frequency of Releases

    Embrace change, don't "scope creep" it

    64% of IT professionals adopt Agile to enhance their ability to manage changing priorities.

    71% of IT professionals found their ability to manage changing priorities improved after implementing Agile.

    Info-Tech Insight

    Traditional delivery processes work on the assumption that product requirements will remain constant throughout the SDLC. This results in delayed delivery of product enhancements which are critical to maintaining a positive customer experience.

    Adapted from: "12th Annual State of Agile Report"

    Agile's four core values

    "…while there is value in the items on the right, we value the items on the left more."
    – Source: "The Agile Manifesto"

    We value. . .

    Individuals and Interactions

    OVER

    Processes and Tools

    Working Software

    OVER

    Comprehensive Documentation

    Customer Collaboration

    OVER

    Contract Negotiation

    Responding to Change

    OVER

    Following a Plan

    Being Agile

    OVER

    Being Prescriptive

    Harness Agile's cultural advantages

    Collaboration

    • Team members leverage all their experience working toward a common goal.

    Iterations

    • Cycles provide opportunities for more product feedback.

    Continual Improvement

    • Self-managing teams continually improve their approach for the next iteration.

    Prioritization

    • The most important needs are addressed in the current iteration.

    Compare Waterfall and Agile – the "what" (how are they different?)

    This is an example of the Waterfall Approach.

    A "One and Done" Approach (Planning & Documentation Based)
    Elapsed time to deliver any value: Months to years

    This is an example of the Agile Approach

    An "Iterative" Approach (Empirical/Evidence Based)
    Elapsed time to deliver any value: Weeks

    Be aware of common myths around Agile

    1. … solve development and communication issues.
    2. … ensure you will finish requirements faster.
    3. … mean you don't need planning and documentation.

    "Although Agile methods are increasingly being adopted in globally distributed settings, there is no panacea for success."
    – "Negotiating Common Ground in Distributed Agile Development: A Case Study Perspective."

    "Without proper planning, organizations can start throwing more resources at the work which spirals into the classic Waterfall issues of managing by schedule."
    – Kristen Morton, Associate Implementation Architect,
    OneShield Inc., Info-Tech Interview

    Agile* SDLC

    With shared ownership instead of silos, we can deliver value at the end of every iteration (aka sprint)

    An image of the Agile SDLC Approach.

    * There are many Agile methodologies to choose from, but Scrum is by far the most widely used (and is shown above).

    Key Elements of the Agile SDLC

    • You are not "one-and-done." There are many short iterations with constant feedback.
    • There is an empowered product owner. This is a single authoritative voice that represents stakeholders.
    • There is a fluid product backlog. This enables prioritization of requirements "just-in-time."
    • Cross-functional, self-managing team. This team makes commitments and is empowered by the organization to do so.
    • Working, tested code at the end of each sprint. Value becomes more deterministic along sprint boundaries.
    • Demonstrate to stakeholders. Allow them to see and use the functionality and provide necessary feedback.
    • Feedback is being continuously injected back into the product backlog. This shapes the future of the solution.
    • Continuous improvement through sprint retrospectives.
    • "Internally Governed" when done right (the virtuous cycle of sprint-demo-feedback).

    A backlog stores and organizes PBIs at various stages of readiness

    A well-formed backlog can be thought of as a DEEP backlog:

    • Detailed Appropriately: Product backlog items (PBIs) are broken down and refined as necessary.
    • Emergent: The backlog grows and evolves over time as PBIs are added and removed.
    • Estimated: The effort a PBI requires is estimated at each tier.
    • Prioritized: The PBIs value and priority are determined at each tier.

    (Perforce, 2018)

    An image showing the Ideas; Qualified; Ready; funnel leading to the sprint approach.

    Outline the criteria to proceed to the next tier via quality filters

    Expand the concepts of defining "ready" and "done" to include the other stages of a PBIs journey through product planning.

    An image showing the approach you will use to Outline the criteria to proceed to the next tier via quality filters

    Info-Tech Insight: A quality filter ensures quality is met and teams are armed with the right information to work more efficiently and improve throughput.

    Deliverables

    Many steps in this blueprint are accompanied by supporting deliverables to help you accomplish your goals.

    Common Agile Challenges Survey
    Survey the organization to understand which of the common Agile challenges the organization is experiencing

    A screenshot from Common Agile Challenges Survey

    Roadmap for Transition to Agile
    Identify steps you will take to move your organization toward Agile delivery

    A screenshot from Roadmap for Transition to Agile

    Blueprint benefits

    IT Benefits

    Business Benefits

    • Consistent Agile delivery teams.
    • Delivery prioritized with business needs and committed work is achievable.
    • Improved ability to adjust future delivery cycles to meet changing business, market, and end-user needs.
    • Increased alignment and stability of resources with products and technology areas.
    • Reduction in the mean time to delivery of product backlog items.
    • Reduction in technical debt.
    • Better delivery alignment with enterprise goals, vision, and outcomes.
    • Improved coordination with product owners and stakeholders.
    • Quantifiable value realization following each release.
    • Product decisions made at the right time and with the right input.
    • Improved team morale and productivity.
    • Improved operational efficiency and process automation.
    • Increased employee retention and quality of new hires.
    • Reduction in accumulated project risk.

    Measure the value of this blueprint

    Implementing quality and consistent Agile practices improves SDLC metrics and reduces time to value.

    • Use Select and Use SDLC Metrics Effectivelyto track and measure the impact of Agile delivery. For example:
      • Reduction in PBI wait time
      • Improve throughput
      • Reduction in defects and defect severity
    • Phase 1 helps you prepare and send your Common Agile Challenges Survey.
    • Phase 2 builds a transformation plan aligned with your top pain points.

    Align Agile coaching and practices to address your key pain points identified in the Common Agile Challenges Survey.

    A screenshot from Common Agile Challenges Survey

    Info-Tech offers various levels of support to best suit your needs

    DIY Toolkit

    "Our team has already made this critical project a priority, and we have the time and capability, but some guidance along the way would be helpful."

    Guided Implementation

    "Our team knows that we need to fix a process, but we need assistance to determine where to focus. Some check-ins along the way would help keep us on track."

    Workshop

    "We need to hit the ground running and get this project kicked off immediately. Our team has the ability to take this over once we get a framework and strategy in place."

    Consulting

    "Our team does not have the time or the knowledge to take this project on. We need assistance through the entirety of this project."

    Diagnostics and consistent frameworks used throughout all four options

    Guided Implementation

    What does a typical GI on this topic look like?

    This is an image of the eight calls which will take place over phases 1-3.

    A Guided Implementation (GI) is a series of calls with an Info-Tech analyst to help implement our best practices in your organization.

    A typical GI is between 6 to 8 calls over the course of 1 to 2 months.

    Workshop Overview

    Contact your account representative for more information.
    workshops@infotech.com 1-888-670-8889

    Phases 1-2
    1.5 - 3.0 days estimated

    Backlog Management
    0.5 - 1.0 days estimated

    Scrum Simulation
    1.25 - 2.25 days estimated

    Estimation
    1.0 - 1.25 days estimated

    Product Owner
    1.0 - 1.75 days estimated

    Product Roadmapping
    0.5 - 1.0 days estimated

    Establish a Solid Foundation for Agile Delivery

    Define the
    IT Target State

    Assess the IT
    Current State

    Bridge the Gap and
    Create the Strategy

    Establish an Effective Product Owner Role

    Create Effective Product Roadmaps

    Activities

    1.1 Gather Agile challenges and gaps
    2.1 Align teams with Agile fundamentals
    2.2 Interpret your common Agile challenges survey results
    2.3 (Optional) Move stepwise to iterative Agile delivery
    2.4 Identify insights and team feedback

    1. User stories and the art of decomposition
    2. Effective backlog management and refinement
    3. Identify insights and team feedback
    1. Scrum sprint planning and retrospective simulation
    2. Pass the balls – sprint velocity game
    1. Improve product backlog item estimation
    2. Agile estimation fundamentals
    3. Understand the wisdom of crowds
    4. Identify insights and team feedback
    1. Understand product management fundamentals
    2. The critical role of the product owner
    3. Manage effective product backlogs and roadmaps
    4. Identify insights and team feedback
    1. Identify your product roadmapping pains
    2. The six "tools" of product roadmapping
    3. Product roadmapping exercise

    Deliverables

    1. Identify your organization's biggest Agile pain points.
    2. Establish common Agile foundations.
    3. Prioritize support for a better Agile delivery approach.
    4. Plan to move stepwise to iterative Agile delivery.
    1. A better understanding of backlog management and user story decomposition.
    1. Scrum sprint planning and retrospective simulation
    2. Pass the balls – sprint velocity game
    1. Improve product backlog item estimation
    2. Agile estimation fundamentals
    3. Understand the wisdom of crowds
    4. Identify insights and team feedback
    1. Understand product management fundamentals
    2. The critical role of the product owner
    3. Manage effective product backlogs and roadmaps
    4. Identify insights and team feedback
    1. Understand product vs. project orientation.
    2. Understand product roadmapping fundamentals.

    Agile Modules

    For additional assistance planning your workshop, please refer to the facilitation planning tool in the appendix.

    Related Info-Tech Research

    Mentoring for Agile Teams
    Get practical help and guidance on your Agile transformation journey.

    Implement DevOps Practices That Work
    Streamline business value delivery through the strategic adoption of DevOps practices.

    Deliver on Your Digital Product Vision
    Build a product vision your organization can take from strategy through execution.

    Deliver Digital Products at Scale
    Deliver value at the scale of your organization through defining enterprise product families.

    Phase 1

    Phase 1

    Phase 2

    Agile Modules

    1.1 Identify common Agile challenges

    2.1 Align teams with Agile fundamentals

    2.2 Interpret your common Agile challenges survey results

    2.3 (Optional) Move stepwise to iterative Agile delivery

    2.4 Identify insights and team feedback

    • Backlog Management Module: Manage Your Backlog Effectively
    • Scrum Simulation Module: Simulate Effective Scrum Practices
    • Estimation Module: Improve Product Backlog Item Estimation
    • Product Owner Module: Establish an Effective Product Owner Role
    • Product Roadmapping: Create Effective Product Roadmaps

    This phase will walk you through the following activities:

    • Decide who will participate in the Common Agile Challenges Survey
    • Compile the results of the survey to identify your organization's biggest pain points with Agile

    This phase involves the following participants:

    • Product owners, product managers, and scrum masters
    • Delivery managers and senior leaders
    • Stakeholders and delivery teams

    Develop Your Agile Approach for a Successful Transformation

    Step 1.1

    Identify common Agile challenges

    Activities

    1.1 Distribute Common Agile Challenges Survey and collect results

    This step involves the following participants:

    • Product owners, product managers, and scrum masters
    • Delivery managers and senior leaders
    • Stakeholders and delivery teams

    Outcomes of this step

    • A better understanding of your organization's Agile pain points.

    Focus Agile support where it is most needed

    A screenshot from Common Agile Challenges Survey

    Info-Tech Insight

    There isn't one approach that cures all the problems your Agile teams are facing. First, understand these common challenges, then develop a plan to address the root causes.

    Use Info-Tech's Common Agile Challenges Survey to determine common issues and what problems individual teams are facing. Use the Agile modules and supporting guides in this blueprint to provide targeted support on what matters most.

    Exercise 1.1.1 Distribute Common Agile Challenges Survey

    30 minutes

    1. Download Survey Template: Info-Tech Common Agile Challenges Survey template.
    2. Create your own local copy of the Common Agile Challenges Survey by using the template. The Common Agile Challenges Survey will help you to identify which of the many common Agile-related challenges your organization may be facing.
    3. Decide on the teams/participants who will be completing the survey. It is best to distribute the survey broadly across the organization and include participants from several teams and roles.
    4. Copy the link for your local survey and distribute it for participants to complete (we suggest giving them one week to complete it).
    5. Collect the consolidated survey results in preparation for the next phase.
    6. NOTE: Using this survey template requires having access to Microsoft Forms. If you do not have access to Microsoft Forms, an Info-Tech analyst can perform the survey for you.

    Output

    • Your organization's biggest Agile pain points

    Participants

    • Product owners, product managers, and scrum masters
    • Delivery managers
    • Delivery teams
    • Stakeholders
    • Senior leaders

    Record the results in the Roadmap for Transition to Agile Template

    Phase 2

    Establish a Solid Foundation for Agile Delivery

    Phase 1

    Phase 2

    Agile Modules

    1.1 Identify common Agile challenges

    2.1 Align teams with Agile fundamentals

    2.2 Interpret your common Agile challenges survey results

    2.3 (Optional) Move stepwise to iterative Agile delivery

    2.4 Identify insights and team feedback

    • Backlog Management Module: Manage Your Backlog Effectively
    • Scrum Simulation Module: Simulate Effective Scrum Practices
    • Estimation Module: Improve Product Backlog Item Estimation
    • Product Owner Module: Establish an Effective Product Owner Role
    • Product Roadmapping: Create Effective Product Roadmaps

    This phase will walk you through the following activities:

    • Gain a fundamental understanding of Agile
    • Understand why becoming Agile is hard
    • Identify steps needed to become more Agile
    • Understand your biggest Agile pain points

    This phase involves the following participants:

    • Product owners, product managers, and scrum masters
    • Delivery managers and senior leaders
    • Stakeholders and delivery teams

    Step 2.1

    Align teams with Agile fundamentals

    Activities

    2.1.1 Share what Agile means to you
    2.1.2 (Optional) Contrast two delivery teams
    2.1.3 (Optional) Dissect the Agilist's Oath
    2.1.4 (Optional) Create your prototype definitions of ready
    2.1.5 (Optional) Create your prototype definitions of done
    2.1.6 Identify the challenges of implementing agile in your organization

    This step involves the following participants:

    • Product owners, product managers, and scrum masters
    • Delivery managers and senior leaders
    • Stakeholders and delivery teams

    Outcomes of this step

    • A better understanding of what Agile is and why we do it.

    Exercise 2.1.1 Share what Agile means to you

    30-60 minutes

    1. What is Agile? Why do we do it?
    2. As a group, discuss and capture your thoughts on:
      1. What is Agile (its characteristics, practices, differences from alternatives, etc.)?
      2. Why do we do it (its drivers, benefits, advantages, etc.)?
    3. Capture your findings in the table below:

    What is Agile?

    Why do we do it?

    (e.g. Agile mindset, principles, and practices)

    (e.g. benefits)

    Output

    • Your current understanding of Agile and its benefits

    Participants

    • Product owners, product managers, and scrum masters
    • Delivery managers
    • Delivery teams
    • Stakeholders
    • Senior leaders

    Why Agile/DevOps? It's about time to value

    Leaders and stakeholders are frustrated with long lead times to implement changes. Agile/DevOps promotes smaller, more frequent releases to start earning value sooner.

    A graph demonstrating the increased frequency of release expected over time, from 1960 - present

    Time to delivering value depends on frequency of releases.
    Source: 5Q Partners

    The pandemic accelerated the speed of digital transformation

    With the massive disruption preventing people from gathering, businesses shifted to digital interactions with customers.

    December 2019 - 36%; acceleration of 3 years; July 2020 - 58%.

    Companies also accelerated the pace of creating digital or digitally enhanced products and services.

    December 2019 - 35%; acceleration of 3 years; July 2020 - 55%.

    (McKinsey, 2020 )

    "The Digital Economy incorporates all economic activity reliant on or significantly enhanced by the use of digital inputs, including digital technologies, digital infrastructure, digital services and data."
    (OECD Definition)

    What does "elite" DevOps look like?

    This is an image of an annotated table showing what elite devops looks like.

    Where are you now?
    Where do You Want to Be?

    * Google Cloud/Accelerate State of DevOps 2021

    Realize and sustain value with DevOps

    Businesses with elite DevOps practices…

    973x more frequent faster lead time code deployments from commit to deploy, 3x 6570x lower change failure rate faster time to recover.

    Waterfall vs. Agile – the "what" (How are they different?)

    This is an example of the Waterfall Approach.

    A "One and Done" Approach (Planning & Documentation Based)
    Elapsed time to deliver any value: Months to years

    This is an example of the Agile Approach

    An "Iterative" Approach (Empirical/Evidence Based)
    Elapsed time to deliver any value: Weeks

    (Optional) Exercise 2.1.2 A tale of two teams

    Discussion (5-10 minutes)

    As a group, discuss how these teams differ

    Team 1:
    An image of the business analyst passing the requirements baton to the architect runner.

    Team 2:
    An image of team of soldiers carrying a heavy log up a beach

    Image Credit: DVIDS

    Discuss differences between these teams:
    • How are they different?
    • How would you coach/train/manage/lead?
    • How does team members' behavior differ?
    • How would you measure each team?
    What would have to happen at your organization to make working like this possible?

    Output

    • How your organization can support Agile behavior and mindset

    Participants

    • Product owners, product managers, and scrum masters
    • Delivery managers
    • Delivery teams
    • Stakeholders
    • Senior leaders

    Dissect the Agilist's Oath

    Read and consider each element of the oath.

    • As a member of this Scrum team, I recognize that we are all equally and collectively responsible for the success of this project.
    • Success is defined as achieving the best possible outcome for our stakeholders given the constraints of time, money, and circumstances we will face.
    • We will achieve this by working collaboratively with our product owner to regularly deliver high-quality, working, tested code that can be demonstrated, and we will adjust our path forward based on the feedback we receive.
    • I will holistically embrace the concept of "good enough for now" into my work practices, because I know that waiting for the best/perfect solution does not yield optimal results.
    • Collectively, we will work to holistically minimize risk for the project across all phases and disciplines.
    • My primary role will be _____ [PO, SM, BA, Dev, Arch, Test, Ops, etc.], but I will contribute wherever and however best serves the current needs of the project.
    • I recognize that working in Agile/Scrum is not an excuse to ignore important things like adequate design and documentation. Collectively, we will ensure that these things are completed incrementally to a level of detail and quality which adequately serves the organization and stakeholders.
    • We are a team, and we will succeed or fail as one.

    Exercise 2.1.3 (Optional) Dissect the Agilist's Oath

    30 minutes

    1. Each bullet point in the Agilist's Oath is chosen to convey one of eight key messages about Agile practices and the mindset change that's required by everyone involved.
    2. As a group, discuss the "message" for each bullet point in the Agilist's Oath. Then identify which of them would be "easy" and "hard" to achieve in your organization.
    • As a member of this Scrum team, I recognize that we are all equally and collectively responsible for the success of this project.
    • Success is defined as achieving the best possible outcome for our stakeholders given the constraints of time, money, and circumstances we will face.
    • We will achieve this by working collaboratively with our product owner to regularly deliver high-quality, working, tested code that can be demonstrated, and we will adjust our path forward based on the feedback we receive.
    • I will holistically embrace the concept of "good enough for now" into my work practices, because I know that waiting for the best/perfect solution does not yield optimal results.
    • Collectively, we will work to holistically minimize risk for the project across all phases and disciplines.
    • My primary role will be _____ [PO, SM, BA, Dev, Arch, Test, Ops, etc.], but I will contribute wherever and however best serves the current needs of the project.
    • I recognize that working in Agile/Scrum is not an excuse to ignore important things like adequate design and documentation. Collectively, we will ensure that these things are completed incrementally to a level of detail and quality which adequately serves the organization and stakeholders.
    • We are a team, and we will succeed or fail as one.

    Which aspects of the Agilist's Oath are "easy" in your org?

    Which aspects of the Agilist's Oath are "hard" in your org?

    Output

    • How your organization can support Agile behavior and mindset

    Participants

    • Product owners, product managers, and scrum masters
    • Delivery managers
    • Delivery teams
    • Stakeholders
    • Senior leaders

    Be aware of common myths around Agile

    Agile does not . . . .

    1. … solve development and communication issues.
    2. … ensure you will finish requirements faster.
    3. … mean you don't need planning and documentation.

    "Although Agile methods are increasingly being adopted in globally distributed settings, there is no panacea for success."
    – "Negotiating Common Ground in Distributed Agile Development: A Case Study Perspective."

    "Without proper planning, organizations can start throwing more resources at the work which spirals into the classic Waterfall issues of managing by schedule."
    – Kristen Morton, Associate Implementation Architect,
    OneShield Inc., Info-Tech Interview

    Agile's four core values

    "…while there is value in the items on the right, we value the items on the left more."
    – Source: "The Agile Manifesto"

    We value. . .

    Individuals and Interactions

    OVER

    Processes and Tools

    Working Software

    OVER

    Comprehensive Documentation

    Customer Collaboration

    OVER

    Contract Negotiation

    Responding to Change

    OVER

    Following a Plan

    Being Agile

    OVER

    Being Prescriptive

    Consider the traditional/Waterfall SDLC

    With siloes and handoffs, valuable product is delivered only at the end of an extended project lifecycle.

    This is an image of the Traditional Waterfall SDLC approach

    View additional transition models in the appendix

    Agile* SDLC

    With shared ownership instead of silos, we can deliver value at the end of every iteration (aka sprint)

    Key Elements of the Agile SDLC

    • You are not "one-and-done". There are many short iterations with constant feedback.
    • There is an empowered product owner. This is a single authoritative voice that represents stakeholders.
    • There is a fluid product backlog. This enables prioritization of requirements "just-in-time"
    • Cross-functional, self-managing team. This team makes commitments and is empowered by the organization to do so.
    • Working, tested code at the end of each sprint. Value becomes more deterministic along sprint boundaries.
    • Demonstrate to stakeholders. Allow them to see and use the functionality and provide necessary feedback.
    • Feedback is being continuously injected back into the product backlog. This shapes the future of the solution.
    • Continuous improvement through sprint retrospectives.
    • "Internally Governed" when done right (the virtuous cycle of sprint-demo-feedback).

    This is a picture of the Agile SDLC approach.

    * There are many Agile methodologies to choose from, but Scrum (shown above) is by far the most widely used.

    Scrum roles and responsibilities

    Product Owner

    Scrum Master

    Team Members

    Responsible

    • For identifying the product features and their importance in the final deliverable.
    • For refining and reprioritizing the backlog that identifies which features will be delivered in the next sprint based on business importance.
    • For clearing blockers and escalations when necessary.
    • For leading scrums, retrospectives, sprint reviews, and demonstrations.
    • For team building and resolving team conflicts.
    • For creating, testing, deploying, and supporting deliverables and valuable features.
    • For self-managing. There is no project manager assigning tasks to each team member.

    Accountable

    • For delivering valuable features to stakeholders.
    • For ensuring communication throughout development.
    • For ensuring high-quality deliverables for the product owner.

    Consulted

    • By the team through collaboration, rather than contract negotiation.
    • By the product owner on resolution of risks.
    • By the team on suggestions for improvement.
    • By the scrum master and product owner during sprint planning to determine level of complexity of tasks.

    Informed

    • On the progress of the current sprint.
    • By the team on work completed during the current sprint.
    • On direction of the business and current priorities.

    Scrum ceremonies

    Are any of these challenges for your organization? Done When:

    Project Backlog Refinement (PO & SM): Prepare user stories to be used in the next two to three future sprints. User stories are broken down into small manageable pieces of work that should not span sprints. If a user story is too big for a sprint, it is broken down further here. The estimation of the user story is examined, as well as the acceptance criteria, and each is adjusted as necessary from the Agile team members' input.

    Regularly over the project's lifespan

    Sprint Planning (PO, SM & Delivery Team): Discuss the work for the upcoming sprint with the business. Establish a clear understanding of the expectations of the team and the sprint. The product owner decides if priority and content of the user stories is still accurate. The development team decides what they believe can be completed in the sprint, using the user stories, in priority order, refined in backlog refinement.

    At/before the start of each sprint

    Daily Stand-Up (SM & Delivery Team): Coordinate the team to communicate progress and identify any roadblocks as quickly as possible. This meeting should be kept to fifteen minutes. Longer conversations are tabled for a separate meeting. These are called "stand-ups" because attendees should stay standing for the duration, which helps keep the meeting short and focused. The questions each team member should answer at each meeting: What did I do since last stand-up? What will I do before the next stand-up? Do I have any roadblocks?

    Every day during the sprint

    Sprint Demo (PO, SM, Delivery Team & Stakeholders): Review and demonstrate the work completed in the sprint with the business (demonstrate working and tested code which was developed during the sprint and gather stakeholder feedback).

    At the end of each sprint

    Sprint Retrospective (SM & Delivery Team & PO): Discuss how the sprint worked to determine if anything can be changed to improve team efficiency. The intent of this meeting is not to find/place blame for things that went wrong, but instead to find ways to avoid/alleviate pain points.

    At the end of each sprint

    Sample delivery sprint calendar

    The following calendar illustrates a two-week Scrum cadence (including ceremonies). This diagram is for illustrative purposes only. The length of the sprint and timing of ceremonies may differ from delivery team to delivery team based on their needs and schedules.

    An image of a sample sprint delivery calendar

    Sample delivery sprint calendar

    The following calendar illustrates a three-week Scrum cadence (including ceremonies). This diagram is for illustrative purposes only. The length of the sprint and timing of ceremonies may differ from delivery team to delivery team based on their needs and schedules.

    An image of a sample sprint delivery calendar

    Ensure your teams have the right information

    Implement and enforce your definition of ready at each stage of planning. Ensure your teams understand the required tasks by clarifying the definition of done.*

    Ready

    Done
    • The request has a defined problem, and the value is understood.
    • The request is documented, and the owner is identified.
    • Business and IT roles are committed to participating in estimation and planning activities.
    • Estimates and plans are made and validated with IT teams and business representatives.
    • Stakeholders and decision makers accept the estimates and plans as well as the related risks.
    • Estimates and plans are documented and slated for future review.

    * Note that your definitions of ready and done may vary from project to project, and they should be decided on collectively by the delivery team at the beginning of the project (part of setting their "norms") and updated if/when needed.

    Exercise 2.1.4 (Optional) Create definition of ready and done for an oil change

    10-15 minutes

    Step 1:

    1. As a group, create a definition of ready and done for doing an oil change (this will help you to understand the nature and value of a definition of ready and done using a relatable example):

    Definition of Ready

    Checklist:

    Definition of Done

    Checklist – For each user story:

    The checklist of things that must be true/done to begin the oil change.

    • We have the customer's car and keys
    • We know which grade of oil the customer wants

    The checklist of things that must be true/done at the end of the oil change.

    • The oil has been changed
    • A reminder sticker has been placed on windshield

    Exercise 2.1.4 (Optional) Create your prototype definitions of ready

    30-60 minutes

    Step 2:

    1. As a group, review the two sample definitions of ready below and select the one you consider to be the best starting point for your prototype definition of ready.

    Definition of Ready SAMPLE 1:

    Checklist – For each user story:

    • Technical and business risks are identified.
    • Resources are available for development.
    • Story has been assigned to a sprint/iteration.
    • Organizational business value is defined.
    • A specific user has been identified.
    • Stakeholders and needs defined.
    • Process impacts are identified.
    • Data needs are defined.
    • Business rules and non-functional requirements are identified.
    • Acceptance criteria are ready.
    • UI design work is ready.
    • Story has been traced to the project, epic, and sprint goal.

    Definition of Ready SAMPLE 2:

    Checklist – For each user story:

    • The value of story to the user is clearly indicated.
    • The acceptance criteria for story have been clearly described.
    • User story dependencies identified.
    • User story sized by delivery team.
    • Scrum team accepts user experience artifacts.
    • Performance criteria identified, where appropriate.
    • Person who will accept the user story is identified.
    • The team knows how to demo the story.

    Output

    • Prototype definitions of ready and done for your organization

    Participants

    • Product owners, product managers, and scrum masters
    • Delivery managers
    • Delivery teams
    • Stakeholders
    • Senior leaders

    Exercise 2.1.4 (Optional) Create your prototype definitions of ready

    30-60 minutes

    Step 3:

    1. As a group, using the selected sample as your starting point, decide what changes need to be made (keep/add/delete/modify):

    Definition of Ready Checklist – For each user story:

    Disposition

    The value of story to the user is clearly indicated.

    Keep as is

    The acceptance criteria for story have been clearly described. Keep as is
    User story dependencies identified. Modify to: "Story has been traced to the project, epic, and sprint goal"
    User story sized by delivery team. Modify to: "User Stories have been sized by the Delivery team using Story Points"
    Scrum team accepts user experience artifacts. Keep as is
    Performance criteria identified, where appropriate. Keep as is
    Person who will accept the user story is identified.

    Delete

    The team knows how to demo the story. Keep as is

    Add: "Any performance related criteria have been identified where appropriate"

    Add: "Any data model related changes have been identified where needed"

    Output

    • Prototype definitions of ready and done for your organization

    Participants

    • Product owners, product managers, and scrum masters
    • Delivery managers
    • Delivery teams
    • Stakeholders
    • Senior leaders

    Exercise 2.1.4 (Optional) Create your prototype definitions of ready

    30-60 minutes

    Step 4:

    1. As a group, capture and agree on your prototype definition of ready*:

    Definition of Ready

    Checklist – For each user story:

    User stories and related requirements contain clear descriptions of what is expected of a given functionality. Business value is identified.

    • The value of the story to the user is clearly indicated.
    • The acceptance criteria for the story have been clearly described.
    • Story has been traced to the project, epic, and sprint goal.
    • User stories have been sized by the delivery team using story points.
    • Scrum team accepts user experience artifacts.
    • Performance criteria identified, where appropriate.
    • The team knows how to demo the story.
    • Any performance-related criteria have been identified where appropriate.
    • Any data-model-related changes have been identified where needed.

    Record the results in the Roadmap for Transition to Agile Template

    * This checklist helps Agile teams determine if the stories in their backlog are ready for sprint planning. As your team gains experience with Agile, tailor this list to your needs and follow it until the practice becomes second nature.

    Output

    • Prototype definitions of ready and done for your organization

    Participants

    • Product owners, product managers, and scrum masters
    • Delivery managers
    • Delivery teams
    • Stakeholders
    • Senior leaders

    Exercise 2.1.5 (Optional) Create your prototype definitions of done

    30-60 minutes

    Step 5:

    1. As a group, review the two sample definitions of ready below and select the one you consider to be the best starting point for your prototype definition of ready:

    SAMPLE 1:

    Definition of Done Checklist – For each user story:

    • Design complete
    • Code compiles
    • Static code analysis has been performed and passed
    • Peer reviewed with coding standards passed
    • Code merging completed
    • Unit tests and smoke tests are done/functional (preferably automated)
    • Meets the steps identified in the user story
    • Unit & QA test passed
    • Usability testing completed
    • Passes functionality testing including security testing
    • Data validation has been completed
    • Ready to be released to the next stage

    SAMPLE 2:

    Definition of Done Checklist – For each user story:

    • Work was completed in a way that a professional would say they are satisfied with their work.
    • Work has been seen by multiple team members.
    • Work meets the criteria of satisfaction described by the customer.
    • The work is part of a package that will be shared with the customer as soon as possible.
    • The work and any learnings from doing the work have been documented.
    • Completion of the work is known by and visible to all team members.
    • The work has passed all quality, security, and completeness checks as defined by the team.

    Output

    • Prototype definitions of ready and done for your organization

    Participants

    • Product owners, product managers, and scrum masters
    • Delivery managers
    • Delivery teams
    • Stakeholders
    • Senior leaders

    Exercise 2.1.4 (Optional) Create your prototype definitions of done

    30-60 minutes

    Step 6:

    1. As a group, using the selected sample as your starting point, decide what changes need to be made (keep/add/delete/modify):

    Definition of Ready Checklist – For each user story:

    Disposition

    • Work was completed in a way that a professional would say they are satisfied with their work.
    Keep as is
    • Work has been seen by multiple team members.
    Delete
    • Work meets the criteria of satisfaction described by the customer.
    Modify to: "All acceptance criteria for the user story have been met"
    • The work is a part of a package that will be shared with the customer as soon as possible.
    Modify to: "The user story is ready to be demonstrated to Stakeholders"
    • The work and any learnings from doing the work has been documented.
    Keep as is
    • Completion of the work is known by and visible to all team members.
    Keep as is
    • The work has passed all quality, security, and completeness checks as defined by the team.
    Modify to: "Unit, smoke and regression testing has been performed (preferably automated), all tests were passed"
    Add: "Any performance related criteria associated with the story have been met"

    Output

    • Prototype definitions of ready and done for your organization

    Participants

    • Product owners, product managers, and scrum masters
    • Delivery managers
    • Delivery teams
    • Stakeholders
    • Senior leaders

    Exercise 2.1.4 (Optional) Create your prototype definitions of done

    30-60 minutes

    Step 7:

    1. As a group, capture and agree on your prototype Definition of Done*:

    Definition of Done

    Checklist – For each user story:

    When the user story is accepted by the product owner and is ready to be released.

    • Work was completed in a way that a professional would say they are satisfied with their work.
    • All acceptance criteria for the user story have been met.
    • The user story is ready to be demonstrated to stakeholders.
    • The work and any learnings from doing the work have been documented.
    • Completion of the work is known by and visible to all team members.
    • Unit, smoke, and regression testing has been performed (preferably automated), and all tests were passed.
    • Any performance-related criteria associated with the story have been met.

    Record the results in the Roadmap for Transition to Agile Template

    * This checklist helps Agile teams determine if the stories in their backlog are ready for sprint planning. As your team gains experience with Agile, tailor this list to your needs and follow it until the practice becomes second nature.

    Output

    • Prototype definitions of ready and done for your organization

    Participants

    • Product owners, product managers, and scrum masters
    • Delivery managers
    • Delivery teams
    • Stakeholders
    • Senior leaders

    Getting to "Agile DevOps Nirvana" is hard, but it's worth it.

    An image of the trail to climb Mount Everest, from camps 1-4

    Agile DevOps is a progression of cultural, behavioral, and process changes.
    It takes time.

    An image of the trail to climb Mount Everest, with the camps replaced by the steps to deploy Agile, to reach Agile/Devops Nirvana

    Agile DevOps may be hard, but it's worth it…

    It turns out Waterfall is not as good at reducing risk and ensuring delivery after all.

    CHAOS RESOLUTION BY AGILE VERSUS WATERFALL
    Size Method Successful Challenged Failed
    All Size Projects Agile 39% 52% 9%
    Waterfall 11% 60% 29%

    Standish Group; CHAOS REPORT 2015

    "I believe in this [Waterfall] concept, but the implementation described above is risky and invites failure."

    – Winston W. Royce

    Compare Waterfall to Agile

    Waterfall

    Agile

    Roles and Responsibilities

    Silo your resources

    Defined/segregated responsibilities

    Handoffs between siloes via documents

    Avoid siloes

    Collective responsibility

    Transitions instead of handoffs

    Belief System

    Trust the process

    Assign tasks to individuals

    Trust the delivery team

    Assign ownership/responsibilities to the team

    Planning Approach

    Create a detailed plan before work begins

    Follow the plan

    High level planning only

    The plan evolves over project lifetime

    Delivery Approach

    One and done (big bang delivery at end of project)

    Iterative delivery (regularly demonstrate working code)

    Governance Approach

    Phases and gates

    Artifacts and approvals

    Demo working tested code and get stakeholder feedback

    Support delivery team and eliminate roadblocks

    Approach to Stakeholders

    Involved at beginning and end of project

    "Arm's length" relationship with delivery team

    Involved throughout project (sprint by sprint)

    Closely involved with delivery team (through full time PO)

    Approach to Requirements/Scope

    One-time requirements gathering at start of project

    Scope is fixed at beginning of project ("carved in stone")

    On going requirements gathering and refinement over time

    Scope is roughly determined at beginning (expect change)

    Approach to Changing Requirements

    Treats change like it is "bad"

    Onerous CM process (discourages change)

    Scope changes "require approval" and are disruptive

    Accepts change as natural part of development.

    Light Change Management process (change is welcome)

    Scope changes are handled like all changes

    Hybrid SDLC: Wagile/Agilfall/WaterScrumFall

    Valuable product delivered in multiple releases

    A picture of a hybrid waterfall - Agile approach.

    If moving directly from Waterfall to Agile is too much for your organization, this can be a valuable interim step (but it won't give you the full benefits of Agile, so be careful about getting stuck here).

    Exercise 2.1.6 Identify the challenges of implementing Agile in your organization

    30-60 minutes

    1. As a group, discuss:
      1. Why being Agile may be difficult in your organization?
      2. What are some of the roadblocks and speed bumps you may face?
      3. What incremental steps might the organization take toward becoming Agile?

    Record the results in the Roadmap for Transition to Agile Template

    Output

    • Why being Agile is hard in your organization

    Participants

    • Product owners, product managers, and scrum masters
    • Delivery managers
    • Delivery teams
    • Stakeholders
    • Senior leaders

    Step 2.2

    Align teams with Agile fundamentals

    Activities

    2.2.1 Review the results of your Common Agile Challenges Survey (30-60 minutes)
    2.2.2 Align your support with your top five challenges

    This step involves the following participants:

    • Product owners, product managers, and scrum masters
    • Delivery managers and senior leaders
    • Stakeholders and delivery teams

    Outcomes of this step

    • Identify your organization's biggest Agile pain points.

    Be aware of common Agile challenges

    The road to Agile is filled with potholes, speedbumps, roadblocks, and brick walls!

    1. Establish an effective product owner role (PO)
    2. Uncertainty about minimum viable product (MVP)
    3. How non-Agile teams (like architecture, infosec, operations, etc.) work with Agile teams
    4. Project governance/gating process
    5. What is the role of a PM/PMO in Agile?
    6. How to budget/plan Agile projects
    7. How to contract and work with an Agile vendor
    8. An Agile skills deficit (e.g. new-to-Agile teams who have difficulty "doing Agile right")
    9. General resistance to change in the organization
    10. Lack of Agile training, piloting, and coaching
    11. Different Agile approaches are used by different teams
    12. Backlog management and user story decomposition challenges
    13. Quality assurance challenges
    14. Hierarchical management practices and organization boundaries
    15. Difficulty with establishing autonomous Agile teams
    16. Lack of management support for Agile
    17. Poor Agile estimation practices
    18. Difficulty creating effective product roadmaps in Agile
    19. How do we know when an Agile project is ready to go live?
    20. Sprint goals are not being consistently met, or sprint deliverables that are full of bugs

    Exercise 2.2.1 Review the results of your Common Agile Challenges Survey

    30-60 minutes

    1. Using the results of your Common Agile Challenges Survey, fill in the bar chart with your top five pain points:

    A screenshot from Common Agile Challenges Survey

    Output

    • Your organization's biggest Agile pain points identified and prioritized

    Participants

    • Product owners, product managers, and scrum masters
    • Delivery managers
    • Delivery teams
    • Stakeholders
    • Senior leaders

    Exercise 2.2.2 Align your support with your top five challenges

    30 minutes

    Using the Agile Challenges support mapping on the following slides, build your transformation plan and supporting resources. You can build your plan by individual team results or as an enterprise approach.

    Priority Agile Challenge Module Name and Sequence
    1
    1. Agile Foundations
    2. ?
    2
    1. Agile Foundations
    2. ?
    3
    1. Agile Foundations
    2. ?
    4
    1. Agile Foundations
    2. ?
    5
    1. Agile Foundations
    2. ?

    Output

    • Your organization's Agile Challenges transformation plan

    Participants

    • Product owners, product managers, and scrum masters
    • Delivery managers
    • Delivery teams
    • Stakeholders
    • Senior leaders

    Map challenges to supporting modules

    Agile Challenges

    Supporting Resources

    Difficulty establishing an effective product owner (PO) or uncertainty about the PO role

    Modules:

    • Agile Foundations
    • Establish an Effective Product Owner Role
    Uncertainty about minimum viable product (MVP) and how to identify your MVP

    Modules:

    • Agile Foundations
    • Simulate Effective Scrum Practices
    How non-Agile teams (like architecture, info sec, operations, etc.) work with Agile teams

    Modules:

    • Agile Foundations
    • Work With Non-Agile Teams (Future)
    Project Governance/Gating processes that are unfriendly to Agile

    Modules:

    • Agile Foundations
    • Establish Agile-Friendly Gating (Future)
    Uncertainty about the role of a PM/PMO in Agile

    Modules:

    • Agile Foundations
    • Understand the role of PM/PMO in Agile Delivery (Future)
    Uncertainty about how to budget/plan Agile projects

    Modules:

    • Agile Foundations
    • Simulate Effective Scrum Practices
    • Understand Budgeting and Funding for Agile Delivery (Future)
    Creating an Agile friendly RFP/Contract (e.g. how to contract and work with an Agile vendor)

    Modules:

    • Agile Foundations
    • Work Effectively with Agile Vendors (Future)

    Note: Modules listed as (Future) are in development and may be available in draft format.

    Map challenges to supporting modules

    Agile Challenges

    Supporting Resources

    An Agile skills deficit (e.g. new-to-Agile teams who have difficulty "doing Agile right")

    Modules:

    • Agile Foundations
    General resistance in the organization to process changes required by Agile

    Modules:

    • Agile Foundations
    • Manage Organizational Change to Support Agile Delivery (Future)
    Lack of Agile training, piloting and coaching being offered by the organization

    Modules:

    • Agile Foundations
    Different Agile approaches are used by different teams, making it difficult to work together

    Modules:

    • Agile Foundations
    • Build Your Scrum Playbook (Future)
    Backlog management challenges (e.g. how to manage a backlog, and make effective use of Epics, Features, User Stories, Tasks and Bugs)

    Modules:

    • Agile Foundations
    • Manage Your Backlog Effectively
    Quality Assurance challenges (testing not being done well on Agile projects)

    Modules:

    • Agile Foundations
    • Establish Effect Quality Assurance for Agile Delivery (Future);
    • Use Test Automation Effectively (Future)
    Hierarchical management practices and organization boundaries make it difficult to be Agile

    Modules:

    • Agile Foundations
    • Manage Organizational Change to Support Agile Delivery (Future)

    Note: Modules listed as (Future) are in development and may be available in draft format.

    Map challenges to supporting modules

    Agile Challenges

    Supporting Resources

    Difficulty with establishing autonomous Agile teams (self managing, cross functional teams that are empowered by the organization to deliver)

    Modules:

    • Agile Foundations
    • Manage Organizational Change to Support Agile Delivery (Future)
    Lack of management support for Agile

    Modules:

    • Agile Foundations
    • Manage Organizational Change to Support Agile Delivery (Future)
    Poor understanding of Agile estimation techniques and how to apply them effectively

    Modules:

    • Agile Foundations
    • Estimation Module
    Difficulty creating effective product roadmaps in Agile

    Modules:

    • Agile Foundations
    • Product Roadmapping Tool
    How do we know when an Agile project is ready to go live

    Modules:

    • Agile Foundations
    • Decide When to Go Live (Future)
    Sprint goals are not being consistently met, or Sprint deliverables that are full of bugs

    Modules:

    • Agile Foundations
    • Establish Effect Quality Assurance for Agile Delivery (Future);
    • Use Test Automation Effectively (Future)

    Note: Modules listed as (Future) are in development and may be available in draft format.

    Map challenges to supporting blueprints

    Agile Challenges

    Supporting Resources

    Difficulty establishing an effective product owner (PO) or uncertainty about the PO role

    Blueprints: Build a Better Product Owner; Managing Requirements in an Agile Environment

    Uncertainty about minimum viable product (MVP) and how to identify your MVP

    Blueprints: Deliver on Your Digital Product Vision; Managing Requirements in an Agile Environment

    How non-Agile teams (like architecture, info sec, operations, etc.) work with Agile teams

    Blueprints: Create a Horizontally Optimized SDLC to Better Meet Business Demands, Extend Agile Practices Beyond IT, Implement DevOps Practices That Work; Build Your BizDevOps Playbook, Embed Security into the DevOps Pipeline

    Project Governance/Gating processes that are unfriendly to Agile

    Blueprints: Streamline Your Management Process to Drive Performance, Drive Business Value With a Right-Sized Project Gating Process

    Uncertainty about the role of a PM/PMO in Agile

    Blueprints: Define the Role of Project Management in Agile and Product-Centric Delivery, Create a Horizontally Optimized SDLC to Better Meet Business Demands

    Uncertainty about how to budget/plan Agile projects

    Blueprints: Identify and Reduce Agile Contract Risk

    Creating an Agile friendly RFP/Contract (e.g. how to contract and work with an Agile vendor)

    Blueprints: Identify and Reduce Agile Contract Risk

    Note: Modules listed as (Future) are in development and may be available in draft format.

    Map challenges to supporting blueprints

    Agile Challenges

    Supporting Resources

    An Agile skills deficit (e.g. new-to-Agile teams who have difficulty "doing Agile right")

    Blueprints: Perform an Agile Skills Assessment; Mentoring for Agile Teams

    General resistance in the organization to process changes required by Agile

    Blueprints: Master Organizational Change Management Practices

    Lack of Agile training, piloting and coaching being offered by the organization

    Blueprints: Perform an Agile Skills Assessment; Mentoring for Agile Teams

    Different Agile approaches are used by different teams, making it difficult to work together

    Blueprints: Create a Horizontally Optimized SDLC to Better Meet Business Demands, Extend Agile Practices Beyond IT

    Backlog management challenges (e.g. how to manage a backlog, and make effective use of epics, features, user stories, tasks and bugs)

    Blueprints: Deliver on Your Digital Product Vision, Managing Requirements in an Agile Environment

    Quality Assurance challenges (testing not being done well on Agile projects)

    Blueprints: Build a Software Quality Assurance Program, Automate Testing to Get More Done

    Hierarchical management practices and organization boundaries make it difficult to be Agile

    Blueprints: Master Organizational Change Management Practices

    Map challenges to supporting blueprints

    Agile Challenges

    Supporting Resources

    Difficulty with establishing autonomous Agile teams (self managing, cross functional teams that are empowered by the organization to deliver)

    Blueprints: Master Organizational Change Management Practices

    Lack of management support for Agile

    Blueprints: Master Organizational Change Management Practices

    Poor understanding of Agile estimation techniques and how to apply them effectively

    Blueprints: Estimate Software Delivery with Confidence, Managing Requirements in an Agile Environment

    Difficulty creating effective product roadmaps in Agile

    Blueprints: Deliver on Your Digital Product Vision

    How do we know when an Agile project is ready to go live

    Blueprints: Optimize Applications Release Management,Drive Business Value With a Right-Sized Project Gating Process, Managing Requirements in an Agile Environment

    Sprint goals are not being consistently met, or sprint deliverables that are full of bugs

    Blueprints: Build a Software Quality Assurance Program, Automate Testing to Get More Done, Managing Requirements in an Agile Environment

    Step 2.3

    Move stepwise to iterative Agile delivery (Optional)

    Activities

    2.3.1 (Optional) Identify a hypothetical project
    2.3.2 (Optional) Capture your traditional delivery approach
    2.3.3 (Optional) Consider what a two-phase delivery looks like
    2.3.4 (Optional) Consider what a four-phase delivery looks like
    2.3.5 (Optional) Consider what a four-phase delivery with monthly sprints looks like
    2.3.6 (Optional) Decide on your target state and the steps required to get there

    This step involves the following participants:

    • Product owners, product managers, and scrum masters
    • Delivery managers and senior leaders
    • Stakeholders and delivery teams

    Outcomes of this step

    • Understand the changes that must take place in your organization to support a more Agile delivery approach.

    Moving stepwise from traditional to Agile

    Your transition to Agile and more frequent releases doesn't need to be all at once. Organizations may find it easier to build toward smaller iterations.

    An image of the stepwise approach to adopting Agile.

    Exercise 2.3.1 (Optional) Identify a hypothetical project

    15-30 minutes

    1. As a group, consider some typical, large, mission-critical system deliveries your organization has done in the past (name a few as examples).
    2. Imagine a project like this has been assigned to your team, and the plan calls for delivering the system using your traditional delivery approach and taking two years to complete.
    3. Give this imaginary project a name (e.g. traditional project, our project).

    Name of your imaginary 2-year long project:

    e.g. Big Bang ERP

    Brief Project Description:

    e.g. Replace home-grown legacy ERP with a modern COTS product in a single release scheduled to be delivered in 24 months

    Record this in the Roadmap for Transition to Agile Template

    Info-Tech Best Practice

    For best results, complete these sub-exercises with representatives from as many functional areas as possible
    (e.g. stakeholders, project management, business analysis, development, testing, operations, architecture, infosec)

    Output

    • An imaginary delivery project that is expected to take 2 years to complete

    Participants

    • Product owners, product managers, and scrum masters
    • Delivery managers
    • Delivery teams
    • Stakeholders
    • Senior leaders

    Exercise 2.3.2 (Optional) Capture your traditional delivery approach

    30 minutes

    1. As a group, discuss and capture the high-level steps followed (after project approval) in your traditional delivery approach using the table below and on the next page.

    Step

    Description

    Who is involved

    1
    • Gather detailed requirements (work with project stakeholders to capture all requirements of the system and produce a Detailed Requirements Document)

    PM, Business Analysts, Stakeholders, etc.

    2
    • Produce a Detailed Design Document (develop a design that will meet all requirements identified in the Detailed Requirements Document)
    • Produce a Detailed Test Plan for acceptance of the system
    • Produce a Detailed Project Plan for the system delivery
    • Perform threat and privacy assessment (using the detailed requirements and design documents, perform a Threat Risk Assessment and Privacy Impact Analysis)
    • Submit detailed design to Architecture Review Board
    • Provide Operations with full infrastructure requirements
    PM, Architects, InfoSec, ARB, Operations, etc.
    3
    • Develop software (follow the Detailed Design Document and develop a system which meets all requirements)
    • Perform Unit Testing on all modules of the system as they are developed
    PM, Developers, etc.
    4
    • Create Production Environment based on project specification
    • Perform Integration testing of all modules to ensure the system works as designed
    • Produce an Integration Test Report capturing the results of testing and any deficiencies
    PM, Testers, etc.
    5
    • Fix all Sev 1 and Sev 2 deficiencies found during Integration Testing
    • Perform regression testing
    • Perform User Acceptance Testing as per the Detailed Test Plan
    PM, Developers, Testers, Stakeholders, etc.
    6
    • Product Deployment Plan
    • Perform User and Operations Training
    • Produce updated Threat Risk Assessment and Privacy Impact Analysis
    • Seek CAB (Change Approval Board) approval to go live
    PM, Developers, Testers, Operations, InfoSec, CAB, etc.
    7
    • Close out and Lessons Learned
    • Verify value delivery
    PM, etc.

    Output

    • The high-level steps in your current (traditional) delivery approach and who is involved in each step

    Participants

    • Product owners, product managers, and scrum masters
    • Delivery managers
    • Delivery teams
    • Stakeholders
    • Senior leaders

    Exercise 2.3.2 (Optional) Capture your traditional delivery approach

    Step

    Description

    Who is involved

    1
    • Gather detailed requirements (work with project stakeholders to capture all requirements of the system and produce a Detailed Requirements Document)

    PM, Business Analysts, Stakeholders, etc.

    2
    • Produce a Detailed Design Document (develop a design that will meet all requirements identified in the Detailed Requirements Document)
    • Produce a Detailed Test Plan for acceptance of the system
    • Produce a Detailed Project Plan for the system delivery
    • Perform threat and privacy assessment (using the detailed requirements and design documents, perform a Threat Risk Assessment and Privacy Impact Analysis)
    • Submit detailed design to Architecture Review Board
    • Provide Operations with full infrastructure requirements
    PM, Architects, InfoSec, ARB, Operations, etc.
    3
    • Develop software (follow the Detailed Design Document and develop a system which meets all requirements)
    • Perform Unit Testing on all modules of the system as they are developed
    PM, Developers, etc.
    4
    • Create Production Environment based on project specification
    • Perform Integration testing of all modules to ensure the system works as designed
    • Produce an Integration Test Report capturing the results of testing and any deficiencies
    PM, Testers, etc.
    5
    • Fix all Sev 1 and Sev 2 deficiencies found during Integration Testing
    • Perform regression testing
    • Perform User Acceptance Testing as per the Detailed Test Plan
    PM, Developers, Testers, Stakeholders, etc.
    6
    • Product Deployment Plan
    • Perform User and Operations Training
    • Produce updated Threat Risk Assessment and Privacy Impact Analysis
    • Seek CAB (Change Approval Board) approval to go live
    PM, Developers, Testers, Operations, InfoSec, CAB, etc.
    7
    • Close out and Lessons Learned
    • Verify value delivery
    PM, etc.

    Output

    • The high-level steps in your current (traditional) delivery approach and who is involved in each step

    Participants

    • Product owners, product managers, and scrum masters
    • Delivery managers
    • Delivery teams
    • Stakeholders
    • Senior leaders

    Exercise 2.3.3 (Optional) Consider what a two-phase delivery looks like

    30 minutes

    1. As a group, imagine that project stakeholders tell you two years is too long to wait for the project, and they want to know if they can have something (even if it's not the whole thing) in production sooner.
    2. Now imagine that you are able to convince the stakeholders to work with you to do the following:
      1. Identify their most important project requirements.
      2. Work with you to describe a valuable subset of the project requirements which reflect about ½ of all features they need (call this Phase 1).
      3. Work with you to get this Phase 1 of the project into production in about 1 year.
      4. Agree to leave the remaining requirements (e.g. the less important ones) until Phase 2 (second year of project).
    3. As a group, identify:
      1. How hard this would be for your organization to do, on a scale of 1 to 10.
      2. Identify what changes are needed to make this happen (consider people, processes, and technology).
      3. Capture your results using the table on the following slide.

    Output

    • The high-level steps in your current (traditional) delivery approach and who is involved in each step

    Participants

    • Product owners, product managers, and scrum masters
    • Delivery managers
    • Delivery teams
    • Stakeholders
    • Senior leaders

    Exercise 2.3.3 (Optional) Consider what a two-phase delivery looks like

    30 minutes

    1. What would be needed to let you deliver a two-year project in two one-year phases considering people, process, and technology?

    People

    Processes

    Technology

    • e.g. Stakeholders would need to make hard decisions about which features are more valuable/important than others (and stick to them)
    • e.g. Delivery team and stakeholders would need to work closely together to determine what is a feasible and valuable set of features which can go live in Phase 1
    • e.g. Operations will need to be prepared to support Phase 1 (earlier than before), and then support an updated system after Phase 2
    • e.g. No significant change to traditional processes other than delivering in two phases
    • e.g. Need to decide whether requirements for the full project need to be gathered up front, or do you just do Phase 1, and then Phase 2
    • e.g. No significant changes other than we need a production environment sooner, and infrastructure requirements for the full project may be different from what is needed just for Phase 1

    How difficult would this be to achieve in your organization? (1-easy, 10-next to impossible)

    e.g. 2

    Output

    • Understand how your organization would deliver a large project in two phases

    Participants

    • Product owners, product managers, and scrum masters
    • Delivery managers
    • Delivery teams
    • Stakeholders
    • Senior leaders

    Exercise 2.3.4 (Optional) Consider what a four-phase delivery looks like

    30 minutes

    1. Now, imagine that project stakeholders tell you that even one year is still too long to wait for something of value in production, and they want to know if they can have something (even if it's not the whole thing) in production sooner.
    2. Now imagine that you are able to convince the stakeholders to work with you to do the following:
      1. From the "Phase 1" requirements in Exercise 2.3.3, they will identify the most important ones that they need first.
      2. They will work with you to describe a valuable subset of these project requirements which reflect about ½ of all features they need (call this Phase 1A).
      3. They will work with you to get this Phase 1A of the project into production in about six months.
      4. Agree to leave all the remaining requirements (e.g. the less important ones) until later phases.
    1. As a group, identify:
      1. How hard this would be for your organization to do, on a scale of 1 to 10?
      2. Identify what changes are needed to make this happen (consider people, processes, and technology).
      3. Capture your results using the table on the following slide.

    Output

    • Understand how your organization would deliver a large project in two phases

    Participants

    • Product owners, product managers, and scrum masters
    • Delivery managers
    • Delivery teams
    • Stakeholders
    • Senior leaders

    Exercise 2.3.4 (Optional) Consider what a four-phase delivery looks like

    30 minutes

    1. What more would be needed to let you deliver a two-year project in four, six-month phases considering people, process, and technology?

    People

    Processes

    Technology

    • e.g. Stakeholders would need to make even harder (and faster) decisions about which features are most valuable/important than others.
    • e.g. Because we will be delivering releases so quickly, we'll ask the stakeholders to nominate a "primary contact" who can make decisions on requirements for each phase (also to answer questions from the project team, when needed, so they aren't slowed down).
    • e.g. Delivery team and the "primary contact" would work closely together to determine what is a feasible and valuable set of features to go live within Phase 1A, and then repeat this for the remaining Phases.
    • e.g. Operations will need to be prepared to support Phase 1A (even earlier than before), and then support the remaining phases. Ask them to dedicate someone as primary contact for this series of releases, and who provides guidance/support as needed.

    e.g. Heavy and time-consuming process steps (e.g. architecture reviews, data modelling, infosec approvals, change approval board) will need to be streamlined and made more "iteration-friendly."

    e.g. Gather detailed requirements only for Phase 1A, and leave the rest as high-level requirements to be more fully defined at the beginning of each subsequent phase.

    • e.g. We will need (at a minimum) a Production, and a Pre-production environment set up (and earlier in the project lifecycle) and solid regression testing at the end of each phase to ensure the latest Release doesn't break anything.
    • e.g. Since we will be going into production multiple times over this 2-year project, we should consider using automation (e.g. automated build, automated regression testing, and automated deployment).

    How difficult would this be to achieve in your organization? (1-easy, 10-next to impossible)

    e.g. 5

    Output

    • Understand how your organization would deliver a large project in two phases

    Participants

    • Product owners, product managers, and scrum masters
    • Delivery managers
    • Delivery teams
    • Stakeholders
    • Senior leaders

    Exercise 2.3.5 (Optional) Consider what a four-phase delivery with monthly sprints looks like

    30 minutes

    1. Now, imagine that project stakeholders tell you that they are happy with the six-month release approach (e.g. expect to go live four times over the two-year project, with each release providing increased functionality), but they want to see your team's progress frequently between releases.
    2. Additionally, stakeholders tell you that instead of asking you to provide the traditional monthly project status reports, they want you to demonstrate whatever features you have built and work for the system on a monthly basis. This will be done in the form of a demonstration to a selected list of stakeholders each month.
    3. Each month, your team must show working, tested code (not prototypes or mockups, unless asked for) and demonstrate how this month's deliverable brings value to the business.
    4. Furthermore, the stakeholders would like to be able to test out the system each month, so they can play with it, test it, and provide feedback to your team about what they like and what they feel needs to change.
    5. To help you to achieve this, the stakeholders designate their primary contact as the "product owner" (PO) who will be dedicated to the project and will help your team to decide what is being delivered each month. The PO will be empowered by the stakeholders to make decisions on scope and priority on an expedited basis and will also answer questions on their behalf when your team needs guidance.
    6. You agree with the stakeholders these one-month deliverables will be called "sprints."

    Output

    • Understand how your organization would deliver a large project in two phases

    Participants

    • Product owners, product managers, and scrum masters
    • Delivery managers
    • Delivery teams
    • Stakeholders
    • Senior leaders

    Exercise 2.3.5 (Optional) Consider what a four-phase delivery with monthly sprints looks like

    30 minutes

    1. What more would be needed to let you deliver a two-year project in 24 one-month sprints (plus four six-month releases) considering people, process, and technology?

    People

    Processes

    Technology

    • e.g. The team will need to work closely with the product owner (and/or stakeholders) on a continuous basis to understand requirements and their relative priority
    • e.g. Stakeholders will need to be available for demos and testing at the end of each sprint, and provide feedback to the team as quickly as possible
    • e.g. all functional siloes within IT (e.g. analysts, architects, infosec, developers, testers, operations) will need to work hand in hand on a continuous basis to deliver working tested code into a demo/test environment at the end of each sprint
    • e.g. there isn't enough time in each sprint to have team members working in siloes, instead, we will need to work together as a team to ensure that all aspects of the sprint (requirements, design, build, test, etc.) are worked on as needed (team is equally and collectively responsible for delivery of each sprint)
    • e.g. We can't deliver much in 1-month sprints if we work in siloes and are expected to do traditional documentation and handoffs (e.g. requirements document), so we will use a fluid project backlog instead of requirements documents, we will evolve our design iteratively over the course of the many sprints, and we will need to streamline the CAB process to allow for faster (more frequent) deployments
    • e.g. We will need to evolve the system's data model iteratively over the course of many sprints (rather than a one-and-done approach at the beginning of the project)
    • e.g. We will need to quickly decide the scope to be delivered in each sprint (focusing on highest value functionality first). Each sprint should have a well-defined "goal" that the team is trying to achieve
    • We will need any approval processes (e.g. architecture review, infosec review, CAB approval) to be streamlined and simplified in order to support more frequent and iterative deployment of the system
    • e.g. We will need to maximize our use of automation (build, test, and deploy) in order to maximize what we can deliver in each sprint (Note: the ROI on automation is much higher when we deliver in sprints than in a one-and-done delivery because we are iterating repeatedly over the course of the project
    • e.g. We will need to quickly stand-up environments (dev, test, prod, etc.) and to make changes/enhancements to these environments quickly (it makes sense to leverage infrastructure as a service [IaaS] techniques here)
    • e.g. We will need to automate our security related testing (e.g. static and dynamic security testing, penetration testing, etc.) so that it can be run repeatedly before each release moves into production. We may need to evolve this automated testing with each sprint depending on what new features/functions are being delivered in each release

    How difficult would this be to achieve in your organization? (1-easy, 10-next to impossible)

    e.g. 8

    Output

    • Understand how your organization would deliver a large project in two phases

    Participants

    • Product owners, product managers, and scrum masters
    • Delivery managers
    • Delivery teams
    • Stakeholders
    • Senior leaders

    Exercise 2.3.6 (Optional) Define the steps to reach your target state

    30 minutes

    1. From Exercises 2.3.1-2.3.5, identify your current state on the stepwise transition from traditional to Agile (e.g. one-and-done).
    2. Then, identify your desired future state (e.g. 24 one-month sprints with six-month releases).
    3. Now, review your people, process, and technology changes identified in Exercises 2.3.1-2.3.5 and create a roadmap for this transition using the table on the next slide.

    Identify your current state from Exercises 2.3.1-2.3.5

    e.g. One-and-done

    Identify your desired state from Exercises 2.3.1-2.3.5

    e.g. 24x1 Month Sprints

    Output

    • A roadmap and timeline for adopting a more Agile delivery approach

    Participants

    • Product owners, product managers, and scrum masters
    • Delivery managers
    • Delivery teams
    • Stakeholders
    • Senior leaders

    Exercise 2.3.6 (Optional) Define the steps to reach your target state

    30 minutes

    1. Fill in the table below with your next steps. Identify who will be responsible for each step along with the timeline for completion: "Now" refers to steps you will take in the immediate future (e.g. days to weeks), "Next" refers to steps you will take in the medium term (e.g. weeks to months), and "Later" refers to long-term items (e.g. months to years).

    Now

    Next Later

    What are you going to do now?

    What are you going to do very soon?

    What are you going to do in the future?

    Roadmap Item

    Who

    Date

    Roadmap Item

    Who

    Date

    Roadmap Item

    Who

    Date

    Work with Stakeholders to identify a product owner for the project.

    AC

    Jan 1

    Break down full deliverable into 4 phases with high level requirements for each phase

    DL

    Feb 15

    Work with operations to set up Dev, Test, Pre-Prod, and Prod environments for first phase (make use of automation/scripting)

    DL

    Apr 15

    Work with PO and stakeholders to help them understand Agile approach

    Jan 15

    Work with PO to create a project backlog for the first phase deliverable

    JK

    Feb 28

    Work with QA group to select and implement test automation for the project (start with smoke and regression tests)

    AC

    Apr 30

    Work with project gating body, architecture, infosec and operations to agree on incremental deliveries for the project and streamlined activities to get there

    AC

    Mar 15

    Record the results in the Roadmap for Transition to Agile Template

    Output

    • A roadmap and timeline for adopting a more Agile delivery approach

    Participants

    • Product owners, product managers, and scrum masters
    • Delivery managers
    • Delivery teams
    • Stakeholders
    • Senior leaders

    Step 2.4

    Identify insights and team feedback

    Activities

    2.4.1 Identify key insights and takeaways
    2.4.2 Perform an exit survey

    This step involves the following participants:

    • Product owners, product managers, and scrum masters
    • Delivery managers and senior leaders
    • Stakeholders and delivery teams

    Outcomes of this step

    • Identify your key insights and takeaways from Phase 2

    Exercise 2.4.1 Identify key insights and takeaways

    30 minutes

    1. As a group, discuss and capture your thoughts on:
      1. What key insights have participants gained from the intro to Agile presentation?
      2. What if any takeaways do participants feel are needed as a result of the presentation?
      3. What changes need to be made in the organization to support/enhance Agile adoption?
    2. Capture your findings in the table below:
    What key insights have you gained? What takeaways have you identified?
    • (e.g. better understanding of Agile mindset, principles, and practices)
    • (e.g. how you can improve/spread Agile practices in the organization)

    Output

    • A better understanding of Agile principles and practices
    • Action items that will help solidify Agile practices in the organization

    Participants

    • Product owners, product managers, and scrum masters
    • Delivery managers
    • Delivery teams
    • Stakeholders
    • Senior leaders

    Exercise 2.4.2 Perform an exit survey

    30 minutes

    1. Wrap up this section by addressing any remaining questions participants still have.
    2. Create your local exit survey by copying the template using the link below. Then copy and distribute your local survey link.
    3. Collect the consolidated survey results in preparation for your next steps.
    4. NOTE: Using this survey template requires having access to Microsoft Forms. If you cannot access Microsoft Forms, an Info-Tech analyst can send the survey for you. Alternatively, this survey can be done with sticky notes and a pen and paper to calculate the outcomes.

    Download Survey Template:

    Develop Your Agile Approach Exit Survey Template

    Output

    • A better understanding of Agile principles and practices
    • Action items that will help solidify Agile practices in the organization

    Participants

    • Product owners, product managers, and scrum masters
    • Delivery managers
    • Delivery teams
    • Stakeholders
    • Senior leaders

    Agile Modules

    Prioritize Agile support with your top challenges

    Backlog Management

    Scrum Simulation

    Estimation

    Product Owner

    Product Roadmapping

    1: User stories and the art of decomposition

    2: Effective backlog management & refinement

    3: Identify insights and team feedback

    1: Scrum sprint planning and retrospective simulation

    2: Pass the balls – sprint velocity game

    1: Improve product backlog item estimation

    2: Agile estimation fundamentals

    3: Understand the wisdom of crowds

    4: Identify insights and team feedback

    1: Understand product management fundamentals

    2: The critical role of the product owner

    3: Manage effective product backlogs and roadmaps

    4: Identify insights and team feedback

    1: Identify your product roadmapping pains

    2: The six "tools" of product roadmapping

    3: Product roadmapping exercise

    Organizations often struggle with numerous pain points around Agile delivery.
    The Common Agile Challenges Survey results will help you identify and prioritize the organization's biggest (most cited) pain points. Treat these pain points like a backlog and address the biggest ones first.

    Agile modules provide supporting activities:
    Each module provides guidance and supporting activities related to a specific Agile challenge from your survey. These modules can be arranged to meet each organization's or team's needs while providing cohesive and consistent messaging. For additional supporting research, please visit the Agile / DevOps Resource Center.
    This phase involves the following participants:

    • Product owners, product managers, and scrum masters
    • Delivery managers and senior leaders
    • Stakeholders and delivery teams

    Backlog Management Module

    Manage your backlog effectively

    Activities

    Backlog 1.1 Identify your backlog and user story decomposition pains
    Backlog 1.2 What are user stories and why do we use them?
    Backlog 1.3 User story decomposition: password reset
    Backlog 1.4 (Optional) Decompose a real epic

    This step involves the following participants:

    • Product owners, product managers, and scrum masters
    • Delivery managers and senior leaders
    • Stakeholders and delivery teams

    Outcomes of this step

    • A better understanding of backlog management and user story decomposition.

    Backlog Exercise 1.1 Identify your backlog and user story decomposition pains

    30-60 minutes

    1. As a group, discuss and capture your thoughts on:
      1. What specific challenges you are facing with backlog management
      2. What specific challenges you are facing with user story decomposition
    1. Capture your findings in the table below:

    What are your specific backlog management and user story decomposition challenges?

    • (e.g. We have trouble telling the difference between epics, features, user stories, and tasks)
    • (e.g. We often don't finish all user stories in a sprint because some of them turn out to be too big to complete in one sprint)

    Output

    • Your specific backlog management and user story decomposition challenges

    Participants

    • Product owners, product managers, and scrum masters
    • Delivery managers
    • Delivery teams
    • Stakeholders
    • Senior leaders

    User stories and the art of decomposition

    User stories are core to Agile delivery.

    Good user story decomposition practices are key to doing Agile effectively.

    Agile doesn't use traditional "shoulds" and "shalls" to capture requirements

    Backlog Exercise 1.2 What are user stories and why do we use them?

    30-60 minutes

    1. User stories are a simple way of capturing requirements in Agile and have the form:

    Why do we capture requirements as user stories (what value do they provide)?

    How do they differ from traditional (should/shall) requirements (and are they better)?

    What else stands out to you about user stories?

    as a someone I want something so that achieve something.

    Example:
    As a banking customer, I want to see the current balance of my accounts so that I can know how much money I have in each account.

    Output

    • A better understanding of user stories and why they are used in Agile delivery

    Participants

    • Product owners, product managers, and scrum masters
    • Delivery managers
    • Delivery teams
    • Stakeholders
    • Senior leaders

    User stories are "placeholders for conversations"

    User stories enable collaboration and conversations to fully determine actual business requirements over time.

    e.g. As a banking customer, I want to see the current balance of my accounts so that I can know how much money I have in each account.

    Requirements, determined within the iterations, outline the steps to complete the story: how the user will access their account, the types of funds allowed, etc.

    User stories allow the product owners to prioritize and manage the product needs (think of them as "virtual sticky notes").

    User stories come in different "sizes"

    These items form a four-level hierarchy: epics, features, user stories, and tasks.
    They are collectively referred to as product backlog items or (PBIs)

    A table with the following headings: Agile; Waterfall; Relationship; Definition

    The process of taking large PBIs (e.g. epics and features) and breaking them down in to small PBIs (e.g. user stories and tasks) is called user story decomposition and is often challenging for new-to-Agile teams

    Backlog Exercise 1.3 User story decomposition: password reset

    30-60 minutes

    1. As a group, consider the following feature, which describes a high-level requirement from a hypothetical system:
      • FEATURE: As a customer, I want to be able to set and reset my password, so that I can transact with the system securely.
    2. Imagine your delivery team tells you that this is user story is too large to complete in one sprint, so they have asked you to decompose it into smaller pieces. Work together to break this feature down into several smaller user stories:
    User Story 1: User Story 2: User Story 3:
    As A I Want So That. As A I Want So That. As A I Want So That.

    Output

    • An epic which has been decomposed into smaller user stories which can be completed independently

    Participants

    • Product owners, product managers, and scrum masters
    • Delivery managers
    • Delivery teams
    • Stakeholders
    • Senior leaders

    Backlog Exercise 1.3 User story decomposition: password reset

    Epic: As a customer, I want to be able to set and reset my password, so that I can transact securely.

    A single epic can be broken down into multiple user stories

    User Story 1: User Story 2: User Story 3: User Story 4:
    This is a picture of user story 1 This is a picture of user story 2 This is a picture of user story 3 This is a picture of user story 4

    Acceptance Criteria:
    Given that the customer has a password that they want to change,
    When the administrator clicks reset password on the admin console,
    Then the system will change the password and send it to the user.

    Acceptance Criteria:
    Given that the customer has a password that they want to change,
    When they click reset password in the system,
    Then the system will allow them to choose a new password and will save it the password and send it to the user.

    Acceptance Criteria:
    Given that the customer has not logged onto the system before,
    When they initially log in,
    Then the system will prompt them to change their password.

    Acceptance Criteria:
    Given that a password is stored in the database,
    When anyone looks at the password field in the database,
    Then the actual password will not be visible or easily decrypted.

    Are enablers included in your backlogs? Should they be?

    An enabler is any support activity needed to provide the means for future functionality. Enablers build out the technical foundations (e.g. architecture) of the product and uphold technical quality standards.

    Your audience will dictate the level of detail and granularity you should include in your enabler, but it is a good rule of thumb to stick to the feature level.

    Enablers

    Description

    Enabler Epics

    Non-functional and other technical requirements that support your features (e.g. data and system requirements)

    Enabler Capabilities of Features

    Enabler Stories

    Consider the various types of enabler

    Exploration

    Architectural

    Any efforts toward learning customer or user needs and creation of solutions and alternatives. Exploration enablers are heavily linked to learning milestones.

    Any efforts toward building components of your architecture. These will often be linked to delivery teams other than your pure development team.

    Infrastructure

    Compliance

    Any efforts toward building various development and testing environments. Again, these are artifacts that will relate to other delivery teams.

    Any efforts toward regulatory and compliance requirements in your development activities. These can be both internal and external.

    Source: Scaled Agile, "Enablers."

    Create, split, and bundle your PBIs

    The following questions can be helpful in dissecting an epic down to the user story level. The same line of thinking can also be useful for bundling multiple small PBIs together.

    An image showing how to Create, split, and bundle your PBIs

    Backlog Exercise 1.4 (Optional)
    Decompose a real epic

    30 minutes

    1. As a group, select a real epic or feature from one of your project backlogs which needs to be decomposed:
    2. Work together to decompose this epic down into several smaller features and/or user stories (user stories must be small enough to reasonably be completed within a sprint):

    Epic to be decomposed:

    As a ____ I want _____ so that ______

    User Story 1: User Story 2: User Story 3:
    As A I Want So That. As A I Want So That. As A I Want So That.

    Output

    • A real epic from your project backlog which has been decomposed into smaller features and user stories

    Participants

    • Product owners, product managers, and scrum masters
    • Delivery managers
    • Delivery teams
    • Stakeholders
    • Senior leaders

    Backlog Management Module

    Manage your backlog effectively

    Activities

    Backlog 2.1 Identify enablers and blockers

    This step involves the following participants:

    • Product owners, product managers, and scrum masters
    • Delivery managers and senior leaders
    • Stakeholders and delivery teams

    Outcomes of this step

    • Backlog PBI filters.
    • A better understanding of backlog types and levels.

    Effective backlog management and refinement

    Working with a tiered backlog

    an image showing the backlog tiers: New Idea; Ideas; Qualified; Ready - sprint.

    Use a tiered approach to managing your backlog, and always work on the highest priority items first.

    Distinguish your specific goals for refining in the product backlog vs. planning for a sprint itself

    Often backlog refinement is used interchangeably or considered a part of sprint planning. The reality is they are very similar, as the required participants and objectives are the same however, there are some key differences.

    An image of a Venn diagram comparing Backlog Refinement to sprint Planning.

    A better way to view them is "pre-planning" and "planning."

    A backlog stores and organizes PBIs at various stages of readiness

    A well-formed backlog can be thought of as a DEEP backlog:

    • Detailed Appropriately: Product backlog items (PBIs) are broken down and refined as necessary.
    • Emergent: The backlog grows and evolves over time as PBIs are added and removed.
    • Estimated: The effort a PBI requires is estimated at each tier.
    • Prioritized: The PBIs value and priority are determined at each tier.

    (Perforce, 2018)

    An image showing the Ideas; Qualified; Ready; funnel leading to the sprint approach.

    Backlog tiers facilitate product planning steps

    An image of the product planning steps facilitated by Backlog Tiers

    Each activity is a variation of measuring value and estimating effort to validate and prioritize a PBI.

    A PBI meets our definition of done and passes through to the next backlog tier when it meets the appropriate criteria. Quality filters should exist between each tier.

    Backlog Exercise 2.1 Build a starting checklist of quality filters

    60 minutes

    1. Quality filters provide a checklist to ensure each Product Backlog Item (PBI) meets our definition of Done and is ready to move to the next backlog group (status).
    2. Create a checklist of basic descriptors that must be completed between each backlog level.
    3. If you completed this exercise in a different Module, review and update it here.
    4. Use this information to start your product strategy playbook in Deliver on Your Digital Product Vision.

    An image of the backlog tiers, identifying where product backlog and sprint backlog are

    Output

    • List of enablers and blockers to establishing product owners

    Participants

    • Product owners, product managers, and scrum masters
    • Delivery managers
    • Delivery teams
    • Stakeholders
    • Senior leaders

    Outline the criteria to proceed to the next tier via quality filters

    Expand the concepts of defining "ready" and "done" to include the other stages of a PBIs journey through product planning.

    An image showing the approach you will use to Outline the criteria to proceed to the next tier via quality filters

    Info-Tech Insight: A quality filter ensures quality is met and teams are armed with the right information to work more efficiently and improve throughput.

    Define product value by aligning backlog delivery with roadmap goals

    In each product plan, the backlogs show what you will deliver. Roadmaps identify when and in what order you will deliver value, capabilities, and goals.

    Facilitator slides: Explaining MVP

    Notes and Instructions

    The primary intent of this exercise is to explain the complex notion of MVP (it is one of the most misunderstood and contentious issues in Agile delivery). The exercise is intended to explain it in a simple and digestible way that will fundamentally change participants' understanding of MVP.

    Note that the slide contains animations.

    Imagine that your stakeholder tells you they want a blue 4-door sedan (consider this our "MVP" at this point), and you decide to build it the traditional way. As you build it (tires, then frame, then body, then joint body with frame and install engine), the stakeholder doesn't have anything they can use, and so they are only happy (and able to get value) at the end when the entire car is finished (point out the stakeholder "faces" go from unhappy to happy in the end).
    Animation 1:
    When we use Agile methods, we don't want to wait until the end before we have something the stakeholders can use. So instead of waiting until the entire car is completed, we decide our first iteration will be to give the stakeholder "a simple (blue) wheeled transportation device"…namely a skateboard that they can use for a little while (it's not a car, but it is something the stakeholder can use to get places).
    Animation 2:
    After the stakeholder has tried out the skateboard, we ask for feedback. They tell us the skateboard helped them to get around faster than walking, but they don't like the fact that it is so hard to maintain your balance on it. So, we add a handle to the skateboard to turn it into a scooter. The stakeholder then uses the scooter for a while. Stakeholder feedback says staying balanced on the scooter is much easier, but they don't have a place to put groceries when they go shopping, so can we do something about that?
    (Continued on next slide…)

    Facilitator slides: Explaining MVP

    Notes and Instructions
    Animation 3:
    Next, we build the stakeholder a bicycle and let them use it for a while before asking for feedback. The stakeholder tells us they love the bicycle, but they admit they get tired on long trips, so is there something we can do about that?
    Animation 4:
    So next we add a motor to the bicycle to turn it into a motorcycle, and again we give it to the stakeholder to use for a while. When we ask the stakeholder for feedback, they tell us that they love the motorcycle so much because they love the feeling of the wind in their hair, they've decided that they no longer want a 4-door sedan, but instead would prefer a blue 2-door convertible.
    Animation 5:
    And so, for our last iteration, we build the stakeholder what they actually wanted (a blue 2-door convertible) instead of what they asked for (a blue 4-door sedan), and we see that they are happier than they would have been if we had delivered the traditional way.

    INSIGHTS:

    • An MVP cannot be fully known at the beginning of a project (it is the "journey" of creating the MVP with stakeholders that defines what it looks like in the end).
    • Sometimes, stakeholders don't (or can't) know what they want until they see it.
    • There is no "straight path" to your MVP, you determine the path forward based on what you learned in the previous iterations.
    • This approach is part of the "power of Agile" and demonstrates why Agile can produce better outcomes and happier stakeholders.

    Understanding minimum viable product

    NOT Like This:

    This is a series of images. The top half of the image, shows building a car by starting with the wheels. The bottom Image shows the progression from skateboard, to scooter, to bike, to motorcycle, to car.

    It's Like This:

    Use iterations to maximize value delivery

    An image showing how to use iterations to maximize value delivery.

    Use iterations to reduce accumulated risk

    An image showing how to use iterations to reduce accumulated risk.

    Understanding MVP
    (always be ready to go live)

    A great and wise pharaoh hires two architects to build his memorial pyramids.

    An image shows two architects contribution to pyramid construction.

    Understanding MVP
    (always be ready to go live)

    Several years go by, and then…

    The pharaoh is on his death bed.

    Backlog Management Module

    Manage your backlog effectively

    Activities

    Backlog 3.1 Identify key insights and takeaways
    Backlog 3.2 Perform exit survey and capture results

    This step involves the following participants:

    • Product owners, product managers, and scrum masters
    • Delivery managers and senior leaders
    • Stakeholders and delivery teams

    Outcomes of this step

    • Identify your key insights and takeaways.

    Backlog Exercise 3.1 Identify key insights and takeaways

    30 minutes

    1. As a group, discuss and capture your thoughts on:
      1. What key insights have participants gained from the Intro to Agile presentation?
      2. What if any takeaways do participants feel are needed as a result of the presentation?
      3. What changes need to be made in the organization to support/enhance Agile adoption?
    2. Capture your findings in the table below:

    What key insights have you gained?

    What takeaways have you identified?

    • (e.g. better understanding of Agile mindset, principles, and practices)
    • (e.g. how you can improve/spread Agile practices in the organization)

    Output

    • A better understanding of Agile principles and practices
    • Action items that will help solidify Agile practices in the organization

    Participants

    • Product owners, product managers, and scrum masters
    • Delivery managers
    • Delivery teams
    • Stakeholders
    • Senior leaders

    Backlog Exercise 3.2 Perform an exit survey

    30 minutes

    1. Wrap up this section by addressing any remaining questions participants still have.
    2. Create your local exit survey by copying the template using the link below. Then copy and distribute your local survey link.
    3. Collect the consolidated survey results in preparation for your next steps.
    4. NOTE: Using this survey template requires having access to Microsoft Forms. If you cannot access Microsoft Forms, an Info-Tech analyst can send the survey for you. Alternatively, this survey can be done with sticky notes and a pen and paper to calculate the outcomes.

    Output

    • A better understanding of Agile principles and practices
    • Action items that will help solidify Agile practices in the organization

    Participants

    • Product owners, product managers, and scrum masters
    • Delivery managers
    • Delivery teams
    • Stakeholders
    • Senior leaders

    Download Survey Template:

    Develop Your Agile Approach Exit Survey Template

    Agile Modules

    Prioritize Agile support with your top challenges

    Backlog Management

    Scrum Simulation

    Estimation

    Product Owner

    Product Roadmapping

    1: User stories and the art of decomposition

    2: Effective backlog management & refinement

    3: Identify insights and team feedback

    1: Scrum sprint planning and retrospective simulation

    2: Pass the balls – sprint velocity game

    1: Improve product backlog item estimation

    2: Agile estimation fundamentals

    3: Understand the wisdom of crowds

    4: Identify insights and team feedback

    1: Understand product management fundamentals

    2: The critical role of the product owner

    3: Manage effective product backlogs and roadmaps

    4: Identify insights and team feedback

    1: Identify your product roadmapping pains

    2: The six "tools" of product roadmapping

    3: Product roadmapping exercise

    Organizations often struggle with numerous pain points around Agile delivery.
    The Common Agile Challenges Survey results will help you identify and prioritize the organization's biggest (most cited) pain points. Treat these pain points like a backlog and address the biggest ones first.

    Agile modules provide supporting activities:
    Each module provides guidance and supporting activities related to a specific Agile challenge from your survey. These modules can be arranged to meet each organization's or team's needs while providing cohesive and consistent messaging. For additional supporting research, please visit the Agile / DevOps Resource Center.
    This phase involves the following participants:

    • Product owners, product managers, and scrum masters
    • Delivery managers and senior leaders
    • Stakeholders and delivery teams

    Scrum Simulation Module

    Scrum sprint planning and retrospective simulation

    Activities

    1.1 Identify your scrum pains
    1.2 Review scrum simulation intro
    1.3 Create a mock backlog
    1.4 Review sprint 0
    1.5 Determine a budget and timeline
    1.6 Understand minimum viable product
    1.7 Plan your first sprint
    1.8 Do a sprint retrospective
    1.9 "What if" exercise (understanding what a fluid backlog really means)
    1.10 A sprint 1 example
    1.11 Simulate more sprints

    This step involves the following participants:

    • Product owners, product managers, and scrum masters
    • Delivery managers and senior leaders
    • Stakeholders and delivery teams

    Outcomes of this step

    • A better understanding of Scrum (particularly backlog management and user story decomposition).

    Facilitator slides: Scrum Simulation Introduction

    Introduction Tab

    Talk to the nature of the Scrum team:

    • Collective ownership/responsibility for delivery.
    • The organization has given you great power. With great power comes great responsibility.
    • You may each be specialists in some way, but you need to be prepared to do anything the project requires (no one goes home until everyone can go home).
    • Product owner: Special role, empowered by the organization to act as a single, authoritative voice for stakeholders (again great power/responsibility), determines requirements and priorities, three ears (business/stakeholders/team), holds the vision for the project, answer questions from the team (or finds someone who can answer questions), must balance autonomy with stakeholder needs, is first among equals on the Scrum team, is laser-focused on getting the best possible outcome with the resources, money, and circumstances ← PO acts as the "pathfinder" for the project.
    • Talk about the criticality and qualities of the PO: well-respected, highly collaborative, wise decision maker, a "get it done" type (healthy bias toward immediacy), has a vision for product, understands stakeholders, can get stakeholders' attention when needed, is dedicated full-time to the project, can access help when needed, etc.
    • The rest of you are the delivery team (have avoided singling out an SM for this – not needed for the exercise – but SM is the servant leader/orchestra conductor for the delivery team. The facilitator should act as a pseudo-SM for this exercise).

    Speak about the "bank realizes that the precise scope of the first release can only be fully known at the end of the project" statement and what it means.

    Discuss exercise and everyone's roles (make sure everyone clear), make it as realistic as possible. Your level of participation will determine how much value you get.

    Discuss any questions the participants might have about the background section on the introduction tab. The exercise has been defined in a way that minimizes the scope and complexity of the work to be done by assuming there are existing web-capable services exposed to the bank's legacy system(s) and that the project is mostly about putting a deployable web front end in place.

    Speak about "definition of done": Why was it defined this way? What are the boundaries? What happens if we define it to be only up to unit testing?

    Facilitator slides: Scrum Simulation, Create a Mock Backlog

    Create a Mock Backlog Tab

    This exercise is intended to help participants understand the steps involved in creating an initial backlog and deciding on their MVP.

    Note: The output from this exercise will not be used in the remainder of the simulation (a backlog for the simulation already exists on tab Sprint 0) so don't overdo it on this exercise. Do enough to help the participants understand the basic steps involved (brainstorm features and functions for the app, group them into epics, and decide which will be in- and out-of-scope for MVP). Examples have been provided for all steps of this exercise and are shown in grey to indicate they should be replaced by the participants.

    Step 1: Have all participants brainstorm "features and functions" that they think should be available in the online banking app (stop once you have what feels like a "good enough" list to move on to the next step) – these do not need to be captured as user stories just yet.

    Step 2: Review the list of features and functions with participants and decide on several epics to capture groups of related features and functions (bill payments, etc.). Think of these as forming the high-level structure of your requirements. Now, organize all the features and functions from Step 1, into their appropriate epic (you can identify as many epics as you like, but try to keep them to a minimum).

    Step 3: Point out that on the Introduction tab, you were told the bank wants the first release to go live as soon as possible. So have participants go over the list of features and functions and identify those that they feel are most important (and should therefore go into the first release – that is, the MVP), and which they would leave for future releases. Help participants think critically and in a structured way about how to make these very hard decisions. Point out that the product owner is the ultimate decision maker here, but that the entire team should have input into the decision. Point out that all the features and functions that make up the MVP will be referred to as the "project backlog," and all the rest will be known as the "product backlog" (these are of course, just logical separations, there is only one physical backlog).

    Step 4: This step is optional and involves asking the participants to create user stories (e.g. "As a __, I want ___ so that ___") for all the epics and features and functions that make up their chosen MVP. This step is to get them used to creating user stories, because they will need to get used to doing this. Note that many who are new to Agile often have difficulty writing user stories and end up overdoing it (e.g. providing a long-winded list of things in the "I want ___" part of the user story for an epic) or struggling to come up with something for the "so that ____" part). Help them to get good at quickly capturing the gist of what should be in the user story (the details come later).

    Facilitator slides: Scrum Simulation, Budget and Timeline

    Project Budget and Timeline

    Total Number of Sprints = 305/20 = 15.25 → ROUND UP TO 16 (Why? You can't do a "partial sprint" – plus, give yourself a little breathing room.)

    Cost Per Sprint = 6 x $75 x 8 x 10 = $36,000

    Total Timeline = 16 * 2 = 32 Weeks

    Total Cost of First Release = $36,000 x 16 = $572,000

    Talk about the "commitment" a Scrum delivery team makes to the organization ("We can't tell you exactly what we will deliver, but based on what we know, if you give the team 32 weeks, we will deliver something like what is in the project backlog – subject to any changes our stakeholder tell us are needed"). Most importantly, the team commits to doing the most important backlog items first, so if we run out of time, the unfinished work will be the least valuable user stories. Lastly, to keep to the schedule/timeline, items may move in and out of the project backlog – this is part of the normal and important "horse trading" that takes place on health Agile projects.

    Speak to the fact that this approach allows you to provide a "deterministic" answer about how long a project will take and how much it will cost while keeping the project requirements flexible.

    Facilitator slides: Scrum Simulation, Sprint 0

    Sprint 0 Tab

    This is an unprioritized list, organized to make sense, and includes a user story (plus some stuff), and "good enough estimates" – How good?... Eh! (shoulder shrug)
    Point out the limited ("lazy") investment → Agile principle: simplicity, the art of maximizing the work not done.
    Point out that only way to really understand a requirement is to see a working example (requirements often change once the stakeholders see a working example – the "that's not what I meant" factor).

    Estimates are a balancing act (good enough that we understand the overall approximate size of this, and still acknowledges that more details will have to wait until we decide to put that requirement into a Sprint – remember, no one knows how long this project is going to take (or even what the final deliverable will look like) so don't over invest in estimates here.)

    Sprint velocity calculation is just a best guess → be prepared to find that your initial guess was off (but you will know this early rather than at the end of the project). This should lead to a healthy discussion about why the discrepancy is happening (sprint retrospectives can help here). Note: Sprint velocity doesn't assume working evenings and weekends!

    Speak to the importance of Sprint velocity being based on a "sustainable pace" by the delivery team. Calculations that implicitly expect sustained overtime in order to meet the delivery date must be avoided. Part of the power of Agile comes from this critical insight. Critical → Your project's execution will need to be adjusted to accommodate the actual sprint velocity of the team!

    Point out the "project backlog" and separation from the "product backlog" (and no sprint backlog yet!).

    Point out the function/benefits of the backlog:

    • A single holding place for all the work that needs to be done (so you don't forget/ignore anything).
    • Can calculate how much work is left to do.
    • A mechanism for prioritizing deliverables.
    • A list of placeholders for further discussion.
    • An evolving list that will grow and shrink over time.
    • A "living document" that must be maintained over the course of the project.

    Talk about large items in backlog (>20 pts) and how to deal with them (do we need to break them up now?).

    Give participants time to review the backlog: Questions/What would you be doing if this were real/We're going to collectively work through this backlog.
    Sprint 0 is your opportunity to: get organized as a team, do high level design, strategize on approach, think about test data, environments, etc. – it is the "Ready-Set" in "Ready-Set-Go."
    Think about doing a High/Med/Low value determination for each user story.

    Simulation Exercise 1.1 Identify your Scrum pains

    30 minutes

    1. As a group, discuss and capture your thoughts on:
      • What specific challenges are you facing with your Scrum practices?
    2. Capture your findings in the table below:

    What are your specific Scrum challenges?

    • (e.g. We don't know how to decide on our minimum viable product (MVP), or what to start working on first)
    • (e.g. We don't have a product owner assigned to the project)
    • (e.g. Our daily standups often take 30-60 minutes to complete)
    • (e.g. We heard Scrum was supposed to reduce the number of meetings we have, but instead, meetings have increased)
    • (e.g. We don't know how to determine the budget for an Agile project)

    Output

    • Your specific Scrum related challenges

    Participants

    • Product owners, product managers, and scrum masters
    • Delivery managers
    • Delivery teams
    • Stakeholders
    • Senior leaders

    Simulation Exercise 1.2 Review Scrum Simulation intro

    30 minutes

    1. Ask participants to read the Introduction tab in the Scrum Simulation Exercise(5 minutes)
    2. Discuss and answer any questions the participants may have about the introduction (5 minutes)
    3. Discuss the approach your org would use to deliver this using their traditional approach (5 minutes)

    This is an image of the Introduction tab in the Scrum Simulation Exercise

    How would your organization deliver this using their traditional approach?

    1. Capture all requirements in a document and get signoff from stakeholders
    2. Create a detailed design for the entire system
    3. Build and test the system
    4. Deploy it into production

    Note: Refer to the facilitator slides for more guidance on how to deliver this exercise

    Simulation Exercise 1.3 Create a mock backlog

    30-60 minutes

    Step 1: Brainstorm "Features and Functions" that the group feels would be needed for this app

    Capture anything that you feel might be needed in the Online Banking Application:

    • See account balances
    • Pay a bill online
    • Set up payees for online bill payments
    • Make a deposit online
    • See a history of account transactions
    • Logon and logoff
    • Make an e-transfer
    • Schedule a bill payment for the future
    • Search for a transaction by payee/date/amount/etc.
    • Register for app
    • Reset password

    Note: Refer to the facilitator slides for more guidance on how to deliver this exercise

    Output

    • Create a mock initial backlog for the simulated project

    Participants

    • Product owners, product managers, and scrum masters
    • Delivery managers
    • Delivery teams
    • Stakeholders
    • Senior leaders

    Simulation Exercise 1.3 Create a mock backlog

    30-60 minutes

    Step 2: Identify your epics

    1. Categorize your "Features and Functions" list into several epics for the application:

    Epics

    "Features and Functions" in This Epic

    Administration

    - Logon and logoff
    - Register for app
    - Reset password

    Accounts

    - See account balances
    - See a history of account transactions
    - Search for a transaction by payee/date/amount

    Bill payments

    - Set up payees for online bill payments
    - Pay a bill online
    - Schedule a bill payment for the future

    Deposits

    - Make a deposit online

    E-transfers

    - Make an e-transfer

    Note: Refer to the facilitator slides for more guidance on how to deliver this exercise

    Output

    • Create a mock initial backlog for the simulated project

    Participants

    • Product owners, product managers, and scrum masters
    • Delivery managers
    • Delivery teams
    • Stakeholders
    • Senior leaders

    Simulation Exercise 1.3 Create a mock backlog

    30-60 minutes

    Step 3: Identify your MVP

    1. Decide which "Features and Functions" will be in your MVP and which will be delivered in future releases:

    YOUR MVP (Project Backlog)

    Epics

    "Features and Functions" in This Epic

    Administration

    - Logon and logoff
    - Register for app

    Accounts

    - See account balances
    - See a history of account transactions

    Bill payments

    - Set up payees for online bill payments
    - Pay a bill online

    FOR FUTURE RELEASES (Product Backlog)

    Epics

    In Scope

    Deposits- Make a deposit online
    Accounts- Search for a transaction by payee/date/amount/etc.
    Bill payments- Schedule a bill payment for the future

    Note: Refer to the facilitator slides for more guidance on how to deliver this exercise

    Output

    • Create a mock initial backlog for the simulated project

    Participants

    • Product owners, product managers, and scrum masters
    • Delivery managers
    • Delivery teams
    • Stakeholders
    • Senior leaders

    Simulation Exercise 1.3 Create a mock backlog

    30-60 minutes

    Step 3: Identify your MVP

    1. Decide which "Features and Functions" will be in your MVP and which will be delivered in future releases:

    YOUR MVP EPICS

    Epics

    "Features and Functions" in This Epic

    Administration

    - Logon and logoff
    - Register for app

    Accounts

    - See account balances
    - See a history of account transactions

    Bill payments

    - Set up payees for online bill payments
    - Pay a bill online

    YOUR MVP USER STORIES

    Epics

    In Scope

    Logon and LogoffAs a user, I want to logon/logoff the app so I can do my banking securely
    Register for AppAs a user, I want to register to use the app so I can bank online
    See Account BalancesAs a user, I want to see my account balances so that I know my current financial status
    See a History of Account TransactionsAs a user, I want to see a history of my account transactions, so I am aware of where my money goes
    Set up Payees for Online Bill PaymentsAs a user, I want to set up payees so that I can easily pay my bills
    Pay a Bill OnlineAs a user, I want to pay bills online, so they get paid on time

    Note: Refer to the facilitator slides for more guidance on how to deliver this exercise

    Output

    • Create a mock initial backlog for the simulated project

    Participants

    • Product owners, product managers, and scrum masters
    • Delivery managers
    • Delivery teams
    • Stakeholders
    • Senior leaders

    Simulation Exercise 1.4 Review
    Sprint 0

    The Online Banking Application of the spreadsheet for Sprint 0.

    Step 1: Set aside the Mock Backlog just created (you will be using the Backlog on Sprint 0 for remainder of exercise).
    Step 2: Introduce and walk through the Backlog on the Sprint 0 tab in the Scrum Simulation Exercise.
    Step 3: Discuss and answer any questions the participants may have about the Sprint 0 tab.
    Step 4: Capture any important issues or clarifications from this discussion in the table below.

    Important issues or clarifications from the Sprint 0 tab:

    • (e.g. What is the difference between the project backlog and the product backlog?)
    • (e.g. What do we do with user stories that are bigger than our sprint velocity?)
    • (e.g. Has the project backlog been prioritized?)
    • (e.g. How do we decide what to work on first?)

    Note: Refer to the facilitator slides for more guidance on how to deliver this exercise

    Output

    • Understand Sprint 0 for Scrum Simulation Exercise

    Participants

    • Product owners, product managers, and scrum masters
    • Delivery managers
    • Delivery teams
    • Stakeholders
    • Senior leaders

    Simulation Exercise 1.4 Review
    Sprint 0

    30-60 minutes

    1. Using the information found on the Sprint 0 tab, determine the projected timeline and cost for this project's first release:

    GIVEN

    Total Story Points in Project Backlog (First Release): 307 Story Points
    Expected Sprint Velocity: 20 Story Points/Sprint
    Total Team Size (PO, SM and 4-person Delivery Team): 6 People
    Blended Hourly Rate Per Team Member (assume 8hr day): $75/Hour
    Sprint Duration: 2 Weeks

    DETERMINE

    Expected Number of Sprints to Complete Project Backlog:
    Cost Per Sprint ($):
    Total Expected Timeline (weeks):
    Total Cost of First Release:

    Note: Refer to the facilitator slides for more guidance on how to deliver this exercise

    Output

    • How to determine expected cost and timeline for an Agile project

    Participants

    • Product owners, product managers, and scrum masters
    • Delivery managers
    • Delivery teams
    • Stakeholders
    • Senior leaders

    The Estimation Cone of Uncertainty

    The Estimation Cone of Uncertainty

    Simulation Exercise 1.6 Understanding minimum viable products (MVP)

    30 minutes

    1. Discuss your current understanding of MVP.

    How do you describe/define MVP?

    • (Discuss/capture your understanding of minimum viable product)

    Note: Refer to the facilitator slides for more guidance on how to deliver this exercise

    Output

    • Capture your current understanding of Minimum Viable Product

    Participants

    • Product owners, product managers, and scrum masters
    • Delivery managers
    • Delivery teams
    • Stakeholders
    • Senior leaders

    Facilitator slides: Explaining MVP

    Notes and Instructions

    The primary intent of this exercise is to explain the complex notion of MVP (it is one of the most misunderstood and contentious issues in Agile delivery). The exercise is intended to explain it in a simple and digestible way that will fundamentally change participants' understanding of MVP.
    Note that the slide contains animations.

    Imagine that your stakeholder tells you they want a blue 4-door sedan (consider this our "MVP" at this point), and you decide to build it the traditional way. As you build it (tires, then frame, then body, then joint body with frame and install engine), the stakeholder doesn't have anything they can use, and so they are only happy (and able to get value) at the end when the entire car is finished (point out the stakeholder "faces" go from unhappy to happy in the end).

    Animation 1:
    When we use Agile methods, we don't want to wait until the end before we have something the stakeholders can use. So instead of waiting until the entire car is completed, we decide our first iteration will be to give the stakeholder "a simple (blue) wheeled transportation device"…namely a skateboard that they can use for a little while (it's not a car, but it is something the stakeholder can use to get places).

    Animation 2:
    After the stakeholder has tried out the skateboard, we ask for feedback. They tell us the skateboard helped them to get around faster than walking, but they don't like the fact that it is so hard to maintain your balance on it. So, we add a handle to the skateboard to turn it into a scooter. The stakeholder then uses the scooter for a while. stakeholder feedback says staying balanced on the scooter is much easier, but they don't have a place to put groceries when they go shopping, so can we do something about that?

    (Continued on next slide…)

    Facilitator slides: Explaining MVP

    Notes and Instructions

    Animation 3:
    So next we build the stakeholder a bicycle and let them use it for a while before asking for feedback. The stakeholder tells us they love the bicycle, but they admit they get tired on long trips, so is there something we can do about that?

    Animation 4:
    So next we add a motor to the bicycle to turn it into a motorcycle, and again we give it to the stakeholder to use for a while. When we ask the stakeholder for feedback, they tell us that they LOVE the motorcycle so much, and that because they love the feeling of the wind in their hair, they've decided that they no longer want a 4-door sedan, but instead would prefer a blue 2-door convertible.

    Animation 5:
    And so, for our last iteration, we build the stakeholder what they wanted (a blue 2-door convertible) instead of what they asked for (a blue 4-door sedan), and we see that they are happier than they would have been if we had delivered the traditional way.

    INSIGHTS:
    An MVP cannot be fully known at the beginning of a project (it is the "journey" of creating the MVP with stakeholders that defines what it looks like in the end).
    Sometimes, stakeholders don't (or can't) know what they want until they see it.
    There is no "straight path" to your MVP, you determine the path forward based on what you learned in the previous iterations.
    This approach is part of the "power of Agile" and demonstrates why Agile can produce better outcomes and happier stakeholders.

    Understanding minimum viable product

    NOT Like This:

    This is a series of images. The top half of the image, shows building a car by starting with the wheels. The bottom Image shows the progression from skateboard, to scooter, to bike, to motorcycle, to car.

    It's Like This:

    Use iterations to maximize value delivery

    An image showing how to use iterations to maximize value delivery

    Use iterations to reduce accumulated risk

    An image showing how to use iterations to reduce accumulated risk.

    Understanding MVP
    (always be ready to go live)

    A great and wise pharaoh hires two architects to build his memorial pyramids.

    An image shows two architects contribution to pyramid construction.

    Understanding MVP
    (always be ready to go live)

    Several years go by, and then…

    The pharaoh is on his death bed.

    Simulation Exercise 1.7 Plan your first sprint

    30-60 minutes

    Step 1: Divide participants into independent Scrum delivery teams (max 7-8 people per team) and assign a PO (5 minutes)
    Step 2: Instruct each team to work together to decide on their "MVP strategy" for delivering this project (10-15 minutes)
    Step 3: Have each team decide on which user stories they would put in their first sprint backlog (5-10 minutes)
    Step 4: Have each team report on their findings. (10 minutes)

    Describe your team's "MVP strategy" for this project (Explain why you chose this strategy):

    Identify your first sprint backlog (Explain how this aligns with your MVP strategy):

    What, if anything, did you find interesting, insightful or valuable by having completed this exercise:

    Output

    • Experience deciding on an MVP strategy and creating your first sprint backlog

    Participants

    • Product owners, product managers, and scrum masters
    • Delivery managers
    • Delivery teams
    • Stakeholders
    • Senior leaders

    Simulation Exercise 1.8 Do a sprint retrospective

    30-60 minutes

    Step 1: Thinking about the work you did in Exercise 3.2.7, identify what worked well and what didn't
    Step 2: Create a list of "Start/Stop/Continue" items using the table below
    Step 3: Present your list and discuss with other teams

    1. Capture findings in the table below:

    Start:
    (What could you start doing that would make Sprint Planning work better?)

    Stop:
    (What didn't work well for the team, and so you should stop doing it?)

    Continue:
    (What worked well for the team, and so you should continue doing?)

    Output

    • Experience performing a sprint retrospective

    Participants

    • Product owners, product managers, and scrum masters
    • Delivery managers
    • Delivery teams
    • Stakeholders
    • Senior leaders

    Simulation Exercise 1.9 "What if" exercise (understanding what a fluid backlog really means)

    30-60 minutes

    1. As a team, consider what you would do in each of the following scenarios (treat each one as an independent scenario rather than cumulative):

    Scenario:

    How would you deal with this:

    After playing with and testing the Sprint 1 deliverable, your stakeholders find several small bugs that need to be fixed, along with some minor changes they would like made to the system. The total amount of effort to address all of these is estimated to be 4 story points in total.

    (e.g. First and foremost, put these requests into the Project Backlog, then…)

    Despite your best efforts, your stakeholders tell you that your Sprint 1 deliverable missed the mark by a wide margin, and they have major changes they want to see made to it.

    Several stakeholders have come forward and stated that they feel strongly that the "DEPOSIT – Deposit a cheque by taking a photo" User Story should be part of the first release, and they would like to see it moved from the Product Backlog to the project backlog (Important Note: they don't want this to change the delivery date for the first release)

    Output

    • A better understanding of how to handle change using a fluid project backlog

    Participants

    • Product owners, product managers, and scrum masters
    • Delivery managers
    • Delivery teams
    • Stakeholders
    • Senior leaders

    Simulation Exercise 1.10 A Sprint 1 example

    30-60 minutes

    1. Consider the following example of what your Sprint 1 deliverable could be:

    An example of what your Sprint 1 deliverable could be.

    Output

    • Better understanding of an MVP strategy

    Participants

    • Product owners, product managers, and scrum masters
    • Delivery managers
    • Delivery teams
    • Stakeholders
    • Senior leaders

    Simulation Exercise 1.10 A Sprint 1 example

    30-60 minutes

    1. As a group, discuss this approach, including:
      1. The pros and cons of the approach.
      2. Is this a shippable increment?
      3. What more would you need to do to make it a shippable increment?
    2. Capture your findings in the table below:

    Discussion

    Output

    • Better understanding of an MVP strategy

    Participants

    • Product owners, product managers, and scrum masters
    • Delivery managers
    • Delivery teams
    • Stakeholders
    • Senior leaders

    Simulation Exercise 1.11 Simulate more sprints

    30-60 minutes

    1. As a group, continue to simulate more sprints for the online banking app:
      1. Simulate the planning, execution, demo, and retro stages for additional sprints
      2. Stop when you have had enough
    2. Capture your learnings in the table below:

    Discussion and learnings

    Output

    • Better understanding of an MVP strategy

    Participants

    • Product owners, product managers, and scrum masters
    • Delivery managers
    • Delivery teams
    • Stakeholders
    • Senior leaders

    Scrum Simulation Module

    Simulate effective scrum practices

    Activities

    2.1 Execute the ball passing sprints

    This step involves the following participants:

    • Product owners, product managers, and scrum masters
    • Delivery managers and senior leaders
    • Stakeholders and delivery teams

    Outcomes of this step

    • Model and understand behavioral blockers and patterns affecting Agile teams and organizational culture.

    Pass the balls – sprint velocity game

    Goal 1. Pass as many balls as possible (Story Points) through the system during each sprint.
    Goal 2. Improve your estimation and velocity after each retrospective.

    Backlog

    An image of Sprint, passing balls from one individual to another until you reach the completion point.

    Points Completed

    Rules:

    1. Two people cannot touch the ball at the same time.
    2. Only the first and last person can hold more than one ball at a time.
    3. Every person on the Delivery Team must touch the ball at least once per sprint.
    4. Each team must record its results during the retrospective.

    Scoring:

    1. One point for every ball that completes the system.
    2. Minus one point for every dropped ball.

    Epic 1: 3 sprints

    1. 1-minute Planning
    2. 2-minute Sprints
    3. 1-minute Retrospective

    Group Retrospective
    Epic 2: 3 sprints (repeat)

    1. 1-minute Planning
    2. 2-minute Sprints
    3. 1-minute Retrospective

    Simulation Exercise 1.11 Simulate more sprints

    30-60 minutes

    Goal 1: Pass as many balls (Story Points) through the system during each sprint.
    Goal 2: Improve your estimation and velocity after each retrospective.

    1. Epic 1: 3 sprints
      1. 1-minute Planning
      2. 2-minute Sprints
      3. 1-minute Retrospective
    2. Group Retrospective
    3. Epic 2: 3 sprints
      1. 1-minute Planning
      2. 2-minute Sprints
      3. 1-minute Retrospective
    4. Group Retrospective
    5. Optionally repeat for additional sprints with team configurations or scenarios

    Rules:

    1. Two people cannot touch the ball at the same time.
    2. Only the first and last person can hold more than one ball at a time.
    3. Every person on the delivery team must touch the ball at least once per sprint.
    4. Each team must record its results during the retrospective.

    Scoring:

    1. One point for every ball that completes the system.
    2. Minus one point for every dropped ball.

    Output

    • Understand basic estimation, sprint, and retrospective techniques.
    • Experience common Agile behavior challenges.

    Participants

    • Product owners, product managers, and scrum masters
    • Delivery managers
    • Delivery teams
    • Stakeholders
    • Senior leaders

    Facilitator slides: Sprint velocity game

    Goal:

    Pass as many balls as possible through the system during each cycle.

    Game Setup

    • Divide into teams of 8-16 people. If you have a smaller group, form one team rather than two smaller teams to start. The idea is to cause chaos with too many people in the delivery flow. See alternate versions for adding additional Epics with smaller teams.
    • Read out the instructions and ensure teams understand each one. Note that no assistance will be given during the sprints.

    Use your phone's timer to create 2-minute cycles:

    • 1-minute sprint planning
    • 2-minute delivery sprint
    • 1-minute retrospective and results recording
    • Run 3-4 cycles, then stop for a facilitated discussion of their observations and challenges.
    • Begin epic 2 and run for 3-4 more cycles.

    Facilitator slides: Sprint velocity game

    • Game Cycles
      • Epic 1: 3 complete cycles
      • 1-minute Planning
      • 2-minute Sprints
      • 1-minute Sprint retrospective
    • Group Retrospective
      • Discuss each sprint, challenges, and changes made to optimize throughput.
    • Epic 2: 3 complete cycles
      • 1-minute Planning
      • 2-minute Sprints
      • 1-minute Sprint retrospective
    • Group Retrospective
      • Discuss each sprint, challenges, and changes made to optimize throughput.
    • Game Rules
      • Each ball must have airtime. No ball cannot touch two people at the same time.
      • No person can hold more than one ball at a time.
      • Ball must be passed by every person on a team.
      • You may not pass a ball to a person directly to the person on your left or right.
      • Each team must keep score and record their results during the Retrospective.
    • Scoring
      • 1 point for every ball that completes the system.
      • Minus 1 point for every dropped ball.

    Facilitator slides: Sprint velocity game

    Facilitator Tips

    • Create a feeling of competition to get the teams to rush and work against each other. The goal is to show how this culture must be broken in Agile and DevOps. Then challenge the teams against natural silos and not focus on enterprise goals.
    • Create false urgency to increase stress, errors, and breakdowns in communication.
    • Look for patterns of traditional delivery and top-down management that limit delivery. These will emerge naturally, and teams will fall back into familiar patterns under stress.
    • Look for key lessons you want to reinforce and bring out ball game examples to help teams relate to something that is easier to understand.

    Alternate Versions

    • Run Epic 1 as one team, then have them break into typical Agile teams of 4-9 people. Compare results.
    • Run Epics with different goals: How would their approach change?
      • Fastest delivery
      • Highest production
      • Lowest defect rate
    • Have teams assign a scrum master to coordinate delivery. A scrum master and product owner are part of the overall team, but not part of the delivery team. They would not need to pass balls during each sprint.
    • Increase sprint time. Discuss right sizing sprint to complete work.
    • Give each team different numbers of balls, but don't tell them. Alternately, start each team with half as many balls, then double for Epic 2. Discuss how the sprint backlog affected their throughput.

    Facilitator slides: Sprint velocity game

    Trends to Look For and Discuss

    • False constraints - patterns where teams unnecessarily limited themselves.
    • Larger teams could have divided into smaller working teams, passing the balls between working groups.
    • Instructions did not limit that "team" meant everyone in the group. They could have formed smaller groups to process more work. LEAN
    • Using the first sprint for planning only. More time to create a POC.
    • Teams will start communicating but will grow silent, especially in later sprints. Stress interactions over the process.
    • Borrowing best practices from other teams.
    • Using retrospectives to share ideas with other teams. Stress needs to align with the company's goals, not just the team's goals.
    • How did they treat dropped balls? Rejected as errors, started over (false constraint), or picked up and continued?

    Trends to Look For and Discuss

    • Did individuals dominate the planning and execution, or did everyone feel like an equal member of the team?
    • Did they consider assigning a scrum master? The scrum master and product owner are part of the overall team, but not part of the Delivery Team. They would not need to pass balls during each Sprint.
    • What impacted their expected number of balls completed? Did it help improve quality or was it a distraction?
    • What caused their improvement in velocity? Draw the connection between how teams must work together and the need for stability.
    • Discuss the overall goal and constraints. Did they understand what the desired outcome was? Where did they make assumptions? Add talking points:
      • What if the goal was overall completed balls?
      • What if it was zero defect? No dropped balls.
      • What if it was the fastest delivery? Each ball through the system in the shortest time? Were they timing each ball?

    Scrum Simulation Module

    Simulate effective scrum practices

    Activities

    3.1 Identify key insights and takeaways

    3.2 Perform exit survey and capture results

    This step involves the following participants:

    • Product owners, product managers, and scrum masters
    • Delivery managers and senior leaders
    • Stakeholders and delivery teams

    Outcomes of this step

    • Identify your key insights and takeaways

    Simulation Exercise 3.1
    Identify key insights and takeaways

    30 minutes

    1. As a group, discuss and capture your thoughts on:
      1. What key insights have participants gained from the Intro to Agile presentation?
      2. What if any takeaways do participants feel are needed as a result of the presentation?
      3. What changes need to be made in the organization to support/enhance Agile adoption?
    2. Capture your findings in the table below:

    What key insights have you gained?

    What takeaways have you identified?

    • (e.g. better understanding of Agile mindset, principles, and practices)
    • (e.g. how you can improve/spread Agile practices in the organization)

    Output

    • A better understanding of Agile principles and practices
    • Action items that will help solidify Agile practices in the organization

    Participants

    • Product owners, product managers, and scrum masters
    • Delivery managers
    • Delivery teams
    • Stakeholders
    • Senior leaders

    Simulation Exercise 3.2
    Perform an exit survey

    30 minutes

    1. Wrap up this section by addressing any remaining questions participants still have.
    2. Create your local exit survey by copying the template using the link below. Then copy and distribute your local survey link.
    3. Collect the consolidated survey results in preparation for your next steps.
    4. NOTE: Using this survey template requires having access to Microsoft Forms. If you cannot access Microsoft Forms, an Info-Tech analyst can send the survey for you. Alternatively, this survey can be done with sticky notes and a pen and paper to calculate the outcomes.

    Download Survey Template:

    Develop Your Agile Approach Exit Survey Template

    Output

    • A better understanding of Agile principles and practices
    • Action items that will help solidify Agile practices in the organization

    Participants

    • Product owners, product managers, and scrum masters
    • Delivery managers
    • Delivery teams
    • Stakeholders
    • Senior leaders

    Agile Modules

    Prioritize Agile support with your top challenges

    Backlog Management

    Scrum Simulation

    Estimation

    Product Owner

    Product Roadmapping

    1: User stories and the art of decomposition

    2: Effective backlog management & refinement

    3: Identify insights and team feedback

    1: Scrum sprint planning and retrospective simulation

    2: Pass the balls – sprint velocity game

    1: Improve product backlog item estimation

    2: Agile estimation fundamentals

    3: Understand the wisdom of crowds

    4: Identify insights and team feedback

    1: Understand product management fundamentals

    2: The critical role of the product owner

    3: Manage effective product backlogs and roadmaps

    4: Identify insights and team feedback

    1: Identify your product roadmapping pains

    2: The six "tools" of product roadmapping

    3: Product roadmapping exercise

    Organizations often struggle with numerous pain points around Agile delivery.
    The Common Agile Challenges Survey results will help you identify and prioritize the organization's biggest (most cited) pain points. Treat these pain points like a backlog and address the biggest ones first.

    Agile modules provide supporting activities:

    Each module provides guidance and supporting activities related to a specific Agile Challenge from your survey. These modules can be arranged to meet each organization's or team's needs while providing cohesive and consistent messaging. For additional supporting research, please visit the Agile / DevOps Resource Center.

    This phase involves the following participants:

    • Product owners, product managers, and scrum masters
    • Delivery managers and senior leaders
    • Stakeholders and delivery teams

    Estimation Module

    Improve product backlog item estimation

    Activities

    1.1 Identify your estimation pains

    1.2 (Optional) Why do we estimate?

    1.3 How do you estimate now?

    This step involves the following participants:

    • Product owners, product managers, and scrum masters
    • Delivery managers and senior leaders
    • Stakeholders and delivery teams

    Outcomes of this step

    • A better understanding of Agile estimation practices and how to apply them.

    Establish consistent Agile estimation fundamentals

    an image of a hierarchy answering the question What is an estimate.

    Know the truth about estimates and their potential pitfalls.

    Then, understand how Agile estimation works to avoid these pitfalls.

    Estimation Exercise 1.1 Identify your estimation pains

    30-60 minutes

    1. As a group, discuss and capture your thoughts on:
      1. What specific challenges are you facing with your estimation practices today
      2. Capture your findings in the table below:

    What are your specific Estimation challenges?

    • (e.g. We don't estimate consistently)
    • (e.g. Our estimates are usually off by a large margin)
    • (e.g. We're not sure what approach to use when estimating)

    Output

    • Your specific estimation related challenges

    Participants

    • Product owners, product managers, and scrum masters
    • Delivery managers
    • Delivery teams
    • Stakeholders
    • Senior leaders

    Estimation Exercise 1.2 (Optional) Why do we estimate?

    30 minutes

    1. As a group, discuss and capture your thoughts on:
      1. Why do we do estimates?
      2. What value/merit do estimates have?
    2. Capture your findings in the table below:

    Why would/should you do estimates?

    • (e.g. Our stakeholders need to know how long it will take to deliver a given feature/function)

    Output

    • Better understanding of the need for estimates

    Participants

    • Product owners, product managers, and scrum masters
    • Delivery managers
    • Delivery teams
    • Stakeholders
    • Senior leaders

    Estimation Exercise 1.2 (Optional) Why do we estimate?

    30 minutes

    1. Estimation has its merits
    2. Here are some sample reasons for estimates:
      • "Estimates allow us to predict when a sprint goal will be met, and therefore when a substantial increment of value will be delivered."
      • "Our estimates help our stakeholders plan ahead. They are part of the value we provide."
      • "Estimates help us to de-risk scope of uncertain size and complexity."
      • "Estimated work can be traded in and out of scope for other work of similar size. Without estimates, you can't trade."
      • "The very process of estimation adds value. When we estimate we discuss requirements in more detail and gain a better understanding of what is needed."
      • "Demonstrates IT's commitment to delivering valuable products and changes."
      • "Supports business ambitions with customers and stakeholders."
      • "Helps to build a sustainable value-delivery cadence."

    Source: DZone, 2013.

    Output

    • Better understanding of the need for estimates

    Participants

    • Product owners, product managers, and scrum masters
    • Delivery managers
    • Delivery teams
    • Stakeholders
    • Senior leaders

    Estimation Exercise 1.3 How do you estimate now?

    30 minutes

    1. As a group, speak about now you currently estimate in your organization.
    2. Capture your findings in the table below:

    Why would/should you do estimates?

    • (e.g. We don't do estimates)
    • (e.g. We ask the person assigned to each task in the project plan to estimate how long it will take)

    Output

    • Your current estimation approach

    Participants

    • Product owners, product managers, and scrum masters
    • Delivery managers
    • Delivery teams
    • Stakeholders
    • Senior leaders

    Estimation Module

    Improve product backlog item estimation

    Activities

    2.1 (Optional) Estimate a real PBI

    This step involves the following participants:

    • Product owners, product managers, and scrum masters
    • Delivery managers and senior leaders
    • Stakeholders and delivery teams

    Outcomes of this step

    • A better understanding of Agile estimation practices and how to apply them.

    Don't expect your estimates to be accurate!

    The average rough order of magnitude estimates for software are off by is up to 400%.
    Source: Boehm, 1981

    Estimate inaccuracy has many serious repercussions on the project and organization

    66%

    Average cost overrun(1)

    33%

    Average schedule overrun (1)

    17%

    Average benefits shortfall)1)

    (1) % of software projects with given issue

    Source: McKinsey & Company, 2012

    The Estimation Cone of Uncertainty

    The Estimation Cone of Uncertainty

    What is Agile estimation?

    There is no single Agile estimation technique. When selecting an approach, adopt an Agile estimation technique that works for your organization, and don't be afraid to adapt it to your circumstances. Remember: all estimates are wrong, so use them with care and skepticism.

    • Understands and accepts the limitations of any estimation process.
    • Leverages good practices to counteract these limitations (e.g. wisdom of crowds, quality-first thinking).
    • Doesn't over-invest in individual estimate accuracy (but sees their value "in aggregate").
    • Approach can change from project to project or team to team and evolves/matures over the project lifespan.
    • Uses the estimation process as an effective tool to:
      • Make commitments about what can be accomplished in a sprint (to establish capacity).
      • Convey a measure of progress and rough expected completion dates to stakeholders (including management).

    Info-Tech Insight

    All estimates are wrong, but some can be useful (leverage the "wisdom of crowds" to improve your estimation practices).

    There are many Agile estimation techniques to choose from…

    Consensus-Building Techniques
    Planning Poker

    Most popular by far (stick with one of these unless there is a good reason to consider others)

    This approach uses the Delphi method, where a group collectively estimates the size of a PBI, or user stories, with cards numbered by story points. See our Estimate Software Delivery With Confidence blueprint.

    T-Shirt Sizing

    This approach involves collaboratively estimating PBIs against a non-numerical system (e.g. small, medium, large). See DZone and C# Corner for more information.

    Dot Voting

    This approach involves giving participants a set number of dot stickers or marks and voting on the PBIs (and options) to deliver. See Dotmocracy and Wikipedia for more information.

    Bucket System

    This approach categorizes PBIs by placing them into defined buckets, which can then be further broken down through dividing and conquering. See Agile Advice and Crisp's Blog for more information.

    Affinity Mapping

    This approach involves the individual sizing and sorting of PBIs, and then the order of these PBIs are collaboratively edited. The grouping is then associated with numerical estimates or buckets if desired. See Getting Agile for more information.

    Ordering Method

    This approach involves randomly ordering items on a scale ranging from low to high. Each member will take turns moving an item one spot lower or higher where it seems appropriate. See Apiumhub, Sheidaei Blog (variant), and SitePoint (Relative Mass Valuation) for more information.

    Ensure your teams have the right information

    Estimate accuracy and consistency improve when it is clear what you are estimating (definition of ready) and what it means to complete the PBI (definition of done).
    Be sure to establish and enforce your definition of ready/done throughout the project.

    Ready

    Done
    • The value of the story to the user is indicated.
    • The acceptance criteria for the story have been clearly described.
    • Person who will accept the user story is identified.
    • The team knows how to demo the story…
    • Design complete, code compiles, static code analysis has been performed and passed.
    • Peer reviewed with coding standards passed.
    • Unit test and smoke test are done/functional (preferably automated).
    • Passes functionality testing including security testing…

    What are story points?

    Many organizations use story point sizing to estimate their PBIs
    (e.g. epics, features, user stories, and tasks)

    • A story point is a (unitless) measure of the relative size, complexity, risk, and uncertainty, of a PBI.
    • Story points do not correspond to the exact number of hours it will take to complete the PBI.
    • When using story points, think about them in terms of their size relative to one another.
    • The delivery team's sprint velocity and capacity should also be tracked in story points.

    How do you assign a point value to a user story? There is no easy answer outside of leveraging the experience of the team. Sizes are based on relative comparisons to other PBIs or previously developed items. Example: "This user story is 3 points because it is expected to take 3 times more effort than that 1-point user story."Therefore, the measurement of a story point is only defined through the team's experience, as the team matures.

    Can you equate a point to a unit of time? First and foremost, for the purposes of backlog prioritization, you don't need to know the time, just its size relative to other PBIs. For sprint planning, release planning, or any scenario where timing is a factor, you will need to have a reasonably accurate sprint capacity determined. Again, this comes down to experience.

    "Planning poker" estimation technique

    Leverage the wisdom of crowds to improve your estimates

    an image of the user story points and the Fibonacci sequence

    Planning poker: This approach uses the Delphi method, where a group collectively estimates the size of a PBI or user story, using cards with story points on them.

    Materials: Each participant has deck of cards, containing the numbers of the Fibonacci sequence.

    Typical Participants: Product owner, scrum master (usually acts as facilitator), delivery team.

    Steps:

    1. The facilitator will select a user story.
    2. The product owner answers any questions about the user story from the group.
    3. The group makes their first round of estimates, where each participant individually selects a card without showing it to anyone, and then all selections are revealed at once.
    4. If there is consensus, the facilitator records the estimate and moves onto step 1 for another user story.
    5. If there are discrepancies, the participants should state their case for their selection (especially high or low outliers) and engage in constructive debate.
    6. The group makes an additional round of estimates, where step 3-6 are completed until there is a reasonable consensus.
    7. If the consensus is the user story is too large to fit into a sprint or too poorly defined, then the user story should be decomposed or rewritten.

    Estimation Exercise 2.1 (Optional) Estimate a real PBI

    30-60 minutes

    Step 1: As a group, select a real epic, feature, or user story from one of your project backlogs which needs to be estimated:

    PBI to be Estimated:

    As a ____ I want _____ so that ______

    Step 2: Select one person in your group to act as the product owner and discuss/question the details of the selected PBI to improve your collective understanding of the requirement (the PO will do their best to explain the PBI and answer any questions).
    Step 3: Make your first round of estimates using either T-shirt sizing or the Fibonacci sequence. Be sure to agree on the boundaries for these estimates (e.g. "extra-small" (XS) is any work that can be completed in less than an hour, while "extra-large" (XL) is anything that would take a single person a full sprint to deliver – a similar approach could be used for Fibonacci where a "1" is less than an hour's work, and "21" might be a single person for a full sprint). Don't share your answer until everyone has had a chance to decide on their Estimate value for the PBI.
    Step 4: Have everyone share their chosen estimate value and briefly explain their reasoning for the estimate. If most estimate values are the same/similar, allow the group to decide whether they have reached a "collective agreement" on the estimate. If not, repeat step 3 now that everyone has had a chance to explain their initial Estimate.
    Step 5: Capture the "collective" estimate for the PBI here:

    Our collective estimate for this PBI:

    e.g. 8 story points

    Output

    • A real PBI from your project backlog which has estimated using planning poker

    Participants

    • Product owners, product managers, and scrum masters
    • Delivery managers
    • Delivery teams
    • Stakeholders
    • Senior leaders

    Estimation Module

    Improve product backlog item estimation

    Activities

    3.1 Guess the number of jelly beans (Round 1) (15 minutes)
    3.2 Compare the average of your guesses (15 minutes)
    3.3 Guess the number of gumballs (Round 2) (15 minutes)
    3.4 Compare your guesses against the actual number

    This step involves the following participants:

    • Product owners, product managers, and scrum masters
    • Delivery managers and senior leaders
    • Stakeholders and delivery teams

    Outcomes of this step

    • A better understanding of why Agile estimation and reconciliation provides reliable estimates for planning.

    Facilitator Slides: Agile Estimation (Wisdom of Crowds Exercise – Rounds 1 and 2)

    Notes and Instructions

    The exercise is intended to mimic the way Planning Poker is performed in Agile Estimation. Use the exercise to demonstrate the power of the Wisdom of Crowds and how, in circumstances where the exact answer to a question is not known, asking several people for their opinion often produces more accurate results than most/any individual opinion.

    Some participants will tend to "shout out an answer" right away, so be sure to tell participants not to share their answers until everyone has had an opportunity to register their guess (this is particularly important in Round 1, where we are trying to get unvarnished guesses from the participants).

    In Round 1:

    • Be sure to emphasize that participants are guessing the total number of jelly beans in the jar (sometimes people think it is just the number visible)
    • Once all guesses are gathered and you've calculated the error for them (and the average guess), review the results with participants (Note: the actual number of jelly beans in the jar is 1600 (it is "greyed out" on the bottom line of the table – you can make it visible by turning off the grey highlight on that cell in the table)
    • Most of the time, the average guess will be closer to the actual than most (if not all) individual guesses (but be prepared for the fact that this doesn't always happen – this is especially true when the number of participants is small)
    • When discussing the results, ask participants to share the "method" they used to make their guess (particularly those who were closest to the actual). This part of the exercise can help them to make more accurate guesses in Round 2

    In Round 2:

    • Note that this time, participants are guessing the total number of visible gumballs in the image (both whole and partial gumballs are counted)
    • Once all guesses are gathered and you've calculated the error for them (and the average guess), review the results with participants (Note: the actual number of visible gumballs is 1600 (it is "greyed out" on the bottom line of the table – you can make it visible by turning off the grey highlight on that cell in the table)
    • Most of the time, the average guess will be closer to the actual in Round 2 than it was in Round 1
    • Talk to participants about the outcomes and how the results varied from Round 1 to Round 2, along with any interesting insights they may have gained from the exercise

    Estimation Exercise 3.1 Guess the number of jelly beans (Round 1)

    15 minutes

    1. Option 1: Microsoft Forms
      1. Create your own local survey by copying the template using the link below.
      2. Add the local Survey link to the exercise instructions or send the link to the participants.
      3. Give the participants 2-3 minutes to complete their guesses.
      4. Collect the consolidated Survey responses and calculate the results on the next slide.
      5. NOTE: Using this survey template requires having access to Microsoft Forms. If you cannot access Microsoft Forms, an Info-Tech analyst or Workshop Specialist can set up the survey for you.
    2. Option 2: Embedded Excel table
      1. On the results slide, double-click the table to open the embedded Excel worksheet.
      2. Record each participant's guess in the table.
    3. Alternatively, this survey can be done with sticky notes, a pen, paper, and a calculator to determine the outcomes.

    Download Survey Template:

    Info-Tech Wisdom of the Crowd 1 (Jelly Bean Guess

    Output

    • An appreciation for the power of the wisdom of crowds

    Participants

    • Product owners, product managers, and scrum masters
    • Delivery managers
    • Delivery teams
    • Stakeholders
    • Senior leaders

    Estimation Exercise 3.1 Guess the number of jelly beans (Round 1)

    15 minutes

    1. Guess the total number of jelly beans in the entire container (not just the ones you can see).
    2. Be sure not to share your guess with anyone else.
    3. It doesn't matter how you settle on your guess ("gut feel" is fine, so is being "scientific" about it, as well as everything in between).
    4. Again, please don't share your guess (or even how you settled on your guess) with anyone else (this exercise relies on independent guesses).

    See slide notes for instructions.

    Output

    • An appreciation for the power of the wisdom of crowds

    Participants

    • Product owners, product managers, and scrum masters
    • Delivery managers
    • Delivery teams
    • Stakeholders
    • Senior leaders

    Estimation Exercise 3.2 Compare the average of your guesses

    15 minutes

    A blank table for you to compare the average of your guesses at the number of Jellybeans in the Jar.

    See slide notes for instructions.

    Output

    • An appreciation for the power of the wisdom of crowds

    Participants

    • Product owners, product managers, and scrum masters
    • Delivery managers
    • Delivery teams
    • Stakeholders
    • Senior leaders

    Guess the number of gumballs

    • Option 1: Microsoft Forms
      • Create your own local survey by copying the template using the link below.
      • Add the local Survey link to the exercise instructions or send the link to the participants.
      • Give the participants 2-3 minutes to complete their guesses.
      • Collect the consolidated Survey responses and calculate the results on the next slide.
      • NOTE: Using this survey template requires having access to Microsoft Forms. If you cannot access Microsoft Forms, an Info-Tech analyst or Workshop Specialist can set up the survey for you.
    • Option 2: Embedded Excel table
      • On the results slide, double-click the table to open the embedded Excel worksheet.
      • Record each participant's guess in the table.
    • Alternatively, this survey can be done with sticky notes, a pen, paper, and a calculator to determine the outcomes.

    Download Survey Template:

    Info-Tech Wisdom of the Crowd 2 (Gumball Guess)

    Output

    • An appreciation for the power of the wisdom of crowds

    Participants

    • PM's, PO's and SM's
    • Delivery Managers
    • Delivery Teams
    • Business Stakeholders
    • Senior Leaders
    • Other Interested Parties

    Estimation Exercise 3.3 Guess the number of gumballs (Round 2)

    15 minutes

    1. Guess the total number of gumballs visible in the photo shown on the right.
    2. Again, please don't share your guess with anyone.

    Output

    • An appreciation for the power of the wisdom of crowds

    Participants

    • PM's, PO's and SM's
    • Delivery Managers
    • Delivery Teams
    • Business Stakeholders
    • Senior Leaders
    • Other Interested Parties

    Estimation Exercise 3.2 Compare the average of your guesses

    15 minutes

    A blank table for you to compare the average of your guesses at the number of Jellybeans in the Jar.

    See slide notes for instructions.

    Output

    • An appreciation for the power of the wisdom of crowds

    Participants

    • PM's, PO's and SM's
    • Delivery Managers
    • Delivery Teams
    • Business Stakeholders
    • Senior Leaders
    • Other Interested Parties

    Estimation Module

    Improve product backlog item estimation

    Activities

    4.1 Identify key insights and takeaways
    4.2 Perform exit survey and capture results

    This step involves the following participants:

    • Product owners, product managers, and scrum masters
    • Delivery managers and senior leaders
    • Stakeholders and delivery teams

    Outcomes of this step

    • Identify your key insights and takeaways.

    Estimation Exercise 4.2
    Identify key insights and takeaways

    30 minutes

    1. As a group, discuss and capture your thoughts on:
      1. What key insights have participants gained from the Intro to Agile presentation?
      2. What if any takeaways do participants feel are needed as a result of the presentation?
      3. What changes need to be made in the organization to support/enhance Agile adoption?
    2. Capture your findings in the table below:

    What key insights have you gained?

    What takeaways have you identified?

    • (e.g. better understanding of Agile mindset, principles, and practices)
    • (e.g. how you can improve/spread Agile practices in the organization)

    Output

    • A better understanding of Agile principles and practices
    • Action items that will help solidify Agile practices in the organization

    Participants

    • Product owners, product managers, and scrum masters
    • Delivery managers
    • Delivery teams
    • Stakeholders
    • Senior leaders

    Estimation Exercise 4.2
    Perform an exit survey

    30 minutes

    1. Wrap up this section by addressing any remaining questions participants still have.
    2. Create your local exit survey by copying the template using the link below. Then copy and distribute your local survey link.
    3. Collect the consolidated survey results in preparation for your next steps.
    4. NOTE: Using this survey template requires having access to Microsoft Forms. If you cannot access Microsoft Forms, an Info-Tech analyst can send the survey for you. Alternatively, this survey can be done with sticky notes and a pen and paper to calculate the outcomes.

    Download Survey Template:

    Develop Your Agile Approach Exit Survey Template

    Output

    • A better understanding of Agile principles and practices
    • Action items that will help solidify Agile practices in the organization

    Participants

    • Product owners, product managers, and scrum masters
    • Delivery managers
    • Delivery teams
    • Stakeholders
    • Senior leaders

    Agile Modules

    Prioritize Agile support with your top challenges

    Backlog Management

    Scrum Simulation

    Estimation

    Product Owner

    Product Roadmapping

    1: User stories and the art of decomposition

    2: Effective backlog management & refinement

    3: Identify insights and team feedback

    1: Scrum sprint planning and retrospective simulation

    2: Pass the balls – sprint velocity game

    1: Improve product backlog item estimation

    2: Agile estimation fundamentals

    3: Understand the wisdom of crowds

    4: Identify insights and team feedback

    1: Understand product management fundamentals

    2: The critical role of the product owner

    3: Manage effective product backlogs and roadmaps

    4: Identify insights and team feedback

    1: Identify your product roadmapping pains

    2: The six "tools" of product roadmapping

    3: Product roadmapping exercise

    Organizations often struggle with numerous pain points around Agile delivery.
    The Common Agile Challenges Survey results will help you identify and prioritize the organization's biggest (most cited) pain points. Treat these pain points like a backlog and address the biggest ones first.

    Agile modules provide supporting activities:

    Each module provides guidance and supporting activities related to a specific Agile Challenge from your survey. These modules can be arranged to meet each organization's or team's needs while providing cohesive and consistent messaging. For additional supporting research, please visit the Agile / DevOps Resource Center.

    This phase involves the following participants:

    • Product owners, product managers, and scrum masters
    • Delivery managers and senior leaders
    • Stakeholders and delivery teams

    Product Owner Module

    Establish an effective product owner role

    Activities

    1.1 Identify your product owner pains
    1.2 What is a "product"? Who are your "consumers"?
    1.3 Define your role terminology

    This step involves the following participants:

    • Product owners, product managers, and scrum masters
    • Delivery managers and senior leaders
    • Stakeholders and delivery teams

    Outcomes of this step

    • Understand product management fundamentals.
    • Define your product management roles and terms.

    Product owners ensure we delivery the right changes, for the right people, at the right time.

    The importance of assigning an effective and empowered product owner to your Agile projects cannot be overstated.

    What is a product?

    A tangible solution, tool, or service (physical or digital), which enables the long-term and evolving delivery of value to customers, and stakeholders based on business and user requirements.

    Info-Tech Insight

    A proper definition of a product recognizes three key facts.

    1. A clear recognition that products are long-term endeavors that don't end after the project finishes.
    2. Products are not just 'apps', but can be software or services that drive value.
    3. There is more than one stakeholder group that derives value from the product or service.

    Estimation Exercise 4.2
    Perform an exit survey

    30-60 minutes

    1. As a group, discuss and capture your thoughts on:
      • What specific challenges are you facing with your product owner practices today?
    2. Capture your findings in the table below:

    What are your specific Product Owner challenges?

    • (e.g. We don't have product owners)
    • (e.g. Our product owners have "day jobs" as well, so they don't have enough time to devote to the project)
    • (e.g. Our product owners are unsure about the role and its associated responsibilities)

    Output

    • Your specific product owner challenges

    Participants

    • Product owners, product managers, and scrum masters
    • Delivery managers
    • Delivery teams
    • Stakeholders
    • Senior leaders

    Product Owner Exercise 1.2 What is a "product"? Who are your "consumers"?

    30-60 minutes

    1. Discussion:
      1. How do you define a product, service, or application?
      2. Who are the consumers that receive value from the product?

    Input

    • Organizational knowledge
    • Internal terms and definitions

    Output

    • Our definition of products and services
    • Our definition of product and service consumers/customers

    Products and services share the same foundation and best practices

    The term "product" is used for consistency but would apply to services as well.

    Product=Service

    "Product" and "Service" are terms that each organization needs to define to fit its culture and customers (internal and external). The most important aspect is consistent use and understanding of:

    • External products
    • Internal products
    • External services
    • Internal services
    • Products as a service (PaaS)
    • Productizing services (SaaS)

    Recognize the different product owner perspectives

    • Business
      • Customer facing, revenue generating
    • Operations
      • Keep the lights on processes
    • Technical
      • IT systems and tools

    "A product owner in its most beneficial form acts like an Entrepreneur, like a 'mini-CEO'. The product owner is someone who really 'owns' the product."

    – – Robbin Schuurman,
    "Tips for Starting Technical Product Managers"

    Info-Tech Best Practice

    Product owners must translate needs and constraints from their perspective into the language of their audience. Kathy Borneman, Digital Product Owner at SunTrust Bank, noted the challenges of finding a common language between lines of business and IT (e.g. what is a unit?).

    Implement Info-Tech's product owner capability model

    An image of Info-Tech’s product owner capability model

    Unfortunately, most product owners operate with an incomplete knowledge of the skills and capabilities needed to perform the role. Common gaps include focusing only on product backlogs, acting as a proxy for product decisions, and ignoring the need for key performance indicators (KPIs) and analytics in both planning and value realization.

    Scale products into families to improve alignment

    Operationally align product delivery to enterprise goals

    A hierarchy showing how to break enterprise goals and strategy down into product families.

    The Info-Tech difference:

    Start by piloting product families to determine which approaches work best for your organization.

    Create a common definition of what a product is and identify products in your inventory.

    Use scaling patterns to build operationally aligned product families.

    Develop a roadmap strategy to align families and products to enterprise goals and priorities.

    Use products and families to evaluate the delivery and organizational design improvements.

    Deliver Digital Products at Scale via Enterprise Product Families

    Select the right models for scaling product management

    • Pyramid
      • Logical hierarchy of products rolling into a single service area.
      • Lower levels of the pyramid focus on more discrete services.
      • Example: Human resources mapping down to supporting applications.
    • Service Grouping
      • Organization of related services into service family.
      • Direct hierarchy does not necessarily exist within the family.
      • Example: End user support and ticketing.
    • Technical Grouping
      • Logical grouping of IT infrastructure, platforms, or applications.
      • Provides full lifecycle management when hierarchies do not exist.
      • Example: Workflow and collaboration tools.
    • Market Alignment
      • Grouping of products by customer segments or market strategy.
      • Aligns product to end users and consumers.
      • Example: Customer banking products and services.
    • Organizational Alignment
      • Used at higher levels of the organization where products are aligned under divisions.
      • Separation of product management from organizational structure no longer distinct.

    Match your product management role definitions to your product family levels

    Product Ownership exists at the different operational tiers or levels in your product hierarchy. This does not imply or require a management relationship.

    Product Portfolio
    Groups of product families within an overall value stream or capability grouping.
    Product Portfolio Manager

    Product Family
    A collection of related products. Products can be grouped along architectural, functional, operational, or experiential patterns.
    Product Family Manager

    Product
    Single product composed of one or more applications and services.
    Product Owner

    Info-Tech Insight

    The primary role conflict occurs when the product owner is a proxy for stakeholders or responsible for the delivery team. The product owner owns the product backlog. The delivery team owns the sprint backlog and delivery.

    Examine the differences between product managers and product owners

    Product management terminology is inconsistent, creating confusion in organizations introducing these roles. Understand the roles, then define terms that work best for you.

    A Table comparing the different roles of product managers to those of product owners.

    Define who manages key milestone

    Key milestones must be proactively managed. If a project manager is not available, those responsibilities need to be managed by the Product Owner or Scrum Master. Start with responsibility mapping to decide which role will be responsible.

    An image of a table with the following column headings: Example Milestones; Project Manager; Product Owner; Scrum Master*

    Product Owner Exercise 1.3 Define your role terminology

    30-60 minutes

    1. Using consistent terms is important for any organizational change and evergreen process. Capture your preferred terms to help align teams and expectations.
    Term

    Definition

    Product Owner

    • Owns and manages the product or service providing continuous delivery of value.
    • Owns the product roadmap and backlog for the product or service.
    • Works with stakeholders, end users, the delivery team, and market research to identify the product features and their estimated return on investment when implemented.
    • Responsible for refining and reprioritizing the product backlog ensuring items are "Ready" for the sprint backlog.
    • Defines KPIs to measure the value and impact of each PBI to help refine the backlog and guide the roadmap.
    • Responsible for refining and reprioritizing the sprint backlog that identifies which features will be delivered in the next sprint based on business importance.
    • Works with the product owner, stakeholders, end users, and SMEs to help define PBIs to ensure they are "Ready" for the Sprint backlog.

    Product Manager

    • Owns and manages a product or service family consisting of multiple products or services.
    • Owns the product family roadmap. Note: Product families do not have a backlog, only products do.
    • Works with stakeholders, end users, product owners, enterprise architecture, and market research to identify the product capabilities needed to accomplish goals.
    • Validates the product PBIs delivered realized the expected value and capability. Feedback is used to refine the product family roadmap and guide product owners.

    Output

    • Product management role definitions

    Participants

    • Product owners, product managers, and scrum masters
    • Delivery managers
    • Delivery teams
    • Stakeholders
    • Senior leaders

    Product Owner Module

    Establish an effective product owner role

    Activities

    2.1 Identify enablers and blockers

    2.2 (Optional) Dissect this definition of the product owner role

    This step involves the following participants:

    • Product owners, product managers, and scrum masters
    • Delivery managers and senior leaders
    • Stakeholders and delivery teams

    Outcomes of this step

    • Identify cultural enablers and blockers for product owners.
    • Develop a deeper understanding of the product owner role.

    The importance of establishing an effective product owner role

    The critical importance of establishing an effective product owner role (PO) for your Agile projects cannot be overstated.

    Many new-to-Agile organizations do not fully appreciate the critical role played by the PO in Scrum, nor the fundamental changes the organization will need to make in support of the PO role. Both mistakes will reduce an organization's chances of successfully adopting Agile and achieving its promised benefits.

    The PO role is critical to the proper prioritization of requirements and efficient decision-making during the project.

    The PO role helps the organization to avoid "analysis paralysis" challenges often experienced in large command-and-control-style organizations.

    A poorly chosen or disengaged product owner will almost certainly stifle your Agile project.

    Note that for many organizations, "product owner" is not a formally recognized role, which can create HR issues. Some organizational education on Agile may be needed (especially if your organization is unionized).

    Info-Tech Insight

    Failing to establish effective product owners in your organization can be a "species-killing event" for your Agile transformation.

    The three A's of a product owner

    To ensure the effectiveness of a product owner, your organization should select one that meets the three A's:

    Available: Assign a PO that can focus full-time on the project. Make sure your PO can dedicate the time needed to fulfill this critical role.
    Appropriate: It's best for the PO to have strong subject matter expertise (so-called "super users" are often selected to be POs) as well as strong communication, collaboration, facilitation, and arbitration skills. A good PO will understand how to negotiate the best outcomes for the project, considering all project constraints.
    Authoritative: The PO must be empowered by your organization to speak authoritatively about priorities and goals and be able to answer questions from the project team quickly and efficiently. The PO must know when decisions can be made immediately and when they must be made in collaboration with other stakeholders – choosing a PO that is well-known and respected by stakeholders will help to make this more efficient.

    Info-Tech Insight

    It's critical to assign a PO that meets the three A's:

    • Available
    • Appropriate
    • Authoritative

    The three ears of a product owner*

    An effective product owner listens to (and effectively balances) the needs and constraints of three different groups:

    Organizational needs/constraints represent what is most important to the organization overall, and typically revolve around things like cost, schedule, return on investment, time to market, risk mitigation, conforming to policies and regulations, etc.

    Stakeholder needs/constraints represent what is most important to those who will be using the system and typically revolve around the delivery of value, ease of use, better outcomes, making their jobs easier and more efficient, getting what they ask for, etc.

    Delivery Team needs/constraints represent what is most important to those who are tasked with delivering the project and cover a broad range that includes tools, skills, capabilities, technology limitations, capacity limits, adequate testing, architectural considerations, sustainable workload, clear direction and requirements, opportunities to innovate, getting sufficient input and feedback, support for clearing roadblocks, dependencies on other teams, etc.

    Info-Tech Insight

    An effective PO will expertly balance the needs of:

    • The organization
    • Project stakeholders
    • The delivery team

    * For more, see Understanding Scrum: Why do Product Owners Have Three Ears

    A product owner doesn't act alone

    Although the PO plays a unique and central role in the success of an Agile project, it doesn't mean they "act alone."

    The PO is ultimately responsible for managing and maintaining an effective backlog over the project lifecycle, but many people contribute to maintaining this backlog (on large projects, BA's are often the primary contributors to the backlog).

    The PO role also relies heavily on stakeholders (to help define and elaborate user stories, provide input and feedback, answer questions, participate in sprint demos, participate in testing of sprint deliverables, etc.).

    The PO role also relies heavily on the delivery team. Some backlog management and story elaboration is done by delivery team members instead of the PO (think: elaborating user story details, creating acceptance criteria, writing test plans for user stories, etc.).

    The PO both contributes to these efforts and leads/oversees the efforts of others. The exact mix of "doing" and "leading" can be different on a case-by-case basis and is part of establishing the delivery team's norms.

    Given the importance of the role, care must be taken to not overburden the product owner, especially on large projects.

    Info-Tech Insight

    While being ultimately responsible for the product backlog, a PO often relies on others to aid in backlog management and maintenance.

    This is particularly true on large projects.

    The use of a proxy PO

    Sometimes, a proxy product owner is needed.

    It is always best to assign a product owner "from the business," who will bring subject matter expertise and have established relationships with stakeholders.

    When a PO from the business does not have enough time to fulfill the needs of the role completely (e.g. can only be a part-time PO, because they have a day job), assigning a proxy product owner can help to compensate for this.

    The proxy PO acts on behalf of the PO in order to reduce the PO's workload or to otherwise support them.

    Project participants (e.g. delivery team, stakeholders) should treat the PO and proxy PO as roughly equivalent.

    Project managers (PMs) and business analysts (BAs) are often good candidates for the proxy PO role.

    NOTE: It's highly advisable for the PO to attend all/most sprint demos in order to observe progress for themselves, and to identify any misalignment with expectations as early as possible (remember that the PO still has ultimate responsibility for the project outcomes).

    Info-Tech Insight

    Although not ideal, assigning a proxy PO can help to compensate for a PO who doesn't meet all three A's of Product Ownership.

    It is up to the PO and proxy to decide how they will work together (e.g. establish their norms).

    The use of a proxy PO

    The PO and proxy must work together closely and in a highly coordinated way.

    The PO and proxy must:

    • Work closely at the start of the project to agree on the overall approach they will follow, as well as any needs and constraints for the project.
    • Communicate frequently and effectively throughout the project, to ensure progress is being made and to address any challenges.
    • Have a "meeting of the minds" about how the different "parts" of the PO role will be divided between them (including when the proxy must defer to the PO on matters).
    • Focus on ensuring that all the responsibilities of the PO role are fulfilled effectively by the pair (how this is accomplished is up to the two of them to decide).
    • Ensure all project participants clearly understand the POs' and proxies' relative responsibilities to minimize confusion and mistakes.

    The use of multiple POs

    Sometimes, having multiple product owners makes sense.

    It is always best to assign a single product owner to a project. However, under certain circumstances, it can make sense to use multiple POs.

    For example, when implementing a large ERP system with many distinct modules (e.g. Finance, HR) it can be difficult to find a single PO who has sufficient subject matter expertise across all modules.

    When assigning Multiple POs to a project, be sure to identify a "Lead PO" (who is given ultimate responsibility for the entire project) and have the remaining POs act like Proxy POs.

    NOTE: Not surprisingly, it's highly advisable for the Lead PO to attend as many Sprint Demos as possible to observe progress for themselves, and to identify any misalignment with expectations as early as possible (remember that the Lead PO has ultimate responsibility for the project outcomes).

    Info-Tech Best Practice

    Although not ideal, assigning multiple POs to a project sometimes makes sense.

    When needed, be sure to identify a "Lead PO" and have the other PO's act like Proxies.

    Product Owner Exercise 2.1 Identify enablers and blockers

    30-60 minutes

    1. Brainstorm and discuss the key enablers that can help promote and ease your implementation of Product Ownership.
    2. Brainstorm and discuss the key blockers (or risks) that may interrupt or derail your efforts.
    3. Brainstorm mitigation activities for each blocker.
    Enablers Blockers Mitigation
    High business engagement and buy-in Significant time is required to implement and train resources Limit the scope for pilot project to allow time to learn
    Organizational acceptance for change Geographically distributed resources Temporarily collocate all resources and acquire virtual communication technology
    Existing tools can be customized for BRM Difficulty injecting customers in demos Educate customer groups on the importance of attendance and 'what's in it for them'

    Output

    • List of enablers and blockers to establishing product owners

    Participants

    • Product owners, product managers, and scrum masters
    • Delivery managers
    • Delivery teams
    • Stakeholders
    • Senior leaders

    Establish an effective product owner role

    • The nature of a PO role can be somewhat foreign to many organizations, so candidates for the role will benefit from training along with coaching/mentoring support when starting out.
    • The PO must be able to make decisions quickly around project priorities, goals, and requirements.
    • A PO who is simply a conduit to a slow-moving steering committee will stifle an Agile project.
    • Establish clear boundaries and rules regarding which project decisions can be made directly by the PO and which must be escalated to stakeholders. Lean toward approaches that support the quickest decision-making (e.g. give the PO as much freedom as they need to be effective).
    • An effective PO has a good instinct for what is "good enough for now."
    • The organization can support the PO by focusing attention on goals and accomplishments rather than pushing processes and documentation.
    • Understand the difference between a project sponsor and a PO (the PO role is much more involved in the details, with a higher workload).
    • Agree on and clearly define the roles and responsibilities of PO, PM, dev manager, SM, etc. at the start of the project for clarity and efficiency.

    Characteristics to look for when selecting a product owner

    Here are some "ideal characteristics" for your POs (the more of these that are true for a given PO, the better):

    • Knows how to get things done in your organization
    • Has strong working relationships with project stakeholders (has established trust with them and is well respected by stakeholders as well as others)
    • Comes from the stakeholder community and is invested in the success of the project (ideally, will be an end user of the system)
    • Has proven communication, facilitation, mediation, and negotiation skills
    • Can effectively balance multiple competing priorities and constraints
    • Sees the big picture and strives to achieve the best outcomes possible (grounded in realistic expectations)
    • Works with a sense of urgency and welcomes ongoing feedback and collaboration with stakeholders
    • Understands how to act as an effective "funnel and filter" for stakeholder requests
    • Acts as an informal (but inspirational) leader whom others will follow
    • Has a strong sense of what is "good enough for now"
    • Protects the delivery team from distractions and keeps them focused on goals
    • Thinks strategically and incrementally

    Product Owner Exercise 2.2 (Optional) Dissect this definition of the product owner role

    30-60 minutes

    1. Take a minute or two to review the bullet points below, which describe the product owner's role.
    2. As a group, discuss the "message" for each bullet point in the description, and then identify which aspects would be "easy" and "hard" to achieve in your organization.
      • The product owner is a project team member who has been empowered by both the organization and stakeholders to act on their behalf and to guide the project directly with a single voice (supported by appropriate consultations with the organization and stakeholders).
      • The product owner must be someone with a good understanding of the project deliverable (they are often considered to be a subject matter expert in an area related to the project deliverable) and ideally is both well-known and respected by both the organization and stakeholders.
      • During the project, requirements clarification, prioritization, and scope changes are ultimately decided by the product owner, who must perform the important balancing act required by the project to adequately reflect the needs and constraints of the organization, its stakeholders, and the project team.
      • The product owner role can only be successful in an organization that has established a trusting and supportive culture. Great trust must be placed in the product owner to adequately balance competing needs in a way that leads to good outcomes for the organization. This trust must come with some authority to make important project decisions, and the organization must also support the product owner in addressing risks and roadblocks outside the control of the project team.
      • The product owner is first among equals when it comes to ultimate ownership of success for the project (along with the project delivery team itself). Because of this, any project of any significance will require the full-time effort of the product owner (don't shortchange yourself by under-investing in a willing, able, and available product owner)

    Output

    • Better understanding of the product owner role.

    Participants

    • Product owners, product managers, and scrum masters
    • Delivery managers
    • Delivery teams
    • Stakeholders
    • Senior leaders

    Product Owner Exercise 2.2 (Optional) Dissect this definition of the product owner role

    Which aspects of the product owner are "easy" in your organization?

    Which aspects of the product owner are "hard" in your organization?

    Product Owner Module

    Establish an effective product owner role

    Activities

    3.1 Build a starting checklist of quality filters

    This step involves the following participants:

    • Product owners, product managers, and scrum masters
    • Delivery managers and senior leaders
    • Stakeholders and delivery teams

    Outcomes of this step

    • Understand the levels in a product backlog and how to create quality filters for PBIs moving through the backlog.
    • Define your product roadmap approach for key audiences.

    Product Owner Step 3: Managing effective product backlogs and roadmaps

    The primary role of the product owner is to manage the backlog effectively.

    When managed properly, the product backlog is a powerful project management tool that directly contributes to project success.

    The product owner's primary responsibility is to ensure this backlog is managed effectively.

    A backlog stores and organizes PBIs at various stages of readiness

    A well-formed backlog can be thought of as a DEEP backlog:

    • Detailed Appropriately: Product backlog items (PBIs) are broken down and refined as necessary.
    • Emergent: The backlog grows and evolves over time as PBIs are added and removed.
    • Estimated: The effort a PBI requires is estimated at each tier.
    • Prioritized: The PBIs value and priority are determined at each tier.

    (Perforce, 2018)

    An image showing the Ideas; Qualified; Ready; funnel leading to the sprint approach.

    Backlog tiers facilitate product planning steps

    An image of the product planning steps facilitated by Backlog Tiers

    Each activity is a variation of measuring value and estimating effort to validate and prioritize a PBI.

    A PBI meets our definition of done and passes through to the next backlog tier when it meets the appropriate criteria. Quality filters should exist between each tier.

    Backlog Exercise 2.1 Build a starting checklist of quality filters

    60 minutes

    1. Quality filters provide a checklist to ensure each Product Backlog Item (PBI) meets our definition of Done and is ready to move to the next backlog group (status).
    2. Create a checklist of basic descriptors that must be completed between each backlog level.
    3. If you completed this exercise in a different Module, review and update it here.
    4. Use this information to start your product strategy playbook in Deliver on Your Digital Product Vision.

    An image of the backlog tiers, identifying where product backlog and sprint backlog are

    Output

    • List of enablers and blockers to establishing product owners

    Participants

    • Product owners, product managers, and scrum masters
    • Delivery managers
    • Delivery teams
    • Stakeholders
    • Senior leaders

    Outline the criteria to proceed to the next tier via quality filters

    Expand the concepts of defining "ready" and "done" to include the other stages of a PBIs journey through product planning.

    An image showing the approach you will use to Outline the criteria to proceed to the next tier via quality filters

    Info-Tech Insight: A quality filter ensures quality is met and teams are armed with the right information to work more efficiently and improve throughput.

    Define product value by aligning backlog delivery with roadmap goals

    In each product plan, the backlogs show what you will deliver.

    Roadmaps identify when and in what order you will deliver value, capabilities, and goals.

    Product roadmaps guide delivery and communicate your strategy

    In Deliver on Your Digital Product Vision, we demonstrate how the product roadmap is core to value realization. The product roadmap is your communicated path, and as a product owner, you use it to align teams and changes to your defined goals while aligning your product to enterprise goals and strategy.

    This is an image Adapted from: Pichler, What Is Product Management?

    Adapted from: Pichler, "What Is Product Management?"

    Info-Tech Insight

    The quality of your product backlog – and your ability to realize business value from your delivery pipeline – is directly related to the input, content, and prioritization of items in your product roadmap.

    Product delivery realizes value for your product family

    While planning and analysis are done at the family level, work and delivery are done at the individual product level.

    An example of performing planning and analysis at the family level.

    Leverage the product family roadmap for alignment

    It's more than a set of colorful boxes. It's the map to align everyone to where you are going.

    • Your product family roadmap:
      • Lays out a strategy for your product family.
      • Is a statement of intent for your family of products.
      • Communicates direction for the entire product family and product teams.
      • Directly connects to the organization's goals.
    • However, it is not:
      • Representative of a hard commitment.
      • A simple combination of your current product roadmaps.

    Your ideal roadmap approach is a spectrum, not a choice!

    Match your roadmap and backlog to the needs of the product.

    Tactical vs strategic roadmaps.

    Product Managers do not have to choose between being tactical or strategic.
    – Aha!, 2015

    Multiple roadmap views can communicate differently yet tell the same truth

    Audience

    Business/
    IT Leaders

    Users/Customers

    Delivery Teams

    Roadmap

    View

    Portfolio

    Product Family

    Technology

    Objectives

    To provide a snapshot
    of the portfolio and
    priority products

    To visualize and validate product strategy

    To coordinate broad technology and architecture decisions

    Artifacts

    Line items or sections of the roadmap are made up of individual products, and an artifact represents a disposition at its highest level.

    Artifacts are generally grouped by product teams and consist of strategic goals and the features that realize
    those goals.

    Artifacts are grouped by
    the teams who deliver
    that work and consist of technical capabilities that support the broader delivery of value for the product family.

    Product Owner Exercise 3.1 Build a starting checklist of quality filters

    60 minutes

    1. Views provide roadmap information to different audiences in the format and level of detail that is fit to their purpose.
    2. Consider the three primary audiences for roadmap alignment.
    3. Define the roles or people who the view best fits.
    4. Define the level of detail or artifacts shared in the view for each audience.
    5. Use this information to start your product strategy playbook in Deliver on Your Digital Product Vision.

    Business/
    IT Leaders

    Users/Customers

    Delivery Teams

    Audience:

    Audience:

    Audience:

    Level of Detail/Artifacts:

    Level of Detail/Artifacts:

    Level of Detail/Artifacts:

    Output

    • List of enablers and blockers to establishing product owners

    Participants

    • Product owners, product managers, and scrum masters
    • Delivery managers
    • Delivery teams
    • Stakeholders
    • Senior leaders

    Connecting your product family roadmaps to product roadmaps

    Your product and product family roadmaps should be connected at an artifact level that is common between both. Typically, this is done with capabilities, but it can be done at a more granular level if an understanding of capabilities isn't available.

    A comparison between product family roadmaps and product roadmaps.

    Use product roadmaps to align cross-team dependencies

    Regardless of how other teams operate, teams need to align to common milestones.

    An image showing how you may Use product roadmaps to align cross-team dependencies

    Product Owner Module

    Establish an effective product owner role

    Activities

    4.1 Identify key insights and takeaways

    4.2 Perform exit survey and capture results

    This step involves the following participants:

    • Product owners, product managers, and scrum masters
    • Delivery managers and senior leaders
    • Stakeholders and delivery teams

    Outcomes of this step

    • Identify your key insights and takeaways.

    Product Owner Exercise 4.1
    Identify key insights and takeaways

    30 minutes

    1. As a group, discuss and capture your thoughts on:
      1. What key insights have participants gained from the Intro to Agile presentation?
      2. What if any takeaways do participants feel are needed as a result of the presentation?
      3. What changes need to be made in the organization to support/enhance Agile adoption?
    2. Capture your findings in the table below:
    What key insights have you gained? What takeaways have you identified?
    (e.g. better understanding of Agile mindset, principles, and practices) (e.g. how you can improve/spread Agile practices in the organization)

    Output

    • A better understanding of Agile principles and practices
    • Action items that will help solidify Agile practices in the organization

    Participants

    • Product owners, product managers, and scrum masters
    • Delivery managers
    • Delivery teams
    • Stakeholders
    • Senior leaders

    Product Owner Exercise 4.2
    Perform an exit survey

    30 minutes

    1. Wrap up this section by addressing any remaining questions participants still have.
    2. Create your local exit survey by copying the template using the link below. Then copy and distribute your local survey link.
    3. Collect the consolidated survey results in preparation for your next steps.
    4. NOTE: Using this survey template requires having access to Microsoft Forms. If you cannot access Microsoft Forms, an Info-Tech analyst can send the survey for you. Alternatively, this survey can be done with sticky notes and a pen and paper to calculate the outcomes.

    Download Survey Template:

    Develop Your Agile Approach Exit Survey Template

    Output

    • A better understanding of Agile principles and practices
    • Action items that will help solidify Agile practices in the organization

    Participants

    • Product owners, product managers, and scrum masters
    • Delivery managers
    • Delivery teams
    • Stakeholders
    • Senior leaders

    Agile Modules

    Prioritize Agile support with your top challenges

    Backlog Management

    Scrum Simulation

    Estimation

    Product Owner

    Product Roadmapping

    1: User stories and the art of decomposition

    2: Effective backlog management & refinement

    3: Identify insights and team feedback

    1: Scrum sprint planning and retrospective simulation

    2: Pass the balls – sprint velocity game

    1: Improve product backlog item estimation

    2: Agile estimation fundamentals

    3: Understand the wisdom of crowds

    4: Identify insights and team feedback

    1: Understand product management fundamentals

    2: The critical role of the product owner

    3: Manage effective product backlogs and roadmaps

    4: Identify insights and team feedback

    1: Identify your product roadmapping pains

    2: The six "tools" of product roadmapping

    3: Product roadmapping exercise

    Organizations often struggle with numerous pain points around Agile delivery.
    The Common Agile Challenges Survey results will help you identify and prioritize the organization's biggest (most cited) pain points. Treat these pain points like a backlog and address the biggest ones first.

    Agile modules provide supporting activities:

    Each module provides guidance and supporting activities related to a specific Agile challenge from your survey. These modules can be arranged to meet each organization's or team's needs while providing cohesive and consistent messaging. For additional supporting research, please visit the Agile / DevOps Resource Center.

    This phase involves the following participants:

    • Product owners, product managers, and scrum masters
    • Delivery managers and senior leaders
    • Stakeholders and delivery teams

    Product Roadmapping

    Create effective product roadmaps

    Activities

    Roadmapping 1.1 Identify your product roadmapping pains
    Roadmapping 1.2 The six "tools" of product roadmapping
    Roadmapping 1.3 Product roadmapping exercise

    This step involves the following participants:

    • Product owners, product managers, and scrum masters
    • Delivery managers and senior leaders
    • Stakeholders and delivery teams

    Outcomes of this step

    • Understand product management fundamentals
    • Understand the six "tools" of roadmapping and how to use them

    Roadmapping Exercise 1.1: Tell us what product management means to you and how it differs from a project orientation

    10-15 minutes

    1. Share your current understanding of product management.
    What is product management, and how does it differ from a project orientation?

    Output

    • Your current understanding of product management and its benefits

    Participants

    • PMs, Pos, and SMs
    • Delivery managers
    • Delivery teams
    • Business stakeholders
    • Senior leaders
    • Other interested parties

    Definition of terms

    Project

    "A temporary endeavor undertaken to create a unique product, service, or result. The temporary nature of projects indicates a beginning and an end to the project work or a phase of the project work. Projects can stand alone or be part of a program or portfolio."

    – PMBOK, PMI

    Product

    "A tangible solution, tool, or service (physical or digital) that enables the long-term and evolving delivery of value to customers and stakeholders based on business and user requirements."
    Deliver on Your Digital Product Vision,
    Info-Tech Research Group

    Info-Tech Insight

    Any proper definition of product recognizes that they are long-term endeavors that don't end after the project finishes. Because of this, products need well thought out roadmaps.

    Deliver Digital Products at Scale via Enterprise Product Families

    Match your product management role definitions to your product family levels

    Product ownership exists at the different operational tiers or levels in your product hierarchy. This does not imply or require a management relationship.

    Product Portfolio
    Groups of product families within an overall value stream or capability grouping.
    Product Portfolio Manager

    Product Family
    A collection of related products. Products can be grouped along architectural, functional, operational, or experiential patterns.
    Product Family Manager

    Product
    Single product composed of one or more applications and services.
    Product Owner

    Info-Tech Insight

    The primary role conflict occurs when the product owner is a proxy for stakeholders or responsible for the delivery team. The product owner owns the product backlog. The delivery team owns the sprint backlog and delivery.

    Roadmapping Exercise 1.2 (Optional): Define "product" in your context*

    15-30 minutes

    1. Discuss what "product" means in your organization.
    2. Create a common, enterprise definition for "product."

    For example,

    • An application, platform, or application family.
    • Discrete items that deliver value to a user/customer.

    Capture your organization's definition of product:

    * For more on Product Management see Deliver on Your Digital Product Vision

    Output

    • Your enterprise/ organizational definition of products and services.

    Participants

    • PMs, Pos, and SMs
    • Delivery managers
    • Delivery teams
    • Business stakeholders
    • Senior leaders
    • Other interested parties

    Product Roadmapping

    Create effective product roadmaps

    Activities

    The six "tools" of product roadmapping

    This step involves the following participants:

    • Product owners, product managers, and scrum masters
    • Delivery managers and senior leaders
    • Stakeholders and delivery teams

    Outcomes of this step

    • Understand product management fundamentals
    • Understand the six "tools" of roadmapping and how to use them

    The six "tools" of product roadmapping

    the 6 tools of product roadmapping: Vision; Goals; Strategy; Roadmap; Backlog; Release Plan.

    Product Roadmapping

    Create effective product roadmaps

    Activities

    Roadmapping 3.1 Product roadmapping exercise
    Roadmapping 3.2 Identify key insights and takeaways
    Roadmapping 3.3 Perform an exit survey

    This step involves the following participants:

    • Product owners, product managers, and scrum masters
    • Delivery managers and senior leaders
    • Stakeholders and delivery teams

    Outcomes of this step

    • Understand product management fundamentals
    • Understand the six "tools" of roadmapping and how to use them

    Roadmapping Exercise 1.2 (Optional): Define "product" in your context*

    30 minutes

    1. As a team, read through the exercise back story below:

    The city of Binbetter is a picturesque place that is sadly in decline because local industry jobs are slowly relocating elsewhere. So, the local government has decided to do something to reinvigorate the city. Binbetter City Council has set aside money and a parcel of land they would like to develop into a venue that will attract visitors and generate revenue for the city.

    Your team was hired to develop the site, and you have already spent time with city representatives to create a vision, goals and strategy for building out this venue (captured on the following slides). The city doesn't want to wait until the entire venue is completed before it opens to visitors, and so you have been instructed to build it incrementally in order to bring in much needed revenue as soon as possible.

    Using the vision, goals, and strategy you have created, your team will need to plan out the build (i.e. create a roadmap and release plan for which parts of the venue to build and in which order). You can assume that visitors will come to the venue after your "Release 1", even while the rest is still under construction. Select one member of your team to be designated as the product owner. The entire team will work together to consider options and agree on a roadmap/release plan, but the product owner will be the ultimate decision-maker.

    * Adapted from Rautiainen et al, Toward Agile Product and Portfolio Management, 2015

    Output

    • Practical understanding of how to apply the six tools of product roadmapping.

    Participants

    • PMs, Pos, and SMs
    • Delivery managers
    • Delivery teams
    • Business stakeholders
    • Senior leaders
    • Other interested parties

    Roadmapping Exercise 3.1: Continued

    1. As a team, review vision, goal, and strategy:
      • Is this a "good" vision statement, and if so, why?
      • Does it live up to its definition of being: "notional and inspirational, while also calling out key guidance and constraints"?
      • Does it help you to rule in/out options for the Product?
      • e.g. Would a parking lot fit the vision?
      • What about a bunch of condominiums?
      • What about a theme park?

    Vision, Goals, and Strategy

    Product Vision: Create an architecturally significant venue that will attract both locals and tourists while also generating revenue for the city

    Roadmapping Exercise 3.1: Continued

    1. As a team, review vision, goal, and strategy:

    Vision, Goals, and Strategy

    Product Vision: Create an architecturally significant venue that will attract both locals and tourists while also generating revenue for the city

    An image of a Château-style Hotel (left) and a Gothic-style Cathedral (right)

    Goals: The venue will include a Château-style Hotel, Gothic-style Cathedral, and a Monument dedicated to the city's founder, Ivy Binbetter.

    Strategy: Develop the venue incrementally, focusing on the highest value elements first (prioritizing both usages by visitors and revenue generation).

    Roadmapping Exercise 3.1: Continued

    1. As a team, review the following exercise rules:
    • Your construction team has told you that they can divide the structures into 17 "equal" components (see below)
    • Each component will require about the same amount of time and resources to complete
    • You can ask the team to build these components in any order and temporary roofs can be built for components that are not at the top of a "stack" (e.g. you can build C3 without having to build C4 and C5 at the same time)
    • However, you cannot build the tops of any buildings first (e.g. don't build M3 until M2 and M1 are in place)

    An image of the chateau hotel and the Gothic Cathedral from the previous slide, broken down into 7 parts each

    Roadmapping Exercise 3.1: Continued

    1. As a team, review vision, goal, and strategy:
      • The city has asked you to decide on your "Release 1 MVP" and has limited you to selecting between 4 and 8 components for this MVP (fewer components = earlier opening date).
      • As a team, work together to decide which components will be in your MVP (remember, the PO makes the ultimate decision).
      • Drag your (4-8) selected MVP components over from the right and assemble them below (and explain your reasoning for your MVP selections):

    Release 1 (MVP)

    Vision, Goals, and Strategy

    Product Vision: Create an architecturally significant venue that will attract both locals and tourists while also generating revenue for the city

    Goals: The venue will include a Château-style Hotel, Gothic-style Cathedral, and a Monument dedicated to the city's founder, Ivy Binbetter.

    Strategy: Develop the venue incrementally, focusing on the highest value elements first (prioritizing both usages by visitors and revenue generation).

    An image of the chateau hotel and the Gothic Cathedral from the previous slide, broken down into 7 parts each

    Roadmapping Exercise 3.1: Continued
    (magnified venue)

    An image of the chateau hotel and the Gothic Cathedral from the previous slide, broken down into 7 parts each

    Roadmapping Exercise 3.1: Continued

    1. As a team, decide the rest of your roadmap:
      • The city has asked you to decide on the remainder of your roadmap
      • They have limited you to selecting between 2 and 4 components for each additional release (drag your selected component into each release below):
    Release 2 Release 3 Release 4 Release 5

    Vision, Goals, and Strategy

    Product Vision: Create an architecturally significant venue that will attract both locals and tourists while also generating revenue for the city

    Goals: The venue will include a Château-style Hotel, Gothic-style Cathedral, and a Monument dedicated to the city's founder, Ivy Binbetter.

    Strategy: Develop the venue incrementally, focusing on the highest value elements first (prioritizing both usages by visitors and revenue generation).

    An image of the chateau hotel and the Gothic Cathedral from the previous slide, broken down into 7 parts each

    Roadmapping Exercise 3.1: Continued

    Roadmap, Release Plan and Backlog

    an example roadmap plan; INCREASING: Priority; Requirements detail; Estimate accuracy; Level of commitment.

    Vision, Goals, and Strategy

    Product Vision: Create an architecturally significant venue that will attract both locals and tourists while also generating revenue for the city

    Goals: The venue will include a Château-style Hotel, Gothic-style Cathedral, and a Monument dedicated to the city's founder, Ivy Binbetter.

    Strategy: Develop the venue incrementally, focusing on the highest value elements first (prioritizing both usages by visitors and revenue generation).

    An image of the chateau hotel and the Gothic Cathedral from the previous slide, broken down into 7 parts each

    Roadmapping Exercise 3.2:
    Identify key insights and takeaways

    15 minutes

    1. As a group, discuss and capture your thoughts on:
      1. What key insights have participants gained from the product roadmapping module?
      2. What if any takeaways do participants feel are needed as a result of the module?
      3. What changes need to be made in the organization to support/enhance Agile adoption?
    2. Capture your findings in the table below:
    What key insights have you gained?What takeaways have you identified?
    • (e.g. better understanding of Agile mindset, principles, and practices)
    • (e.g. how you can improve/spread Agile practices in the organization)

    Output

    • A better understanding of Agile principles and practices
    • Action items that will help solidify Agile practices in the organization

    Participants

    • Product owners, product managers, and scrum masters
    • Delivery managers
    • Delivery teams
    • Stakeholders
    • Senior leaders

    Roadmapping Exercise 3.3
    Perform an exit survey

    30 minutes

    1. Wrap up this section by addressing any remaining questions participants still have.
    2. Create your local exit survey by copying the template using the link below. Then copy and distribute your local survey link.
    3. Collect the consolidated survey results in preparation for your next steps.
    4. NOTE: Using this survey template requires having access to Microsoft Forms. If you cannot access Microsoft Forms, an Info-Tech analyst can send the survey for you. Alternatively, this survey can be done with sticky notes and a pen and paper to calculate the outcomes.

    Download Survey Template:

    Develop Your Agile Approach Exit Survey Template

    Output

    • A better understanding of Agile principles and practices
    • Action items that will help solidify Agile practices in the organization

    Participants

    • Product owners, product managers, and scrum masters
    • Delivery managers
    • Delivery teams
    • Stakeholders
    • Senior leaders

    Appendix

    Additional research to start your journey

    Related Info-Tech Research

    Mentoring for Agile Teams

    • Get practical help and guidance on your Agile transformation journey.

    Implement DevOps Practices That Work

    • Streamline business value delivery through the strategic adoption of DevOps practices.

    Deliver on Your Digital Product Vision

    • Build a product vision your organization can take from strategy through execution.

    Deliver Digital Products at Scale

    • Deliver value at the scale of your organization through defining enterprise product families.

    Bibliography

    "Agile Estimation Practice." DZone.com, 13 May 2013. Web.
    "Announcing DORA 2021 Accelerate State of DevOps Report." Google Cloud Blog. Accessed 8 Nov. 2022.
    "Are Your IT Strategy and Business Strategy Aligned?" 5Q Partners, 8 Jan. 2015. Accessed Oct. 2016.
    A, Karen. "20 Mental Models for Product Managers." Medium, Product Management Insider, 2 Aug. 2018 . Web.
    ADAMS, PAUL. "Product Teams: How to Build & Structure Product Teams for Growth." Inside Intercom, 30 Oct. 2019. Web.
    Agile Alliance. "Product Owner." Agile Alliance. n.d. Web.
    Ambysoft. "2018 IT Project Success Rates Survey Results." Ambysoft. 2018. Web.
    Banfield, Richard, et al. "On-Demand Webinar: Strategies for Scaling Your (Growing) Enterprise Product Team." Pluralsight, 31 Jan. 2018. Web.
    Bloch, Michael, Sven Blumberg, and Jurgen Laartz. "Delivering Large-Scale IT Projects on Time, on Budget, and on Value." McKinsey & Company, October 2012.
    Blueprint. "10 Ways Requirements Can Sabotage Your Projects Right From the Start." Blueprint. 2012. Web.
    Boehm, Barry W. Software Engineering Economics. New Jersey: Prentice Hall, 1981.
    Breddels, Dajo, and Paul Kuijten. "Product Owner Value Game." Agile2015 Conference. 2015. Web.
    Cagan, Martin. "Behind Every Great Product." Silicon Valley Product Group. 2005. Web.
    "Chaos Report 2015." The Standish Group, 2015. Accessed 29 July 2022.
    Cohn, Mike. Succeeding With Agile: Software Development Using Scrum. Addison-Wesley. 2010. Web.
    Connellan, Thomas K. Inside the Magic Kingdom, Bard Press, 1997. Print.
    Dyba, Tore, and Torgeir Dingsøyr. "Empirical Studies of Agile Software Development: A Systematic Review." Elsevier, ScienceDirect. 24 Jan. 2008. Web.
    "How do you define a product?" Scrum.org. 4 Apr 2017, Web
    EDUCAUSE. "Aligning IT Funding Models to the Pace of Technology Change." EDUCAUSE. 14 Dec. 2015. Web.
    Eick, Stephen. "Does Code Decay? Assessing the Evidence from Change Management Data." IEEE Transactions on Software Engineering, vol. 27, no. 1, Jan. 2001, pp. 1-12. Web.
    "Enablers." Scaled Agile. n.d. Web.
    "Epic." Scaled Agile. n.d. Web.
    Eringa, Ron. "Evolution of the Product Owner." RonEringa.com. 12 June 2016. Web.
    Fernandes, Thaisa. "Spotify Squad Framework - Part I." Medium.com. 6 Mar. 2017. Web.
    Fowler, Martin. "Application Boundary." MartinFowler.com. 11 Sept. 2003. Web. 20 Nov. 2017.
    Galen, Robert. "Measuring Technical Product Managership – What Does 'Good' Look Like ...." RGalen Consulting. 5 Aug. 2015. Web.
    Hackshall, Robin. "Product Backlog Refinement." Scrum Alliance. 9 Oct. 2014. Web. Feb. 2019.
    Halisky, Merland, and Luke Lackrone. "The Product Owner's Universe." Agile Alliance, Agile2016. 2016. Web.
    Kamer, Jurriaan. "How to Build Your Own 'Spotify Model'." Medium.com. 9 Feb. 2018. Web.
    Karlsson, Johan. "Backlog Grooming: Must-Know Tips for High-Value Products." Perforce. 18 May 2018. Web. Feb. 2019.
    Lindstrom, Lowell. "7 Skills You Need to Be a Great Product Owner." Scrum Alliance. n.d. Web.
    Lawrence, Richard, and Peter Green. "The Humanizing Work Guide to Splitting User Stories." Humanizing Work, 22 Oct. 2020. Web.
    Leffingwell, Dean. "SAFe 5.0." Scaled Agile Inc. 2021. Web. Feb. 2021.
    Lucero, Mario. "Product Backlog – Deep Model." Agilelucero. 8 Oct. 2014. Web.
    Lukassen, Chris. "The Five Belts Of The Product Owner." Xebia.com. 20 Sept. 2016. Web.
    Management 3.0. "Delegation Poker Product Image." Management 3.0. n.d. Web.
    McCloskey, Heather. "Scaling Product Management: Secrets to Defeating Common Challenges." Scaling Product Management: Secrets to Defeating Common Challenges, ProductPlan, 12 July 2019 . Web.
    McCloskey, Heather. "When and How to Scale Your Product Team." UserVoice Blog, UserVoice, 21 Feb. 2017 . Web.
    Medium.com. "Exploring Key Elements of Spotify's Agile Scaling Model." Medium.com. 23 July 2018. Web.
    Mironov, Rich. "Scaling Up Product Manager/Owner Teams: - Rich Mironov's Product Bytes." Rich Mironov's Product Bytes, Mironov Consulting, 12 Apr. 2014 . Web.
    "Most Agile Transformations Will Fail." Vitality Chicago Inc., 24 Jan. 2019.
    Overeem, Barry. "A Product Owner Self-Assessment." Barry Overeem. 6 Mar. 2017. Web.
    Overeem, Barry. "Retrospective: Using the Team Radar." Barry Overeem. 27 Feb. 2017. Web.
    "PI Planning." Scaled Agile. n.d. Web.
    "PI Planning."SAFe. 2020.
    Pichler, Roman. "How to Scale the Scrum Product Owner." Roman Pichler, 28 June 2016 . Web.
    Pichler, Roman. "Product Management Framework." Pichler Consulting Limited. 2014. Web.
    Pichler, Roman. "Sprint Planning Tips for Technical Product Managers." LinkedIn. 4 Sept. 2018. Web.
    Pichler, Roman. "What Is Product Management?" Pichler Consulting Limited. 26 Nov. 2014. Web.
    Project Management Institute. A Guide to the Project Management Body of Knowledge (PMBOK Guide). 7th ed., Project Management Institute, 2021.
    Radigan, Dan. "Putting the 'Flow' Back in Workflow With WIP Limits." Atlassian. n.d. Web.
    Royce, Dr. Winston W. "Managing the Development of Large Software Systems." Scf.usc.edu. 1970. Web.
    Schuurman, Robbin. "10 Tips for Technical Product Managers on Agile Product Management." Scrum.org. 28 Nov. 2017. Web.
    Schuurman, Robbin. "10 Tips for Technical Product Managers on (Business) Value." Scrum.org. 30 Nov. 2017. Web.
    Schuurman, Robbin. "10 Tips for Technical Product Managers on Product Backlog Management." Scrum.org. 5 Dec. 2017. Web.
    Schuurman, Robbin. "10 Tips for Technical Product Managers on the Product Vision." Scrum.org. 29 Nov. 2017. Web.
    Schuurman, Robbin. "Tips for Starting Technical Product Managers." Scrum.org. 27 Nov. 2017. Web.
    Sharma, Rohit. "Scaling Product Teams the Structured Way." Monetary Musings, Monetary Musings, 28 Nov. 2016 . Web.
    STEINER, ANNE. "Start to Scale Your Product Management: Multiple Teams Working on Single Product." Cprime, Cprime, 6 Aug. 2019 . Web.
    Shirazi, Reza. "Betsy Stockdale of Seilevel: Product Managers Are Not Afraid To Be Wrong." Austin VOP #50. 2 Oct. 2018. Web.
    Standish Group, The. "The Standish Group 2015 Chaos Report." The Standish Group. 2015. Web.
    Theus, Andre. "When Should You Scale the Product Management Team?" When Should You Scale the Product Management Team?, ProductPlan, 7 May 2019 . Web.
    Todaro, Dave. "Splitting Epics and User Stories." Ascendle. n.d. Web. Feb. 2019.
    Tolonen, Arto. "Scaling Product Management in a Single Product Company." Smartly.io - Digital Advertising Made Easy, Effective, and Enjoyable, Smartly.io, 26 Apr. 2018 . Web.
    Ulrich, Catherine. "The 6 Types of Product Managers. Which One Do You Need?" Medium.com. 19 Dec. 2017. Web.
    Vähäniitty, J. et al. "Chapter 7: Agile Product Management" in Towards Agile Product and Portfolio Management. Aalto University Software Process Research Group, 2010.
    VersionOne. "12th Annual State of Agile Report." VersionOne. 9 April 2018. Web.
    Verwijs, Christiaan. "Retrospective: Do The Team Radar." Medium.com. 10 Feb. 2017. Web.
    "Why Agile Fails Because of Corporate Culture - DZone Agile." Dzone.Com. Accessed 31 Aug. 2021.

    page 1 of the appendix
    page 2 of the appendix
    page 3 of the appendix
    page 4 of the appendix

    Cultural advantages of Agile

    Collaboration

    Team members leverage all their experience working towards a common goal.

    Iterations

    Cycles provide opportunities for more product feedback.

    Prioritization

    The most important needs are addressed in the current iteration.

    Continual Improvement

    Self-managing teams continually improve their approach for next iteration.

    A backlog stores and organizes PBIs at various stages of readiness

    A well-formed backlog can be thought of as a DEEP backlog:

    • Detailed Appropriately: Product backlog items (PBIs) are broken down and refined as necessary.
    • Emergent: The backlog grows and evolves over time as PBIs are added and removed.
    • Estimated: The effort a PBI requires is estimated at each tier.
    • Prioritized: The PBIs value and priority are determined at each tier.

    (Perforce, 2018)

    Info-Tech Best Practice

    Don't fully elaborate all of your PBIs at the beginning of the project instead, make sure they are elaborated "just in time." (Keep no more than 2 or 3 sprints worth of user stories in the Ready state.)

    An image showing the Ideas; Qualified; Ready; funnel leading to the sprint aproach.

    Scrum versus Kanban: Key differences

    page 6 of the appendix

    Scrum versus Kanban: When to use each

    Scrum: Delivering related or grouped changes in fixed time intervals.

    • Coordinating the development or release of related items
    • Maturing a product or service
    • Interdependencies between work items

    Kanban: Delivering independent items as soon as each is ready.

    • Work items from ticketing or individual requests
    • Completing independent changes
    • Releasing changes as soon as possible

    Develop an adaptive governance process

    page 7 of the appendix

    Five key principles for building an adaptive governance framework

    Delegate and Empower

    Decision making must be delegated down within the organization, and all resources must be empowered and supported to make effective decisions.

    Define Outcomes

    Outcomes and goals must be clearly articulated and understood across the organization to ensure decisions are in line and stay within reasonable boundaries.

    Make Risk informed decisions

    Integrated risk information must be available with sufficient data to support decision making and design approaches at all levels of the organization.

    Embed / Automate

    Governance standards and activities need to be embedded in processes and practices. Optimal governance reduces its manual footprint while remaining viable. This also allows for more dynamic adaptation.

    Establish standards and behavior

    Standards and policies need to be defined as the foundation for embedding governance practices organizationally. These guardrails will create boundaries to reinforce delegated decision making.

    Maturing governance is a journey

    Organizations should look to progress in their governance stages. Ad-Hoc, and controlled governance tends to be slow, expensive, and a poor fit for modern practices.

    The goal as you progress in your stages is to delegate governance and empower teams to make optimal decisions in real-time, knowing that they are aligned with the understood best interests of the organization.

    Automate governance for optimal velocity, while mitigating risks and driving value.

    This puts your organization in the best position to be adaptive and able to react effectively to volatility and uncertainty.

    page 8 of the appendix

    Business value is a key component to driving better decision making

    Better Decisions

    • Team Engagement
    • Frequent Delivery
    • Stakeholder Input
    • Market Analysis
    • Articulating Business Value
    • Focus on Business Needs

    Facilitation Planning Tool

    • Double-click the embedded Excel workbook to select and plan your exercises and timing.
    • Place or remove the "X" in the "Add to Agenda" column to add it to the workshop agenda and duration estimate.
    • Verify the exercise and step timing estimates from the blueprint provided on the "Detailed Workshop Planner" in columns C-F and adjust based on your facilitation and intended audience.

    an image of the Facilitation Planning Tool

    Appendix:
    SDLC transformation steps

    Waterfall SDLC: Valuable product delivered at the end of an extended project lifecycle, frequently in years

    Page 1 of the SDLC Appendix.

    • Business separated from delivery of technology it needs, only one third of product is actually valuable (Info-Tech, N=40,000).
    • In Waterfall, a team of experts in specific disciplines hand off different aspects of the lifecycle.
    • Document signoffs are required to ensure integration between silos (Business, Dev, and Ops) and individuals.
    • A separate change request process lays over the entire lifecycle to prevent changes from disrupting delivery.
    • Tools are deployed to support a specific role (e.g. BA) and seldom integrated (usually requirements <-> test).

    Wagile/Agifall/WaterScrumFall SDLC: Valuable product delivered in multiple releases

    Page 2 of the SDLC Appendix.

    • Business is more closely integrated by a business product owner accountable for day-to-day delivery of value for users.
    • The team collaborates and develops cross-functional skills as they define, design, build, and test code over time.
    • Signoffs are reduced but documentation is still focused on satisfying project delivery and operations policy requirements.
    • Change is built into the process to allow the team to respond to change dynamically.
    • Tools start to be integrated to streamline delivery (usually requirements and Agile work management tools).

    Agile SDLC: Valuable product delivered iteratively; frequency depends on Ops' capacity

    Page 3 of the SDLC Appendix.

    • Business users are closely integrated through regularly scheduled demos (e.g. every two weeks).
    • Team is fully cross-functional and collaboratesto plan, define, design, build, and test the code supported by specialists.
    • Documentation is focused on future development and operations needs.
    • Change is built into the process to allow the team to respond to change dynamically.
    • Explore automation for application development (e.g. automated regression testing).

    Agile with DevOps SDLC: High frequency iterative delivery of valuable product (e.g. every two weeks)

    Page 4 of the SDLC Appendix.

    • Business users are closely integrated through regularly scheduled demos.
    • Dev and ops teams collaborate to plan, define, design, build, test, and deploy code supported by automation.
    • Documentation is focused on supporting users, future changes, and operational support.
    • Change is built into the process to allow the team to respond to change dynamically.
    • Build, test, deploy is fully automated (service desk is still separated).

    DevOps SDLC: Continuous integration and delivery

    Page 5 of the SDLC Appendix.

    • Business users are closely integrated through regularly scheduled demos.
    • Fully integrated DevOps team collaborates to plan, define, design, build, test, deploy, and maintain code.
    • Documentation Is focused on future development and use adoption.
    • Change is built into the process to allow the team to respond to change dynamically.
    • Fully integrated development and operations toolchain.

    Fully integrated product SDLC: Agile + DevOps + continuous delivery of valuable product on demand

    Page 6 of the SDLC Appendix.

    • Business users are fully integrated with the teams through dedicated business product owner.
    • Cross-functional teams collaborate across the business and technical life of the product.
    • Documentation supports internal and external needs (business, users, Ops).
    • Change is built into the process to allow the team to respond to change dynamically.
    • Fully integrated toolchain (including service desk).

    Build an IT Employee Engagement Program

    • Buy Link or Shortcode: {j2store}544|cart{/j2store}
    • member rating overall impact: 9.2/10 Overall Impact
    • member rating average dollars saved: $5,734 Average $ Saved
    • member rating average days saved: 8 Average Days Saved
    • Parent Category Name: Engage
    • Parent Category Link: /engage
    • IT’s performance and stakeholder satisfaction with IT services hinge on IT’s ability to attract and retain top talent and to motivate teams to go above and beyond.
    • With the growing IT job market, turnover is a serious threat to IT’s ability to deliver seamless value and continuously drive innovation.
    • Engagement initiatives are often seen as being HR’s responsibility; however, IT leadership needs to take accountability for the retention and productivity of their employees in order to drive business value.

    Our Advice

    Critical Insight

    • Engagement is a two-way street. Initiatives must address a known need and be actively sought by employees – not handed down from management.
    • Engagement initiatives are useless unless they target the right issues. It can be tempting to focus on the latest perks and gadgets and ignore difficult issues. Use a systematic approach to uncover and tackle the real problems.
    • It’s time for IT leadership to step up. IT leaders have a much bigger impact on IT staff engagement than HR ever can. Leverage this power to lead your team to peak performance.

    Impact and Result

    • Info-Tech engagement diagnostics and accompanying tools will help you perform a deep dive into the root causes of disengagement on your team.
    • The guidance that accompanies Info-Tech’s tools will help you avoid common engagement program pitfalls and empower IT leaders to take charge of their own team’s engagement.

    Build an IT Employee Engagement Program Research & Tools

    Start here – read the Executive Brief

    Read our concise Executive Brief to discover why engagement is critical to IT performance, review Info-Tech’s methodology, and understand how our tools will help you construct an effective employee engagement program.

    Besides the small introduction, subscribers and consulting clients within this management domain have access to:

    1. Measure employee engagement

    Use Info-Tech's Pulse or Full Engagement Surveys to measure employee engagement.

    • Improve Employee Engagement to Drive IT Performance – Phase 1: Measure Employee Engagement
    • Engagement Strategy Record
    • Engagement Communication Template

    2. Analyze results and ideate solutions

    Understand the drivers of engagement that are important for your team, and involve your staff in brainstorming engagement initiatives.

    • Improve Employee Engagement to Drive IT Performance – Phase 2: Analyze Results and Ideate Solutions
    • Engagement Survey Results Interpretation Guide
    • Full Engagement Survey Focus Group Facilitation Guide
    • Pulse Engagement Survey Focus Group Facilitation Guide
    • Focus Group Facilitation Guide Driver Definitions
    • One-on-One Manager Meeting Worksheet

    3. Select and implement engagement initiatives

    Select engagement initiatives for maximal impact, create an action plan, and establish open and ongoing communication about engagement with your team.

    • Improve Employee Engagement to Drive IT Performance – Phase 3: Select and Implement Engagement Initiatives
    • Summary of Interdepartmental Engagement Initiatives
    • Engagement Progress One-Pager
    [infographic]

    Workshop: Build an IT Employee Engagement Program

    Workshops offer an easy way to accelerate your project. If you are unable to do the project yourself, and a Guided Implementation isn't enough, we offer low-cost delivery of our project workshops. We take you through every phase of your project and ensure that you have a roadmap in place to complete your project successfully.

    1 (Preparation) Run Engagement Survey

    The Purpose

    Select and run your engagement survey prior to the workshop.

    Key Benefits Achieved

    Receive an in-depth report on your team’s engagement drivers to form the basis of your engagement strategy.

    Activities

    1.1 Select engagement survey.

    1.2 Identify engagement program goals and metrics.

    1.3 Run engagement survey.

    Outputs

    Full or Pulse engagement survey report

    Engagement survey results interpretation guide

    2 Explore Engagement

    The Purpose

    To understand the current state of engagement and prepare to discuss the drivers behind it with your staff.

    Key Benefits Achieved

    Empower your leadership team to take charge of their own teams’ engagement.

    Activities

    2.1 Review engagement survey results.

    2.2 Finalize focus group agendas.

    2.3 Train managers.

    Outputs

    Customized focus group agendas

    3 Hold Focus Groups

    The Purpose

    Establish an open dialogue with your staff to understand what would improve their engagement.

    Key Benefits Achieved

    Employee-generated initiatives have the greatest chance at success.

    Activities

    3.1 Identify priority drivers.

    3.2 Identify engagement KPIs.

    3.3 Brainstorm engagement initiatives.

    3.4 Vote on initiatives within teams.

    Outputs

    Summary of focus groups results

    Identified engagement initiatives

    Identified engagement initiatives

    4 Select and Plan Initiatives

    The Purpose

    Learn the characteristics of successful engagement initiatives and build execution plans for each.

    Key Benefits Achieved

    Choose initiatives with the greatest impact on your team’s engagement, and ensure you have the necessary resources for success.

    Activities

    4.1 Select engagement initiatives with IT leadership.

    4.2 Create initiative project plans.

    4.3 Present project plans.

    4.4 Define implementation checkpoints.

    4.5 Develop communications plan.

    4.6 Define strategy for ongoing engagement monitoring.

    Outputs

    Engagement project plans

    Implementation and communication checkpoints

    Further surveys planned (optional)

    5 Additional Leadership Training

    The Purpose

    Select training modules that best address your team’s needs from Info-Tech’s modular leadership training program.

    Key Benefits Achieved

    Arm your IT leadership team with the key skills of effective leadership, tailored to their existing experience level.

    Activities

    5.1 Adopting an Integrated Leadership Mindset

    5.2 Optimizing Talent Leadership Practices

    5.3 Driving Diversity & Inclusion

    5.4 Fortifying Internal Stakeholder Relations

    5.5 Engaging Executives and the Board

    5.6 Crafting Your Leadership Brand

    5.7 Crafting and Delivering Compelling Presentations

    5.8 Communication & Difficult Conversations

    5.9 Conflict Management

    5.10 Performance Management

    5.11 Feedback & Coaching

    5.12 Creating a Culture of Personal Accountability

    Outputs

    Develop the skills to lead resourcefully in times of uncertainty

    Apply leadership behaviors across enterprise initiatives to deploy and develop talent successfully

    Develop diversity and inclusion practices that turn the IT function and leaders into transformative champions of inclusion

    Identify elements of effective partnering to maximize the impact of internal interactions

    Understand the major obstacles to CEO and board relevance and uncover the keys to elevating your internal executive profile

    Develop a leadership brand statement that demonstrates leadership competency and is aligned with the brand, mission, vision, and goals of the organization

    Identify the components of effective presentations and hone your presentation skills

    Gain the skills to confront and drive solutions from difficult situations

    Develop strategies to engage in conflict constructively and reach a resolution that benefits the team or organization

    Learn to identify the root causes of low performance and develop the skills to guide employees through the process of improvement

    Adopt a behavior-focused coaching model to help managers sustain and apply effective coaching principles

    Understand how and when to encourage autonomy and how to empower employees to take success into their own hands

    Manage Your Chromebooks and MacBooks

    • Buy Link or Shortcode: {j2store}167|cart{/j2store}
    • member rating overall impact: N/A
    • member rating average dollars saved: N/A
    • member rating average days saved: N/A
    • Parent Category Name: End-User Computing Devices
    • Parent Category Link: /end-user-computing-devices

    Windows is no longer the only option. MacBooks and Chromebooks are justified, but now you have to manage them.

    • If you have modernized your end-user computing strategy, you may have Windows 10 devices as well as MacBooks.
    • Virtual desktop infrastructure (VDI) and desktop as a service (DaaS) are becoming popular. Chromebooks may be ideal as a low-cost interface into DaaS for your employees.
    • Managing Chromebooks can be particularly challenging as they grow in popularity in the education sector.

    Our Advice

    Critical Insight

    Managing end-user devices may be accomplished with a variety of solutions, but many of those solutions advocate integration with a Microsoft-friendly solution to take advantage of features such as conditional access, security functionality, and data governance.

    Impact and Result

    • Many solutions are available to manage end-user devices, and they come with a long list of options and features. Clarify your needs and define your requirements before you purchase another endpoint management tool. Don’t purchase capabilities that you may never use.
    • Use the associated Endpoint Management Selection Tool spreadsheet to identify your desired endpoint solution features and compare vendor solution functionality based on your desired features.

    Manage Your Chromebooks and MacBooks Research & Tools

    Besides the small introduction, subscribers and consulting clients within this management domain have access to:

    1. Manage Your Chromebooks and MacBooks deck – MacBooks and Chromebooks are growing in popularity in enterprise and education environments, and now you have to manage them.

    Explore options, guidance and some best practices related to the management of Chromebooks and MacBooks in the enterprise environment and educational institutions. Our guidance will help you understand features and options available in a variety of solutions. We also provide guidance on selecting the best endpoint management solution for your own environment.

    • Manage Your Chromebooks and MacBooks Storyboard

    2. Endpoint Management Selection Tool – Select the best endpoint management tool for your environment. Build a table to compare endpoint management offerings in relation to the features and options desired by your organization.

    This tool will help you determine the features and options you want or need in an endpoint management solution.

    • Endpoint Management Selection Tool
    [infographic]

    Further reading

    Manage Your Chromebooks and MacBooks

    Financial constraints, strategy, and your user base dictate the need for Chromebooks and MacBooks – now you have to manage them in your environment.

    Analyst Perspective

    Managing MacBooks and Chromebooks is similar to managing Windows devices in many ways and different in others. The tools have many common features, yet they struggle to achieve the same goals.

    Until recently, Windows devices dominated the workplace globally. Computing devices were also rare in many industries such as education. Administrators and administrative staff may have used Windows-based devices, but Chromebooks were not yet in use. Most universities and colleges were Windows-based in offices with some flavor of Unix in other areas, and Apple devices were gaining some popularity in certain circles.

    That is a stark contrast compared to today, where Chromebooks dominate the classrooms and MacBooks and Chromebooks are making significant inroads into the enterprise environment. MacBooks are also a common sight on many university campuses. There is no doubt that while Windows may still be the dominant player, it is far from the only one in town.

    Now that Chromebooks and MacBooks are a notable, if not significant, part of the education and enterprise environments, they must be afforded the same considerations as Windows devices in those environments when it comes to management. The good news is that there is no lack of available solutions for managing these devices, and the endpoint management landscape is continually evolving and improving.

    This is a picture of P.J. Ryan, Research Director, Infrastructure & Operations, Info-Tech Research Group

    P.J. Ryan
    Research Director, Infrastructure & Operations
    Info-Tech Research Group

    Executive Summary

    Your Challenge

    • You modernized your end-user computing strategy and now have Windows 10 devices as well as MacBooks.
    • Virtual desktop infrastructure (VDI) and desktop as a service (DaaS) are becoming popular. Chromebooks would be ideal as a low-cost interface into DaaS for your employees.
    • You are responsible for the management of all the new Chromebooks in your educational district.
    • Windows is no longer the only option. MacBooks and Chromebooks are justified, but now you have to manage them.

    Common Obstacles

    • Endpoint management solutions typically do a great job at managing one category of devices, like Windows or MacBooks, but they struggle to fully manage alternative endpoints.
    • Multiple solutions to manage multiple devices will result in multiple dashboards. A single view would be better.
    • One solution may not fit all, but multiple solutions is not desirable either, especially if you have Windows devices, MacBooks, and Chromebooks.

    Info-Tech's Approach

    • Use the tools at your disposal first – don't needlessly spend money if you don't have to. Many solutions can already manage other types of devices to some degree.
    • Use the integration capabilities of endpoint management tools. Many of them can integrate with each other to give you a single interface to manage multiple types of devices while taking advantage of additional functionality.
    • Don't purchase capabilities you will never use. Using 80% of a less expensive tool is economically smarter than using 10% of a more expensive tool.

    Info-Tech Insight

    Managing end-user devices may be accomplished with a variety of solutions, but many of those solutions advocate integration with a Microsoft-friendly solution to take advantage of features such as conditional access, security functionality, and data governance.

    Insight Summary

    Insight 1

    Google Admin Console is necessary to manage Chromebooks, but it can be paired with other tools. Implementation partnerships provide solutions to track the device lifecycle, track the repair lifecycle, sync with Google Admin Console as well as PowerSchool to provide a more complete picture of the user and device, and facilitate reminders to return the device, pay fees if necessary, pick up a device when a repair is complete, and more.

    Insight 2

    The Google Admin Console allows admins to follow an organizational unit (OU) structure very similar to what they may have used in Microsoft's Active Directory environment. This familiarity makes the task of administering Chromebooks easier for admins.

    Insight 3

    Chromebook management goes beyond securing and manipulating the device. Controls to protect the students while online, such as Safe Search and Safe Browsing, should also be implemented.

    Insight 4

    Most companies choose to use a dedicated MacBook management tool. Many unified endpoint management (UEM) tools can manage MacBooks to some extent, but admins tend to agree that a MacBook-focused endpoint management tool is best for MacBooks while a Windows-based endpoint management tool is best for Windows devices.

    Insight 5

    Some MacBook management solutions advocate integration with Windows UEM solutions to take advantage of Microsoft features such as conditional access, security functionality, and data governance. This approach can also be applied to Chromebooks.

    Chromebooks

    Chromebooks had a respectable share of the education market before 2020, but the COVID-19 pandemic turbocharged the penetration of Chromebooks in the education industry.

    Chromebooks are also catching the attention of some decision makers in the enterprise environment.

    "In 2018, Chromebooks represented an incredible 60 percent of all laptop or tablet devices in K-12 -- up from zero percent when the first Chromebook launched during the summer break in 2011."
    – "Will Chromebooks Rule the Enterprise?" Computerworld

    "Chromebooks were the best performing PC products in Q3 2020, with shipment volume increasing to a record-high 9.4 million units, up a whopping 122% year-on-year."
    – Android Police

    "Until the pandemic, Chrome OS' success was largely limited to U.S. schools. Demand in 2020 appears to have expanded beyond that small but critical part of the U.S. PC market."
    – Geekwire

    "In addition to running a huge number of Chrome Extensions and Apps at once, Chromebooks also run Android, Linux and Windows apps."
    – "Will Chromebooks Rule the Enterprise?" Computerworld

    Managing Chromebooks

    Start with the Google Admin Console (GAC)

    GAC is necessary to initially manage Chrome OS devices.

    GAC gives you a centralized console that will allow you to:

    • Create organizational units
    • Add your Chromebook devices
    • Add users
    • Assign users to devices
    • Create groups
    • Create and assign policies
    • Plus more

    GAC can facilitate device management with features such as:

    • Control admin permissions
    • Encryption and update settings
    • App deployment, screen timeout settings
    • Perform a device wipe if required
    • Audit user activity on a device
    • Plus more

    Device and user addition, group and organizational unit creation and administration, applying policies to devices and users – does all this remind you of your Active Directory environment?

    GAC lets you administer users and devices with a similar approach.

    Managing Chromebooks

    Use Active Directory to manage Chromebooks.

    • Enable Active Directory (AD) management from within GAC and you will be able to integrate your Chromebook devices with your AD environment.
    • Devices will be visible in both the GAC and AD environment.
    • Use Windows Group Policy to manage devices and to push policies to users and devices.
    • Users can use their AD username and password to sign into Chromebook devices.
    • GAC can still be used for devices that are not synced with AD.

    Chromebooks can also be managed through these approved partners:

    • Cisco Meraki
    • Citrix XenMobile
    • IBM MaaS360
    • ManageEngine Mobile Device Manager Plus
    • VMware Workspace ONE

    Source: Google

    You must be running the Chrome Enterprise Upgrade and have any licenses required by the approved partner to take advantage of this management option. The partner admin policies supersede GAC.

    If you stop using the approved partner admin console to manage your devices, the polices and settings in GAC will immediately take over the devices.

    Microsoft still has the market share when it comes to device sales, and many administrators are already familiar with Microsoft's Active Directory. Google took advantage of that familiarity when it designed the Google Admin Console structure for users, groups, and organizational units.

    Chromebook Deployment

    Chromebook deployment becomes a challenge when device quantities grow. The enrollment process can be time consuming, and every device must be enrolled before it can be used by an employee or a student. Many admins enlist their full IT teams to assist in the short term. Some vendor partners may assist with distribution options if staffing levels permit. Recent developments from Google have opened additional options for device enrollment beyond the manual enrollment approach.

    Enrolling Chromebooks comes down to one of two approaches:

    1. Manually enrolling one device at a time
      • Users can assist by entering some identifying details during the enrollment if permitted.
      • Some third-party solutions exist, such as USB drives to reduce repetitive keystrokes or hubs to facilitate manually enrolling multiple Chromebooks simultaneously.
    2. Google's Chrome Enterprise Upgrade or the Chrome Education Upgrade
      • This allows you to let your users enroll devices after they accept the end-user license agreement.
      • You can take advantage of Google's vendor partner program and use a zero-touch deployment method where the Chromebook devices automatically receive the assigned policies, apps, and settings as soon as the device is powered on and an authorized user signs in.
      • The Enterprise Upgrade and the Education Upgrade do come with an annual cost per device, which is currently less than US$50.
      • The Enterprise and Education Upgrades come with other features as well, such as enhanced security.

    Chromebooks are automatically assigned to the top-level organizational unit (OU) when enrolled. Devices can be manually moved to another OU, but admins can also create enrollment policies to place newly enrolled devices in a specific OU or have the device locate itself in the same OU as the user.

    Chromebooks in Education

    GAC is also used with Education-licensed devices

    Most of the settings and features previously mentioned are also available for Education-licensed devices and users. Enterprise-specific features will not be available to Education licenses. (Active Directory integration with Education licenses, for example, is accomplished using a different approach)

    • Groups, policies, administrative controls, app deployment and management, adding devices and users, creating organizational units, and more features are all available to Education Admins to use.

    Education device policies and settings tend to focus more on protecting the students with controls such as:

    • Disable incognito mode
    • Disable location tracking
    • Disable external storage devices
    • Browser based protections such as Safe Search or Safe Browsing
    • URL blocking
    • Video input disable for websites
    • App installation prevention, auto re-install, and app blocking
    • Forced re-enrollment to your domain after a device is wiped
    • Disable Guest Mode
    • Restrict who can sign in
    • Audit user activity on a device

    When a student takes home a Chromebook assigned to them, that Chromebook may be the only computer in the household. Administrative polices and settings must take into account the fact that the device may have multiple users accessing many different sites and applications when the device is outside of the school environment.

    Chromebook Management Extended

    An online search for Chromebook management solutions will reveal several software solutions that augment the capabilities of the Google Admin Console. Many of these solutions are focused on the education sector and classroom and student options, although the features would be beneficial to enterprises and educational organizations alike.

    These solutions assist or augment Chromebook management with features such as:

    • Ability to sync with Google Admin Console
    • Ability to sync with student information systems, such as PowerSchool
    • Financial management, purchase details, and chargeback
    • Asset lifecycle management
    • 1:1 Chromebook distribution management
    • Repair programs and repair process management
    • Check-out/loan program management
    • Device distribution/allocation management, including barcode reader integration
    • Simple learning material distribution to the classroom for teachers
    • Facilitate GAC bulk operations
    • Manage inventory of non-IT assets such as projectors, TVs, and other educational assets
    • Plus more

    "There are many components to managing Chromebooks. Schools need to know which student has which device, which school has which device, and costs relating to repairs. Chromebook Management Software … facilitates these processes."
    – VIZOR

    MacBooks

    • MacBooks are gaining popularity in the Enterprise world.
    • Some admins claim MacBooks are less expensive in the long run over Windows-based PCs.
    • Users claim less issues when using a MacBook, and overall, companies report increased retention rates when users are using MacBooks.

    "Macs now make up 23% of endpoints in enterprises."
    – ComputerWeekly.com

    "When given the choice, no less than 72% of employees choose Macs over PCs."
    – "5 Reasons Mac is a must," Jamf

    "IBM says it is 3X more expensive to manage PCs than Macs."
    – Computerworld

    "74% of those who previously used a PC for work experienced fewer issues now that they use a Mac"
    – "Global Survey: Mac in the Enterprise," Jamf

    "When enterprise moves to Mac, staff retention rates improve by 20%. That's quite a boost! "
    – "5 Reasons Mac is a must," Jamf

    Managing MacBooks

    Can your existing UEM keep up?

    Many Windows unified endpoint management (UEM) tools can manage MacBooks, but most companies choose to use a dedicated MacBook management tool.

    • UEM tools that are primarily Windows focused do not typically go deep enough into the management capabilities of non-Windows devices.
    • Admins have noted limitations when it comes to using Windows UEM tools, and reasons they prefer a dedicated MacBook management solution include:
      • Easier to use
      • Faster response times when deploying settings and policies
      • Better control over notification settings and lock screen settings.
      • Easier Apple Business Manager (ABM) integration and provisioning.
    • Note that not every UEM will have the same limitations or advantages. Functionality is different between vendor products.

    Info-Tech Insight

    Most Windows UEM tools are constantly improving, and it is only a matter of time before they rival many of the dedicated MacBook management tools out there.

    Admins tend to agree that a Windows UEM is best for Windows while an Apple-based UEM is best for Apple devices.

    Managing MacBooks

    The market for "MacBook-first" management solutions includes a variety of players of varying ages such as:

    • Jamf
    • Kandji
    • Mosyle
    • SimpleMDM
    • Others

    MacBook-focused management tools can provide features such as:

    • Encryption and update settings
    • App deployment and lifecycle management
    • Remote device wipe, scan, shutdown, restart, and lock
    • Zero touch deployment and support
    • Location tracking
    • Browser content filtering
    • Enable, hide/block, or disable built-in features
    • Configure Wi-Fi, VPN, and certificate-based settings
    • Centralized dashboard with device and app listings as well as individual details
    • Data restrictions
    • Plus more

    Unified endpoint management (UEM) solutions that can provide MacBook management to some degree include (but are not limited to):

    • Intune
    • Ivanti
    • Endpoint Central
    • WorkspaceOne

    Dedicated solutions advocate integration with UEM solutions to take advantage of conditional access, security functionality, and data governance features.

    Jamf and Microsoft entered into a collaboration several years ago with the intention of making the MacBook management process easier and more secure.

    Microsoft Intune and Jamf Pro: Better together to manage and secure Macs
    Microsoft Conditional Access with Jamf Pro ensures that company data is only accessed by trusted users, on trusted devices, using trusted apps. Jamf extends this Enterprise Mobile + Security (EMS) functionality to Mac, iPhone and iPad.
    – "Microsoft Intune and Jamf Pro," Jamf

    Endpoint Management Selection Tool
    Activity

    There are many solutions available to manage end-user devices, and they come with a long list of options and features. Clarify your needs and define your requirements before you purchase another endpoint management tool. Don't purchase capabilities that you may never use.

    Use the Endpoint Management Selection Tool to identify your desired endpoint solution features and compare vendor solution functionality based on your desired features.

    1. List out the desired features you want in an endpoint solution for your devices and record those features in the first column. Use the features provided, or add your own and edit or delete the existing ones if necessary.
    2. List your selected endpoint management solution vendors in each of the columns in place of "Vendor 1," "Vendor 2," etc.
    3. Fill out the spreadsheet by changing the corresponding desired feature cell under each vendor to a "yes" or "no" based on your findings while investigating each vendor solution.
    4. When you have finished your investigation, review your spreadsheet to compare the various offerings and pros and cons of each vendor.
    5. Select your endpoint management solution.

    Endpoint Management Selection Tool

    In the first column, list out the desired features you want in an endpoint solution for your devices. Use the features provided if desired, or add your own and edit or delete the existing ones if necessary. As you look into various endpoint management solution vendors, list them in the columns in place of "Vendor 1," "Vendor 2," etc. Use the "Desired Feature" list as a checklist and change the values to "yes" or "no" in the corresponding box under the vendors' names. When complete, you will be able to look at all the features and compare vendors in a single table.

    Desired Feature Vendor 1 Vendor 2 Vendor 3
    Organizational unit creation Yes No Yes
    Group creation Yes Yes Yes
    Ability to assign users to devices No Yes Yes
    Control of administrative permissions Yes Yes Yes
    Conditional access No Yes Yes
    Security policies enforced Yes No Yes
    Asset management No Yes No
    Single sign-on Yes Yes Yes
    Auto-deployment No Yes No
    Repair lifecycle tracking No Yes No
    Application deployment Yes Yes No
    Device tracking Yes Yes Yes
    Ability to enable encryption Yes No Yes
    Device wipe Yes No Yes
    Ability to enable/disable device tracking No No Yes
    User activity audit No No No

    Related Info-Tech Research

    this is a screenshot from Info-Tech's Modernize and Transform Your End-User Computing Strategy.

    Modernize and Transform Your End-User Computing Strategy
    This project helps support the workforce of the future by answering the following questions: What types of computing devices, provisioning models, and operating systems should be offered to end users? How will IT support devices? What are the policies and governance surrounding how devices are used? What actions are we taking and when? How do end-user devices support larger corporate priorities and strategies?

    Best Unified Endpoint Management (UEM) Software 2022 | SoftwareReviews
    Compare and evaluate unified endpoint management vendors using the most in-depth and unbiased buyer reports available. Download free comprehensive 40+ page reports to select the best unified endpoint management software for your organization.

    Best Enterprise Mobile Management (EMM) Software 2022 | (softwarereviews.com)
    Compare and evaluate enterprise mobile management vendors using the most in-depth and unbiased buyer reports available. Download free comprehensive 40+ page reports to select the best enterprise mobile management software for your organization.

    Bibliography

    Bridge, Tom. "Macs in the enterprise – what you need to know". Computerweekly.com, TechTarget. 27 May 2022. Accessed 12 Aug. 2022.
    Copley-Woods, Haddayr. "5 reasons Mac is a must in the enterprise". Jamf.com, Jamf. 28 June 2022. Accessed 16 Aug. 2022.
    Duke, Kent. "Chromebook sales skyrocketed in Q3 2020 with online education fueling demand." androidpolice.com, Android Police. 16 Nov 2020. Accessed 10 Aug. 2022.
    Elgin, Mike. "Will Chromebooks Rule the Enterprise? (5 Reasons They May)". Computerworld.com, Computerworld. 30 Aug 2019. Accessed 10 Aug. 2022.
    Evans, Jonny. "IBM says it is 3X more expensive to manage PCs than Macs". Computerworld.com, Computerworld. 19 Oct 2016. Accessed 23 Aug. 2022.
    "Global Survey: Mac in the Enterprise". Jamf.com, Jamf. Accessed 16 Aug. 2022.
    "How to Manage Chromebooks Like a Pro." Vizor.cloud, VIZOR. Accessed 10 Aug. 2022.
    "Manage Chrome OS Devices with EMM Console". support.google.com, Google. Accessed 16 Aug. 2022.
    Protalinski, Emil. "Chromebooks outsold Macs worldwide in 2020, cutting into Windows market share". Geekwire.com, Geekwire. 16 Feb 2021. Accessed 22 Aug. 2022.
    Smith, Sean. "Microsoft Intune and Jamf Pro: Better together to manage and secure Macs". Jamf.com, Jamf. 20 April 2022. Accessed 16 Aug. 2022.

    Safety as a secondary consideration

    • Large vertical image:
    • member rating overall impact: Very High
    • member rating average dollars saved: N/A
    • member rating average days saved: N/A

    This is a story that should make you perk up.

    I know of a department that was eager to launch their new product. The strain was severe. The board was breathing down their necks. Rivals were catching up (or so they thought).

    What did they do?

    "Let's get this thing live, prove the market wants it, then we'll circle back and handle all the security and stability backlog items." For the product owner, at the time, that seemed the right thing to do.

    They were hacked 48 hours after going live.

    Customer information was stolen. The brand's reputation suffered. The decision led to a months-long legal nightmare. And they still had to completely rebuild the system. Making stability and security bolt-on items is never a good idea.

    The true price of "fix it later"

    See, I understand. When the product owner is pressing for user experience enhancements and you're running out of time for launch, it's easy to overlook those "non-functional requirements." Yet, we should avoid blaming the product owner. The PO is under pressure from many stakeholders, and a delayed launch may also come with significant costs.

    Load balancing isn't visible to customers, after all. Penetration testing doesn't excite them. Failure mechanisms don't matter to them. This statement is true until a malfunction impacts a client. Then it suddenly becomes the most important thing in the world.

    However, I know that ignoring non-functional requirements (NFRs) can lead to failed businesses (or business lines). This elevates these issues beyond mere technical inconveniences. NFRs are designed with the client in mind.

    Look at it this way. When your system crashes during periods of high traffic, how does the user experience change? How satisfied are customers when their personal information is stolen? When it takes 30 seconds for your website to load, how does that conversion rate look?

    Let me expose you to some consultant figures. The average cost of IT outages is $5,600 per minute, according to a 2014 Gartner study. That figure can rise to $300,000 per hour for larger businesses. The reality is that in your department, you will rarely reach these numbers. When we look at current (2020-2025) and expected (2026) trends, the typical operational loss numbers in international commercial banking or insurance are closer to 100K for high-impact incidents that are handled within 2–3 hours.

    Obviously, your numbers will vary. And if you don't know what your costs are, now would be a good time to discover that. This does not imply that you should simply accept the risks associated with such situations. You must fix or mitigate such opportunities for hackers to get in. Do so at the appropriate cost for your business.

    Data breaches are a unique phenomenon. According to IBM's Cost of a Data Breach Report 2025, a data breach typically costs $4.44 million, and detecting and containing it takes an average of 241 days. Some preview data from the 2025 report include that 97% of organizations that reported on the study indicated that they lacked access controls for their AI systems. That means that many companies don't even have the basics in order. And AI-related breaches are just going to accelerate. AI security defenses will help lower the cost of such breaches.

    Despite the decreasing cost of these breaches, I anticipate an increase in their frequency in the upcoming years.

    This means that non-functional requirements in terms of security and resilience should take a more prominent place in the prioritizations. Your client depends on your systems being safe, resilient, and performant.

    The blind spot in leadership

    And yet, this is where some leaders make mistakes. I have the impression they believe that client-focused design means more functionality and elegant interfaces. They prioritize user experience enhancements over system reliability.

    I want to share a key fact that distinguishes successful businesses: customers desire more than just a good product. It must always function for them. And that means following certain procedures. They are not there to hamper you; they are there to retain customers.

    88% of online shoppers are less likely to visit a website again after a negative experience, according to research from Forrester. Amazon found that they lose 1% of sales for every 100 ms of latency. That 100 milliseconds adds up to millions of lost profits when billions of dollars are at stake.

    You run the risk of more than just technical difficulties when you deprioritize safety. Customer trust, revenue stability, competitive advantage, adherence to the law, costs, and team morale are all at stake.

    The "happy flow" trap is costing you revenue.

    Allow me to illustrate what I see happening during development cycles.

    The team tests the happy flow. The user successfully logs in. The user navigates with ease. The user makes the purchase without any problems. The user logs off without incident.

    "Excellent! Publish it!"

    However, what occurs if 1000 users attempt to log in at once? What occurs if an attempt is made to insert malicious code into your contact form? During a transaction, what happens if your database connection fails?

    These are not extreme situations. These are real-life occurrences.

    Fifty percent of data center managers and operators reported having an impactful outage in the previous three years, according to the Uptime Institute's 2025 Global Data Center Survey. Note that this is at the infra level. The biggest contributor is power outages. What role does power play in ensuring a smooth flow? Power will not always flow as you want it, so plan for lack of power and for spikes.

    With regard to software failures, the spread of possible causes widens. AI is a big contributor. AI is typically brought in to accelerate development and assist in coding. But it tends to introduce subtle bugs and vulnerabilities that a seasoned developer has to review and solve.

    Another upcoming article will discuss how faster release cycles often lead to a rush in testing. This should not be the case; by spending some time automating your (non-)regression test bank, you will gain speed. But you have to invest time in building the test suite.

    Can your system handle success? This question should keep every executive awake at night.

    I've witnessed businesses invest millions in advertising campaigns to drive traffic to systems that fail due to their success. Consider describing to your board how your greatest marketing victory became your worst operational mishap.

    Managing traffic spikes is only one aspect of load balancing. It is about ensuring that your business can handle opportunities without being overwhelmed.

    The mindset that transforms everything

    Let's now address the most pressing issue: security.

    The majority of leaders consider security to be like insurance, something you hope you never need. The fact that security is more than just protection, however, will alter the way you approach every project. It's approval to develop.

    According to the Ponemon Institute's 2025 Cost of Insider Threats Global Report, the average annualized cost of insider threats, defined as employee negligence, criminal insiders, and credential thieves, has risen to $17.4 million per incident, up from $15.4 million in 2022. The number of discovered and analyzed incidents increased from 3,269 in 2018 to 7,868 in 2025 research studies.

    Cybersecurity Ventures predicts that cybercrime will cost the global economy $10.5 trillion annually by 2025.

    The most fascinating thing, though, is that companies that invest in proactive security see measurable outcomes. Organizations that allocate over 10% of their IT budget to cybersecurity have a 2.5-fold higher chance of experiencing no security incidents than those that allocate less than 1%, per Deloitte's Future of Cyber Survey.

    By hardening your systems against common attack vectors, you can scale quickly without worrying about the future. You can handle sensitive data with confidence, enter new markets without fear, establish partnerships that require trust, and focus on innovation instead of crisis management.

    The non-functional needs that genuinely generate income

    Allow me to explain this in a way that will satisfy your CFO.

    Retention is equal to reliability. Customers return when a system functions reliably (given you sell items they want). The Harvard Business Review claims that a 5% increase in customer retention rates boosts profits by 25% to 95%. It is five to twenty-five times less expensive to retain customers than to acquire new ones.

    Scalability is equal to security. Secure systems can handle larger client volumes, more sensitive data, and higher-value transactions. 69% of board members and C-suite executives think that privacy and cyber risks could affect their company's ability to grow, according to PwC.

    Profit is equal to performance. You lose conversions for every second of load time. Google discovered that the likelihood of a bounce rises by 32% as page load time increases from 1 to 3 seconds. It increases by 90% from 1 second to 5 seconds. Walmart discovered that every second improvement in page load time led to a 2% increase in conversions.

    Reputation is equal to resilience. Guess which company benefits when your system works while your competitors' systems fail? Failures reduce trust. 71% of consumers will actively advocate against companies they don't trust, and 67% of consumers will stop purchasing from them, according to Edelman's 2023 Trust Barometer. While the 2025 report does not present comparative numbers, distrust impacting consumer behavior is likely to be even more prevalent.

    The structure that reverses the script

    Reframe this discussion with your executives and team

    • The question we should not ask is, "Can we afford to build this right?" but rather, "Can we afford not to?" This consideration is crucial because we risk losing customers at every obstacle they encounter.
    • Non-functional requirements should be viewed as competitive advantages rather than obstructions. If it suddenly does not work, the customer walks away.
    • Consider viewing system reliability as a profit center instead of a cost center. When a customer knows it will work, they will order again and refer a friend.

    The numbers support this point. Businesses that invest in operational resilience see three times higher profit margins and 2.5 times higher revenue growth than their counterparts, according to McKinsey's 2023 State of Organizations report. In 2025 we see a focus on AI, but the point remains.

    These metrics will grab the attention when you're presenting them.

    Although the average cost of downtime varies by industry, it is always high.

    The impact of a security breach on customer lifetime value is equally uncomfortable. Following a data breach, 78% of consumers will cease interacting with a brand online, and 36% will never do so again, according to Ping Identity's 2023 Consumer Identity Breach Report.

    Every second that the system is unavailable results in a rapidly mounting loss of money. That's about $3,170 per minute of full downtime for a business that makes $100 million a year. We're talking about $31,700 per minute for billion-dollar businesses. Again, your experience may differ, but it's important to note that this cost is often unseen yet undeniable. If you want to calculate this more granularly, then I have a calculation method for you that is easy to implement.

    There is a discernible trend in the cost of rebuilding versus building correctly the first time. Resolving a problem in production can cost four to five times as much as fixing it during design, and it can cost up to 100 times as much as fixing it during the requirements and design phase, according to IBM's Systems Sciences Institute.

    The plan of action that truly works

    This is what you should do right away.

    Please begin by reviewing your current primary systems. When they're under stress, what happens? What occurs if they are attacked? What occurs if they don't work? 40% of businesses that suffer a significant system failure never reopen, although only 23% of organizations have tested their disaster recovery plans in the previous year, according to Gartner. Companies we work with test their systems at least once per year. If the results are unsatisfactory, we conduct a retest to ensure they meet our standards.

    Next, please determine the actual cost of addressing issues at a later stage. Add in the costs of customer attrition, security breaches, downtime, and reconstruction. To lend credibility to your calculations, try to work out exact numbers for your company. Industry standards (like in this article) will give you indicators, but you need to know your figures.

    Third, recast your non-functional needs as business needs. Consider focusing on strategies for managing success rather than solely discussing load balancing. Instead of discussing security testing, focus on revenue protection.

    Fourth, consider safety when defining "done." Until a feature is dependable, secure, and scalable, it isn't considered complete. Projects that incorporate non-functional requirements from the outset have a threefold higher chance of success, per the Standish Group's 2023 Chaos Report.

    Fifth, use system dependability as a differentiator in the marketplace. You're up when your rivals are down. You're safe when they're compromised.

    The bottom line

    I understand that resilience isn't sexy. I am aware that UI enhancements are more exciting than infrastructure resilience.

    And yet, I know that businesses that prioritize safety will survive and lead after seeing others thrive and fail based on this one choice. Customers trust them. They are capable of scaling without breaking. Because they are confident that their systems can manage whatever comes next, they are the ones who get a good night's sleep.

    Resilient organizations are twice as likely to surpass customer satisfaction goals and are 2.5 times more likely to achieve revenue growth of 10% or more.

    Resilience represents the most significant competitive advantage. You have a choice. Just keep in mind that your clients are depending on you to do the job correctly.

    Always happy to engage in a conversation.

    Build Your First RPA Bot

    • Buy Link or Shortcode: {j2store}238|cart{/j2store}
    • member rating overall impact: 9.4/10 Overall Impact
    • member rating average dollars saved: $53,126 Average $ Saved
    • member rating average days saved: 24 Average Days Saved
    • Parent Category Name: Optimization
    • Parent Category Link: /optimization
    • Your organization has many business processes that rely on manual, routine, and repetitive data collection and processing work. These processes need to be automated to meet strategic priorities.
    • Your stakeholders decided to invest in robotic process automation (RPA). They are ready to begin the planning and delivery of their first RPA bot.
    • However, your organization lacks the critical foundations involved in successful RPA delivery, such as analysis of the suitability of candidate processes, business and IT collaboration, and product ownership.

    Our Advice

    Critical Insight

    • Manage your business and IT debt before you adopt RPA. RPA doubles down on your process inefficiencies, lack of operations and architectural standardization, and unenforced quality standards. RPA solutions will be fragile and prone to failure if debt is not managed.
    • Adopt BizDevOps. RPA will not be successful if your lines-of-business (LOBs) and IT are not working together. IT must empathize with how LOBs operate and proactively support the underlying operational systems. LOBs must be accountable for all products leveraging RPA and be able to rationalize RPA’s technical feasibility.
    • Start with RPA 1.0. Don’t get caught up in the AI and machine learning (RPA 2.0) hype. Evaluate the acceptance and value of RPA 1.0 to establish a sustainable and collaborative foundation for its delivery and management. Then use the lessons learned to prepare for future RPA 2.0 adoption. In many cases, RPA 1.0 is good enough.

    Impact and Result

    • Establish the right expectations. Gain a grounded understanding of RPA value and limitations in your context. Discuss current IT and business operations challenges to determine if they will impact RPA success.
    • Build your RPA governance. Clarify the roles, processes, and tools needed to support RPA delivery and management through IT and business collaboration.
    • Evaluate the fit of RPA. Obtain a thorough view of the business and technical complexities of your candidate processes. Indicate where and how RPA is expected to generate the most return.

    Build Your First RPA Bot Research & Tools

    Start here – read the Executive Brief

    Read our concise Executive Brief to find out how you should build your first RPA bot, review Info-Tech’s methodology, and understand the four ways we can support you in completing this project.

    Besides the small introduction, subscribers and consulting clients within this management domain have access to:

    1. Define your RPA governance

    Set the expectations of your first RPA bot. Define the guiding principles, ethics, and delivery capabilities that will govern RPA delivery and support.

    • Build Your First RPA Bot – Phase 1: Define Your RPA Governance

    2. Deliver and manage your bots

    Validate the fit of your candidate business processes for RPA and ensure the support of your operational system. Shortlist the features of your desired RPA vendor. Modernize your delivery process to accommodate RPA.

    • Build Your First RPA Bot – Phase 2: Deliver and Manage Your Bots

    3. Roadmap your RPA adoption

    Build a roadmap of initiatives to implement your first bot and build the foundations of your RPA practice.

    • Build Your First RPA Bot – Phase 3: Roadmap Your RPA Adoption
    [infographic]

    Workshop: Build Your First RPA Bot

    Workshops offer an easy way to accelerate your project. If you are unable to do the project yourself, and a Guided Implementation isn't enough, we offer low-cost delivery of our project workshops. We take you through every phase of your project and ensure that you have a roadmap in place to complete your project successfully.

    1 Define Your RPA Governance

    The Purpose

    State the success criteria of your RPA adoption through defined objectives and metrics.

    Define your RPA guiding principles and ethics.

    Build the RPA capabilities that will support the delivery and management of your bots.

    Key Benefits Achieved

    Grounded stakeholder expectations

    RPA guiding principles

    RPA capabilities and the key roles to support RPA delivery and management

    Activities

    1.1 State Your RPA Objectives.

    1.2 Define Your RPA Principles

    1.3 Develop Your RPA Capabilities

    Outputs

    RPA objectives and metrics

    RPA guiding principles and ethics

    RPA and product ownership, RPA capabilities, RPA role definitions

    2 Deliver and Manage Your Bots

    The Purpose

    Evaluate the fit of your candidate business processes for automation.

    Define the operational platform to support your RPA solution.

    Shortlist the desired RPA vendor features.

    Optimize your product delivery process to support RPA.

    Key Benefits Achieved

    Verifies the decision to implement RPA for the candidate business process

    The system changes and modifications needed to support RPA

    Prioritized list of RPA vendor features

    Target state RPA delivery process

    Activities

    2.1 Prepare Your RPA Platform

    2.2 Select Your RPA Vendor

    2.3 Deliver and Manage Your Bots

    Outputs

    Assessment of candidate business processes and supporting operational platform

    List of desired RPA vendor features

    Optimized delivery process

    3 Roadmap Your RPA Adoption

    The Purpose

    Build your roadmap to implement your first RPA bot and build the foundations of your RPA practice.

    Key Benefits Achieved

    Implementation initiatives

    RPA adoption roadmap

    Activities

    3.1 Roadmap Your RPA Adoption

    Outputs

    RPA adoption roadmap

    DORA - Article 7 — Explained

    • member rating overall impact: N/A
    • member rating average dollars saved: N/A
    • member rating average days saved: N/A

    Intro

    While this text is about DORA requirements, it is really about resilient availability of your service. Even if you are not bound to this regulation, maybe you are not a financial services provider, the requirements and tips on how to get there are invaluable to your client satisfaction.

    Legal text

    In order to address and manage ICT risk, financial entities shall use and maintain updated ICT systems, protocols and tools that are:
    (a) appropriate to the magnitude of operations supporting the conduct of their activities, in accordance with the
    proportionality principle as referred to in Article 4;
    (b) reliable;
    (c) equipped with sufficient capacity to accurately process the data necessary for the performance of activities and the timely provision of services, and to deal with peak orders, message or transaction volumes, as needed, including where new technology is introduced;
    (d) technologically resilient in order to adequately deal with additional information processing needs as required under
    stressed market conditions or other adverse situations.

    What do you need to do?

    • Determine what systems you need.
    • Inventory the systems you have.
    • Make sure your systems and applications are sized right for your business
      • and made resilient according to the business functions they support
        in relation to the size of the business functions they support (proportionality)
      • and are reliable, meaning they produce consistent results
      • and are resilient, meaning they can withstand adverse effects where needed

    How do you do this?

    For requirement (a)

    • Identify the capacity requirements for your services
    • Also identify the capacity requirements in case of serious decapacitating events (Business continuity)
    • Detail your capacity management plan so that you can meet the requirements
    • Test your systems for compliamce with these requirements

    For requirement (b)

    • Show the parts of your IT policy that deals with availability,
    • Show the technical Disaster recovery plans and their execution reports (ideally over a number of years)
    • Show the availability reports for your systems.
    • Show the vulnerability management reports for your systems (optional)

    For requirement (C)

    • Show the availability reports for your systems: this is really the end-result: if you can show that your systems are available even under heavy load, you have won half the battle.
    • Show the capacity requirements for your systems. This is where you can prove you really thought about demad for your service.
    • Show the capacity monitoring plans, plans and roadmaps and reports for your systems
    •  Show the load testing reports executed on your systems

     For requirement (d)

    • Show the identified attacks scenarios and you defend against them
    •  Show the results of your resilience test plans: talk about High availability, Disaster recovery, and manual workaround or alternative workflows (that is business continuity.)

    Many of these solutions will depend on the the solutions and responses to other DORA requirements.

    dora

    Develop an IT Asset Management Strategy

    • Buy Link or Shortcode: {j2store}295|cart{/j2store}
    • member rating overall impact: 8.5/10 Overall Impact
    • member rating average dollars saved: $52,211 Average $ Saved
    • member rating average days saved: 31 Average Days Saved
    • Parent Category Name: Asset Management
    • Parent Category Link: /asset-management

    You have a mandate to create an accurate and actionable database of the IT assets in your environment, but:

    • The data you have is often incomplete or wrong.
    • Processes are broken or non-existent.
    • Your tools aren’t up to the task of tracking ever more hardware, software, and relevant metadata.
    • The role of stakeholders outside the core ITAM team isn’t well defined or understood.

    Our Advice

    Critical Insight

    ITAM is a foundational IT service that provides accurate, accessible, actionable data on IT assets. But there’s no value in data for data’s sake. Enable collaboration between IT asset managers, business leaders, and IT leaders to develop an ITAM strategy that maximizes the value they can deliver as service providers.

    Impact and Result

    • Develop an approach and strategy for ITAM that is sustainable and aligned with your business priorities.
    • Clarify the structure for the ITAM program, including scope, responsibility and accountability, centralization vs. decentralization, outsourcing vs. insourcing, and more.
    • Create a practical roadmap to guide improvement.
    • Summarize your strategy and approach using Info-Tech’s templates for review with stakeholders.

    Develop an IT Asset Management Strategy Research & Tools

    Besides the small introduction, subscribers and consulting clients within this management domain have access to:

    1. Develop an IT Asset Management Strategy – A methodology to create a business-aligned, coherent, and durable approach to ITAM.

    This two-phase, step-by-step methodology will guide you through the activities to build a business-aligned, coherent, and durable approach to ITAM. Review the executive brief at the start of the slide deck for an overview of the methodology and the value it can provide to your organization.

    • Develop an IT Asset Management Strategy – Phases 1-2

    2. ITAM Strategy Template – A presentation-ready repository for the work done as you define your ITAM approach.

    Use this template to document your IT asset management strategy and approach.

    • ITAM Strategy Template

    3. IT Asset Estimations Tracker – A rough-and-ready inventory exercise to help you evaluate the work ahead of you.

    Use this tool to estimate key data points related to your IT asset estate, as well as your confidence in your estimates.

    • IT Asset Estimations Tracker

    Infographic

    Workshop: Develop an IT Asset Management Strategy

    Workshops offer an easy way to accelerate your project. If you are unable to do the project yourself, and a Guided Implementation isn't enough, we offer low-cost delivery of our project workshops. We take you through every phase of your project and ensure that you have a roadmap in place to complete your project successfully.

    1 Identify ITAM Priorities & Goals, Maturity, Metrics and KPIs

    The Purpose

    Align key stakeholders to the potential strategic value of the IT asset management practice.

    Ensure the ITAM practice is focused on business-aligned goals.

    Key Benefits Achieved

    Define a business-aligned direction and expected outcomes for your ITAM program.

    Activities

    1.1 Brainstorm ITAM opportunities and challenges.

    1.2 Conduct an executive alignment working session.

    1.3 Set ITAM priorities, goals and tactics.

    1.4 Identify target and current state ITAM maturity.

    Outputs

    ITAM opportunities and challenges

    Align executive priorities with ITAM opportunities.

    ITAM metrics and KPIs

    ITAM maturity

    2 Identify Your Approach to Support ITAM Priorities and Goals

    The Purpose

    Translate goals into specific and coherent actions to enable your ITAM practice to deliver business value.

    Key Benefits Achieved

    A business-aligned approach to ITAM, encompassing scope, structure, tools, audits, budgets, documentation and more.

    A high-level roadmap to achieve your vision for the ITAM practice.

    Activities

    2.1 Define ITAM scope.

    2.2 Acquire ITAM services (outsourcing and contracting).

    2.3 Centralize or decentralize ITAM capabilities.

    2.4 Create a RACI for the ITAM practice.

    2.5 Align ITAM with other service management practices.

    2.6 Evaluate ITAM tools and integrations.

    2.7 Create a plan for internal and external audits.

    2.8 Improve your budget processes.

    2.9 Establish a documentation framework.

    2.10 Create a roadmap and communication plan.

    Outputs

    Your ITAM approach

    ITAM roadmap and communication plan

    Further reading

    Develop an IT Asset Management Strategy

    Define your business-aligned approach to ITAM.

    Table of Contents

    4 Analyst Perspective

    5 Executive Summary

    17 Phase 1: Establish Business-Aligned ITAM Goals and Priorities

    59 Phase 2: Support ITAM Goals and Priorities

    116 Bibliography

    Develop an IT Asset Management Strategy

    Define your business-aligned approach to ITAM.

    EXECUTIVE BRIEF

    Analyst Perspective

    Track hardware and software. Seems easy, right?

    It’s often taken for granted that IT can easily and accurately provide definitive answers to questions like “how many laptops do we have at Site 1?” or “do we have the right number of SQL licenses?” or “how much do we need to budget for device replacements next year?” After all, don’t we know what we have?

    IT can’t easily provide these answers because to do so you must track hardware and software throughout its lifecycle – which is not easy. And unfortunately, you often need to respond to these questions on very short notice because of an audit or to support a budgeting exercise.

    IT Asset Management (ITAM) is the solution. It’s not a new solution – the discipline has been around for decades. But the key to success is to deploy the practice in a way that is sustainable, right-sized, and maximizes value.

    Use our practical methodology to develop and document your approach to ITAM that is aligned with the goals of your organization.

    Photo of Andrew Sharp, Research Director, Infrastructure & Operations Practice, Info-Tech Research Group.

    Andrew Sharp
    Research Director
    Infrastructure & Operations Practice
    Info-Tech Research Group

    Realize the value of asset management

    Cost optimization, application rationalization and reduction of technical debt are all considered valuable to right-size spending and improve service outcomes. Without access to accurate data, these activities require significant investments of time and effort, starting with creation of point-in-time inventories, which lengthens the timeline to reaching project value and may still not be accurate.

    Cost optimization and reduction of technical debt should be part of your culture and technical roadmap rather than one-off projects. Why? Access to accurate information enables the organization to quickly make decisions and pivot plans as needed. Through asset management, ongoing harvest and redeployment of assets improves utilization-to-spend ratios. We would never see any organization saying, “We’ve closed our year end books, let’s fire the accountants,” but often see this valuable service relegated to the back burner. Similar to the philosophy that “the best time to plant a tree is 20 years ago and the next best time is now,” the sooner you can start to collect, validate, and analyze data, the sooner you will find value in it.

    Photo of Sandi Conrad, Principal Research Director, Infrastructure & Operations Practice, Info-Tech Research Group.

    Sandi Conrad
    Principal Research Director
    Infrastructure & Operations Practice
    Info-Tech Research Group

    Executive Summary

    Your Challenge

    You have a mandate to create an accurate and actionable database of the IT assets in your environment, but:

    • The data you have is often incomplete or wrong.
    • Processes are broken or non-existent.
    • Your tools aren’t up to the task of tracking ever more hardware, software, and relevant metadata.
    • The role of stakeholders outside the core ITAM team isn’t well defined or understood.
    Common Obstacles

    It is challenging to make needed changes because:

    • There’s cultural resistance to asset tracking, it’s seen as busywork that doesn’t clearly create value.
    • Decentralized IT teams aren’t generating the data required to track hardware and licenses.
    • ITAM can’t direct needed tool improvements because the admins don’t report to ITAM.
    • It’s hard to find time to improve processes given the day-to-day demands on your time.
    Info-Tech’s Approach
    • Develop an approach and strategy for ITAM that is sustainable and aligned with your business priorities.
    • Clarify the structure for the ITAM program, including scope, responsibility and accountability, centralization vs. decentralization, outsourcing vs. insourcing, and more.
    • Create a practical roadmap to guide improvement.
    • Summarize your strategy and approach using Info-Tech’s templates for review with stakeholders.

    Info-Tech Insight

    ITAM is a foundational IT service that provides accurate, accessible, actionable data on IT assets. But there’s no value in data for data’s sake. Enable collaboration between IT asset managers, business leaders, and IT leaders to develop an ITAM strategy that maximizes the value they can deliver as service providers.

    Unlock business value with IT asset management

    • IT asset management (ITAM) is the practice of maintaining accurate, accessible, and actionable data on the assets within the organization’s IT estate. Each IT asset will have a record that tracks it across its lifecycle from purchase to disposal.
    • ITAM’s value is realized through other processes and practice areas that can leverage ITAM data to manage risk, improve IT services, and control costs.
    • Develop an approach to ITAM that maximizes the value delivered to the business and IT. ITAM succeeds when its partners succeed at delivering business value, and it fails when it doesn’t show value to those partners.

    This blueprint will help you develop your approach for the management of IT hardware and software, including cloud services. Leverage other Info-Tech methodologies to dive directly into developing hardware asset management procedures, software asset management procedures, or to implement configuration management best practices.

    Info-Tech Members report significant savings from implementing our hardware and software asset management frameworks. In order to maximize value from the process-focused methodologies below, develop your ITAM strategy first.

    Implement Hardware Asset Management (Based on Info-Tech Measured Value Surveys results from clients working through these blueprints, as of February 2022.)

    9.6/10

    $23k

    32

    Overall Impact Average $ Saved Average Days Saved
    Implement Software Asset Management (Based on Info-Tech Measured Value Surveys results from clients working through these blueprints, as of February 2022.)

    9.0/10

    $12k

    5

    Overall Impact Average $ Saved Average Days Saved

    ITAM provides both early and ongoing value

    ITAM isn’t one-and-done. Properly supported, your ITAM practice will deliver up-front value that will help demonstrate the value ongoing ITAM can offer through the maintenance of an accurate, accessible, and actionable ITAM database.

    Example: Software Savings from ITAM

    This chart shows the money saved between the first quote and the final price for software and maintenance by a five-person ITAM team. Over a year and a half, they saved their organization a total of $7.5 million from a first quote total of $21 million over that period.

    This is a perfect example of the direct value that ITAM can provide on an ongoing basis to the organization, when properly supported and integrated with IT and the business.

    Examples of up-front value delivered in the first year of the ITAM practice:

    • Save money by reviewing and renegotiating critical, high-spend, and undermanaged software and service contracts.
    • Redeploy or dispose of clearly unused hardware and software.
    • Develop and enforce standards for basic hardware and software.
    • Improve ITAM data quality and build trust in the results.

    Examples of long-term value from ongoing governance, management, and operational ITAM activities:

    • Optimize spend: Reallocate unused hardware and software, end unneeded service agreements, and manage renewals and audits.
    • Reduce risk: Provide comprehensive asset data for security controls development and incident management; manage equipment disposal.
    • Improve IT service: Support incident, problem, request, and change management with ITAM data. Develop new solutions with an understanding of what you have already.

    Common obstacles

    The rulebook is available, but hard to follow
    • ITAM takes a village, but stakeholders aren’t aware of their role. ITAM processes rely on technicians to update asset records, vendors to supply asset data, administrators to manage tools, leadership to provide direction and support, and more.
    • Constant change in the IT and business environment undermines the accuracy of ITAM records (e.g. licensing and contract changes, technology changes that break discovery tools, personnel and organizational changes).
    • Improvement efforts are overwhelmed by day-to-day activities. One study found that 83% of SAM teams’ time is consumed by audit-related activities. (Flexera State of ITAM Report 2022) A lack of improvement becomes a vicious cycle when stakeholders who don’t see the value of ITAM decline to dedicate resources for improvement.
    • Stakeholders expect ITAM tools to be a cure-all, but even at their best, they can’t provide needed answers without some level of configuration, manual input, and supervision.
    • There’s often a struggle to connect ITAM to value. For example, respondents to Info-Tech’s Management & Governance Diagnostic consistently rank ITAM as less important than other processes that ITAM directly supports (e.g. budget management and budget optimization). (Info-Tech MGD Diagnostic (n=972 unique organizations))
    ITAM is a mature discipline with well-established standards, certifications, and tools, but we still struggle with it.
    • Only 28% of SAM teams track IaaS and PaaS spend, and only 35% of SAM teams track SaaS usage.
    • Increasing SAM maturity is a challenge for 76% of organizations.
    • 10% of organizations surveyed have spent more than $5 million in the last three years in audit penalties and true-ups.
    • Half of all of organizations lack a viable SAM tool.
    • Seventy percent of SAM teams have a shortfall of qualified resources.
    • (Flexera State of ITAM Report 2022)

    Info-Tech's IT Asset Management Framework (ITAM)

    Adopt, manage, and mature activities to enable business value thorugh actionable, accessible, and accurate ITAM data

    Logo for Info-Tech Research Group. Enable Business Value Logo for #iTRG.
    Business-Aligned Spend
    Optimization and Transparency
    Facilitate IT Services
    and Products
    Actionable, Accessible,
    and Accurate Data
    Context-Aware Risk Management
    and Security Controls

    Plan & Govern

    Business Goals, Risks, and Structure
    • ITAM Goals & Priorities
    • Roles, Accountability, Responsibilities
    • Scope
    Ongoing Management Commitment
    • Resourcing & Funding
    • Policies & Enforcement
    • Continuous Improvement
    Culture
    • ITAM Education, Awareness & Training
    • Organizational Change Management
    Section title 'Operate' with a cycle surrounding key components of Operate: 'Data Collection & Validation', 'Tool Administration', 'License Management', and 'Lease Management'. The cycle consists of 'Request', 'Procure', 'Receive', 'Deploy', 'Manage', 'Retire & Dispose', and back to 'Request'.

    Build & Manage

    Tools & Data
    • ITAM Tool Selection & Deployment
    • Configuration Management Synchronization
    • IT Service Management Integration
    Process
    • Process Management
    • Data & Process Audits
    • Document Management
    People, Policies, and Providers
    • Stakeholder Management
    • Technology Standardization
    • Vendor & Contract Management

    Info-Tech Insight

    ITAM is a foundational IT service that provides actionable, accessible, and accurate data on IT assets. But there's no value in data for data's sake. Use this methodology to enable collaboration between ITAM, the business, and IT to develop an approach to ITAM that maximizes the value the ITAM team can deliver as service providers.

    Key deliverable

    IT asset management requires ongoing practice – you can’t just implement it and walk away.

    Our methodology will help you build a business-aligned strategy and approach for your ITAM practice with the following outputs:

    • Business-aligned ITAM priorities, opportunities, and goals.
    • Current and target state ITAM maturity.
    • Metrics and KPIs.
    • Roles, responsibilities, and accountability.
    • Insourcing, outsourcing, and (de)centralization.
    • Tools and technology.
    • A documentation framework.
    • Initiatives, a roadmap, and a communication plan.
    Each step of this blueprint is designed to help you create your IT asset management strategy:
    Sample of Info-Tech's key deliverable 'IT Asset Management' blueprint.

    Info-Tech’s methodology to develop an IT asset management strategy

    1. Establish business-aligned ITAM goals and priorities 2. Identify your approach to support ITAM priorities and goals
    Phase Steps
    • 1.1 Define ITAM and brainstorm opportunities and challenges.
    • Executive Alignment Working Session:
    • 1.2 Review organizational priorities, strategy, and key initiatives.
    • 1.3 Align executive priorities with ITAM opportunities and priorities.
    • 1.4 Identify business-aligned ITAM goals and target maturity.
    • 1.5 Write mission and vision statements.
    • 1.6 Define ITAM metrics and KPIs.
    • 2.1 Define ITAM scope.
    • 2.2 Acquire ITAM services (outsourcing and contracting).
    • 2.3 Centralize or decentralize ITAM capabilities.
    • 2.4 Create a RACI for the ITAM practice.
    • 2.5 Align ITAM with other service management practices.
    • 2.6 Evaluate ITAM tools and integrations.
    • 2.7 Create a plan for internal and external audits.
    • 2.8 Improve your budget processes.
    • 2.9 Establish a documentation framework.
    • 2.10 Create a roadmap and communication plan.
    Phase Outcomes Defined, business-aligned goals and priorities for ITAM. Establish an approach to achieving ITAM goals and priorities including scope, structure, tools, service management integrations, documentation, and more.
    Project Outcomes Develop an approach and strategy for ITAM that is sustainable and aligned with your business priorities.

    Insight Summary

    There’s no value in data for data’s sake

    ITAM is a foundational IT service that provides accurate, accessible, actionable data on IT assets. Enable collaboration between IT asset managers, business leaders, and IT leaders to develop an approach to ITAM that maximizes the value they can deliver as service providers.

    Service provider to a service provider

    ITAM is often viewed (when it’s viewed at all) as a low-value administrative task that doesn’t directly drive business value. This can make it challenging to build a case for funding and resources.

    Your ITAM strategy is a critical component to help you define how ITAM can best deliver value to your organization, and to stop creating data for the sake of data or just to fight the next fire.

    Collaboration over order-taking

    To align ITAM practices to deliver organizational value, you need a very clear understanding of the organization’s goals – both in the moment and as they change over time.

    Ensure your ITAM team has clear line of sight to business strategy, objectives, and decision-makers, so you can continue to deliver value as priorities change

    Embrace dotted lines

    ITAM teams rely heavily on staff, systems, and data beyond their direct area of control. Identify how you will influence key stakeholders, including technicians, administrators, and business partners.

    Help them understand how ITAM success relies on their support, and highlight how their contributions have created organizational value to encourage ongoing support.

    Project benefits

    Benefits for IT
    • Set a foundation and direction for an ITAM practice that will allow IT to manage risk, optimize spend, and enhance services in line with business requirements.
    • Establish accountability and responsibility for essential ITAM activities. Decide where to centralize or decentralize accountability and authority. Identify where outsourcing could add value.
    • Create a roadmap with concrete, practical next steps to develop an effective, right-sized ITAM practice.
    Stock image of a trophy. Benefits for the business
    • Plan and control technology spend with confidence based on trustworthy ITAM data.
    • Enhance IT’s ability to rapidly and effectively support new priorities and launch new projects. Effective ITAM can support more streamlined procurement, deployment, and management of assets.
    • Implement security controls that reflect your total technology footprint. Reduce the risk that a forgotten device or unmanaged software turns your organization into the next Colonial Pipeline.

    Info-Tech offers various levels of support to best suit your needs

    DIY Toolkit

    Guided Implementation

    Workshop

    Consulting

    "Our team has already made this critical project a priority, and we have the time and capability, but some guidance along the way would be helpful." "Our team knows that we need to fix a process, but we need assistance to determine where to focus. Some check-ins along the way would help keep us on track." "We need to hit the ground running and get this project kicked off immediately. Our team has the ability to take this over once we get a framework and strategy in place." "Our team does not have the time or the knowledge to take this project on. We need assistance through the entirety of this project."

    Diagnostics and consistent frameworks used throughout all four options

    Guided Implementation

    A Guided Implementation (GI) is a series of calls with an Info-Tech analyst to help implement our best practices in your organization.

    A typical GI around 12 calls over the course of 6 months.

    What does a typical GI on this topic look like?

    Call #1: Scope requirements, objectives, and your specific challenges.

    Call #2: Review business priorities.

    Call #3: Identify ITAM goals & target maturity.

    Call #4: Identify metrics and KPIs. Call #5: Define ITAM scope.

    Call #6: Acquire ITAM services.

    Call #7: ITAM structure and RACI.

    Call #8: ITAM and service management.

    Tools and integrations.

    Call #10: Internal and external audits.

    Call #11: Budgets & documentation

    Call #12: Roadmap, comms plan. Wrap-up.

    Phase 1 Phase 2

    Workshop Overview

    Contact your account representative for more information.
    workshops@infotech.com1-888-670-8889
    Day 1 Day 2 Day 3 Day 4 Day 5
    Identify ITAM priorities & goals, maturity, metrics and KPIs
    Identify your approach to support ITAM priorities and goals
    Next Steps and wrap-Up (offsite)
    Activities

    1.1 Define ITAM.

    1.2 Brainstorm ITAM opportunities and challenges.

    Conduct an executive alignment working session:

    1.3 Review organizational priorities, strategy, and key initiatives.

    1.4 Align executive priorities with ITAM opportunities.

    1.5 Set ITAM priorities.

    2.1 Translate opportunities into ITAM goals and tactics.

    2.2 Identify target and current state ITAM maturity.

    2.3 Create mission and vision statements.

    2.4 Identify key ITAM metrics and KPIs.

    3.1 Define ITAM scope.

    3.2 Acquire ITAM services (outsourcing and contracting)

    3.3 Centralize or decentralize ITAM capabilities.

    3.4 Create a RACI for the ITAM practice.

    3.5 Align ITAM with other service management practices.

    3.6 Evaluate ITAM tools and integrations.

    4.1 Create a plan for internal and external audits.

    4.2 Improve your budget processes.

    4.3 Establish a documentation framework and identify documentation gaps.

    4.4 Create a roadmap and communication plan.

    5.1 Complete in-progress deliverables from previous four days.

    5.2 Set up review time for workshop deliverables and to discuss next steps.

    Deliverables
    1. ITAM opportunities and challenges.
    2. Align executive priorities with ITAM opportunities.
    3. Set ITAM priorities.
    1. ITAM goals and tactics.
    2. Current and target ITAM maturity.
    3. Mission and vision statements.
    4. ITAM metrics and KPIs.
    1. Decisions that will shape your ITAM approach, including:
      1. What’s in scope (hardware, software, and cloud services).
      2. Where to centralize, decentralize, or outsource ITAM activities.
      3. Accountability, responsibility, and structure for ITAM activities.
      4. Service management alignment, tooling gaps, audit plans, budget processes, and required documentation.
    2. A roadmap and communication plan.
    1. Your completed ITAM strategy template.
    Develop an IT Asset Management Strategy

    Phase 1:

    Establish business-aligned ITAM goals and priorities

    Phase 1

    1.1 Define ITAM and brainstorm opportunities and challenges.

    Executive Alignment Working Session:

    1.2 Review organizational priorities, strategy, and key initiatives.

    1.3 Align executive priorities with ITAM opportunities & priorities.

    1.4 Identify business-aligned ITAM goals and target maturity.

    1.5 Write mission and vision statements.

    1.6 Define ITAM metrics and KPIs.

    Phase 2

    2.1 Define ITAM scope.

    2.2 Acquire ITAM services (outsourcing and contracting).

    2.3 Centralize or decentralize ITAM capabilities.

    2.4 Create a RACI for the ITAM practice.

    2.5 Align ITAM with other service management practices.

    2.6 Evaluate ITAM tools and integrations.

    2.7 Create a plan for internal and external audits.

    2.8 Improve your budget processes.

    2.9 Establish a documentation framework.

    2.10 Create a roadmap and communication plan.

    Phase Outcomes:

    Defined, business-aligned goals, priorities, and KPIs for ITAM. A concise vision and mission statement. The direction you need to establish a practical, right-sized, effective approach to ITAM for your organization.

    Before you get started

    Set yourself up for success with these three steps:
    • This methodology and the related slides are intended to be executed via intensive, collaborative working sessions using the rest of this slide deck.
    • Ensure the working sessions are a success by working through these steps before you start work on your IT asset management strategy.

    1. Identify participants

    Review recommended roles and identify who should participate in the development of your ITAM strategy.

    2. Estimate assets managed today

    Work through an initial assessment to establish ease of access to ITAM data and your level of trust in the data available to you.

    3. Create a working folder

    Create a repository to house your notes and any work in progress, including your copy of the ITAM Strategy Template.

    0.1 Identify participants

    30 minutes

    Output: List of key roles for the strategy exercises outlined in this methodology

    Participants: Project sponsor, Lead facilitator, ITAM manager and SMEs

    This methodology relies on having the right stakeholders in the room to identify ITAM goals, challenges, roles, structure, and more. On each activity slide in this deck, you’ll see an outline of the recommended participants. Use the table below to translate the recommended roles into specific people in your organization. Note that some people may fill multiple roles.

    Role Expectations People
    Project Sponsor Accountable for the overall success of the methodology. Ideally, participates in all exercises in this methodology. May be the asset manager or whoever they report to. Jake Long
    Lead Facilitator Leads, schedules, and manages all working sessions. Guides discussions and ensures activity outputs are completed. Owns and understands the methodology. Has a working knowledge of ITAM. Robert Loblaw
    Asset Manager(s) SME for the ITAM practice. Provides strategic direction to mature ITAM practices in line with organizational goals. Supports the facilitator. Eve Maldonado
    ITAM Team Hands-on ITAM professionals and SMEs. Includes the asset manager. Provide input on tactical ITAM opportunities and challenges. Bruce Wayne, Clark Kent
    IT Leaders & Managers Leaders of key stakeholder groups from across the IT department – the CIO and direct reports. Provide input on what IT needs from ITAM, and the role their teams should play in ITAM activities. May include delegates, particularly those familiar with day-to-day processes relevant to a particular discussion or exercise. Marcelina Hardy, Edmund Broughton
    ITAM Business Partners Non-IT business stakeholders for ITAM. This could include procurement, vendor management, accounting, and others. Zhang Jin, Effie Lamont
    Business Executives Organizational leaders and executives (CFO, COO, CEO, and others) or their delegates. Will participate in a mini-workshop to identify organizational goals and initiatives that can present opportunities for the ITAM practice. Jermaine Mandar, Miranda Kosuth

    0.2 Estimate asset numbers

    1 hour

    Output: Estimates of quantity and spend related to IT assets, Confidence/margin of error on estimates

    Participants: IT asset manager, ITAM team

    What do you know about your current IT environment, and how confident are you in that knowledge?

    This exercise will help you evaluate the size of the challenge ahead in terms of the raw number of assets in your environment, the spend on those assets, and the level of trust your organization has in the ITAM data.

    It is also a baseline snapshot your ability to relay key ITAM metrics quickly and confidently, so you can measure progress (in terms of greater confidence) over time.

    1. Download the estimation tracker below. Add any additional line items that are particularly important to the organization.
    2. Time-box this exercise to an hour. Use your own knowledge and existing data repositories to identify count/spend for each line item, then add a margin of error to your guess. Larger margins of error on larger counts will typically indicate larger risks.
    3. Track any assumptions, data sources used, or SMEs consulted in the comments.

    Download the IT Asset Estimation Tracker

    “Any time there is doubt about the data and it doesn’t get explained or fixed, then a new spreadsheet is born. Data validation and maintenance is critical to avoid the hidden costs of having bad data”

    Allison Kinnaird,
    Operations Practice Lead,
    Info-Tech Research Group

    0.3 Create a working folder

    15 minutes

    Output: A repository for templates and work in progress

    Participants: Lead facilitator

    Create a central repository for collaboration – it seems like an obvious step, but it’s one that gets forgotten about
    1. Download a copy of the ITAM Strategy Template.
      1. This will be the repository for all the work you do in the activities listed in this blueprint; take a moment to read it through and familiarize yourself with the contents.
    2. House the template in a shared repository that can house other related work in progress. Share this folder with participants so they can check in on your progress.
    3. You’ll see this callout box: Add your results to your copy of the ITAM Strategy Template as you work through activities in this blueprint. Copy the output to the appropriate slide in the ITAM Strategy Template.
    Stock image of a computer screen with a tiny person putting likes on things.

    Collect action items as you go

    Don’t wait until the end to write down your good ideas.
    • The last exercise in this methodology is to gather everything you’ve learned and build a roadmap to improve the ITAM practice.
    • The output of the exercises will inform the roadmap, as they will highlight areas with opportunities for improvement.
    • Write them down as you work through the exercises, or you risk forgetting valuable ideas.
    • Keep an “idea space” – a whiteboard with sticky notes or a shared document – to which any of your participants can post an idea for improvement and that you can review and consolidate later.
    • Encourage participants to add their ideas at any time during the exercises.
    Pad of sticky notes, the top of which reads 'Good ideas go here!'

    Step 1.1: Brainstorm ITAM opportunities and challenges

    Participants

    • Project sponsor and lead facilitator
    • ITAM team
    • IT leaders and managers
    • ITAM business partners

    Outcomes

    • Rally the working group around a collection of ideas that, when taken together, create a vision for the future ITAM practice.
    • Identify your organization’s current ITAM challenges.

    “ITAM is a cultural shift more than a technology shift.” (Rory Canavan, SAM Charter)

    What is an IT Asset?

    Any piece of technology can be considered an asset, but it doesn’t mean you need to track everything. Image of three people building a computer from the inside.
    Icon of a power button.

    According to the ISO 19770 standard on ITAM, an IT Asset is “[an] item, thing, or entity that can be used to acquire, process, store and distribute digital information and has potential or actual value to an organization.”
    These are all things that IT is expected to support and manage, or that have the potential to directly impact services that IT supports and manages.

    Icon of a half-full battery.

    IT assets are distinct from capital assets. Some IT assets will also be capital assets, but not all will be. And not all capital assets are IT assets, either.

    Icon of a microphone.

    IT assets are typically tracked by IT, not by finance or accounting.
    IT needs more from their IT asset tracking system than the typical finance department can deliver.
    This can include end-user devices, software, IT infrastructure, cloud-based resources, third-party managed IT services, Internet-of-Things devices, embedded electronics, SCADA equipment, “smart” devices, and more.

    Icon of a fingerprint.

    It’s important to track IT assets in a way that enables IT to deliver value to the business – and an important part of this is understanding what not to track. This list should be aligned to the needs of your organization.

    What is IT asset management?

    • IT asset management is the practice of maintaining accurate, accessible, and actionable data on IT hardware, software, and cloud assets from procurement to disposal.
    • Trustworthy data maintained by an IT asset management practice will help your business meet its goals by managing risk, controlling costs, and enabling IT services and products.
    • ITAM tends to focus on the asset itself – its technical, financial, contractual, lifecycle, and ownership attributes – rather than its interactions or connections to other IT assets, which tends to be part of configuration management.

    What IT Asset Management is NOT:

    Configuration Management: Configuration management databases (CMDBs) often draw from the same data pool as ITAM (many configuration items are assets, and vice versa), but they focus on the interaction, interconnection, and interoperation of configuration items within the IT estate.

    In practice, many configuration items will be IT assets (or parts of assets) and vice versa. Configuration and asset teams should work closely together as they develop different but complementary views of the IT environment. Use Info-Tech’s methodology to harness configuration management superpowers.

    Organizational Data Management: Leverage a different Info-Tech methodology to develop a digital and data asset management program within Info-Tech’s DAM framework.

    “Asset management’s job is not to save the organization money, it’s not to push back on software audits.

    It’s to keep the asset database as up-to-date and as trustworthy as possible. That’s it.” (Jeremy Boerger, Consultant & Author)

    “You can’t make any real decisions on CMDB data that’s only 60% accurate.

    You start extrapolating that out, you’re going to get into big problems.” (Mike Austin, Founder & CEO, MetrixData 360)

    What is an ITAM strategy?

    Our strategy document will outline a coherent, sustainable, business-aligned approach to ITAM.

    No single approach to ITAM fits all organizations. Nor will the same approach fit the same organization at different times. A world-leading research university, a state government, and a global manufacturer all have very different goals and priorities that will be best supported by different approaches to ITAM.

    This methodology will walk you through these critical decisions that will define your approach to ITAM:

    • Business-aligned priorities, opportunities, and goals: What pressing opportunities and challenges do we face as an organization? What opportunities does this create that ITAM can seize?
    • Current and future state maturity, challenges: What is the state of the practice today? Where do we need to improve to meet our goals? What challenges stand in the way of improvement?
    • Responsibility, accountability, sourcing and (de)centralization: Who does what? Who is accountable? Where is there value to outsourcing? What authority will be centralized or decentralized?
    • Tools, policies, and procedures: What technology do we need? What’s our documentation framework?
    • Initiatives, KPIs, communication plan, and roadmap: What do we need to do, in what order, to build the ITAM practice to where we need it to be? How long do we expect this to take? How will we measure success?

    “A good strategy has coherence, coordinating actions, policies, and resources so as to accomplish an important end. Most organizations, most of the time, don’t have this.

    Instead, they have multiple goals and initiatives that symbolize progress, but no coherent approach to accomplish that progress other than ‘spend more and try harder.’” (Good Strategy, Bad Strategy, Richard Rumelt)

    Enable business value with IT asset management

    If you’ve never experienced a mature ITAM program before, it is almost certainly more rewarding than you’d expect once it’s functioning as intended.

    Each of the below activities can benefit from accessible, actionable, and accurate ITAM data.

    • Which of the activities, practices, and initiatives below have value to your organization?
    • Which could benefit most from ITAM data?
    Manage Risk: Effective ITAM practices provide data and processes that help mitigate the likelihood and impact of potentially damaging IT risks.

    ITAM supports the following practices that help manage organizational risk:

    • Security Controls Development
    • Security Incident Response
    • Security Audit Reports
    • Regulatory Compliance Reports
    • IT Risk Management
    • Technical Debt Management
    • M&A Due Diligence
    Optimize Spend: Asset data is essential to maintaining oversight of IT spend, ensuring that scarce resources are allocated where they can have the most impact.

    ITAM supports these activities that help optimize spend:

    • Vendor Management & Negotiations
    • IT Budget Management & Variance Analysis
    • Asset Utilization Analysis
    • FinOps & Cloud Spend Optimization
    • Showback & Chargeback
    • Software Audit Defense
    • Application Rationalization
    • Contract Consolidation
    • License and Device Reallocation
    Improve IT Services: Asset data can help inform solutions development and can be used by service teams to enhance and improve IT service practices.

    Use ITAM to facilitate these IT services and initiatives:

    • Solution and Enterprise Architecture
    • Service Level Management
    • Technology Procurement
    • Technology Refresh Projects
    • Incident & Problem Management
    • Request Management
    • Change Management
    • Green IT

    1.1 Brainstorm ideas to create a vision for the ITAM practice

    30 minutes

    Input: Stakeholders with a vision of what ITAM could provide, if resourced and funded adequately

    Output: A collection of ideas that, when taken together, create a vision for the future ITAM practice

    Materials: ITAM strategy template, Whiteboard or virtual whiteboard

    Participants: ITAM team, IT leaders and managers, ITAM business partners

    It can be easy to lose sight of long-term goals when you’re stuck in firefighting mode. Let’s get the working group into a forward-looking mindset with this exercise.

    Think about what ITAM could deliver with unlimited time, money, and technology.

    1. Provide three sticky notes to each participant.
    2. Add the headings to a whiteboard, or use a blank slide as a digital whiteboard
    3. On each sticky note, ask participants to outline a single idea as follows:
      1. We could: [idea]
      2. Which would help: [stakeholder]
      3. Because: [outcome]
    4. Ask participants to present their sticky notes and post them to the whiteboard. Ask later participants to group similar ideas together.

    As you hear your peers describe what they hope and expect to achieve with ITAM, a shared vision of what ITAM could be will start to emerge.

    1.1 Identify structural ITAM challenges

    30 minutes

    Input: The list of common challenges on the next slide, Your estimated visibility into IT assets from the previous exercise, The experience and knowledge of your participants

    Output: Identify current ITAM challenges

    Materials: Your working copy of the ITAM Strategy Template

    Participants: ITAM team, IT leaders and managers, ITAM business partners

    What’s standing in the way today of delivering the ITAM practices you want to achieve?

    Review the list of common challenges on the next slide as a group.

    1. Delete any challenges that don’t apply to your organization.
    2. Modify any challenges as required to reflect your organization.
    3. Add further challenges that aren’t on the list, as required.
    4. Highlight challenges that are particularly painful.

    Add your results to your copy of the ITAM Strategy Template

    “The problem – the reason why asset management initiatives keep falling on their face – is that people attack asset management as a problem to solve, instead of a practice and epistemological construct.” (Jeremy Boerger, Consultant & Author)

    1.1 Identify structural ITAM challenges

    Review and update the list of common challenges below to reflect your own organization.

    • Leadership and executives don’t understand the value of asset management and don’t fund or resource it.
    • Tools aren’t fit for purpose, don’t scale, or are broken.
    • There’s a cultural tendency to focus on tools over processes.
    • ITAM data is fragmented across multiple repositories.
    • ITAM data is widely viewed as untrustworthy.
    • Stakeholders respond to vendor audits before consulting ITAM, which leads to confusion and risks penalties.
    • No time for improvement; we’re always fighting fires.
    • We don’t audit our own ITAM data for accuracy.
    • End-user equipment is shared, re-assigned, or disposed without notifying or involving IT.
    • No dedicated resources.
    • Lack of clarity on roles and responsibilities.
    • Technicians don’t track assets consistently; ITAM is seen as administrative busywork.
    • Many ITAM tasks are manual and prone to error.
    • Inconsistent organizational policies and procedures.
    • We try to manage too many hardware types/software titles.
    • IT is not involved in the procurement process.
    • Request and procurement is seen as slow and excessively bureaucratic.
    • Hardware/software standards don’t exist or aren’t enforced.
    • Extensive rogue purchases/shadow IT are challenging to manage via ITAM tools and processes.
    What Else?

    Copy results to your copy of the ITAM Strategy Template

    Step 1.2: Review organizational priorities, strategy, initiatives

    Participants

    • Project sponsor and lead facilitator
    • ITAM team
    • IT leaders and managers
    • Business executives or their delegates

    Outcomes

    • Review organizational priorities and strategy.
    • Identify key initiatives.

    Enter the executives

    Deliver on leadership priorities

    • Your business’ major transformative projects and executive priorities might seem far removed from hardware and software tracking. Why would we start with business strategy and executive priorities as we’re setting goals for the ITAM program?
    • While business executives have (likely) no interest in how software and hardware is tracked, they are accountable for the outcomes ITAM can enable. They are the most likely to understand why and how ITAM can deliver value to the organization.
    • ITAM succeeds by enabling its stakeholders to achieve business outcomes. The next three activities are designed to help you identify how you can enable your stakeholders, and what outcomes are most important from their point of view. Specifically:
      • What are the business’ planned transformational initiatives?
      • What are your highest priority goals?
      • What should the priorities of the ITAM practice be?
    • The answers to these questions will shape your approach to ITAM. Direct input from your leadership and executives – or their delegates – will help ensure you’re setting a solid foundation for your ITAM practice.

    “What outcomes does the organization want from IT asset management? Often, senior managers have a clear vision for the organization and where IT needs to go, and the struggle is to communicate that down.” (Kylie Fowler, ITAM Intelligence)

    Stock image of many hands with different puzzle pieces.

    Executive Alignment Session Overview

    ITAM Strategy Working Sessions

    • Discover & Brainstorm
    • Executive Alignment Working Session
      • 1.2 Review organizational strategy, priorities, and key initiatives
      • 1.3 Align executive priorities with ITAM opportunities, set ITAM priorities
    • ITAM Practice Maturity, Vision & Mission, Metrics & KPIs
    • Scope, Outsourcing, (De)Centralization, RACI
    • Service Management Integration
    • ITAM Tools
    • Audits, Budgets, Documents
    • Roadmap & Comms Plan

    A note to the lead facilitator and project sponsor:
    Consider working through these exercises by yourself ahead of time. As you do so, you’ll develop your own ideas about where these discussions may go, which will help you guide the discussion and provide examples to participants.

    1.2 Review organizational strategy and priorities

    30 minutes

    Input: Organizational strategy documents

    Output: A list of prioritized organizational goals, An initial assessment of how ITAM can support these goals

    Materials: The diagram in the next slide, and/or a whiteboard, Your copy of the ITAM Strategy Template

    Participants: Asset manager, IT leadership, Business executives or delegates

    Welcome your group to the working session and outline the next few exercises using the previous slide.

    Ask the most senior leader present to provide a summary of the following:

    1. What is the vision for the organization?
    2. What are our priorities and what must we absolutely get right?
    3. What do we expect the organization to look like in three years?

    The facilitator or a dedicated note-taker should record key points on a whiteboard or flipchart paper.

    1.2 Identify transformational initiatives

    30 minutes

    Input: Organizational strategy documents

    Output: A list of prioritized organizational goals, An initial assessment of how ITAM can support these goals

    Materials: The diagram in the next slide, and/or a whiteboard, Your copy of the ITAM Strategy Template

    Participants: Asset manager, IT leadership, Business executives or delegates

    Ask the most senior leader present to provide a summary of the following: What transformative business and IT initiatives are planned? When will they begin and end?

    Using one box per initiative, draw the initiatives in a timeline like the one below.

    Sample timeline for ITAM initiatives.

    Add your results to your copy of the ITAM Strategy Template

    Step 1.3: Set business-aligned ITAM priorities

    Participants

    • Project sponsor and lead facilitator
    • ITAM team
    • IT leaders and managers
    • Business executives

    Outcomes

    • Connect executive priorities to ITAM opportunities.
    • Set business-aligned priorities for the ITAM practice.

    1.3 Align executive priorities with ITAM opportunities

    45 minutes

    Input: Organizational strategy documents

    Output: A list of prioritized organizational goals, An initial assessment of how ITAM can support these goals

    Materials: The diagram in the next slide, and/or a whiteboard, Your copy of the ITAM Strategy Template

    Participants: Asset manager, IT leaders and managers, Business executives or delegates

    In this exercise, we’ll use the table on the next slide to identify the top priorities of key business and IT stakeholders and connect them to opportunities for the ITAM practice.

    1. Ask your leadership or executive delegates – what are their goals? What are they trying to accomplish? List roles and related goals in the table.
    2. Brainstorm opportunities for IT asset management to support listed goals:
      1. Can ITAM provide an enhanced level of service, access, or insight?
      2. Can ITAM address an existing issue or mitigate an existing risk?

    Add your results to your copy of the ITAM Strategy Template

    1.3 Align executive priorities with ITAM opportunities (example)

    ITAM is for the… Who wants to… Which presents these ITAM opportunities
    CEO Deliver transformative business initiatives Acquire the right tech at the right time to support transformational initiatives.
    Establish a data-driven culture of stewardship Improve data to increase IT spend transparency.
    COO Improve organizational efficiency Increase asset use.
    Consolidate major software contracts to drive discounts.
    CFO Accurately forecast spending Track and anticipate IT asset spending.
    Control spending Improve data to increase IT spend transparency.
    Consolidate major software contracts to drive discounts.
    CIO Demonstrate IT value Use data to tell a story about value delivered by IT assets.
    Govern IT use Improve data to increase IT spend transparency.
    CISO Manage IT security and compliance risks Identify abandoned or out-of-spec IT assets.
    Provide IT asset data to support controls development.
    Respond to security incidents Support security incident teams with IT asset data.
    Apps Leader Build, integrate, and support applications Identify opportunities to retire applications with redundant functionality.
    Connect applications to relevant licensing and support agreements.
    IT Infra Leader Build and support IT infrastructure. Provide input on opportunities to standardize hardware and software.
    Provide IT asset data to technicians supporting end users.

    1.3 Categorize ITAM opportunities

    10-15 minutes

    Input: The outputs from the previous exercise

    Output: Executive priorities, sorted into the three categories at the right

    Materials: The table in this slide, The outputs from the previous exercise

    Participants: Lead facilitator

    Give your participants a quick break. Quickly sort the identified ITAM opportunities into the three main categories below as best you can.

    We’ll use this table as context for the next exercise.

    Example: Optimize Spend Enhance IT Services Manage Risk
    ITAM Opportunities
    • Improve data to increase IT spend transparency.
    • Consolidate major software contracts to drive discounts.
    • Increase asset utilization.
    • Identify opportunities to retire applications with redundant functionality
    • Acquire the right tech at the right time to support transformational initiatives.
    • Provide IT asset data to technicians supporting end users.
    • Identify abandoned or out-of-spec IT assets.
    • Provide IT asset data to support controls development.
    • Support security incident teams with IT asset data.

    Add your results to your copy of the ITAM Strategy Template

    1.3 Set ITAM priorities

    30 minutes

    Input: Organizational strategy documents

    Output: A list of prioritized organizational goals, An initial assessment of how ITAM can support these goals

    Materials: Whiteboard, The template on the next slide, Your copy of the ITAM Strategy Template

    Participants: Asset manager, IT leaders and managers, Business executives or delegates

    The objective of this exercise is to prioritize the outcomes your organization wants to achieve from its ITAM practice, given the context from the previous exercises.

    Review the image below. The three points of the triangle are the three core goals of ITAM: Enhance IT Service, Manage Risk, and Optimize Spend. This exercise was first developed by Kylie Fowler of ITAM Intelligence. It is an essential exercise to understand ITAM priorities and the tradeoffs associated with those priorities. These priorities aren’t set in stone and should be revisited periodically as technology and business priorities change.

    Draw the diagram on the next slide on a whiteboard. Have the most senior leader in the room place the dot on the triangle – the closer it is to any one of the goals, the more important that goal is to the organization. Note: The center of the triangle is off limits! It’s very rarely possible to deliver on all three at once.
    Track notes on what’s being prioritized – and why – in the template on the next slide.
    Triangle with the points labelled 'Enhance IT Service', 'Manage Risk', and 'Optimize Spend'.

    Add your results to your copy of the ITAM Strategy Template

    1.3 Set ITAM Priorities

    The priorities of the ITAM practice are to:
    • Optimize Spend
    • Manage Risk
    Why?
    • We believe there is significant opportunity right now to rationalize spend by consolidating key software contracts.
    • Major acquisitions are anticipated in the near future. Effective ITAM processes are expected to mitigate acquisition risk by supporting due diligence and streamlined integration of acquired organizations.
    • Ransomware and supply chain security threats have increased demands for a comprehensive accounting of IT assets to support security controls development and security incident response.
    (Update this section with notes from your discussion.)
    Triangle with the points labelled 'Enhance IT Service', 'Manage Risk', and 'Optimize Spend'. There is a dot close to the 'Optimize Spend' corner, a legend labelling the dot as 'Our Target', and a note reading 'Move this dot to reflect your priorities'.

    Step 1.4: Identify ITAM goals, target maturity

    Participants

    • Project sponsor and lead facilitator
    • ITAM team
    • IT leaders and managers

    Outcomes

    • Connect executive priorities to ITAM opportunities.
    • Set business-aligned priorities for the ITAM practice.

    “ITAM is really no different from the other ITIL practices: to succeed, you’ll need some ratio of time, treasure, and talent… and you can make up for less of one with more of the other two.” (Jeremy Boerger, Consultant and Author)

    1.4 Identify near- and medium-term goals

    15-30 minutes

    Input: Organizational strategy documents

    Output: A list of prioritized organizational goals, An initial assessment of how ITAM can support these goals

    Materials: The table in this slide, Your copy of the ITAM Strategy Template

    Participants: ITAM team, IT leaders and managers

    Narrow down the list of opportunities to identify specific goals for the ITAM practice.

    1. Use one color to highlight opportunities you will seize in the next year.
    2. Use a second color to highlight opportunities you plan to address in the next three years.
    3. Leave blank anything you don’t intend to address in this timeframe.

    The highlighted opportunities are your near- and medium-term objectives.

    Optimize Spend Enhance IT Services Manage Risk
    Priority Critical Normal High
    ITAM Opportunities
    • Improve data to increase IT spend transparency.
    • Increase asset utilization.
    • Consolidate major software contracts to drive discounts.
    • Identify opportunities to retire applications with redundant functionality
    • Acquire the right tech at the right time to support transformational initiatives.
    • Provide IT asset data to technicians supporting end users.
    • Identify abandoned or out-of-spec IT assets.
    • Provide IT asset data to support controls development.
    • Support security incident teams with IT asset data.

    1.4 Connect ITAM goals to tactics

    30 minutes

    Input: Organizational strategy documents

    Output: A list of prioritized organizational goals, An initial assessment of how ITAM can support these goals

    Materials: The table in this slide, Your copy of the ITAM Strategy Template

    Participants: ITAM team, IT leaders and managers

    Let’s dig down a little deeper. Connect the list of opportunities from earlier to specific ITAM tactics that allow the team to seize those opportunities.

    Add another row to the earlier table for ITAM tactics. Brainstorm tactics with your participants (e.g. sticky notes on a whiteboard) and align them with the priorities they’ll support.

    Optimize SpendEnhance IT ServicesManage Risk
    PriorityCriticalNormalHigh
    ITAM Opportunities
    • Improve data to increase IT spend transparency.
    • Increase asset utilization.
    • Consolidate major software contracts to drive discounts.
    • Identify opportunities to retire applications with redundant functionality
    • Acquire the right tech at the right time to support transformational initiatives.
    • Provide IT asset data to technicians supporting end users.
    • Identify abandoned or out-of-spec IT assets.
    • Provide IT asset data to support controls development.
    • Support security incident teams with IT asset data.
    ITAM Tactics to Seize Opportunities
    • Review and improve hardware budgeting exercises.
    • Reallocate unused licenses, hardware.
    • Ensure ELP reports are up to date.
    • Validate software usage.
    • Data to support software renewal negotiations.
    • Use info from ITAM for more efficient adds, moves, changes.
    • Integrate asset records with the ticket intake system, so that when someone calls the service desk, the list of their assigned equipment is immediately available.
    • Find and retire abandoned devices or services with access to the organization’s network.
    • Report on lost/stolen devices.
    • Develop reliable disposal processes.
    • Report on unpatched devices/software.

    Add your results to your copy of the ITAM Strategy Template

    1.4 Identify current and target state

    20 minutes

    Input: Organizational strategy documents

    Output: A list of prioritized organizational goals, An initial assessment of how ITAM can support these goals

    Materials: The table in this slide, Your copy of the ITAM Strategy Template

    Participants: ITAM team, IT leaders and managers

    We’ll use this exercise to identify the current and one-year target state of ITAM using Info-Tech’s ITAM maturity framework.

    1. Review the maturity framework on the next slide as a group.
    2. In one color, highlight statements that reflect your organization today. Summarize your current state. Are you in firefighter mode? Between “firefighter” and “trusted operator”?
    3. In a second color, highlight statements that reflect where you want to be one year from today, taking into consideration the goals and tactics identified in the last exercise.
    4. During a break, copy the highlighted statements to the table on the slide after next, then add this final slide to your working copy of the ITAM Strategy Template.

    Add your results to your copy of the ITAM Strategy Template

    Establish current and target ITAM maturity

    IT maturity ladder with five color-coded levels. Innovator – Optimized Asset Management
    • All items from Business & Technology Partner, plus:
    • Business and IT stakeholders collaborate regularly with the ITAM team to identify new opportunities to leverage or deploy ITAM practices and data to mitigate risks, optimize spend, and improve service. The ITAM program scales with the business.
    Business & Technology Partner – Proactive Asset Management
    • All items from Trusted Operator, plus:
    • The ITAM data is integral to decisions related to budget, project planning, IT architecture, contract renewal, and vendor management. Software and cloud assets are reviewed as frequently as required to manage costs. ITAM data consumers have self-serve access to ITAM data.
    • Continuous improvement practices strengthen ITAM efficiency and effectiveness.
    • ITAM processes, standards, and related policies are regularly reviewed and updated. ITAM teams work closely with SMEs for key tools/systems integrated with ITAM (e.g. AD, ITSM, monitoring tools) to maximize the value and reliability of integrations.
    Trusted Operator – Controls Assets
    • ITAM data for deployed hardware and software is regularly audited for accuracy.
    • Sufficient staff and skills to support asset tracking, including a dedicated IT asset management role. Teams responsible for ITAM data collection cooperate effectively. Policies and procedures are documented and enforced. Key licenses and contracts are available to the ITAM team. Discovery, tracking, and analysis tools support most important use cases.
    Firefighter – Reactive Asset Tracking
    • Data is often untrustworthy, may be fragmented across multiple repositories, and typically requires significant effort to translate or validate before use.
    • Insufficient staff, fragmented or incomplete policies or documentation. Data tracking processes are extremely highly manual. Effective cooperation for ITAM data collection is challenging.
    • ITAM tools are in place, but additional configuration or tooling is needed.
    Unreliable - Struggles to Support
    • No data, or data is typically unusable.
    • No allocated staff, no cooperation between parties responsible for ITAM data collection.
    • No related policies or documentation.
    • Tools are non-existent or not fit-for-purpose.

    Current and target ITAM maturity

    Today:
    Firefighter
    • Data is often untrustworthy, is fragmented across multiple repositories, and typically requires significant effort to translate or validate before use.
    • Insufficient staff, fragmented or incomplete policies or documentation.
    • Tools are non-existent.
    In One Year:
    Trusted Operator
    • ITAM data for deployed hardware and software is regularly audited for accuracy.
    • Sufficient staff and skills to support asset tracking, including a dedicated IT asset management role.
    • Teams responsible for ITAM data collection cooperate effectively.
    • Discovery, tracking, and analysis tools support most important use cases.
    IT maturity ladder with five color-coded levels.

    Innovator – Optimized Asset Management

    Business & Technology Partner – Proactive Asset Management

    Trusted Operator – Controls Assets

    Firefighter – Reactive Asset Tracking

    Unreliable - Struggles to Support

    Step 1.5: Write mission and vision statements

    Participants

    • Project sponsor and lead facilitator
    • ITAM team
    • IT leaders and managers

    Outcomes

    • Write a mission statement that encapsulates the purpose and intentions of the ITAM practice today.
    • Write a vision statement that describes what the ITAM practice aspires to become and achieve.

    Write vision and mission statements

    Create two statements to summarize the role of the ITAM practice today – and where you want it to be in the future.

    Create two short, compelling statements that encapsulate:
    • The vision for what we want the ITAM practice to be in the future; and
    • The mission – the purpose and intentions – of the ITAM practice today.

    Why bother creating mission and vision statements? After all, isn’t it just rehashing or re-writing all the work we’ve just done? Isn’t that (at best) a waste of time?

    There are a few very important reasons to create mission and vision statements:

    • Create a compass that can guide work today and your roadmap for the future.
    • Focus on the few things you must do, rather than the many things you could do.
    • Concisely communicate a compelling vision for the ITAM practice to a larger audience who (let’s face it) probably won’t read the entire ITAM Strategy deck.

    “Brevity is the soul of wit.” (Hamlet, Act 2, Scene 2)

    “Writing is easy. All you have to do is cross out the wrong words.” (Mark Twain)

    1.5 Write an ITAM vision statement

    30 minutes

    Input: Organizational strategy documents

    Output: A list of prioritized organizational goals, An initial assessment of how ITAM can support these goals

    Materials: A whiteboard, Your copy of the ITAM Strategy Template

    Participants: ITAM team, IT Leaders and managers

    Your vision statement describes the ITAM practice as it will be in the far future. It is a target to aspire to, beyond your ability to achieve in the near or medium term.

    Examples of ITAM vision statements:

    Develop the single accurate view of IT assets, available to anyone who needs it.

    Indispensable data brokers that support strategic decisions on the IT environment.

    Provide sticky notes to participants. Write out the three questions below on a whiteboard side by side. Have participants write their answers to the questions and post them below the appropriate question. Give everyone 10 minutes to write and post their ideas.

    1. What’s the desired future state of the ITAM practice?
    2. What needs to be done to achieved this desired state?
    3. How do we want ITAM to be perceived in this desired state?

    Review the answers and combine them into one focused vision statement. Use the 20x20 rule: take no more than 20 minutes and use no more than 20 words. If you’re not finished after 20 minutes, the ITAM manager should make any final edits offline.

    Document your vision statement in your ITAM Strategy Template.

    Add your results to your copy of the ITAM Strategy Template

    1.5 Write an ITAM mission statement

    30 minutes

    Input: Organizational strategy documents

    Output: A list of prioritized organizational goals, An initial assessment of how ITAM can support these goals

    Materials: The table in this slide, Your copy of the ITAM Strategy Template

    Participants: ITAM team, IT leaders and managers

    Your ITAM mission statement is an expression of what your IT asset management function brings to your organization today. It should be presented in straightforward language that is compelling, easy to understand, and sharply focused.

    Examples of ITAM mission statements:

    Maintain accurate, actionable, accessible on data on all IT assets.

    Support IT and the business with centralized and integrated asset data.

    Provide sticky notes to participants. Write out the questions below on a whiteboard side by side. Have participants write their answers to the questions and post them below the appropriate question. Give everyone 10 minutes to write and post their ideas.

    1. What is our role as the asset management team?
    2. How do we support the IT and business strategies?
    3. What does our asset management function offer that no one else can?

    Review the answers and combine them into one focused vision statement. Use the 20x20 rule: take no more than 20 minutes and use no more than 20 words. If you’re not finished after 20 minutes, the ITAM manager should make any final edits offline.

    Document your vision statement in your ITAM Strategy Template.

    Add your results to your copy of the ITAM Strategy Template

    Step 1.6: Define ITAM metrics and KPIs

    Participants

    • Project sponsor and lead facilitator
    • ITAM team
    • IT leaders and managers

    Outcomes

    • Identify metrics, data, or reports that may be of interest to different consumers of ITAM data.
    • Identify the key performance indicators (KPIs) for the ITAM practice, based on the goals and priorities established earlier.

    Navigate a universe of ITAM metrics

    When you have the data, how will you use it?

    • There’s a dizzying array of potential metrics you can develop and track across your ITAM environment.
    • Different stakeholders will need different data feeds, metrics, reports, and dashboards.
    • Different measures will be useful at different times. You will often need to filter or slice the data in different ways (by department, timeframe, equipment type, etc.)
    • We’ll use the next few exercises to identify the types of metrics that may be useful to different stakeholders and the KPIs to measure progress towards ITAM goals and priorities.

    ITAM Metrics

    • Quantity
      e.g. # of devices or licenses
    • Cost
      e.g. average laptop cost
    • Compliance
      e.g. effective license position reports
    • Progress
      e.g. ITAM roadmap items completed
    • Quality
      e.g. ITAM data accuracy rate
    • Time
      e.g. time to procure/ deploy

    Drill down by:

    • Vendor
    • Date
    • Dept.
    • Product
    • Location
    • Cost Center

    Develop different metrics for different teams

    A few examples:

    • CIOs — CIOs need asset data to govern technology use, align to business needs, and demonstrate IT value. What do we need to budget for hardware and software in the next year? Where can we find money to support urgent new initiatives? How many devices and software titles do we manage compared to last year? How has IT helped the business achieve key goals?
    • Asset Managers — Asset managers require data to help them oversee ITAM processes, technology, and staff, and to manage the fleet of IT assets they’re expected to track. What’s the accuracy rate of ITAM data? What’s the state of integrations between ITAM and other systems and processes? How many renewals are coming up in the next 90 days? How many laptops are in stock?
    • IT Leaders — IT managers need data that can support their teams and help them manage the technology within their mandate. What technology needs to be reviewed or retired? What do we actually manage?
    • Technicians — Service desk technicians need real-time access to data on IT assets to support service requests and incident management – for example, easy access to the list of equipment assigned to a particular user or installed in a particular location.
    • Business Managers and Executives — Business managers and executives need concise, readable dashboards to support business decisions about business use of IT assets. What’s our overall asset spend? What’s our forecasted spend? Where could we reallocate spend?

    1.6 Identify useful ITAM metrics and reports

    60 minutes

    Input: Organizational strategy documents

    Output: A list of prioritized organizational goals, An initial assessment of how ITAM can support these goals

    Materials: The table in this slide, Your copy of the ITAM Strategy Template

    Participants: ITAM team, IT leaders and managers

    Use this exercise to identify as many potentially useful ITAM metrics and reports as possible, and narrow them down to a few high-priority metrics. Leverage the list of example metrics on the next slide for your own exercise. If you have more than six participants, consider splitting into two or more groups, and divide the table between groups to minimize overlap.

    1. List potential consumers of ITAM data in the column on the left.
    2. What type of information do we think this role needs? What questions about IT assets do we get on a regular basis from this role or team?
    3. Review and consolidate the list as a group. Discuss and highlight any metrics the group thinks are a particularly high priority for tracking.
    Role Compliance Quality Quantity Cost Time Progress
    IT Asset Manager Owned devices not discovered in last 60 days Discrepancies between discovery data and ITAM DB records # of corporate-owned devices Spend on hardware (recent and future/ planned) Average time, maximum time to deploy end-user devices Number of ITAM roadmap items in progress
    Service Desk

    Add your results to your copy of the ITAM Strategy Template

    Examples of ITAM metrics

    Compliance Quality Quantity Cost Time/Duration/Age Progress
    Owned devices not discovered in last 60 days Discrepancies between discovery data and ITAM DB records # of corporate-owned devices Spend on hardware (recent and future/planned) Average time, maximum time to deploy end-user devices Number of ITAM roadmap items in progress or completed
    Disposed devices without certificate of destruction Breakage rates (in and out of warranty) by vendor # of devices running software title X, # of licenses for software title X Spend on software (recent and future/planned) Average time, maximum time to deploy end user software Number of integrations between ITAM DB and other sources
    Discrepancies between licenses and install count, by software title RMAs by vendor, model, equipment type Number of requests by equipment model or software title Spend on cloud (recent and future/planned) Average & total time spent on software audit responses Number of records in ITAM database
    Compliance reports (e.g. tied to regulatory compliance or grant funding) Tickets by equipment type or software title Licenses issued from license pool in the last 30 days Value of licenses issued from license pool in the last 30 days (cost avoidance) Devices by age Software titles with an up-to-date ELP report
    Reports on lost and stolen devices, including last assigned, date reported stolen, actions taken User device satisfaction scores, CSAT scores Number of devices retired or donated in last year Number of IT-managed capital assets Number of hardware/software request tickets beyond time-to-fulfil targets Number of devices audited (by ITAM team via self-audit)
    Number of OS versions, unpatched systems Number of devices due for refresh in the next year Spend saved by harvesting unused software Number of software titles, software vendors managed by ITAM team
    Audit accuracy rate Equipment in stock Cost savings from negotiations
    # of users assigned more than one device Number of non-standard devices or requests Dollars charged during audit or true-up

    Differentiate between metrics and KPIs

    Key performance indicators (KPIs) are metrics with targets aligned to goals.

    Targets could include one or more of:

    • Target state (e.g. completed)
    • Target magnitude (e.g. number, percent, rate, dollar amount)
    • Target direction (e.g. trending up or down)

    You may track many metrics, but you should have only a few KPIs (typically 2-3 per objective).

    A breached KPI should be a trigger to investigate and remediate the root cause of the problem, to ensure progress towards goals and priorities can continue.

    Which KPIs you track will change over the life of the practice, as ITAM goals and priorities shift. For example, KPIs may initially track progress towards maturing ITAM practices. Once you’ve reached target maturity, KPIs may shift to track whether the key service targets are being met.

    1.6 Identify ITAM KPIs

    20 minutes

    Input: Organizational strategy documents

    Output: A list of prioritized organizational goals, An initial assessment of how ITAM can support these goals

    Materials: The table in this slide, Your copy of the ITAM Strategy Template

    Participants: ITAM team, IT leaders and managers

    Good KPIs are a more objective measure of whether you’re succeeding in meeting the identified priorities for the ITAM practice.

    Identify metrics that can measure progress or success against the priorities and goals set earlier. Aim for around three metrics per goal. Identify targets for the metric you think are SMART (specific, measurable, achievable, relevant, and timebound). Track your work using the example table below.

    Goal Metric Target
    Consolidate major software contracts to drive discounts Amount spent on top 10 software contracts Decrease by 10% by next year
    Customer satisfaction scores with enterprise software Satisfaction is equal to or better than last year
    Value of licenses issued from license pool 30% greater than last year
    Identify abandoned or out-of-spec IT assets # of security incidents involving undiscovered assets Zero
    % devices with “Deployed” status in ITAM DB but not discovered for 30+ days ‹1% of all records in ITAM DB
    Provide IT asset data to technicians for service calls Customer satisfaction scores Satisfaction is equal to or better than last year
    % of end-user devices meeting minimum standards 97%

    Add your results to your copy of the ITAM Strategy Template

    Develop an IT Asset Management Strategy

    Phase 2:

    Identify your approach to support ITAM priorities and goals

    Phase 1

    1.1 Define ITAM and brainstorm opportunities and challenges.

    Executive Alignment Working Session:

    1.2 Review organizational priorities, strategy, and key initiatives.

    1.3 Align executive priorities with ITAM opportunities & priorities.

    1.4 Identify business-aligned ITAM goals and target maturity.

    1.5 Write mission and vision statements.

    1.6 Define ITAM metrics and KPIs.

    Phase 2

    2.1 Define ITAM scope.

    2.2 Acquire ITAM services (outsourcing and contracting).

    2.3 Centralize or decentralize ITAM capabilities.

    2.4 Create a RACI for the ITAM practice.

    2.5 Align ITAM with other service management practices.

    2.6 Evaluate ITAM tools and integrations.

    2.7 Create a plan for internal and external audits.

    2.8 Improve your budget processes.

    2.9 Establish a documentation framework.

    2.10 Create a roadmap and communication plan.

    Phase Outcomes:

    Establish an approach to achieving ITAM goals and priorities, including scope, structure, tools, service management integrations, documentation, and more.

    Create a roadmap that enables you to realize your approach.

    Step 2.1: Define ITAM Scope

    Participants

    • Project sponsor and lead facilitator
    • ITAM team
    • IT leaders and managers
    • ITAM business partners

    Outcomes

    • Establish what types of equipment and software you’ll track through the ITAM practice.
    • Establish which areas of the business will be in scope of the ITAM practice.

    Determine ITAM Scope

    Focus on what’s most important and then document it so everyone understands where they can provide the most value.

    Not all categories of assets require the same level of tracking, and some equipment and software should be excluded from the ITAM practice entirely.

    In some organizations, portions of the environment won’t be tracked by the asset management team at all. For example, some organizations will choose to delegate tracking multi-function printers (MFPs) or proprietary IoT devices to the department or vendor that manages them.

    Due to resourcing or technical limitations, you may decide that certain equipment or software is out of scope for the moment.

    What do other organizations typically track in detail?
    • Installs and entitlements for major software contracts that represent significant spend and/or are highly critical to business goals.
    • Equipment managed directly by IT that needs to be refreshed on a regular cycle:
      • End-user devices such as laptops, desktops, and tablets.
      • Server, network, and telecoms devices.
    • High value equipment that is not regularly refreshed may also be tracked, but in less detail – for example, you may not refresh large screen TVs, but you may need to track date of purchase, deployed location, vendor, and model for insurance or warranty purposes.

    2.1 Establish scope for ITAM

    45 minutes

    Input: Organizational strategy documents

    Output: ITAM scope, in terms of types of assets tracked and not tracked

    Materials: The table in this slide, Your copy of the ITAM Strategy Template

    Participants: ITAM team, IT leaders and managers, ITAM business partners

    Establish the hardware and software that are within the scope of the ITAM program by updating the tables below to reflect your own environment. The “out of scope” category will include asset types that may be of value to track in the future but for which the capability or need don’t exist today.

    Hardware Software Out of Scope
    • End-user devices housing data or with a dollar value of more than $300, which will be replaced through lifecycle refresh.
    • Infrastructure devices, including network, telecom, video conferencing, servers and more
    • End-user software purchased under contract
    • Best efforts on single license purchases
    • Infrastructure software, including solutions used by IT to manage the infrastructure
    • Enterprise applications
    • Cloud (SaaS, IaaS, PaaS)
    • Departmental applications
    • Open-source applications
    • In-house developed applications
    • Freeware & shareware
    • IoT devices

    The following locations will be included in the ITAM program: All North and South America offices and retail locations.

    Add your results to your copy of the ITAM Strategy Template

    Step 2.2: Acquire ITAM Services

    Participants

    • Project sponsor and lead facilitator
    • ITAM team
    • IT leaders and managers
    • ITAM business partners

    Outcomes

    • Define the type of work that may be more effectively or efficiently delivered by an outsourcer or contractor.

    “We would like our clients to come to us with an idea of where they want to get to. Why are you doing this? Is it for savings? Because you want to manage your security attack surface? Are there digital initiatives you want to move forward? What is the end goal?” (Mike Austin, MetrixData 360)

    Effectively acquire ITAM services

    Allow your team to focus on strategic, value-add activities by acquiring services that free them from commodity tasks.
    • When determining which asset capabilities and activities are best kept in-house and which ones are better handled by a supplier, it is imperative to keep the value to the business in mind.
    • Activities/capabilities that are challenging to standardize and are critical to enabling business goals are better kept in-house.
    • Activities/capabilities that are (or should be) standardized and automated are ideal candidates for outsourcing.
    • Outsourcing can be effective and successful with a narrow scope of engagement and an alignment to business outcomes.
    • Organizations that heavily weigh cost reduction as a significant driver for outsourcing are far less likely to realize the value they expected to receive.
    Business Enablement
    • Supports business-aligned ITAM opportunities & priorities
    • Highly specialized
    • Offers competitive advantages
    Map with axes 'Business Enablement' and 'Vendor's Performance Advantage' for determining whether or not to outsource.
    Vendor’s Performance Advantage
    • Talent or access to skills
    • Economies of scale
    • Access to technology
    • Does not require deep knowledge of your business

    Decide what to outsource

    It’s rarely all or nothing.

    Ask yourself:
    • How important is this activity or capability to ITAM, IT, and business priorities and goals?
    • Is it a non-commodity IT service that can improve customer satisfaction?
    • Is it a critical service to the business and the specialized knowledge must remain in-house?
    • Does the function require access to talent or skills not currently available in-house, and is cost-prohibitive to obtain?
    • Are there economies of scale that can help us meet growing demand?
    • Does the vendor provide access to best-of-breed tools and solutions that can handle the integration, management, maintenance and support of the complete system?

    You may ultimately choose to engage a single vendor or a combination of multiple vendors who can best meet your ITAM needs.

    Establishing effective vendor management processes, where you can maximize the amount of service you receive while relying on the vendor’s expertise and ability to scale, can help you make your asset management practice a net cost-saver.

    ITAM activities and capabilities
    • Contract review
    • Software audit management
    • Asset tagging
    • Asset disposal and recycling
    • Initial ITAM record creation
    • End-user device imaging
    • End-user device deployment
    • End-user software provisioning
    • End-user image management
    • ITAM database administration
    • ELP report creation
    • ITAM process management
    • ITAM report generation
    ITAM-adjacent activities and capabilities
    • Tier 1 support/service desk
    • Deskside/field support
    • Tier 3 support
    • IT Procurement
    • Device management/managed IT services
    • Budget development
    • Applications development, maintenance
    • Infrastructure hosting (e.g. cloud or colocation)
    • Infrastructure management and support
    • Discovery/monitoring tools management and support

    2.2 Identify outsourcing opportunities

    1-2 hours

    Input: Understanding of current ITAM processes and challenges

    Output: Understanding of potential outsourcing opportunities

    Materials: The table in this slide, and insight in previous slides, Your copy of the ITAM Strategy Template

    Participants: ITAM team, IT leaders and managers, ITAM business partners

    At a high level, discuss which functions of ITAM are good candidates for outsourcing.

    Start with the previous slide for examples of outsourcing activities or capabilities directly related to or adjacent to the ITAM practice. Categorize these activities as follows:

    Outsource Potentially Outsource Insource
    • Asset disposal/recycling
    • ELP report creation
    • ITAM process management

    Go through the list of activities to potentially or definitely outsource and confirm:

    1. Will outsourcing solve a resourcing need for an existing process, or can you deliver this adequately in-house?
    2. Will outsourcing improve the effectiveness and efficiency of current processes? Will it deliver more effective service channels or improved levels of reliability and performance consistency?
    3. Will outsourcing provide or enable enhanced service capabilities that your IT customers could use, and which you cannot deliver in-house due to lack of scale or capacity?

    Answering “no” to more than one of these questions suggests a need to further review options to ensure the goals are aligned with the potential value of the service offerings available.

    Add your results to your copy of the ITAM Strategy Template

    Step 2.3: Centralize or decentralize ITAM capabilities

    Participants

    • Project sponsor and lead facilitator
    • ITAM team
    • IT leaders and managers
    • ITAM business partners

    Outcomes

    • Outline where the team(s) responsible for ITAM sit across the organization, who they report to, and who they need to work with across IT and the business.

    Align ITAM with IT’s structure

    ITAM’s structure will typically align with the larger business and IT structure. The wrong structure will undermine your ability to meet ITAM goals and lead to frustration, missed work, inefficiency, and loss of value.

    Which of the four archetypes below reflects the structure you need?

    1. Centralized — ITAM is entirely centralized in a single function, which reports into a central IT department.
    2. Decentralized — Local IT groups are responsible and accountable for ITAM. They may coordinate informally but do not report to any central team.
    3. Hybrid-Shared Services — Local IT can opt in to shared services but must follow centrally set ITAM practices to do so, usually with support from a shared ITAM function.
    4. Hybrid-Federated — Local IT departments are free to develop their own approach to ITAM outside of core, centrally set requirements.

    Centralized ITAM

    Total coordination, control, and oversight

    • ITAM accountability, policies, tools, standards, and expertise – in this model, they’re all concentrated in a single, specialized IT asset management practice. Accountability, authority, and oversight are concentrated in the central function as well.
    • A central ITAM team will benefit from knowledge sharing and task specialization opportunities. They are a visible single point of contact for ITAM-related questions
    • The central ITAM team will coordinate ITAM activities across the organization to optimize spend, manage risk, and enhance service. Any local IT teams are supported by and directly answerable to the central ITAM team for ITAM activities.
    • There is a single, centrally managed ITAM database. Wherever possible, this database should be integrated with other tools to support cross-solution automation (e.g. integrate AD to automatically reflect user identity changes in the ITAM database).
    • This model drives cross-organization coordination and oversight, but it may not be responsive to specific and nuanced local requirements.
    Example: Centralized
    Example of a Centralized ITAM.

    Solid line. Direct reporting relationship

    Dotted line. Dotted line working or reporting relationship

    Decentralized ITAM

    Maximize choice

    • ITAM accountability and oversight are entirely devolved to local or regional IT and/or ITAM organizations, which are free to set their own priorities, goals, policies, and standards. This model maximizes the authority of local groups to build practices that meet local requirements.
    • It may be challenging to resource and mature local practices. ITAM maturity will vary from one local organization to the next.
    • It is more likely that ITAM managers are a part-time role, and sometimes even a non-IT role. Local ITAM teams or coordinators may coordinate and share knowledge informally, but specialization can be challenging to build or leverage effectively across the organization.
    • There is likely no central ITAM tool. Local tools may be acquired, implemented, and integrated by local IT departments to suit their own needs, which can make it very difficult to report on assets organization-wide – for example, to establish compliance on an enterprise software contract.
    Example: Decentralized

    Example of a Decentralized ITAM.

    Solid line. Direct reporting relationship

    Dotted line. Dotted line working or reporting relationship

    Blue dotted line. Informal working relationships, knowledge sharing

    Hybrid: Federation

    Centralization with a light touch

    • A middle ground between centralized and decentralized ITAM, this model balances centralized decision making, specialization, and governance with local autonomy.
    • A central team will define organization-wide ITAM goals, develop capabilities, policies, and standards, and monitor compliance by local and central teams. All local teams must comply with centrally defined requirements, but they can also develop further capabilities to meet local goals.
    • For example, there will typically be a central ITAM database that must be used for at least a subset of assets, but other teams may build their own databases for day-to-day operations and export data to the central database as required.
    • There are often overlapping responsibilities in this model. A strong collaborative relationship between central and local ITAM teams is especially important here, particularly after major changes to requirements, processes, tools, or staffing when issues and breakdowns are more likely.
    Example: Federation

    Example of a Federation ITAM.

    Solid line. Direct reporting relationship

    Purple solid line. Oversight/governance

    Dotted line. Dotted line working or reporting relationship

    Hybrid: Shared Services

    Optional centralization

    • A special case of federated ITAM that balances central control and local autonomy, but with more power given to local IT to opt out of centralized shared services that come with centralized ITAM requirements.
    • ITAM requirements set by the shared services team will support management, allocation, and may have showback or chargeback implications. Following the ITAM requirements is a condition of service. If a local organization chooses to stop using shared services, they are (naturally) no longer required to adhere to the shared services ITAM requirements.
    • As with the federated model, local teams may develop further capabilities to meet local goals.
    Example: Shared Services

    Example of a Shared Services ITAM.

    Solid line. Direct reporting relationship

    Dotted line. Dotted line working relationship

    Blue dotted line. Informal working relationships, knowledge sharing

    Structure data collection & analysis

    Consider the implications of structure on data.

    Why centralize?
    • There is a need to build reports that aggregate data on assets organization-wide, rather than just assets within a local environment.
    • Decentralized ITAM tracking isn’t producing accurate or usable data, even for local purposes.
    • Tracking tools have overlapping functionality. There’s an opportunity to rationalize spend, management and support for ITAM tools.
    • Contract centralization can optimize spend and manage risks, but only with the data required to manage those contracts.
    Why decentralize?
    • Tracking and reporting on local assets is sufficient to meet ITAM goals; there is limited or no need to track assets organization-wide.
    • Local teams have the skills to track and maintain asset data; subsidiaries have appropriate budgets and tools to support ITAM tracking.
    • Decentralized ITSM/ITAM tools are in place, populated, and accurate.
    • The effort to consolidate tools and processes may outweigh the benefits to data centralization.
    • Lots of variability in types of assets and the environment is stable.
    Requirements for success:
    • A centralized IT asset management solution is implemented and managed.
    • Local teams must understand the why and how of centralized data tracking and be held accountable for assigned responsibilities.
    • The asset tool should offer both centralized and localized views of the data.
    Requirements for success:
    • Guidelines and expectations for reporting to centralized asset management team will be well defined and supported.
    • Local asset managers will have opportunity to collaborate with others in the role for knowledge transfer and asset trading, where appropriate.

    Structure budget and contract management

    Contract consolidation creates economies of scale for vendor management and license pooling that strengthen your negotiating position with vendors and optimize spend.

    Why centralize?
    • Budgeting, governance, and accountability are already centralized. Centralized ITAM practices can support the existing governance practices.
    • Centralizing contract management and negotiation can optimize spend and/or deliver access to better service.
    • Centralize management for contracts that cover most of the organization, are highly complex, involve large spend and/or higher risk, and will benefit from specialization of asset staff.
    Why decentralize?
    • Budgeting, governance, and accountability rest with local organizations.
    • There may be increased need for high levels of customer responsiveness and support.
    • Decentralize contract management for contracts used only by local groups (e.g. a few divisions, a few specialized functions), and that are smaller, low risk, and come with standard terms and conditions.
    Requirements for success:
    • A centralized IT asset management solution is implemented and managed.
    • Contract terms must be harmonized across the organization.
    • Centralized fulfillment is as streamlined as possible. For example, software contracts should include the right to install at any time and pay through a true-up process.
    Requirements for success:
    • Any expectations for harmonization with the centralized asset management team will be well defined and supported.
    • Local asset managers can collaborate with other local ITAM leads to support knowledge transfer, asset swapping, etc.

    Structure technology management

    Are there opportunities to centralize or decentralize support functions?

    Why centralize?
    • Standard technologies are deployed organization-wide.
    • There are opportunities to improve service and optimize costs by consolidating knowledge, service contracts, and support functions.
    • Centralizing data on product supply allows for easier harvest and redeployment of assets by a central support team.
    • A stable, central support function can better support localized needs during seasonal staffing changes, mergers and acquisitions.
    Why decentralize?
    • Technology is unique to a local subset of users or customers.
    • Minimal opportunity for savings or better support by consolidating knowledge, service contracts, or support functions.
    • Refresh standards are set at a local level; new tech adoption may be impeded by a reliance on older technologies, local budget shortfalls, or other constraints.
    • Hardware may need to be managed locally if shipping costs and times can’t reasonably be met by a distant central support team.
    Requirements for success:
    • Ensure required processes, technologies, skills, and knowledge are in place to enable centralized support.
    • Keep a central calendar of contract renewals, including reminders to start work on the renewal no less than 90 days prior. Prioritize contracts with high dollar value or high risk.
    • The central asset management solution should be configured to provide data that can enable the central support team.
    Requirements for success:
    • Ensure required processes, technologies, skills, and knowledge are in place to enable decentralized support.
    • Decentralized support teams must understand and adhere to ITAM activities that are part of support work (e.g. data entry, data audits).
    • The central asset management solution should be configured to provide data that can enable the central support team, or decentralized asset solutions must be funded, and teams trained on their use.

    2.3 Review ITAM Structure

    1-2 hours

    Input: Understanding of current organizational structure, Understanding of challenges and opportunities related to the current structure

    Output: A list of prioritized organizational goals, An initial assessment of how ITAM can support these goals

    Materials: The table in this slide, Your copy of the ITAM Strategy Template

    Participants: ITAM team, IT leaders and managers, ITAM business partners

    Outline the current model for your organization and identify opportunities to centralize or decentralize ITAM-related activities.

    1. What model best describes how ITAM should be structured in your organization? Modify the slide outlining structure as a group to outline your own organization, as required.
    2. In the table below, outline opportunities to centralize or decentralize data tracking, budget and contract management, and technology management activities.
    Centralize Decentralize
    Data collection & analysis
    • Make better use of central ITAM database.
    • Support local IT departments building runbooks for data tracking during lifecycle activities (create templates, examples)
    Budget and contract management
    • Centralize Microsoft contracts.
    • Create a runbook to onboard new companies to MSFT contracts.
    • Create tools and data views to support local department budget exercises.
    Technology management
    • Ensure all end-user devices are visible to centrally managed InTune, ConfigMgr.
    • Enable direct shipping from vendor to local sites.
    • Establish disposal/pickup at local sites.

    Add your results to your copy of the ITAM Strategy Template

    Step 2.4: Create a RACI

    Participants

    • Project sponsor and lead facilitator
    • ITAM team
    • IT leaders and managers
    • ITAM business partners

    Outcomes

    • Review the role of the IT asset manager.
    • Identify who’s responsible, accountable, consulted, and informed for key ITAM activities.

    Empower your asset manager

    The asset manager is the critical ITAM role. Ensure they’re positioned to succeed.

    There’s too much change in the technology and business environment to expect ITAM to be “a problem to solve.” It is a practice that requires care and feeding through regular iteration to achieve success. At the helm of this practice is your asset manager, whose approach and past experience will have a significant impact on how you approach ITAM.

    The asset manager role requires a variety of skills, knowledge, and abilities including:

    • Operations, process, and practice management.
    • An ability to communicate, influence, negotiate, and facilitate.
    • Organizational knowledge and relationship management.
    • Contract and license agreement analysis, attention to detail.
    • Natural curiosity and a willingness to learn.
    • A strong understanding of technologies in use by the organization, and how they fit into the asset management program.
    Where the asset manager sits in the organization will also have an impact on their focus and priorities. When the asset manager reports into a service team, their focus will often reflect their team’s focus: end-user devices and software, customer satisfaction, request fulfillment. Asset teams that report into a leadership or governance function will be more likely to focus on organization-wide assets, governance, budget management, and compliance.

    “Where your asset manager sits, and what past experience they have, is going to influence how they do asset management.” (Jeremy Boerger, Consultant & Author)

    “It can be annoying at times, but a good IT asset manager will poke their nose into activities that do not obviously concern them, such as programme and project approval boards and technical design committees. Their aim is to identify and mitigate ITAM risks BEFORE the technology is deployed as well as to ensure that projects and solutions ‘bake in’ the necessary processes and tools that ensure IT assets can be managed effectively throughout their lifecycle.” (Kylie Fowler, ITAM by Design, 2017)

    IT asset managers must have a range of skills and knowledge

    • ITAM Operations, Process, and Practice Management
      The asset manager is typically responsible for managing and improving the ITAM practice and related processes and tools. The asset manager may administer the ITAM tool, develop reports and dashboards, evaluate and implement new technologies or services to improve ITAM maturity, and more.
    • Organizational Knowledge
      An effective IT asset manager has a good understanding of your organization and its strategy, products, stakeholders, and culture.
    • Technology & Product Awareness
      An IT asset manager must learn about new and changing technologies and products adopted by the organization (e.g. IoT, cloud) and develop recommendations on how to track and manage them via the ITAM practice.
    A book surrounded by icons corresponding to the bullet points.
    • People Management
      Asset managers often manage a team directly and have dotted-line reports across IT and the business.
    • Communication
      Important in any role, but particularly critical where learning, listening, negotiation, and persuasion are so critical.
    • Finance & Budgeting
      A foundational knowledge of financial planning and budgeting practices is often helpful, where the asset manager is asked to contribute to these activities.
    • Contract Review & Analysis
      Analyze new and existing contracts to evaluate changes, identify compliance requirements, and optimize spend.

    Assign ITAM responsibilities and accountabilities

    Align authority and accountability.
    • A RACI exercise will help you discuss and document accountability and responsibility for critical ITAM activities.
    • When responsibility and accountability are not currently well documented, it’s often useful to invite a representative of the roles identified to participate in this alignment exercise. The discussion can uncover contrasting views on responsibility and governance, which can help you build a stronger management and governance model.
    • The RACI chart can help you identify who should be involved when making changes to a given activity. Clarify the variety of responsibilities assigned to each key role.
    • In the future, you may need to define roles in more detail as you change your hardware and software asset management procedures.

    R

    Responsible: The person who actually gets the job done.

    Different roles may be responsible for different aspects of the activity relevant to their role.

    A

    Accountable: The one role accountable for the activity (in terms completion, quality, cost, etc.)

    Must have sufficient authority to be held accountable; responsible roles are often accountable to this role.

    C

    Consulted: Must have the opportunity to provide meaningful input at certain points in the activity.

    Typically, subject matter experts or stakeholders. The more people you must consult, the more overhead and time you’ll add to a process.

    I

    Informed: Receives information regarding the task, but has no requirement to provide feedback.

    Information might relate to process execution, changes, or quality.

    2.4 Conduct a RACI Exercise

    1-2 hours

    Input: An understanding of key roles and activities in ITAM practices, An understanding of your organization, High-level structure of your ITAM program

    Output: A RACI diagram for IT asset management

    Materials: The table in the next slide, Your copy of the ITAM Strategy Template

    Participants: ITAM team, IT leaders and managers, ITAM business partners

    Let’s face it – RACI exercises can be dry. We’ve found that the approach below is more collaborative, engaging, and effective compared to filling out the table as a large group.

    1. Create a shared working copy of the RACI charts on the following slides (e.g. write it out on a whiteboard or provide a link to this document and work directly in it).
    2. Review the list of template roles and activities as a group. Add, change, or remove roles and activities from the table as needed.
    3. Divide into small groups. Assign each group a set of roles, and have them define whether that role is accountable, responsible, consulted, or informed for each activity in the chart. Refer to the previous slide for context on RACI. Give everyone 15 minutes to update their section of the chart.
    4. Come back together as a large group to review the chart. First, check for accountability – there should generally be just one role accountable for each activity. Then, have each small group walk through their section, and encourage participants to ask questions. Is there at least one role responsible for each task, and what are they responsible for? Does everyone listed as consulted or informed really need to be? Make any necessary adjustments.

    Add your results to your copy of the ITAM Strategy Template

    Define ITAM governance activities

    RACI Chart for ITAM governance activities. In the first column is a list of governance activities, and the row headers are positions within a company. Fields are marked with an R, A, C, or I.

    Document asset management responsibilities and accountabilities

    RACI Chart for ITAM asset management responsibilities and accountabilities. In the first column is a list of responsibilities and accountabilities, and the row headers are positions within a company. Fields are marked with an R, A, C, or I.

    Step 2.5: Align ITAM with other Service Management Practices

    Participants

    • Project sponsor and lead facilitator
    • ITAM team
    • IT leaders and managers

    Outcomes

    • Establish shared and separate responsibilities for asset and configuration management.
    • Identify how ITAM can support other practices, and how other practices can support ITAM.

    Asset vs. Configuration

    Asset and configuration management look at the same world through different lenses.
    • IT asset management tends to focus on each IT asset in its own right: assignment or ownership, its lifecycle, and related financial obligations and entitlements.
    • Configuration management is focused on configuration items (CIs) that must be managed to deliver a service and the relationships and integrations to other CIs.
    • ITAM and configuration management teams and practices should work closely together. Though asset and configuration management focus on different outcomes, they tend use overlapping tools and data sets. Each practice, when working effectively, can strengthen the other.
    • Many objects will exist in both the CMDB and AMDB, and the data on those shared objects will need to be kept in sync.
    Asset and Configuration Management: An Example

    Configuration Management Database (CMDB)

    A database of uniquely identified configuration items (CIs). Each CI record may include information on:
    Service Attributes

    Supported Service(s)
    Service Description, Criticality, SLAs
    Service Owners
    Data Criticality/Sensitivity

    CI Relationships

    Physical Connections
    Logical Connections
    Dependencies

    Arrow connector.

    Discovery, Normalization, Dependency Mapping, Business Rules*

    Manual Data Entry

    Arrow connector.
    This shared information could be attached to asset records, CI records, or both, and it should be synchronized between the two databases where it’s tracked in both.
    Hardware Information

    Serial, Model and Specs
    Network Address
    Physical Location

    Software Installations

    Hypervisor & OS
    Middleware & Software
    Software Configurations

    Arrow connector.

    Asset Management Database (AMDB)

    A database of uniquely identified IT assets. Each asset record may include information on:
    Procurement/Purchasing

    Purchase Request/Purchase Order
    Invoice and Cost
    Cost Center
    Vendor
    Contracts and MSAs
    Support/Maintenance/Warranties

    Asset Attributes

    Model, Title, Product Info, License Key
    Assigned User
    Lifecycle Status
    Last ITAM Audit Date
    Certificate of Disposal

    Arrows connecting multiple fields.

    IT Security Systems

    Vulnerability Management
    Threat Management
    SIEM
    Endpoint Protection

    IT Service Management (ITSM) System

    Change Tickets
    Request Tickets
    Incident Tickets
    Problem Tickets
    Project Tickets
    Knowledgebase

    Financial System/ERP

    General Ledger
    Accounts Payable
    Accounts Receivable
    Enterprise Assets
    Enterprise Contract Database

    (*Discovery, dependency mapping, and data normalization are often features or modules of configuration management, asset management, or IT service management tools.)

    2.5 Integrate ITAM and configuration practices

    45 minutes

    Input: Knowledge of the organization’s configuration management processes

    Output: Define how ITAM and configuration management will support one another

    Materials: The table in this slide, Your copy of the ITAM Strategy Template

    Participants: ITAM team, IT leaders and managers, Configuration manager

    Work through the table below to identify how you will collaborate and synchronize data across ITAM and configuration management practices and tools.

    What are the goals (if any currently exist) for the configuration management practice? Connect configuration items to services to support service management.
    How will configuration and asset management teams collaborate? Weekly status updates. As-needed working sessions.
    Shared visibility on each others’ Kanban tracker.
    Create tickets to raise and track issues that require collaboration or attention from the other team.
    How can config leverage ITAM? Connect CIs to financial, contractual, and ownership data.
    How can ITAM leverage config? Connect assets to services, changes, incidents.
    What key fields will be primarily tracked/managed by ITAM? Serial number, unique ID, user, location, PO number, …
    What key fields will be primarily tracked/managed by configuration management? Supported service(s), dependencies, service description, service criticality, network address…

    Add your results to your copy of the ITAM Strategy Template

    ITAM supports service management

    Decoupling asset management from other service management practices can result in lost value. Establish how asset management can support other service management practices – and how those practices can support ITAM.

    Incident Management

    What broke?
    Was it under warranty?
    Is there a service contract?
    Was it licensed?
    Who was it assigned to?
    Is it end-of-life?

    ITAM
    Practice

    Request Management

    What can this user request or purchase?
    What are standard hardware and software offerings?
    What does the requester already have?
    Are there items in inventory to fulfil the request?
    Did we save money by reissuing equipment?
    Is this a standard request?
    What assets are being requested regularly?

    What IT assets are related to the known issue?
    What models and vendors are related to the issue?
    Are the assets covered by a service contract?
    Are other tickets related to this asset?
    What end-of-life assets have been tied to incidents recently?

    Problem Management

    What assets are related to the change?
    Is the software properly licensed?
    Has old equipment been properly retired and disposed?
    Have software licenses been returned to the pool?
    Is the vendor support on the change part of a service contract?

    Change Enablement

    2.5. Connect with other IT service practices

    45 minutes

    Input: Knowledge of existing organizational IT service management processes

    Output: Define how ITAM will help other service management processes, and how other service management processes will help ITAM

    Materials: The table in this slide, Your copy of the ITAM Strategy Template

    Participants: ITAM team, IT leaders and managers, Service leads

    Complete the table below to establish what ITAM can provide to other service management practices, and what other practices can provide to ITAM.

    Practice ITAM will help Will help ITAM
    Incident Management Provide context on assets involved in an incident (e.g. ownership, service contracts). Track when assets are involved in incidents (via incident tickets).
    Request Management Oversee request & procurement processes. Help develop asset standards. Enter new assets in ITAM database.
    Problem Management Collect information on assets related to known issues. Report back on models/titles that are generating known issues.
    Change Enablement Provide context on assets for change review. Ensure EOL assets are retired and licenses are returned during changes.
    Capacity Management Identify ownership, location for assets at capacity. Identify upcoming refreshes or purchases.
    Availability Management Connect uptime and reliability to assets. Identify assets that are causing availability issues.
    Monitoring and Event Management Provide context to events with asset data. Notify asset of unrecognized software and hardware.
    Financial Management Establish current and predict future spending. Identify upcoming purchases, renewals.

    Add your results to your copy of the ITAM Strategy Template

    Step 2.6: Evaluate ITAM tools and integrations

    Participants

    • Project sponsor and lead facilitator
    • ITAM team
    • IT leaders and managers

    Outcomes

    • Create a list of the ITAM tools currently in use, how they’re used, and their current limitations.
    • Identify new tools that could provide value to the ITAM practice, and what needs to be done to acquire and implement them.

    “Everything is connected. Nothing is also connected.” (Dirk Gently’s Holistic Detective Agency)

    Establish current strengths and gaps in your ITAM toolset

    ITAM data quality relies on tools and integrations that are managed by individuals or teams who don’t report directly to the ITAM function.

    Without direct line of sight into tools management, the ITAM team must influence rather than direct improvement initiatives that are in some cases critical to the performance of the ITAM function. To more effectively influence improvement efforts, you must explicitly identify what you need, why you need it, from which tools, and from which stakeholders.

    Data Sources
    Procurement Tools
    Discovery Tools
    Active Directory
    Purchase Documents
    Spreadsheets
    Input To Asset System(s) of Record
    ITAM Database
    ITSM Tool
    CMDB
    Output To Asset Data Consumption
    ITFM Tools
    Security Tools
    TEM Tools
    Accounting Tools
    Spreadsheets
    “Active Directory plays a huge role in audit defense and self-assessment, but no-one really goes out there and looks at Active Directory.

    I was talking to one organization that has 1,600,000 AD records for 100,000 employees.” (Mike Austin, Founder, MetrixData 360)

    2.6 Evaluate ITAM existing technologies

    30 minutes

    Input: Knowledge of existing ITAM tools

    Output: A list of prioritized organizational goals, An initial assessment of how ITAM can support these goals

    Materials: The table in this slide, Your copy of the ITAM Strategy Template

    Participants: ITAM team, IT leaders and managers

    Identify the use, limitations, and next steps for existing ITAM tools, including those not directly managed by the ITAM team.

    1. What tools do we have today?
    2. What are they used for? What are their limitations?
    3. Who manages them?
    4. What actions could we take to maximize the value of the tools?
    Existing Tool Use Constraints Owner Proposed Action?
    ITAM Module
    • Track HW/SW
    • Connect assets to incident, request
    • Currently used for end-user devices only
    • Not all divisions have access
    • SAM capabilities are limited
    ITAM Team/Service Management
    • Add license for additional read/write access
    • Start tracking infra in this tool
    Active Directory
    • Store user IDs, organizational data
    Major data quality issues IT Operations
    • Work with AD team to identify issues creating data issues

    Add your results to your copy of the ITAM Strategy Template

    2.6 Identify potential new tools

    30 minutes

    Input: Knowledge of tooling gaps, An understanding of available tools that could remediate gaps

    Output: New tools that can improve ITAM capabilities, including expected value and proposed next steps

    Materials: The table in this slide, Your copy of the ITAM Strategy Template

    Participants: ITAM team, IT leaders and managers

    Identify tools that are required to support the identified goals of the ITAM practice.

    1. What types of tools do we need that we don’t have?
    2. What could these tools help us do?
    3. What needs to be done next to investigate or acquire the appropriate tool?
    New Tool Expected Value Proposed Next Steps
    SAM tool
    • Automatically calculate licensing entitlements from contract data.
    • Automatically calculate licensing requirements from discovery data.
    • Support gap analyses.
    • Further develop software requirements.
    • Identify vendors in the space and create a shortlist.

    Add your results to your copy of the ITAM Strategy Template

    Step 2.7: Create a plan for internal and external audits

    Participants

    • Project sponsor and lead facilitator
    • ITAM team
    • IT leaders and managers
    • ITAM business partners

    Outcomes

    • Establish your approach to internal data audits.
    • Create a high-level response plan for external audits.

    Validate ITAM data via internal audits

    Data audits provide assurance that the records in the ITAM database are as accurate as possible. Consider these three approaches:

    Compare Tool Records

    Audit your data by comparing records in the ITAM system to other discovery sources.

    • Ideally, use three separate data sources (e.g. ITAM database, discovery tool, security tool). Use a common field, such as the host name, to compare across fields. (To learn more about discovery tool analysis, see Jeremy Boerger’s book, Rethinking IT Asset Management.)
    • Run reports to compare records and identify discrepancies. This could include assets missing from one system or metadata differences such as different users or installed software.
    • Over time, discrepancies between tools should be well understood and accepted; otherwise, they should be addressed and remediated.
    IT-led Audit

    Conduct a hands-on investigation led by ITAM staff and IT technicians.

    • In-person audits require significant effort and resources. Each audit should be scoped and planned ahead of time to focus on known problem areas.
    • Provide the audit team with exact instructions on what needs to be verified and recorded. Depending on the experience and attention to detail of the audit team, you may need to conduct spot checks to ensure you’re catching any issues in the audit process itself.
    • Automation should be used wherever possible (e.g. through barcodes, scanners, and tables for quick access to ITAM records).
    User-led audit

    Have users validate the IT assets assigned to them.

    • Even more than IT-led audits: don’t use this approach too frequently; keep the scope as narrow as possible and the process as simple as possible.
    • Ensure users have all the information and tools they’ll need readily available to complete this task, or the result will be ineffective and will only frustrate your users.
    • Consider a process integrated with your ITSM tool: once a year, when a user logs in to the portal, they will be asked to enter the asset code for their laptop (and provided with instructions on where to find that code). Investigate discrepancies between assignments and ITAM records.

    2.7 Set an approach to internal data audits

    30 minutes

    Input: An understanding of current data audit capabilities and needs

    Output: An outline of how you’ll approach data audits, including frequency, scope, required resources

    Materials: Your copy of the ITAM Strategy Template

    Participants: ITAM team

    Review the three internal data audit approaches outlined on the previous slide, and identify which of the three approaches you’ll use. For each approach, complete the fields in the table below.

    Audit Approach How often? What scope? Who’s involved? Comments
    Compare tool records Monthly Compare ITAM DB, Intune/ConfigMgr, and Vulnerability Scanner Data; focus on end-user devices to start Asset manager will lead at first.
    Work with tool admins to pull data and generate reports.
    IT-led audit Annual End-user devices at a subset of locations Asset manager will work with ITSM admins to generate reports. In-person audit to be conducted by local techs.
    User-led audit Annual Assigned personal devices (start with a pilot group) Asset coordinator to develop procedure with ITSM admin. Run pilot with power users first.

    Add your results to your copy of the ITAM Strategy Template

    Prepare for and respond to external audits and true-ups

    Are you ready when software vendors come knocking?

    • Vendor audits are expensive.
    • If you’re out of compliance, you will at minimum be required to pay the missing license fees. At their discretion, vendors may choose to add punitive fees and require you to cover the hourly cost of their audit teams. If you choose not to pay, the vendor could secure an injunction to cut off your service, which in many cases will be far more costly than the fines. And this is aside from the intangible costs of the disruption to your business and damaged relationships between IT, ITAM, your business, and other partners.
    • Having a plan to respond to an audit is critical to reducing audit risk. Preparation will help you coordinate your audit response, ensure the audit happens on the most favorable possible terms, and even prevent some audits from happening in the first place.
    • The best defense, as they say, is a good offense. Good ITAM and SAM processes will allow you to track acquisition, allocation, and disposal of software licenses; understand your licensing position; and ensure you remain compliant whenever possible. The vendor has no reason to audit you when there’s nothing to find.
    • Know when and where your audit risk is greatest, so you can focus your resources where they can deliver the most value.
    “If software audits are a big part of your asset operations, you have problems. You can reduce the time spent on audits and eliminate some audits by having a proactive ITAM practice.” (Sandi Conrad, Principal Research Director)

    Info-Tech Insight

    Audit defense starts long before you get audited. For an in-depth review of your audit approach, see Info-Tech’s Prepare and Defend Against a Software Audit.

    Identify areas of higher audit risk

    Watch for these warning signs
    • Your organization is visibly fighting fires. Signs of disorder may signal to vendors that there are opportunities to exploit via an audit. Past audit failures make future audits more likely.
    • You are looking for ways to decrease spend. Vendors may counter attempts to true-down licensing by launching an audit to try to find unlicensed software that provides them leverage to negotiate maintained or even increased spending.
    • Your license/contract terms with the vendor are particularly complex or highly customized. Very complex terms may make it harder to validate your own compliance, which may present opportunities to the vendor in an audit.
    • The vendor has earned a reputation for being particularly aggressive with audits. Some vendors include audits as a standard component of their business model to drive revenue. This may include acquiring smaller vendors or software titles that may not have been audit-driven in the past, and running audits on their new customer base.

    “The reality is, software vendors prey on confusion and complication. Where there’s confusion, there’s opportunity.” (Mike Austin, Founder, MetrixData 360)

    Develop an audit response plan

    You will be on the clock once the vendor sends you an audit request. Have a plan ready to go.
    • Don’t panic: Resist knee-jerk reactions. Follow the plan.
    • Form an audit response team and centralize your response: This team should be led by a member of the ITAM group, and it should include IT leadership, software SMEs, representatives from affected business areas, vendor management, contract management, and legal. You may also need to bring on a contractor with deep expertise with the vendor in question to supplement your internal capabilities. Establish clearly who will be the point of contact with the vendor during the audit.
    • Clarify the scope of the audit: Clearly establish what the audit will cover – what products, subsidiaries, contracts, time periods, geographic regions, etc. Manage the auditors to prevent scope creep.
    • Establish who covers audit costs: Vendors may demand the auditee cover the hourly cost of their audit team if you’re significantly out of compliance. Consider asking the vendor to pay for your team’s time if you’re found to be compliant.
    • Know your contract: Vendors’ contracts change over time, and it’s no guarantee that even your vendor’s licensing experts will be aware of the rights you have in your contract. You must know your entitlements to negotiate effectively.
    1. Bring the audit request received to the attention of ITAM and IT leadership. Assemble the response team.
    2. Acknowledge receipt of audit notice.
    3. Negotiate timing and scope of the audit.
    4. Direct staff not to remove or acquire licenses for software under audit without directly involving the ITAM team first.
    5. Gather installation data and documentation to establish current entitlements, including original contract, current contract, addendums, receipts, invoices.
    6. Compare entitlements to installed software.
    7. Investigate any anomalies (e.g. unexpected or non-compliant software).
    8. Review results with the audit response team.

    2.7 Clarify your vendor audit response plan

    1 hour

    Input: Organizational knowledge on your current audit response procedures

    Output: Audit response team membership, High-level audit checklist, A list of things to start, stop, and continue doing as part of the audit response

    Materials: Your copy of the ITAM Strategy Template

    Participants: ITAM team, IT leaders and managers, ITAM business partners

    1. Who’s on the audit response team, and what’s their role? Who will lead the team? Who will be the point of contact with the auditor?
    2. What are the high-level steps in our audit response workflow? Use the example checklist below as a starting point.
    3. What do we need to start, stop, and continue doing in response to audit requests?

    Example Audit Checklist

    • Bring the audit request received to the attention of ITAM and IT leadership. Assemble the response team.
    • Acknowledge receipt of audit notice.
    • Negotiate timing and scope of the audit.
    • Direct staff not to remove or acquire licenses for software under audit without directly involving the ITAM team first.
    • Gather installation data and documentation to establish current entitlements, including original contract, current contract, addendums, receipts, invoices.
    • Compare entitlements to installed software.
    • Investigate any anomalies (e.g. unexpected or non-compliant software).
    • Review results with the audit response team.

    Add your results to your copy of the ITAM Strategy Template

    Step 2.8: Improve budget processes

    Participants

    • Project sponsor and lead facilitator
    • ITAM team
    • IT leaders and managers
    • ITAM business partners

    Outcomes

    • Identify what you need to start, stop, and continue to do to support budgeting processes.

    Improve budgeting and forecasting

    Insert ITAM into budgeting processes to deliver significant value.

    Some examples of what ITAM can bring to the budgeting table:
    • Trustworthy data on deployed assets and spending obligations tied to those assets.
    • Projections of hardware due for replacement in terms of quantity and spend.
    • Knowledge of IT hardware and software contract terms and pricing.
    • Lists of unused or underused hardware and software that could be redeployed to avoid spend.
    • Comparisons of spend year-over-year.

    Being part of the budgeting process positions ITAM for success in other ways:

    • Helps demonstrate the strategic value of the ITAM practice.
    • Provides insight into business and IT strategic projects and priorities for the year.
    • Strengthens relationships with key stakeholders, and positions the ITAM team as trusted partners.

    “Knowing what you have [IT assets] is foundational to budgeting, managing, and optimizing IT spend.” (Dave Kish, Info-Tech, Practice Lead, IT Financial Management)

    Stock image of a calculator.

    2.8 Build better budgets

    20 minutes

    Input: Context on IT budgeting processes

    Output: A list of things to start, stop, and continue doing as part of budgeting exercises

    Materials: The table in this slide, Your copy of the ITAM Strategy Template

    Participants: ITAM team, IT leaders and managers, ITAM business partners

    What should we start, stop, and continue doing to support organizational budgeting exercises?

    Start Stop Continue
    • Creating buckets of spend and allocating assets to those buckets.
    • Zero-based review on IaaS instances quarterly.
    • Develop dashboards plugged into asset data for department heads to view allocated assets and spend.
    • Create value reports to demonstrate hard savings as well as cost avoidance.
    • Waiting for business leaders to come to us for help (start reaching out with reports proactively, three months before budget cycle).
    • % increases on IT budgets without further review.
    • Monthly variance budget analysis.
    • What-if analysis for asset spend based on expected headcount increases.

    Add your results to your copy of the ITAM Strategy Template

    Step 2.9: Establish a documentation framework

    Participants

    • Project sponsor and lead facilitator
    • ITAM team

    Outcomes

    • Identify key documentation and gaps in your documentation.
    • Establish where documentation should be stored, who should own it, who should have access, and what should trigger a review.

    Create ITAM documentation

    ITAM documentation will typically support governance or operations.

    Long-term planning and governance
    • ITAM policy and/or related policies (procurement policy, security awareness policy, acceptable use policy, etc.)
    • ITAM strategy document
    • ITAM roadmap or burndown list
    • Job descriptions
    • Functional requirements documents for ITAM tools

    Operational documentation

    • ITAM SOPs (hardware, software) and workflows
    • Detailed work instructions/knowledgebase articles
    • ITAM data/records
    • Contracts, purchase orders, invoices, MSAs, SOWs, etc.
    • Effective Licensing Position (ELP) reports
    • Training and communication materials
    • Tool and integration documentation
    • Asset management governance, operations, and tools typically generate a lot of documentation.
    • Don’t create documentation for the sake of documentation. Prioritize building and maintaining documentation that addresses major risks or presents opportunities to improve the consistency and reliability of key processes.
    • Maximize the value of ITAM documentation by ensuring it is as current, accessible, and usable as it needs to be.
    • Clearly identify where documentation is stored and who should have access to it.
    • Identify who is accountable for the creation and maintenance of key documentation, and establish triggers for reviews, updates, and changes.

    Consider ITAM policies

    Create policies that can and will be monitored and enforced.
    • Certain requirements of the ITAM practice may need to be backed up by corporate policies: formal statements of organizational expectations that must be recognized by staff, and which will lead to sanctions/penalties if breached.
    • Some organizations will choose to create one or more ITAM-specific policies. Others will include ITAM-related statements in other existing policies, such as acceptable use policies, security training and awareness policies, procurement policies, configuration policies, e-waste policies, and more.
    • Ensure that you are prepared to monitor compliance with policies and evenly enforce breaches of policy. Failing to consistently enforce your policies exposes you and your organization to claims of negligence or discriminatory conduct.
    • For a template for ITAM-specific policies, see Info-Tech’s policy templates for Hardware Asset Management and Software Asset Management.

    2.9 Establish documentation gaps

    15-30 minutes

    Input: An understanding of existing documentation gaps and risks

    Output: Documentation gaps, Identified owners, repositories, access rights, and review/update protocols

    Materials: The table in this slide, Your copy of the ITAM Strategy Template

    Participants: ITAM team, Optional: IT managers, ITAM business partners

    Discuss and record the following:

    • What planning/governance, operational, and tooling documentation do we still need to create? Who is accountable for the creation and maintenance of these documents?
    • Where will the documentation be stored? Who can access these documents?
    • What will trigger reviews or changes to the documents?
    Need to Create Owner Stored in Accessible by Trigger for review
    Hardware asset management SOP ITAM manager ITAM SharePoint site › Operating procedures folder
    • All IT staff
    • Annual review
    • As-needed for major tooling changes that require a documentation update

    Add your results to your copy of the ITAM Strategy Template

    Step 2.10: Create a roadmap and communication plan

    Participants

    • Project sponsor and lead facilitator
    • ITAM team
    • IT leaders and managers

    Outcomes

    • A timeline of key ITAM initiatives.
    • Improvement ideas aligned to key initiatives.
    • A communication plan tailored to key stakeholders.
    • Your ITAM Strategy document.

    “Understand that this is a journey. This is not a 90-day project. And in some organizations, these journeys could be three or five years long.” (Mike Austin, MetrixData 360)

    2.10 Identify key ITAM initiatives

    30-45 minutes

    Input: Organizational strategy documents

    Output: A roadmap that outlines next steps

    Materials: The table in this slide, Your copy of the ITAM Strategy Template

    Participants: ITAM team, IT leaders and managers, Project sponsor

    1. Identify key initiatives that are critical to improving practice maturity and meeting business goals.
    2. There should only be a handful of really key initiatives. This is the work that will have the greatest impact on your ability to deliver value. Too many initiatives muddy the narrative and can distract from what really matters.
    3. Plot the target start and end dates for each initiative in the business and IT transformation timeline you created in Phase 1.
    4. Review the chart and consider – what new capabilities should the ITAM practice have once the identified initiatives are complete? What transformational initiatives will you be better positioned to support?

    Add your results to your copy of the ITAM Strategy Template

    Transformation Timeline

    Example transformation timeline with row headers 'Business Inititiaves', 'IT Initiatives', and 'ITAM Initiatives'. Each initiative is laid out along the timeline appropriately.

    2.10 Align improvement ideas to initiatives

    45 minutes

    Input: Key initiatives, Ideas for ITAM improvement collected over the course of previous exercises

    Output: Concrete action items to support each initiative

    Materials: The table in the next slide, Your copy of the ITAM Strategy Template

    Participants: ITAM team, IT leaders and managers, Project sponsor

    As you’ve been working through the previous exercises, you have been tracking ideas for improvement – now we’ll align them to your roadmap.

    1. Review the list of ideas for improvement you’ve produced over the working sessions. Consolidate the list – are there any ideas that overlap or complement each other? Record any new ideas. Frame each idea as an action item – something you can actually do.
    2. Connect the action items to initiatives. It may be that not every action item becomes part of a key initiative. (Don’t lose ideas that aren’t part of key initiatives – track them in a separate burndown list or backlog.)
    3. Identify a target completion date and owner for each action item that’s part of an initiative.

    Add your results to your copy of the ITAM Strategy Template

    Example ITAM initiatives

    Initiative 1: Develop hardware/software standards
    Task Target Completion Owner
    Laptop standards Q1-2023 ITAM manager
    Identify/eliminate contracts for unused software using scan tool Q2-2023 ITAM manager
    Review O365 license levels and standard service Q3-2023 ITAM manager

    Initiative 2: Improve ITAM data quality
    Task Target Completion Owner
    Implement scan agent on all field laptops Q3-2023 Desktop engineer
    Conduct in person audit on identified data discrepancies Q1-2024 ITAM team
    Develop and run user-led audit Q1-2024 Asset manager

    Initiative 3: Acquire & implement a new ITAM tool
    Task Target Completion Owner
    Select an ITAM tool Q3-2023 ITAM manager
    Implement ITAM tool, incl. existing data migration Q1-2024 ITAM manager
    Training on new tool Q1-2024 ITAM manager
    Build KPIs, executive dashboards in new tool Q2-2024 Data analyst
    Develop user-led audit functionality in new tool Q3-2024 ITAM coordinator

    2.10 Create a communication plan

    45 minutes

    Input: Proposed ITAM initiatives, Stakeholder priorities and goals, and an understanding of how ITAM can help them meet those goals

    Output: A high-level communication plan to communicate the benefits and impact of proposed changes to the ITAM program

    Materials: The table in this slide, Your copy of the ITAM Strategy Template

    Participants: IT asset manager, Project sponsor

    Develop clear, consistent, and targeted messages to key ITAM stakeholders.

    1. Modify the list of stakeholders in the first column.
    2. What benefits should those stakeholders realize from ITAM? What impact may the proposed improvements have on them? Refer back to exercises from Phase 1, where you identified key stakeholders, their priorities, and how ITAM could help them.
    3. Identify communication channels (in-person, email, all-hands meeting, etc.) and timing – when you’ll distribute the message. You may choose to use more than one channel, and you may need to convey the message more than once.
    Group ITAM Benefits Impact Channel(s) Timing
    CFO
    • More accurate IT spend predictions
    • Better equipment utilization and value for money
    • Sponsor integration project between ITAM DB and financial system
    • Support procurement procedures review
    Face-to-face – based on their availability Within the next month
    CIO
    • Better oversight into IT spend
    • Data to help demonstrate IT value
    • Resources required to support tool and ITAM process improvements
    Standing bi-monthly 1:1 meetings Review strategy at next meeting
    IT Managers
    Field Techs

    Add your results to your copy of the ITAM Strategy Template

    2.10 Put the final touches on your ITAM Strategy

    30 minutes

    Input: Proposed ITAM initiatives, Stakeholder priorities and goals, and an understanding of how ITAM can help them meet those goals

    Output: A high-level communication plan to communicate the benefits and impact of proposed changes to the ITAM program

    Materials: The table in this slide, Your copy of the ITAM Strategy Template

    Participants: IT asset manager, Project sponsor

    You’re almost done! Do a final check of your work before you send a copy to your participants.

    1. Summarize in three points the key findings from the activities you’ve worked through. What have you learned? What are your priorities? What key message do you need to get across? Add these to the appropriate slide near the start of the ITAM Strategy Template.
    2. What are your immediate next steps? Summarize no more than five and add them to the appropriate slide near the start of the ITAM Strategy Template.
      1. Are you asking for something? Approval for ITAM initiatives? Funding? Resources? Clearly identify the ask as part of your next steps.
    3. Are the KPIs identified in Phase 1 still valid? Will they help you monitor for success in the initiatives you’ve identified in Phase 2? Make any adjustments you think are required to the KPIs to reflect the additional completed work.

    Add your results to your copy of the ITAM Strategy Template

    Research Contributors and Experts

    Kylie Fowler
    Principal Consultant
    ITAM Intelligence

    Kylie is an experienced ITAM/FinOps consultant with a track record of creating superior IT asset management frameworks that enable large companies to optimize IT costs while maintaining governance and control.

    She has operated as an independent consultant since 2009, enabling organizations including Sainsbury's and DirectLine Insurance to leverage the benefits of IT asset management and FinOps to achieve critical business objectives. Recent key projects include defining an end-to-end SAM strategy, target operating model, policies and processes which when implemented provided a 300% ROI.

    She is passionate about supporting businesses of all sizes to drive continuous improvement, reduce risk, and achieve return on investment through the development of creative asset management and FinOps solutions.

    Rory Canavan
    Owner and Principal Consultant
    SAM Charter

    Rory is the founder, owner, and principal consultant of SAM Charter, an internationally recognized consultancy in enterprise-wide Software & IT Asset Management. As an industry leader, SAM Charter is uniquely poised to ensure your IT & SAM systems are aligned to your business requirements.

    With a technical background in business and systems analysis, Rory has a wide range of first-hand experience advising numerous companies and organizations on the best practices and principles pertaining to software asset management. This experience has been gained in both military and civil organizations, including the Royal Navy, Compaq, HP, the Federation Against Software Theft (FAST), and several software vendors.

    Research Contributors and Experts

    Jeremy Boerger
    Founder, Boerger Consulting
    Author of Rethinking IT Asset Management

    Jeremy started his career in ITAM fighting the Y2K bug at the turn of the 21st century. Since then, he has helped companies in manufacturing, healthcare, banking, and service industries build and rehabilitate hardware and software asset management practices.

    These experiences prompted him to create the Pragmatic ITAM method, which directly addresses and permanently resolves the fundamental flaws in current ITAM and SAM implementations.

    In 2016, he founded Boerger Consulting, LLC to help business leaders and decision makers fully realize the promises a properly functioning ITAM can deliver. In his off time, you will find him in Cincinnati, Ohio, with his wife and family.

    Mike Austin
    Founder and CEO
    MetrixData 360

    Mike Austin leads the delivery team at MetrixData 360. Mike brings more than 15 years of Microsoft licensing experience to his clients’ projects. He assists companies, from Fortune 500 to organizations with as few as 500 employees, with negotiations of Microsoft Enterprise Agreements (EA), Premier Support Contracts, and Select Agreements. In addition to helping negotiate contracts, he helps clients build and implement software asset management processes.

    Previously, Mike was employed by Microsoft for more than 8 years as a member of the global sales team. With Microsoft, Mike successfully negotiated more than a billion dollars in new and renewal EAs. Mike has also negotiated legal terms and conditions for all software agreements, developed Microsoft’s best practices for global account management, and was awarded Microsoft’s Gold Star Award in 2003 and Circle of Excellence in 2008 for his contributions.

    Bibliography

    “Asset Management.” SFIA v8. Accessed 17 March 2022.

    Boerger, Jeremy. Rethinking IT Asset Management. Business Expert Press, 2021.

    Canavan, Rory. “C-Suite Cheat Sheet.” SAM Charter, 2021. Accessed 17 March 2022.

    Fisher, Matt. “Metrics to Measure SAM Success.” Snow Software, 26 May 2015. Accessed 17 March 2022.

    Flexera (2021). “State of ITAM Report.” Flexera, 2021. Accessed 17 March 2022.

    Fowler, Kylie. “ITAM by design.” BCS, The Chartered Institute for IT, 2017. Accessed 17 March 2022.

    Fowler, Kylie. “Ch-ch-ch-changes… Is It Time for an ITAM Transformation?” ITAM Intelligence, 2021. Web. Accessed 17 March 2022.

    Fowler, Kylie. “Do you really need an ITAM policy?” ITAM Accelerate, 15 Oct. 2021. Accessed 17 March 2022.

    Hayes, Chris. “How to establish a successful, long-term ITAM program.” Anglepoint, Sept. 2021. Accessed 17 March 2022.

    ISO/IEC 19770-1-2017. IT Asset Management Systems – Requirements. Third edition. ISO, Dec 2017.

    Joret, Stephane. “IT Asset Management: ITIL® 4 Practice Guide”. Axelos, 2020.

    Jouravlev, Roman. “IT Service Financial Management: ITIL® 4 Practice Guide”. Axelos, 2020.

    Pagnozzi, Maurice, Edwin Davis, Sam Raco. “ITAM Vs. ITSM: Why They Should Be Separate.” KPMG, 2020. Accessed 17 March 2022.

    Rumelt, Richard. Good Strategy, Bad Strategy. Profile Books, 2013.

    Stone, Michael et al. “NIST SP 1800-5 IT Asset Management.” Sept, 2018. Accessed 17 March 2022.

    Build a Zero Trust Roadmap

    • Buy Link or Shortcode: {j2store}253|cart{/j2store}
    • member rating overall impact: 9.3/10 Overall Impact
    • member rating average dollars saved: $48,932 Average $ Saved
    • member rating average days saved: 42 Average Days Saved
    • Parent Category Name: Security Strategy & Budgeting
    • Parent Category Link: /security-strategy-and-budgeting
    • Many IT and security leaders struggle to understand zero trust and how best to deploy it with their existing IT resources.
    • The need to move from a perimeter-based approach to security toward an “Always Verify” approach is clear. The path to getting there is complex and expensive.
    • Zero trust as a principle is a moving target due to competing definitions and standards. A strategy that adapts evolving best practices must be supported by business stakeholders.
    • Full zero trust includes many components. Performing an accurate assessment of readiness and benefits to adopt zero trust can be extremely difficult when you don’t know where to start.

    Our Advice

    Critical Insight

    Apply zero trust to key protect surfaces. A successful zero trust strategy should evolve through an iterative and repeatable process by assessing the full spectrum of available technologies to apply zero trust principles to the most relevant protect surfaces.

    Impact and Result

    Every organization should have a zero trust strategy and the roadmap to deploy it must always be tested and refined. Our unique approach:

    • Assess resources and determine zero trust readiness.
    • Prioritize initiatives and build out roadmap.
    • Deploy zero trust and monitor with zero trust progress metrics.

    Build a Zero Trust Roadmap Research & Tools

    Besides the small introduction, subscribers and consulting clients within this management domain have access to:

    1. Build a Zero Trust Roadmap Deck – The purpose of the storyboard is to provide a detailed description of the steps involving in building a roadmap for implementing zero trust.

    The storyboard contains five easy-to-follow steps on building a roadmap for implementing zero trust, from aligning initiatives to business goals to establishing metrics for measuring the progress and effectiveness of a zero trust implementation.

    • Build a Zero Trust Roadmap – Phases 1-5

    2. Zero Trust Protect Surface Mapping Tool – A tool to identify key protect surfaces and map them to business goals.

    Use this tool to develop your zero trust strategy by having it focus on key protect surfaces that are aligned to the goals of the business.

    • Zero Trust Protect Surface Mapping Tool

    3. Zero Trust Program Gap Analysis Tool – A tool to perform a gap analysis between the organization's current implementation of zero trust controls and its desired target state and to build a roadmap to achieve the target state.

    Use this tool to develop your zero trust strategy by creating a roadmap that is aligned with the current state of the organization when it comes to zero trust and its desired target state.

    • Zero Trust Program Gap Analysis Tool

    4. Zero Trust Candidate Solutions Selection Tool – A tool to identify and evaluate solutions for identified zero trust initiatives.

    Use this tool to develop your zero trust strategy by identifying the best solutions for zero trust initiatives.

    • Zero Trust Candidate Solutions Selection Tool

    5. Zero Trust Progress Monitoring Tool – A tool to identify metrics to measure the progress and efficiency of the zero trust implementation.

    Use this tool to develop your zero trust strategy by identifying metrics that will allow the organization to monitor how the zero trust implementation is progressing, and whether it is proving to be effective.

    • Zero Trust Progress Monitoring Tool

    6. Zero Trust Communication Deck – A template to present the zero trust template to key stakeholders.

    Use this template to present the zero trust strategy and roadmap to ensure all key elements are captured.

    • Zero Trust Communication Deck

    Infographic

    Workshop: Build a Zero Trust Roadmap

    Workshops offer an easy way to accelerate your project. If you are unable to do the project yourself, and a Guided Implementation isn't enough, we offer low-cost delivery of our project workshops. We take you through every phase of your project and ensure that you have a roadmap in place to complete your project successfully.

    1 Define Business Goals and Protect Surfaces

    The Purpose

    Align business goals to protect surfaces.

    Key Benefits Achieved

    A better understanding of how business goals can map to key protect surfaces and their associated DAAS elements.

    Activities

    1.1 Understand business and IT strategy and plans.

    1.2 Define business goals.

    1.3 Identify five critical protect surfaces and their associated DAAS elements.

    1.4 Map business goals and protect surfaces.

    Outputs

    Mapping of business goals to key protect surfaces and their associated DAAS elements.

    2 Begin Gap Analysis

    The Purpose

    Identify and define zero trust initiatives.

    Key Benefits Achieved

    A list of zero trust initiatives to be prioritized and set into a roadmap.

    Activities

    2.1 Assess current security capabilities and define the zero trust target state for a set of controls.

    2.2 Identify tasks to close maturity gaps.

    2.3 Assign tasks to zero trust initiatives.

    Outputs

    Security capabilities current state assessment

    Zero trust target state

    Tasks to address maturity gaps

    3 Complete Gap Analysis

    The Purpose

    Complete the zero trust gap analysis and prioritize zero trust initiatives.

    Key Benefits Achieved

    A prioritized list of zero trust initiatives aligned to business goals and key protect surfaces.

    Activities

    3.1 Align initiatives to business goals and key protect surfaces.

    3.2 Conduct cost/benefit analysis on zero trust initiatives.

    3.3 Prioritize initiatives.

    Outputs

    Zero trust initiative list mapped to business goals and key protect surfaces

    Prioritization of zero trust initiatives

    4 Finalize Roadmap and Formulate Policies

    The Purpose

    Finalize the zero trust roadmap and begin to formulate zero trust policies for roadmap initiatives.

    Key Benefits Achieved

    A zero trust roadmap of prioritized initiatives.

    Activities

    4.1 Define solution criteria.

    4.2 Identify candidate solutions.

    4.3 Evaluate candidate solutions.

    4.4 Finalize roadmap.

    4.5 Formulate policies for critical DAAS elements.

    4.6 Establish metrics for high-priority initiatives.

    Outputs

    Zero trust roadmap

    Zero trust policies for critical protect surfaces

    Method for defining zero trust policies for candidate solutions

    Metrics for high-priority initiatives

    Further reading

    Build a Zero Trust Roadmap

    Leverage an iterative and repeatable process to apply zero trust to your organization.

    EXECUTIVE BRIEF

    Analyst Perspective

    Internet is the new corporate network.

    For the longest time we have focused on reducing the attack surface to deter malicious actors from attacking organizations, but I dare say that has made these actors scream “challenge accepted.” With sophisticated tools, time, and money in their hands, they have embarrassed even the finest of organizations. A popular hybrid workforce and rapid cloud adoption have introduced more challenges for organizations, as the security and network perimeter have shifted and the internet is now the corporate network. Suffice it to say that a new mindset needs to be adopted to stay on top of the game.

    The success of most attacks is tied to denial of service, data exfiltration, and ransom. A shift from focusing on the attack surface to the protect surface will help organizations implement an inside-out architecture that protects critical infrastructure, prevents the success of any attack, makes it difficult to gain access, and links directly to business goals.

    Zero trust principles aid that shift across several pillars (Identity, Device, Application, Network, and Data) that make up a typical infrastructure; hence, the need for a zero trust roadmap to accomplish that which we desire for our organization.

    Victor Okorie
    Senior Research Analyst, Security and Privacy
    Info-Tech Research Group

    Executive Summary

    Your Challenge

    • Many IT and security leaders struggle to understand zero trust and how best to deploy it with their existing IT resources.
    • The need to move from a perimeter-based approach to security toward an “Always Verify” approach is clear. The path to getting there is complex and expensive.

    Common Obstacles

    • Zero trust as a principle is a moving target due to competing definitions and standards. A strategy that adapts evolving best practices must be supported by business stakeholders.
    • Full zero trust includes many components. Performing an accurate assessment of readiness and benefits to adopt zero trust can be extremely difficult when you don’t know where to start.

    Info-Tech’s Approach

    • Every organization should have a zero trust strategy and the roadmap to deploy it must always be tested and refined.
    • Our unique approach:
      • Assess resources and determine zero trust readiness.
      • Address barriers and identify enablers.
      • Prioritize initiatives and build out roadmap.
      • Identify most appropriate vendors via vendor selection framework.
      • Deploy zero trust and monitor with zero trust progress metrics.

    Info-Tech Insight

    A successful zero trust strategy should evolve through an iterative and repeatable process by assessing the full spectrum of available technologies to apply zero trust principles to the most relevant protect surfaces.

    Your challenge

    This research is designed to help organizations:

    • Understand what zero trust is and decide how best to deploy it with their existing IT resources. Zero trust is a set of principles that defaults to the highest level of security; a failed implementation can easily disrupt the business. A pragmatic zero trust implementation must be flexible and adaptable yet maintain a consistent level of protection.
    • Move from a perimeter-based approach to security toward an “Always Verify” approach. The path to getting there is complex without a clear understanding of desired outcomes. Focusing efforts on key protection gaps and leveraging capable controls in existing architecture allows for a repeatable process that carries IT, security, and the business along on the journey.

    On this zero trust journey, identify your valuable assets and zero trust controls to protect them.

    Top three reasons for building a zero trust strategy

    44%

    Reduce attacker’s ability to move laterally

    44%

    Enforce least privilege access to critical resources

    41%

    Reduce enterprise attack surface

    Common obstacles

    These barriers make this challenge difficult to address for many organizations:

    • Due to zero trust’s many components, performing an accurate assessment of readiness and benefits to adopt zero trust can be extremely difficult when you don’t know where to start.
      • To feel ready to implement and to understand the benefits of zero trust, IT must first understand what zero trust means to the organization.
    • Zero trust as a set of principles is a moving target, with many developing standards and competing technology definitions. A strategy built around evolving best practices must be supported by related business stakeholders.
      • To ensure support, IT must be able to “sell” zero trust to business stakeholders by illustrating the value zero trust can bring to business objectives.

    43%

    Organizations with a full implementation of zero trust saved 43% on the costs of data breaches.
    (Source: Teramind, 2021)

    96%

    Zero trust is considered key to the success of 96% of organizations in a survey conducted by Microsoft.
    (Source: Microsoft, 2021)

    What is zero trust?

    It depends on who you ask…

    • Vendors use zero trust as a marketing buzzword.
    • Organizations try to comprehend zero trust in their own limited views.
    • Zero trust regulations/standards are still developing.

    “A cybersecurity paradigm focused on resource protection and the premise that trust is never granted implicitly but must be continually evaluated.”

    Source: NIST, SP 800-207: Zero Trust Architecture, 2020

    “An evolving set of cybersecurity paradigms that move defenses from static, network-based perimeters to focus on users, assets, and resources.”

    Source: DOD, Zero Trust Reference Architecture, 2021

    “A security model, a set of system design principles, and a coordinated cybersecurity and system management strategy based on an acknowledgement that threats exist both inside and outside traditional network boundaries.”

    Source: NSA, Embracing a Zero Trust Security Model, 2021

    “Zero trust provides a collection of concepts and ideas designed to minimize uncertainty in enforcing accurate, least privilege per-request access decisions in information systems and services in the face of a network viewed as compromised.”

    Source: CISA, Zero Trust Maturity Model, 2021

    “The foundational tenet of the zero trust model is that no actor, system, network, or service operating outside or within the security perimeter is trusted.”

    Source: OMB, Moving the U.S. Government Toward Zero Trust Cybersecurity Principles, 2022

    What is zero trust?

    From Theoretical to Practical

    Zero trust is an ideal in the literal sense of the word, because it is a standard defined by its perfection. Just as nothing in life is perfect, there is no measure that determines an organization is absolutely zero trust. The best organizations can do is improve their security iteratively and get as close to ideal as possible.

    In the most current application of zero trust in the enterprise, a zero trust strategy applies a set of principles, including least-privilege access and per-request access enforcement, to minimize compromise to critical assets. A zero trust roadmap is a plan that leverages zero trust concepts, considers relationships between technical elements as well as security solutions, and applies consistent access policies to minimize areas of exposure.

    Zero Trust; Identity; Workloads & Applications; Network; Devices; Data

    Info-Tech Insight

    Solutions offering zero trust often align with one of five pillars. A successful zero trust implementation may involve a combination of solutions, each protecting the various data, application, assets, and/or services elements in the protect surface.

    Zero trust business benefits

    Reduce business and organizational risk

    Reduced business risks as continuous verification of identity, devices, network, applications, and data is embedded in the organizations practice.

    36% of data breaches involved internal actors.
    Source: Verizon, 2021

    Reduce CapEx and OpEx

    Reduced CapEx and OpEx due to the scalability, low staffing requirement, and improved time-to-respond to threats.
    Source: SecurityBrief - Australia, 2020.

    Reduce scope and cost of compliance

    Helps achieve compliance with several privacy standards and regulations, improves maturity for cyber insurance premium, and fewer gaps during audits.

    Scope of compliance reduced due to segmentation.

    Reduce risk of data breach

    Reduced risk of data breach in any instance of a malicious attack as there’s no lateral movement, secure segment, and improved visibility.

    10% Increase in data breach costs; costs went from $3.86 million to $4.24 million.
    Source: IBM, 2021

    This is an image of a thought map detailing Info-Tech's Build A Zero Trust Roadmap.  The main headings are: Define; Design; Develop; Monitor

    Info-Tech’s methodology for Building a Zero Trust Roadmap

    1. Define Business Goals and Protect Surfaces

    2. Assess Key Capabilities and Identify Zero Trust Initiatives

    3. Evaluate Candidate Solutions and Finalize Roadmap

    4. Formulate Policies for Roadmap Initiatives

    5. Monitor the Zero Trust Roadmap Deployment

    Phase Steps

    Define business goals

    Identify critical DAAS elements

    Map business goals to critical DAAS elements

    1. Review the Info-Tech framework
    2. Assess current capabilities and define the zero trust target state
    3. Identify tasks to close gaps
    4. Define tasks and initiatives
    5. Align initiatives to business goals and protect surfaces
    1. Define solution criteria
    2. Identify candidate solutions
    3. Evaluate candidate solutions
    4. Perform cost/benefit analysis
    5. Prioritize initiatives
    6. Finalize roadmap
    1. Formulate policies for critical DAAS elements
    2. Formulate policies to secure a path to access critical DAAS elements
    1. Establish metrics for roadmap tasks
    2. Track and report metrics
    3. Build a communication deck

    Phase Outcomes

    Mapping of business goals to protect surfaces

    Gap analysis of security capabilities

    Evaluation of candidate solutions and a roadmap to close gaps

    Method for defining zero trust policies for candidate solutions

    Metrics for measuring the progress and efficiency of the zero trust implementation

    Protect what is relevant

    Apply zero trust to key protect surfaces

    A successful zero trust strategy should evolve through an iterative and repeatable process by assessing the full spectrum of available technologies to apply zero trust principles to the most relevant protect surfaces.

    Align protect surfaces to business objectives

    Developing a zero trust roadmap collaboratively with business stakeholders enables alignment with upcoming business priorities and industry trends.

    Identify zero trust capabilities

    Deriving protect surface elements from business goals reframes how security controls are applied. Assess control effectiveness in this context and identify zero trust capabilities to close any gaps.

    Roadmap first, not solution first

    Don’t let your solution dictate your roadmap. Define your zero trust solution criteria before engaging in vendor selection.

    Create enforceable policies

    The success of a zero trust implementation relies on consistent enforcement. Applying the Kipling methodology to each protect surface is the best way to design zero trust policies.

    Success should benefit the organization

    To measure the efficacy of a zero trust implementation, ensure you know what a successful zero trust implementation means for your organization, and define metrics that demonstrate whether that success is being realized.

    Blueprint deliverables

    Each step of this blueprint is accompanied by supporting deliverables to help you accomplish your goals:

    Key deliverable:

    Zero Trust Communication Deck

    Present your zero trust strategy in a prepopulated document that summarizes the work you have completed as a part of this blueprint.

    Zero Trust Protect Surface Mapping Tool

    Identify critical and vulnerable DAAS elements to protect and align them to business goals.

    Zero Trust Program Gap Analysis Tool

    Perform a gap analysis between current and target states to build a zero trust roadmap.

    Zero Trust Candidate Solutions Selection Tool

    Determine and evaluate candidate solutions based on defined criteria.

    Zero Trust Progress Monitoring Tool

    Develop metrics to track the progress and efficiency of the organization’s zero trust implementation.

    Blueprint benefits

    IT Benefits

    • A mapped transaction flow of critical and vulnerable assets and visibility of where to implement security controls that aligns with the principle of zero trust.
    • Improved security posture across the digital attack surface while focusing on the protect surface.
    • An inside-out architecture that leverages current existing architecture to tighten security controls, is automated, and gives granular visibility.

    Business Benefits

    • Reduced business risks as continuous verification of identity, devices, network, applications, and data is embedded in the organization’s practice.
    • Reduced CapEx and OpEx due to the scalability, low staffing requirement, and improved time-to-respond to threats.
    • Helps achieve compliance with several privacy standards and regulations, improves maturity for cyber insurance premium, and fewer gaps during audits.
    • Reduced risk of data breach in any instance of a malicious attack.

    Measure the value of this blueprint

    Save an average of $1.76 million dollars in the event of a data breach

    • This research set seeks to help organizations develop a mature zero trust implementation which, according to IBM’s “Cost of a Data Breach 2021 Report,” saves organizations an average of $1.76 million in the event of a data breach.
    • Leverage phase 5 of this research to develop metrics to track the implementation progress and efficacy of zero trust tasks.

    43%

    Organizations with a mature implementation of zero trust saved 43%, or $1.76 million, on the costs of data breaches.
    Source: IBM, 2021

    In phase 2 of this blueprint, we will help you establish zero trust implementation tasks for your organization.

    In phase 3, we will help you develop a game plan and a roadmap for implementing those tasks.

    This image contains a screenshot info-tech's methodology for building a zero-trust roadmap, discussed earlier in this blueprint

    Executive Brief Case Study

    National Aeronautics and Space Administration (NASA)

    INDUSTRY: Government

    SOURCE: Zero Trust Architecture Technical Exchange Meeting

    NASA recognized the potential benefits of both adopting a zero trust architecture (including aligning with OMB FISMA and DHS CDM DEFEND) and improving NASA systems, especially those related to user experience with dynamic access, application security with sole access from proxy, and risk-based asset management with trust score. The trust score is continually evaluated from a combination of static factors, such as credential and biometrics, and dynamic factors, such as location and behavior analytics, to determine the level of access. The enhanced access mechanism is projected on use-case flows of users and external partners to analyze the required initiatives.

    The lessons learned in adapting zero trust were:

    • Focus on access to data, assets, applications, and services; and don’t select solutions or vendors too early.
    • Provide support for mobile and external partners.
    • Complete zero trust infrastructure and services design with holistic risk-based management, including network access control with software-defined networking and an identity management program.
    • Develop a zero trust strategy that aligns with mission objectives.

    Results

    NASA implemented zero trust architecture by leveraging the agency existing components on a roadmap with phases related to maturity. The initial development includes privileged access management, security user behavior analytics, and a proof-of-concept lab for evaluating the technologies.
    Case Study Source: NASA, “Planning for a Zero Trust Architecture Target State,” 2019

    Info-Tech offers various levels of support to best suit your needs

    DIY Toolkit

    “Our team has already made this critical project a priority, and we have the time and capability, but some guidance along the way would be helpful.”

    Guided Implementation

    “Our team knows that we need to fix a process, but we need assistance to determine where to focus. Some check-ins along the way would help keep us on track.”

    Workshop

    “We need to hit the ground running and get this project kicked off immediately. Our team has the ability to take this over once we get a framework and strategy in place.”

    Consulting

    “Our team does not have the time or the knowledge to take this project on. We need assistance through the entirety of this project.”

    Diagnostics and consistent frameworks used throughout all four options

    Guided Implementation

    What does a typical GI on this topic look like?

    Phase 1 Phase 2 Phase 3 Phase 4 Phase 5
    Call #1:
    Scope requirements, objectives, and your specific challenges.

    Call #3:
    Define current security capabilities and zero trust target state.

    Call #5:

    Identify and evaluate solution criteria.

    Call #7:
    Create a process for formulating zero trust policies.

    Call #8:
    Establish metrics for assessing the implementation and effectiveness of zero trust.

    Call #2:
    Identify business goals and protect surfaces.

    Call #4:
    Identify gap-closing tasks and assign to zero trust initiatives.

    Call #6:
    Prioritize zero trust initiatives.

    A Guided Implementation (GI) is a series of calls with an Info-Tech analyst to help implement our best practices in your organization.
    A typical GI is between 8 to 12 calls over the course of 2 to 4 months.

    Workshop Overview

    Contact your account representative for more information.workshops@infotech.com 1-888-670-8889

    Day 1 Day 2 Day 3 Day 4 Day 5

    Define Business Goals and Protect Surfaces

    Begin Gap Analysis

    Complete Gap Analysis

    Finalize Roadmap and Formulate Policies

    Next Steps and
    Wrap-Up (offsite)

    Activities

    1.1 Understand business and IT strategy and plans.

    1.2 Define business goals.

    1.3 Identify five critical protect surfaces and their associated DAAS elements.

    1.4 Map business goals and protect surfaces.

    2.1 Assess current security capabilities and define the zero Trust target state for a set of controls.

    2.2 Identify tasks to close maturity gaps.

    2.3 Assign tasks to zero trust initiatives.

    3.1 Align initiatives to business goals and key protect surfaces.

    3.2 Conduct cost/benefit analysis on zero trust initiatives.

    3.3 Prioritize initiatives.

    4.1 Define solution criteria.

    4.2 Identify candidate solutions.

    4.3 Evaluate candidate solutions.

    4.4 Finalize roadmap.

    4.5 Formulate policies for critical DAAS elements.

    4.6 Establish metrics for high-priority initiatives.

    5.1 Complete in-progress deliverables from previous four days.

    5.2 Set up review time for workshop deliverables and to discuss next steps.

    Deliverables
    1. 1.Mapping of business goals to key protect surfaces and their associated DAAS elements
    1. Security capabilities current state assessment
    2. Zero trust target state
    3. Tasks to address maturity gaps
    1. Zero trust initiative list mapped to business goals and key protect surfaces
    2. Prioritization of zero trust initiatives
    1. Zero trust roadmap
    2. Zero trust policies for critical protect surfaces
    3. Method for defining zero trust policies for candidate solutions
    4. Metrics for high-priority initiatives
    1. Zero trust roadmap documentation
    2. Mapping of Info-Tech resources against individual initiatives

    Phase 1

    Define Business Objectives and Protect Surfaces

    Build a Zero Trust Roadmap

    This phase will walk you through the following activities:

    • Identify and define the business goals.
    • Identify the critical DAAS elements and protect surface.
    • Align the business goals to the protect surface and critical DAAS elements.

    This phase involves the following participants:

    • Security Team
    • Business Executives
    • Subject Matter Experts From IT, Finance, HR, Legal, Facilities, Compliance, Audit, Risk Management

    Analyze your business goals

    Identifying business goals is the first step in aligning your zero trust roadmap with your business’ vision.

    • Security leaders need to understand the direction the business is headed in.
    • Wise security investments depend on aligning your security initiatives to business objectives.
    • Zero trust, and information security at large, should contribute to your organization’s business objectives by supporting operational performance, ensuring brand protection and shareholder value.
      • For example, if the organization is working on a new business initiative that requires the handling of credit card payments, the security organization needs to know as soon as possible to ensure the zero trust architecture will be extended to protect the PCI data and enable the organization to be PCI compliant.

      Info-Tech Insight

      Security and the business need to be in alignment when implementing zero trust. Defining the business goal helps rationalize the need for a zero trust implementation.

    1.1 Define your organization’s business goals

    Estimated time 1-3 hours

    1. As a group, brainstorm the business goals of the organization.
    2. Review relevant business and IT strategies.
    3. Review the business goal definitions in tab “2. Business Objectives” of the Zero Trust Protect Surface Mapping Tool, including the key goal indicator metrics.
    4. Record the most important business goals in the Business Goal column on tab “3. Protect Surfaces” of the Zero Trust Protect Surface Mapping Tool. Try to limit the number of business goals to no more than five primary goals. This limitation will be critical to help map the protect surface and the zero trust roadmap later.

    Input

    • Business and IT strategies

    Output

    • Prioritized list of business objectives

    Materials

    • Whiteboard/Flip Charts
    • Zero Trust Protect Surface Mapping Tool

    Participants

    • Security Team
    • IT Leadership
    • Business Stakeholders
    • Risk Management
    • Compliance
    • Legal

    Download the Zero Trust Protect Surface Mapping Tool

    Info-Tech Insight

    Developing a zero trust roadmap collaboratively with business stakeholders enables alignment with upcoming business priorities and industry trends.

    What does zero trust mean for you?

    For a successful implementation, focus on your zero trust outcome.

    This image describes the Who, What, When, Where, Why, and How for Zero Trust.

    Regardless of whether the user is accessing resources internally or externally, zero trust is posed to authenticate, authorize, and continuously verify the security policies and posture before access is granted or denied. Many network architecture can be local, cloud based, or hybrid and with users working from any location, there is no network perimeter as we knew it and the internet is now the corporate network.

    Zero trust framework seeks to extend the perimeter-less security to the present digital transformation.

    Understand protect surface

    Data, Application, Asset, and Services

    A protect surface can be described as what’s critical, most vulnerable, or most valuable to your organization. This protect surface could include at least one of the following – data, assets, applications, and services (DAAS) – that requires protection. This is also the area that zero trust policy is aimed to protect. Understanding what your protect surface is can help channel the required energy into protecting that which is crucial to the business, and this aligns with the shift from focusing on the attack surface to narrowing it down to a smaller and achievable area of protection.

    Anything and everything that connects to the internet is a potential attack surface and pursuing every loophole will leave us one step behind due to lack of resources. Since a protect surface contains one or more DAAS element, the micro-perimeter is created around it and the appropriate protection is applied around it. As a team, we can ask ourselves this question when thinking of our protect surface: to what degree does my organization want me to secure things? The knowledge of the answer to this question can be tied to the risk tolerance level of the organization and it is only fair for us to engage the business in identifying what the protect surface should be.

    Components of a protect surface

    • Data
    • Application
    • Asset
    • Services

    Info-Tech Insight

    The protect surface is a shift from focusing on the attack surface. DAAS elements show where the initiatives and controls associated with the zero trust pillars (Identity, Devices, Network, Application, and Data) need to be applied.

    Sample Scenario

    INDUSTRY: Healthcare

    SOURCE: Info-Tech Research Group

    Illustration

    A healthcare provider would consider personal health information a critical resource worthy of being protected against data exfiltration due to a host of reasons including but not limited to privacy regulations, loss of revenue, legal, and reputational loss; hence, this would be considered a protect surface.

    • What is the data that can’t be risked exfiltrated?
    • What application(s) is used to access this data?
    • What assets are used to generate and store the data?
    • What are the services we rely on to be able to access the data?

    DAAS Element

    • The data here is the patient information.
    • The application used to access the personal health information would be EPIC, OR list, and any other application used in that organization.
    • The assets used to store the data and generate the PHI would include physical workstations, medical scanners, etc.
    • The services that can be exploited to disrupt the operation or used to access the data would include active directory, single sign-on, etc.

    DAAS and Zero Trust Pillar

    This granular identification provides an opportunity to not only see what the protect surface and DAAS elements are but also understand where to apply security controls that align with the principle of zero trust as well as how the transaction flows. The application pillar initiatives will provide protection to the EPIC application and the device pillar initiatives will provide protection to the workstations and physical scanners. The identity pillar initiatives will apply protection to the active directory, and single sign-on services. The zero trust pillar initiatives align with the protection of the DAAS elements.

    Shift from attack surface to protect surface

    This image contains a screenshot of the thought map: Shift from attack surface to protect surface.  Go from complex to a micro perimeter approach.

    Info-Tech Insight

    The protect surface is a shift from focusing on the attack surface as it creates a micro-perimeter for the application of zero trust policies on the system. This drastically reduces the success of an attack whether internally or externally, reduces the attack surface, and is also repeatable.

    1.2 Identify critical DAAS elements

    Estimated time 1-3 hours

    1. As a group, brainstorm and identify critical, valuable, sensitive assets or resources requiring high availability in the organization. Each DAAS element is part of a protect surface, or sometimes, the DAAS element itself is a protect surface.
    • Data – The sensitive data that poses the greatest risk if exfiltrated or misused. What data needs to be protected?
    • Applications – The applications that use sensitive data or control critical assets. Which applications are critical for your business functions?
    • Assets – Physical or virtual assets, including an organization’s information technology (IT), operational technology (OT), or Internet of Things devices.
    • Services – The services an organization most depends on. Services that can be exploited to disrupt normal IT or business operations.
  • Record the critical DAAS elements and protect surface in their respective columns of the Zero Trust Protect Surface Mapping Tool. Try to limit the number of business goals to no more than five primary protect surfaces to match with the business goals.
  • Download the Zero Trust Protect Surface Mapping Tool

    Input

    • Critical resources to protect
    • Understanding of how they interoperate or connect

    Output

    • Protect surfaces

    Materials

    • Whiteboard/Flip Charts
    • Zero Trust Protect Surface Mapping Tool

    Participants

    • Security Team
    • IT Leadership
    • Business Stakeholders

    1.3 Map business goals to critical DAAS elements

    Estimated time 1-2 hours

    1. The protect surface will be generated from the critical DAAS elements as a standalone protect surface or a group of interconnected DAAS elements merged into one.
    • Each protect surface can be tied back to a business objective.
  • Select from the drop-down list of business objectives the option that fits the identified protect surface as it relates to the organization.
    • Type in your business objectives if the drop-down list does not apply.

    Download the Zero Trust Protect Surface Mapping Tool

    This image contains a screenshot from the Zero Trust Protect Surface Mapping Tool, with the following columns highlighted: Business Goal Name; Protect Surface Name

    Phase 2

    Assess Key Capabilities and Identify Zero Trust Initiatives

    Build a Zero Trust Roadmap

    This phase will walk you through the following activities:

    • Assess the organization’s current capabilities.
    • Define the zero trust target state.
    • Identify tasks to close gaps
    • Define zero trust initiatives and align zero trust initiatives to business goals and protect surfaces.

    This phase involves the following participants:

    • Security Team
    • Subject Matter Experts From IT, Finance, HR, Legal, Facilities, Compliance, Audit, Risk Management
    • Project Management Office

    The Info-Tech Zero Trust Framework

    Info-Tech’s Zero Trust Framework aligns with zero trust references, including:

    • ACT Zero Trust Cybersecurity Current Trends. 2019
    • NIST SP 800-207: Zero Trust Architecture. 2020
    • DOD Zero Trust Reference Architecture. 2021
    • NSA Embracing a Zero Trust Security Model. 2021
    • CISA Zero Trust Maturity Model. 2021
    • Executive Order (EO) 14028: Improving the Nation’s Cybersecurity, The White House. 2021
    • OMB Moving the U.S. Government Toward Zero Trust Cybersecurity Principles. 2022
    • NSTAC Zero Trust and Trusted Identity Management. 2022
    • NIST SP 800-53 r5: Security and Privacy Controls for Information Systems and Organizations

    Identity

    • Authentication
    • Authorization
    • Privileged Access Management

    Applications

    • Software Defined Compute
    • DevSecOps
    • Software Supply Chain

    Devices

    • Authentication
    • Authorization
    • Compliance

    Networks

    • Software Defined Networking
    • Macro Segmentations
    • Micro Segmentation

    Data

    • Software Defined Storage
    • Data Loss Prevention
    • Data Rights Management

    Info-Tech Insight

    A best-of-breed approach ensures holistic coverage of your zero trust program while refraining from locking you into a specific reference.

    2.1 Review the Info-Tech framework

    Estimated time 30-60 minutes

    1. As a group, have the team review the framework within the Zero Trust Program Gap Analysis Tool.
    2. Customize the tool as required using the instructions in tab “2. Setup”:
    • Define costing criteria
    • Define benefits criteria
    • Configure full-time equivalent hours and start year
    • Input business goals as mapped to protect surfaces (see next slide)

    Download the Zero Trust Program Gap Analysis Tool

    Input

    • Protect surfaces mapped to business objectives

    Output

    • Customized framework

    Materials

    • Zero Trust Program Gap Analysis Tool

    Participants

    • Security Team
    • Subject Matter Experts From IT

    2.1.1 Input business goals as mapped to protect surfaces

    Refer to the Protect Surface Mapping Tool, copy the following elements from the Protect Surface tab.

    1. Enter Business Goals.
    2. Enter Protect Surfaces.
    3. Enter Data.
    4. Enter Application.
    5. Enter Assets.
    6. Enter Services.

    This image contains a screenshot from Info-Tech's Zero Trust Program Gap Analysis Tool.  The Column headings are labeled as follows: 1: Business Goal Name; 2: Protect Surface; 3: DATA; 4: APPLICATION; 5: ASSETS; 6: SERVICES

    Info-Tech Insight

    Deriving protect surface elements from business goals reframes how security controls are applied. Assess control effectiveness in this context and identify zero trust capabilities to close any gaps.

    2.2 Assess current capabilities and define zero trust target state

    Estimated time 6-12 hours

    1. Using the Zero Trust Program Gap Analysis Tool, review each of the controls in the Gap Analysis tab.
    2. Follow the instructions on the next slides to complete your current-state and target-state assessment.
    3. For most organizations, multiple internal subject matter experts will need to be consulted to complete the assessment.

    Download the Zero Trust Program Gap Analysis Tool

    Input

    • Protect surfaces mapped to business objectives
    • Information on current state of controls, including sources such as audit findings, vulnerability and penetration test results, and risk registers

    Output

    • Current-state and target-state assessment for gap analysis

    Materials

    • Zero Trust Program Gap Analysis Tool

    Participants

    • Security Team
    • Subject Matter Experts From IT, Facilities, Audit, Risk Management

    Understanding security target states

    Maturity models are very effective for determining target states. This table provides general descriptions for each maturity level. As a group, consider which description most accurately reflects the ideal target state in your organization.

    AD HOC 01

    Initial/ad hoc security programs are reactive. Lacking strategic vision, these programs are less effective and less responsive to the needs of the business.

    DEVELOPING 02

    Developing security programs can be effective at what they do but are not holistic. Governance is largely absent. These programs tend to rely on the talents of individuals rather than a cohesive plan.

    DEFINED 03

    A defined security program is holistic, documented, and proactive. At least some governance is in place; however, metrics are often rudimentary and operational in nature. These programs still often rely on best practices rather than strong risk management.

    MANAGED 04

    Managed security programs have robust governance and metrics processes. Management and board-level metrics for the overall program are produced. These are reviewed by business leaders and drive security decisions. More mature risk management practices take the place of best practices.

    OPTIMIZED 05

    An optimized security program is based on strong risk management practices, including the production of key risk indicators (KRIs). Individual security services are optimized using key performance indicators (KPIs) that continually measure service effectiveness and efficiency.

    2.2.1 Conduct current-state assessment

    1. Carefully review each of the controls in the Gap Analysis tab that are needed for the protect surfaces. For each control, indicate the current maturity level of the organization. The tool uses the maturity levels of the CMMI model to score maturity.
    • Only use “N/A” if you are confident that the control is not required in your protect surfaces. For example, if the protect surfaces do not require or use software-defined computing, select “N/A” for any controls related to software-defined computing.
  • Provide comments to describe your current state. This step is optional but recommended as it may be important to record this information for future reference.
  • Select the target maturity for the control.
  • This image contains a screenshot from Info-Tech's Zero Trust Program Gap Analysis Tool, with the following column headings highlighted and numbered: 1: Current Maturity; 2: Current State Comments (optional); Target Maturity

    Make sure that the gap between target state and current state is achievable for the current zero trust roadmap. For instance, if you set your current maturity to 1 – Ad Hoc, then having a target maturity of 4 – Managed or 5 – Optimized is not recommended due to the big jump.

    2.2.2 Review the Gap Analysis Dashboard

    1. Use the Dashboard to map your progress on assessing current- and future-state maturities. As you fill out the Zero Trust Program Gap Analysis Tool, check with the Dashboard to see the difference between your current and target state.
    2. Use the color-coded legend to see the size of the gap between your current and target state.
    3. Zero trust processes that appear white have not yet been assessed or are rated as “N/A.”
    this image contains a screenshot of Info-tech's Zero-Trust framework discussed earlier in this blueprint, with the addition of a legend demonstrating how to use the gap analysis tool to identify the size of the gap between current and target states

    2.3 Identify tasks to close gaps

    Estimated time 5 hours

    1. Using the Zero Trust Program Gap Analysis Tool, review each of the controls in the Gap Analysis tab.
    2. Follow the instructions on the next slides to identify gap closure tasks for each control that requires improvement.
    3. For most organizations, multiple internal subject matter experts will need to be consulted to complete the assessment.

    Download the Zero Trust Program Gap Analysis Tool

    Input

    • Zero trust controls gap information

    Output

    • Gap closure task list

    Materials

    • Zero Trust Program Gap Analysis Tool

    Participants

    • Security Team
    • Subject Matter Experts From IT, Facilities, Audit, Risk Management

    2.3 Identify tasks to close gaps (cont.)

    1. For each of the controls where there is a gap between the current and target state, a gap closure task should be identified:
    • Review the example tasks and copy one or more of them if appropriate. Otherwise, enter your own gap closure task.
  • Considerations for identifying gap closure tasks:
    • In small groups, have participants ask, “what would we have to do to achieve the target state?” Document these in the Gap Closure Tasks column.
    • The example gap closure tasks may be appropriate for your organization, but do not simply copy them without considering whether they are right for you.
    • Not all gaps require their own task. You can enter one task that may address multiple gaps.
    • Be aware that tasks that are along the lines of “investigate and make recommendations” may not fully close maturity gaps.
    this image contains a screenshot from Info-Tech's Zero Trust Program Gap Analysis Tool, with the following column heading highlighted and numbered: 1: Gap Closure Tasks

    Make sure that the Gap Closure Tasks are SMART (Specific, Measurable, Achievable, Realistic, Timebound).

    2.4 Define tasks and initiatives

    Estimated time 2-4 hours

    1. As a group, review the gap tasks identified in the Gap Analysis tab.
    2. Using the instructions on the following slides, finalize your tab “5. Task List.”
    3. Using the instructions on the following slides, review and consolidate your tab “6. Initiative List.”

    Download the Zero Trust Program Gap Analysis Tool

    Input

    • Gap analysis

    Output

    • Refined list of tasks
    • List of zero trust initiatives

    Materials

    • Zero Trust Program Gap Analysis Tool

    Participants

    • Security Team
    • Subject Matter Experts From IT, Facilities, Audit, Risk Management
    • Project Management Office

    2.4.1 Finalize your task list

    1. Define the gap closure task list in tab “5. Task List”:
      1. Obtain a list of all your tasks from Gap Closure Tasks column in tab “3. Gap Analysis.”
      2. Paste the list into the table in tab “5. Task List,” Task column.
    • Use Paste Values to retain the table formatting.
  • Consolidate tasks into initiatives when:
      • They have costs associated with them.
      • They require initial effort to implement and ongoing effort to maintain.
      • They must be accomplished dependently of other tasks.
    1. For each new initiative, create the initiative name on Initiative Name column in the tab “6. Initiative List.”
  • For tasks which are not incorporated into initiatives, enter a task owner and due date for each task.
  • this image contains a screenshot from Info-Tech's Zero Trust Gap analysis Tool with the following column headings highlighted and numbered: 1: Task; 2: Initiative Name; 3: (Task Owner; Due Date)

    Example: Initiative consolidation

    In the example below, we see three gap closure tasks within the Authentication process for the Identity pillar being consolidated into a single initiative “IAM modernization.”

    We can also see three gap closure tasks within the Micro Segmentation process for the Network pillar being grouped into another initiative “Network segmentation.”

    This image contains an example of Initiative Consolidation

    Info-Tech Insight

    As you go through this exercise, you may find that some tasks that you previously defined could be consolidated into an initiative.

    2.4.2 Finalize your initiative list

    1. As you go through this exercise, you may find that some tasks that you previously defined could be consolidated into an initiative.
    2. Review your final list of initiatives in tab “6. Initiative List” and make any required updates.
      1. Optionally, add a description or paste in a list of the individual gap closure actions that are associated with the initiative. This will make it easier to perform the cost and benefit analysis.
    3. Obtain a list of all gap closure tasks associated with an initiative by filtering the Initiative Name column in the Task List tab.
    4. Indicate the most appropriate pillar alignment for each initiative using the drop-down list.
      1. Refer to tab “5. Task List” for the pillar associated with an initiative under the Initiative Name column.

    This image contains a screenshot from Info-Tech's Zero Trust Program Gap Analysis Tool, the following column headings are numbered and highlighted: 1: Initiative Name; 2: Description; 3: Pillar

    If the list of tasks is too long for the Description column, then you can also shorten the name of the tasks or group several tasks to a more general task.

    2.5 Align initiatives to business goals and protect surfaces

    Estimated time 30-60 minutes

    1. Using the instructions on the following slides, align initiatives to business goals in tab “6. Initiative List.”
    2. Using the instructions on the following slides, align initiatives to protect surfaces in tab “6. Initiative List.”

    Download the Zero Trust Program Gap Analysis Tool

    Input

    • List of zero trust initiatives
    • Protect surfaces mapped to business objectives

    Output

    • List of zero trust initiatives aligned to business goals and protect surfaces

    Materials

    • Zero Trust Program Gap Analysis Tool

    Participants

    • Security Team
    • Subject Matter Experts From IT, Facilities, Audit, Risk Management
    • Project Management Office

    2.5.1 Align initiatives to business goals

    1. Indicate the most appropriate business goal(s) alignment for each initiative using the drop-down list in “Selection for Business Goal(s)” column.
      1. Use the legend to determine the most appropriate business goal(s).
    2. After that copy the selected business goal(s) to Business Goal(s) Alignment column.
    3. Then reset the selection using the blank cell in Selection for Business Goal(s) column.
    This image contains a screenshot from the Zero Trust Program Gap Analysis Tool, with the following column headings numbered: 1: Selection for Business Goal(s); Business Goals Alignment; 3: Selection for Business Goals

    2.5.2 Align initiatives to protect surfaces

    1. Indicate the most appropriate protect surface(s) for each initiative using the drop-down list in Selection for Protect Surface(s) column.
      1. Use the legend to determine the most appropriate protect surface(s).
    2. After that copy the selected protect surface(s) to Protect Surface(s) Coverage column.
    3. Reset the selection using the blank cell in Selection for Protect Surface(s) column.
    This image contains a screenshot from the Zero Trust Program Gap Analysis Tool, with the following column headings numbered: 1: Description; 2: Protect Surfaces Covered; 3: Selection for Protect Surfaces

    Phase 3

    Evaluate Candidate Solutions and Finalize Roadmap

    Build a Zero Trust Roadmap

    This phase will walk you through the following activities:

    • Define solution criteria.
    • Identify candidate solutions.
    • Evaluate candidate solutions.
    • Perform cost/benefit analysis.
    • Prioritize initiatives and build roadmap.

    This phase involves the following participants:

    • Security Team
    • Subject Matter Experts From IT, Finance, HR, Legal, Facilities, Compliance, Audit, Risk Management
    • Project Management Office

    3.1 Define solution criteria

    Estimated time 30-60 minutes

    1. As a group, review the scoring system within the Zero Trust Candidate Solutions Selection Tool.
    2. Customize the tool as required using the instructions on the following slides.

    Info-Tech Insight

    Don’t let your solution dictate your roadmap. Define your zero trust solution criteria before engaging in vendor selection.

    Download the Zero Trust Candidate Solutions Selection Tool

    Input

    • Zero trust initiative list

    Output

    • Zero trust candidate solutions

    Materials

    • Zero Trust Program Gap Analysis Tool
    • Zero Trust Candidate Solutions Selection Tool

    Participants

    • Security Team
    • Subject Matter Experts From IT

    3.1.1 Define compliance and solution evaluation criteria

    On the Setup tab, provide a weight for each evaluation criterion to evaluate the candidate solutions. You can use “0%” weight if that criterion is not required in your solution selection.

    1. Verify that the Description for each criterion is accurate.
    2. Provide weights for the compliance score and the solution score, which are the overall evaluation:
    • Compliance score consists of tenets score, pillar score, threat protection score, and trust algorithm score.
    • Solution score consists of features score, usability score, affordability score, and architecture score.
    This image contains a screenshot from the Zero Trust Candidate Solutions Selection Tool, which demonstrates how to define compliance and solution evaluation criteria.

    3.1.2 Define remaining evaluation criteria

    On the Setup tab, provide a weight for each evaluation criterion to evaluate the candidate solutions. You can use “0%” weight if that criterion is not required in your solution selection.

    1. Verify that the Description for each criterion is accurate.
    2. Provide weights for the remaining evaluation criteria:
    • Tenets: Considers how well each initiative aligns with zero trust principles.
    • Pillars: Considers how well each initiative aligns with zero trust pillars.
    • Threats: Considers what zero trust threats are relevant with the candidate solution.
    • Trust Algorithm: Considers trust evaluation factors, trust evaluation process score, and input coverage.
    • Cost Estimation: Considers initial costs, which are one-time, upfront capital investments (e.g. hardware and software costs), and ongoing cost, which is any annually recurring operating expenses that are new budgetary costs (e.g. licensing, maintenance, subscription fees).
    • Deployment Architecture: Considers the solutions deployment architecture capabilities.

    This image contains a screenshot from the Zero Trust Candidate Solutions Selection Tool, and demonstrates where to define additional evaluation data

    Review available candidate solutions

    this image contains a list of available candidate Solutions.  This list includes: Zero Trust Identity; Zero-Trust Application & Workloads; Zero-Trust Networks; Zero-Trust Devices; and Zero-Trust Data

    The Rapid Application Selection Framework is a comprehensive yet fast-moving approach to help you select the right software for your organization

    Five key phases sequentially add rigor to your selection efforts while giving you a clear, swift-flowing methodology to follow.

    Awareness Education & Discovery Evaluation Selection Negotiation & Configuration
    1.1 Proactively Lead Technology Optimization & Prioritization 2.1 Understand Marketplace Capabilities & Trends 3.1 Gather & Prioritize Requirements & Establish Key Success Metrics 4.1 Create a Weighted Vendor Selection Decision Model 5.1 Initiate Price Negotiation With Top
    1.2 Scope & Define the Selection Process for Each Selection Request Action 2.2 Discover Alternative Solutions & Conduct Market Education 3.2 Conduct a Data-Driven Comparison of Vendor Features & Capabilities 4.2 Conduct Investigative Interviews Focused on Mission Critical Priorities With Top 2-4 Vendors 5.2 Negotiate Contract Terms & Product Configuration Two Vendors Selected
    1.3 Conduct an Accelerated Business Needs Assessment 2.3 Evaluate Enterprise Architecture & Application Portfolio 3.3 Narrow the Field to Four Top Contenders 4.3 Validate Key Issues With Deep Technical Assessments, Trial Configuration & Reference Checks 5.3 Finalize Budget Approval & Project Implementation Timeline
    1.4 Align Stakeholder Calendars to Reduce Elapsed Time & Asynchronous Evaluation 2.4 Validate the Business Case 5.4 Invest in Training & Onboarding Assistance

    Download the Rapid Application Selection Framework research

    Evaluate software category leaders through vendor rankings and awards

    SoftwareReviews

    The Data Quadrant is a thorough evaluation and ranking of all software in an individual category to compare platforms across multiple dimensions.

    The Data Quadrant Report

    Vendors are ranked by their Composite Score, based on individual feature evaluations, user satisfaction rankings, vendor capability comparisons, and likeliness to recommend the platform.

    Vendors ranked by their Composite Score

    The Emotional Footprint is a powerful indicator of overall user sentiment toward the relationship with the vendor, capturing data across five dimensions.

    Emotional Footprint

    Vendors are ranked by their Customer Experience (CX) Score, which combines the overall Emotional Footprint rating with a measure of the value delivered by the solution.

    Vendors ranked by their Customer Experience (CX) Score

    Sample whiteboard activity

    • Place sticky notes on the zero trust tenet that matches with the identified candidate solution to produce “solution requirements” that can be used to develop an RFP.
    • A sample sticky note is provided below for privileged access management.

    This image contains a screenshot of a sample whiteboard activity which can be done using sticky notes.

    • The PAM solution should support MFA
    • Live session monitoring, audit, and reporting
    • Should have password vaulting to prevent privileged users from knowing the passwords to critical systems and resources

    3.2 Identify candidate solutions

    Estimated time 2 hours

    1. As a group, have the team review the candidate solutions within the Zero Trust Program Gap Analysis Tool.
    2. On tab 3 in the Zero Trust Candidate Solutions Selection Tool:
    • Review the candidate solutions within the Zero Trust Program Gap Analysis Tool. For example, the candidate solutions with multifactor authentication (MFA) options are authenticators with SMS, mobile application, smartcard, or token.

    Input

    • Candidate solutions for zero trust tasks and initiatives

    Output

    • Suitability evaluation of candidate solutions

    Materials

    • Zero Trust Program Gap Analysis Tool
    • Zero Trust Candidate Solutions Selection Tool

    Participants

    • Security Team
    • Subject Matter Experts From IT

    Info-Tech Insight

    Add a description associated with the candidate solution, e.g. reference link to vendors or manufacturers. This will make it easier to perform the evaluation.

    Download the Zero Trust Candidate Solutions Selection Tool

    3.2.1 Review candidate solutions

    1. Review the candidate solutions within the Zero Trust Program Gap Analysis Tool. For example, the candidate solutions with multifactor authentication (MFA) options are authenticators with SMS, mobile application, smartcard, or token.
    2. Enter candidate solutions to the Compliance Data Entry tab on the Solution column within the Zero Trust Candidate Solutions Selection Tool.
    3. Optionally, add a description associated with the candidate solution, e.g. reference link to vendors or manufacturers. This will make it easier to perform the evaluation.
    this image contains a screenshot of a sample candidate solution, which can be done using Info-Tech's Zero Trust Program Gap Analysis Tool

    3.3 Evaluate candidate solutions

    Estimated time 3 hours

    On the Scoring tab, evaluate solution features, usability, affordability, and architecture using the instructions on the following slides. This activity will produce a solution score that can be used to identify the suitability of a solution.

    Input

    • Candidate solutions

    Output

    • Candidate solutions scored

    Materials

    • Zero Trust Program Gap Analysis Tool
    • Zero Trust Candidate Solutions Selection Tool

    Participants

    • Security Team
    • Subject Matter Experts From IT

    Download the Zero Trust Candidate Solutions Selection Tool

    3.3.3 Evaluate solution scores

    After all candidate solutions are evaluated, the Solution Score column can be sorted to rank the candidate solutions. After sorting, the top solutions can be used on prioritization of initiatives on Zero Trust Program Gap Analysis Tool.

    1. On Features
      1. Enter Coverage.
      2. Enter Quality.
    2. Enter Usability.
    3. On Affordability
      1. Enter Initial Cost.
      2. Enter Ongoing Cost (annual).
    4. Enter Architecture.
    this image contains a screenshot of how you can sort the solution score column in Info-Tech's Zero Trust Program Gap Analysis Tool

    3.4 Perform cost/benefit analysis

    Estimated time 1-2 hours

    1. Assign costing and benefits information for each initiative, following the instructions on the next slide.
    2. Define dependencies or business impacts if they will help with prioritization.

    Input

    • Ranked candidate solutions
    • Gap analysis
    • Initiative list

    Output

    • Completed cost/benefit analysis for initiative list

    Materials

    • Zero Trust Program Gap Analysis Tool
    • Zero Trust Candidate Solutions Selection Tool

    Participants

    • Security Team
    • Subject Matter Experts From IT, Facilities, Audit, Risk Management
    • Project Management Office

    Download the Zero Trust Program Gap Analysis Tool

    3.4.1 Complete the cost/benefit analysis

    Use Zero Trust Program Gap Analysis Tool.

    1. On the Prioritization tab, use the drop-down lists to enter the estimated costs and efforts for each initiative, using the criteria defined earlier.
    • Use the result from candidate selection to define the estimated costs.
    • If you have actual costs available, you can optionally enter them under the Detailed Cost Estimates columns.
  • Enter the estimated benefits, also using the criteria defined earlier.
  • This image contains a screenshot of a cost/benefit analysis table which can be found in the Zero Trust Program Gap Analysis Tool

    The Cost / Effort Rating is calculated based on the weight defined on step 2.1.1. The Benefit Rating is calculated based on the weight defined on step 2.1.2.

    3.4.2 Optionally enter detailed cost estimates

    Use Zero Trust Program Gap Analysis Tool.

    1. For each initiative, the tool will automatically populate the Detailed Cost Estimates and Detailed Staffing Estimates columns using the averages that you provided in step 2.1.1. However, if you have more detailed data about the costs and effort requirements for an initiative, you can override the calculated data by manually entering it into these columns. For example:
    • You are planning to subscribe to a security awareness vendor, and you have a quote from them specifying that the initial cost will be $75,000.
    • You have defined your “Medium” cost range as being “$10-100K,” so you select medium as your initial cost for this initiative in step 3.4.1. As you defined the average for medium costs as being $50,000, this is what the tool will put into the detailed cost estimate.
    • You can override this average by entering $75,000 as the initial cost in the detailed cost estimate column.

    This image contains a screenshot of a sample cost/benefit table found in the Zero Trust Program Gap Analysis Tool.

    The Benefits-Cost column will give results after comparing the cost and the benefit. Negative value means that the cost outweighs the benefit. Positive value means that the benefit outweighs the cost. Zero value means that the cost equals the benefit.

    3.5 Prioritize initiatives

    Estimated time 2-3 hours

    1. As a group, review the results of the cost/benefit analysis. Optionally, complete the Other Considerations columns in the Prioritization tab:
    • Dependencies can refer to other initiatives on the list or any other dependency that relates to activities or projects within the organization.
    • Business impacts can be helpful to document as they may require additional planning and communication that could impact initiative timelines.
  • Follow step 3.5.1 to create a visual effort map for your organization.
  • Follow step 3.5.2 and 3.5.3 to refine the effort map’s visual output.
  • Input

    • Gap analysis
    • Initiative list
    • Cost/benefit analysis

    Output

    • Prioritized list of initiatives

    Materials

    • Zero Trust Program Gap Analysis Tool

    Participants

    • Security Team
    • IT Leadership
    • Project Management Office

    Download the Zero Trust Program Gap Analysis Tool

    3.5.1 Create a visual effort map for your organization

    1 hour

    An effort map is a tool used for the visualization of a cost and benefit analysis. It is a quadrant output that visually shows how your gap initiatives were prioritized based on tab 7 in the Zero Trust Program Gap Analysis Tool.

    1. Establish the axes and colors for your effort map:
      1. X-axis represents the Benefit value from column J
      2. Y-axis represents the Cost/Effort value from column H
      3. Sticky note color is determined using the Alignment to Business value from column I
    2. Create sticky notes for each initiative and place them on the effort map or whiteboard based on the axes you have created with the help of your team.
    3. As you place initiatives on the visual effort map, discuss and modify rankings based on team member input.

    this image contains a sample visual effort map which can be found in the Zero Trust Program Gap Analysis Tool.

    Input

    • Outputs from activities 3.4.1 and 3.4.2

    Output

    • High-level prioritization for each of the gap-closing initiatives
    • Visual representation of quantitative values

    Materials

    • Zero Trust Program Gap Analysis Tool (tab 7)
    • Sticky notes
    • Markers
    • Whiteboard

    Participants

    • Security Team
    • IT Leadership
    • Project Management Office

    3.5.2 Refine the effort map’s visual output

    1 hour

    Once the effort map is complete, work to further simplify the visual output by categorizing initiatives based on the quadrant in which they have been placed.

    1. Before moving forward with the initiative wave prioritization (activity 3.7), identify any initiatives listed across all quadrants that are required as a part of compliance and mark with a sticky dot.
    2. Document these initiatives as Execution Wave 1.

    this image contains a screenshot of a refined visual effort map, which can be done by following the instructions in this section.

    Input

    • Outputs from activity 3.5.1

    Output

    • Prioritization for each of the gap-closing initiatives
    • First execution wave of gap-closing initiatives

    Materials

    • Zero Trust Program Gap Analysis Tool (tab 7)
    • Sticky notes
    • Sticky dots
    • Markers
    • Whiteboard

    Participants

    • Security Team
    • IT Leadership
    • Project Management Office

    3.5.3 Refine the effort map’s visual output

    30 minutes

    1. Use a separate area of the whiteboard to draw out four to five Execution Wave columns.
    2. Group initiatives into each Execution Wave column based on their placement within the quadrant from activities 3.5.1 and 3.5.2.
      1. Ensure that all identified mandatory activities as per governing privacy law fall within the first wave.
      2. Leverage the following 0-4 Execution Wave scale:
        1. Underway –Initiatives that are already underway
        2. Must Do – Initiatives that must happen right away
        3. Should Do – Initiatives that should happen but need more time/support
        4. Could Do – Initiatives that are not a priority
        5. Won’t Do – Initiatives that likely won’t be carried out
    3. Indicate the granular level for each execution wave using the a-z scale.
    • Use the lettering to track dependencies between initiatives.
      • If one must take place before another, ensure that its letter comes first alphabetically.
      • If multiple initiatives must take place at the same time, use the same letter to show they will take place in tandem.

    This image depicts the sample output for a refined visual effort map

    Input

    • Outputs from activity 3.5.2

    Output

    • Prioritization for each of the gap-closing initiatives
    • First execution wave of gap-closing initiatives

    Materials

    • Zero Trust Program Gap Analysis Tool (tab 7)
    • Sticky notes
    • Sticky dots
    • Markers
    • Whiteboard

    Participants

    • Security Team
    • IT Leadership
    • Project Management Office

    Wave assignment example

    In the example below, we see “IAM modernization” was assessed as 9 on cost/effort rating and 5 on benefit rating and its Benefits-Cost has a positive value of 1. We can label this as SHOULD DO (wave 2).

    We can also see “Network segmentation” was assessed as 6 on cost/effort rating and 4 on benefit rating and its Benefits-Cost has a positive value of 2. We can label this as MUST DO (wave 1).

    We can also see “Unified Endpoints Management” was assessed as 8 on cost/effort rating and 2 on benefit rating and its Benefits-Cost has a negative value of -4. We can label this as WON’T DO (no wave).

    We can also see “Data Protection” was assessed as 4 on cost/effort rating and 2 on benefit rating and its Benefits-Cost has a zero value. We can label this as COULD DO (wave 3).

    This image depicts a sample wave assignment output, discussed in this section.

    It is recommended to define the threshold of each wave based on the value of Benefits-Cost before assigning waves.

    3.6 Build roadmap

    Estimated time 2-3 hours

    1. As a group, follow step 3.6.1 to create your roadmap by scheduling initiatives into the Gantt chart within the Zero Trust Program Gap Analysis Tool.
    2. Review the roadmap for resourcing conflicts and adjust as required.
    3. Review the final cost and effort estimates for the roadmap.

    Input

    • Gap analysis
    • Cost/benefit analysis
    • Prioritized initiative list

    Output

    • Zero trust roadmap

    Materials

    • Zero Trust Program Gap Analysis Tool

    Participants

    • Security Team
    • IT Leadership
    • Project Management Office

    Download the Zero Trust Program Gap Analysis Tool

    3.6.1 Schedule initiatives using the Gantt chart

    1. On the Gantt Chart tab for each initiative, enter an owner (the role who will be primarily responsible for execution).
    2. Additionally, enter a start month and year for the initiative and the expected duration in months.
    • You can filter the Wave column to only see specific waves at any one time to assist with the scheduling.
    • You do not need to schedule Wave 4 initiatives as the expectation is that these initiatives will not be done.
    • This Image contains a screenshot of the Gantt Chart, with the following column headings highlighted and numbered: 1: Owner; 2: Expected Duration

    3.6.2 Review your roadmap

    1. When you have completed the Gantt chart, as a group review the overall roadmap to ensure that it is reasonable for your organization. Consider the following:
    • Do you have other IT or business projects planned during this time frame that may impact your resourcing or scheduling?
    • Does your organization have regular change freezes throughout the year that will impact the schedule?
    • Do you have over-subscribed resources? You can filter the list on the Owner column to identify potential over-subscription of resources.
    • Have you considered any long vacations, sabbaticals, parental leaves, or other planned longer-term absences?
    • Are your initiatives adequately aligned to your budget cycle? For instance, if you have an initiative that is expected to make recommendations for capital expenditure, it must be completed prior to budget planning.

    This image depicts an example roadmap which can be created following the use of the Gantt Chart

    3.6.3 Review your cost/effort estimates table

    1. Once you have completed your roadmap, review the total cost/effort estimates. This can be found in a table on the Results tab. This table will provide initial and ongoing costs and staffing requirements for each wave. This also includes the total three-year investment. In your review consider:
    • Is this investment realistic? Will completion of your roadmap require adding more staff or funding than you otherwise expected?
    • If the investment seems unrealistic, you may need to revisit some of your assumptions, potentially reducing target levels or increasing the amount of time to complete the strategy.

    This table provides you with the information to have important conversations with management and stakeholders.

    This image contains an example of the Zero Trust Roadmap Cost/Effort Estimates.  The column headings are as follows: Wave; Number of Initiatives; Initial Implementation - Cost; Initial Implementation - Effort; Ongoing Maintenance - Cost; Ongoing Maintenance - Effort.  A separate table is shown with the column heading: Estimated Total Three Year Investment

    Phase 4

    Formulate Policies for Roadmap Initiatives

    Build a Zero Trust Roadmap

    This phase will walk you through the following activities:

    • Formulate zero trust policies for critical DAAS elements.
    • Formulate zero trust policies to secure a path to access critical DAAS elements.

    This phase involves the following participants:

    • CIO
    • CISO
    • Business Executives
    • IT Manager
    • Security Team

    Understand the zero trust policy

    Use the Kipling methodology as a vendor agnostic approach to identify appropriate allow list elements when deploying multiple zero trust solutions.
    The policies help to prevent lateral movement.

    Who Who should access a resource? Here, the user ID that identifies the users through the principle of least privilege is allowed access to a particular resource. The authentication policy will be used to verify identity of a user when access request to a resource is made. Who requires MFA?
    What What application is used to access the resource? Application ID to identify applications that are only allowed on the network. Port control policies can be used for the application service.
    When When do users access the resource? Policy that identifies and enforces time schedule when an application accessed by users is used.
    Where Where is the resource located? The location of the destination resource should be added to the policy and, where possible, restrict the source of the traffic either by zone and/or IP address.
    Why Why is the data accessed? Data classification should be done to know why the data needs protection and the type of protection (data filtering).
    How How should you allow access to the resource? This covers the protection of the application traffic. Principle of least privilege access, log all traffic, configure security profiles, NGFW, decryption and encryption, consistent application of policy and threat prevention across all locations for all local and remote users on managed and unmanaged endpoints are ways to apply content-ID.

    Info-Tech Insight

    The success of a zero trust implementation relies on enforcing policies consistently. Applying the Kipling methodology to the protect surface is the best way to design zero trust policies.

    4.1.1 Formulate policy

    Estimated time 1-2 hours

    1. As a group, review the protect surface(s) identified in phase one, and using the Kipling methodology from the previous slide, formulate a policy. Each policy can be reviewed repeatedly until we are sure it satisfies the goal.
    2. The policy created should be consistent for both cloud and on-prem environments.
    3. As an example, let's use the healthcare scenario found in tab 3 of the Zero Trust Protect Surface Mapping Tool. The protect surface used is "Automated Medication Dispensing." Another example will be "Salesforce" accessed via the cloud.
    Who What When Where Why How
    Method User-ID App-ID Time limit System Object Classification Content-ID
    On-Prem Pyxis_Users Pyxis Any Pyxis_server Severe (high value data) Decrypt, Inspect, log traffic
    Cloud Sales Salesforce Working hours Canada Severe (high value data) Decrypt, Inspect, log traffic

    Input

    • Kipling methodology
    • Protect surface

    Output

    • Zero trust policy

    Materials

    • Whiteboard/Flip Charts
    • Zero Trust Protect Surface Mapping Tool

    Participants

    • CIO
    • CISO
    • Business Executives
    • IT Manager
    • Security Team

    4.1.2 Apply policy

    1-2 hours

    1. Place each protect surface in its own microperimeter. Each microperimeter should be segmented by a next-generation firewall or authentication broker that will serve as a segmentation gateway.
    2. Name the microperimeter and place it on a firewall.

    Input

    • Kipling methodology
    • Protect surface

    Output

    • Zero trust policy

    Materials

    • Whiteboard/Flip Charts
    • Sticky Notes
    • Zero Trust Protect Surface Mapping Tool

    Participants

    • CIO
    • CISO
    • Business Executives
    • IT Manager
    • Security Team

    Microperimeter A
    Protect Surface:
    DAAS Elements:

    Who What When Where Why How
    Method User-ID App-ID Time limit System Object Classification Content-ID

    Microperimeter B
    Protect Surface:
    DAAS Elements:

    Who What When Where Why How
    Method User-ID App-ID Time limit System Object Classification Content-ID

    Microperimeter C
    Protect Surface:
    DAAS Elements:

    Who What When Where Why How
    Method User-ID App-ID Time limit System Object Classification Content-ID

    4.2 Secure a path to access critical DAAS elements

    How should you allow access to the resource?

    This component makes up the final piece of formulating the policies as it applies the protection of the application traffic.

    The principle of least privilege is applied to the security policy to only allow access requests and restrict the access to the purpose it serves. This access request is then logged as well as the traffic (both internal and external). Most firewalls (NGFW) have policy rules that, by default, enable logging.

    Segmentation gateways (NGFW, VM-series firewalls, agent-based and clientless VPN solutions), are used to apply zero trust policy (Kipling methodology) in the network, cloud, and endpoint (managed and unmanaged) for all local and remote users.

    These policies need to be applied to security profiles on all allowed traffic. Some of these profiles include but are not limited to the following: URL filtering profile for web access and protect against phishing attacks, vulnerability protection profile intrusion prevention systems, anti spyware profiles to protect against command-and-control threats, malware and antivirus profile to protect against malware, and a file blocking profile to block and/or alert suspicious file types.

    Good visibility on your network can also be tied to decryption as you can inspect traffic and data to the lowest level possible that is generally accepted by your organization and in compliance with regulation.

    Conceptualized flow

    With users working from anywhere on managed and unmanaged devices, access to the internet, SAAS, public cloud, and the data center will have consistent policies applied regardless of their location.

    The policy is validating that the user is who they say they are based on the role profile, what they are trying to access to make sure their role or attribute profile has the appropriate permission to the application, and within the stipulated time limit. Where the data or application is located is also verified and the why needs to be satisfied before the requested access is granted. Based on the mentioned policies, the how element is then applied throughout the lifecycle of the access.

    Who

    (Internet)

    What

    (SAAS)

    When

    Where

    (Public Cloud)

    Why

    How

    (Data Center)

    Method User-ID App-ID Time limit System Object Classification Content-ID
    On-Prem Pyxis_Users Pyxis Any Pyxis_server Severe (high value data) Decrypt, Inspect, log traffic
    Cloud Sales Salesforce Working hours Canada Severe (high value data) Decrypt, Inspect, log traffic

    Phase 5

    Monitor Zero Trust Roadmap Deployment

    Build a Zero Trust Roadmap

    This phase will walk you through the following activities:

    • Establish metrics for roadmap tasks.
    • Track metrics for roadmap tasks.

    This phase involves the following participants:

    • Security Team
    • Subject Matter Experts From IT, HR, Legal, Facilities, Compliance, Audit, Risk Management
    • Project Management Office

    5.1 Establish metrics for roadmap tasks

    Estimated time 2 hours

    1. On tab “2. Task & Metric Register” of the Zero Trust Progress Monitoring Tool, identify metrics to measure implementation and efficacy of tasks
    2. On tab “2. Task & Metric Register” of the Zero Trust Progress Monitoring Tool, document metric metadata.
    3. On the Prioritization tab, use the drop-down lists to enter the estimated costs and efforts for each initiative, using the criteria defined earlier.
    • If you have actual costs available, you can optionally enter them under the Detailed Cost Estimates columns.
  • Enter the estimated benefits, also using the criteria defined earlier.
  • Input

    • Zero trust roadmap task list

    Output

    • Metrics for measuring zero trust task implementation and efficacy

    Materials

    • Zero Trust Progress Monitoring Tool

    Participants

    • Security Team
    • Subject Matter Experts From IT, HR, Legal, Facilities, Compliance, Audit, Risk Management
    • Project Management Office

    Download the Zero Trust Progress Monitoring Tool

    5.1.1 Identify metrics to measure implementation and efficacy of tasks

    Estimated time 3-4 hours

    1. On tab “2. Task & Metric Register” of the Zero Trust Progress Monitoring Tool, for each section defined in columns C and D, enter zero trust implementation tasks into column E. If you completed the Zero Trust Program Gap Analysis Tool, use the tasks identified there to populate column E.
    2. For each task, identify in column F any metrics that will communicate implementation progress and/or implementation efficacy.
    • If multiple metrics are needed for a single task, we recommend expanding the size of the row and adding additional metrics onto a new line in the same row. A sample is provided in the tool.

    this image contains a screenshot of tab 2 in the Zero Trust Progress Monitoring Tool

    Info-Tech Insight

    To measure the efficacy of a zero trust implementation, ensure you know what a successful zero trust implementation means for your organization, and define metrics that demonstrate whether that success is being realized.

    5.1.2 Document metric metadata

    Estimated time 1-2 hours

    For each metric defined in step 4.1.1:

    1. Identify in column G whether the metric can be measured now (Phase 1), measured in a few months’ time (Phase 2), or measured in a few years’ time (Phase 3).
    2. Identify in columns H through M who is responsible for collecting the metric (Person Source), who/what is consulted to collect the metric (Technology Source), who compiles the collected metric into dashboards and presentations (Compiler), and who is informed of the measurement of the metric (Audience).
    • Add more columns under the Audience category if needed.
    • Use “X” to identify if an audience group will be informed of the measurement of the metric.
  • Identify in columns N through P the target for the metric (Metric Target), the effort it takes to collect the metric (Effort to Collect), the frequency with which the organizations plans to collect the metric (Frequency of Collection), and any comments that people should know when collecting, compiling, or presenting metrics.
  • This image contains a screenshot from the Zero Trust Progress Monitoring Tool, with the following column headings numbered: 1: Priority; 2: Roles and Responsibilities; 3: effort to collect; frequency of collection; Metric Target; Comments

    5.2 Track and report metrics

    Estimated time 2 hours

    1. In the Zero Trust Progress Monitoring Tool, copy and paste metrics you plan to track in the tool from column F on tab 2 to column B on tab 3.
    2. Use tab 3 to identify collection frequency, metric target, and measurements collected for each metric. Add notes or comments to each metric or measurement to track contextual elements that could affect metric measurements.
    3. Leverage the graphs on tab 4 to communicate metrics to the appropriated audience groups, as defined in tab 2.

    Input

    • Metrics for measuring zero trust task implementation and efficacy

    Output

    • Metric data and graphs for presenting zero trust implementation metrics to audience groups

    Materials

    • Zero Trust Progress Monitoring Tool

    Participants

    • Security Team
    • Subject Matter Experts From IT, HR, Legal, Facilities, Compliance, Audit, Risk Management
    • Project Management Office

    Download the Zero Trust Progress Monitoring Tool

    5.2.1 Record baseline measurements for metrics

    Estimated time 1-2 hours

    On tab “3. Track Metrics” of the Zero Trust Progress Monitoring Tool:

    1. Copy and paste the metrics from Column F on tab “2. Task & Metric Register” that you want to track into Column B of this tab.
    2. For each metric, record the frequency of collection (Collection Frequency) and the metric target (Target) by referencing columns O and P on tab “2. Task & Metric Register.”
    3. Begin to record baseline/initial values for each metric in column E. Rename columns to match your highest frequency of collection.
      (e.g. if any metric is being measured monthly, there should be one column per month)
    4. Over time, conduct measurements of your metrics and store them in the table below.
    5. Add notes, as necessary.

    this image contains a screenshot of tab 3 of the Zero Trust Progress Monitoring Tool, with the following column headings numbered: 1: Your Metrics; 2: Collection Frequency; Target; 3: Jan; 4: Metric Measurements; 5: Notes

    5.2.2 Report metric health to audience groups

    Estimated time 1-2 hours

    On tab “4. Graphs” of the Zero Trust Progress Monitoring Tool:

    1. The Overall Metric Health gauge at the top of this tab presents the average percentage away from meeting metric targets for all metrics being tracked. To calculate this value, the differences between the most recent measurements and target values for each metric are averaged.
    2. Below the Overall Metric Health gauge, use the drop-down list in cell D9 to select one of the metrics from tab “3. Track Metrics.”
    3. Six different graphic representations of the tracked data for the selected metric will populate.

    Copy and paste desired graphs into presentations for audience members identified in step 5.1.2.

    This image contains a screenshot from tab “4. Graphs” of the Zero Trust Progress Monitoring Tool:

    5.3 Build a communication deck

    Estimated time 2 hours

    Leverage the Zero Trust Communication Deck to showcase the work that you have done in the tools and activities associated with this research.

    In this communication deck template, you will find the following sections:

    • Introduction
    • Protect Surfaces
    • Zero Trust Gap Analysis
    • Zero Trust Initiatives & Tasks

    Input

    • Protect surfaces mapped to business goals
    • Zero trust program gap analysis
    • Zero trust roadmap initiatives and tasks
    • Zero trust metrics

    Output

    • Communication deck for zero trust strategy

    Materials

    • Zero Trust Communication Deck

    Participants

    • Security Team
    • Subject Matter Experts From IT, HR, Legal, Facilities, Compliance, Audit, Risk Management
    • Project Management Office

    Download the Zero Trust Communication Deck

    Summary of Accomplishment

    Knowledge Gained

    • Knowledge of protect surfaces and the business goals protecting them supports
    • Comprehensive knowledge of zero trust current state and summary initiatives required to achieve zero trust objectives
    • Assessment of which solutions for zero trust tasks and initiatives are the most appropriate for the organization
    • A defined set of security metrics assessing zero trust implementation progress and efficacy

    Deliverables Completed

    If you would like additional support, have our analysts guide you through other phases as part of an Info-Tech workshop

    Contact your account representative for more information

    workshops@infotech.com

    1-888-670-8889

    Additional Support

    If you would like additional support, have our analysts guide you through other phases as part of an Info-Tech Workshop

    To accelerate this project, engage your IT team in an Info-Tech workshop with an Info-Tech analyst team.

    Info-Tech analysts will join you and your team at your location or welcome you to Info-Tech’s historic Toronto office to participate in an innovative onsite workshop.

    Contact your account representative for more information.

    This is a picture of an Info-Tech Account Representative
    workshops@infotech.com 1-888-670-8889

    The following are sample activities that will be conducted by Info-Tech analysts with your team:

    Zero Trust Program Gap Analysis Tool

    This is a screenshot from the Zero Trust Program Gap Analysis Tool

    Assess current security capabilities and build a roadmap of tasks and initiatives that close maturity gaps.

    Zero Trust Progress Monitoring Tool

    This is a screenshot from the Zero Trust Progress Monitoring Tool

    Identify and track metrics for zero trust tasks and initiatives.

    Research Contributors

    • Aaron Benson, CME Group, Director of IAM Governance
    • Brad Mateski, Zones, Solutions Architect for CyberSecurity
    • Bob Smock, Info-Tech Research Group, Vice President of Consulting
    • Dr. Chase Cunningham, Ericom Software, Chief Strategy Officer
    • John Kindervag, ON2IT Cybersecurity, Senior Vice President, Cybersecurity Strategy and ON2IT Group Fellow
    • John Zhao, Fonterra, Enterprise Security Architect
    • Rongxing Lu, University of New Brunswick, Associate Professor
    • Sumanta Sarkar, University of Warwick, Assistant Professor
    • Tim Malone, J.B. Hunt Transport, Senior Director Information Security
    • Vana Matte, J.B. Hunt Transport, Senior Vice President of Technology Services

    Related Info-Tech Research

    This is a screenshot from Info-Tech's Build an Information Security Strategy

    Build an Information Security Strategy

    Info-Tech has developed a highly effective approach to building an information security strategy – an approach that has been successfully tested and refined for over seven years with hundreds of organizations. This unique approach includes tools for ensuring alignment with business objectives, assessing organizational risk and stakeholder expectations, enabling a comprehensive current-state assessment, prioritizing initiatives, and building out a security roadmap.

    This is a screenshot from Info-Tech's Determine Your Zero Trust Readiness.

    Determine Your Zero Trust Readiness

    IT security was typified by perimeter security. However, the way the world does business has mandated a change to IT security. In response, zero trust is a set of principles that can add flexibility to planning your IT security strategy.

    Use this blueprint to determine your zero trust readiness and understand how zero trust can benefit both security and the business.

    This is a screenshot from Info-Tech's Mature Your Identity and Access Management Program

    Mature Your Identity and Access Management Program

    Many organizations are looking to improve their identity and access management (IAM) practices but struggle with where to start and whether all areas of IAM have been considered. This blueprint will help you improve the organization's identity and access management practices by following our three-phase methodology:

    • Assess identity and access requirements
    • Identify initiatives using the identity lifecycle
    • Prioritize initiatives and build a roadmap

    Bibliography

    • “2021 Data Breach Investigations Report.” Verizon, 2021. Web.
    • “A Zero-Trust Strategy Has 3 Needs - Identify, Authenticate, and Monitor Users and Devices On and Off The Network.” Fortinet, 15 July 2021. Web.
    • “Applying Zero Trust Principles to Enterprise Mobility.” CISA, March 2022. Web.
    • Biden Jr., Joseph R. “Executive Order on Improving the Nation’s Cybersecurity.” The White House, 12 May 2021. Web.
    • “CISA Zero Trust Maturity Model.” CISA - Cybersecurity Division, June 2021. Web.
    • “Continuous Diagnostics and Mitigation Program Overview.” CISA, Jan. 2022. Web.
    • Contributor. “The Five Business Benefits of a Zero Trust Approach to Security.” Security Brief - Australia, 19 Aug. 2020. Web.
    • “Cost of a Data Breach Report 2021.” IBM, July 2021. Web.
    • English, Melanie. “5 Stats That Show The Cost Saving Effect of Zero Trust.” Teramind, 29 Sept. 2021. Web.
    • “Improve Application Access and Security With Fortinet Zero Trust Network Access.” Fortinet, 2 March 2021. Web.
    • “Incorporating Zero-trust Strategies for Secure Network and Application Access.” Fortinet, 21 July 2021. Web.
    • Jakkal, Vasu. “Zero Trust Adoption Report: How Does Your Organization Compare?” Microsoft, 28 July 2021. Web.
    • “Jericho Forum™ Commandments.” The Open Group, Jericho Forum, May 2007. Web.
    • Johnson, Derrick. “Zero Trust vs. SASE - Here's What You Need to Know.” Security Magazine, 23 July 2021. Web.
    • Joint Defense Information Systems Agency (DISA) and National Security Agency (NSA) Zero Trust Engineering Team. “Department of Defense (DOD) Zero Trust Reference Architecture.” DoD CIO, Feb. 2021. Web.
    • Kay, Dennis. “Planning for a Zero Trust Architecture Target State.” NASA, NIST, 13 Nov. 2019. Web.
    • National Security Agency. “Embracing a Zero Trust Security Model.” U.S. Department of Defense, Feb. 2021. Web.
    • NSTAC. “Draft Report to the President - Zero Trust and Trusted Identity Management.” CISA, NSTAC, n.d. Web.
    • Rose, Scott W., et al. “Zero Trust Architecture.” NIST, 10 Aug. 2020. Web.
    • “Securing Digital Innovation Demands Zero-Trust Access.” Fortinet, 15 July 2021. Web.
    • Shackleford, Dave. “How to Create a Comprehensive Zero Trust Strategy.” SANS, Cisco, 2 Sept. 2020. Web.
    • “The CISO’s Guide to Effective Zero-Trust Access.” Fortinet, 28 April 2021. Web.
    • “The State of Zero Trust Security 2021.” Okta, June 2021. Web.
    • Kerman, Alper, et al. “Implementing a Zero Trust Architecture.” NIST - National Cybersecurity Center of Excellence, March 2020. Web.
    • Kindervag, John. “Keynote - John KINDERVAG - 021622.” Vimeo, VIRTUAL Eastern | CyberSecurity Conference, 16 Feb. 2022. Web.
    • Lodewijkx, Koos. “IBM CISO Perspective: Zero Trust Changes Security From Something You Do to Something You Have.” SecurityIntelligence, IBM, 19 Nov. 2020. Web.
    • VB Staff. “Report: Only 21% of Enterprises Use Zero Trust Architecture.” VentureBeat, 15 Feb. 2022. Web.
    • Young, Shalanda D. “Moving the U.S. Government Toward Zero Trust Cybersecurity Principles.” The White House, EXECUTIVE OFFICE OF THE PRESIDENT - OFFICE OF MANAGEMENT AND BUDGET, 26 Jan. 2022. Web.
    • “Zero Trust Access.” Fortinet, n.d. Web.
    • “Zero Trust Architecture Technical Exchange Meeting.” NIST - National Cybersecurity Center of Excellence, 12 Nov. 2019. Web.
    • “Zero Trust Cybersecurity Current Trends.” ACT-IAC, 18 April 2019. Web.
    • “Zero-Trust Access for Comprehensive Visibility and Control.” Fortinet, 24 Sep. 2020. Web.

    Get Started With Customer Advocacy

    • Buy Link or Shortcode: {j2store}565|cart{/j2store}
    • member rating overall impact: N/A
    • member rating average dollars saved: N/A
    • member rating average days saved: N/A
    • Parent Category Name: Marketing Solutions
    • Parent Category Link: /marketing-solutions

    Getting started with customer advocacy (CA) is no easy task. Many customer success professionals carry out ad hoc customer advocacy activities to address immediate needs but lack a more strategic approach.

    Our Advice

    Critical Insight

    • Customer success leaders must reposition their CA program around growth; the recognition that customer advocacy is a strategic growth initiative is necessary to succeed in today’s competitive market.
    • Get key stakeholders on board early – especially Sales!
    • Always link your CA efforts back to retention and growth.
    • Make building genuine relationships with your advocates the cornerstone of your CA program.

    Impact and Result

    • Enable the organization to identify and develop meaningful relationships with top customers and advocates.
    • Understand the concepts and benefits of CA and how CA can be used to improve marketing and sales and fuel growth and competitiveness.
    • Follow SoftwareReviews’ methodology to identify where to start to apply CA within the organization.
    • Develop a customer advocacy proof of concept/pilot program to gain stakeholder approval and funding to get started with or expand efforts around customer advocacy.

    Get Started With Customer Advocacy Research & Tools

    Besides the small introduction, subscribers and consulting clients within this management domain have access to:

    1. Get Started With Customer Advocacy Executive Brief – An overview of why customer advocacy is critical to your organization and the recommended approach for getting started with a pilot program.

    Understand the strategic benefits and process for building a formal customer advocacy program. To be successful, you must reposition CA as a strategic growth initiative and continually link any CA efforts back to growth.

    • Get Started With Customer Advocacy Storyboard

    2. Define Your Advocacy Requirements – Assess your current customer advocacy efforts, identify gaps, and define your program requirements.

    With the assessment tool and steps outlined in the storyboard, you will be able to understand the gaps and pain points, where and how to improve your efforts, and how to establish program requirements.

    • Customer Advocacy Maturity Assessment Tool

    3. Win Executive Approval and Launch Pilot – Develop goals, success metrics, and timelines, and gain approval for your customer advocacy pilot.

    Align on pilot goals, key milestones, and program elements using the template and storyboard to effectively communicate with stakeholders and gain executive buy-in for your customer advocacy pilot.

    • Get Started With Customer Advocacy Executive Presentation Template

    Infographic

    Further reading

    Get Started With Customer Advocacy

    Develop a customer advocacy program to transform customer satisfaction into revenue growth.

    EXECUTIVE BRIEF

    Analyst perspective

    Customer advocacy is critical to driving revenue growth

    The image contains a picture of Emily Wright.

    Customer advocacy puts the customer at the center of everything your organization does. By cultivating a deep understanding of customer needs and how they define value and by delivering positive experiences throughout the customer journey, organizations inspire and empower customers to become evangelists for their brands or products. Both the client and solution provider enjoy satisfying and ongoing business outcomes as a result.

    Focusing on customer advocacy is critical for software solutions providers. Business-to-business (B2B) buyers are increasingly looking to their peers and third-party resources to arm themselves with information on solutions they feel they can trust before they choose to engage with solution providers. Your satisfied customers are now your most trusted and powerful resource.

    Customer advocacy helps build strong relationships with your customers, nurtures brand advocacy, gives your marketing messaging credibility, and differentiates your company from the competition; it’s critical to driving revenue growth. Companies that develop mature advocacy programs can increase Customer Lifetime Value (CLV) by 16% (Wharton Business School, 2009), increase customer retention by 35% (Deloitte, 2011), and give themselves a strong competitive advantage in an increasingly competitive marketplace.

    Emily Wright
    Senior Research Analyst, Advisory
    SoftwareReviews

    Executive summary

    Your Challenge

    Ad hoc customer advocacy (CA) efforts and reference programs, while still useful, are not enough to drive growth. Providers increase their chance for success by assessing if they face the following challenges:

    • Lack of referenceable customers that can turn into passionate advocates, or a limited pool that is at risk of burnout.
    • Lack of references for all key customer types, verticals, etc., especially in new growth segments or those that are hard to recruit.
    • Lack of a consistent program for gathering customer feedback and input to make improvements and increase customer satisfaction.
    • Lack of executive and stakeholder (e.g. Sales, Customer Success, channel partners, etc.) buy-in for the importance and value of customer advocacy.

    Building a strong customer advocacy program must be a high priority for customer service/success leaders in today’s highly competitive software markets.

    Common Obstacles

    Getting started with customer advocacy is no easy task. Many customer success professionals carry out ad hoc customer advocacy activities to address immediate needs but lack a more strategic approach. What separates them from success are several nagging obstacles:

    • Efforts lack funding and buy-in from stakeholders.
    • Senior management doesn’t fully understand the business value of a customer advocacy program.
    • Duplicate efforts are taking place between Sales, Marketing, product teams, etc., because ownership, roles, and responsibilities have not been determined.
    • Relationships are guarded/hoarded by those who feel they own the relationship (e.g. Sales, Customer Success, channel partners, etc.).
    • Customer-facing staff often lack the necessary skills to foster customer advocacy.

    SoftwareReviews’ Approach

    This blueprint will help leaders of customer advocacy programs get started with developing a formalized pilot program that will demonstrate the value of customer advocacy and lay a strong foundation to justify rollout. Through SoftwareReviews’ approach, customer advocacy leaders will:

    • Enable the organization to identify and develop meaningful relationships with top customers and advocates.
    • Understand the concepts and benefits of CA and how CA can be used to improve marketing and sales and fuel growth and competitiveness.
    • Follow SoftwareReviews’ methodology to identify where to start to apply CA within the organization.
    • Develop a customer advocacy proof of concept/pilot program to gain stakeholder approval and funding to get started with or expand efforts around customer advocacy.

    What is customer advocacy?

    “Customer advocacy is the act of putting customer needs first and working to deliver solution-based assistance through your products and services." – Testimonial Hero, 2021

    Customer advocacy is designed to keep customers loyal through customer engagement and advocacy marketing campaigns. Successful customer advocacy leaders experience decreased churn while increasing return on investment (ROI) through retention, acquisition, and cost savings.

    Businesses that implement customer advocacy throughout their organizations find new ways of supporting customers, provide additional customer value, and ensure their brands stand unique among the competition.

    Customer Advocacy Is…

    • An integral part of any marketing and/or business strategy.
    • Essential to improving and maintaining high levels of customer satisfaction.
    • Focused on delivering value to customers.
    • Not only a set of actions, but a mindset that should be fostered and reinforced through a customer-centric culture.
    • Mutually beneficial relationships for both company and customer.

    Customer Advocacy Is Not…

    • Only referrals and testimonials.
    • Solely about what you can get from your advocates.
    • Brand advocacy. Brand advocacy is the desired outcome of customer advocacy.
    • Transactional. Brand advocates must be engaged.
    • A nice-to-have.
    • Solved entirely by software. Think about what you want to achieve and how a software solution can you help you reach those goals.

    SoftwareReviews Insight

    Customer advocacy has evolved into being a valued company asset versus a simple referral program – success requires an organization-wide customer-first mindset and the recognition that customer advocacy is a strategic growth initiative necessary to succeed in today’s competitive market.

    Customer advocacy: Essential to high retention

    When customers advocate for your company and products, they are eager to retain the value they receive

    • Customer acts of advocacy correlate to high retention.
    • Acts of advocacy won’t happen unless customers feel their interests are placed ahead of your company’s, thereby increasing satisfaction and customer success. That’s the definition of a customer-centric culture.
    • And yet your company does receive significant benefits from customer advocacy:
      • When customers advocate and renew, your costs go down and margins rise because it costs less to keep a happy customer than it does to bring a new customer onboard.
      • When renewal rates are high, customer lifetime value increases, also increasing profitability.

    Acquiring a new customer can cost five times more than retaining an existing customer (Huify, 2018).

    Increasing customer retention by 5% can increase profits by 25% to 95% (Bain & Company, cited in Harvard Business Review, 2014).

    SoftwareReviews Insight

    Don’t overlook the value of customer advocacy to retention! Despite the common knowledge that it’s far easier and cheaper to sell to an existing customer than to sell to a new prospect, most companies fail to leverage their customer advocacy programs and continue to put pressure on Marketing to focus their budgets on customer acquisition.

    Customer advocacy can also be your ultimate growth strategy

    In your marketing and sales messaging, acts of advocacy serve as excellent proof points for value delivered.

    Forty-five percent of businesses rank online reviews as a top source of information for selecting software during this (top of funnel) stage, followed closely by recommendations and referrals at 42%. These sources are topped only by company websites at 54% (Clutch, 2020).

    With referrals coming from customer advocates to prospects via your lead gen engine and through seller talk tracks, customer advocacy is central to sales, marketing, and customer experience success.

    ✓ Advocates can help your new customers learn your solution and ensure higher adoption and satisfaction.
    ✓ Advocates can provide valuable, honest feedback on new updates and features.

    The image contains a picture to demonstrate the cycle of customer advocacy. The image has four circles, with one big circle in the middle and three circles surrounding with arrows pointing in both directions in between them. The middle circle is labelled customer advocacy. The three circles are labelled: sales, customer success, marketing.

    “A customer advocacy program is not just a fancy buzz word or a marketing tool that’s nice to have. It’s a core discipline that every major brand needs to integrate into their overall marketing, sales and customer success strategies if they expect to survive in this trust economy. Customer advocacy arguably is the common asset that runs throughout all marketing, sales and customer success activities regardless of the stage of the buyer’s journey and ties it all together.” – RO Innovation, 2017

    Positive experience drives acts of advocacy

    More than price or product, experience now leads the way in customer advocacy and retention

    Advocacy happens when customers recommend your product. Our research shows that the biggest drivers of likeliness to recommend and acts of customer advocacy are the positive experiences customers have with vendors and their products, not product features or cost savings. Customers want to feel that:

    1. Their productivity and performance is enhanced and the vendor is helping them to innovate and grow as a company.
    2. Their vendor inspires them and helps them to continually improve.
    3. They can rely on the vendor and the product they purchased.
    4. They are respected by the vendor.
    5. They can trust that the vendor will be on their side and save them time.

    The image contains a graph to demonstrate the correlation of likeliness to recommend a satisfaction driver. Where anything above a 0.5 indicates a strong driver of satisfaction.

    Note that anything above 0.5 indicates a strong driver of satisfaction.
    Source: SoftwareReviews buyer reviews (based on 82,560 unique reviews).

    SoftwareReviews Insight

    True customer satisfaction comes from helping customers innovate, enhancing their performance, inspiring them to continually improve, and being reliable, respectful, trustworthy, and conscious of their time. These true drivers of satisfaction should be considered in your customer advocacy and retention efforts. The experience customers have with your product and brand is what will differentiate your brand from competitors, drive advocacy, and ultimately, power business growth. Talk to a SoftwareReviews advisor to learn how users rate your product on these satisfaction drivers in the SoftwareReviews Emotional Footprint Report.

    Yet challenges exist for customer advocacy program leaders

    Customer success leaders without a strong customer advocacy program feel numerous avoidable pains:

    • Lack of compelling stories and proof points for the sales team, causing long sales cycles.
    • Heavy reliance on a small pool of worn-out references.
    • Lack of references for all needed customer types, verticals, etc.
    • Lack of a reliable customer feedback process for solution improvements.
    • Overspending on acquiring new customers due to a lack of customer proof points.
    • Missed opportunities that could grow the business (customer lifetime value, upsell/cross-sell, etc.).

    Marketing, customer success, and sales teams experiencing any one of the above challenges must consider getting started with a more formalized customer advocacy program.

    Obstacles to customer advocacy programs

    Leaders must overcome several barriers in developing a customer advocacy program:

    • Stakeholders are often unclear on the value customer advocacy programs can bring and require proof of benefits to invest.
    • Efforts are duplicated among sales, marketing, product, and customer success teams, given ownership and collaboration practices are ill-defined or nonexistent.
    • There is a culture of guarding or hoarding customer relationships by those who feel they own the relationship, or there’s high turnover among employees who own the customer relationships.
    • The governance, technology, people, skills, and/or processes to take customer advocacy to the next level are lacking.
    • Leaders don’t know where to start with customer advocacy, what needs to be improved, or what to focus on first.

    A lack of customer centricity hurts organizations

    12% of people believe when a company says they put customers first. (Source: HubSpot, 2019)

    Brands struggle to follow through on brand promises, and a mismatch between expectations and lived experience emerges. Customer advocacy can help close this gap and help companies live up to their customer-first messaging.

    42% of companies don’t conduct any customer surveys or collect feedback. (Source: HubSpot, 2019)

    Too many companies are not truly listening to their customers. Companies that don’t collect feedback aren’t going to know what to change to improve customer satisfaction. Customer advocacy will orient companies around their customer and create a reliable feedback loop that informs product and service enhancements.

    Customer advocacy is no longer a nice-to-have but a necessity for solution providers

    B2B buyers increasingly turn to peers to learn about solutions:

    “84% of B2B decision makers start the buying process with a referral.” (Source: Influitive, Gainsight & Pendo, 2020)

    “46% of B2B buyers rely on customer references for information before purchasing.” (Source: RO Innovation, 2017)

    “91% of B2B purchasers’ buying decisions are influenced by word-of-mouth recommendations.” (Source: ReferralRock, 2022)

    “76% of individuals admit that they’re more likely to trust content shared by ‘normal’ people than content shared by brands.” (Source: TrustPilot, 2020)

    By ignoring the importance of customer advocacy, companies and brands are risking stagnation and missing out on opportunities to gain competitive advantage and achieve growth.

    Getting Started With Customer Advocacy: SoftwareReviews' Approach

    1 BUILD
    Build the business case
    Identify your key stakeholders, steering committee, and working team, understand key customer advocacy principles, and note success barriers and ways to overcome them as your first steps.

    2 DEVELOP
    Develop your advocacy requirements
    Assess your current customer advocacy maturity, identify gaps in your current efforts, and develop your ideal advocate profile.

    3 WIN
    Win executive approval and implement pilot
    Determine goals and success metrics for the pilot, establish a timeline and key project milestones, create advocate communication materials, and finally gain executive buy-in and implement the pilot.

    SoftwareReviews Insight
    Building and implementing a customer advocacy pilot will help lay the foundation for a full program and demonstrate to executives and key stakeholders the impact on revenue, retention, and CLV that can be achieved through coordinated and well-planned customer advocacy efforts.

    Customer advocacy benefits

    Our research benefits customer advocacy program managers by enabling them to:

    • Explain why having a centralized, proactive customer advocacy program is important.
    • Clearly communicate the benefits and business case for having a formalized customer advocacy program.
    • Develop a customer advocacy pilot to provide a proof of concept (POC) and demonstrate the value of customer advocacy.
    • Assess the maturity of your current customer advocacy efforts and identify what to improve and how to improve to grow your customer advocacy function.

    "Advocacy is the currency for business and the fuel for explosive growth. Successful marketing executives who understand this make advocacy programs an essential part of their go-to-market strategy. They also know that advocacy isn't something you simply 'turn on': ... ultimately, it's about making human connections and building relationships that have enduring value for everyone involved."
    - Dan Cote, Influitive, Dec. 2021

    Case Study: Advocate impact on sales at Genesys

    Genesys' Goal

    Provide sales team with compelling customer reviews, quotes, stories, videos, and references.

    Approach to Advocacy

    • Customers were able to share their stories through Genesys' customer hub GCAP as quotes, reviews, etc., and could sign up to host reference forum sessions for prospective customers.
    • Content was developed that demonstrated ROI with using Genesys' solutions, including "top-tier logos, inspiring quotes, and reference forums featuring some of their top advocates" (Influitive, 2021).
    • Leveraged customer advocacy-specific software solution integration with the CRM to easily identify reference recommendations for Sales.

    Advocate Impact on Sales

    According to Influitive (2021), the impacts were:

    • 386% increase in revenue influences from references calls
    • 82% of revenue has been influence by reference calls
    • 78 reference calls resulted in closed-won opportunities
    • 250 customers and prospects attended 7 reference forums
    • 112 reference slides created for sales enablement
    • 100+ quotes were collect and transformed into 78 quote slides

    Who benefits from getting started with customer advocacy?

    This Research Is Designed for:

    • Customer advocacy leaders and marketers who are looking to:
      • Take a more strategic, proactive, and structured approach to customer advocacy.
      • Find a more effective and reliable way to gather customer feedback and input on products and services.
      • Develop and nurture a customer-oriented mindset throughout the organization.
      • Improve marketing credibility both within the company and outside to prospective customers.

    This Research Will Help You:

    • Explain why having a centralized, proactive customer advocacy program is important.
    • Clearly communicate the benefits and business case for having a formalized customer advocacy program.
    • Develop a customer advocacy pilot to provide a proof of concept (POC) and demonstrate the value of customer advocacy.
    • Assess the maturity of your current customer advocacy efforts and identify what to improve and how to improve to grow your customer advocacy function.

    This Research Will Also Assist:

    • Customer success leaders and sales directors who are responsible for:
      • Gathering customer references and testimonials.
      • Referral or voice of the customer (VoC) programs.

    This Research Will Help Them:

    • Align stakeholders on an overall program of identifying ideal advocates.
    • Coordinate customer advocacy efforts and actions.
    • Gather and make use of customer feedback to improve products, solutions, and service provided.
    • Provide an amazing customer experience throughout the entirety of the customer journey.

    SoftwareReviews’ methodology for getting started with customer advocacy

    Phase Steps

    1. Build the business case

    1. Identify your key stakeholders, steering committee, and working team
    2. Understand the concepts and benefits of customer advocacy as they apply to your organization
    3. Outline barriers to success, risks, and risk mitigation tactics

    2. Develop your advocacy requirements

    1. Assess your customer advocacy maturity using the SoftwareReviews CA Maturity Assessment Tool
    2. Identify gaps/pains in current CA efforts and add tasks to your action plan
    3. Develop ideal advocate profile/identify target advocate segment(s)

    3. Create implementation plan and pitch CA pilot

    1. Determine pilot goals and success metrics
    2. Establish timeline and create advocate communication materials
    3. Gain executive buy-in and implement pilot

    Phase Outcomes

    1. Common understanding of CA concepts and benefits
    2. Buy-in from CEO and head of Sales
    3. List of opportunities, risks, and risk mitigation tactics
    1. Identification of gaps in current customer advocacy efforts and/or activities
    2. Understanding customer advocacy readiness
    3. Identification of ideal advocate profile/target segment
    4. Basic actions to bridge gaps in CA efforts
    1. Clear objective for CA pilot
    2. Key metrics for program success
    3. Pilot timelines and milestones
    4. Executive presentation with business case for CA

    Insight summary

    Customer advocacy is a critical strategic growth initiative
    Customer advocacy (CA) has evolved into being a highly valued company asset as opposed to a simple referral program, but not everyone in the organization sees it that way. Customer success leaders must reposition their CA program around growth instead of focusing solely on retention and communicate this to key stakeholders. The recognition that customer advocacy is a strategic growth initiative is necessary to succeed in today’s competitive market.

    Get key stakeholders on board early – especially Sales!
    Work to bring the CEO and the head of Sales on your side early. Sales is the gatekeeper – they need to open the door to customers to turn them into advocates. Clearly reposition CA for growth and communicate that to the CEO and head of Sales; wider buy-in will follow.

    Identify the highest priority segment for generating acts of advocacy
    By focusing on the highest priority segment, you accomplish a number of things: generating growth in a critical customer segment, proving the value of customer advocacy to key stakeholders (especially Sales), and setting a strong foundation for customer advocacy to build upon and expand the program out to other segments.

    Always link your CA efforts back to retention and growth
    By clearly demonstrating the impact that customer advocacy has on not only retention but also overall growth, marketers will gain buy-in from key stakeholders, secure funding for a full CA program, and gain the resources needed to expand customer advocacy efforts.

    Focus on providing value to advocates
    Many organizations take a transactional approach to customer advocacy, focusing on what their advocates can do for them. To truly succeed with CA, focus on providing your advocates with value first and put them in the spotlight.

    Make building genuine relationships with your advocates the cornerstone of your CA program
    "57% of small businesses say that having a relationship with their consumers is the primary driver of repeat business" (Factory360).

    Guided Implementation

    What does our GI on getting started with building customer advocacy look like?

    Build the Business Case

    Call #1: Identify key stakeholders. Map out motivations and anticipate any concerns or objections. Determine steering committee and working team. Plan next call – 1 week.

    Call #2: Discuss concepts and benefits of customer advocacy as they apply to organizational goals. Plan next call – 1 week.

    Call #3: Discuss barriers to success, risks, and risk mitigation tactics. Plan next call – 1 week.

    Call #4: Finalize CA goals, opportunities, and risks and develop business case. Plan next call – 2 weeks.

    Develop Your Advocacy Requirements

    Call #5: Review the SoftwareReviews CA Maturity Assessment Tool. Assess your current level of customer advocacy maturity. Plan next call – 1 week.

    Call #6: Review gaps and pains in current CA efforts. Discuss tactics and possible CA pilot program goals. Begin adding tasks to action plan. Plan next call – 2 weeks.

    Call #7: Discuss ideal advocate profile and target segments. Plan next call – 2 weeks.

    Call #8: Validate and finalize ideal advocate profile. Plan next call – 1 week.

    Win Executive Approval and Implement Pilot

    Call #9: Discuss CA pilot scope. Discuss performance metrics and KPIs. Plan next call – 3 days.

    Call #10: Determine timeline and key milestones. Plan next call –2 weeks.

    Call #11: Develop advocate communication materials. Plan next call – 3 days.

    Call #12: Review final business case and coach on executive presentation. Plan next call – 1 week.

    A Guided Implementation (GI) is series of calls with a SoftwareReviews Advisory analyst to help implement our best practices in your organization. For guidance on marketing applications, we can arrange a discussion with an Info-Tech analyst. Your engagement managers will work with you to schedule analyst calls.

    Customer Advocacy Workshop

    Pre-Workshop Day 1 Day 2 Day 3 Day 4 Day 5 Post-Workshop
    Activities Identify Stakeholders & CA Pilot Team Build the Business Case Assess Current CA Efforts Develop Advocacy Goals & Ideal Advocate Profile Develop Project Timelines, Materials, and Exec Presentation Next Steps and Wrap-Up (offsite) Pitch CA Pilot
    0.1 Identify key stakeholders to involve in customer advocacy pilot and workshop; understand their motivations and anticipate possible concerns. 1.1 Review key CA concepts and identify benefits of CA for the organization.
    1.2 Outline barriers to success, risks, and risk mitigation tactics.
    2.1 Assess your customer advocacy maturity using the SoftwareReviews CA Maturity Assessment Tool.
    2.2 Identify gaps/pains in current CA efforts.
    2.3 Prioritize gaps from diagnostic and any other critical pain points.
    3.1 Identify and document the ideal advocate profile and target customer segment for pilot.
    3.2 Determine goal(s) and success metrics for program pilot.
    4.1 Develop pilot timelines and key milestones.
    4.2 Outline materials needed and possible messaging.
    4.3 Build the executive buy-in presentation.
    5.1 Complete in-progress deliverables from the previous four days. 6.1 Present to executive team and stakeholders.
    6.2 Gain executive buy-in and key stakeholder approval.
    6.3 Execute CA pilot.
    Deliverables
    1. Rationale for CA pilot; clear benefits, and how they apply to the organization.
    2. Documented barriers to success, risks, and risk mitigation tactics.
    1. CA Maturity Assessment results.
    2. Identification of gaps in current customer advocacy efforts and/or activities.
    1. Documented ideal advocate profile/target customer segment.
    2. Clear goal(s) and success metrics for CA pilot.
    1. Documented pilot timelines and key milestones.
    2. Draft/outlines of advocate materials.
    3. Draft executive presentation with business case for CA.
    1. Finalized implementation plan for CA pilot.
    2. Finalized executive presentation with business case for CA.
    1. Buy-in from decision makers and key stakeholders.

    Contact your account representative for more information.
    workshops@infotech.com
    1-888-670-8889

    Get started!

    Know your target market and audience, deploy well-designed strategies based on shared values, and make meaningful connections with people.

    Phase 1
    Build the Business Case

    Phase 2
    Develop Your Advocacy Requirements

    Phase 3
    Win Executive Approval and Implement Pilot

    Phase 1: Build the Business Case

    Steps
    1.1 Identify your key stakeholders, steering committee, and working team
    1.2 Understand the concepts and benefits of customer advocacy as they apply to your organization
    1.3 Outline barriers to success, risks, and risk mitigation tactics

    Phase Outcome

    • Common understanding of CA concepts and benefits
    • Buy-in from CEO and head of Sales
    • List of barriers to success, risks, and risk mitigation tactics

    Build the business case

    Step 1.1 Identify your key stakeholders, steering committee, and working team

    Total duration: 2.5-8.0 hours

    Objective
    Identify, document, and finalize your key stakeholders to know who to involve and how to get them onboard by truly understanding the forces of influence.

    Output

    • Robust stakeholder list with key stakeholders identified.
    • Steering committee and working team decided.

    Participants

    • Customer advocacy lead
    • Identified stakeholders
    • Workstream leads

    MarTech
    None

    Tools

    1.1.1 Identify Stakeholders
    (60-120 min.)

    Identify
    Using the guidance on slide 28, identify all stakeholders who would be involved or impacted by your customer advocacy pilot by entering names and titles into columns A and B on slide 27 "Stakeholder List Worksheet."

    Document
    Document as much information about each stakeholder as possible in columns C, D, E, and F into the table on slide 27.

    1.1.2 Select Steering Committee & Working Team
    (60-90 min.)

    Select
    Using the guidance on slides 28 and 29 and the information collected in the table on slide 27, identify the stakeholders that are steering committee members, functional workstream leads, or operations; document in column G on slide 27.

    Document
    Open the Executive Presentation Template to slides 5 and 6 and document your final steering committee and working team selections. Be sure to note the Executive Sponsor and Program Manager on slide 5.

    Tips & Reminders

    1. It is critical to identify "key stakeholders"; a single missed key stakeholder can disrupt an initiative. A good way to ensure that nobody is missed is to first uncover as many stakeholders as possible and later decide how important they are.
    2. Ensure steering committee representation from each department this initiative would impact or that may need to be involved in decision-making or problem-solving endeavors.

    Consult Info-Tech's Manage Stakeholder Relations blueprint for additional guidance on identifying and managing stakeholders, or contact one of our analysts for more personalized assistance and guidance.

    Stakeholder List Worksheet

    *Possible Roles
    Executive Sponsor
    Program Manager
    Workstream Lead
    Functional Lead
    Steering Committee
    Operations
    A B C D E F G
    Name Position Decision Involvement
    (Driver / Approver / Contributor / Informe
    Direct Benefit?
    (Yes / No)
    Motivation Concerns *Role in Customer Advocacy Pilot
    E.g. Jane Doe VP, Customer Success A N
    • Increase customer retention
    • Customer advocate burnout
    Workstream Lead

    Customer advocacy stakeholders

    What to consider when identifying stakeholders required for CA:
    Customer advocacy should be done as a part of a cross-functional company initiative. When identifying stakeholders, consider:

    • Who can make the ultimate decision on approving the CA program?
    • Who are the senior leadership members you need buy-in from?
    • Who do you need to support the CA program?
    • Who is affected by the CA program?
    • Who will help you build the CA program?
    • Where and among who is there enthusiasm for customer advocacy?
    • Consider stakeholders from Customer Success, Marketing, Sales, Product, PR & Social, etc.
    Key Roles Supporting an Effective Customer Advocacy Pilot
    Executive Sponsor
    • Owns the function at the management/C-suite level
    • Responsible for breaking down barriers and ensuring alignment with organizational strategy
    • CMO, VP of Marketing, and in SMB providers, the CEO
    Program Manager
    • Typically, a senior member of the marketing team
    • Responsible for organizing the customer advocacy pilot, preparing summary executive-level communications, and approval requests
    • Program manages the customer advocacy pilot, and in many cases, the continued formal program
    • Product Marketing Director, or other Marketing Director, who has strong program management skills, has run large-scale marketing or product programs, and is familiar with the stakeholder roles and enabling technologies
    Functional / Workstream Leads
    • Works alongside the Program Manager on planning and implementing the customer advocacy pilot and ensures functional workstreams are aligned with pilot objectives
    • Typical customer advocacy pilots will have a team comprised of representatives from Marketing, Sales, and Customer Success
    Steering Committee
    • Comprised of C-suite/management-level individuals that guide key decisions, approve requests, and mitigate any functional conflicts
    • Responsible for validating goals and priorities, enabling adequate resourcing, and critical decision making
    • CMO, CRO/Head of Sales, Head of Customer Success
    Operations
    • Comprised of individuals whose application and tech tools knowledge and skills support integration of customer advocacy functions into existing tech stack/CRM (e.g. adding custom fields into CRM)
    • Responsible for helping select technology that enables customer advocacy program activities
    • CRM, Marketing Applications, and Analytics Managers, IT Managers

    Customer advocacy working team

    Consider the skills and knowledge required for planning and executing a customer advocacy pilot.

    Workstream leads should have strong project management and collaboration skills and deep understanding of both product and customers (persona, journeys, satisfaction, etc.).

    Required Skills Suggested Functions
    • Project management
    • CRM knowledge
    • Marketing automation experience
    • MarTech knowledge
    • Understanding of buyer persona and journey
    • Product knowledge
    • Understanding of executive-level goals for the pilot
    • Content creation
    • Customer advocacy experience, if possible
    • Customer satisfaction
    • Email and event marketing experience
    • Customer Success
    • Marketing
    • Sales
    • Product
    • PR/Corporate Comms.

    Build the business case

    Step 1.2 Understand key concepts and benefits of customer advocacy

    Total duration: 2.0-4.0 hours

    Objective
    Understand customer advocacy and what benefits you seek from your customer advocacy program, and get set up to best communicate them to executives and decision makers.

    Output

    • Documented customer advocacy benefits

    Participants

    • Customer advocacy lead

    MarTech
    None

    Tools

    1.2.1 Discuss Key Concepts
    (60-120 min.)

    Envision
    Schedule a visioning session with key stakeholders and share the Get Started With Customer Advocacy Executive Brief (slides 3-23 in this deck).

    Discuss how key customer advocacy concepts can apply to your organization and how CA can contribute to organizational growth.

    Document
    Determine the top benefits sought from the customer advocacy program pilot and record them on slides 4 and 12 in the Executive Presentation Template.

    Finalize
    Work with the Executive Sponsor to finalize the "Message from the CMO" on slide 4 in the Executive Presentation Template.

    Tips & Reminders

    Keep in mind that while we're starting off broadly, the pilot for your customer advocacy program should be narrow and focused in scope.

    Build the business case

    Step 1.3 Understand barriers to success, risks, and risk mitigation tactics

    Total duration: 2.0-8.0 hours

    Objective
    Anticipate threats to pilot success; identify barriers to success, any possible risks, and what can be done to reduce the chances of a negative pilot outcome.

    Output

    • Awareness of barriers
    • Tactics to mitigate risk

    Participants

    • Customer advocacy lead
    • Key stakeholders

    MarTech
    None

    Tools

    1.3.1 Brainstorm Barriers to Success & Possible Risks
    (60-120 min.)

    Identify
    Using slide 7 of the Executive Presentation Template, brainstorm any barriers to success that may exist and risks to the customer advocacy program pilot success. Consider the people, processes, and technology that may be required.

    Document
    Document all information on slide 7 of the Executive Presentation Template.

    1.3.2 Develop Risk Mitigation Tactics
    (60-300 min.)

    Develop
    Brainstorm different ways to address any of the identified barriers to success and reduce any risks. Consider the people, processes, and technology that may be required.

    Document
    Document all risk mitigation tactics on slide 7 of the Executive Presentation Template.

    Tips & Reminders
    There are several types of risk to explore. Consider the following when brainstorming possible risks:

    • Damage to brand (if advocate guidance not provided)
    • Legal (compliance with regulations and laws around contact, incentives, etc.)
    • Advocate burnout
    • Negative advocate feedback

    Phase 2: Develop Your Advocacy Requirements

    Steps
    2.1 Assess your customer advocacy maturity
    2.2 Identify and document gaps and pain points
    2.3 Develop your ideal advocate profile

    Phase Outcome

    • Identification of gaps in current customer advocacy efforts or activities
    • Understanding of customer advocacy readiness and maturity
    • Identification of ideal advocate profile/target segment
    • Basic actions to bridge gaps in CA efforts

    Develop your advocacy requirements

    Step 2.1 Assess your customer advocacy maturity

    Total duration: 2.0-8.0 hours

    Objective
    Use the Customer Advocacy Maturity Assessment Tool to understand your organization's current level of customer advocacy maturity and what to prioritize in the program pilot.

    Output

    • Current level of customer advocacy maturity
    • Know areas to focus on in program pilot

    Participants

    • Customer advocacy lead
    • Key stakeholders

    MarTech
    None

    Tools

    2.1.1 Diagnose Current Customer Advocacy Maturity
    (60-120 min.)

    Diagnose
    Begin on tab 1 of the Customer Advocacy Maturity Assessment Tool and read all instructions.

    Navigate to tab 2. Considering the current state of customer advocacy efforts, answer the diagnostic questions in the Diagnostic tab of the Customer Advocacy Maturity Assessment Tool.

    After completing the questions, you will receive a diagnostic result on tab 3 that will identify areas of strength and weakness and make high-level recommendations for your customer advocacy program pilot.

    2.1.2 Discuss Results
    (60-300 min.)

    Discuss
    Schedule a call to discuss your customer advocacy maturity diagnostic results with a SoftwareReviews Advisor.

    Prioritize the recommendations from the diagnostic, noting which will be included in the program pilot and which require funding and resources to advance.

    Transfer
    Transfer results into slides 8 and 11 of the Executive Presentation Template.

    Tips & Reminders
    Complete the diagnostic with a handful of key stakeholders identified in the previous phase. This will help provide a more balanced and accurate assessment of your organization’s current level of customer advocacy maturity.

    Develop your advocacy requirements

    Step 2.2 Identify and document gaps and pain points

    Total duration: 2.5-8.0 hours

    Objective
    Understand the current pain points within key customer-related processes and within any current customer advocacy efforts taking place.

    Output

    • Prioritized list of pain points that could be addressed by a customer advocacy program.

    Participants

    • Customer advocacy lead
    • Key stakeholders

    MarTech
    None

    Tools

    2.2.1 Identify Pain Points
    (60-120 min.)

    Identify
    Identify and list current pain points being experienced around customer advocacy efforts and processes around sales, marketing, customer success, and product feedback.

    Add any gaps identified in the diagnostic to the list.

    Transfer
    Transfer key information into slide 9 of Executive Presentation Template.

    2.2.2 Prioritize Pain Points
    (60-300 min.)

    Prioritize
    Indicate which pains are the most important and that a customer advocacy program could help improve.

    Schedule a call to discuss the outputs of this step with a SoftwareReviews Advisor.

    Document
    Document priorities on slide 9 of Executive Presentation Template.

    Tips & Reminders

    Customer advocacy won't solve for everything; it's important to be clear about what pain points can and can't be addressed through a customer advocacy program.

    Develop your advocacy requirements

    Step 2.3 Develop your ideal advocate profile

    Total duration: 3.0-9.0 hours

    Objective
    Develop an ideal advocate persona profile that can be used to identify potential advocates, guide campaign messaging, and facilitate advocate engagement.

    Output

    • Ideal advocate persona profile

    Participants

    • Customer advocacy lead
    • Key stakeholders
    • Sales lead
    • Marketing lead
    • Customer Success lead
    • Product lead

    MarTech
    May require the use of:

    • CRM or marketing automation platform
    • Available and up-to-date customer database

    Tools

    2.3.1 Brainstorm Session Around Ideal Advocate Persona
    (60-150 min.)

    Brainstorm
    Lead the team to prioritize an initial, single, most important persona and to collaborate to complete the template.

    Choose your ideal advocate for the pilot based on your most important audience. Start with firmographics like company size, industry, and geography.

    Next, consider satisfaction levels and behavioral attributes, such as renewals, engagement, usage, and satisfaction scores.

    Identify motivations and possible incentives for advocate activities.

    Document
    Use slide 10 of the Executive Presentation Template to complete this exercise.

    2.3.2 Review and Refine Advocate Persona
    (60-300 min.)

    Review & Refine
    Place the Executive Presentation Template in a shared drive for team collaboration. Encourage the team to share persona knowledge within the shared drive version.

    Hold any necessary follow-up sessions to further refine persona.

    Validate
    Interview advocates that best represent your ideal advocate profile on their type of preferred involvement with your company, their role and needs when it comes to your solution, ways they'd be willing to advocate, and rewards sought.

    Confirm
    Incorporate feedback and inputs into slide 10 of the Executive Presentation Template. Ensure everyone agrees on persona developed.

    Tips & Reminders

    1. When identifying potential advocates, choose based on your most important audience.
    2. Ensure you're selecting those with the highest satisfaction scores.
    3. Ideally, select candidates that have, on their own, advocated previously such as in social posts, who may have acted as a reference, or who have been highly visible as a positive influence at customer events.
    4. Knowing motivations will determine the type of acts of advocacy they would be most willing to perform and the incentives for participating in the program.

    Consider the following criteria when identifying advocates and developing your ideal advocate persona:

    Demographics Firmographics Satisfaction & Needs/Value Sought Behavior Motivation
    Role - user, decision-maker, etc. Company size: # of employees Satisfaction score Purchase frequency & repeat purchases (renewals), upgrades Career building/promotion
    Department Company size: revenue NPS score Usage Collaboration with peers
    Geography CLV score Engagement (e.g. email opens, response, meetings) Educate others
    Industry Value delivered (outcomes, occasions used, etc.) Social media interaction, posts Influence (on product, service)
    Tenure as client Benefits sought
    Account size ($) Minimal and resolved service tickets, escalations
    1. When identifying potential advocates, choose based on your most important audience/segments. 2. Ensure you're selecting those with the highest satisfaction, NPS, and CLV scores. 3. When identifying potential advocates, choose based on high engagement and interaction, regular renewals, and high usage. 4. Knowing motivations will determine the type of acts of advocacy they would be most willing to perform and incentives for participating in the program.

    Phase 3: Win Executive Approval and Implement Pilot

    Steps
    3.1 Determine pilot goals and success metrics
    3.2 Establish timeline and create advocate communication materials
    3.3 Gain executive buy-in and implement pilot

    Phase Outcome

    • Clear objective for CA pilot
    • Key metrics for program success
    • Pilot timelines and milestones
    • Executive presentation with business case for CA

    Win executive approval and implement pilot

    Step 3.1 Determine pilot goals and success metrics

    Total duration: 2.0-4.0 hours

    Objective
    Set goals and determine the scope for the customer advocacy program pilot.

    Output

    • Documented business objectives for the pilot
    • Documented success metrics

    Participants

    • Customer advocacy lead
    • Key stakeholders
    • Sales lead
    • Marketing lead
    • Customer Success lead
    • Product lead

    MarTech
    May require to use, set up, or install platforms like:

    • Register to a survey platform
    • CRM or marketing automation platform

    Tools

    3.1.1 Establish Pilot Goals
    (60-120 min.)

    Set
    Organize a meeting with department heads and review organizational and individual department goals.

    Using the Venn diagram on slide 39 in this deck, identify customer advocacy goals that align with business goals. Select the highest priority goal for the pilot.

    Check that the goal aligns with benefits sought or addresses pain points identified in the previous phase.

    Document
    Document the goals on slides 9 and 16 of the Executive Presentation Template.

    3.1.2 Establish Pilot Success Metrics
    (60-120 min.)

    Decide
    Decide how you will measure the success of your program pilot using slide 40 in this document.

    Document
    Document metrics on slide 16 of the Executive Presentation Template.

    Tips & Reminders

    1. Don't boil the ocean. Pick the most important goal that can be achieved through the customer advocacy pilot to gain executive buy-in and support or resources for a formal customer advocacy program. Once successfully completed, you'll be able to tackle new goals and expand the program.
    2. Keep your metrics simple, few in number, and relatively easy to track

    Connect customer advocacy goals with organizational goals

    List possible customer advocacy goals, identifying areas of overlap with organizational goals by taking the following steps:

    1. List organizational/departmental goals in the green oval.
    2. List possible customer advocacy program goals in the purple oval.
    3. Enter goals that are covered in both the Organizational Goals and Customer Advocacy Goals sections into the Shared Goals section in the center.
    4. Highlight the highest priority goal for the customer advocacy program pilot to tackle.
    Organizational Goals Shared Goals Customer Advocacy Goals
    Example Example: Gain customer references to help advance sales and improve win rates Example: Develop pool of customer references
    [insert goal] [insert goal] Example: Gather customer feedback
    [insert goal] [insert goal] [insert goal]
    [insert goal] [insert goal] [insert goal]

    Customer advocacy success metrics for consideration

    This table provides a starting point for measuring the success of your customer advocacy pilot depending on the goals you've set.

    This list is by no means exhaustive; the metrics here can be used, or new metrics that would better capture success measurement can be created and tracked.

    Metric
    Revenue influenced by reference calls ($ / % increase)
    # of reference calls resulting in closed-won opportunities
    # of quotes collected
    % of community growth YoY
    # of pieces of product feedback collected
    # of acts of advocacy
    % membership growth
    % product usage amongst community members
    # of social shares, clicks
    CSAT score for community members
    % of registered qualified leads
    # of leads registered
    # of member sign-ups
    # of net-new referenceable customers
    % growth rate of products used by members
    % engagement rate
    # of published third-party reviews
    % increase in fulfilled RFPs

    When selecting metrics, remember:
    When choosing metrics for your customer advocacy pilot, be sure to align them to your specific goals. If possible, try to connect your advocacy efforts back to retention, growth, or revenue.

    Do not choose too many metrics; one per goal should suffice.

    Ensure that you can track the metrics you select to measure - the data is available and measuring won't be overly manual or time-consuming.

    Win executive approval and implement pilot

    Step 3.2 Establish timeline and create advocate communication materials

    Total duration: 2.5-8.0 hours

    Objective
    Outline who will be involved in what roles and capacities and what tasks and activities need to completed.

    Output

    • Timeline and milestones
    • Advocate program materials

    Participants

    • Customer advocacy lead
    • Key stakeholders
    • Sales lead
    • Marketing lead
    • Customer Success lead
    • Product lead

    MarTech
    None

    Tools

    3.2.1 Establish Timeline & Milestones
    (30-60 min.)

    List & Assign
    List all key tasks, phases, and milestones on slides 13, 14, and 15 in the Executive Presentation Template.

    Include any activities that help close gaps or address pain points from slide 9 in the Executive Presentation Template.

    Assign workstream leads on slide 15 in the Executive Presentation Template.

    Finalize all tasks and activities with working team.

    3.2.2 Design & Build Advocate Program Materials
    (180-300 min.)

    Decide
    Determine materials needed to recruit advocates and explain the program to advocate candidates.

    Determine the types of acts of advocacy you are looking for.

    Determine incentives/rewards that will be provided to advocates, such as access to new products or services.

    Build
    Build out all communication materials.

    Obtain incentives.

    Tips & Reminders

    1. When determining incentives, use the validated ideal advocate profile for guidance (i.e. what motivates your advocates?).
    2. Ensure to leave a buffer in the timeline if the need to adjust course arises.

    Win executive approval and implement pilot

    Step 3.3 Implement pilot and gain executive buy-in

    Total duration: 2.5-8.0 hours

    Objective
    Successfully implement the customer advocacy pilot program and communicate results to gain approval for full-fledged program.

    Output

    • Deliver Executive Presentation
    • Successful customer advocacy pilot
    • Provide regular updates to stakeholders, executives

    Participants

    • Customer advocacy lead
    • Workstream leads

    MarTech
    May require the use of:

    • CRM or Marketing Automation Platform
    • Available and up-to-date customer database

    Tools

    3.3.1 Complete & Deliver Executive Presentation
    (60-120 min.)

    Present
    Finalize the Executive Presentation.

    Hold stakeholder meeting and introduce the program pilot.

    3.3.2 Gain Executive Buy-in
    (60-300 min.)

    Pitch
    Present the final results of the customer advocacy pilot using the Executive Presentation Template and gain approval.

    3.3.3 Implement the Customer Advocacy Program Pilot
    (30-60 min.)

    Launch
    Launch the customer advocacy program pilot. Follow the timelines and activities outlined in the Executive Presentation Template. Track/document all advocate outreach, activity, and progress against success metrics.

    Communicate
    Establish a regular cadence to communicate with steering committee, stakeholders. Use the Executive Presentation Template to present progress and resolve roadblocks if/as they arise.

    Tips & Reminders

    1. Continually collect feedback and input from advocates and stakeholders throughout the process.
    2. Don't be afraid to make changes on the go if it helps to achieve the end goal of your pilot.
    3. If the pilot program was successful, consider scaling it up and rolling it out to more customers.

    Summary of Accomplishment

    Mission Accomplished

    • You successfully launched your customer advocacy program pilot and demonstrated clear benefits and ROI. By identifying the needs of the business and aligning those needs with key customer advocacy activities, marketers and customer advocacy leaders can prioritize the most important tasks for the pilot while also identifying potential opportunities for expansion pending executive approval.
    • SoftwareReviews' comprehensive and tactical approach takes you through the steps to build the foundation for a strategic customer advocacy program. Our methodology ensures that a customer advocacy pilot is developed to deliver the desired outcomes and ROI, increasing stakeholder buy-in and setting up your organization for customer advocacy success.

    If you would like additional support, contact us and we'll make sure you get the professional expertise you need.

    Contact your account representative for more information.
    info@softwarereviews.com
    1-888-670-8889

    Related SoftwareReviews Research

    Measure and Manage the Customer Satisfaction Metrics That Matter the Most
    Understand what truly keeps your customer satisfied. Measure what matters to improve customer experience and increase satisfaction and advocacy.

    • Understand the true drivers of satisfaction and dissatisfaction among your customer segments.
    • Establish process and cadence for effective satisfaction measurement and monitoring.
    • Know where resources are needed most to improve satisfaction levels and increase retention.

    Develop the Right Message to Engage Buyers
    Sixty percent of marketers find it hard to produce high-quality content consistently. SaaS marketers have an even more difficult job due to the technical nature of content production.

    • Create more compelling and relevant content that aligns with a buyer's needs and journey.
    • Shrink marketing and sales cycles.
    • Increase the pace of content production.

    Create a Buyer Persona and Journey
    Get deeper buyer understanding and achieve product-market fit, with easier access to market and sales.

    • Reduce time and resources wasted chasing the wrong prospects.
    • Increase open and click-through rates.
    • Perform more effective sales discovery.
    • Increase win rate.

    Bibliography

    "15 Award-Winning Customer Advocacy Success Stories." Influitive, 2021. Accessed 8 June 2023.

    "Advocacy Marketing." Influitive, June 2016. Accessed 26 Oct. 2021.

    Andrews, Marcus. "42% of Companies Don’t Listen to their Customers. Yikes." HubSpot, June 2019. Accessed 2 Nov. 2021.

    "Before you leap! Webcast." Point of Reference, Sept. 2019. Accessed 4 Nov. 2021.

    "Brand Loyalty: 5 Interesting Statistics." Factory360, Jan. 2016. Accessed 2 Nov. 2021.

    Brenner, Michael. "The Data Driven Guide to Customer Advocacy." Marketing Insider Group, Sept. 2021. Accessed 3 Feb. 2022.

    Carroll, Brian. "Why Customer Advocacy Should Be at the Heart of Your Marketing." Marketing Insider Group, Sept. 2017. Accessed 3 Feb. 2022.

    Cote, Dan. "Advocacy Blooms and Business Booms When Customers and Employees Engage." Influitive, Dec. 2021. Accessed 3 Feb. 2022.

    "Customer Success Strategy Guide." ON24, Jan. 2021. Accessed 2 Nov. 2021.

    Dalao, Kat. "Customer Advocacy: The Revenue-Driving Secret Weapon." ReferralRock, June 2017. Accessed 7 Dec. 2021.

    Frichou, Flora. "Your guide to customer advocacy: What is it, and why is it important?" TrustPilot, Jan. 2020. Accessed 26 Oct. 2021.

    Gallo, Amy. "The Value of Keeping the Right Customers." Harvard Business Review, Oct. 2014. Accessed 10 March 2022.

    Huhn, Jessica. "61 B2B Referral Marketing Statistics and Quotes." ReferralRock, March 2022. Accessed 10 March 2022.

    Kemper, Grayson. "B2B Buying Process: How Businesses Purchase B2B Services and Software." Clutch, Feb. 2020. Accessed 6 Jan. 2022.

    Kettner, Kyle. "The Evolution of Ambassador Marketing." BrandChamp.io, Oct. 2018. Accessed 2 Nov. 2021.

    Landis, Taylor. "Customer Retention Marketing vs. Customer Acquisition Marketing." OutboundEngine, April 2022. Accessed 23 April 2022.

    Miels, Emily. "What is customer advocacy? Definition and strategies." Zendesk Blog, June 2021. Accessed 27 Oct. 2021.

    Mohammad, Qasim. "The 5 Biggest Obstacles to Implementing a Successful B2B Customer Advocacy Program." HubSpot, June 2018. Accessed 6 Jan. 2022.

    Murphy, Brandon. "Brand Advocacy and Social Media - 2009 GMA Conference." Deloitte, Dec. 2009. Accessed 8 June 2023.

    Patel, Neil. "Why SaaS Brand Advocacy is More Important than Ever in 2021." Neil Patel, Feb. 2021. Accessed 4 Nov. 2021.

    Pieri, Carl. "The Plain-English Guide to Customer Advocacy." HubSpot, Apr. 2020. Accessed 27 Oct. 2021.

    Schmitt, Philipp; Skiera, Bernd; Van den Bulte, Christophe. "Referral Programs and Customer Value." Wharton Journal of Marketing, Jan. 2011. Accessed 8 June 2023.

    "The Complete Guide to Customer Advocacy." Gray Group International, 2020. Accessed 15 Oct. 2021.

    "The Customer-powered Enterprise: Playbook." Influitive, Gainsight & Pendo. 2020. Accessed 26 Oct. 2021.

    "The Winning Case for a Customer Advocacy Solution." RO Innovation, 2017. Accessed 26 Oct. 2021.

    Tidey, Will. "Acquisition vs. Retention: The Importance of Customer Lifetime Value." Huify, Feb. 2018. Accessed 10 Mar. 2022.

    "What a Brand Advocate Is and Why Your Company Needs One." RockContent, Jan. 2021. Accessed 7 Feb. 2022.

    "What is Customer Advocacy? A Definition and Strategies to Implement It." Testimonial Hero, Oct. 2021. Accessed 26 Jan. 2022.

    Annual CIO Survey Report 2024

    • Buy Link or Shortcode: {j2store}106|cart{/j2store}
    • member rating overall impact: N/A
    • member rating average dollars saved: N/A
    • member rating average days saved: N/A
    • Parent Category Name: Innovation
    • Parent Category Link: /innovation

    CIOs today face increasing pressures, disruptive emerging technologies, talent shortages, and a slew of other challenges. What are their top concerns, priorities, and technology bets that will define the future direction of IT?

    CIO responses to our Future of IT 2024 survey reveal key insights on spending projects, the potential disruptions causing the most concern, plans for adopting emerging technology, and how firms are responding to generative AI.

    See how CIOs are sizing up the opportunities and threats of the year ahead

    Map your organization’s response to the external environment compared to CIOs across geographies and industries. Learn:

    • The CIO view on continuing concerns such as cybersecurity.
    • Where they rate their IT department’s maturity.
    • What their biggest concerns and budget increases are.
    • How they’re approaching third-party generative AI tools.

    Annual CIO Survey Report 2024 Research & Tools

    Besides the small introduction, subscribers and consulting clients within this management domain have access to:

    1. Future of IT Survey 2024 – A summary of key insights from the CIO responses to our Future of IT 2024 survey.

    Take the pulse of the IT industry and see how CIOs are planning to approach 2024.

    • Annual CIO Survey Report for 2024
    [infographic]

    Further reading

    Annual CIO Survey Report 2024

    An inaugural look at what's on the minds of CIOs.

    1. Firmographics

    • Region
    • Title
    • Organization Size
    • IT Budget Size
    • Industry

    Firmographics

    The majority of CIO responses came from North America. Contributors represent regions from around the world.

    Countries / Regions Response %
    United States 47.18%
    Canada 11.86%
    Australia 9.60%
    Africa 6.50%
    China 0.28%
    Germany 1.13%
    United Kingdom 5.37%
    India 1.41%
    Brazil 1.98%
    Mexico 0.56%
    Middle East 4.80%
    Asia 0.28%
    Other country in Europe 4.52%

    n=354

    Firmographics

    A typical CIO respondent held a C-level position at a small to mid-sized organization.

    Half of CIOs hold a C-level position, 10% are VP-level, and 20% are director level

    Pie Chart of CIO positions

    38% of respondents are from an organization with above 1,000 employees

    Pie chart of size of organizations

    Firmographics

    A typical CIO respondent held a C-level position at a small to mid-sized organization.

    40% of CIOs report an annual budget of more than $10 million

    Pie chart of CIO annual budget

    A range of industries are represented, with 29% of respondents in the public sector or financial services

    Range of industries

    2. Key Factors

    • IT Maturity
    • Disruptive Factors
    • IT Spending Plans
    • Talent Shortage

    Two in three respondents say IT can deliver outcomes that Support or Optimize the business

    IT drives outcomes

    Most CIOs are concerned with cybersecurity disruptions, and one in four expect a budget increase of above 10%

    How likely is it that the following factors will disrupt your business in the next 12 months?

    Chart for factors that will disrupt your business

    Looking ahead to 2024, how will your organization's IT spending change compared to spending in 2023?

    Chart of IT spending change

    3. Adoption of Emerging Technology

    • Fastest growing tech for 2024 and beyond

    CIOs plan the most new spend on AI in 2024 and on mixed reality after 2024

    Top five technologies for new spending planned in 2024:

    1. Artificial intelligence - 35%
    2. Robotic process automation or intelligent process automation - 24%
    3. No-code/low-code platforms - 21%
    4. Data management solutions - 14%
    5. Internet of Things (IoT) - 13%

    Top five technologies for new spending planned after 2024:

    1. Mixed reality - 20%
    2. Blockchain - 19%
    3. Internet of Things (IoT) - 17%
    4. Robotics/drones - 16%
    5. Robotic process automation or intelligent process automation - 14%

    n=301

    Info-Tech Insight
    Three in four CIOs say they have no plans to invest in quantum computing, more than any other technology with no spending plans.

    4. Adoption of AI

    • Interest in generative AI applications
    • Tasks to be completed with AI
    • Progress in deploying AI

    CIOs are most interested in industry-specific generative AI applications or text-based

    Rate your business interest in adopting the following generative AI applications:

    Chart for interest in AI

    There is interest across all types of generative AI applications. CIOs are least interested in visual media generators, rating it just 2.4 out of 5 on average.

    n=251

    Info-Tech Insight
    Examples of generative AI solutions specific to the legal industry include Litigate, CoCounsel, and Harvey.

    By the end of 2024, CIOs most often plan to use AI for analytics and repetitive tasks

    Most popular use cases for AI by end of 2024:

    1. Business analytics or intelligence - 69%
    2. Automate repetitive, low-level tasks - 68%
    3. Identify risks and improve security - 66%
    4. IT operations - 62%
    5. Conversational AI or virtual assistants - 57%

    Fastest growing uses cases for AI in 2024:

    1. Automate repetitive, low-level tasks - 39%
    2. IT operations - 38%
    3. Conversational AI or virtual assistants - 36%
    4. Business analytics or intelligence - 35%
    5. Identify risks and improve security - 32%

    n=218

    Info-Tech Insight
    The least popular use case for AI is to help define business strategy, with 45% saying they have no plans for it.

    One in three CIOs are running AI pilots or are more advanced with deployment

    How far have you progressed in the use of AI?

    Chart of progress in use of AI

    Info-Tech Insight
    Almost half of CIOs say ChatGPT has been a catalyst for their business to adopt new AI initiatives.

    5. AI Risk

    • Perceived impact of AI
    • Approach to third-party AI tools
    • AI features in business applications
    • AI governance and accountability

    Six in ten CIOs say AI will have a positive impact on their organization

    What overall impact do you expect AI to have on your organization?

    Overall impact of AI on organization

    The majority of CIOs are waiting for professional-grade generative AI tools

    Which of the following best describes your organization's approach to third-party generative AI tools (such as ChatGPT or Midjourney)?

    Third-party generative AI

    Info-Tech Insight
    Business concerns over intellectual property and sensitive data exposure led OpenAI to announce ChatGPT won't use data submitted via its API for model training unless customers opt in to do so. ChatGPT users can also disable chat history to avoid having their data used for model training (OpenAI).

    One in three CIOs say they are accountable for AI, and the majority are exploring it cautiously

    Who in your organization is accountable for governance of AI?

    Governance of AI

    More than one-third of CIOs say no AI governance steps are in place today

    What AI governance steps does your organization have in place today?

    Chart of AI governance steps

    Among organizations that plan to invest in AI in 2024, 30% still say there are no steps in place for AI governance. The most popular steps to take are to publish clear explanations about how AI is used, and to conduct impact assessments (n=170).

    Chart of AI governance steps

    Among all CIOs, including those that do not plan to invest in AI next year, 37% say no steps are being taken toward AI governance today (n=243).

    6. Contribute to Info-Tech's Research Community

    • Volunteer to be interviewed
    • Attend LIVE in Las Vegas

    It's not too late; take the Future of IT online survey

    Contribute to our tech trends insights

    If you haven't already contributed to our Future of IT online survey, we are keeping the survey open to continue to collect insights and inform our research reports and agenda planning process. You can take the survey today. Those that complete the survey will be sent a complimentary Tech Trends 2024 report.

    Complete an interview for the Future of IT research project

    Help us chart the future course of IT

    If you are receiving this for completing the Future of IT online survey, thank you for your contribution. If you are interested in further participation and would like to provide a complementary interview, please get in touch at brian.Jackson@infotech.com. All interview subjects must also complete the online survey.

    If you've already completed an interview, thank you very much, and you can look forward to seeing more impacts of your contribution in the near future.

    LIVE 2023

    Methodology

    All data in this report is from Info-Tech's Future of IT online survey 2023 edition.

    A CIO focus for the Future of IT

    Data in this report represents respondents to the Future of IT online survey conducted by Info-Tech Research Group between May 11 and July 7, 2023.

    Only CIO respondents were selected for this report, defined as those who indicated they are the most senior member of their organization's IT department.

    This data segment reflects 355 total responses with 239 completing every question on the survey.

    Further data from the Future of IT online survey and the accompanying interview process will be featured in Info-Tech's Tech Trends 2024 report this fall and in forthcoming Priorities reports including Applications, Data & EA, CIO, Infrastructure, and Security.

    Create a Customized Big Data Architecture and Implementation Plan

    • Buy Link or Shortcode: {j2store}388|cart{/j2store}
    • member rating overall impact: 10.0/10 Overall Impact
    • member rating average dollars saved: After each Info-Tech experience, we ask our members to quantify the real-time savings, monetary impact, and project improvements our research helped them achieve.
    • member rating average days saved: Read what our members are saying
    • Parent Category Name: Data Management
    • Parent Category Link: /data-management
    • Big data architecture is different from traditional data for several key reasons, including:
      • Big data architecture starts with the data itself, taking a bottom-up approach. Decisions about data influence decisions about components that use data.
      • Big data introduces new data sources such as social media content and streaming data.
      • The enterprise data warehouse (EDW) becomes a source for big data.
      • Master data management (MDM) is used as an index to content in big data about the people, places, and things the organization cares about.
      • The variety of big data and unstructured data requires a new type of persistence.
    • Many data architects have no experience with big data and feel overwhelmed by the number of options available to them (including vendor options, storage options, etc.). They often have little to no comfort with new big data management technologies.
    • If organizations do not architect for big data, there are a couple of main risks:
      • The existing data architecture is unable to handle big data, which will eventually result in a failure that could compromise the entire data environment.
      • Solutions will be selected in an ad hoc manner, which can cause incompatibility issues down the road.

    Our Advice

    Critical Insight

    • Before beginning to make technology decisions regarding the big data architecture, make sure a strategy is in place to document architecture principles and guidelines, the organization’s big data business pattern, and high-level functional and quality of service requirements.
    • The big data business pattern can be used to determine what data sources should be used in your architecture, which will then dictate the data integration capabilities required. By documenting current technologies, and determining what technologies are required, you can uncover gaps to be addressed in an implementation plan.
    • Once you have identified and filled technology gaps, perform an architectural walkthrough to pull decisions and gaps together and provide a fuller picture. After the architectural walkthrough, fill in any uncovered gaps. A proof-of-technology project can be started as soon as you have evaluation copies (or OSS) products and at least one person who understands the technology.

    Impact and Result

    • Save time and energy trying to fix incompatibilities between technology and data.
    • Allow the Data Architect to respond to big data requests from the business more quickly.
    • Provide the organization with valuable insights through the analytics and visualization technologies that are integrated with the other building blocks.

    Create a Customized Big Data Architecture and Implementation Plan Research & Tools

    Besides the small introduction, subscribers and consulting clients within this management domain have access to:

    1. Recognize the importance of big data architecture

    Big data is centered on the volume, variety, velocity, veracity, and value of data. Achieve a data architecture that can support big data.

    • Storyboard: Create a Customized Big Data Architecture and Implementation Plan

    2. Define architectural principles and guidelines while taking into consideration maturity

    Understand the importance of a big data architecture strategy. Assess big data maturity to assist with creation of your architectural principles.

    • Big Data Maturity Assessment Tool
    • Big Data Architecture Principles & Guidelines Template

    3. Build the big data architecture

    Come to accurate big data architecture decisions.

    • Big Data Architecture Decision Making Tool

    4. Determine common services needs

    What are common services?

    5. Plan a big data architecture implementation

    Gain business satisfaction with big data requests. Determine what steps need to be taken to achieve your big data architecture.

    • Big Data Architecture Initiative Definition Tool
    • Big Data Architecture Initiative Planning Tool

    Infographic

    Workshop: Create a Customized Big Data Architecture and Implementation Plan

    Workshops offer an easy way to accelerate your project. If you are unable to do the project yourself, and a Guided Implementation isn't enough, we offer low-cost delivery of our project workshops. We take you through every phase of your project and ensure that you have a roadmap in place to complete your project successfully.

    1 Recognize the Importance of Big Data Architecture

    The Purpose

    Set expectations for the workshop.

    Recognize the importance of doing big data architecture when dealing with big data.

    Key Benefits Achieved

    Big data defined.

    Understanding of why big data architecture is necessary.

    Activities

    1.1 Define the corporate strategy.

    1.2 Define big data and what it means to the organization.

    1.3 Understand why doing big data architecture is necessary.

    1.4 Examine Info-Tech’s Big Data Reference Architecture.

    Outputs

    Defined Corporate Strategy

    Defined Big Data

    Reference Architecture

    2 Design a Big Data Architecture Strategy

    The Purpose

    Identification of architectural principles and guidelines to assist with decisions.

    Identification of big data business pattern to choose required data sources.

    Definition of high-level functional and quality of service requirements to adhere architecture to.

    Key Benefits Achieved

    Key Architectural Principles and Guidelines defined.

    Big data business pattern determined.

    High-level requirements documented.

    Activities

    2.1 Discuss how maturity will influence architectural principles.

    2.2 Determine which solution type is best suited to the organization.

    2.3 Define the business pattern driving big data.

    2.4 Define high-level requirements.

    Outputs

    Architectural Principles & Guidelines

    Big Data Business Pattern

    High-Level Functional and Quality of Service Requirements Exercise

    3 Build a Big Data Architecture

    The Purpose

    Establishment of existing and required data sources to uncover any gaps.

    Identification of necessary data integration requirements to uncover gaps.

    Determination of the best suited data persistence model to the organization’s needs.

    Key Benefits Achieved

    Defined gaps for Data Sources

    Defined gaps for Data Integration capabilities

    Optimal Data Persistence technology determined

    Activities

    3.1 Establish required data sources.

    3.2 Determine data integration requirements.

    3.3 Learn which data persistence model is best suited.

    3.4 Discuss analytics requirements.

    Outputs

    Data Sources Exercise

    Data Integration Exercise

    Data Persistence Decision Making Tool

    4 Plan a Big Data Architecture Implementation

    The Purpose

    Identification of common service needs and how they differ for big data.

    Performance of an architectural walkthrough to test decisions made.

    Group gaps to form initiatives to develop an Initiative Roadmap.

    Key Benefits Achieved

    Common service needs identified.

    Architectural walkthrough completed.

    Initiative Roadmap completed.

    Activities

    4.1 Identify common service needs.

    4.2 Conduct an architectural walkthrough.

    4.3 Group gaps together into initiatives.

    4.4 Document initiatives on an initiative roadmap.

    Outputs

    Architectural Walkthrough

    Initiative Roadmap

    Manage End-User Devices

    • Buy Link or Shortcode: {j2store}307|cart{/j2store}
    • member rating overall impact: 10.0/10 Overall Impact
    • member rating average dollars saved: $45,499 Average $ Saved
    • member rating average days saved: 10 Average Days Saved
    • Parent Category Name: End-User Computing Devices
    • Parent Category Link: /end-user-computing-devices
    • Desktop and mobile device management teams use separate tools and different processes.
    • People at all levels of IT are involved in device management.
    • Vendors are pushing unified endpoint management (UEM) products, and teams struggling with device management are hoping that UEM is their savior.
    • The number and variety of devices will only increase with the continued advance of mobility and emergence of the Internet of Things (IoT).

    Our Advice

    Critical Insight

    • Many problems can be solved by fixing roles, responsibilities, and process. Standardize so you can optimize.
    • UEM is not a silver bullet. Your current solution can image computers in less than 4 hours if you use lean images.
    • Done with, not done to. Getting input from the business will improve adoption, avoid frustration, and save everyone time.

    Impact and Result

    • Define the benefits that you want to achieve and optimize based on those benefits.
    • Take an evolutionary, rather than revolutionary, approach to merging end-user support teams. Process and tool unity comes first.
    • Define the roles and responsibilities involved in end-user device management, and create a training plan to ensure everyone can execute their responsibilities.
    • Stop using device management practices from the era of Windows XP. Create a plan for lean images and app packages.

    Manage End-User Devices Research & Tools

    Start here – read the Executive Brief

    Read our concise Executive Brief to find out why you should optimize end-user device management, review Info-Tech’s methodology, and understand the four ways we can support you in completing this project.

    Besides the small introduction, subscribers and consulting clients within this management domain have access to:

    1. Identify the business and IT benefits of optimizing endpoint management

    Get your desktop and mobile device support teams out of firefighting mode by identifying the real problem.

    • Manage End-User Devices – Phase 1: Identify the Business and IT Benefits
    • End-User Device Management Standard Operating Procedure
    • End-User Device Management Executive Presentation

    2. Improve supporting teams and processes

    Improve the day-to-day operations of your desktop and mobile device support teams through role definition, training, and process standardization.

    • Manage End-User Devices – Phase 2: Improve Supporting Teams and Processes
    • End-User Device Management Workflow Library (Visio)
    • End-User Device Management Workflow Library (PDF)

    3. Improve supporting technologies

    Stop using management tools and techniques from the Windows XP era. Save yourself, and your technicians, from needless pain.

    • Manage End-User Devices – Phase 3: Improve Supporting Technologies
    [infographic]

    Workshop: Manage End-User Devices

    Workshops offer an easy way to accelerate your project. If you are unable to do the project yourself, and a Guided Implementation isn't enough, we offer low-cost delivery of our project workshops. We take you through every phase of your project and ensure that you have a roadmap in place to complete your project successfully.

    1 Identify the Business and IT Benefits of Optimizing End-User Device Management

    The Purpose

    Identify how unified endpoint management (UEM) can improve the lives of the end user and of IT.

    Key Benefits Achieved

    Cutting through the vendor hype and aligning with business needs.

    Activities

    1.1 Identify benefits you can provide to stakeholders.

    1.2 Identify business and IT goals in order to prioritize benefits.

    1.3 Identify how to achieve benefits.

    1.4 Define goals based on desired benefits.

    Outputs

    Executive presentation

    2 Improve the Teams and Processes That Support End-User Device Management

    The Purpose

    Ensure that your teams have a consistent approach to end-user device management.

    Key Benefits Achieved

    Developed a standard approach to roles and responsibilities, to training, and to device management processes.

    Activities

    2.1 Align roles to your environment.

    2.2 Assign architect-, engineer-, and administrator-level responsibilities.

    2.3 Rationalize your responsibility matrix.

    2.4 Ensure you have the necessary skills.

    2.5 Define Tier 2 processes, including patch deployment, emergency patch deployment, device deployment, app deployment, and app packaging.

    Outputs

    List of roles involved in end-user device management

    Responsibility matrix for end-user device management

    End-user device management training plan

    End-user device management standard operating procedure

    Workflows and checklists of end-user device management processes

    3 Improve the Technologies That Support End-User Device Management

    The Purpose

    Modernize the toolset used by IT to manage end-user devices.

    Key Benefits Achieved

    Saving time and resources for many standard device management processes.

    Activities

    3.1 Define the core image for each device/OS.

    3.2 Define app packages.

    3.3 Gather action items for improving the support technologies.

    3.4 Create a roadmap for improving end-user device management.

    3.5 Create a communication plan for improving end-user device management.

    Outputs

    Core image outline

    Application package outline

    End-user device management roadmap

    End-user device management communication plan

    Harness Configuration Management Superpowers

    • Buy Link or Shortcode: {j2store}303|cart{/j2store}
    • member rating overall impact: 8.5/10 Overall Impact
    • member rating average dollars saved: $12,999 Average $ Saved
    • member rating average days saved: 10 Average Days Saved
    • Parent Category Name: Asset Management
    • Parent Category Link: /asset-management
    • Configuration management databases (CMDB) are a lot of work to build and maintain. Starting down this process without the right tools, processes, and buy-in is a lot of work with very little reward.
    • If you decide to just build it and expect they will come, you may find it difficult to articulate the value, and you will be disappointed by the lack of visitors.
    • Relying on manual entry or automated data collection without governance may result in data you can’t trust, and if no one trusts the data, they won’t use it.

    Our Advice

    Critical Insight

    • The right mindset is just as important as the right tools. By involving everyone early, you can ensure the right data is captured and validated and you can make maintenance part of the culture. This is critical to reaching early and continual value with a CMDB.

    Impact and Result

    • Define your use cases: Identify the use cases and prioritize those objectives into phases. Define what information will be needed to meet the use cases and how that information will be populated.
    • Understand and design the CMDB data model: Define services and undiscoverable configuration items (CI) and map them to the discoverable CIs.
    • Operationalize configuration record updates: Define data stewards and governance processes and integrate your configuration management practice with existing practices and lifecycles.

    Harness Configuration Management Superpowers Research & Tools

    Besides the small introduction, subscribers and consulting clients within this management domain have access to:

    1. Harness Configuration Management Superpowers Deck – A step-by-step document that walks you through creating a configuration management program.

    Use this blueprint to create a configuration management program that provides immediate value.

    • Harness Configuration Management Superpowers – Phases 1-4

    2. Configuration Management Project Charter Template – A project charter template to help you build a concise document for communicating appropriate project details to stakeholders.

    Use this template to create a project charter to launch the configuration management project.

    • Configuration Management Project Charter

    3. Configuration Control Board Charter Template – A board charter template to help you define the roles and responsibilities of the configuration control board.

    Use this template to create your board charter for your configuration control board (CCB). Define roles and responsibilities and mandates for the CCB.

    • Configuration Control Board Charter

    4. Configuration Management Standard Operating Procedures (SOP) Template – An SOP template to describe processes and procedures for ongoing maintenance of the CMDB under the configuration management program.

    Use this template to create and communicate your SOP to ensure ongoing maintenance of the CMDB under the configuration management program.

    • Configuration Management Standard Operation Procedures

    5. Configuration Management Audit and Validation Checklist Template – A template to be used as a starting point to meet audit requirements under NIST and ITIL programs.

    Use this template to assess capability to pass audits, adding to the template as needed to meet internal auditors’ requirements.

    • Configuration Management Audit and Validation Checklist

    6. Configuration Management Policy Template – A template to be used for building out a policy for governance over the configuration management program.

    Use this template to build a policy for your configuration management program.

    • Configuration Management Policy

    7. Use Cases and Data Worksheet – A template to be used for validating data requirements as you work through use cases.

    Use this template to determine data requirements to meet use cases.

    • Use Cases and Data Worksheet

    8. Configuration Management Diagram Template Library – Examples of process workflows and data modeling.

    Use this library to view sample workflows and a data model for the configuration management program.

    • Configuration Management Diagram Template Library (Visio)
    • Configuration Management Diagram Template Library (PDF)

    9. Configuration Manager Job Description – Roles and responsibilities for the job of Configuration Manager.

    Use this template as a starting point to create a job posting, identifying daily activities, responsibilities, and required skills as you create or expand your configuration management program.

    • Configuration Manager

    Infographic

    Workshop: Harness Configuration Management Superpowers

    Workshops offer an easy way to accelerate your project. If you are unable to do the project yourself, and a Guided Implementation isn't enough, we offer low-cost delivery of our project workshops. We take you through every phase of your project and ensure that you have a roadmap in place to complete your project successfully.

    1 Configuration Management Strategy

    The Purpose

    Define the scope of your service configuration management project.

    Design the program to meet specific stakeholders needs

    Identify project and operational roles and responsibilities.

    Key Benefits Achieved

    Designed a sustainable approach to building a CMDB.

    Activities

    1.1 Introduction

    1.2 Define challenges and goals.

    1.3 Define and prioritize use cases.

    1.4 Identify data needs to meet these goals.

    1.5 Define roles and responsibilities.

    Outputs

    Data and reporting use cases based on stakeholder requirements

    Roles and responsibility matrix

    2 CMDB Data Structure

    The Purpose

    Build a data model around the desired use cases.

    Identify the data sources for populating the CMDB.

    Key Benefits Achieved

    Identified which CIs and relationships will be captured in the CMDB.

    Activities

    2.1 Define and prioritize your services.

    2.2 Evaluate CMDB default classifications.

    2.3 Test configuration items against existing categories.

    2.4 Build a data model diagram.

    Outputs

    List of CI types and relationships to be added to default settings

    CMDB data model diagram

    3 Processes

    The Purpose

    Key Benefits Achieved

    Built a right-sized approach to configuration record updates and data validation.

    Activities

    3.1 Define processes for onboarding, offboarding, and maintaining data in the CMDB.

    3.2 Define practices for configuration baselines.

    3.3 Build a data validation and auditing plan.

    Outputs

    Documented processes and workflows

    Data validation and auditing plan

    4 Communications & Roadmap

    The Purpose

    Key Benefits Achieved

    Metrics program defined

    Communications designed

    Activities

    4.1 Define key metrics for configuration management.

    4.2 Define metrics for supporting services.

    4.3 Build configuration management policies.

    4.4 Create a communications plan.

    4.5 Build a roadmap

    Outputs

    Policy for configuration management

    Communications documents

    Roadmap for next steps

    Further reading

    Harness Configuration Management Superpowers

    Create a configuration management practice that will provide ongoing value to the organization.

    EXECUTIVE BRIEF

    Analyst Perspective

    A robust configuration management database (CMDB) can provide value to the business and superpowers to IT. It's time to invest smartly to reap the rewards.

    IT environments are becoming more and more complex, and balancing demands for stability and demands for faster change requires visibility to make the right decisions. IT needs to know their environment intimately. They need to understand dependencies and integrations and feel confident they are making decisions with the most current and accurate view.

    Solutions for managing operations rely on the CMDB to bring visibility to issues, calculate impact, and use predictive analytics to fix performance issues before they become major incidents. AIOps solutions need accurate data, but they can also help identify configuration drift and flag changes or anomalies that need investigation.

    The days of relying entirely on manual entry and updates are all but gone, as the functionality of a robust configuration management system requires daily updates to provide value. We used to rely on that one hero to make sure information was up to date, but with the volume of changes we see in most environments today, it's time to improve the process and provide superpowers to the entire IT department.

    This is a picture of Sandi Conrad

    Sandi Conrad, ITIL Managing Professional
    Principal Research Director, IT Infrastructure & Operations, Info-Tech Research Group

    Executive Summary

    Your Challenge

    • Build a configuration management database (CMDB): You need to implement a CMDB, populate it with records and relationships, and integrate it with discovery and management tools.
    • Identify the benefits of a CMDB: Too many CMDB projects fail because IT tries to collect everything. Base your data model on the desired use cases.
    • Define roles and responsibilities: Keeping data accurate and updated is difficult. Identify who will be responsible for helping

    Common Obstacles

    • Significant process maturity is required: Service configuration management (SCM) requires high maturity in change management, IT asset management, and service catalog practices.
    • Large investment: Building a CMDB takes a large amount of effort, process, and expertise.
    • Tough business case: Configuration management doesn't directly provide value to the business, but it requires a lot of investment from IT.

    Info-Tech's Approach

    • Define your scope and objectives: Identify the use cases for SCM and prioritize those objectives into phases.
    • Design the CMDB data model: Align with your existing configuration management system's data model.
    • Operationalize configuration record updates: Integrate your SCM practice with existing practices and lifecycles.

    Start small

    Scope creep is a serial killer of configuration management databases and service configuration management practices.

    Insight summary

    Many vendors are taking a CMDB-first approach to enable IT operations or sometimes asset management. It's important to ensure processes are in place immediately to ensure the data doesn't go stale as additional modules and features are activated.

    Define processes early to ensure success

    The right mindset is just as important as the right tools. By involving everyone early, you can ensure the right data is captured and validated and you can make maintenance part of the culture. This is critical to reaching early and continual value with a CMDB.

    Identify use cases

    The initial use case will be the driving force behind the first assessment of return on investment (ROI). If ROI can be realized early, momentum will increase, and the team can build on the initial successes.

    If you don't see value in the first year, momentum diminishes and it's possible the project will never see value.

    Keep the initial scope small and focused

    Discovery can collect a lot of data quickly, and it's possible to be completely overwhelmed early in the process.

    Build expertise and troubleshoot issues with a smaller scope, then build out the process.

    Minimize customizations

    Most CMDBs have classes and attributes defined as defaults. Use of the defaults will enable easier implementation and faster time to value, especially where automations and integrations depend on standard terms for field mapping.

    Automate as much as possible

    In large, complex environments, the data can quickly become unmanageable. Use automation as much as possible for discovery, dependency mapping, validation, and alerts. Minimize the amount of manual work but ensure everyone is aware of where and how these manual updates need to happen to see continual value.

    Info-Tech's Harness Configuration Management Superpowers.

    Configuration management will improve functionality of all surrounding processes

    A well-functioning CMDB empowers almost all other IT management and governance practices.

    Service configuration management is about:

    • Building a system of record about IT services and the components that support those services.
    • Continuously reconciling and validating information to ensure data accuracy.
    • Ensuring the data lifecycle is defined and well understood and can pass data and process audits.
    • Accessing information in a variety of ways to effectively serve IT and the business.
    An image of Info-Tech's CMDB Configuration Management tree, breaking down aspects into the following six categories: Strategic Partner; Service Provider; Proactive; Stabilize; Core; and Foundational.

    Configuration management most closely impacts these practices

    Info-Tech Research Group sees a clear relationship.

    When an IT department reports they are highly effective at configuration management, they are much more likely to report they are highly effective at these management and governance processes:

    The following management and governance processes are listed: Quality Management; Asset Management; Performance Measurement; Knowledge Management; Release Management; Incident and Problem Management; Service Management; Change Management.

    The data is clear

    Service configuration management is about more than just doing change management more effectively.

    Source: Info-Tech Research Group, IT Management and Governance Diagnostic; N=684 organizations, 2019 to July 2022.

    Make the case to use configuration management to improve IT operations

    Consider the impact of access to data for informing innovations, optimization efforts, and risk assessments.

    75% of Uptime's 2021 survey respondents who had an outage in the past three years said the outage would have been prevented if they'd had better management or processes.(1)

    75%

    75% of Uptime's 2021 survey respondents who had an outage in the past three years said the outage would have been prevented if they'd had better management or processes.(1)

    42%

    of publicly reported outages were due to software or configuration issues. (1)

    58%

    of networking-related IT outages were due to configuration and change management failure.(1)

    It doesn't have to be that way!

    Enterprise-grade IT service management (ITSM) tools require a CMDB for the different modules to work together and to enable IT operations management (ITOM), providing greater visibility.

    Decisions about changes can be made with accurate data, not guesses.

    The CMDB can give the service desk fast access to helpful information about the impacted components, including a history of similar incidents and resolutions and the relationship between the impacted components and other systems and components.

    Turn your team into IT superheroes.

    CMDB data makes it easier for IT Ops groups to:

    • Avoid change collisions.
    • Eliminate poor changes due to lack of visibility into complex systems.
    • Identify problematic equipment.
    • Troubleshoot incidents.
    • Expand the services provided by tier 1 and through automation.

    Benefits of configuration management

    For IT

    • Configuration management will supercharge processes that have relied on inherent knowledge of the IT environment to make decisions.
    • IT will more quickly analyze and understand issues and will be positioned to improve and automate issue identification and resolution.
    • Increase confidence and reduce risks for decisions involving release and change management with access to accurate data, regardless of the complexity of the environment.
    • Reduce or eliminate unplanned work related to poor outcomes due to decisions made with incorrect or incomplete data.

    For the Business

    • Improve strategic planning for business initiatives involving IT solutions, which may include integrations, development, or security concerns.
    • More quickly deploy new solutions or updates due to visibility into complex environments.
    • Enable business outcomes with reliable and stable IT systems.
    • Reduce disruptions caused by planning without accurate data and improve resolution times for service interruptions.
    • Improve access to reporting for budgeting, showbacks, and chargebacks as well as performance metrics.

    Measure the value of this blueprint

    Fast-track your planning and increase the success of a configuration management program with this blueprint

    Workshop feedback
    8.1/10

    $174,000 savings

    30 average days saved

    Guided Implementation feedback

    8.7/10

    $31,496 average savings

    41 average days saved

    "The workshop was well run, with good facilitation, and gained participation from even the most difficult parts of the audience. The best part of the experience was that if I were to find myself in the same position in the future, I would repeat the workshop."

    – University of Exeter

    Info-Tech offers various levels of support to best suit your needs

    DIY Toolkit

    “Our team has already made this critical project a priority, and we have the time and capability, but some guidance along the way would be helpful.”

    Guided Implementation

    “Our team knows that we need to fix a process, but we need assistance to determine where to focus. Some check-ins along the way would help keep us on track.”

    Workshop

    “We need to hit the ground running and get this project kicked off immediately. Our team has the ability to take this over once we get a framework and strategy in place.”

    Consulting

    “Our team does not have the time or the knowledge to take this project on. We need assistance through the entirety of this project.”

    Diagnostics and consistent frameworks used throughout all four options

    Guided Implementation

    What does a typical GI on this topic look like?

    Phase 1 Phase 2 Phase 3 Phase 4

    Call #1: Scope requirements, objectives, and your specific challenges.

    Call #2: Prioritize services and use cases.

    Call #3: Identify data needed to meet goals.

    Call #4: Define roles and responsibilities.

    Call #5: Define and prioritize your services.

    Call #6: Evaluate and test CMDB default classifications.

    Call #7: Build a data model diagram.

    Call #8: Define processes for onboarding, offboarding, and maintaining data.

    Call #9: Discuss configuration baselines.

    Call #10: Build a data validation and audit plan.

    Call #11: Define key metrics.

    Call #12: Build a configuration management policy and communications plan.

    Call #13: Build a roadmap.

    A Guided Implementation (GI) is a series of calls with an Info-Tech analyst to help implement our best practices in your organization.

    A typical GI is between 8 to 12 calls over the course of 4 to 9 months.

    Workshop Overview

    Contact your account representative for more information.
    workshops@infotech.com 1-888-670-8889

    Day 1 Day 2 Day 3 Day 4

    Configuration Management Strategy

    CMDB Data Structure

    Process Design

    Communications & Roadmap

    Activities
    • Introduction
    • Define challenges and goals.
    • Define and prioritize use cases.
    • Identify data needed to meet goals.
    • Define roles and responsibilities.
    • Define and prioritize your services.
    • Evaluate CMDB default classifications.
    • Test configuration items against existing categories.
    • Build a data model diagram.
    • Define processes for onboarding, offboarding, and maintaining data in the CMDB.
    • Define practices for configuration baselines.
    • Build a data validation and auditing plan.
    • Define key metrics for configuration management.
    • Define metrics for supporting services.
    • Build configuration management policies.
    • Create a communications plan.
    • Build a roadmap.

    Deliverables

    • Roles and responsibility matrix
    • Data and reporting use cases based on stakeholder requirements
    • List of CI types and relationships to be added to default settings
    • CMDB data model diagram
    • Documented processes and workflows
    • Data validation and auditing plan
    • Policy for configuration management
    • Roadmap for next steps
    • Communications documents

    Blueprint deliverables

    Each step of this blueprint is accompanied by supporting deliverables to help you accomplish your goals:

    Configuration Management Project Charter

    Detail your approach to building an SCM practice and a CMDB.

    Screenshot from the Configuration Management Project Charter

    Use Cases and Data Worksheet

    Capture the action items related to your SCM implementation project.

    Screenshot from the Use Cases and Data Worksheet

    Configuration Manager Job Description

    Use our template for a job posting or internal job description.

    Screenshot from the Configuration Manager Job Description

    Configuration Management Diagram Template Library

    Use these diagrams to simplify building your SOP.

    Screenshot from the Configuration Management Diagram Template Library

    Configuration Management Policy

    Set expectations for configuration control.

    screenshot from the Configuration Management Policy

    Configuration Management Audit and Validation Checklist

    Use this framework to validate controls.

    Screenshot from the Configuration Management Audit and Validation Checklist

    Configuration Control Board Charter

    Define the board's responsibilities and meeting protocols.

    Screenshot from the Configuration Management Audit and Validation Checklist

    Key deliverable:

    Configuration Management Standard Operating Procedures Template

    Outlines SCM roles and responsibilities, the CMDB data model, when records are expected to change, and configuration baselines.

    Four Screenshots from the Configuration Management Standard Operating Procedures Template

    Phase 1

    Configuration Management Strategy

    Strategy Data Structure Processes Roadmap
    • Challenges and Goals
    • Use Cases and Data
    • Roles and Responsibilities
    • Services
    • Classifications
    • Data Modeling
    • Lifecycle Processes
    • Baselines
    • Audit and Data Validation
    • Metrics
    • Communications Plan
    • Roadmap

    This phase will walk you through the following aspects of a configuration management system:

    • Scope
    • Use Cases
    • Reports and Analytics

    This phase involves the following participants:

    • IT and business service owners
    • Business/customer relationship managers
    • Enterprise architects
    • Practice owners and managers
    • SCM practice manager
    • SCM project manager
    • SCM project sponsor

    Harness Service Configuration Management Superpowers

    Establish clear definitions

    Ensure everyone is using the same terms.

    Term Definition
    Configuration Management

    The purpose of configuration management is to:

    • "Ensure that accurate and reliable information about the configuration of services, and the CIs that support them, is available when and where it is needed. This includes information on how CIs are configured and the relationships between them" (AXELOS).
    • "Provide sufficient information about service assets to enable the service to be effectively managed. Assess the impact of changes and deal with service incidents" (ISACA, 2018).
    Configuration Management System (CMS) A set of tools and databases used to manage, update, and present data about all configuration items and their relationships. A CMS may maintain multiple federated CMDBs and can include one or many discovery and dependency mapping tools.
    Configuration Management Database (CMDB) A repository of configuration records. It can be as simple as a spreadsheet or as complex as an integrated database populated through multiple autodiscovery tools.
    Configuration Record Detailed information about a configuration item.
    Configuration Item (CI)

    "Any component that needs to be managed in order to deliver an IT service" (AXELOS).

    These components can include everything from IT services and software to user devices, IT infrastructure components, and documents (e.g. maintenance agreements).
    Attributes Characteristics of a CI included in the configuration record. Common attributes include name, version, license expiry date, location, supplier, SLA, and owner.
    Relationships Information about the way CIs are linked. A CI can be part of another CI, connect to another CI, or use another CI. A CMDB is significantly more valuable when relationships are recorded. This information allows CMDB users to identify dependencies between components when investigating incidents, performing root-cause analysis, assessing the impact of changes before deployment, and much more.

    What is a configuration management database (CMDB)?

    The CMDB is a system of record of your services and includes a record for everything you need to track to effectively manage your IT services.

    Anything that is tracked in your CMDB is called a configuration item (CI). Examples of CIs include:

    • User-Facing Services
    • IT-Facing Services
    • Business Capabilities
    • Relationships
    • IT Infrastructure Components
    • Enterprise Software
    • End-User Devices
    • Documents

    Other systems of record can refer to CIs, such as:

    • Ticket database: Tickets can refer to which CI is impacted by an incident or provided as part of a service request.
    • Asset management database (AMDB): An IT asset is often also a CI. By associating asset records with CI records, you can leverage your IT asset data in your reporting.
    • Financial systems: If done well, the CMDB can supercharge your IT financial cost model.

    CMDBs can allow you to:

    • Query multiple databases simultaneously (so long as you have the CI name field in each database).
    • Build automated workflows and chatbots that interact with data across multiple databases.
    • More effectively identify the potential impact of changes and releases.

    Do not confuse asset with configuration

    Asset and configuration management look at the same world through different lenses

    • IT asset management (ITAM) tends to focus on each IT asset in its own right: assignment or ownership, lifecycle, and related financial obligations and entitlements.
    • Configuration management is focused on configuration items (CIs) that must be managed to deliver a service and the relationships and integrations with other CIs.
    • ITAM and configuration management teams and practices should work closely together. Though asset and configuration management focus on different outcomes, they may use overlapping tools and data sets. Each practice, when working effectively, can strengthen the other.
    • Many objects will exist in both the CMDB and AMDB, and the data on those shared objects will need to be kept in sync.

    A comparison between Asset and Configuration Management Databases

    *Discovery, dependency mapping, and data normalization are often features or modules of configuration management, asset management, or IT service management tools.

    Start with ITIL 4 guiding principles to make your configuration management project valuable and realistic

    Focus on where CMDB data will provide value and ensure the cost of bringing that data in will be reasonable for its purpose. Your end goal should be not just to build a CMDB but to use a CMDB to manage workload and workflows and manage services appropriately.

    Focus on value

    Include only the relevant information required by stakeholders.

    Start where you are

    Use available sources of information. Avoid adding new sources and tools unless they are justified.

    Progress iteratively with feedback

    Regularly review information use and confirm its relevance, adjusting the CMDB scope if needed.

    Collaborate and promote visibility

    Explain and promote available sources of configuration information and the best ways to use them, then provide hints and tips for more efficient use.

    Think and work holistically

    Consider other sources of data for decision making. Do not try to put everything in the CMDB.

    Keep it simple and practical

    Provide relevant information in the most convenient way; avoid complex interfaces and reports.

    Optimize and automate

    Continually optimize resource-consuming practice activities. Automate CDMB verification, data collection, relationship discovery, and other activities.

    ITIL 4 guiding principles as described by AXELOS

    Step 1.1

    Identify use cases and desired benefits for service configuration management

    Activities

    1.1.1 Brainstorm data collection challenges

    1.1.2 Define goals and how you plan to meet them

    1.1.3 Brainstorm and prioritize use cases

    1.1.4 Identify the data needed to reach your goals

    1.1.5 Record required data sources

    This step will walk you through the following aspects of a configuration management system:

    • Scope
    • Use cases

    This phase involves the following participants:

    • IT and business service owners
    • Business/customer relationship managers
    • Enterprise architects
    • Practice owners and managers
    • SCM practice manager
    • Project sponsor
    • Project manager

    Identify potential obstacles in your organization to building and maintaining a CMDB

    Often, we see multiple unsuccessful attempts to build out a CMDB, with teams eventually losing faith and going back to spreadsheets. These are common obstacles:

    • Significant manual data collection, which is rarely current and fully accurate.
    • Multiple discovery solutions creating duplicate records, with no clear path to deduplicate records.
    • Manual dependency mapping that isn't accurate because it's not regularly assessed and updated.
    • Hybrid cloud and on-premises environment with discovery solutions only partially collecting as the right discovery and dependency mapping solutions aren't in place.
    • Dynamic environments (virtual, cloud, or containers) that may exist for a very short time, but no one knows how they should be managed.
    • Lack of expertise to maintain and update the CMDB or lack of an assigned owner for the CMDB. If no one owns the process and is assigned as a steward of data, it will not be maintained.
    • Database that was designed with other purposes in mind and is heavily customized, making it difficult to use and maintain.

    Understanding the challenges to accessing and maintaining quality data will help define the risks created through lack of quality data.

    This knowledge can drive buy-in to create a configuration management practice that benefits the organization.

    1.1.1 Brainstorm data collection challenges

    Involve stakeholders.
    Allot 45 minutes for this discussion.

    1. As a group, brainstorm the challenges you have with data:
    2. Accuracy and trustworthiness: What challenges do you have with getting accurate data on IT services and systems?
      1. Access: Where do you have challenges with getting data to people when they need it?
      2. Manually created data: Where are you relying on data that could be automatically collected?
      3. Data integration: Where do you have issues with integrating data from multiple sources?
      4. Impact: What is the result of these challenges?
    3. Group together these challenges into similar issues and identify what goals would help overcome them.
    4. Record these challenges in the Configuration Management Project Charter, section 1.2: Project Purpose.

    Download the Configuration Management Project Charter

    Input

    Output

    • None
    • List of high-level desired benefits for SCM
    Materials Participants
    • Whiteboard/flip charts
    • Sticky notes
    • Markers/pens
    • Configuration Management Project Charter
    • IT and business service owners
    • Business/customer relationship managers
    • Practice owners and managers
    • SCM practice manager
    • SCM project sponsor

    Info-Tech Maturity Ladder

    Identify your current and target state

    INNOVATOR

    • Characteristics of business partner
    • Integration with orchestration tools

    BUSINESS PARTNER

    Data collection and validation is fully automated

    Integrated with several IT processes

    Meets the needs of IT and business use cases

    TRUSTED OPERATOR

    • Data collection and validation is partially or fully automated
    • Trust in data accuracy is high, meets the needs of several IT use cases

    FIREFIGHTER

    • Data collection is partially or fully automated, validation is ad hoc
    • Trust in data accuracy is variable, used for decision making

    UNSTABLE

    INNOVATOR

    • Characteristics of business partner
    • Integration with orchestration tools

    BUSINESS PARTNER

    • Data collection and validation is fully automated
    • Integrated with several IT processes
    • Meets the needs of IT and business use cases

    TRUSTED OPERATOR

    • Data collection and validation is partially or fully automated
    • Trust in data accuracy is high, meets the needs of several IT use cases

    FIREFIGHTER

    • Data collection is partially or fully automated, validation is ad hoc
    • Trust in data accuracy is variable, used for decision making

    UNSTABLE

    A tower is depicted, with arrows pointing to Current (orange) and Target(blue)

    Define goals for your CMDB to ensure alignment with all stakeholders

    • How are business or IT goals being hindered by not having the right data available?
    • If the business isn't currently asking for service-based reporting and accountability, start with IT goals. This will help to develop goals that will be most closely aligned to the IT teams' needs and may help incentivize the right behavior in data maintenance.
    • Configuration management succeeds by enabling its stakeholders to achieve their outcomes. Set goals for configuration management based on the most important outcomes expected from this project. Ask your stakeholders:
      1. What are the business' or IT's planned transformational initiatives?
      2. What are your highest priority goals?
      3. What should the priorities of the configuration management practice be?
    • The answers to these questions will shape your approach to configuration management. Direct input from your leadership and executives, or their delegates, will help ensure you're setting a solid foundation for your practice.
    • Identify which obstacles will need to be overcome to meet these goals.

    "[T]he CMDB System should be viewed as a 'system of relevance,' rather than a 'single source of truth.' The burdens of relevance are at once less onerous and far more meaningful in terms of action, analysis, and automation. While 'truth' implies something everlasting or at least stable, relevance suggests a far more dynamic universe."

    – CMDB Systems, Making Change Work in the Age of Cloud and Agile, Drogseth et al

    Identify stakeholders to discuss what they need from a CMDB; business and IT needs will likely differ

    Define your audience to determine who the CMDB will serve and invite them to these conversations. The CMDB can aid the business and IT and can be structured to provide dashboards and reports for both.

    Nondiscoverable configuration items will need to be created for both audiences to organize CIs in a way that makes sense for all uses.

    Integrations with other systems may be required to meet the needs of your audience. Note integrations for future planning.

    Business Services

    Within the data sets, service configuration models can be used for:

    • Impact analysis
    • Cause and effect analysis
    • Risk analysis
    • Cost allocation
    • Availability analysis and planning

    Technical Services

    Connect to IT Finance for:

    • Service-based consumption and costing
    • Financial awareness through showback
    • Financial recovery through chargeback
    • Support IT strategy through financial transparency
    • Cost optimization
    • Reporting for depreciation, location-related taxation, and capitalization (may also use asset management for these)

    Intersect with IT Processes to:

    • Reduce time to restore services through incident management
    • Improve stability through change management
    • Reduce outages through problem management
    • Optimize assets through IT asset management
    • Provide detailed reporting for audit/governance, risk, and compliance

    1.1.2 Define goals and how you plan to meet them

    Involve stakeholders.

    Allot 45 minutes for this discussion.

    As a group, identify current goals for building and using a CMDB.

    Why are we doing this?

    • How do you hope to use the data within the CMDB?
    • What processes will be improved through use of this data and what are the expected outcomes?

    How will we improve the process?

    • What processes will be put in place to ensure data integrity?
    • What tools will be put in place to improve the methods used to collect and maintain data?

    Record these goals in the Configuration Management Project Charter, section 1.3: Project Objectives.

    Input

    Output

    • None
    • List of high-level desired benefits for SCM
    Materials Participants
    • Whiteboard/flip charts
    • Sticky notes
    • Markers/pens
    • Configuration Management Project Charter
    • IT and business service owners
    • Business/customer relationship managers
    • Practice owners and managers
    • SCM practice manager
    • SCM project sponsor

    It's easy to think that if you build it, they will come, but CMDBs rarely succeed without solid use cases

    Set expectations for your organization that defined and fulfilled use cases will factor into prioritization exercises, functional plans, and project milestones to achieve ROI for your efforts.

    A good use case:

    • Justifies resource allocation
    • Gains funding for the right tools
    • Builds stakeholder support
    • Drives interest and excitement
    • Gains support from anyone in a position to help build out and validate the data
    • Helps to define success

    In the book CMDB Systems, Making Change Work in the Age of Cloud and Agile, authors Drogseth, Sturm, and Twing describe the secrets of success:

    A documented evaluation of CMDB System vendors showed that while most "best case" ROI fell between 6 and 9 months for CMDB deployments, one instance delivered ROI for a significant CMDB investment in as little as 2 weeks!

    If there's a simple formula for quick time to value for a CMDB System, it's the following:

    Mature levels of process awareness
    + Strong executive level support
    + A ready and willing team with strongly supportive stakeholders
    + Clearly defined and ready phase one use case
    + Carefully selected, appropriate technologies

    All this = Powerful early-phase CMDB System results

    Define and prioritize use cases for how the CMDB will be used to drive value

    The CMDB can support several use cases and may require integration with various modules within the ITSM solution and integration with other systems.

    Document the use cases that will drive your CMDB to relevance, including the expected benefits for each use case.

    Identify the dependencies that will need to be implemented to be successful.

    Define "done" so that once data is entered, verified, and mapped, these use cases can be realized.

    "Our consulting experience suggests that more than 75% of all strategic initiatives (CMDB or not) fail to meet at least initial expectations across IT organizations. This is often due more to inflated expectations than categorical failure."

    – CMDB Systems, Making Change Work in the Age of Cloud and Agile, Drogseth et al.

    This image demonstrates how CMBD will be used to drive value.

    After identifying use cases, determine the scope of configuration items required to feed the use cases

    On-premises software and equipment will be critical to many use cases as the IT team and partners work on network and data-center equipment, enterprise software, and integrations through various means, including APIs and middleware. Real-time and near real-time data collection and validation will ensure IT can act with confidence.

    Cloud use can include software as a service (SaaS) solutions as well as infrastructure and platform as a service (IaaS and PaaS), and this may be more challenging for data collection. Tools must be capable of connecting to cloud environments and feeding the information back into the CMDB. Where on-premises and cloud applications show dependencies, you might need to validate data if multiple discovery and dependency mapping solutions are used to get a complete picture. Tagging will be crucial to making sense of the data as it comes into the CMDB.

    In-house developed software would be beneficial to have in the CMDB but may require more manual work to identify and classify once discovered. A combination of discovery and tagging may be beneficial to input and classification.

    Highly dynamic environments may require data collection through integration with a variety of solutions to manage and record continuous deployment models and verifications, or they may rely on tags and activity logs to record historical activity. Work with a partner who specializes in CI/CD to help architect this use case.

    Containers will require an assessment of the level of detail required. Determine if the container is a CI and if the content will be described as attributes. If there is value to your use case to map the contents of each container as separate CIs within the container CI, then you can map to that level of detail, but don't map to that depth unless the use case calls for it.

    Internet of Things (IoT) devices and applications will need to match a use case as well. IoT device asset data will be useful to track within an asset database but may have limited value to add to a CMDB. If there are connections between IoT applications and data warehouses, the dependencies should likely be mapped to ensure continued dataflow.

    Out of scope

    A single source of data is highly beneficial, but don't make it a catchall for items that are not easily stored in a CMDB.

    Source code should be stored in a definitive media library (DML). Code can be linked to the CMDB but is generally too big to store in a CMDB and will reduce performance for data retrieval.

    Knowledge articles and maintenance checklists are better suited to a knowledge base. They can also be linked to the CDMB if needed but this can get messy where many-to-many relationships between articles and CIs exist.

    Fleet (transportation) assets and fixed assets should be in fleet management systems and accounting systems, respectively. Storing these types of data in the CMDB doesn't provide value to the support process.

    1.1.3 Brainstorm and prioritize use cases

    Which IT practices will you supercharge?

    Focus on improving both operations and strategy.

    1. Brainstorm the list of relevant use cases. What do you want to do with the data from the CMDB? Consider:
      1. ITSM management and governance practices
      2. IT operations, vendor orchestration, and service integration and management (SIAM) to improve vendor interactions
      3. IT finance and business service reporting needs
    2. Identify which use cases are part of your two- to three-year plan, including the purpose for adding configuration data into that process. Prioritize one or two of these use cases to accomplish in your first year.
    3. Identify dependencies to manage as part of the solution and define a realistic timeline for implementing integrations, modules, or data sources.
    4. Document this table in the Configuration Management Project Charter, section 2.2: Use Cases.
    Audience Use Case Goal/Purpose Project/Solution Dependencies Proposed Timeline Priority
    • IT
    • Change Management

    Stabilize the process by seeing:

    Change conflict reporting

    Reports of CI changes without change records

    System availability

    RFC mapping requires discovered CIs

    RFC review requires criticality, technical and business owners

    Conflict reporting requires dependency mapping

    • Discovery and manual information entered by October
    • Dependency mapping implemented by December

    High

    Determine what additional data will be needed to achieve your use cases

    Regardless of which use cases you are planning to fulfill with the CMDB, it is critical to not add data and complexity with the plan of resolving every possible inquiry. Ensure the cost and effort of bringing in the data and maintaining it is justified. The complexity of the environment will impact the complexity of data sources and integrations for discovery and dependency mapping.

    Before bringing in new data, consider:

    • Is this information available in other maintained databases now?
    • Will this data be critical for decision making? If it is nice to have or optional, can it be automatically moved into the database and maintained using existing integrations?
    • Is there a cost to bringing the data into the CMDB and maintaining it? Is that cost reasonable for its purpose?
    • How frequently will this information be accessed, and can it be updated in an adequate cadence to meet these needs?
    • When does this information need to be available?

    Info-Tech Insight

    If data will be used only occasionally upon request, determine if it will be more efficient to maintain it or to retrieve it from the CMDB or another data source as needed.

    Remember, within the data sets, service configuration models can be used for:

    • Impact analysis
    • Cause and effect analysis
    • Risk analysis
    • Cost allocation
    • Availability analysis and planning

    1.1.4 Expand your use cases by identifying the data needed to reach your goals

    Involve stakeholders.

    Allot 60 minutes for this discussion.

    Review use cases and their goals.

    Identify what data will be required to meet those goals and determine whether it will be mandatory or optional/nice-to-have information.

    Identify sources of data for each type of data. Color code or sort.

    Italicize data points that can be automatically discovered.

    Gain consensus on what information will be manually entered.

    Record the data in the Use Cases and Data Worksheet.

    Download the Use Cases and Data Worksheet

    Input

    Output

    • None
    • List of data requirements
    MaterialsParticipants
    • Whiteboard/flip charts
    • Sticky notes
    • Markers/pens
    • Use Cases and Data Worksheet
    • IT and business service owners
    • Business/customer relationship managers
    • Practice owners and managers
    • SCM practice manager
    • SCM project sponsor

    Use discovery and dependency mapping tools to automatically update the CMDB

    Avoid manual data entry whenever possible.

    Consider these features when looking at tools:

    • Application dependency mapping: Establishing and tracking the relationships and dependencies between system components, applications, and IT services. The ideal tool will be able to generate maps automatically.
    • Agentless and agent discovery: Scanning systems with both agent and agentless approaches. Agent-based scanning provides comprehensive information on applications used in individual endpoints, which is helpful in minimizing its IT footprint. However, agents require endpoint access. Agentless-based scanning provides a broader and holistic view of deployed applications without the need to install an agent on end devices, which can be good enough for inventory awareness.
    • Data export capability: Easy exporting of application inventory information to be used in reports and other tools.
    • Dashboards and chart visualization: Detailed list of the application inventory, including version number, number of users, licenses, deployment location, and other application details. These details will inform decision makers of each application's health and its candidacy for further rationalization activities.
    • Customizable scanning scripts: Tailor your application discovery approach by modifying the scripts used to scan your systems.
    • Integration with third-party tools: Easy integration with other systems with out-of-the-box plugins or customizable APIs.

    Determine which data collection methods will be used to populate the CMDB

    The effort-to-value ratio is an important factor in populating a CMDB. Manual efforts require a higher process focus, more intensive data validation, and a constant need to remind team members to act on every change.

    Real-Time Data AIOps continual scans Used for event and incident management
    Near Real-Time Data Discovery and dependency mapping run on a regular cycle Used for change and asset management
    Historical Data Activity log imports, manual data entry Used for IT finance, audit trail
    • Determine what amount of effort is appropriate for each data grouping and use case. As decisions are made to expand data within the CMDB, the effort-to-value ratio should always factor in. To be usable, data must be accurate, and every piece of data that needs to be manually entered runs the risk of becoming obsolete.
    • Identify which data sources will bring in each type of data. Where there is a possibility of duplicate records being created, one of the data sources will need to be identified as the primary.
    • If the decision is to manually enter configuration items early in the process, be aware that automation may create duplicates of the CIs that will need to be deduplicated at some point in the process to make the information more usable.
    • Typically, items are discovered, validated, then mapped, but there will be variations depending on the source.
    • Active Directory or LDAP may be used to bring users and technicians into the CMDB. Data may be imported from spreadsheets. Identify efforts where data cleanup may have to happen before transferring into the CMDB.
    • Identify how often manual imports will need to be conducted to make sure data is usable.

    Identify other nondiscoverable data that will need to be added to or accessed by the CMDB

    Foundational data, such as technicians, end users and approvers, roles, location, company, agency, department, building, or cost center, may be added to tables that are within or accessed by the CMDB. Work with your vendor to understand structure and where this information resides.

    • These records can be imported from CSV files manually, but this will require manual removal or edits as information changes.
    • Integration with the HRIS, Active Directory, or LDAP will enable automatic updates through synchronization or scheduled imports.
    • If synchronization is fully enabled, new data can be added and removed from the CMDB automatically.
    • Identify which nondiscoverable attributes will be needed, such as system criticality, support groups, groups it is managed by, location.
    • If partially automating the process, identify where manual updates will need to occur.
    • If fully automating the process, notifications will need to be set up when business owner or product or technical owner fields become empty to prompt defining a replacement within the CMDB.
    • Determine who will manage these updates.
    • Work with your CMDB implementation vendor to determine the best option for bringing this information in.

    1.1.5 Record required data sources

    Allot 15 minutes for this discussion.

    1. Where do you track the work involved in providing services? Typically, your ticket database tracks service requests and incidents. Additional data sources can include:
      • Enterprise resource planning tools for tracking purchase orders
      • Project management information system for tracking tasks
    2. What trusted data sources exist for the technology that supports these services? Examples include:
      • Management tools (e.g. Microsoft Endpoint Configuration Manager)
      • Architectural diagrams and network topology diagrams
      • IT asset management database
      • Spreadsheets
      • Other systems of record
    3. What other data sources can help you gather the data you identified in activity 1.1.4?
    4. Record the relevant data sources for each use case in the Configuration Management Standard Operating Procedures, section 6: Data Collection and Updates.

    Info-Tech Insight

    Improve the trustworthiness of your CMDB as a system of record by relying on data that is already trusted.

    Input

    Output

    • Use cases
    • List of data requirements
    MaterialsParticipants
    • Use Cases and Data Worksheet
    • Configuration Management Standard Operating Procedures
    • IT and business service owners
    • Practice owners and managers
    • SCM practice manager
    • SCM project sponsor

    Step 1.2

    Define roles and responsibilities

    Activities

    1.2.1 Record the project team and stakeholders

    1.2.2 Complete a RACI chart to define who will be accountable and responsible for configuration tasks

    This step will walk you through the following aspects of a configuration management system:

    • Roles and responsibilities

    This phase involves the following participants:

    • IT service owners
    • Enterprise architects
    • Practice owners and managers
    • SCM practice manager
    • Project manager

    Identify the roles you need in your SCM project

    Determine which roles will need to be involved in the initial project and how to source these roles.

    Leadership Roles
    Oversee the SCM implementation

    1. Configuration Manager – The practice owner for SCM. This is a long-term role.
    2. Configuration Control Board (CCB) Chair – An optional role that oversees proposed alterations to configuration plans. If a CCB is implemented, this is a long-term role.
    3. Project Sponsor or Program Sponsor – Provides the necessary resources for building the CMDB and SCM practices.
    4. Architecture Roles
      Plan the program to build strong foundation
      1. Configuration Management Architect – Technical leader who defines the overall CM solution, plans the scope, selects a tool, and leads the technical team that will implement the solution.
      2. Requirements Analyst – Gathers and manages the requirements for CM.
      3. Process Engineer – Defines, documents, and implements the entire process.

    Architecture Roles
    Plan the program to build strong foundation

    1. Configuration Management Architect – Technical leader who defines the overall CM solution, plans the scope, selects a tool, and leads the technical team that will implement the solution.
    2. Requirements Analyst – Gathers and manages the requirements for CM.
    3. Process Engineer – Defines, documents, and implements the entire process.

    Engineer Roles
    Implement the system

    1. Logical Database Analyst (DBA) Designs the structure to hold the configuration management data and oversees implementation.
    2. Communications and Trainer – Communicates the goals and functions of CM and teaches impacted users the how and why of the process and tools.

    Administrative Roles
    Permanent roles involving long-term ownership

    1. Technical Owner – The system administrator responsible for their system's uptime. These roles usually own the data quality for their system.
    2. Configuration Management Integrator – Oversees regular transfer of data into the CMDB.
    3. Configuration Management Tool Support – Selects, installs, and maintains the CM tool.
    4. Impact Manager – Analyzes configuration data to ensure relationships between CIs are accurate; conducts impact analysis.

    1.2.1 Record the project team and stakeholders

    Allocate 25 minutes to this discussion.

    1. Record the project team.
      1. Identify the project manager who will lead this project.
      2. Identify key personnel that will need to be involved in design of the configuration management system and processes.
      3. Identify where vendors/outsourcers may be required to assist with technical aspects.
      4. Document the project team in the Configuration Management Project Charter, section 1.1: Project Team.
    1. Record a list of stakeholders.
      1. Identify stakeholders internal and external to IT.
      2. Build the stakeholder profile. For each stakeholder, identify their role, interest in the project, and influence on project success. You can score these criteria high/medium/low or score them out of ten.
      3. If managed service providers will need to be part of the equation, determine who will be the liaison and how they will provide or access data.
    Input

    Output

    • Project team members
    • Project plan resources
    MaterialsParticipants
    • Configuration Management Project Charter
    • List of project stakeholders and participants
    • IT service owners
    • Practice owners and managers
    • SCM practice manager
    • SCM project sponsor

    Even with full automation, this cannot be a "set it and forget it" project if it is to be successful long-term

    Create a team to manage the process and data updates and to ensure data is always usable.

    • Services may be added and removed.
    • Technology will change as technical debt is reduced.
    • Vendors may change as contract needs develop.
    • Additional use cases may be introduced by IT and the business as approaches to management evolve.
    • AIOps can reduce the level of effort and improve visibility as configuration items change from the baseline and notifications are automated.
    • Changes can be checked against requests for changes through automated reconciliations, but changes will still need to be investigated where they do not meet expectations.
    • Manual data changes will need to be made regularly and verified.

    "We found that everyone wanted information from the CMDB, but no one wanted to pay to maintain it. People pointed to the configuration management team and said, 'It's their responsibility.'

    Configuration managers, however, cannot own the data because they have no way of knowing if the data is accurate. They can own the processes related to checking accuracy, but not the data itself."
    – Tim Mason, founding director at TRM Associates
    (Excerpt from Viewpoint: Focus on CMDB Leadership)

    Include these roles in your CMDB practice to ensure continued success and continual improvement

    These roles can make up the configuration control board (CCB) to make decisions on major changes to services, data models, processes, or policies. A CCB will be necessary in complex environments.

    Configuration Manager

    This role is focused on ensuring everyone works together to build the CMDB and keep it up to date. The configuration manager is responsible to:

    • Plan and manage the standards, processes, and procedures and communicate all updates to appropriate staff. Focused on continual improvement.
    • Plan and manage population of the CMDB and ensure data included meets criteria for cost effectiveness and reasonable effort for the value it brings.
    • Validate scope of services and CIs to be included and controlled within the CMDB and manage exceptions.
    • Audit data quality to ensure it is valid, is current, and meets defined standards.
    • Evaluate and recommend tools to support processes, data collection, and integrations.
    • Ensure configuration management processes interface with all other service and business management functions to meet use cases.
    • Report on configuration management performance and take appropriate action on process adherence and quality issues.

    Configuration Librarian

    This role is most important where manual data entry is prevalent and where many nonstandard configurations are in place. The librarian role is often held by the tool administrator. The librarian focuses specifically on data within the CMDB, including:

    • Manual updates to configuration data.
    • CMDB data verification on a regular schedule.
    • Processing ad hoc requests for data.

    Product/Service/Technical Owners

    The product or technical owner will validate information is correctly updating and reflects the existing data requirements as new systems are provisioned or as existing systems change.

    Interfacing Practice Owners

    All practice owners, such as change manager, incident manager, or problem manager, must work with the configuration team to ensure data is usable for each of the use cases they are responsible for.

    Download the Configuration Manager job description

    Assign configuration management responsibilities and accountabilities

    Align authority and accountability.

    • A RACI exercise will help you discuss and document accountability and responsibility for critical configuration management activities.
    • When responsibility and accountability are not well documented, it's often useful to invite a representative of the roles identified to participate in this alignment exercise. The discussion can uncover contrasting views on responsibility and governance, which can help you build a stronger management and governance model.
    • The RACI chart can help you identify who should be involved when making changes to a given activity. Clarify the variety of responsibilities assigned to each key role.
    • In the future, you may need to define roles in more detail as you change your configuration management procedures.

    Responsible: The person who actually gets the job done.
    Different roles may be responsible for different aspects of the activity relevant to their role.

    Accountable: The one role accountable for the activity (in terms of completion, quality, cost, etc.)
    Must have sufficient authority to be held accountable; responsible roles are often accountable to this role.

    Consulted: Those who need the opportunity to provide meaningful input at certain points in the activity; typically, subject matter experts or stakeholders. The more people you must consult, the more overhead and time you'll add to a process.

    Informed: Those who receive information regarding the task but do not need to provide feedback.
    Information might relate to process execution, changes, or quality.

    Complete a RACI chart to define who will be accountable and responsible for configuration tasks

    Determine what roles will be in place in your organization and who will fulfill them, and create your RACI chart to reflect what makes sense for your organization. Additional roles may be involved where there is complexity.

    R = responsible, A = accountable, C = consulted, I = informed CCB Configuration Manager Configuration Librarian Technical Owner(s) Interfacing Practice Owners Tool Administrator
    Plan and manage the standards, processes, and procedures and communicate all updates to appropriate staff. Focused on continual improvement. A R
    Plan and manage population of the CMDB and ensure data included meets criteria for cost effectiveness and reasonable effort for the value it brings. A R
    Validate scope of services and CIs to be included and controlled within the CMDB and manage exceptions. A R
    Audit data quality to ensure it is valid, is current, and meets defined standards. A,R
    Evaluate and recommend tools to support processes, data collection, and integrations. A,R
    Ensure configuration management processes interface with all other service and business management functions to meet use cases. A
    Report on configuration management performance and take appropriate action on process adherence and quality issues. A
    Make manual updates to configuration data. A
    Conduct CMDB data verification on a regular schedule. A
    Process ad hoc requests for data. A
    Enter new systems into the CMDB. A R
    Update CMDB as systems change. A R
    Identify new use cases for CMDB data. R A
    Validate data meets the needs for use cases and quality. R A
    Design reports to meet use cases. R
    Ensure integrations are configured as designed and are functional. R

    1.2.2 Complete a RACI chart to define who will be accountable and responsible for configuration tasks

    Allot 60 minutes for this discussion.

    1. Open the Configuration Management Standard Operating Procedures, section 4.1: Responsibility Matrix. In the RACI chart, review the top row of roles. Smaller organizations may not need a configuration control board, in which case the configuration manager may have more authority.
    2. Modify or expand the process tasks in the left column as needed.
    3. For each role, identify what that person is responsible for, accountable for, consulted on, or informed of. Fill out each column.
    4. Document in the SOP. Schedule a time to share the results with organization leads.
    5. Distribute the chart among all teams in your organization.
    6. Describe additional roles as needed in the documentation.
    7. Add accountabilities and responsibilities for the CCB into the Configuration Control Board Charter.
    8. If appropriate, add auxiliary roles to the Configuration Management Standard Operating Procedures, section 4.2: Configuration Management Auxiliary Role Definitions.

    Notes:

    1. Assign one Accountable for each task.
    2. Have one or more Responsible for each task.
    3. Avoid generic responsibilities such as "team meetings."
    4. Keep your RACI definitions in your documents for quick reference.

    Refer back to the RACI chart when building out the communications plan to ensure accountable and responsible team members are on board and consulted and informed people are aware of all changes.

    Input

    Output

    • Task assignments
    • RACI chart with roles and responsibilities
    MaterialsParticipants
    • Configuration Management Standard Operating Procedures, RACI chart
    • Configuration Control Board Charter, Responsibilities section
    • IT service owners
    • Practice owners and managers
    • SCM practice manager
    • SCM project sponsor

    Phase 2

    Configuration Management Data Model

    StrategyData StructureProcessesRoadmap
    • Challenges and Goals
    • Use Cases and Data
    • Roles and Responsibilities
    • Services
    • Classifications
    • Data Modeling
    • Lifecycle Processes
    • Baselines
    • Audit and Data Validation
    • Metrics
    • Communications Plan
    • Roadmap

    This phase will walk you through the following aspects of a configuration management system:

    • Data Model
    • Customer-Facing and Supporting Services
    • Business Capabilities
    • Relationships
    • IT Infrastructure Components
    • Enterprise Software
    • End-User Devices
    • Documents

    This phase involves the following participants:

    • IT service owners
    • Enterprise architects
    • Practice owners and managers
    • CM practice manager
    • CM project manager

    Step 2.1

    Build a framework for CIs and relationships

    Activities

    Document services:

    2.1.1 Define and prioritize your services

    2.1.2 Test configuration items against existing categories

    2.1.3 Create a configuration control board charter to define the board's responsibilities and protocols

    This step will walk you through the following aspects of a configuration management system:

    • Data model
    • Configuration items
    • Relationships

    This phase involves the following participants:

    • IT service owners
    • Enterprise architects
    • Practice owners and managers
    • CM practice manager
    • Project manager

    Making sense of data daily will be key to maintaining it, starting with services

    As CIs are discovered and mapped, they will automatically map to each other based on integrations, APIs, queries, and transactions. However, CIs also need to be mapped to a conceptional model or service to present the service and its many layers in an easily consumable way.

    These services will need to be manually created or imported into the CMDB and manually connected to the application services. Services can be mapped to technical or business services or both.

    If business services reporting has been requested, talk to the business to develop a list of services that will be required. Use terms the business will be expecting and identify which applications and instances will be mapped to those services.

    If IT is using the CMDB to support service usage and reporting, develop the list of IT services and identify which applications and instances will be mapped to those services.

    This image show the relationship between Discoverable and Nondiscoverable CIs. The discoverable CIs are coloured in purple, and the nondiscoverables are blue.

    Work with your stakeholders to ensure catalog items make sense to them

    There isn't a definitive right or wrong way to define catalog items. For example, the business and IT could both reference application servers, but only IT may need to see technical services broken down by specific locations or device types.

    Refer back to your goals and use cases to think through how best to meet those objectives and determine how to categorize your services.

    Define the services that will be the top-level, nondiscoverable services, which will group together the CIs that make up the complete service. Identify which application(s) will connect into the technical service.

    When you are ready to start discovery, this list of services will be connected to the discovered data to organize it in a way that makes sense for how your stakeholders need to see the data.

    While working toward meeting the goals of the first few use cases, you will want to keep the structure simple. Once processes are in place and data is regularly validated, complexities of different service types and names can be integrated into the data.

    This image show the relationship between Discoverable and Nondiscoverable CIs. Both Discoverable and nondiscoverable CIs are blue.

    Application Service(blue); Technical Service(Purple); IT Shared Services(Orange); Billable Services(green); Service Portfolio(red)

    Define the service types to manage within the CMDB to logically group CIs

    Determine which method of service groupings will best serve your audience for your prioritized use cases. This will help to name your service categories. Service types can be added as the CMDB evolves and as the audience changes.

    Application Service

    Technical Service

    IT Shared Services

    Billable Services

    Service Portfolio

    A set of interconnected applications and hosts configured to offer a service to the organization.

    Example: Financial application service, which may include email, web server, application server, databases, and middleware.

    A logical grouping of CIs based on common criteria.

    Example: Toronto web services, which may include several servers, web applications, and databases.

    A logical grouping of IT and business services shared and used across the organization.

    Example: VoIP/phone services or networking or security services.

    A group of services that will be billed out to departments or customers and would require logical groupings to enable invoicing.

    A group of business and technical service offerings with specific performance reporting levels. This may include multiple service levels for different customer audiences for the same service.

    2.1.1 Define and prioritize your services

    Prioritize your starting point. If multiple audiences need to be accommodated, work with one group at a time.

    Timing: will vary depending on number of services, and starting point

    1. Create your list of services, referencing an existing service catalog, business continuity or disaster recovery plan, list of applications, or brainstorming sessions. Use the terminology that makes the most sense for the audience and their reporting requirements.
    2. If this list is already in place, assess for relevance and reduce the list to only those services that will be managed through the CMDB.
    3. Determine what data will be relevant for each service based on the exercises done in 1.1.4 and 1.1.5. For example, if priority was a required attribute for use case data, ensure each service lists the priority of that service.
    4. For each of these, identify the supporting services. These items can come from your technical service catalog or list of systems and software.
    5. Document this table in the Use Cases and Data Worksheet, tab 3: Service Catalog.

    Service Record Example

    Service: Email
    Supporting Services: M365, Authentication Services

    Service Attributes

    Availability: 24/7 (99.999%)
    Priority: Critical
    Users: All
    Used for: Collaboration
    Billable: Departmental
    Support: Unified Support Model, Account # 123456789

    The CMDB will be organized by services and will enable data analysis through multiple categorization schemes

    To extract maximum service management benefit from a CMDB, the highest level of CI type should be a service, as demonstrated below. While it is easier to start at the system or single-asset level, taking the service mapping approach will provide you with a useful and dynamic view of your IT environment as it relates to the services you offer, instead of a static inventory of components.

    Level 1: Services

    • Business Service Offering: A business service is an IT service that supports a business process, or a service that is delivered to business customers. Business service offerings typically are bound by service-level agreements.
    • IT Service Offering: An IT service supports the customer's business processes and is made up of people, processes, and technology. IT service offerings typically are bound by service-level agreements.

    Level 2: Infrastructure CIs

    • IT Component Set: An IT service offering consists of one of more sets of IT components. An IT component set allows you to group or bundle IT components with other components or groupings.
    • IT Component: An IT system is composed of one or more supporting components. Many components are shared between multiple IT systems.

    Level 3: Supporting CIs

    • IT Subcomponent: Any IT asset that is uniquely identifiable and a component of an IT system.
    • IT components can have subcomponents, and those components can have subcomponents, etc.

    Two charts, showing Enterprise Architect Model and Configuration Service Model. Each box represents a different CI.

    Assess your CMDB's standard category offerings against your environment, with a plan to minimize customization

    Standard categorization schemes will allow for easier integration with multiple tools and reporting and improve results if using machine learning to automate categorization. If the CMDB chosen includes structured categories, use that as your starting point and focus only on gaps that are not addressed for CIs unique to your environment.

    There is an important distinction between a class and a type. This concept is foundational for your configuration data model, so it is important that you understand it.

    • Types are general groupings, and the things within a type will have similarities. For attributes that you want to collect on a type, all children classes and CIs will have those attribute fields.
    • Classes are a more specific grouping within a type. All objects within a class will have specific similarities. You can also use subclasses to further differentiate between CIs.
    • Individual CIs are individual instances of a class or subclass. All objects in a class will have the same attribute fields and behave the same, although the values of their attributes will likely differ.
    • Attributes may be discovered or nondiscoverable and manually added to CIs. The attributes are properties of the CI such as serial number, version, memory, processor speed, or asset tag.

    Use inheritance structures to simplify your configuration data model.

    An example CM Data Model is depicted.

    Assess the list of classes of configuration items against your requirements

    Types are general groupings, and the things within a type will have similarities. Each type will have its own table within the CMDB. Classes within a type are a more specific grouping of configuration items and may include subclasses.

    Review your vendor's CMDB documentation. Find the list of CI types or classes. Most CMDBs will have a default set of classes, like this standard list. If you need to build your own, use the table below as a starting point. Define anything required for unique classes. Create a list and consult with your installation partner.

    Sample list of classes organized by type

    Types Services Network Hardware Storage Compute App Environment Documents
    Classes
    • Application Service
    • Technical Service
    • IT Shared Service
    • Billable Service
    • Service Portfolio
    • Switch
    • Router
    • Firewall
    • Modem
    • SD-WAN
    • Load Balancer
    • UPS
    • Computer
    • Laptop
    • Server
    • Tablet
    • Database
    • Network-Attached Storage
    • Storage Array Network
    • Blob
    • Operating System
    • Hypervisor
    • Virtual Server
    • Virtual Desktop
    • Appliance
    • Virtual Application
    • Enterprise Application
    • Line of Business Application Software
    • Development
    • Test
    • Production
    • Contract
    • Business Impact Analysis
    • Requirements

    Review relationships to determine which ones will be most appropriate to map your dependencies

    Your CMDB should include multiple relationship types. Determine which ones will be most effective for your environment and ensure everyone is trained on how to use them. As CIs are mapped, verify they are correct and only manually map what is incorrect or not mapping through automation.

    Manually mapping CMDB relationships may be time consuming and prone to error, but where manual mapping needs to take place, ensure the team has a common view of the dependency types available and what is important to map.

    Use automated mapping whenever possible to improve accuracy, provide functional visualizations, and enable dynamic updates as the environment changes.

    Where a dependency maps to external providers, determine where it makes sense to discover and map externally provided CIs.

    • Only connect where there is value in mapping to vendor-owned systems.
    • Only connect where data and connections can be trusted and verified.

    Most common dependency mapping types

    A list of the most common dependency mapping types.

    2.1.2 Test configuration items against existing categories

    Time to complete: 1-2 hours

    1. Select a service to test.
    2. Identify the various components that make up the service, focusing on configuration items, not attributes
    3. Categorize configuration items against types and classes in the default settings of the CMDB.
    4. Using the default relationships within the CMDB, identify the relationships between the configuration items.
    5. Identify types, classes, and relationships that do not fit within the default settings. Determine if there are common terms for these items or determine most appropriate name.
    6. Validate these exceptions with the publisher.
    7. Document exceptions in the Configuration Management Standard Operating Procedures, Appendix 2: Types and Classes of Configuration Items
    Input

    Output

    • List of default settings for classes, types, and relationships
    • Small list of services for testing
    • List of CIs to map to at least one service
    • List of categories to add to the CMDB solution.
    MaterialsParticipants
    • Use Cases and Data Worksheet
    • Configuration Management Standard Operating Procedures
    • IT service owners
    • Practice owners and managers
    • SCM practice manager
    • SCM project sponsor

    2.1.3 Create a configuration control board charter to define the board's responsibilities and protocols

    A charter will set the tone for meetings, ensure purpose is defined and meeting cadence is set for regular reviews.

    1. Open the Configuration Control Board Charter. Review the document and modify as appropriate for your CCB. This will include:
      • Purpose and mandate of the committee – Reference objectives from the project charter.
      • Team composition – Determine the right mix of team members. A team of six to ten people can provide a good balance between having a variety of opinions and getting work done.
      • Voting option – Determine the right quorum to approve changes.
      • Responsibilities – List responsibilities, starting with RACI chart items.
      • Authority – Define the control board's span of control.
      • Governing laws and regulations – List any regulatory requirements that will need to be met to satisfy your auditors.
      • Meeting preparation – Set expectations to ensure meetings are productive.
    2. Distribute the charter to CCB members.
    Input

    Output

    • Project team members
    • Project plan resources
    MaterialsParticipants
    • Configuration Control Board Charter
    • IT service owners
    • Practice owners and managers
    • SCM practice manager
    • SCM project sponsor

    Assess the default list of statuses for each state

    Align this list with your CMDB

    Minimize the number of customizations that will make it difficult to update the platform.

    1. Review the default status list within the tool.
    2. Identify which statuses will be most used. Write a definition for each status.
    3. Update this list as you update process documentation in Step 3.1. After initial implementation, this list should only be modified through change enablement.
    4. Record this list of statuses in the Configuration Management Standard Operating Procedures, Appendix 4: Statuses
    State Status Description
    Preparation Ordered Waiting delivery from the vendor
    In Planning Being created
    Received Vendor has delivered the item, but it is not ready for deployment
    Production In Stock Available to be deployed
    In Use Deployed
    On Loan Deployed to a user on a temporary basis
    For Removal Planning to be phased out but still deployed to an end user
    Offline In Transit Moving to a new location
    Under Maintenance Temporarily offline while a patch or change is applied
    Removed Decommissioned Item has been retired and is no longer in production
    Disposed Item has been destroyed and we are no longer in possession of it
    Lost Item has been lost
    Stolen Item has been stolen

    Step 2.2

    Document statuses, attributes, and data sources

    Activities

    2.2.1 Follow the packet and map out the in-scope services and data centers

    2.2.2 Build data model diagrams

    2.2.3 Determine access rights for your data

    This step will walk you through the following aspects of a configuration management system:

    • Statuses
    • Attributes for each class of CI

    This phase involves the following participants:

    • IT service owners
    • Enterprise architects
    • Practice owners and managers
    • SCM practice manager
    • Project manager

    Outcomes of this step

    • Framework for approaching CI statuses
    • Attributes for each class of CI
    • Data sources for those attributes

    Service mapping approaches

    As you start thinking about dependency mapping, it's important to understand the different methods and how they work, as well as your CMDB's capabilities. These approaches may be all in the same tool, or the tool may only have the top-down options.

    Top down, most common

    Pattern-based

    Most common option, which includes indicators of connections such as code, access rights, scripting, host discovery, and APIs.

    Start with pattern-based, then turn on traffic-based for more detail. This combination will provide the most accuracy.

    Traffic-based

    Map against traffic patterns involving connection rules to get more granular than pattern-based.

    Traffic-based can add a lot of overhead with extraneous data, so you may not want to run it continuously.

    Tag-based

    Primarily used for cloud, containers, and virtual machines and will attach the cloud licenses to their dependent services and any related CIs.

    Tags work well with cloud but will not have the same hierarchical view as on-premises dependency mapping.

    Machine learning

    Machine learning will look for patterns in the traffic-based connections, match CIs to categories and help organize the data.

    Machine learning (ML) may not be in every solution, but if you have it, use it. ML will provide many suggestions to make the life of the data manager easier.

    Model hierarchy

    Automated data mapping will be helpful, but it won't be foolproof. It's critical to understand the data model to validate and map nondiscoverable CIs correctly.

    The framework consists of the business, enterprise, application, and implementation layers.

    The business layer encodes real-world business concepts via the conceptual model.

    The enterprise layer defines all enterprise data assets' details and their relationships.

    The application layer defines the data structures as used by a specific application.

    The implementation layer defines the data models and artifacts for use by software tools.

    An example of Model Hierarchy is depicted.

    Learn how to create data models with Info-Tech's blueprint Create and Manage Enterprise Data Models

    2.2.1 Follow the packet and map out the in-scope services and data centers

    Reference your network topology and architecture diagrams.

    Allot 1 hour for this activity.

    1. Start with a single service that is well understood and documented.
    2. Identify the technical components (hardware and applications) that make up the service.
    3. Determine if there is a need to further break down services into logical service groupings. For example, the email service to the right is broken down into authentication and mail flow.
    4. If you don't have a network diagram to follow, create a simple one to identify workflows within the service and components the service uses.
    5. Record the apps and underlying components in the Configuration Management Standard Operating Procedures, Appendix 1: Configuration Data Model Structure.

    This information will be used for CM project planning and validating the contents of the CMDB.

    an example of a Customer-facing service is shown, for Email sample topology.

    Download the Configuration Management Diagram Template Library to see an example.

    Build your configuration data model

    Rely on out-of-the-box functionality where possible and keep a narrow focus in the early implementation stages.

    1. If you have an enterprise architecture, then your configuration management data model should align with it.
    2. Keep a narrow focus in the early implementation stages. Don't fill up your CMDB until you are ready to validate and fix the data.
    3. Rely on out-of-the-box (OOTB) functionality where possible. If your configuration management database (CMDB) and platform do not have a data model OOTB, then rely on a publicly available data model.
    4. Map your business or IT service offering to the first few layers.

    Once this is built out in the system, you can let the automated dependency mapping take over, but you will still need to validate the accuracy of the automated mapping and investigate anything that is incorrect.

    Sample Configuration Data Model

    Every box represents a CI, and every line represents a relationship

    A sample configuration Data model is shown.

    Example: Data model and CMDB visualization

    Once the data model is entered into the CMDB, it will provide a more dynamic and complex view, including CIs shared with other services.

    An example of a Data Model Exercise

    CMDB View

    An example of a CMDB View of the Data Model Exercise

    2.2.2 Build data model diagrams

    Visualize the expected CI classes and relationships.

    Allot 45 minutes.

    1. Identify the different data model views you need. Use multiple diagrams to keep the information simple to read and understand. Common diagrams include:
      1. Network level: Outline expected CI classes and relationships at the network level.
      2. Application level: Outline the expected components and relationships that make up an application.
      3. Services level: Outline how business capability CIs and service CIs relate to each other and to other types of CIs.
    1. Use boxes to represent CI classes.
    2. Use lines to represent relationships. Include details such as:
      1. Relationship name: Write this name on the arrow.
      2. Direction: Have an arrow point to each child.

    Review samples in Configuration Management Diagram Template Library.
    Record these diagrams in the Configuration Management Standard Operating Procedures, Appendix 1: Configuration Data Model Structure.

    Input

    Output

    • List of default settings for classes, types, and relationships
    • Small list of services for testing
    • List of CIs to map to at least one service
    • List of additions of categories to add to the CMDB solution.
    MaterialsParticipants
    • Configuration Management Standard Operating Procedures
    • Configuration Management Diagram Template Library
    • IT service owners
    • Practice owners and managers
    • SCM practice manager
    • SCM project sponsor

    Download the Configuration Management Diagram Template Library to see examples.

    Determine governance for data security, access, and validation

    Align CMDB access to the organization's access control policy to maintain authorized and secure access for legitimate staff performing their role.

    Data User Type Access Role
    Data consumers
    • View-only access
    • Will need to view and use the data but will not need to make modifications to it
    • Service desk
    • Change manager
    • Major incident manager
    • Finance
    CMDB owner
    • Read/write access with the ability to update and validate data as needed
    • Configuration manager
    Domain owner
    • Read/write access for specific domains
    • Data owner within their domain, which includes validating that data is in the database and that it is correctly categorized.
    • Enterprise architect
    • Application owner
    Data provider
    • Read/write access for specific domains
    • Ensures automated data has been added and adds nondiscoverable assets and attributes as needed
    • Server operations
    • Database management
    • Network teams
    CMDB administrator
    • View-only access for data
    • Will need to have access for modifying the structure of the product, including adding fields, as determined by the CCB
    • ITSM tool administrator

    2.2.3 Determine access rights for your data

    Allot 30 minutes for this discussion.

    1. Open the Configuration Management Standard Operating Procedures, section 5: Access Rights.
    2. Review the various roles from an access perspective.
      1. Who needs read-only access?
      2. Who needs read/write access?
      3. Should there be restrictions on who can delete data?
    1. Fill in the chart and communicate this to your CMDB installation vendor or your CMDB administrator.
    Input

    Output

    • Task assignments
    • Access rights and roles
    MaterialsParticipants
    • Configuration Management Standard Operating Procedures
    • IT service owners
    • Practice owners and managers
    • SCM practice manager
    • SCM project sponsor

    Phase 3

    Configuration Record Updates

    StrategyData StructureProcessesRoadmap
    • Challenges and Goals
    • Use Cases and Data
    • Roles and Responsibilities
    • Services
    • Classifications
    • Data Modeling
    • Lifecycle Processes
    • Baselines
    • Audit and Data Validation
    • Metrics
    • Communications Plan
    • Roadmap

    This phase will walk you through the following aspects of a configuration management system:

    • ITSM Practices and Workflows
    • Discovery and Dependency Mapping Tools
    • Auditing and Data Validation Practices

    This phase involves the following participants:

    • IT service owners
    • Enterprise architects
    • Practice owners and managers
    • SCM practice manager
    • SCM project manager
    • IT audit

    Harness Service Configuration Management Superpowers

    Step 3.1

    Keep CIs and relationships up to date through lifecycle process integrations

    Activities

    3.1.1 Define processes to bring new services into the CMDB

    3.1.2 Determine when each type of CI will be created in the CMDB

    3.1.3 Identify when each type of CI will be retired in the CMDB

    3.1.4 Record when and how attributes will change

    3.1.5 Institute configuration control and configuration baselines

    This step will walk you through the following aspects of a configuration management system:

    1. ITSM Practices and Workflows
    2. Discovery and Dependency Mapping Tools

    This phase involves the following participants:

    1. IT service owners
    2. Enterprise architects
    3. Practice owners and managers
    4. SCM practice manager
    5. Project manager

    Outcomes of this step

    • List of action items for updating interfacing practices and processes
    • Identification of where configuration records will be manually updated

    Incorporate CMDB updates into IT operations

    Determine which processes will prompt changes to the CMDB data

    Onboard new services - Offboard Redundant Services. Onboard new CIs - Offboard Redundant CIs; Maintain CIs - Update Attributes.

    Change enablement

    Identify which process are involved in each stage of data input, maintenance, and removal to build out a process for each scenario.

    Project management

    Change enablement

    Asset management

    Security controls

    Project management

    Incident management

    Deployment management

    Change enablement

    Asset management

    Security controls

    Project management

    Incident management

    Service management

    Formalize the process for adding new services to the CMDB

    As new services and products are introduced into the environment, you can improve your ability to correctly cost the service, design integrations, and ensure all operational capabilities are in place, such as data backup and business continuity plans.
    In addition, attributes such as service-level agreements (SLAs), availability requirements, and product, technical, and business owners should be documented as soon as those new systems are made live.

    • Introduce the technical team and CCB to the product early to ensure the service record is created before deployment and to quickly map the services once they are moved into the production environment.
    • Engage with project managers or business analysts to define the process to include security and technical reviews early.
    • Engage with the security and technical reviewers to start documenting the service as soon as it is approved.
    • Determine which practices will be involved in the creation and approval of new services and formalize the process to streamline entry of the new service, onboarding corresponding CIs and mapping dependencies.

    an example of the review and approval process for new service or products is shown.

    3.1.1 Define processes to bring new services into the CMDB

    Start with the most frequent intake methods, and if needed, use this opportunity to streamline the process.

    1. Discuss the methods for new services to be introduced to the IT environment.
    2. Critique existing methods to assess consistency and identify issues that could prevent the creation of services in the CMDB in a timely manner.
    3. Create a workflow for the existing processes, with an eye to improvement. Identify any changes that will need to be introduced and managed appropriately.
    4. Identify where additional groups may need to be engaged to ensure success. For example, if project managers are not interfacing early with IT, discuss process changes with them.
    5. Discuss the validation process and determine where control points are. Document these on the workflows.
    6. Complete the Configuration Management Standard Operating Procedures, section 8.1: Introduce New Service and Data Model.

    Possible intake opportunities:

    • Business-driven project intake process
    • IT-driven project intake process
    • Change enablement reviews
    • Vendor-driven product changes
    Input

    Output

    • Discussion
    • Intake processes
    MaterialsParticipants
    • Configuration Management Standard Operating Procedures
    • Configuration Management Diagram Template Library
    • Configuration control board
    • Configuration manager
    • Project sponsor
    • IT stakeholders

    Identify scenarios where CIs are added and removed in the configuration management database

    New CIs may be introduced with new services or may be introduced and removed as part of asset refreshes or through service restoration in incident management. Updates may be done by your own services team or a managed services provider.
    Determine the various ways the CIs may be changed and test with various CI types.
    Review attributes such as SLAs, availability requirements, and product, technical, and business owners to determine if changes are required.

    • Identify what will be updated automatically or manually. Automation could include discovery and dependency mapping or synchronization with AMDB or AIOps tools.
    • Engage with relevant program managers to define and validate processes.
    • Identify control points and review audit requirements.

    An example of New or refresh CI from Procurement.

    Info-Tech Insight

    Data deemed no longer current may be archived or deleted. Retained data may be used for tracing lifecycle changes when troubleshooting or meeting audit obligations. Determine what types of CIs and use cases require archived data to meet data retention policies. If none do, deletion of old data may be appropriate.

    3.1.2 Identify when each type of CI will be created in the CMDB

    Allot 45 minutes for discussion.

    1. Discuss the various methods for new CIs to be introduced to the IT environment.
    2. Critique existing methods to assess consistency and identify issues that could prevent the creation of CIs in the CMDB in a timely manner.
    3. Create a workflow for the existing processes, with an eye to improvement. Identify any changes that will need to be introduced and managed appropriately.
    4. Identify where additional groups may need to be engaged to ensure success. For example, if project managers are not interfacing early with IT, discuss process changes with them.
    5. Discuss the validation process and determine where control points are. Document these on the workflows.
    6. Complete Configuration Management Standard Operating Procedures, section 8.2: Introduce New Configuration Items to the CMDB

    Possible intake opportunities:

    • Business-driven project intake process
    • IT-driven project intake process
    • Change enablement reviews
    • Vendor-driven product changes
    • Incident management
    • Asset management, lifecycle refresh
    Input

    Output

    • Discussion
    • Retirement processes
    MaterialsParticipants
    • Configuration Management Standard Operating Procedures
    • Configuration Management Diagram Template Library
    • Configuration control board
    • Configuration manager
    • Project sponsor
    • IT stakeholders

    3.1.3 Identify when each type of CI will be retired in the CMDB

    Allot 45 minutes for discussion.

    1. Discuss the various methods for CIs to be removed from the IT environment.
    2. Critique existing methods to assess consistency and identify issues that could prevent the retirement of CIs in the CMDB in a timely manner.
    3. Create a workflow for the existing processes, with an eye to improvement. Identify any changes that will need to be introduced and managed appropriately.
    4. Identify where additional groups may need to be engaged to ensure success. For example, if project managers are not interfacing early with IT, discuss process changes with them.
    5. Discuss the validation process and determine where control points are. Document these on the workflows.
    6. Discuss data retention. How long will retired information need to be archived? What are the potential scenarios where legacy information may be needed for analysis?
    7. Complete the Configuration Management Standard Operating Procedures, section 8.4: Retire and Archive Configuration Records.

    Possible retirement scenarios:

    • Change enablement reviews
    • Vendor-driven product changes
    • Incident management
    • Asset management, lifecycle refresh
    Input

    Output

    • Discussion
    • Intake processes
    MaterialsParticipants
    • Configuration Management Standard Operating Procedures
    • Configuration Management Diagram Template Library
    • Configuration control board
    • Configuration manager
    • Project sponsor
    • IT stakeholders

    Determine appropriate actions for detecting new or changed CIs through discovery

    Automated detection will provide the most efficient way of recording planned changes to CIs as well as detected unplanned changes. Check with the tool to determine what reports or notifications are available for the configuration management process and define what actions will be appropriate.

    As new CIs are detected, identify the process by which they should have been introduced into configuration management and compare against those records. If your CMDB can automatically check for documentation, this may be easier. Weekly reporting will allow you to catch changes quickly, and alerts on critical CIs could enable faster remediation, if the tool allows for alerting. AIOps could identify, notify of, and process many changes in a highly dynamic environment.

    Type of Change

    Impacted Process

    Validation

    Findings

    Actions

    Configuration change to networking equipment or software

    Change management

    Check for request for change

    No RFC

    Add to CAB agenda, notify technical owner

    Configuration change to end-user device or software

    Asset management

    Check for service ticket

    No ticket

    Escalate to asset agenda, notify service manager

    New assets coming into service

    Security incident and event management

    Check for SIEM integration

    No SIEM integration

    Notify security operations team to investigate

    The configuration manager may not have authority to act but can inform the process owners of unauthorized changes for further action. Once the notifications are forwarded to the appropriate process owner, the configuration manager will note the escalation and follow up on data corrections as deemed appropriate by the associated process owner.

    3.1.4 Record when and how attributes will change

    These lists will help with configuration control plans and your implementation roadmap.

    1. List each attribute that will change in that CI type's life.
    2. Write all the times that each attribute will change. Identify:
      1. The name of the workflow, service request, process, or practice that modifies the attribute.
      2. Whether the update is made automatically or manually.
      3. The role or tool that updates the CMDB.
    1. Update the relevant process or procedure documentation. Explicitly identify when the configuration records are updated.

    Document these tables in Configuration Management Standard Operation Procedures, Section 8.7: Practices That Modify CIs.

    Network Equipment
    Attributes

    Practices That Modify This Attribute

    Status
    • Infra Deployment (updated manually by Network Engineering)
    • Change Enablement (updated manually by CAB or Network Engineering)
    Assigned User
    • IT Employee Offboarding or Role Change (updated manually by Network Engineering)
    Version
    • Patch Deployment (updated automatically by SolarWinds)
    End-User Computers
    Attributes
    Practices That Modify This Attribute
    Status
    • Device Deployment (updated manually by Desktop Support)
    • Device Recovery (updated manually by Desktop Support)
    • Employee Offboarding and Role Change (updated manually by Service Desk)
    Assigned User
    • Device Deployment (updated manually by Desktop Support)
    • Device Recovery (updated manually by Desktop Support)
    • Employee Offboarding and Role Change (updated manually by Service Desk)
    Version
    • Patch Deployment (updated automatically by ConfigMgr)

    Institute configuration control and configuration baselines where appropriate

    A baseline enables an assessment of one or more systems against the desired state and is useful for troubleshooting incidents or problems and validating changes and security settings.

    Baselines may be used by enterprise architects and system engineers for planning purposes, by developers to test their solution against production copies, by technicians to assess configuration drift that may be causing performance issues, and by change managers to assess and verify the configuration meets the target design.

    Configuration baselines are a snapshot of configuration records, displaying attributes and first-level relationships of the CIs. Standard configurations may be integral to the success of automated workflows, deployments, upgrades, and integrations, as well as prevention of security events. Comparing current CIs against their baselines will identify configuration drift, which could cause a variety of incidents. Configuration baselines are updated through change management processes.
    Configuration baselines can be used for a variety of use cases:

    • Version control – Management of software and hardware versions, https://dj5l3kginpy6f.cloudfront.net/blueprints/harness-configuration-management-superpowers-phases-1-4/builds, and releases.
    • Access control – Management of access to facilities, storage areas, and the CMS.
    • Deployment control – Take a baseline of CIs before performing a release so you can use this to check against actual deployment.
    • Identify accidental changes Everyone makes mistakes. If someone installs software on the wrong server or accidentally drops a table in a database, the CMS can alert IT of the unauthorized change (if the CI is included in configuration control).

    Info-Tech Insight

    Determine the appropriate method for evaluating and approving changes to baselines. Delegating this to the CCB every time may reduce agility, depending on volume. Discuss in CCB meetings.

    A decision tree for deploying requested changes.

    3.1.5 Institute configuration control and configuration baselines where appropriate

    Only baseline CIs and relationships that you want to control through change enablement.

    1. Determine criteria for capturing configuration baselines, including CI type, event, or processes.
    2. Identify who will use baselines and how they will use the data. Identify their needs.
    3. Identify CIs that will be out of scope and not have baselines created.
    4. Document requirements in the SOP.
    5. Ensure appropriate team members have training on how to create and capture baselines in the CMDB.
    6. Document in the Configuration Management Standard Operating Procedures, section 8.5: Establish and Maintain Configuration Baselines.
    Process Criteria Systems
    Change Enablement & Deployment All high-risk changes must have the baseline captured with version number to revert to stable version in the event of an unsuccessful change
    • Servers (physical and virtual)
    • Enterprise software
    • IaaS
    • Data centers
    Security Identify when configuration drift may impact risk mitigation strategies
    • Servers (physical and virtual)
    • Enterprise software
    • IaaS
    • Data centers
    Input

    Output

    • Discussion
    • Baseline configuration guidelines
    MaterialsParticipants
    • Configuration Management Standard Operating Procedures
    • Configuration control board
    • Configuration manager
    • Project sponsor
    • IT stakeholders

    Step 3.2

    Validate data within the CMDB

    Activities

    3.2.1 Build an audit plan and checklist

    This step will walk you through the following aspects of a configuration management system:

    • Data validation and audit

    This phase involves the following participants:

    • IT service owners
    • Enterprise architects
    • Practice owners and managers
    • SCM practice manager
    • Project manager
    • IT audit

    Outcomes of this step

    • Updates to processes for data validation
    • Plan for auditing and validating the data in the CMDB

    Audit and validate the CMDB

    Review the performance of the supporting technologies and processes to validate the accuracy of the CMDB.

    A screenshot of the CM Audit Plan.

    CM Audit Plan

    • CM policies
    • CM processes and procedures
    • Interfacing processes
    • Content within the CMDB

    "If the data in your CMDB isn't accurate, then it's worthless. If it's wrong or inaccurate, it's going to drive the wrong decisions. It's going to make IT worse, not better."
    – Valence Howden, Research Director, Info-Tech Research Group

    Ensure the supporting technology is working properly

    Does the information in the database accurately reflect reality?

    Perform functional tests during audits and as part of release management practices.

    Audit results need to have a clear status of "compliant," "noncompliant," or "compliant with conditions," and conditions need to be noted. The conditions will generally offer a quick win to improve a process, but don't use these audit results to quickly check off something as "done." Ensure the fix is useful and meaningful to the process.
    The audit should cover three areas:

    • Process: Are process requirements for the program well documented? Are the processes being followed? If there were updates to the process, were those updates to the process documented and communicated? Has behavior changed to suit those modified processes?
    • Physical: Physical configuration audits (PCAs) are audits conducted to verify that a configuration item, as built, conforms to the technical documentation that defines and describes it.
    • Functional: Functional configuration audits (FCAs) are audits conducted to verify that the development of a configuration item has been completed satisfactorily, the item has achieved the functional attributes specified in the functional or allocated baseline, and its technical documentation is complete and satisfactory.

    Build auditing and validation of processes whenever possible

    When technicians and analysts are working on a system, they should check to make sure the data about that system is correct. When they're working in the CMDB, they should check that the data they're working with is correct.

    More frequent audits, especially in the early days, may help move toward process adoption and resolving data quality issues. If audits are happening more frequently, the audits can include a smaller scope, though it's important to vary each one to ensure many different areas have been audited through the year.

    • Watch for data duplication from multiple discovery tools.
    • Review mapping to ensure all relevant CIs are attached to a product or service.
    • Ensure report data is logical.

    Ensure the supporting technology is working properly

    Does the information in the database accurately reflect reality?

    Perform functional tests during audits and as part of release management practices.

    Audit results need to have a clear status of "compliant," "noncompliant," or "compliant with conditions," and conditions need to be noted. The conditions will generally offer a quick win to improve a process, but don't use these audit results to quickly check off something as "done." Ensure the fix is useful and meaningful to the process.
    The audit should cover three areas:

    • Process: Are process requirements for the program well documented? Are the processes being followed? If there were updates to the process, were those updates to the process documented and communicated? Has behavior changed to suit those modified processes?
    • Physical: Physical configuration audits (PCAs) are audits conducted to verify that a configuration item, as built, conforms to the technical documentation that defines and describes it.
    • Functional: Functional configuration audits (FCAs) are audits conducted to verify that the development of a configuration item has been completed satisfactorily, the item has achieved the functional attributes specified in the functional or allocated baseline, and its technical documentation is complete and satisfactory.

    More frequent audits, especially in the early days, may help move toward process adoption and resolving data quality issues. If audits are happening more frequently, the audits can include a smaller scope, though it's important to vary each one to ensure many different areas have been audited through the year.

    • Watch for data duplication from multiple discovery tools.
    • Review mapping to ensure all relevant CIs are attached to a product or service.
    • Ensure report data is logical.

    Identify where processes break down and data is incorrect

    Once process stops working, data becomes less accurate and people find workarounds to solve their own data needs.

    Data within the CMDB often becomes incorrect or incomplete where human work breaks down

    • Investigate processes that are performed manually, including data entry.
    • Investigate if the process executors are performing these processes uniformly.
    • Determine if there are opportunities to automate or provide additional training.
    • Select a sample of the corresponding data in the CMS. Verify if the data is correct.

    Non-CCB personnel may not be completing processes fully or consistently

    • Identify where data in the CMS needs to be updated.
    • Identify whether the process practitioners are uniformly updating the CMS.
    • Discuss options for improving the process and driving consistency for data that will benefit the whole organization.

    Ensure that the data entered in the CMDB is correct

    • Confirm that there is no data duplication. Data duplication is very common when there are multiple discovery tools in your environment. Confirm that you have set up your tools properly to avoid duplication.
    • Build a process to respond to baseline divergence when people make changes without following change processes and when updates alter settings.
    • Audit the system for accuracy and completeness.

    3.2.1 Build an audit plan and checklist

    Use the audit to identify areas where processes are breaking down.

    Audits present you with the ability to address these pain points before they have greater negative impact.

    1. Identify which regulatory requirements and/or auditing bodies will be relevant to audit processes or findings.
    2. Determine frequency of practice audits and how they relate to internal audits or external audits.
    3. Determine audit scope, including requirements for data spot checks.
    4. Determine who will be responsible for conducting audits and validate this is consistent with the RACI chart.
    5. Record audit procedures in the Configuration Management Standard Operating Procedures section 8.6: Verify and Review the Quality of Information Through Auditing.
    6. Review the Configuration Management Audit and Validation Checklist and modify to suit your needs.

    Download the Configuration Management Audit and Validation Checklist

    Input

    Output

    • Discussion
    • Baseline configuration guidelines
    MaterialsParticipants
    • Configuration Management Standard Operating Procedures
    • Configuration control board
    • Configuration manager
    • Project sponsor
    • IT stakeholders

    Phase 4

    Service Configuration Roadmap

    StrategyData StructureProcessesRoadmap
    • Challenges and Goals
    • Use Cases and Data
    • Roles and Responsibilities
    • Services
    • Classifications
    • Data Modeling
    • Lifecycle Processes
    • Baselines
    • Audit and Data Validation
    • Metrics
    • Communications Plan
    • Roadmap

    This phase will walk you through the following aspect of a configuration management system:
    Roadmap
    This phase involves the following participants:

    • IT service owners
    • Enterprise architects
    • Practice owners and managers
    • SCM practice manager
    • SCM project manager

    Harness Service Configuration Management Superpowers

    Step 4.1

    Define measures of success

    Activities

    4.1.1 Identify key metrics to define configuration management success
    4.1.2 Brainstorm and record desired reports, dashboards, and analytics
    4.1.3 Build a configuration management policy

    This phase will walk you through the following aspects of a configuration management system:

    • Metrics
    • Policy

    This phase involves the following participants:

    • IT service owners
    • Enterprise architects
    • Practice owners and managers
    • SCM practice manager
    • SCM project manager

    The value of metrics can be found in IT efficiency increases

    When determining metrics for configuration management, be sure to separate metrics needed to gauge configuration management success and those that will use data from the CMDB to provide metrics on the success of other practices.

    • Metrics provide accurate indicators for IT and business decisions.
    • Metrics help you identify IT efficiencies and problems and solve issues before they become more serious.
    • Active metrics tracking makes root cause analysis of issues much easier.
    • Proper application of metrics helps IT services identification and prioritization.
    • Operational risks can be prevented by identifying and implementing metrics.
    • Metrics analysis increases the confidence of the executive team and ensures that IT is working well.

    A funnel is shown. The output is IT Performance. The inputs are: Service Desk Metrics; Incident Metrics; Asset Mgmt. Metrics; Release Mgmt. Metrics; Change Mgmt. Metrics; Infra. Metrics

    4.1.1 Identify key metrics to define configuration management success

    Determine what metrics are specifically related to the practice and how and when metrics will be accessed.

    Success factors

    Key metrics

    Source

    Product and service configuration data is relevant

    • Stakeholder satisfaction with data access, accuracy, and usability
    • Stakeholder satisfaction with service configuration management interface, procedures, and reports

    Stakeholder discussions

    • Number of bad decisions made due to incorrect or insufficient data
    • Impact of bad decisions made due to incorrect or insufficient data

    Process owner discussions

    • Number and impact of data identified as incorrect
    • % of CMDB data verified over the period

    CMDB

    Cost and effort are continually optimized

    • Effort devoted to service configuration management
    • Cost of tools directly related to the process

    Resource management or scheduling

    ERP

    Progress reporting

    • Communication execution
    • Process
    • Communications and feedback

    Communications team and stakeholder discussions

    Data – How many products are in the CMDB and are fully and accurately discovered and mapped?

    CMDB

    Ability to meet milestones on time and with appropriate quality

    Project team

    Document metrics in the Configuration Management Standard Operating Procedures, section 7: Success Metrics

    Use performance metrics to identify areas to improve service management processes using CMDB data

    Metrics can indicate a problem with service management processes but cannot provide a clear path to a solution on their own.

    • The biggest challenge is defining and measuring the process and people side of the equation.
    • Expected performance may also need to be compared to actual performance in planning, budgeting, and improvements.
    • The analysis will need to include critical success factors (CSFs), data collection procedures, office routines, engineering practices, and flow diagrams including workflows and key relationships.
    • External benchmarking may also prove useful in identifying how similar organizations are managing aspects of their infrastructure, processing transactions/requests, or staffing. If using external benchmarking for actual process comparisons, clearly defining your internal processes first will make the data collection process smoother and more informative.

    Info-Tech Insight

    Using a service framework such as ITIL, COBIT, or ISO 20000 may make this job easier, and subscribing to benchmarking partners will provide some of the external data needed for comparison.

    4.1.2 Brainstorm and record desired reports, dashboards, and analytics with related practices

    The project team will use this list as a starting point

    Allot 45 minutes for this discussion.

    1. Create a table for each service or business capability.
      1. Have one column for each way of consuming data: reports, dashboards, and ad hoc analytics.
      2. Have one row for each stakeholder group that will consume the information.
    2. Use the challenges and use cases to brainstorm reports, dashboards, and ad hoc analytic capabilities that each stakeholder group will find useful.
    3. Record these results in your Configuration Management Standard Operating Procedures, section 7: Aligned Processes' Desired Analytical Capabilities.
    Stakeholder Groups Reports Dashboards
    Change Management
    • CI changes executed without an RFC
    • RFCs grouped by service
    • Potential collisions in upcoming changes
    Security
    • Configuration changes that no longer match the baseline
    • New configuration items discovered
    Finance
    • Service-based costs
    • Service consumption by department

    Download the blueprint Take Control of Infrastructure and Operations Metrics to create a complete metrics program.

    Create a configuration management policy and communicate it

    Policies are important documents to provide definitive guidelines and clarity around data collection and use, process adherence, and controls.

    • A configuration management policy will apply to IT as the audience, and participants in the program will largely be technical.
    • Business users will benefit from a great configuration management program but will not participate directly.
    • The policy will include objectives and scope, use of data, security and integrity of data, data models and criteria, and baseline configurations.
    • Several governing regulations and practices may intersect with configuration management, such as ITIL, COBIT, and NIST frameworks, as well as change enablement, quality management, asset management, and more.
    • As the policy is written, review processes to ensure policies and processes are aligned. The policy should enable processes, and it may require modifications if it hinders the collection, security, or use of data required to meet proposed use cases.
    • Once the policy is written and approved, ensure all stakeholders understand the importance, context, and repercussions of the policy.

    The approvals process is about appropriate oversight of the drafted policies. For example:

    • Do the policies satisfy compliance and regulatory requirements?
    • Do the policies work with the corporate culture?
    • Do the policies address the underlying need?

    If the draft is approved:

    • Set the effective date and a review date.
    • Begin communication, training, and implementation.

    Employees must know that there are new policies and understand the steps they must take to comply with the policies in their work.

    Employees must be able to interpret, understand, and know how to act upon the information they find in the policies.

    Employees must be informed on where to get help or ask questions and who to request policy exceptions from.

    If the draft is rejected:

    • Acquire feedback and make revisions.
    • Resubmit for approval.

    4.1.3 Build a configuration management policy

    This policy provides the foundation for configuration control.

    Use this template as a starting point.

    The Configuration Management Policy provides the foundation for a configuration control board and the use of configuration baselines.
    Instructions:

    1. Review and modify the policy statements. Ensure that the policy statements reflect your organization and the expectations you wish to set.
    2. If you don't have a CCB: The specified responsibilities can usually be assigned to either the configuration manager or the governing body for change enablement.
    3. Determine if you should apply this policy beyond SCM. As written, this policy may provide a good starting point for practices such as:
      • Secure baseline configuration management
      • Software configuration management

    Two screenshots from the Configuration Management Policy template

    Download the Configuration Management Policy template

    Step 4.2

    Build communications and a roadmap

    Activities

    4.2.1 Build a communications plan
    4.2.2 Identify milestones

    This phase will walk you through the following aspects of a configuration management system:

    • Communications plan
    • Roadmap

    This phase involves the following participants:

    • IT service owners
    • Enterprise architects
    • Practice owners and managers
    • SCM practice manager
    • SCM project manager

    Outcomes of this step

    • Documented expectations around configuration control
    • Roadmap and action items for the SCM project

    Do not discount the benefits of a great communications plan as part of change management

    Many configuration management projects have failed due to lack of organizational commitment and inadequate communications.

    • Start at the top to ensure stakeholder buy-in by verifying alignment and use cases. Without a committed project sponsor who believes in the value of configuration management, it will be difficult to draw the IT team into the vision.
    • Clearly articulate the vision, strategy, and goals to all stakeholders. Ensure the team understands why these changes are happening, why they are happening now, and what outcomes you hope to achieve.
    • Gain support from technical teams by clearly expressing organizational and departmental benefits – they need to know "what's in it for me."
    • Clearly communicate new responsibilities and obligations and put a feedback process in place to hear concerns, mitigate risk, and act on opportunities for improvement. Be prepared to answer questions as this practice is rolled out.
    • Be consistent in your messaging. Mixed messages can easily derail progress.
    • Communicate to the business how these efforts will benefit the organization.
    • Share documents built in this blueprint or workshop with your technical teams to ensure they have a clear picture of the entire configuration management practice.
    • Share your measures and view of success and communicate wins throughout building the practice.

    30%

    When people are truly invested in change, it is 30% more likely to stick.
    McKinsey

    82%

    of CEOs identify organizational change management as a priority.
    D&B Consulting

    6X

    Initiatives with excellent change management are six times more likely to meet objectives than those with poor change management.
    Prosci

    For a more detailed program, see Drive Technology Adoption

    Formulate a communications plan to ensure all stakeholders and impacted staff will be aware of the plan

    Communication is key to success in process adoption and in identifying potential risks and issues with integration with other processes. Engage as often as needed to get the information you need for the project and for adoption.

    Identify Messages

    Distinct information that needs to be sent at various times. Think about:

    • Who will be impacted and how.
    • What the goals are for the project/new process.
    • What the audience needs to know about the new process and how they will interface with each business unit.
    • How people can request configuration data.

    Identify Audiences

    Any person or group who will be the target of the communication. This may include:

    • Project sponsors and stakeholders.
    • IT staff who will be involved in the project.
    • IT staff who will be impacted by the project (i.e. who will benefit from it or have obligations to fulfill because of it).
    • Business sponsors and product owners.

    Document and Track

    Document messaging, medium, and responsibility, working with the communications team to refine messages before executing.

    • Identify where people can send questions and feedback to ensure they have the information they need to make or accept the changes.
    • Document Q&A and share in a central location.

    Determine Timing

    Successful communications plans consider timing of various messages:

    • Advanced high-level notice of improvements for those who need to see action.
    • Advanced detailed notice for those who will be impacted by workload.
    • Advanced notice for who will be impacted (i.e. who will benefit from it or have obligations to fulfill because of it) once the project is ready to be transitioned to daily life.

    Determine Delivery

    Work with your communications team, if you have one, to determine the best medium, such as:

    • Meeting announcement for stakeholders and IT.
    • Newsletter for those less impacted.
    • Intranet announcements: "coming soon!"
    • Demonstrations with vendors or project team.

    4.2.1 Build a communications plan

    The communications team will use this list as a starting point.

    Allot 45 minutes for this discussion.

    Identify stakeholders.

    1. Identify everyone who will be affected by the project and by configuration management.

    Craft key messages tailored to each stakeholder group.

    1. Identify the key messages that must be communicated to each group.

    Finalize the communication plan.

    1. Determine the most appropriate timing for communications with each group to maximize receptivity.
    2. Identify any communication challenges you anticipate and incorporate steps to address them into your communication plan.
    3. Identify multiple methods for getting the messages out (e.g. newsletters, emails, meetings).
    1. Identify how feedback will be collected (i.e. through interviews or surveys) to measure whether the changes were communicated well.
    Audience Message Medium Timing Feedback Mechanism
    Configuration Management Team Communicate all key processes, procedures, policies, roles, and responsibilities In-person meetings and email communications Weekly meetings Informal feedback during weekly meetings
    Input

    Output

    • Discussion
    • Rough draft of messaging for communications team
    MaterialsParticipants
    • Project plan
    • Configuration manager
    • Project sponsor
    • IT director
    • Communications team

    Build a realistic, high-level roadmap including milestones

    Break the work into manageable pieces

    1. Plan to have multiple phases with short-, medium-, and long-term goals/timeframes. Building a CMDB is not easy and should be broken into manageable sections.
    2. Set reasonable milestones. For each phase, document goals to define "done" and ensure they're reasonable for the resources you have available. If working with a vendor, include them in your discussions of what's realistic.
    3. Treat the first phase as a pilot. Focus on items you understand well:
      1. Well-understood user-facing and IT services
      2. High-maturity management and governance practices
      3. Trusted data sources
    4. Capture high-value, high-criticality services early. Depending on the complexity of your systems, you may need to split this phase into multiple phases.

    Document this table in the Configuration Management Project Charter, section 3.0: Milestones

    Timeline/Owner Milestone/Deliverable Details
    First four weeks Milestone: Plan defined and validated with ITSM installation vendor Define processes for intake, maintenance, and retirement.
    Rebecca Roberts Process documentation written, approved, and ready to communicate Review CI categories

    4.2.2 Identify milestones

    Build out a high-level view to inform the project plan

    Open the Configuration Management Project Charter, section 3: Milestones.
    Instructions:

    1. Identify high-level milestones for the implementation of the configuration management program. This may include tool evaluation and implementation, assignment of roles, etc.
    2. Add details to fill out the milestone, keeping to a reasonable level of detail. This may inform vendor discussion or further development of the project plan.
    3. Add target dates to the milestones. Validate they are realistic with the team.
    4. Add notes to the assumptions and constraints section.
    5. Identify risks to the plan.

    Two Screenshots from the Configuration Management Project Charter

    Download the Configuration Management Project Charter

    Workshop Participants

    R = Recommended
    O = Optional

    Participants Day 1 Day 2 Day 3 Day 4
    Configuration Management Strategy CMDB Data Structure Processes Communications & Roadmap
    Morning Afternoon Morning Afternoon Morning Afternoon Morning Afternoon
    Head of IT R O
    Project Sponsor R R O O O O O O
    Infrastructure, Enterprise Apps Leaders R R O O O O O O
    Service Manager R R O O O O O O
    Configuration Manager R R R R R R R R
    Project Manager R R R R R R R R
    Representatives From Network, Compute, Storage, Desktop R R R R R R R R
    Enterprise Architecture R R R R O O O O
    Owner of Change Management/Change Control/Change Enablement R R R R R R R R
    Owner of In-Scope Apps, Use Cases R R R R R R R R
    Asset Manager R R R R R R R R

    Related Info-Tech Research

    Research Contributors and Experts

    Thank you to everyone who contributed to this publication

    Brett Johnson, Senior Consultant, VMware

    Yev Khovrenkov, Senior Consultant, Solvera Solutions

    Larry Marks, Reviewer, ISACA New Jersey

    Darin Ohde, Director of Service Delivery, GreatAmerica Financial Services

    Jim Slick, President/CEO, Slick Cyber Systems

    Emily Walker, Sr. Digital Solution Consultant, ServiceNow

    Valence Howden, Principal Research Director, Info-Tech Research Group

    Allison Kinnaird, Practice Lead, IT Operations, Info-Tech Research Group

    Robert Dang, Principal Research Advisor, Security, Info-Tech Research Group

    Monica Braun, Research Director, IT Finance, Info-Tech Research Group

    Jennifer Perrier, Principal Research Director, IT Finance, Info-Tech Research Group

    Plus 13 anonymous contributors

    Bibliography

    An Introduction to Change Management, Prosci, Nov. 2019.
    BAI10 Manage Configuration Audit Program. ISACA, 2014.
    Bizo, Daniel, et al, "Uptime Institute Global Data Center Survey 2021." Uptime Institute, 1 Sept. 2021.
    Brown, Deborah. "Change Management: Some Statistics." D&B Consulting Inc. May 15, 2014. Accessed June 14, 2016.
    Cabinet Office. ITIL Service Transition. The Stationery Office, 2011.
    "COBIT 2019: Management and Governance Objectives. ISACA, 2018.
    "Configuration Management Assessment." CMStat, n.d. Accessed 5 Oct. 2022.
    "Configuration Management Database Foundation." DMTF, 2018. Accessed 1 Feb. 2021.
    Configuration Management Using COBIT 5. ISACA, 2013.
    "Configuring Service Manager." Product Documentation, Ivanti, 2021. Accessed 9 Feb. 2021.
    "Challenges of Implementing configuration management." CMStat, n.d. Accessed 5 Oct. 2022.
    "Determining if configuration management and change control are under management control, part 1." CMStat, n.d. Accessed 5 Oct. 2022.
    "Determining if configuration management and change control are under management control, part 2." CMStat, n.d. Accessed 5 Oct. 2022.
    "Determining if configuration management and change control are under management control, part 3." CMStat, n.d. Accessed 5 Oct. 2022.
    "CSDM: The Recipe for Success." Data Content Manager, Qualdatrix Ltd. 2022. Web.
    Drogseth, Dennis, et al., 2015, CMDB Systems: Making Change Work in the Age of Cloud and Agile. Morgan Kaufman.
    Ewenstein, B, et al. "Changing Change Management." McKinsey & Company, 1 July 2015. Web.
    Farrell, Karen. "VIEWPOINT: Focus on CMDB Leadership." BMC Software, 1 May 2006. Web.
    "How to Eliminate the No. 1 Cause of Network Downtime." SolarWinds, 4 April 2014. Accessed 9 Feb. 2021.
    "ISO 10007:2017: Quality Management -- Guidelines for Configuration Management." International Organization for Standardization, 2019.
    "IT Operations Management." Product Documentation, ServiceNow, version Quebec, 2021. Accessed 9 Feb. 2021.
    Johnson, Elsbeth. "How to Communicate Clearly During Organizational Change." Harvard Business Review, 13 June 2017. Web.
    Kloeckner, K. et al. Transforming the IT Services Lifecycle with AI Technologies. Springer, 2018.
    Klosterboer, L. Implementing ITIL Configuration Management. IBM Press, 2008.
    Norfolk, D., and S. Lacy. Configuration Management: Expert Guidance for IT Service Managers and Practitioners. BCS Learning & Development Limited, revised ed., Jan. 2014.
    Painarkar, Mandaar. "Overview of the Common Data Model." BMC Documentation, 2015. Accessed 1 Feb. 2021.
    Powers, Larry, and Ketil Been. "The Value of Organizational Change Management." Boxley Group, 2014. Accessed June 14, 2016.
    "Pulse of the Profession: Enabling Organizational Change Throughout Strategic Initiatives." PMI, March 2014. Accessed June 14, 2016.
    "Service Configuration Management, ITIL 4 Practice Guide." AXELOS Global Best Practice, 2020
    "The Guide to Managing Configuration Drift." UpGuard, 2017.

    Release management

    • Buy Link or Shortcode: {j2store}9|cart{/j2store}
    • Related Products: {j2store}9|crosssells{/j2store}
    • Up-Sell: {j2store}9|upsells{/j2store}
    • member rating overall impact: 10.0/10
    • member rating average dollars saved: $35,731
    • member rating average days saved: 20
    • Parent Category Name: Infra and Operations
    • Parent Category Link: /infra-and-operations
    Today's world requires frequent and fast deployments. Stay in control with release management.

    Help Managers Inform, Interact, and Involve on the Way to Team Engagement

    • Buy Link or Shortcode: {j2store}595|cart{/j2store}
    • member rating overall impact: N/A
    • member rating average dollars saved: N/A
    • member rating average days saved: N/A
    • Parent Category Name: Employee Development
    • Parent Category Link: /train-and-develop
    • Employee engagement impacts a company’s bottom line as well as the quality of work life for employees.
    • Employee engagement surveys often fail to provide the value you are hoping for because they are treated like an annual project that quickly loses steam.
    • The responsibility for fixing the issues identified falls to HR, and ultimately HR has very little control over an employee’s concerns with their day-to-day role.

    Our Advice

    Critical Insight

    • HR and the executive team have been exclusively responsible for engagement for too long. Since managers have the greatest impact on employees, they should also be primarily responsible for employee engagement.
    • In most organizations, managers underestimate the impact they can have on employee engagement, and assume that the broader organization will take more meaningful action.
    • Improving employee engagement may be as simple as improving the frequency and quality of the “3Is”: informing employees about the why behind decisions, interacting with them on a personal level, and involving them in decisions that affect them.

    Impact and Result

    • Managers have the greatest impact on employee engagement as they are in a unique situation to better understand what makes employees tick.
    • If employees have a good relationship with their manager, they are much more likely to be engaged at work which ultimately leads to increases in revenue, profit, and shareholder return.

    Help Managers Inform, Interact, and Involve on the Way to Team Engagement Research & Tools

    Besides the small introduction, subscribers and consulting clients within this management domain have access to:

    1. Get more involved in analyzing and improving team engagement

    Improve employee engagement and ultimately the organization’s bottom line.

    • Storyboard: Help Managers Inform, Interact, and Involve on the Way to Team Engagement

    2. Gather feedback from employees

    Have a productive engagement feedback discussion with teams.

    • Engagement Feedback Session Agenda Template

    3. Engage teams to improve engagement

    Facilitate effective team engagement action planning.

    • Action Planning Worksheet

    4. Gain insight into what engages and disengages employees

    Solicit employee pain points that could potentially hinder their engagement.

    • Stay Interview Guide

    5. Get to know new hires on a more personal level

    Develop a stronger relationship with employees to drive engagement.

    • New Hire Conversation Guide
    [infographic]

    Reimagine Learning in the Face of Crisis

    • Buy Link or Shortcode: {j2store}601|cart{/j2store}
    • member rating overall impact: N/A
    • member rating average dollars saved: N/A
    • member rating average days saved: N/A
    • Parent Category Name: Train & Develop
    • Parent Category Link: /train-and-develop
    • As organizations re-evaluate their priorities and shift to new ways of working, leaders and employees are challenged to navigate unchartered territory and to adjust quickly to ever-evolving priorities.
    • Learning how to perform effectively through the crisis and deliver on new priorities is crucial to the success of all employees and the organization.

    Our Advice

    Critical Insight

    The most successful organizations recognize that learning is critical to adjusting quickly and effectively to their new reality. This requires L&D to reimagine their approach to deliver learning that enables the organization’s immediate and evolving priorities.

    Impact and Result

    • L&D teams should focus on how to support employees and managers to develop the critical competencies they need to successfully perform through the crisis, enabling organizations to survive and thrive during and beyond the crisis.
    • Ensure learning needs align closely with evolving organizational priorities, collaborate cross-functionally, and curate content to provide the learning employees and leaders need most, when they need it.

    Reimagine Learning in the Face of Crisis Research & Tools

    Besides the small introduction, subscribers and consulting clients within this management domain have access to:

    1. Prioritize

    Involve key stakeholders, identify immediate priorities, and conduct high-level triage of L&D.

    • Reimagine Learning in the Face of Crisis Storyboard
    • Reimagine Learning in the Face of Crisis Workbook

    2. Reimagine

    Determine learning needs and ability to realistically deliver learning. Leverage existing or curate learning content that can support learning needs.

    3. Transform

    Identify technical requirements for the chosen delivery method and draft a four- to six-week action plan.

    • How to Curate Guide
    • Tips for Building an Online Learning Community
    • Ten Tips for Adapting In-Person Training During a Crisis
    • Tips for Remote Learning in the Face of Crisis
    [infographic]

    We may not be able to show you this

    We may not be able to show you this just yet.
    Our deeper, more detailed content is reserved for Tymans Group clients.

    If you are interested in retaining our services or would really like access, please contact us.

    Adopt Change Management Practices and Succeed at IT Organizational Redesign

    • Buy Link or Shortcode: {j2store}393|cart{/j2store}
    • member rating overall impact: N/A
    • member rating average dollars saved: N/A
    • member rating average days saved: N/A
    • Parent Category Name: Organizational Design
    • Parent Category Link: /organizational-design

    Organizational redesigns frequently fail when it comes to being executed. This leads to:

    • The loss of critical talent and institutional knowledge.
    • An inability to deliver on strategic goals and objectives.
    • Financial and time losses to the organization.

    Organizational redesigns fail during implementation primarily because they do not consider the change management required to succeed.

    Our Advice

    Critical Insight

    Implementing your organizational design with good change management practices is more important than defining the new organizational structure.

    Implementation is often negatively impacted due to:

    • Employees not understanding the need to redesign the organizational structure or operating model.
    • Employees not being communicated with or engaged throughout the process, which can cause chaos.
    • Managers not being prepared or trained to have difficult conversations with employees.

    Impact and Result

    When good change management practices are used and embedded into the implementation process:

    • Employees feel respected and engaged, reducing turnover and productivity loss.
    • The desired operating structure can be implemented faster, enabling the delivery of strategic objectives.
    • Gaps and disorganization are avoided, saving the organization time and money.

    Invest change management for your IT redesign.

    Adopt Change Management Practices and Succeed at IT Organizational Redesign Research & Tools

    Besides the small introduction, subscribers and consulting clients within this management domain have access to:

    1. Adopt Change Management Practices and Succeed at IT Organizational Redesign Deck – Succeed at implementing your IT organizational structure by adopting the necessary change management practices.

    The best IT organizational structure will still fail to be implemented if the organization does not leverage and use good change management practices. Consider practices such as aligning the structure to a meaningful vision, preparing leadership, communicating frequently, including employees, and measuring adoption to succeed at organizational redesign implementation.

    • Adopt Change Management Practices and Succeed at IT Organizational Redesign Storyboard

    2. IT Organizational Redesign Pulse Survey Template – A survey template that can be used to measure the success of your change management practices during organizational redesign implementation.

    Taking regular pulse checks of employees and managers during the transition will enable IT Leaders to focus on the right practices to enable adoption.

    • IT Organizational Redesign Pulse Survey Template
    [infographic]

    Further reading

    Adopt Change Management Practices & Succeed at IT Organizational Redesign

    The perfect IT organizational structure will fail to be implemented if there is no change management.

    Analyst Perspective

    Don’t doom your organizational redesign efforts

    The image contains a picture of Brittany Lutes.

    After helping hundreds of organizations across public and private sector industries redesign their organizational structure, we can say there is one thing that will always doom this effort: A failure to properly identify and implement change management efforts into the process.

    Employees will not simply move forward with the changes you suggest just because you as the CIO are making them. You need to be prepared to describe the individual benefits each employee can expect to receive from the new structure. Moreover, it has to be clear why this change was needed in the first place. Redesign efforts should be driven by a clear need to align to the organization’s vision and support the various objectives that will need to take place.

    Most organizations do a great job defining a new organizational structure. They identify a way of operating that tells them how they need to align their IT capabilities to deliver on strategic objectives. What most organizations do poorly is invest in their people to ensure they can adopt this new way of operating.

    Brittany Lutes
    Research Director, Organizational Transformation

    Info-Tech Research Group

    Executive Summary

    Your Challenge

    Common Obstacles

    Info-Tech’s Approach

    Organizational redesigns frequently fail when it comes to being executed. This leads to:

    • The loss of critical talent and institutional knowledge.
    • An inability to deliver on strategic goals and objectives.
    • Financial and time losses to the organization.

    Organizational redesigns fail during implementation primarily because they do not consider the change management required to succeed.

    Implementation of the organizational redesign is often impacted when:

    • Employees do not understand the need to redesign the organizational structure or operating model.
    • Employees are not communicated with or engaged throughout the process, which can cause chaos.
    • Managers are not prepared or trained to have difficult conversations with employees.

    Essentially, implementation is impacted when change management is not included in the redesign process.

    When good change management practices are used and embedded into the implementation process:

    • Employees feel respected and engaged, reducing turnover and productivity loss.
    • The desired operating structure can be implemented faster, enabling the delivery of strategic objectives.
    • Gaps and disorganization are avoided, saving the organization time and money.

    Invest in change management for your IT redesign.

    Info-Tech Insight

    Implementing your organizational design with good change management practices is more important than defining the new organizational structure.

    Your challenge

    This research enables organizations to succeed at their organizational redesign:

    • By implementing the right change management practices. These methods prevent:
      • The loss of critical IT employees who will voluntarily exit the organization.
      • Employees from creating rumors that will be detrimental to the change.
      • Confusion about why the change was needed and how it will benefit the strategic objectives the organization is seeking to achieve.
      • Spending resources (time, money, and people) on the initiative longer than is necessary.

    McKinsey reported less than 25% of organizational redesigns are successful. Which is worse than the average change initiative, which has a 70% failure rate.

    Source: AlignOrg, 2020.

    The value of the organizational redesign efforts is determined by the percentage of individuals who adopt the changes and operate in the desired way of working.

    When organizations properly use organizational design processes, they are:

    4× more likely to delight customers

    13× more effective at innovation

    27× more likely to retain employees

    Source: The Josh Bersin Company, 2022

    Common obstacles

    These barriers make implementing an organizational redesign difficult to address for many organizations:

    • You communicated the wrong message to the wrong audience at the wrong time. Repeatedly.
    • There is a lack of clarity around the drivers for an organizational redesign.
    • A readiness assessment was not completed ahead of the changes.
    • There is no flexibility built into the implementation approach.
    • The structure is not aligned to the strategic goals of IT and the organization.
    • IT leadership is not involved in their staff’s day-to-day activities, making it difficult to suggest realistic changes.

    Don’t doom your organizational redesign with poor change management

    Only 17% of frontline employees believe the lines of communication are open.

    Source: Taylor Reach Group, 2019

    43% Percentage of organizations that are ineffective at the organizational design methodology.

    Source: The Josh Bersin Company, 2022.

    Change management is a must for org design

    Forgetting change management is the easiest way to fail at redesigning your IT organizational structure

    • Change management is not a business transformation.
    • Change management consists of the practices and approaches your organization takes to support your people through a transformation.
    • Like governance, change management happens regardless of whether it is planned or ad hoc.
    • However, good change management will be intentional and agile, using data to help inform the next action steps you will take.
    • Change management is 100% focused on the people and how to best support them as they learn to understand the need for the change, what skills they must have to support and adopt the change, and eventually to advocate for the change.

    "Organizational transformation efforts rarely fail because of bad design, but rather from lack of sufficient attention to the transition from the old organization to the new one."

    – Michael D. Watkins & Janet Spencer. ”10 Reason Why Organizational Change Fails.”

    Info-Tech’s approach

    Redesigning the IT structure depends on good change management

    The image contains a screenshot of Info-Tech's approach, and good change management.

    Common changes in organizational redesigns

    Entirely New Teams

    Additions, reductions, or new creations. The individuals that make up a functional team can shift.

    New Team Members

    As roles become defined, some members might be required to shift and join already established groups.

    New Responsibilities

    The capabilities individuals will be accountable or responsible for become defined.

    New Ways of Operating

    From waterfall to Agile, collaborative to siloed, your operating model provides insight into the ways roles will engage one another.

    Top reasons organizational redesigns fail

    1. The rationale for the redesign is not clear.
    2. Managers do not have the skills to lead their teams through a change initiative like organizational redesign.
    3. You communicated the wrong messages at the wrong times to the wrong audiences.
    4. Frontline employees were not included in the process.
    5. The metrics you have to support the initiative are countering one another – if you have metrics at all.
    6. Change management and project management are being treated interchangeably.

    Case study: restructuring to reduce

    Clear Communication & Continuous Support

    Situation

    On July 26th, 2022, employees at Shopify – an eCommerce platform – were communicated to by their CEO that a round of layoffs was about to take place. Effective that day, 1,000 employees or 10% of the workforce would be laid off.

    In his message to staff, CEO Tobi Lutke admitted he had assumed continual growth in the eCommerce market when the COVID-19 pandemic forced many consumers into online shopping. Unfortunately, it was clear that was not the case.

    In his communications, Tobi let people know what to expect throughout the day, and he informed people what supports would be made available to those laid off. Mainly, employees could expect to see a transparent approach to severance pay; support in finding new jobs through coaching, connections, or resume creation; and ongoing payment for new laptops and internet to support those who depend on this connectivity to find new jobs.

    Results

    Unlike many of the other organizations (e.g. Wayfair and Peloton) that have had to conduct layoffs in 2022, Shopify had a very positive reaction. Many employees took to LinkedIn to thank their previous employer for all that they had learned with the organization and to ask their network to support them in finding new opportunities. Below is a letter from the CEO:

    The image contains a screenshot of a letter from the CEO.

    Shopify, 2022.
    Forbes, 2022.

    Aligned to a Meaningful Vision

    An organizational redesign must be aligned to a clear and meaningful vision of the organization.

    Define the drivers for organizational redesign

    And align the structure to execute on those drivers.

    • Your structure should follow your strategy. However, 83% of people in an organization do not fully understand the strategy (PWC, 2017).
    • How can employees be expected to understand why the IT organization needs to be restructured to meet a strategy if the strategy itself is still vague and unclear?
    • When organizations pursue a structural redesign, there are often a few major reasons:
      • Digital/organizational transformation
      • New organizational strategy
      • Acquisition or growth of products, services, or capabilities
      • The need to increase effectiveness
      • Cost savings
    • Creating a line of sight for your employees and leadership team will increase the likelihood that they want to adopt this structure.

    “The goal is to align your operating model with your strategy, so it directly supports your differentiating capabilities.”

    – PWC, 2017.

    How to align structure to strategy

    Recommended action steps:

    • Describe the end state of the organizational structure and how long you anticipate it will take to reach that state. It's important that employees be able to visualize the end state of the changes being made.
    • Ensure people understand the vision and goals of the IT organization. Are you having discussions about these? Are managers discussing these? Do people understand that their day-to-day job is intended to support those goals?
    • Create a visual:
      • The goals of the organization → align to the initiatives IT → which require this exact structure to deliver.
    • Do not assume people are willing to move forward with this vision. If people are not willing, assess why and determine if there are benefits specific to the individual that can support them in adopting the future state.
    • Define and communicate the risks of not making the organizational structure changes.

    Info-Tech Insight

    A trending organizational structure or operating model should never be the driver for an organizational redesign.

    IT Leaders Are Not Set Up To Succeed

    Empower these leaders to have difficult conversations.

    Lacking key leadership capabilities in managers

    Technical leaders are common in IT, but people leaders are necessary during the implementation of an organizational structure.

    • Managers are important during a transformational change for many reasons:
      • Managers play a critical role in being able to identify the skill gaps in employees and to help define the next steps in their career path.
      • After the sponsor (CIO) has communicated to the group the what and the why, the personal elements of the change fall to managers.
      • Managers’ displays of disapproval for the redesign can halt the transformation.
    • However, many managers (37%) feel uncomfortable talking to employees and providing feedback if they think it will elicit a negative response (Taylor Reach Group, 2019).
    • Unfortunately, organizational redesign is known for eliciting negative responses from employees as it generates fears around the unknown.
    • Therefore, managers must be able to have conversations with employees to further the successful implementation and adoption of the structure.

    “Successful organizational redesign is dependent on the active involvement of different managerial levels."

    – Marianne Livijn, “Managing Organizational Redesign: How Organizations Relate Macro and Micro Design.”

    They might be managers, but are they leaders?

    Recommended action steps:

    • Take time to speak with managers one on one and understand their thoughts, feelings, and understanding of the change.
    • Ensure that middle-managers have an opportunity to express the benefits they believe will be realized through the proposed changes to the organizational chart.
    • Provide IT leaders with leadership training courses (e.g. Info-Tech’s Leadership Programs).
    • Do not allow managers to start sharing and communicating the changes to the organizational structure if they are not demonstrating support for this change. Going forward, the group is all-in or not, but they should never demonstrate not being bought-in when speaking to employees.
    • Ensure IT leaders want to manage people, not just progress to a management position because they cannot climb a technical career ladder within the proposed structure. Provide both types of development opportunities to all employees.
    • Reduce the managers’ span of control to ensure they can properly engage all direct reports and there is no strain on the managers' time.

    Info-Tech Insight

    47% of direct reports do not agree that their leader is demonstrating the change behaviors. Often, a big reason is that many middle-managers do not understand their own attitudes and beliefs about the change.

    Source: McKinsey & Company “How Do We Manage the Change Journey?”

    Check out Info-Tech’s Build a Better Manager series to support leadership development

    These blueprints will help you create strong IT leaders who can manage their staff and themselves through a transformation.

    Build a Better Manager: Basic Management Skills

    Build a Better Manager: Personal Leadership

    Build a Better Manager: Manage Your People

    Build Successful Teams

    Transparent & Frequent Communication

    Provide employees with several opportunities to hear information and ask questions about the changes.

    Communication must be done with intention

    Include employees in the conversation to get the most out of your change management.

    • Whether it is a part of a large transformation or a redesign to support a specific goal of IT, begin thinking about how you will communicate the anticipated changes and who you will communicate those changes to right away.
    • The first group of people who need to understand why this initiative is important are the other IT leaders. If they are not included in the process and able to understand the foundational drivers of the initiative, you should not continue to try and gain the support of other members within IT.
    • Communication is critical to the success of the organizational redesign.
    • Communicating the right information at the right time will make the difference between losing critical talent and emerging from the transition successfully.
    • The sponsor of this redesign initiative must be able to communicate the rationale of the changes to the other members of leadership, management, and employees.
    • The sponsor and their change management team must then be prepared to accept the questions, comments, and ideas that members of IT might have around the changes.

    "Details about the new organization, along with details of the selection process, should be communicated as they are finalized to all levels of the organization.”

    – Courtney Jackson, “7 Reasons Why Organizational Structures Fail.”

    Two-way communication is necessary

    Recommended action steps:

    • Don't allow rumors to disrupt this initiative – be transparent with people as early as possible.
    • If the organizational restructure will not result in a reduction of staff – let them know! If someone's livelihood (job) is on the line, it increases the likelihood of panic. Let's avoid panic.
    • Provide employees with an opportunity to voice their concerns, questions, and recommendations – so long as you are willing to take that information and address it. Even if the answer to a recommendation is "no" or the answer to a question is "I don't know, but I will find out," you've still let them know their voice was heard in the process.
    • As the CIO, ensure that you are the first person to communicate the changes. You are the sponsor of this initiative – no one else.
    • Create communications that are clear and understandable. Imagine someone who does not work for your organization is hearing the information for the first time. Would they be able to comprehend the changes being suggested?
    • Conduct a pulse survey on the changes to identify whether employees understand the changes and feel heard by the management team.

    Info-Tech Insight

    The project manager of the organizational redesign should not be the communicator. The CIO and the employees’ direct supervisor should always be the communicators of key change messages.

    Communication spectrum

    An approach to communication based on the type of redesign taking place

    ← Business-Mandated Organizational Redesign

    Enable Alignment & Increased Effectiveness

    IT-Driven & Strategic Organizational Redesign →

    Reduction in roles

    Cost savings

    Requires champions who will maintain employee morale throughout

    Communicate with key individuals ahead of time

    Restructure of IT roles

    Increase effectiveness

    Lean on managers & supervisors to provide consistent messaging

    Communicate the individual benefits of the change

    Increase in IT Roles

    Alignment to business model

    Frequent and ongoing communication from the beginning

    Collaborate with IT groups for input on best structure

    Include Employees in the Redesign Process

    Stop talking at employees and ensure they are involved in the changes impacting their day-to-day lives.

    Employees will enable the change

    Old-school approaches to organizational redesign have argued employee engagement is a hinderance to success – it’s not.

    • We often fail to include the employees most impacted by a restructuring in the redesign process. As a result, one of the top reasons employees do not support the change is that they were not included in the change.
    • A big benefit of including employees in the process is it mitigates the emergence of a rumor mill.
    • Moreover, being open to suggestions from staff will help the transformation succeed.
    • Employees can best describe what this transition might entail on a day-to-day basis and the supports they will require to succeed in moving from their current state to their future state.
      • CIOs and other IT leaders are often too far removed from the day-to-day to best describe what will or will not work.
    • When employees feel included in the process, they are more likely to feel like they had a choice in what and how things change.

    "To enlist employees, leadership has to be willing to let things get somewhat messy, through intensive, authentic engagement and the involvement of employees in making the transformation work."

    – Michael D. Watkins & Janet Spencer, “10 Reasons Why Organizational Change Fails.”

    Empowering employees as change agents

    Recommended action steps:

    • Do not tell employees what benefits they will gain from this new change. Instead, ask them what benefits they anticipate.
    • Ask employees what challenges they anticipate, and identify actions that can be taken to minimize those challenges.
    • Identify who the social influencers are in the organization by completing an influencer map. The informal social networks in your organization can be powerful drivers of change when the right individuals are brought onboard.
    • Create a change network using those influencers. The change network includes individuals who represent all levels within the organization and can represent the employee perspective. Use them to help communicate the change and identify opportunities to increase the success of adoption: “Engaging influencers in change programs makes them 3.8 times more likely to succeed," (McKinsey & Company, 2020).
    • Ask members of the change network to identify possible resistors of the new IT structure and inform you of why they might be resisting the changes.

    Info-Tech Insight

    Despite the persistent misconceptions, including employees in the process of a redesign reduces uncertainty and rumors.

    Monitor employee engagement & adoption throughout the redesign

    Only 22% of organizations include the employee experience as a part of the design process

    – The Josh Bersin Company, 2022.
    1 2 3
    Monitor IT Employee Experience

    When Prosci designed their Change Impact Analysis, they identified the ways in which roles will be impacted across 10 different components:

    • Location
    • Process
    • Systems
    • Tools
    • Job roles
    • Critical behaviors
    • Mindset/attitudes/beliefs
    • Reporting structure
    • Performance reviews
    • Compensation

    Engaging employees in the process so that they can define how their role might be impacted across these 10 categories not only empowers the employee, but also ensures they are a part of the process.

    Source: Prosci, 2019.

    Conduct an employee pulse survey

    See the next slide for more information on how to create and distribute this survey.

    Employee Pulse Survey

    Conduct mindful and frequent check-ins with employees

    Process to conduct survey:

    1. Using your desired survey solution (e.g. MS Forms, SurveyMonkey, Qualtrics) input the questions into the survey and send to staff. A template of the survey in MS Forms is available here: IT Organizational Redesign Pulse Survey Template.
    2. When sending to staff, ensure that the survey is anonymous and reinforce this message.
    3. Leverage the responses from the survey to learn where there might be opportunities to improve the transformation experience (aligning the structure to the vision, employee inclusion, communication, or managerial support for the change). Review the recommended action steps in this research set for help.
    4. This assessment is intended for frequent but purposeful use. Only send out the survey when you have taken actions in order to improve adoption of the change or have provided communications. The Employee Pulse Survey should be reevaluated on a regular basis until adoption across all four categories reaches the desired state (80-100% adoption is recommended).

    The image contains a screenshot of the employee pulse survey.

    Define Key Metrics of Adoption & Success

    Metrics have a dual benefit of measuring successful implementation and meeting the original drivers.

    Measuring the implementation is a two-pronged approach

    Both employee adoption and the transformation of the IT structure need to be measured during implementation

    • Organizations that are going through any sort of transformation – such as organizational redesign – should be measuring whether they are successfully on track to meet their target or have already met that goal.
    • Throughout the organizational structure transition, a major factor that will impact the success of that goal is employee willingness to move forward with the changes.
    • However, rather than measuring these two components using hard data, we rely on gut checks that let us know if we think we are on track to gaining adoption and operating in the desired future state.
    • Given how fluid employees and their responses to change can be, conducting a pulse survey at a regular (but strategically identified) interval will provide insight into where the changes will be adopted or resisted.

    “Think about intentionally measuring at the moments in the change storyline where feedback will allow leaders to make strategic decisions and interventions.”

    – Bradley Wilson, “Employee Survey Questions: The Ultimate Guide.”

    Report that the organizational redesign for IT was a success

    Recommended action steps:

    • Create clear metrics related to how you will measure the success of the organizational redesign, and communicate those metrics to people. Ensure the metrics are not contrary to the goals of other initiatives or team outcomes.
    • Create one set of metrics related to adoption and another set of metrics tied to the successful completion of the project objective.
      • Are people changing their attitudes and behaviors to reflect the required outcome?
      • Are you meeting the desired outcome of the organizational redesign?
    • Use the metrics to inform how you move forward. Do not attempt the next phase of the organizational transformation before employees have clearly indicated a solid understanding of the changes.
    • Ensure that any metrics used to measure success will not negatively interfere with another team’s progress. The metrics of the group need to work together, not against each other.

    Info-Tech Insight

    Getting 100% adoption from employees is unlikely. However, if employee adoption is not sitting in the 80-90% range, it is not recommended that you move forward with the next phase of the transformation.

    Example sustainment metrics

    Driver Goal Measurement Key Performance Indicator (KPI)
    Workforce Challenges and Increased Effectiveness Employee Engagement The change in employee engagement before, during, and after the new organizational structure is communicated and implemented.
    Increased Effectiveness Alignment of Demand to Resources Does your organization have sufficient resources to meet the demands being placed on your IT organization?
    Increased Effectiveness and Workforce Challenges Role Clarity An increase in role clarity or a decrease in role ambiguity.

    Increased Effectiveness

    Reduction in Silos

    Employee effectiveness increases by 27% and efficiency by 53% when provided with role clarity (Effectory, 2019).
    Increased Effectiveness Reduction in Silos Frequency of communication channels created (scrum meetings, Teams channels, etc.) specific to the organizational structure intended to reduce silos.
    Operating in a New Org. Structure Change Adoption Rate The percentage of employees who have adopted their defined role within the new organizational chart in 3-, 6-, and 12-month increments.
    Workforce Challenges Turnover Rate The number of employees who voluntarily leave the organization, citing the organizational redesign.
    Workforce Challenges Active Resistors The number of active resistors anticipated related to the change in organizational structure versus the number of active resistors that actually present themselves to the organizational restructuring.
    New Capabilities Needed Gap in Capability Delivery The increase in effectiveness in delivering on new capabilities to the IT organization.
    Operating in a New Org. Structure Change Adoption Rate The percentage of employees who found the communication around the new organizational structure clear, easy to understand, and open to expressing feedback.
    Lack of Business Understanding or Increased Effectiveness Business Satisfaction with IT Increase in business satisfaction toward IT products and services.
    Workforce Challenges Employee Performance Increase in individual employee performances on annual/bi-annual reviews.
    Adoption Pulse Assessment Increase in overall adoption scores on pulse survey.
    Adoption Communication Effectiveness Reduction in the number of employees who are still unsure why the changes are required.
    Adoption Leadership Training Percentage of members of leadership attending training to support their development at the managerial level.

    Change Management ≠ Project Management

    Stop treating the two interchangeably.

    IT organizations struggle to mature their OCM capabilities

    Because frankly they didn’t need it

    • Change management is all about people.
    • If the success of your organization is dependent on this IT restructuring, it is important to invest the time to do it right.
    • This means it should not be something done off the side of someone's desk.
    • Hire a change manager or look to roles that have a responsibility to deliver on organizational change management.
    • While project success is often measured by if it was delivered on time, on budget, and in scope, change management is adaptable. It can move backward in the process to secure people's willingness to adopt the required behaviors.
    • Strategic organizations recognize it’s not just about pushing an initiative or project forward. It’s about making sure that your employees are willing to move that initiative forward too.
    • A major organizational transformation initiative like restructuring requires you lean into employee adoption and buy-in.

    “Only if you have your employees in mind can you implement change effectively and sustainably.”

    – Creaholic Pulse Feedback, “Change Management – And Why It Has to Change.”

    Take the time to educate & communicate

    Recommended action steps:

    • Do not treat change management and project management as synonymous.
    • Hire a change manager to support the organizational redesign transformation.
    • Invest the resources (time, money, people) that can support the change and enable its success. This can look like:
      • Training and development.
      • Hiring the right people.
      • Requesting funds during the redesign process to support the transition.
    • Create a change management plan – and be willing to adjust the timelines or actions of this plan based on the feedback you receive from employees.
    • Implement the new organizational structure in a phased approach. This allows time to receive feedback and address any fears expressed by staff.

    Info-Tech Insight

    OCM is often not included or used due to a lack of understanding of how it differs from project management.

    And an additional five experts across a variety of organizations who wish to remain anonymous.

    Research Contributors and Experts

    Info-Tech Research Group

    Amanda Mathieson Research Director Heather Munoz Executive Counselor Valence Howden Principal Research Director
    Ugbad Farah Research Director Lisa Hager Duncan Executive Counselor Alaisdar Graham Executive Counselor
    Carlene McCubbin Practice Lead

    Related Info-Tech Research

    Redesign Your IT Organizational Structure

    Build a Strategic IT Workforce Plan

    Implement a New IT Organizational Structure

    • Organizational redesign is only as successful as the process leaders engage in.
    • Benchmarking your organizational redesign to other organizations will not work.
    • You could have the best IT employees in the world, but if they aren’t structured well, your organization will still fail in reaching its vision.
    • A well-defined strategic workforce plan (SWP) isn’t just a nice-to-have, it’s a must-have.
    • Integrate as much data as possible into your workforce plan to best prepare you for the future. Without knowledge of your future initiatives, you are filling hypothetical holes.
    • To be successful, you need to understand your strategic initiatives, workforce landscape, and external and internal trends.
    • Organizational design implementations can be highly disruptive for IT staff and business partners. Without a structured approach, IT leaders may experience high turnover, decreased productivity, and resistance to change.
    • CIOs walk a tightrope as they manage operational and emotional turbulence while aiming to improve business satisfaction with IT. Failure to achieve balance could result in irreparable failure.

    Bibliography

    Aronowitz, Steven, et al. “Getting Organizational Design Right,” McKinsey, 2015. Web.
    Ayers, Peg. “5 Ways to Engage Your Front-Line Staff.” Taylor Reach Group, 2019. Web.
    Bushard, Brian, and Carlie Porterfield. “Meta Reportedly Scales Down, Again – Here Are the Major US Layoffs This Year.” Forbes, September 28, 2022. Web.
    Caruci, Ron. “4 Organizational Design Issues that Most Leaders Misdiagnose.” Harvard Business Review, 2019.
    “Change Management – And Why It Has to Change.” Creaholic Pulse Feedback. Web.
    “Communication Checklist for Achieving Change Management.” Prosci, 27 Oct. 2022. Web.
    “Defining Change Impact.” Prosci. 29 May 2019. Web.
    “The Definitive Guide To Organization Design.” The Josh Bersin Company, 2022.
    Deshler, Reed. “Five Reasons Organizational Redesigns Fail to Deliver.” AlignOrg. 28 Jan. 2020. Web.
    The Fit for Growth Mini Book. PwC, 12 Jan. 2017.
    Helfand, Heidi. Dynamic Reteaming: The Art and Wisdom of Changing Teams. 2nd ed., O’Reilly Media, 2020.
    Jackson, Courtney. “7 Reasons Why Organizational Structures Fail.” Scott Madden Consultants. Web.
    Livijn, Marianne. Managing Organizational Redesign: How Organizations Relate Macro and Micro Design. Doctoral dissertation. Department of Management, Aarhus University, 2020.
    Lutke, Tobias. “Changes to Shopify’s Team.” Shopify. 26 July 2022.
    McKinsey & Company. “How Do We Manage the Change Journey?” McKinsey & Company.2020.
    Pijnacker, Lieke. “HR Analytics: Role Clarity Impacts Performance.” Effectory, 29 Sept. 2019. Web.
    Tompkins, Teri C., and Bruce G. Barkis. “Conspiracies in the Workplace: Symptoms and Remedies.” Graziadio Business Review, vol. 21, no. 1, 2021.Web.
    “Understanding Organizational Structures.” SHRM,2022.
    Watkins, Michael D., and Janet Spencer. “10 Reasons Why Organizational Change Fails.” I by IMD, 10 March 2021. Web.
    Wilson, Bradley. “Employee Survey Questions: The Ultimate Guide.” Perceptyx, 1 July 2020. Web.

    Monitor IT Employee Experience

    • Buy Link or Shortcode: {j2store}543|cart{/j2store}
    • member rating overall impact: 10.0/10 Overall Impact
    • member rating average dollars saved: $29,096 Average $ Saved
    • member rating average days saved: 19 Average Days Saved
    • Parent Category Name: Engage
    • Parent Category Link: /engage
    • In IT, high turnover and sub-optimized productivity can have huge impacts on IT’s ability to execute SLAs, complete projects on time, and maintain operations effectively.
    • With record low unemployment rates in IT, retaining top employees and keeping them motivated in their jobs has never been more critical.

    Our Advice

    Critical Insight

    • One bad experience can cost you your top employee. Engagement is the sum total of the day-to-day experiences your employees have with your company.
    • Engagement, not pay, drives results. Engagement is key to your team's productivity and ability to retain top talent. Approach it systematically to learn what really drives your team.
    • It’s time for leadership to step up. As the CIO, it’s up to you to take ownership of your team’s engagement.

    Impact and Result

    • Info-Tech tools and guidance will help you initiate an effective conversation with your team around engagement, and avoid common pitfalls in implementing engagement initiatives.
    • Monitoring employee experience continuously using the Employee Experience Monitor enables you to take a data-driven approach to evaluating the success of your engagement initiatives.

    Monitor IT Employee Experience Research & Tools

    Start here – read the Executive Brief

    Read our concise Executive Brief to find out why you should focus on employee experience to improve engagement in IT, review Info-Tech’s methodology, and understand how our tools will help you construct an effective employee engagement program.

    Besides the small introduction, subscribers and consulting clients within this management domain have access to:

    1. Start monitoring employee experience

    Plan out your employee engagement program and launch the Employee Experience Monitor survey for your team.

    • Drive IT Performance by Monitoring Employee Experience – Phase 1: Start Monitoring Employee Experience
    • None
    • None
    • EXM Setup Guide
    • EXM Training Guide for Managers
    • None
    • EXM Communication Template

    2. Analyze results and ideate solutions

    Interpret your Employee Experience Monitor results, understand what they mean in the context of your team, and involve your staff in brainstorming engagement initiatives.

    • Drive IT Performance by Monitoring Employee Experience – Phase 2: Analyze Results and Ideate Solutions
    • EXM Focus Group Facilitation Guide
    • Focus Group Facilitation Guide Driver Definitions

    3. Select and implement engagement initiatives

    Select engagement initiatives for maximal impact, create an action plan, and establish open and ongoing communication about engagement with your team.

    • Drive IT Performance by Monitoring Employee Experience – Phase 3: Measure and Communicate Results
    • Engagement Progress One-Pager
    [infographic]

    Workshop: Monitor IT Employee Experience

    Workshops offer an easy way to accelerate your project. If you are unable to do the project yourself, and a Guided Implementation isn't enough, we offer low-cost delivery of our project workshops. We take you through every phase of your project and ensure that you have a roadmap in place to complete your project successfully.

    1 Launch the EXM

    The Purpose

    Set up the EXM and collect a few months of data to build on during the workshop.

    Key Benefits Achieved

    Arm yourself with an index of employee experience and candid feedback from your team to use as a starting point for your engagement program.

    Activities

    1.1 Identify EXM use case.

    1.2 Identify engagement program goals and obstacles.

    1.3 Launch EXM.

    Outputs

    Defined engagement goals.

    EXM online dashboard with three months of results.

    2 Explore Engagement

    The Purpose

    To understand the current state of engagement and prepare to discuss the drivers behind it with your staff.

    Key Benefits Achieved

    Empower your leadership team to take charge of their own team's engagement.

    Activities

    2.1 Review EXM results to understand employee experience.

    2.2 Finalize focus group agendas.

    2.3 Train managers.

    Outputs

    Customized focus group agendas.

    3 Hold Employee Focus Groups

    The Purpose

    Establish an open dialogue with your staff to understand what drives their engagement.

    Key Benefits Achieved

    Understand where in your team’s experience you can make the most impact as an IT leader.

    Activities

    3.1 Identify priority drivers.

    3.2 Identify engagement KPIs.

    3.3 Brainstorm engagement initiatives.

    3.4 Vote on initiatives within teams.

    Outputs

    Summary of focus groups results

    Identified engagement initiatives.

    4 Select and Plan Initiatives

    The Purpose

    Learn the characteristics of successful engagement initiatives and build execution plans for each.

    Key Benefits Achieved

    Choose initiatives with the greatest impact on your team’s engagement, and ensure you have the necessary resources for success.

    Activities

    4.1 Select engagement initiatives with IT leadership.

    4.2 Discuss and decide on the top five engagement initiatives.

    4.3 Create initiative project plans.

    4.4 Build detailed project plans.

    4.5 Present project plans.

    Outputs

    Engagement project plans.

    Re-Envision Enterprise Printing

    • Buy Link or Shortcode: {j2store}165|cart{/j2store}
    • member rating overall impact: 8.0/10 Overall Impact
    • member rating average dollars saved: $9,000 Average $ Saved
    • member rating average days saved: 2 Average Days Saved
    • Parent Category Name: End-User Computing Devices
    • Parent Category Link: /end-user-computing-devices
    • Enterprises may be overspending on printing, but this spend is often unknown and untracked.
    • You are locked into a traditional printer lease and outdated document management practices, hampering digital transformation.

    Our Advice

    Critical Insight

    Don’t just settle for printer consolidation: Seek to eliminate print and enlist your managed print services vendor to help you achieve that goal.

    Impact and Result

    • Identify reduction opportunities via a thorough inventory and requirements-gathering process, and educate others on the financial and non-financial benefits. Enforce reduced printing through policies.
    • Change your printing financial model to print as a service by building an RFP and scoring tool for managed print services that makes the vendor a partner in continuous innovation.
    • Leverage durable print management software to achieve vendor-agnostic governance and visibility.

    Re-Envision Enterprise Printing Research & Tools

    Besides the small introduction, subscribers and consulting clients within this management domain have access to:

    1. Re-Envision Enterprise Printing – A step-by-step document to help plan and execute a printer reduction project.

    This storyboard will help you plan the project, assess your current state and requirements, build a managed print services RFP and scoring process, and build continuous improvement of business processes into your operations.

    • Re-Envision Enterprise Printing – Phases 1-3

    2. Planning tools

    Use these templates and tools to plan the printer reduction project, document your inventory, assess current printer usage, and gather information on current and future requirements.

    • Enterprise Printing Project Charter
    • Enterprise Printing Roles and Responsibilities RACI Guide
    • Printer Reduction Tool
    • End-User Print Requirements Survey

    3. RFP tools

    Use these templates and tools to create an RFP for managed print services that can easily score and compare vendors.

    • Managed Print Services Vendor Assessment Questions
    • Managed Print Services RFP Vendor Proposal Scoring Tool
    • Managed Print Services RFP Template

    4. Printer policy

    Update the printer policy to express the new focus on reducing unsupported printer use.

    • Printer Policy Template

    Infographic

    Further reading

    Re-Envision Enterprise Printing

    Don't settle for printer consolidation; seek the elimination of print

    Analystperspective

    You're likely not in the printing business.
    Prepare your organization for the future by reducing print.

    Initiatives to reduce printers are often met with end-user resistance. Don't focus on the idea of taking something away from end users. Instead, focus on how print reduction fits into larger goals of business process improvement, and on opportunities to turn the vendor into a partner who drives business process improvement through ongoing innovation and print reduction.

    What are your true print use cases? Except in some legitimate use cases, printing often introduces friction and does not lead to efficiencies. Companies investing in digital transformation and document management initiatives must take a hard look at business processes still reliant on hard copies. Assess your current state to identify what the current print volume and costs are and where there are opportunities to consolidate and reduce.

    Change your financial model. The managed print services industry allows you to use a pay-as-you-go approach and right-size your print spend to the organization's needs. However, in order to do printing-as-a-service right, you will need to develop a good RFP and RFP evaluation process to make sure your needs are covered by the vendor, while also baking in assurances the vendor will partner with you for continuous print reduction.

    This is a picture of Emily Sugerman

    Emily Sugerman
    Research Analyst, Infrastructure & Operations
    Info-Tech Research Group

    Darin Stahl
    Principal Research Advisor, Infrastructure & Operations
    Info-Tech Research Group

    Executive summary

    Your Challenge

    IT directors and business operations managers face several challenges:

    • Too many known unknowns: Enterprises may be overspending on printing, but this spend is often unknown and untracked.
    • Opportunity costs: By locking into conventional printer leases and outdated document management, you are locking yourself out of the opportunity to improve business processes.

    Common Obstacles

    Printer reduction initiatives are stymied by:

    • End-user resistance: Though sometimes the use of paper remains necessary, end users often cling to paper processes out of concern about change.
    • Lack of governance: You lack insight into legitimate print use cases and lack full control over procurement of devices and consumables.
    • Overly generic RFP: Print requirements are not tailored to your organization, and your managed print services RFP does not ask enough of the vendor.

    Info-Tech's Approach

    Follow these steps to excise superfluous, costly printing:

    • Identify reduction opportunities via a thorough inventory and requirements-gathering process, and educate others on the financial and non-financial benefits. Enforce reduced printing through policies.
    • Change your printing financial model to print-as-a-service by building an RFP and scoring tool for managed print services that makes the vendor a partner in continuous innovation.
    • Leverage durable print management software to achieve vendor-agnostic governance and visibility.

    Info-Tech Insight

    Don't settle for printer consolidation: seek to eliminate print and enlist your managed print services vendor to help you achieve that goal.

    Your challenge

    This research is designed to help organizations that aim to reduce printing long term

    • Finally understand aggregate printing costs: Not surprisingly, printing has become a large hidden expense in IT. Enterprises may be overspending on printing, but this spend is often unknown and untracked. Printer consumables are purchased independently by each department, non-networked desktop printers are everywhere, and everyone seems to be printing in color.
    • Walk the walk when it comes to digital transformation: Outdated document management practices that rely on unnecessary printing are not the foundation upon which the organization can improve business processes.
    • Get out of the printing business: Hire a managed print provider and manage that vendor well.

    "There will be neither a V-shaped nor U-shaped recovery in demand for printing paper . . . We are braced for a long L-shaped decline."
    –Toru Nozawa, President, Nippon Paper Industries (qtd. in Nikkei Asia, 2020).

    Weight of paper and paperboard generated in the U.S.*

    This is an image of a graph plotting the total weight of paper and paperboard generated in the US, bu thousands of US tons.

    *Comprises nondurable goods (including office paper), containers, and packaging.

    **2020 data not available.

    Source: EPA, 2020.

    Common obstacles

    These barriers make this challenge difficult to address for many organizations:

    • Cost-saving opportunities are unclear: In most cases, nobody is accountable for controlling printing costs, so there's a lack of incentive to do so.
    • End-user attachment to paper-based processes: For end users who have been relying on paper processes, switching to a new way of working can feel like a big ask, particularly if an optimized alternative has not been provided and socialized.
    • Legitimate print use cases are undefined: Print does still have a role in some business processes (e.g. for regulatory reasons). However, these business processes have not been analyzed to determine which print use cases are still legitimate. The WFH experience during the COVID-19 pandemic demonstrated that many workflows that previously incorporated printing could be digitized. Indeed, the overall attachment to office paper is declining (see chart).
    • Immature RFP and RFP scoring methods: Outsourcing print to a managed service provider necessitates careful attention to RFP building and scoring. If your print requirements are not properly tailored to your organization and your managed print services RFP does not ask enough of the vendor, it will be harder to hold your vendor to account.

    How important is paper in your office?

    87% 77%

    Quocirca, a printer industry market research firm, found that the number of organizations for whom paper is "fairly or very important to their business" has dropped 10 percentage points between 2019 and 2021.

    Source: Quocirca, 2021.

    Info-Tech's approach

    Permanently change your company's print culture

    1. Plan your Project
    • Create your project charter, investigate end user printer behavior and reduction opportunities, gather requirements and calculate printer costs
  • Find the right managed print vendor
    • Protect yourself by building the right requirements into your RFP, evaluating candidates and negotiating from a strong position
  • Implement the new printer strategy
    • Identify printers to consolidate and eliminate, install them, and communicate updated printer policy
  • Operate
    • Track the usage metrics, service requests, and printing trends, support the printers and educate users to print wisely and sparingly
  • The Info-Tech difference:

    1. Use Info-Tech's tracking tools to finally track data on printer inventory and usage.
    2. Get to an RFP for managed print services faster through Info-Tech's requirement selection activity, and use Info-Tech's scoring tool template to more quickly compare candidates and identify frontrunners and knockouts.
    3. Use Info-Tech's guidance on print management software to decouple your need to govern the fleet from any specific vendor.

    Info-Tech's methodology for Re-Envision Enterprise Printing

    1. Strategy & planning 2. Vendor selection, evaluation, acquisition 3. Implementation & operation
    Phase steps
    1. Create project charter and assign roles
    2. Assess current state of enterprise print environments
    3. Gather current and future printer requirements
    1. Understand managed print services model
    2. Create RFP documents and score vendors
    3. Understand continuous innovation & print management software
    1. Modify printer policies
    2. Measure project success
    3. Training & adoption
    4. Plan persuasive communication
    5. Prepare for continuous improvement
    Phase outcomes
    • Documentation of project roles, scope, objectives, success metrics
    • Accurate printer inventory
    • Documentation of requirements based on end-user feedback, existing usage, and future goals
    • Finalized requirements
    • Completed RFP and vendor scoring tool
    • Managed print vendor selected, if necessary
    • Updated printer policies that reinforce print reduction focus
    • Assessment of project success

    Insight summary

    Keep an eye on the long-term goal of eliminating print

    Don't settle for printer consolidation: seek to eliminate print and enlist your managed print services vendor to help you achieve that goal.

    Persuading leaders is key

    Good metrics and visible improvement are important to strengthen executive support for a long-term printer reduction strategy.

    Tie printer reduction into business process improvement

    Achieve long-lasting reductions in print through document management and improved workflow processes.

    Maintain clarity on what types of printer use are and aren't supported by IT

    Modifying and enforcing printing policies can help reduce use of printers.

    Print management software allows for vendor-agnostic continuity

    Print management software should be vendor-agnostic and allow you to manage devices even if you change vendors or print services.

    Secure a better financial model from the provider

    Simply changing your managed print services pay model to "pay-per-click" can result in large cost savings.

    Blueprint deliverables

    Key deliverable:

    Managed Print Services RFP

    This blueprint's key deliverable is a completed RFP for enterprise managed print services, which feeds into a scoring tool that accelerates the requirements selection and vendor evaluation process.

    Managed Print Services Vendor Assessment Questions

    This is a screenshot from the Managed Print Services Vendor Assessment Questions

    Managed Print Services RFP Template

    This is a screenshot from the Managed Print Services RFP Template

    Managed Print Services RFP Vendor Proposal Scoring Tool

    This is a screenshot from the Managed Print Services RFP Vendor Proposal Scoring Tool

    Each step of this blueprint is accompanied by supporting deliverables to help you accomplish your goals:

    Enterprise Printing Project Charter

    This is a screenshot from the Enterprise Printing Project Charter

    Document the parameters of the print reduction project, your goals, desired business benefits, metrics.

    Enterprise Printing Roles and Responsibilities RACI Guide

    This is a screenshot from the Enterprise Printing Project Charter

    Assign key tasks for the project across strategy & planning, vendor selection, implementation, and operation.

    Printer Policy

    This is a screenshot from the Printer Policy

    Start with a policy template that emphasizes reduction in print usage and adjust as needed for your organization.

    Printer Reduction Tool

    This is a screenshot from the Printer Reduction Tool

    Track the printer inventory and calculate total printing costs.

    End-User Print Requirements Survey

    This is a screenshot from the End-User Print Requirements Survey

    Base your requirements in end user needs and feedback.

    Blueprint benefits

    IT benefits

    • Make the project charter for printer reduction and estimate cost savings
    • Determine your organization's current printing costs, usage, and capabilities
    • Define your organization's printing requirements and select a solution
    • Develop a printer policy and implement the policy

    Business benefits

    • Understand the challenges involved in reducing printers
    • Understand the potential of this initiative to reduce costs
    • Accelerate existing plans for modernization of paper-based business processes by reducing printer usage
    • Contribute to organizational environmental sustainability targets

    Info-Tech offers various levels of support to best suit your needs

    DIY Toolkit

    "Our team has already made this critical project a priority, and we have the time and capability, but some guidance along the way would be helpful."

    Guided Implementation

    "Our team knows that we need to fix a process, but we need assistance to determine where to focus. Some check-ins along the way would help keep us on track."

    Workshop

    "We need to hit the ground running and get this project kicked off immediately. Our team has the ability to take this over once we get a framework and strategy in place."

    Consulting

    "Our team does not have the time or the knowledge to take this project on. We need assistance through the entirety of this project."

    Diagnostics and consistent frameworks used throughout all four options

    Guided Implementation

    What does a typical GI on this topic look like?

    Phase 1 Phase 2 Phase 3

    Call #1: Scope requirements, objectives, and your specific challenges.

    Call #4: Review requirements.
    Weigh the benefits of managed print services.

    Call #6: Measure project success.

    Call #2: Review your printer inventory.
    Understand your current printing costs and usage.

    Call #5: Review completed scoring tool and RFP.

    Call #5: Review vendor responses to RFP.

    A Guided Implementation (GI) is a series of calls with an Info-Tech analyst to help implement our best practices in your organization.

    A typical GI is 8 to 12 calls over the course of 4 to 6 months.

    Phase 1

    Strategy and Planning

    Strategy & planning

    Vendor selection, evaluation, acquisition

    Implementation & Operation

    1.1 Create project charter and assign roles

    1.2 Assess current state

    1.3 Gather requirements

    2.1 Understand managed print services model

    2.2 Create RFP materials

    2.3 Leverage print management software

    3.1 Modify printer policies

    3.2 Measure project success

    3.3 Training & adoption

    3.4 Plan communication

    3.5 Prepare for continuous improvement

    Re-Envision Enterprise Printing

    • This phase will walk you through the following activities:
    • Create a list of enterprise print roles and responsibilities
    • Create project charter
    • Inventory printer fleet and calculate printing costs
    • Examine current printing behavior and identify candidates for device elimination
    • Gather requirements, including through end user survey

    This phase involves the following participants:

    • IT director/CIO
    • Business operations manager
    • Project manager

    Step 1.1

    Create project charter and assign roles

    Outcomes of this step

    Completed Project Charter with RACI chart

    Phase 1: Strategy and Planning

    • Step 1.1 Create project charter and assign roles
    • Step 1.2 Assess current state
    • Step 1.3 Gather requirements

    This step involves the following participants:

    • IT director/CIO
    • Business operations manager
    • Project manager

    Activities in this step

    • Create a list of enterprise print roles and responsibilities
    • Create project charter

    1.1 Create project charter

    Use the project charter to clearly define the scope and avoid scope creep

    Identify project purpose

    • Why is the organization taking on this project? What are you trying to achieve?
    • What is the important background you need to document? How old is the fleet? What kinds of printer complaints do you get? What percentage of the IT budget does printing occupy?
    • What specific goals should this project achieve? What measurable financial and non-financial benefits do these goals achieve?

    Identify project scope

    • What functional requirements do you have?
    • What outputs are expected?
    • What constraints will affect this project?
    • What is out of scope for this project?

    What are the main roles and responsibilities?

    • Who is doing what for this project?

    How will you measure success?

    • What are the project's success metrics and KPIs?

    Enterprise Printing Project Charter

    This is a screenshot from the Enterprise Printing Project Charter

    Anticipate stakeholder resistance

    Getting management buy-in for printer reduction is often one of the biggest challenges of the project.

    Challenge Resolution
    Printer reduction is not typically high on the priority list of strategic IT initiatives. It is often a project that regularly gets deferred. The lack of an aggregate view of the total cost of printing in the environment could be one root cause, and what can't be measured usually isn't being managed. Educate and communicate the benefits of printer reduction to executives. In particular, spend time getting buy-in from the COO and/or CFO. Use Info-Tech's Printer Reduction Tool to show executives the waste that is currently being generated.
    Printers are a sensitive and therefore unpopular topic of discussion. Executives often see a trade-off: cost savings versus end-user satisfaction. Make a strong financial and non-financial case for the project. Show examples of other organizations that have successfully consolidated their printers.

    Info-Tech Insight

    If printer reduction is not driven and enforced from the top down, employees will find ways to work around your policies and changes. Do not attempt to undertake printer reduction initiatives without alerting executives. Ensure visible executive support to achieve higher cost savings.

    Align the printer reduction project to org goals to achieve buy-in

    A successful IT project demonstrates clear connections to business goals

    Which business and organizational goals and drivers are supported by IT's intention to transform its printing ecosystem? For example,

    Legislation: In 2009, the Washington House of Representatives passed a bill requiring state agencies to implement a plan to reduce paper consumption by 30% (State of Washington, 2009). The University of Washington cites this directive as one of the drivers for their plans to switch fully to electronic records by 2022 (University of Washington, n.d.).

    Health care modernization: Implementing electronic health records; reducing paper charts.

    Supply chain risk reduction: In 2021, an Ontario district school board experienced photocopier toner shortages and were forced to request schools to reduce printing and photocopying: "We have recommended to all locations that the use of printing be minimized as much as possible and priority given to the printing of sensitive and confidential documentation" (CBC, 2021).

    Identify overall organizational goals in the following places:

    • Company mission statements
    • Corporate website
    • Business strategy documents
    • Other IT strategy documents
    • Executives

    Document financial and non-financial benefits

    Financial benefits: Printer reduction can reduce your printing costs and improve printing capabilities.

    • Printer reduction creates a controlled print environment; poorly controlled print environments breed unnecessary costs.
    • Cost savings can be realized through:
      • Elimination of cost-efficient inkjet desktop printers.
      • Elimination of high-cost, inefficient, or underutilized printers.
      • Sharing of workshop printers between an optimal number of end users.
      • Replacing separate printers, scanners, copiers, and fax machines with. multi-function devices.
    • Cost savings can be achieved through a move to managed print services, if you negotiate the contract well and manage the vendor properly. The University of Washington estimated a 20-25% cost reduction under a managed print services model compared to the existing lease (University of Washington, "What is MPS").

    Non-financial benefits: Although the main motivation behind printer reduction is usually cost savings, there are also non-financial benefits to the project.

    • Printer reduction decreases physical space required for printers
    • Printer reduction meets employee and client environmental demands
      • Printer reduction can reduce the electricity and consumables used
      • Reduction in consumables means reduced hazardous waste from consumables and devices
    • Printer reduction can result in better printing capabilities
      • Moving to a managed print services model can provide you with better printing capabilities with higher availability

    Assign responsibility to track print device costs to IT

    Problem:
    Managers in many organizations wrongly assume that since IT manages the printer devices, they also already manage costs.

    However, end users typically order printer devices and supplies through the supplies/facilities department, bypassing any budget approval process, or through IT, which does not have any authority or incentive to restrict requests (when they're not measured against the controlling of printer costs).

    Organization-wide printer usage policies are rarely enforced with any strictness.

    Without systematic policy enforcement, end-user print behavior becomes frivolous and generates massive printing costs.

    Solution:
    Recommend all print device costs be allocated to IT.

    • Aggregate responsibility: Recommend that all printer costs be aggregated under IT's budget and tracked by IT staff.
    • Assign accountability: Although supplies may continually be procured by the organization's supplies/facilities department, IT should track monthly usage and costs by department.
    • Enforce policy: Empower IT with the ability to enforce a strict procurement policy that ensures all devices in the print environment are approved models under IT's control. This eliminates having unknown devices in the printer fleet and allows for economies of scale to be realized from purchasing standardized printing supplies.
    • Track metrics: IT should establish metrics to measure and control each department's printer usage and flat departments that exceed their acceptable usage amounts.

    Assign accountability for the initiative

    Someone needs to have accountability for both the printer reduction tasks and the ongoing operation tasks, or the initiative will quickly lose momentum.

    Customize Info-Tech's Enterprise Printing Roles and Responsibilities RACI Guide RACI chart to designate project roles and responsibilities to participants both inside and outside IT.

    These tasks fall under the categories of:

    • Strategy and planning
    • Vendor selection, evaluation, and acquisition
    • Implementation
    • Operate

    Assign a RACI: Remember the meaning of the different roles

    • Responsible (does the work on a day-to-day basis)
    • Accountable (reviews, signs off on, and is held accountable for outcomes)
    • Consulted (input is sought to feed into decision making)
    • Informed (is given notification of outcomes)

    As a best practice, no more than one person should be responsible or accountable for any given process. The same person can be both responsible and accountable for a given process, or it could be two different people.

    Avoid making someone accountable for a process if they do not have full visibility into the process for appropriate oversight, or do not have time to give the process sufficient attention.

    The Enterprise Printing Roles and Responsibilities RACI Guide can be used to organize and manage these tasks.

    This is a screenshot from the Enterprise Printing Roles and Responsibilities RACI Guide

    Define metrics to measure success

    Track your project success by developing and tracking success metrics

    Ensure your metrics relate both to business value and customer satisfaction. "Reduction of print" is a business metric, not an experience metric.

    Frame metrics around experience level agreements (XLAs) and experience level objectives (XLOs): What are the outcomes the customer wants to achieve and the benefits they want to achieve? Tie the net promoter score into the reporting from the IT service management system, since SLAs are still needed to tactically manage the achievement of the XLOs.

    Use the Metrics Development Workbook from Info-Tech's Develop Meaningful Service Metrics to define:

    • Relevant stakeholders
    • Their goals and pain points
    • The success criteria that must be met to achieve these goals
    • The key indicators that must be measured to achieve these goals from an IT perspective
    • What the appropriate IT metrics are, based on all of the above

    Metrics could include

    • User satisfaction
    • Print services net promoter model
    • Total printing costs
    • Printer availability (uptime)
    • Printer reliability (mean time between failures)
    • Total number of reported incidents
    • Mean time for vendor to respond and repair

    Info-Tech Insight:

    Good metrics and visible improvement are important to strengthen executive support for a long-term printer reduction strategy.

    Step 1.2

    Assess current state

    Outcomes of this step

    • Aggregate view of your printer usage and costs

    Strategy and Planning

    This step involves the following participants:

    • IT director/CIO
    • Business operations manager
    • Project manager

    Activities in this step

    • 1.2. Inventory your printer fleet: Office walk-around
    • 1.2 Inventory your printer fleet: Collect purchase receipts/statements/service records
    • 1.3 Calculate printing costs

    Create an aggregate view of your printer usage and costs

    Problem: Lack of visibility

    • Most organizations are unaware of the savings potential in reducing print due to a lack of data.
    • Additionally, organizations may have inappropriately sized devices for their workloads.
    • Often, nobody is responsible for managing the printers collectively, resulting in a lack of visibility into printing activity. Without this visibility, it is difficult to muster executive commitment and support for printer reduction efforts.
    • The first step to eliminating your printers is to inventory all the printers in the organization and look at an aggregate view of the costs. Without understanding the cost saving potential, management will likely continue to avoid printer changes due to the idea's unpopularity with end users.
    • Valid use cases for printers will likely still remain, but these use cases should be based on a requirements analysis.
    This is a screenshot from the Printer Reduction Tool. It includes the Printer Inventory, and a table with the following column headings: Device Type; Specific Device; Networked; Manufacturer; Model; Serial #; Office Location; Device Owner; # users Supported; Monthly Duty; Page Count to; Device Age; Remaining Useful; # Pages printer/month; % Utilization

    Create visibility through by following these steps:

    1. Office walk-around: Most organizations have no idea how many printers they have until they walk around the office and physically count them. This is especially true in cases where management is allowed to purchase personal printers and keep them at their desks. An office walk-around is often necessary to accurately capture all the printers in your inventory.
    2. Collect purchase receipts/statements/service records: Double-check your printer inventory by referring to purchase receipts, statements, and service records.
    3. Identify other sources of costs: Printer purchases only make up a small fraction of total printing costs. Operating costs typically account for 95% of total printer costs. Make sure to factor in paper, ink/toner, electricity, and maintenance costs.

    1.2.1 Inventory your printer fleet: part 1

    Office walk-around

    1. Methodically walk around the office and determine the following for each printer:
      • Device type
      • Make, model, serial number
      • Location
      • Number of users supported
      • Device owner
      • Type of users supported (department, employee position)
    2. Record printer details in Tab 1 of Info-Tech's Printer Reduction Tool. Collaborate with the accounting or purchasing department to determine the following for each printer recorded:
      • Purchase price/date
      • Monthly duty cycle
      • Estimated remaining useful life
      • Page count to date

    Input

    Output
    • Existing inventory lists
    • Visual observation
    • Inventory of office printers, including their printer details

    Materials

    Participants

    • Notepad
    • Pen
    • Printer Reduction Tool
    • IT director
    • IT staff

    Download the Printer Reduction Tool

    1.2.2 Inventory your printer fleet:
    part 2

    Collect purchase receipts/statements/service records

    1. Ask your purchasing manager for purchase receipts, statements, and service records relating to printing.
    2. For documents found, match the printer with your physical inventory. Add any printers found that were not captured in the physical inventory count. Record the following:
      1. Device type
      2. Make, model, serial number
      3. Location
      4. Number of users supported
      5. Device owner
      6. Type of users supported (department, employee position)
    3. 3. Collaborate with the accounting or purchasing department to determine the following for each printer recorded:
      1. Purchase price/date
      2. Monthly duty cycle
      3. Estimated remaining useful life
      4. Page count to date
    4. Enter the data in Tab 1 of the Printer Reduction Tool

    Input

    Output
    • Purchase receipts
    • Statements
    • Service records
    • Printer inventory cross-checked with paperwork

    Materials

    Participants

    • Printer inventory from previous activity
    • IT director
    • IT staff
    • Purchasing manager

    Download the Printer Reduction Tool

    1.2.3 Calculate your printing costs

    Collect purchase receipts/statements/service records

    • Collect invoices, receipts, and service records to sum up the costs of paper, ink or toner, and maintenance for each machine. Estimate electricity costs.
    • Record your costs in Tab 2 of the Printer Reduction Tool.
    • Review the costs per page and per user to look for particularly expensive printers and understand the main drivers of the cost.
    • Review your average monthly cost and annual cost per user. Do these costs surprise you?

    Input

    Output
    • Invoices, receipts, service records for
    • Cost per page and user
    • Average monthly and annual cost

    Materials

    Participants

    • Printer Reduction Tool
    • IT director
    • IT staff

    Step 1.3

    Gather printing requirements

    Outcomes of this step

    • Understanding of the organization's current printing behavior and habits
    • Identification of how industry context and digitization of business processes have impacted current and future requirements

    This step involves the following participants:

    • IT director
    • IT staff
    • Rest of organization

    Activities in this step

    • Examine current printing behavior and habits
    • Administer end-user survey
    • Identify current requirements
    • Identify future requirements

    Requirements Gathering Overview

    1. Identify opportunities to go paperless
      • Determine where business process automation is occurring
      • Align with environmental and sustainability campaigns
    2. Identify current requirements
      • Review the types of document being printed and the corresponding features needed
      • Administer end-user survey to understand user needs and current printer performance
    3. Identify future requirements
    • Identify future requirements to avoid prematurely refreshing your printer fleet
  • Examine industry-specific/ workflow printing
    • Some industries have specific printing requirements such as barcode printing accuracy. Examine your industry-specific printing requirements
  • Stop: Do not click "Print"

    The most effective way to achieve durable printing cost reduction is simply to print less.

    • Consolidating devices and removing cost-inefficient individual printers is a good first step to yielding savings.
    • However, more sustainable success is achieved by working with the printer vendor(s) and the business on continuous innovation via proposals and initiatives that combine hardware, software, and services.
    • Sustained print reduction depends on separate but related business process automation and digital innovation initiatives.

    Info-Tech Insight:

    Achieve long-lasting reductions in print through document management and improved workflow processes.

    Leverage Info-Tech research to support your business' digital transformation

    This is an image of the title page from Info-Tech's Define your Digital Business Strategy blueprint.

    Define how changes to enterprise printing fit into digital transformation plans

    Identify opportunities to go paperless

    The "paperless office" has been discussed since the 1970s. The IT director alone does not have authority to change business processes. Ensure the print reduction effort is tied to other strategies and initiatives around digital transformation. Working on analog pieces of paper is not digital and may be eroding digital transformation process.

    Leverage Info-Tech's Assert IT's Relevance During Digital Transformations to remind others that modernization of the enterprise print environment belongs to the discussion around increasing digitized support capabilities.

    1. Digital Marketing

    2. Digital Channels

    3. Digitized Support Capabilities

    4. Digitally Enabled Products

    5. Business Model Innovation

    Manage Websites

    E-Channel Operations

    Workforce Management

    Product Design

    Innovation Lab Management

    Brand Management

    Product Inventory Management

    Digital Workplace Management

    Portfolio Product Administration

    Data Sandbox Management

    SEO

    Interactive Help

    Document Management

    Product Performance Measurement

    Innovation Compensation Management

    Campaign Execution

    Party Authentication

    Eliminate business process friction caused by print

    Analyze workflows for where they are still using paper. Ask probing questions about where paper still adds value and where the business process is a candidate for paperless digital transformation

    • Is this piece of paper only being used to transfer information from one application to another?
    • What kind of digitalization efforts have happened in the business as a result of the COVID-19 pandemic? Which workflows have digitized on their own?
    • Where has e-signature been adopted?
    • Is this use of paper non-negotiable (e.g. an ER triage that requires a small printer for forms; the need for bank tellers to provide receipts to customers)?
    • Do we have compliance obligations that require us to retain a paper process?
    • What is getting printed? Who is printing the most? Identify if there are recurring system-generated reports being printed daily/weekly/quarterly that are adding to the volume. Are reports going directly from staff mailboxes to a recycling bin?
    • Does our print financial model incentivize the transformation of business processes, or does it reinforce old habits?
    • What services, software, and solutions for document management and business process analysis does our managed print services vendor offer? Can we involve the vendor in the business transformation conversation by including an innovation clause in the next contract (re)negotiation to push the vendor to offer proposals for projects that reduce print?

    Develop short-term and long-term print reduction strategies

    Short-term strategies

    • Consolidate the number of printers you have.
    • Determine whether to outsource printing to a managed services provider and make the move.
    • Enable print roaming and IT verification.
    • Require user-queued print jobs to be authenticated at a printer to prevent print jobs that are lost or not picked up.
    • Set up user quotas.
    • Provide usage records to business managers so they can understand the true cost of printing.
    • User quotas may create initial pushback, but they lead users to ask themselves whether a particular print job is necessary.
    • Renegotiate print service contracts.
    • Revisit contracts and shop around to ensure pricing is competitive.
    • Leverage size and centralization by consolidating to a single vendor, and use the printing needs of the entire enterprise to decrease pricing and limit future contractual obligations.
    • Train users on self-support.
    • Train users to remedy paper jams and move paper in and out of paper trays.

    Long-term strategies

    • Promote a paperless culture by convincing employees of its benefits (greater cost savings, better security, easier access, centralized repository, greener).
    • Educate users to use print area wisely.
    • Develop campaigns to promote black and white printing or a paperless culture.

    Info-Tech Insight:

    One-time consolidation initiatives leave money on the table. The extra savings results from changes in printing culture and end-user behavior.

    Examine current printing behavior and habits

    It's natural for printer usage and printing costs to vary based on office, department, and type of employee. Certain jobs simply require more printing than others.

    However, the printing culture within your organization likely also varies based on

    • office
    • department
    • type of employee

    Examine the printing behaviors of your employees based on these factors and determine whether their printing behavior aligns with the nature of their job.

    Excessive printing costs attributed to departments or groups of employees that don't require much printing for their jobs could indicate poor printing culture and potentially more employee pushback.

    Examine current printing behavior and habits, and identify candidates for elimination

    1. Go to Tab 3 of your Printer Reduction Tool ("Usage Dashboard Refresh"). Right-click each table and press "Refresh."
    2. Go to Tab 4 of your Printer Reduction Tool ("Usage Dashboard") to understand the following:
      1. Average printer utilization by department
      2. Pages printed per month by department
      3. Cost per user by department
    3. Take note of the outliers and expensive departments.
    4. Review printer inventory and printer use rates on Tab 5.
    5. Decide which printers are candidates for elimination and which require more research.
    6. If already working in a managed print services model, review the vendor's recommendations for printer elimination and consolidation.
    7. Mark printers that could be eliminated or consolidated.

    Input

    Output
    • Discussion
    • Understanding of expensive departments and other outliers

    Materials

    Participants

    • Printer Reduction Tool
    • IT director/ business operations
    • Business managers

    Administer end-user survey

    Understand end-user printing requirements and current printer performance through an end-user survey

    1. Customize Info-Tech's End-User Print Requirements Survey to help you understand your users' needs and the current performance of your printer fleet.
    2. Send the survey to all printer users in the organization.
    3. Collect the surveys and aggregate the requirements of users in each department.
    4. Record the survey results in the "Survey Results" tab.

    Input

    Output
    • End-user feedback
    • Identification of outliers and expensive departments

    Materials

    Participants

    • End-User Print Requirements Survey template
    • IT director
    • IT staff
    • Rest of organization

    Download the End-User Print Requirements Survey

    Info-Tech Insight:

    Use an end-user printer satisfaction survey before and after any reduction efforts or vendor implementation, both as a requirement-gathering user input and to measure/manage the vendor.

    Identify your current requirements

    Collect all the surveys and aggregate user requirements. Input the requirements into your Printer Reduction Tool.

    Discussion activity:

    • Review the requirements for each department and discuss:
    • What is this device being used for (e.g. internal documents, external documents, high-quality graphics/color)?
    • Based on its use case, what kinds of features are needed (e.g. color printing, scanning to email, stapling)?
    • Is this the right type of device for its purpose? Do we need this device, or can it be eliminated?
    • Based on its use case, what kinds of security features are needed (e.g. secure print release)?
    • Are there any compliance requirements that need to be satisfied (e.g. PCI, ITAR, HIPAA)?
    • Based on its use case, what's the criticality of uptime?
    • What is this device's place in the organization's workflow? What are its dependencies?
    • With which systems is the device compatible? Is it compatible with the newer operating system versions? If not, determine whether the device is a refresh candidate.

    Input

    Output
    • Survey results and department requirements
    • List of current requirements

    Materials

    Participants

    • N/A
    • IT director
    • IT staff

    Identify your future requirements

    Prepare your printer fleet for future needs to avoid premature printer refreshes.

    Discussion activity:

    • Review the current requirements for each department's printers and discuss whether the requirements will meet the department's printing needs over the next 10 years.
    • What is this device going to be used for in the next 10 years?
    • Will use of this device be reduced by plans to increase workflow digitization?
    • Based on its use case, what kinds of features are needed?
    • Is this the right type of device for its purpose?
    • Based on its use case, what kinds of security features are needed?
    • Based on its use case, what is the criticality of uptime?
    • Is this device's place in the organization's workflow going to change? What are its dependencies?
    • Reassess your current requirements and make any changes necessary to accommodate for future requirements.

    Input

    Output
    • Discussion
    • List of future requirements

    Materials

    Participants

    • N/A
    • IT director
    • IT staff

    Examine requirements specific to your industry and workflow

    Some common examples of industries with specific printing requirements:

    • Healthcare
      • Ability to comply with HIPAA requirements
      • High availability and reliability with on-demand support and quick response times
      • Built-in accounting software for billing purposes
      • Barcode printing for hospital wristbands
      • Fax requirements
    • Manufacturing
      • Barcoding technology
      • Ability to meet regulations such as FDA requirements for the pharmaceutical industry
      • Ability to integrate with ERP systems
    • Education
      • Password protection for sensitive student information
      • Test grading solutions
      • Paper tests for accessibility needs

    Phase 2

    Vendor Selection, Evaluation, Acquisition

    Strategy & planning

    Vendor selection, evaluation, acquisition

    Implementation & Operation

    1.1 Create project charter and assign roles

    1.2 Assess current state

    1.3 Gather requirements

    2.1 Understand managed print services model

    2.2 Create RFP materials

    2.3 Leverage print management software

    3.1 Modify printer policies

    3.2 Measure project success

    3.3 Training & adoption

    3.4 Plan communication

    3.5 Prepare for continuous improvement

    Re-Envision Enterprise Printing

    • This phase will walk you through the following activities:
    • Define managed print services RFP requirement questions
    • Create managed print services RFP and scoring tool
    • Score the RFP responses

    This phase involves the following participants:

    • IT director/CIO
    • Business operations manager
    • Project manager

    Change your financial model

    The managed print services industry allows you to use a pay-as-you-go approach and right-size your print spend to the organization's needs.

    Avoid being locked into a long lease where the organization pays a fixed monthly fee whether the printer runs or not.

    Instead, treat enterprise printing as a service, like the soda pop machine in the break room, where the vendor is paid when the device is used. If the vending machine is broken, the vendor is not paid until the technician restores it to operability. Printers can work the same way.

    By moving to a per click/page financial model, the vendor installs and supports the devices and is paid whenever a user prints. Though the organization pays more on a per-click/page basis compared to a lease, the vendor is incentivized to right-size the printer footprint to the organization, and the organization saves on monthly recurring lease costs and maintenance costs.

    Right-size commitments: If the organization remains on a lease instead of pay-per-click model, it should right-size the commitment if printing drops below a certain volume. In the agreement, include a business downturn clause that allows the organization to right-size and protect itself in the event of negative growth.

    Understand the managed print services model and its cost savings

    Outsourcing print services can monitor and balance your printers and optimize your fleet for efficiency. Managed print services are most appropriate for:

    • Organizations engaging in high-volume, high-quality print jobs with growing levels of output.
    • Organizations with many customer-facing print jobs.

    There are three main managed printing service models. Sometimes, an easy switch from a level pay model to a pay-per-click model can result in substantial savings:

    Level Pay

    • Flat rate per month based on estimates.
    • Attempts to flatten IT's budgeting so printing costs are consistent every month or every year (for budgeting purposes). At the end of the year, the amount of supplies used is added up and compared with the initial estimates and adjusted accordingly.
    • The customer pays the same predictable fee each month every year, even if you don't meet the maximum print quantity for the pay. Increased upcharge for quantities exceeding maximum print quantity.

    Base Plus Click

    • Fixed base payment (lease or rental) + pay-per-sheet for services.
    • In addition to the monthly recurring base cost, you pay for what you use. This contract may be executed with or without a minimum monthly page commitment. Page count through remote monitoring technologies is typically required.

    Pay Per Click

    • Payment is solely based on printing usage.
    • Printing costs will likely be the lowest with this option, but also the most variable.
    • This option requires a minimum monthly page commitment and/or minimum term.

    Info-Tech Insight:

    Vendors typically do not like the pay-per-click option and will steer businesses away from it. However, this option holds the vendor accountable for the availability and reliability of your printers, and Info-Tech generally recommends this option.

    Compare financials of each managed print services option

    Your printing costs with a pay-per-click model are most reflective of your actual printer usage. Level pay tends to be more expensive, where you need to pay for overages but don't benefit from printing less than the maximum allocated.

    See the below cost comparison example with level pay set at a maximum of 120,000 impressions per month. In the level pay model, the organization was paying for 120,000 sheets in the month it only used 60,000 impressions, whereas it would have been able to pay just for the 60,000 sheets in the pay-per-click model.

    This image contains tables with the column headings: Impressions per month; Total Cost; Average Cost per Impression; for each of the following categories: Level Pay; Base Plus Click; Pay Per Click

    Financial comparison case study

    This organization compared estimated costs over a 36-month period for the base-plus-click and pay-per-page models for Toshiba E Studio 3515 AC Digital Color Systems.

    Base-plus-click model

    Monthly recurring cost

    Avg. impressions per month

    Monthly cost

    Monthly cost

    "Net pay per click"

    Cost over 36-month period

    A fixed lease cost each month, with an additional per click/page charge

    $924.00

    12,000 (B&W)

    $0.02 (B&W)

    $1,164.00 (B&W)

    $0.097 (B&W)

    $41,904 (B&W)

    5,500 (Color)

    $0.09 (Color)

    $495.00 (Color)

    $0.090 (Color)

    $17,820 (Color)

    Base-plus-click model

    Monthly recurring cost

    Avg. impressions per month

    Monthly cost

    Monthly cost

    "Net pay per click"

    Cost over 36-month period

    No monthly lease cost, only per-image charges

    0.00

    12,000 (B&W)

    $0.06 (B&W)

    $720.00 (B&W)

    $0.060 (B&W)

    $25,920 (B&W)

    5,500 (Color)

    $0.12 (Color)

    $660.00 (Color)

    $0.120 (Color)

    $23,760 (Color)

    Results

    Though the per-image cost for each image is lower in the base-plus-click model, the added monthly recurring costs for the lease means the "net pay per click" is higher.

    Overall, the pay-per-page estimate saved $10,044 over a 36-month period for this device.

    Bake continuing innovation into your requirements

    Once you are in the operation phase, you will need to monitor and analyze trends in company printing in order to make recommendations for the future and to identify areas for possible savings and/or asset optimization.

    Avoid a scenario where the vendor drops the printer in your environment and returns only for repairs. Engage the vendor in this continuous innovation work:

    In the managed services agreement, include a proviso for continuous innovation where the vendor has a contractual obligation to continually look at the business process flow and bring yearly proposals to show innovation (e.g. cost reductions; opportunities to reduce print, which allows the vendor to propose document management services and record keeping services). Leverage vendors who are building up capabilities to transform business processes to help with the heavy lifting.

    Establish a vision for the relationship that goes beyond devices and toner. The vendor can make a commitment to continuous management and constant improvement, instead of installing the devices and leaving. Ideally, this produces a mutually beneficial situation: The client asks the vendor to sell them ways to mature and innovate the business processes, while the vendor retains the business and potentially sells new services. In order to retain your business, the vendor must continue to learn and know about your business.

    The metric of success for your organization is the simple reduction in printed copies overall. The vendor success metric would be proposals that may combine hardware, software, and services that provide cost-effective reductions in print through document management and workflow processes. The vendors should be keen to build this into the relationship since the services delivery has a higher margin for them.

    Sample requirement wording:

    "Continuing innovation: The contractor initiates at least one (1) project each year of the contract that shows leadership and innovation in solutions and services for print, document management, and electronic recordkeeping. Bidders must describe a sample project in their response, planning for an annual investment of approximately 50 consulting hours and $10,000 in hardware and/or software."

    Reward the vendor for performance instead of "punishing" them for service failures

    Problem: Printer downtime and poor service is causing friction with your managed service provider (MSP).

    MSPs often offer clients credit requests (service credits) for their service failures, which are applied to the previous month's monthly recurring charge. They are applied to the last month's MRC (monthly reoccurring charges) at the end of term and then the vendor pays out the residual.

    However, while common, service credits are not always perceived to be a strong incentive for the provider to continually focus on improvement of mean time to respond or mean time to repair.

    Solution: Turn your vendor into a true partner by including an "earn back" condition in the contract.

    • Engage the vendor as a true partner within a relationship based upon service credits.
    • Suggest that the vendor include a minor change to the non-performance processes within the final agreement: the vendor implements an "earn back" condition in the agreement.
    • Where a bank of service credits exists because of non-performance, if the provider exceeds the SLA performance metrics for a number of consecutive months (two is common), then a given number of prior credits received by the client are returned to the provider as a reward for improved performance.
    • This can be a useful mechanism to drive improved performance.

    Leverage enterprise print management software

    Printers are commoditized and can come and go, but print management software enables the governance, compliance, savings and visibility necessary for the transformation

    • Printer management solutions range from tools bundled with ink-jet printers that track consumables' status, to software suites that track data for thousands of print devices.
    • Typically, these solutions arrive in enterprises as part of larger managed services printing engagements, bundled with hardware, financing, maintenance, and "services."
    • Bundling print management software means that customers very rarely seek to acquire printing management software alone.
    • Owing to the level of customization (billing, reporting, quotas, accounts, etc.) switching print management software solutions is also rare. The work you put into this software will remain with IT regardless of your hardware.
    • Durability of print management software is also influenced by the hardware- and technology-agnostic nature of the solutions (e.g. swapping one vendor's devices for another does not trigger anything more than a configuration change in print management software.)

    Include enterprise print management requirements in the RFP

    Ask respondents to describe their managed services capabilities and an optional on-premises, financed solution with these high-level capabilities.

    Select the appropriate type of print management software

    Vendor-provided solutions are adequate control for small organizations with simple print environments

    • Suitable for small organizations (<100 users).
    • Software included with print devices can pool print jobs, secure access, and centralize job administration.
    • Dealing with complex sales channels for third-party vendors is likely a waste of resources.

    SMBs with greater print control needs can leverage mid-level solutions to manage behavior

    • Suitable for mid-size organizations (<500 users).
    • Mid-level software can track costs, generate reports, and centralize management.
    • Solutions start at $500 but require additional per-device costs.

    Full control solutions will only attract large organizations with a mature print strategy

    • Full control solutions tend to be suitable for large organizations (>500 users) with complex print environments and advanced needs.
    • Full control software allows for absolute enforcement of printing policies and full control of printing.
    • Expect to spend thousands for a tailored solution that will save time and guide cost savings.

    Enterprise print management software features

    The feature set for these tools is long and comprehensive. The feature list below is not exhaustive, as specific tools may have additional product capabilities.

    Print Management Software Features

    Hardware-neutral support of all major printer types and operating systems (e.g. direct IP to any IPP-enabled printer along with typical endpoint devices) Tracking of all printing activity by user, client account, printer, and document metadata
    Secure print on demand (Secure print controls: User Authenticated Print Release, Pull Printing) Granular print cost/charging, allowing costs to be assigned on a per-printer basis with advanced options to charge different amounts based on document type (e.g. color, grayscale or duplex), page size, user or group
    Managed and secured mobile printing (iOS/Android), BYOD, and guest printing DaaS/VDI print support
    Printer installation discovery/enablement, device inventory/management Auditing/reporting, print audit trail using document attributes to manage costs/savings, enforce security and compliance with regulations and policies
    Monitoring print devices, print queues, provide notification of conditions Watermarking and/or timestamping to ensure integrity and confidentially/classification of printed documents some solutions support micro font adding print date, time, user id and other metadata values discreetly to a page preventing data leakage
    Active Directory integration or synchronization with LDAP user accounts Per-user quotas or group account budgets
    Ability to govern default print settings policies (B&W, double-sided, no color, etc.)

    Get to the managed print services RFP quicker

    Jumpstart your requirements process using these tools and exercises

    Vendor Assessment Questions

    Use Info-Tech's catalog of commonly used questions and requirements in successful acquisition processes for managed print services. Ask the right questions to secure an agreement that meets your needs. If you are already in a contract with managed print services, take the opportunity of contract renewal to improve the contract and service.

    RFP Template and "Schedule 1" Attachment

    Add your finalized assessment questions into this table, which you will attach to your RFP. The vendor answers questions in this "Schedule 1" attachment and returns it to you.

    RFP Scoring Tool

    Aggregate the RFP responses into this scoring tool to identify the frontrunners and candidates for elimination. Since the vendors are asked to respond in a standard format, it is easier to bring together all the responses to create a complete view of your options.

    Define RFP requirement questions

    Include the right requirements for your organization, and avoid leaving out important requirements that might have been overlooked.

    1. Download the Managed Print Services Vendor Assessment Questions tool. Use this document as a "shopping list" to jumpstart an initial draft of the RFP and, more importantly, scoring requirements.
    2. Review the questions in the context of your near- and long-term printer outsourcing needs. Consider your environment, your requirements, and goals. Include other viewpoints from the RACI chart from Phase 1.
    3. Place an 'X' in the first column to retain the question. Edit the wording of the question if required, based on your organizational needs.
    4. Use the second column to indicate which section of the RFP to include the question in.

    Input

    Output
    • Requirements from Phase 1.3
    • Completed list of requirement questions

    Materials

    Participants

    • Managed Print Services Vendor Assessment Questions tool
    • IT director/business operations
    • Other roles from the RACI chart completed in Phase 1

    Download the Managed Print Services Vendor Assessment Questions tool

    Create RFP scoring tool and RFP

    1. Enter the requirements questions into the scoring tool on Tabs 2 and 4.
    2. Tab 2: Create scoring column for each vendor. You will paste in their responses here.
    3. Edit Tabs 3 and 4 so they align with what you want the vendor to see. Copy and paste Tab 3 and Tab 4 into a new document, which will serve as a "Schedule 1" attachment to the RFP package the vendor receives.
    4. Complete the RFP template. Describe your current state and current printer hardware (documented in the earlier current-state assessment). Explain the rules of how to respond and how to fill out the Schedule 1 document. Instruct each vendor to fill in their responses to each question along with any notes, and to reply with a zip file that includes the completed RFP package along with any marketing material needed to support their response.
    5. Send a copy of the RFP and Schedule 1 to each vendor under consideration.

    Input

    Output
    • Completed list of requirement questions from previous activity
    • RFP Scoring tool
    • Completed RFP and schedule 1 attachment

    Materials

    Participants

    • Managed Print Services RFP Vendor Proposal Scoring Tool
    • Managed Print Services RFP
    • IT director/business operations

    Download the Managed Print Services RFP Vendor Proposal Scoring Tool

    Download the Managed Print Services RFP template

    Score RFP responses

    1. When the responses are returned, copy and paste each vendor's results from Schedule 1 into Tab 2 of the main scoring tool.
    2. Evaluate each RFP response against the RFP criteria based on the scoring scale.
    3. Send the completed scoring tool to the CIO.
    4. Set up a meeting to discuss the scores and generate shortlist of vendors.
    5. Conduct further interviews with shortlisted vendors for due diligence, pricing, and negotiation discussions.
    6. Once a vendor is selected, review the SLAs and contract and develop a transition plan.

    Input

    Output
    • Completed Managed Print Services RFP Vendor Proposal Scoring Tool
    • Shortlist or final decision on vendor

    Materials

    Participants

    • N/A
    • IT director/business operations

    Info-Tech Insight:

    The responses from the low-scoring vendors still have value: these providers will likely provide ideas that you can then leverage with your frontrunner, even if their overall proposal did not score highly.

    Phase 3

    Implementation & Operation

    Strategy & planning

    Vendor selection, evaluation, acquisition

    Implementation & Operation

    1.1 Create project charter and assign roles

    1.2 Assess current state

    1.3 Gather requirements

    2.1 Understand managed print services model

    2.2 Create RFP materials

    2.3 Leverage print management software

    3.1 Modify printer policies

    3.2 Measure project success

    3.3 Training & adoption

    3.4 Plan communication

    3.5 Prepare for continuous improvement

    Re-Envision Enterprise Printing

    This phase will walk you through the following activities:

    • Update your enterprise printer policies
    • Readminister end-user survey to measure project success

    This phase involves the following participants:

    • IT director/CIO
    • Business operations manager
    • Project manager

    Modify your printer policies

    Review and modify Info-Tech's Printer Policy Template to support your print reduction goals

    Consider that your goal is to achieve printer reduction. Discuss with your team how strict it needs to be to truly reset behavior with printers. Many organizations struggle with policy enforcement. Firm language in the policy may be required to achieve this goal. For example,

    • IT only supports the printers acquired through the managed print service. Personal desktop printers are not supported by IT. Expense statements will not be accepted for non-supported printers.
    • Create a procurement policy where all device requests need justification and approval by department managers and IT. Have a debate over what the extreme exceptions would be. Legitimate exceptions must go through a review and approval process.
    • Restrict color printing to external or customer-facing use cases.
    • Encourage digital or electronic solutions in lieu of hard copies (e.g. e-signatures and approval workflows; scanning; use of integrated enterprise applications like SharePoint).
    This is a screenshot of the Printer Policy Page Template

    Download the Printer Policy template

    Readminister the end-user survey

    You have already run this survey during the requirements-gathering phase. Run it again to measure success.

    The survey was run once prior to the changes being implemented to establish a baseline of user satisfaction and to gain insights into additional requirements.

    Several months after the initial rollout (90 days is typical to let the dust settle), resurvey the end users and publish or report to the administration success metrics (the current costs vs. the actual costs prior to the change).

    User satisfaction survey can be used to manage the vendor, especially if the users are less happy after the vendor touched their environment. Use this feedback to hold the provider to account for improvement.

    Input

    Output
    • Previous survey results
    • Changes to baseline satisfaction metrics

    Materials

    Participants

    • End-user survey from Phase 1
    • IT director
    • IT staff
    • Rest of organization

    Measure project success

    Revisit the pre-project metrics and goals and compare with your current metrics

    • Identify printers to consolidate or eliminate.
    • Update asset management system (enter software and hardware serial numbers or identification tags into configuration management system).
    • Reallocate/install printers across the organization.
    • Develop ongoing printer usage and cost reports for each department.
    • Review the end-user survey and compare against baseline.
    • Operate, validate, and distribute usage metrics/chargeback to stakeholders.
    • Audit and report on environmental performance and sustainability performance to internal and external bodies, as required.
    • Write and manage knowledgebase articles.
    • Monitor and analyze trends in company printing in order to make recommendations for the future and to identify areas for possible savings and/or asset optimization.

    Metrics could include

    • User satisfaction
    • Print services net promoter model
    • Total printing costs
    • Printer availability (uptime)
    • Printer reliability (mean time between failures)
    • Total number of reported incidents
    • Mean time for vendor to respond and repair

    Support training and adoption

    Train users on self-support

    Prepare troubleshooting guides and step-by-step visual aid posters for the print areas that guide users to print, release, and find their print jobs and fix common incidents on their own. These may include:

    • The name of this printer location and the names of the others on that floor.
    • How to enter a PIN to release a print job.
    • How to fix a paper jam.
    • How to empty the paper tray.
    • How to log a service ticket if all other steps are exhausted.

    Educate users to use print area wisely

    • Inform users what to do if other print jobs appear to be left behind in the printer area.
    • Display guidelines on printer location alternatives in case of a long line.
    • Display suggestions on maximum recommended time to spend on a job in the event other users are waiting.

    Develop campaign to promote paperless culture

    Ensure business leadership and end users remain committed to thinking before they print.

    • Help your users avoid backsliding by soliciting feedback on the new printer areas.
    • Ensure timely escalation of service tickets to the vendor.
    • Support efforts by the business to seek out business process modernization opportunities whenever possible.

    Plan persuasive communication strategies

    Identify cost-saving opportunities and minimize complaints through persuasive communication

    Solicit the input of end users through surveys and review comments.

    Common complaints Response

    Consider the input of end users when making elimination and consolidation decisions and communicate IT's justification for each end user's argument to keep their desktop printers.

    "I don't trust network storage. I want physical copies." Explain the security and benefits of content management systems.
    "I use my desktop a lot. I need it." Explain the cost benefits of printing on cheaper network MFPs, especially if they print in large quantities.
    "I don't use it a lot, so it's not costly." It's a waste of money to maintain and power underused devices.
    "I need security and confidentiality." MFPs have biometric and password-release functions, which add an increased layer of security.
    "I need to be able to print from home." Print drivers and networked home printers can be insecure devices and attack vectors.
    "I don't have time to wait." Print jobs in queue can be released when users are at the device.
    "I don't want to walk that far." Tell the end user how many feet the device will be within (e.g. 50 feet). It is not usually very far.

    Implement a continual improvement plan to achieve long-term enterprise print goals

    Implement a continual improvement plan for enterprise printing:

    • Develop a vendor management plan:
      • In order to govern SLAs and manage the vendor, ensure that you can track printer-related tickets even if the device is now supported by managed print services.
      • Ensure that printer service tickets sent from the device to the vendor are also reconciled in your ITSM tool. Require the MSP to e-bond the ticket created within their own device and ticketing system back to you so you can track it in your own ITSM tool.
      • Every two months, validate service credits that can be returned to the vendor for exceeding SLA performance metrics.
      • Monitor the impact of their digital transformation strategies. Develop a cadence to review the vendor's suggestions for innovation opportunities.
    • Operate, validate, and distribute usage and experience metrics/chargeback to stakeholders.
    • Monitor and analyze trends in company printing.
    This is a graph which demonstrates the process of continual improvement through Standardization. It depicts a graph with Time as the X axis, and Quality Management as the Y axis. A grey circle with the words: ACT; PLAN; CHECK; DO, moving from the lower left part of the graph to the upper right, showing that standardization improves Quality Management.

    Summary of Accomplishment

    Problem Solved

    You have now re-envisioned your enterprise print environment by documenting your current printer inventory and current cost and usage. You also have hard inventory and usage data benchmarks that you can use to measure the success of future initiatives around digitalization, going paperless, and reducing print cost.

    You have also developed a plan to go to market and become a consumer of managed print services, rather than a provider yourself. You have established a reusable RFP and requirements framework to engage a managed print services vendor who will work with you to support your continuous improvement plans.

    Return to the deliverables and advice in this blueprint to reinforce the organization's message to end users on when, where, and how to print. Ideally, this project has helped you go beyond a printer refresh – but rather served as a means to change the printing culture at your organization.

    If you would like additional support, have our analysts guide you through other phases as part of an Info-Tech workshop.

    Contact your account representative for more information

    workshops@infotech.com
    1-888-670-8889

    Bibliography

    Fernandes, Louella. "Quocirca Managed Services Print Market, 2021." Quocirca, 25 Mar. 2021. Accessed 12 Oct. 2021.

    McInnes, Angela. "No More Photocopies, No More Ink: Thames Valley Schools Run Out of Toner." CBC, 21 Oct. 2021. Web.

    "Paper and Paperboard: Material-Specific Data." EPA, 15 Dec. 2020. Accessed 15 Oct. 2021.

    State of Washington, House of Representatives. "State Agencies – Paper Conservation and Recycling." 61st Legislature, Substitute House Bill 2287, Passed 20 April 2009.

    Sugihara, Azusa. "Pandemic Shreds Office Paper Demand as Global Telework Unfolds." Nikkei Asia, 18 July 2020. Accessed 29 Sept. 2021.

    "Paper Reduction." University of Washington, n.d. Accessed 28 Oct. 2021.

    "What is MPS?" University of Washington, n.d. Accessed 16 Mar. 2022.

    Research contributors

    Jarrod Brumm
    Senior Digital Transformation Consultant

    Jacques Lirette
    President, Ditech Testing

    3 anonymous contributors

    Info-Tech Research Group Experts

    Allison Kinnaird, Research Director & Research Lead
    Frank Trovato, Research Director

    Reduce Risk With Rock-Solid Service-Level Agreements

    • Buy Link or Shortcode: {j2store}365|cart{/j2store}
    • member rating overall impact: N/A
    • member rating average dollars saved: N/A
    • member rating average days saved: N/A
    • Parent Category Name: Vendor Management
    • Parent Category Link: /vendor-management

    Organizations can struggle to understand what service-level agreements (SLAs) are required and how they can differ depending on the service type. In addition, these other challenges can also cloud an organization’s knowledge of SLAs:

    • No standardized SLAs documents, service levels, or metrics
    • Dealing with lost productivity and revenue due to persistent downtime
    • Not understanding SLAs components and what service levels are required for a particular service
    • How to manage the SLA and hold the vendor accountable

    Our Advice

    Critical Insight

    SLAs need to have clear, easy-to-measure objectives, to meet expectations and service level requirements, including meaningful reporting and remedies to hold the provider accountable to its obligations.

    Impact and Result

    This project will provide several benefits and learnings for almost all IT workers:

    • Better understanding of an SLA framework and required SLA elements
    • Standardized service levels and metrics aligned to the organization’s requirements
    • Reduced time in reviewing, evaluating, and managing service provider SLAs

    Reduce Risk With Rock-Solid Service-Level Agreements Research & Tools

    Start here – Read our Executive Brief

    Understand how to resolve your challenges with SLAs and their components and ensuring adequate metrics. Learn how to create meaningful SLAs that meet your requirements and manage them effectively.

    Besides the small introduction, subscribers and consulting clients within this management domain have access to:

    1. Understand SLA elements – Understand the elements of SLAs, service types, service levels, metrics/KPIs, monitoring, and reporting

    • SLA Checklist
    • SLA Evaluation Tool

    2. Create requirements – Create your own SLA criteria and templates that meet your organization’s requirements

    • SLA Template & Metrics Reference Guide

    3. Manage obligations – Learn the SLA Management Framework to track providers’ performance and adherence to their commitments.

    • SLO Tracker & Trending Tool

    Infographic

    Workshop: Reduce Risk With Rock-Solid Service-Level Agreements

    Workshops offer an easy way to accelerate your project. If you are unable to do the project yourself, and a Guided Implementation isn't enough, we offer low-cost delivery of our project workshops. We take you through every phase of your project and ensure that you have a roadmap in place to complete your project successfully.

    1 Understand the Elements of SLAs

    The Purpose

    Understand key components and elements of an SLA.

    Key Benefits Achieved

    Properly evaluate an SLA for required elements.

    Activities

    1.1 SLA overview, objectives, SLA types, service levels

    1.2 SLA elements and objectives

    1.3 SLA components: monitoring, reporting, and remedies

    1.4 SLA checklist review

    Outputs

    SLA Checklist

    Evaluation Process

    SLA Checklist

    Evaluation Process

    SLA Checklist

    Evaluation Process

    SLA Checklist

    Evaluation Process

    2 Create SLA Criteria and Management Framework

    The Purpose

    Apply knowledge of SLA elements to create internal SLA requirements.

    Key Benefits Achieved

    Templated SLAs that meet requirements.

    Framework to manage SLOs.

    Activities

    2.1 Creating SLA criteria and requirements

    2.2 SLA templates and policy

    2.3 SLA evaluation activity

    2.4 SLA Management Framework

    2.5 SLA monitoring, tracking, and remedy reconciliation

    Outputs

    Internal SLA Management Framework

    Evaluation of current SLAs

    SLA tracking and trending

    Internal SLA Management Framework

    Evaluation of current SLAs

    SLA tracking and trending

    Internal SLA Management Framework

    Evaluation of current SLAs

    SLA tracking and trending

    Internal SLA Management Framework

    Evaluation of current SLAs

    SLA tracking and trending

    Internal SLA Management Framework

    Evaluation of current SLAs

    SLA tracking and trending

    Further reading

    Reduce Risk With Rock-Solid Service-Level Agreements

    Hold Service Providers more accountable to their contractual obligations with meaningful SLA components & remedies

    EXECUTIVE BRIEF

    Analyst Perspective

    Reduce Risk With Rock-Solid Service-Level Agreements

    Every year organizations outsource more and more IT infrastructure to the cloud, and IT operations to managed service providers. This increase in outsourcing presents an increase in risk to the CIO to save on IT spend through outsourcing while maintaining required and expected service levels to internal customers and the organization. Ensuring that the service provider constantly meets their obligations so that the CIO can meet their obligation to the organization can be a constant challenge. This brings forth the importance of the Service Level Agreement.

    Research clearly indicates that there is a general lack of knowledge when comes to understanding the key elements of a Service Level Agreement (SLA). Even less understanding of the importance of the components of Service Levels and the Service Level Objectives (SLO) that service provider needs to meet so that the outsourced service consistently meets requirements of the organization. Most service providers are very good at providing the contracted service and they all are very good at presenting SLOs that are easy to meet with very few or no ramifications if they don’t meet their objectives. IT leaders need to be more resolute in only accepting SLOs that are meaningful to their requirements and have meaningful, proactive reporting and associated remedies to hold service providers accountable to their obligations.

    Ted Walker

    Principal Research Director, Vendor Practice

    Info-Tech Research Group

    Executive Brief

    Vendors provide service level commitments to customers in contracts to show a level of trust, performance, availability, security, and responsiveness in an effort create a sense of confidence that their service or platform will meet your organization’s requirements and expectations. Sifting through these promises can be challenging for many IT Leaders. Customers struggle to understand and evaluate what’s in the SLA – are they meaningful and protect your investment? Not understanding the details of SLAs applicable to various types of Service (SaaS, MSP, Service Desk, DR, ISP) can lead to financial and compliance risk for the organization as well as poor customer satisfaction.

    This project will provide IT leadership the knowledge & tools that will allow them to:

    • Understand what SLAs are and why they need them.
    • Develop standard SLAs that meet the organization’s requirements.
    • Negotiate meaningful remedies aligned to Service Levels metrics or KPIs.
    • Create SLA monitoring & reporting and remedies requirements to hold the provider accountable.

    This research:

    1. Is designed for:
    • The CIO or CFO who needs to better understand their provider’s SLAs.
    • The CIO or BU that could benefit from improved service levels.
    • Vendor management who needs to standardize SLAs for the organization IT leadership that needs consistent service levels to the business
    • The contract manager who needs a better understanding of contact SLAs
  • Will help you:
    • Understand what a Service Level Agreement is and what it’s for
    • Learn what the components are of an SLA and why you need them
    • Create a checklist of required SLA elements for your organization
    • Develop standard SLA template requirements for various service types
    • Learn the importance of SLA management to hold providers accountable
  • Will also assist:
    • Vendor management
    • Procurement and sourcing
    • Organizations that need to understand SLAs within contract language
    • With creating standardized monitoring & reporting requirements
    • Organizations get better position remedies & credits to hold vendors accountable to their commitments
  • Reduce Risk With Rock-Solid Service-Level Agreements (SLAs)

    Hold service providers more accountable to their contractual obligations with meaningful SLA components and remedies

    The Problem

    IT Leadership doesn't know how to evaluate an SLA.

    Misunderstanding of obligations given the type of service provided (SAAS, IAAS, DR/BCP, Service Desk)

    Expectations not being met, leading to poor service from the provider.

    No way to hold provider accountable.

    Why it matters

    SLAS are designed to ensure that outsourced IT services meet the requirements and expectations of the organization. Well-written SLAs with all the required elements, metrics, and remedies will allow IT departments to provide the service levels to their customer and avoid financial and contractual risk to the organization.

    The Solution

    1. Understand the key service elements within an SLA
    • Develop a solid understanding of the key elements within an SLA and why they're important.
  • Establish requirements to create SLA criteria
    • Prioritize contractual services and establish concise SLA checklists and performance metrics.
  • Manage SLA obligations to ensure commitments are met
    • Review the five steps for effective SLA management to track provider performance and deal with chronic issues.
  • Service types

    • Availability/Uptime
    • Response Times
    • Resolution Time
    • Accuracy
    • First-Call Resolution

    Agreement Types

    • SaaS/IaaS
    • Service Desk
    • MSP
    • Co-Location
    • DR/BCP
    • Security Ops

    Performance Metrics

    • Reporting
    • Remedies & Credits
    • Monitoring
    • Exclusion

    Example SaaS Provider

    • Response Times ✓
    • Availability/Uptime ✓
    • Resolution Time ✓
    • Update Times ✓
    • Coverage Time ✓
    • Monitoring ✓
    • Reporting ✓
    • Remedies/Credits ✓

    SLA Management Framework

    1. SLO Monitoring
    • SLOs must be monitored by the provider, otherwise they can't be measured.
  • Concise Reporting
    • This is the key element for the provider to validate their performance.
  • Attainment Tracking
    • Capturing SLO metric attainment provides performance trending for each provider.
  • Score carding
    • Tracking details provide input into overall vendor performance ratings.
  • Remedy Reconciliation
    • From SLO tracking, missed SLOs and associated credits needs to be actioned and consumed.
  • Executive Summary

    Your Challenge

    To understand which SLAs are required for your organization and how they can differ depending on the service type. In addition, these other challenges can also cloud your knowledge of SLAs

    • No standardized SLA documents, Service levels, or metrics
    • Dealing with lost productivity & revenue due to persistent downtime
    • Understanding SLA components and what service levels are requires for a particular service
    • How to manage the SLA and hold the vendor accountable

    Common Obstacles

    There are several unknowns that SLA can present to different departments within the organization:

    • Little knowledge of what service levels are required
    • Not knowing SLO standards for a service type
    • Lack of resources to manage vendor obligations
    • Negotiating required metrics/KPIs with the provider
    • Low understanding of the risk that poor SLAs can present to the organization

    Info-Tech's Approach

    Info-Tech has a three-step approach to effective SLAs

    • Understand the elements of an SLA
    • Create Requirements for your organization
    • Manage the SLA obligations

    There are some basic components that every SLA should have – most don’t have half of what is required

    Info-Tech Insight

    SLAs need to have clear, easy to measure objectives to meet your expectations and service level requirements, including meaningful reporting and remedies to hold the provider accountable to their obligations.

    Your challenge

    This research is designed to help organizations gain a better understanding of what an SLA is, understand the importance of SLAs in IT contracts, and ensure organizations are provided with rock-solid SLAs that meet their requirements and not just what the vendor wants to provide.

    • Vendors can make SLAs weak and difficult to understand; sometimes the metrics are meaningless. Not fully understanding what makes up a good SLA can bring unknown risks to the organization.
    • Managing vendor SLA obligations effectively is important. Are adequate resources available? Does the vendor provide manual vs. automated processes and which do you need? Is the process proactive from the vendor or reactive from the customer?

    SLAs come in many variations and for many service types. Understanding what needs to be in them is one of the keys to reducing risk to your organization.

    “One of the biggest mistakes an IT leader can make is ignoring the ‘A’ in SLA,” adds Wendy M. Pfeiffer, CIO at Nutanix. “

    An agreement isn’t a one-sided declaration of IT capabilities, nor is it a one-sided demand of business requirements,” she says. “An agreement involves creating a shared understanding of desired service delivery and quality, calculating costs related to expectations, and then agreeing to outcomes in exchange for investment.” (15 SLA mistakes IT leaders still make | CIO)

    Common obstacles

    There are typically a lot of unknowns when it comes to SLAs and how to manage them.

    Most organizations don’t have a full understanding of what SLAs they require and how to ensure they are met by the vendor. Other obstacles that SLAs can present are:

    • Inadequate resources to create and manage SLAs
    • Poor awareness of standard or required SLA metrics/KPIs
    • Lack of knowledge about each provider’s commitment as well as your obligations
    • Low vendor willingness to provide or negotiate meaningful SLAs and credits
    • The know-how or resources to effectively monitor and manage the SLA’s performance

    SLAs need to address your requirements

    55% of businesses do not find all of their service desk metrics useful or valuable (Freshservice.com)

    27% of businesses spend four to seven hours a month collating metric reports (Freshservice.com)

    Executive Summary

    Info-Tech’s Approach

    • Understand the elements of an SLA
      • Availability
      • Monitoring
      • Response Times
      • SLO Calculation
      • Resolution Time
      • Reporting
      • Milestones
      • Exclusions
      • Accuracy
      • Remedies & Credits
    • Create standard SLA requirements and criteria
      • SLA Element Checklist
      • Corporate Requirements and Standards
      • SLA Templates and Policy
    • Effectively Manage the SLA Obligations
      • SLA Management Framework
        • SLO Monitoring
        • Concise Reporting
        • Attainment Tracking
        • Score Carding
        • Remedy Reconciliation

    Info-Tech’s three phase approach

    Reduce Risk With Rock-Solid Service-Level Agreements

    Phase 1

    Understand SLA Elements

    Phase Content:

    • 1.1 What are SLAs, types of SLAs, and why are they needed?
    • 1.2 Elements of an SLA
    • 1.3 Obligation management monitoring, Reporting requirements
    • 1.4 Exclusions
    • 1.5 SLAs vs. SLOs vs. SLIs

    Outcome:

    This phase will present you with an understanding of the elements of an SLA: What they are, why you need them, and how to validate them.

    Phase 2

    Create Requirements

    Phase Content:

    • 2.1 Create a list of your SLA criteria
    • 2.2 Develop SLA policy & templates
    • 2.3 Create a negotiation strategy
    • 2.4 SLA Overachieving discussion

    Outcome:

    This phase will leverage knowledge gained in Phase 1 and guide you through the creation of SLA requirements, criteria, and templates to ensure that providers meet the service level obligations needed for various service types to meet your organization’s service expectations.

    Phase 3

    Manage Obligations

    Phase Content:

    • 3.1 SLA Monitoring, Tracking
    • 3.2 Reporting
    • 3.3 Vendor SLA Reviews & Optimizing
    • 3.4 Performance management

    Outcome:

    This phase will provide you with an SLA management framework and the best practices that will allow you to effectively manage service providers and their SLA obligations.

    Insight summary

    Overarching insight

    SLAs need to have clear, easy-to-measure objectives to meet your expectations and service level requirements, including meaningful reporting and remedies to hold the provider accountable to their obligations.

    Phase 1 insight

    Not understanding the required elements of an SLA and not having meaningful remedies to hold service providers accountable to their obligations can present several risk factors to your organization.

    Phase 2 insight

    Creating standard SLA criteria for your organization’s service providers will ensure consistent service levels for your business units and customers.

    Phase 3 insight

    SLAs can have appropriate SLOs and remedies but without effective management processes they could become meaningless.

    Tactical insight

    Be sure to set SLAs that are easily measurable from regularly accessible data and that are straight forward to interpret.

    Tactical insight

    Beware of low, easy to attain service levels and metrics/KPIs. Service levels need to meet your expectations and needs not the vendor’s.

    Blueprint deliverables

    Each step of this blueprint is accompanied by supporting deliverables to help you accomplish your goals:

    SLA Tracker & Trending Tool

    Track the provider’s SLO attainment and see how their performance is trending over time

    SLA Evaluation Tool

    Evaluate SLA service levels, metrics, credit values, reporting, and other elements

    SLA Template & Metrics Reference Guide

    Reference guide for typical SLA metrics with a generic SLA Template

    Service-Level Agreement Checklist

    Complete SLA component checklist for core SLA and contractual elements.

    Key deliverable:

    Service-Level Agreement Evaluation Tool

    Evaluate each component of the SLA , including service levels, metrics, credit values, reporting, and processes to meet your requirements

    Blueprint objectives

    Understand the components of an SLA and effectively manage their obligations

    • To provide an understanding of different types of SLAs, their required elements, and what they mean to your organization. How to identify meaningful service levels based on service types. We will break down the elements of the SLA such as service types and define service levels such as response times, availability, accuracy, and associated metrics or KPIs to ensure they are concise and easy to measure.
    • To show how important it is that all metrics have remedies to hold the service provider accountable to their SLA obligations.

    Once you have this knowledge you will be able to create and negotiate SLA requirements to meet your organization’s needs and then manage them effectively throughout the term of the agreement.

    InfoTech Insight:

    Right-size your requirements and create your SLO criteria based on risk mitigation and create measurements that motivate the desired behavior from the SLA.

    Blueprint benefits

    IT Benefits

    • An understanding of standard SLA service levels and metrics
    • Reduced financial risk through clear and concise easy-to-measure metrics and KPIs
    • Improved SLA commitments from the service provider
    • Meaningful reporting and remedies to hold the provider accountable
    • Service levels and metrics that meet your requirements to support your customers

    Business Benefits

    • Better understanding of an SLA framework and required SLA elements
    • Improved vendor performance
    • Standardized service levels and metrics aligned to your organization’s requirements
    • Reduced time in reviewing and comprehending vendor SLAs
    • Consistent performance from your service providers

    Measure the value of this blueprint

    1. Dollars Saved
    • Improved performance from your service provider
    • Reduced financial risk through meaningful service levels & remedies
    • Dollars gained through:
      • Reconciled credits from obligation tracking and management
      • Savings due to automated processes
  • Time Saved
    • Reduced time in creating effective SLAs through requirement templates
    • Time spent tracking and managing SLA obligations
    • Reduced negotiation time
    • Time spent tracking and reconciling credits
  • Knowledge Gained
    • Understanding of SLA elements, service levels, service types, reporting, and remedies
    • Standard metrics and KPIs required for various service types and levels
    • How to effectively manage the service provider obligations
    • Tactics to negotiate appropriate service levels to meet your requirements
  • Info-Tech offers various levels of support to best suit your needs

    DIY Toolkit

    "Our team has already made this critical project a priority, and we have the time and capability, but some guidance along the way would be helpful."

    Guided Implementation

    "Our team knows that we need to fix a process, but we need assistance to determine where to focus. Some check-ins along the way wound help keep us on track."

    Workshop

    "We need to hit the ground running and get this project kicked off immediately. Our team has the ability to take this over once we get a framework and strategy in place."

    Consulting

    "Our team does not have the time or the knowledge to take this project on. We need assistance through the entirety of this project."

    Diagnostics and consistent frameworks are used throughout all four options.

    Guided Implementation

    What does a typical GI on this topic look like?

    A Guided Implementation (GI) is a series of calls with an Info-Tech analyst to help implement our best practices in your organization.

    A typical GI is between three to six calls over the course of two to three months.

    Phase 1 - Understand

    • Call #1: Scope requirements, objectives, and your specific SLA challenges

    Phase 2 - Create Requirements

    • Call #2: Review key SLA and how to identify them
    • Call #3: Deep dive into SLA elements and why you need them
    • Call #4: Review your service types and SLA criteria
    • Call #5: Create internal SLA requirements and templates

    Phase 3 - Management

    • Call #6: Review SLA Management Framework
    • Call #7: Review and create SLA Reporting and Tracking

    Workshop Overview

    Contact your account representative for more information.

    workshops@infotech.com 1-888-670-8889

    Day 1 Day 2
    Understanding SLAs SLA Templating & Management
    Activities

    1.1 SLA overview, objectives, SLA types, service levels

    1.2 SLA elements and objectives

    1.3 SLA components – monitoring, reporting, remedies

    1.4 SLA Checklist review

    2.1 Creating SLA criteria and requirements

    2.2 SLA policy & template

    2.3 SLA evaluation activity

    2.4 SLA management framework

    2.5 SLA monitoring, tracking, remedy reconciliation

    Deliverables
    1. SLA Checklist
    2. SLA policy & template creation
    3. SLA management gap analysis
    1. Evaluation of current SLAs
    2. SLA tracking and trending
    3. Create internal SLA management framework

    Reduce Risk With Rock-Solid Service-Level Agreements

    Phase 1

    Phase 1

    Understand SLA Elements

    Phase Steps

    • 1.1 What are SLAs, the types of SLAs, and why are they needed?
    • 1.2 Elements of an SLA
    • 1.3 Obligation management monitoring, Reporting requirements
    • 1.4 Exclusions and exceptions
    • 1.5 SLAs vs. SLOs vs. SLIs

    Create Requirements

    Manage Obligations

    1.1 What are SLAs, the types of SLAs, and why are they needed?

    SLA Overview

    What is a Service Level Agreement?

    An SLA is an overarching contractual agreement between a service provider and a customer (can be external or internal) that describes the services that will be delivered by the provider. It describes the service levels and associated performance metrics and expectations, how the provider will show it has attained the SLAs, and defines any remedies or credits that would apply if the provider fails to meet its commitments. Some SLAs also include a change or revision process.

    SLAs come in a few forms. Some are unique, separate, standalone documents that define the service types and levels in more detail and is customized to your needs. Some are separate documents that apply to a service and are web posted or linked to an MSA or SSA. The most common is to have them embedded in, or as an appendix to an MSA or SSA. When negotiating an MSA it’s generally more effective to negotiate better service levels and metrics at the same time.

    Objectives of an SLA

    To be effective, SLAs need to have clearly described objectives that define the service type(s) that the service provider will perform, along with commitment to associated measurable metrics or KPIs that are sufficient to meet your expectations. The goal of these service levels and metrics is to ensure that the service provider is committed to providing the service that you require, and to allow you to maintain service levels to your customers whether internal or external.

    1.1 What are SLAs, the types of SLAs, and why are they needed?

    Key Elements of an SLA

    Principle service elements of an SLA

    There are several more common service-related elements of an SLA. These generally include:

    • The Agreement – the document that defines service levels and commitments.
    • The service types – the type of service being provided by the vendor. These can include SaaS, MSP, Service Desk, Telecom/network, PaaS, Co-Lo, BCP, etc.
    • The service levels – these are the measurable performance objectives of the SLA. They include availability (uptime), response times, restore times, priority level, accuracy level, resolution times, event prevention, completion time, etc.
    • Metrics/KPIs – These are the targets or commitments associated to the service level that the service provider is obligated to meet.
    • Other elements – Reporting requirements, monitoring, remedies/credit values and process.

    Contractual Construct Elements

    These are construct components of an SLA that outline their roles and responsibilities, T&Cs, escalation process, etc.

    In addition, there are several contractual-type elements including, but not limited to:

    • A statement regarding the purpose of the SLA.
    • A list of services being supplied (service types).
    • An in-depth description of how services will be provided and when.
    • Vendor and customer requirements.
    • Vendor and customer obligations.
    • Acknowledgment/acceptance of the SLA.
    • They also list each party’s responsibilities and how issues will be escalated and resolved.

    Common types of SLAs explained

    Service-level SLA

    • This service-level agreement construct is the Service-based SLA. This SLA covers an identified service for all customers in general (for example, if an IT service provider offers customer response times for a service to several customers). In a service-based agreement, the response times would be the same and apply to all customers using the service. Any customer using the service would be provided the same SLA – in this case the same defined response time.

    Customer-based SLA

    • A customer-based SLA is a unique agreement with one customer. The entire agreement is defined for one or all service levels provided to a particular customer (for example, you may use several services from one telecom vendor). The SLAs for these services would be covered in one contract between you and the vendor, creating a unique customer-based vendor agreement. Another scenario could be where a vendor offers general SLAs for its services but you negotiate a specific SLA for a particular service that is unique or exclusive to you. This would be a customer-based SLA as well.

    Multi-level SLA

    • This service-level agreement construct is the multi-level SLA. In a multi-level SLA, components are defined to the organizational levels of the customer with cascading coverage to sublevels of the organization. The SLA typically entails all services and is designed to the cover each sub-level or department within the organization. Sometimes the multi-level SLA is known as a master organization SLA as it cascades to several levels of the organization.

    InfoTech Insight: Beware of low, easy to attain Service levels and metrics/KPIs. Service levels need to meet your requirements, expectations, and needs not the vendor’s.

    1.2 Elements of SLA-objectives, service types, and service levels

    Objectives of Service Levels

    The objective of the service levels and service credits are to:

    • Ensure that the services are of a consistently high quality and meet the requirements of the customer
    • Provide a mechanism whereby the customer can attain meaningful recognition of the vendors failure to deliver the level of service for which it was contracted to deliver
    • Incentivize the vendor or service provider to comply with and to expeditiously provide a remedy for any failure to attain the service levels committed to in the SLA
    • To ensure that the service provider fulfills the defined objectives of the outsourced service

    Service types

    There are several service types that can be part of an SLA. Service types are the different nature of services associated with the SLA that the provider is performing and being measured against. These can include:

    Service Desk, SaaS, PaaS, IaaS, ISP/Telecom/Network MSP, DR & BCP, Co-location security ops, SOW.

    Each service type should have standard service level targets or obligations that can vary depending on your requirements and reliance on the service being provided.

    Service levels

    Service levels are measurable targets, metrics, or KPIs that the service provider has committed to for the particular service type. Service levels are the key element of SLAs – they are the performance expectations set between you and the provider. The service performance of the provider is measured against the service level commitments. The ability of the provider to consistently meet these metrics will allow your organization to fully benefit from the objectives of the service and associated SLAs. Most service levels are time related but not all are.

    Common service levels are:

    Response times, resolution times per percent, restore/recovery times, accuracy, availability/uptime, completion/milestones, updating/communication, latency.

    Each service level has standard or minimum metrics for the provider. The metrics, or KPIs, should be relatively easy to measure and report against on a regular basis. Service levels are generally negotiable to meet your requirements.

    1.2.1 Activity SLA Checklist Tool

    1-2 hours

    Input

    • SLA content, Service elements
    • Contract terms & exclusions
    • Service metrices/KPIs

    Output

    • A concise list of SLA components
    • A list of missing SLA elements
    • Evaluation of the SLA

    Materials

    • Comprehensive checklist
    • Service provider SLA
    • Internal templates or policies

    Participants

    • Vendor or contract manager
    • IT or business unit manager
    • Legal
    • Finance

    Using this checklist will help you review a provider’s SLA to ensure it contains adequate service levels and remedies as well as contract-type elements.

    Instructions:

    Use the checklist to identify the principal service level elements as well as the contractual-type elements within the SLA.

    Review the SLA and use the dropdowns in the checklist to verify if the element is in the SLA and whether it is within acceptable parameters as well the page or section for reference.

    The checklist contains a list of service types that can be used for reference of what SLA elements you should expect to see in that service type SLA.

    Download the SLA Checklist Tool

    1.3 Monitoring, reporting requirements, remedies/credit process

    Monitoring & Reporting

    As mentioned, well-defined service levels are key to the success of the SLA. Validating that the metrics/KPIs are being met on a consistent basis requires regular monitoring and reporting. These elements of the SLA are how you hold the provider accountable to the SLA commitments and obligations. To achieve the service level, the service must be monitored to validate that timelines are met and accuracy is achieved.

    • Data or details from monitoring must then be presented in a report and delivered to the customer in an agreed-upon format. These formats can be in a dashboard, portal, spreadsheet, or csv file, and they must have sufficient criteria to validate the service-level metric. Reports should be kept for future review and to create historical trending.
    • Monitoring and reporting should be the responsibility of the service provider. This is the only way that they can validate to the customer that a service level has been achieved.
    • Reporting criteria and delivery timelines should be defined in the SLA and can even have a service level associated with it, such as a scheduled report delivery on the fifth day of the following month.
    • Reports need to be checked and balanced. When defining report criteria, be sure to define data source(s) that can be easily validated by both parties.
    • Report criteria should include compliance requirements, target metric/KPIs, and whether they were attained.
    • The report should identify any attainment shortfall or missed KPIs.

    Too many SLAs do not have these elements as often the provider tries to put the onus on the customer to monitor their performance of the service levels. .

    1.3.1 Monitoring, reporting requirements, remedies/credit process

    Remedies and Credits

    Service-level reports validate the performance of the service provider to the SLA metrics or KPIs. If the metrics are met, then by rights, the service provider is doing its job and performing up to expectations of the SLA and your organization.

    • What if the metrics are not being met either periodically or consistently? Solving this is the goal of remedies. Remedies are typically monetary costs (in some form) to the provider that they must pay for not meeting a service-level commitment. Credits can vary significantly and should be aligned to the severity of the missed service level. Sometimes there no credits offered by the vendor. This is a red flag in an SLA.
    • Typically expressed as a monetary credit, the SLA will have service levels and associated credits if the service-level metric/KPI is not met during the reporting period. Credits can be expressed in a dollar format, often defined as a percentage of a monthly fee or prorated annual fee. Although less common, some SLAs offer non-financial credits. These could include: an extension to service term, additional modules, training credits, access to a higher support level, etc.
    • Regardless of how the credit is presented, this is typically the only way to hold your provider accountable to their commitments and to ensure they perform consistently to expectations. You must do a rough calculation to validate the potential monetary value and if the credit is meaningful enough to the provider.

    Research shows that credit values that equate to just a few dollars, when you are paying the provider tens of thousands of dollars a month for a service or product, the credit is insignificant and therefore doesn’t incent the provider to achieve or maintain a service level.

    1.3.2 Monitoring, reporting requirements, remedies/credit process

    Credit Process

    Along with meaningful credit values, there must be a defined credit calculation method and credit redemption process in the SLA.

    Credit calculation. The credit calculation should be simple and straight forward. Many times, we see providers define complicated methods of calculating the credit value. In some cases complicated service levels require higher effort to monitor and report on, but this shouldn’t mean that the credit for missing the service level needs to require the same effort to calculate. Do a sample credit calculation to validate if the potential credit value is meaningful enough or meets your requirements.

    Credit redemption process. The SLA should define the process of how a credit is provided to the customer. Ideally the process should be fairly automated by the service provider. If the report shows a missed service level, that should trigger a credit calculation and credit value posted to account followed by notification. In many SLAs that we review, the credit process is either poorly defined or not defined at all. When it is defined, the process typically requires the customer to follow an onerous process and submit a credit request that must then be validated by the provider and then, if approved, posted to your account to be applied at year end as long as you are in complete compliance with the agreement and up-to-date on your account etc. This is what we need to avoid in provider-written SLAs. You need a proactive process where the service provider takes responsibility for missing an SLA and automatically assigns an accurate credit to your account with an email notice.

    Secondary level remedies. These are remedies for partial performance. For example, the platform is accessible but some major modules are not working (i.e.: the payroll platform is up and running and accessible but the tax table is not working properly so you can’t complete your payroll run on-time). Consider the requirement of a service level, metric, and remedy for critical components of a service and not just the platform availability.

    Info-Tech Insight SLA’s without adequate remedies to hold the vendor accountable to their commitments make the SLAs essentially meaningless.

    1.4 Exclusions indemnification, force majeure, scheduled maintenance

    Contract-Related Exclusions

    Attaining service-level commitments by the provider within an SLA can depend on other factors that could greatly influence their performance to service levels. Most of these other factors are common and should be defined in the SLA as exclusions or exceptions. Exceptions/exclusions can typically apply to credit calculations as well. Typical exceptions to attaining service levels are:

    • Denial of Service (DoS) attacks
    • Communication/ISP outage
    • Outages of third-party hosting
    • Actions or inactions of the client or third parties
    • Scheduled maintenance but not emergency maintenance
    • Force majeure events which can cover several different scenarios

    Attention should be taken to review the exceptions to ensure they are in fact not within the reasonable control of the provider. Many times the provider will list several exclusions. Often these are not reasonable or can be avoided, and in most cases, they allow the service provider the opportunity to show unjustified service-level achievements. These should be negotiated out of the SLA.

    1.5 Activity SLA Evaluation Tool

    1-2 hours

    Input

    • SLA content
    • SLA elements
    • SLA objectives
    • SLO calculation methods

    Output

    • Rating of the SLA service levels and objectives
    • Overall rating of the SLA content
    • Targeted list of required improvements

    Materials

    • SLA comprehensive checklist
    • Service provider SLA

    Participants

    • Vendor or contract manager
    • IT manager or leadership
    • Application or business unit manager

    The SLA Evaluation Tool will allow you evaluate an SLA for content. Enter details into the tool and evaluate the service levels and SLA elements and components to ensure the agreement contains adequate SLOs to meet your organization’s service requirements.

    Instructions:

    Review and identify SLA elements within the service provider’s SLA.

    Enter service-level details into the tool and rate the SLOs.

    Enter service elements details, validate that all required elements are in the SLA, and rate them accordingly.

    Capture and evaluate service-level SLO calculations.

    Review the overall rating for the SLA and create a targeted list for improvements with the service provider.

    Download the SLA Evaluation Tool

    1.5 Clarification: SLAs vs. SLOs vs. SLIs

    SLA – Service-Level Agreement The promise or commitment

    • This is the formal agreement between you and your service provider that contains their service levels and obligations with measurable metrics/KPIs and associated remedies. SLAs can be a separate or unique document, but are most commonly embedded within an MSA, SOW, SaaS, etc. as an addendum or exhibit.

    SLO – Service-Level Objective The goals or targets

    • This service-level agreement construct is the customer-based SLA. A Customer-based SLA is a unique agreement with one customer. The entire agreement is defined for one or all service levels provided to a particular customer. For example, you may use several services from one telecom vendor. The SLAs for these services would be covered in one contract between you and the Telco vendor, creating a unique customer-based to vendor agreement. Another scenario: a vendor offers general SLAs for its services and you negotiate a specific SLA for a particular service that is unique or exclusive to you. This would be a customer-based SLA as well.

    Other common names are Metrics and Key Performance Indicators (KPIs )

    SLI – Service-Level Indicator How did we do? Did we achieve the objectives?

    • An SLI is the actual metric attained after the measurement period. SLI measures compliance with an SLO (service level objective). So, for example, if your SLA specifies that your systems will be available 99.95% of the time, your SLO is 99.95% uptime and your SLI is the actual measurement of your uptime. Maybe it’s 99.96%. maybe 99.99% or even 99.75% For the vendor to be compliant to the SLA, the SLI(s) must meet or exceed the SLOs within the SLA document.

    Other common names: attainment, results, actual

    Info-Tech Insight:

    Web-posted SLAs that are not embedded within a signed MSA, can present uncertainty and risk as they can change at any time and typically without direct notice to the customer

    Reduce Risk With Rock-Solid Service-Level Agreements

    Phase 2

    Understand SLA Elements

    Phase 2

    Create Requirements

    Phase Steps

    • 2.1 Create a list of your SLA criteria
    • 2.2 Develop SLA policy & templates
    • 2.3 Create a negotiation strategy
    • 2.4 SLA overachieving discussion

    Manage Obligations

    2.1 Create a list of your SLA criteria

    Principle Service Elements

    With your understanding of the types of SLAs and the elements that comprise a well-written agreement

    • The next step is to start to create a set of SLA criteria for service types that your organization outsources or may require in the future.
    • This criteria should define the elements of the SLA with tolerance levels that will require the provider to meet your service expectations.
    • Service levels, metrics/KPIs, associated remedies and reporting criteria. This criteria could be captured into table-like templates that can be referenced or inserted into service provider SLAs.
    • Once you have defined minimum service-level criteria, we recommend that you do a deeper review of the various service provider types that your organization has in place. The goal of the review is to understand the objective of the service type and associated service levels and then compare them to your requirements for the service to meet your expectations. Service levels and KPIs should be no less than if your IT department was providing the service with its own resources and infrastructure.
    • Most IT departments have service levels that they are required to meet with their infrastructure to the business units or organization, whether it’s App delivery, issue or problem resolution, availability etc. When any of these services are outsourced to an external service provider, you need to make all efforts to ensure that the service levels are equal to or better than the previous or existing internal expectations.
    • Additionally, the goal is to identify service levels and metrics that don’t meet your requirements or expectations and/or service levels that are missing.

    2.2 Develop SLA policies and templates

    Contract-type Elements

    After creating templates for minimum-service metrics & KPIs, reporting criteria templates, process, and timing, the next step should be to work on contract-type elements and additional service-level components. These elements should include:

    • Reporting format, criteria, and timelines
    • Monitoring requirements
    • Minimum acceptable remedy or credits process; proactive by provider vs. reactive by customer
    • Roles & responsibilities
    • Acceptable exclusion details
    • Termination language for persistent failure to meet SLOs

    These templates or criteria minimums can be used as guidelines or policy when creating or negotiating SLAs with a service provider.

    Start your initial element templates for your strategic vendors and most common service types: SaaS, IaaS, Service Desk, SecOps, etc. The goal of SLA templates is to create simple minimum guidelines for service levels that will allow you to meet your internal SLAs and expectations. Having SLA templates will show the service provider that you understand your requirements and may put you in a better negotiating position when reviewing with the provider.

    When considering SLO metrics or KPIs consider the SMART guidance:

    Simple: A KPI should be easy to measure. It should not be complicated, and the purpose behind recording it must be documented and communicated.

    Measurable: A KPI that cannot be measured will not help in the decision-making process. The selected KPIs must be measurable, whether qualitatively or quantitatively. The procedure for measuring the KPIs must be consistent and well-defined.

    Actionable: KPIs should contribute to the decision-making process of your organization. A KPI that does not make any such contributions serves no purpose.

    Relevant: KPIs must be related to operations or functions that a security team seeks to assess.

    Time-based: KPIs should be flexible enough to demonstrate changes over time. In a practical sense, an ideal KPI can be grouped together by different time intervals.

    (Guide for Security Operations Metrics)

    2.2.1 Activity: Review SLA Template & Metrics Reference Guide

    1-2 hours

    Input

    • Service level metrics
    • List of who is accountable for PPM decisions

    Output

    • SLO templates for service types
    • SLA criteria that meets your organization’s requirements

    Materials

    • SLA Checklist
    • SLA criteria list with SLO & credit values
    • PPM Decision Review Workbook

    Participants

    • Vendor manager
    • IT leadership
    • Procurement or contract manager
    1. Review the SLA Template and Metrics Reference Guide for common metrics & KPIs for the various service types. Each Service Type tab has SLA elements and SLO metrics typically associated with the type of service.
    2. Some service levels have common or standard credits* that are typically associated with the service level or metric.
    3. Use the SLA Template to enter service levels, metrics, and credits that meet your organization’s criteria or requirements for a given service type.

    Download the SLA Template & Metrics Reference Guide

    *Credit values are not standard values, rather general ranges that our research shows to be the typical ranges that credit values should be for a given missed service level

    2.3 Create a negotiation strategy

    Once you have created service-level element criteria templates for your organization’s requirements, it’s time to document a negotiation position or strategy to use when negotiating with service providers. Not all providers are flexible with their SLA commitments, in fact most are reluctant to change or create “unique” SLOs for individual customers. Particularly cloud vendors providing IaaS, SaaS, or PaaS, SLAs. ISP/Telcom, Co-Lo and DR/BU providers also have standard SLOs that they don’t like to stray far from. On the other hand, security ops (SIEM), service desk, hardware, and SOW/PS providers who are generally contracted to provide variable services are somewhat more flexible with their SLAs and more willing to meet your requirements.

    • Service providers want to avoid being held accountable to SLOs, and their SLAs are typically written to reflect that.

    The goal of creating internal SLA templates and policies is to set a minimum baseline of service levels that your organization is willing to accept, and that will meet their requirements and expectations for the outsourced service. Using these templated SLOs will set the basis for negotiating the entire SLA with the provider. You can set the SLA purpose, objectives, roles, and responsibilities and then achieve these from the service provider with solid SLOs and associated reporting and remedies.

    Info-Tech Insight

    Web-posted SLAs that are not embedded within a signed MSA can present uncertainty and risk as they can change at any time and typically without direct notice to the customer

    2.3.1 Negotiating strategy guidance

    • Be prepared. Create a negotiating plan and put together a team that understands your organization’s requirements for SLA.
    • Stay informed. Request provider’s recent performance data and negotiate SLOs to the provider’s average performance.
    • Know what you need. Corporate SLA templates or policies should be positioned to service providers as baseline minimums.
    • Show some flexibility. Be willing to give up some ground on one SLO in exchange for acceptance of SLOs that may be more important to your organization.
    • Re-group. Have a fallback position or Plan B. What if the provider can’t or won’t meet your key SLOs? Do you walk?
    • Do your homework. Understand what the typical standard SLOs are for the type of service level.

    2.4 SLO overachieving incentive discussion

    Monitoring & Reporting

    • SLO overachieving metrics are seen in some SLAs where there is a high priority for a service provider to meet and or exceed the SLOs within the SLA. These are not common terms but can be used to improve the overall service levels of a provider. In these scenarios the provider is sometimes rewarded for overachieving on the SLOs, either consistently or on a monthly or quarterly basis. In some cases, it can make financial sense to incent the service provider to overachieve on their commitments. Incentives can drive behaviors and improved performance by the provider that can intern improve the benefits to your organization and therefore justify an incent of some type.
    • Example: You could have an SLO for invoice accuracy. If not achieved, it could cost the vendor if they don’t meet the accuracy metric, however if they were to consistently overachieve the metric it could save accounts payable hours of time in validation and therefore you could pass on some of these measurable savings to the provider.
    • Overachieving incentives can add complexity to the SLA so they need to be easily measurable and simple to manage.
    • Overachieving incentives can also be used in provider performance improvement plans, where a provider might have poor trending attainment and you need to have them improve their performance in a short period of time. Incentives typically will motivate provider improvement and generally will cost much less than replacing the provider.
    • There is another school of thought that you shouldn’t have to pay a provider for doing their job; however, others are of the opinion that incentives or bonuses improve the overall performance of individuals or teams and are therefore worth consideration if both parties benefit from the over performance.

    Reduce Risk With Rock-Solid Service-Level Agreements

    Phase 3

    Understand SLA Elements

    Create Requirements

    Phase 3

    Manage Obligations

    Phase Steps

    • 3.1 SLA monitoring and tracking
    • 3.2 Reporting
    • 3.3 Vendor SLA reviews & optimizing
    • 3.4 Performance management

    3.1 SLA monitoring, tracking, and remedy reconciliation

    The next step to effective SLAs is the management component. It could be fruitless if you were to spend your time and efforts negotiating your required service levels and metrics and don’t have some level of managing the SLA. In that situation you would have no way of knowing if the service provider is attaining their SLOs.

    There are several key elements to effective SLA management:

    • SLO monitoring
    • Simple, concise reporting
    • SLO attainment tracking
    • Score carding & trending
    • Remedy reconciliation

    SLA Management framework

    SLA Monitoring → Concise Reporting → Attainment Tracking → Score Carding →Remedy Reconciliation

    “A shift we’re beginning to see is an increased use of data and process discovery tools to measure SLAs,” says Borowski of West Monroe. “While not pervasive yet, these tools represent an opportunity to identify the most meaningful metrics and objectively measure performance (e.g., cycle time, quality, compliance). When provided by the client, it also eliminates the dependency on provider tools as the source-of-truth for performance data.” – Stephanie Overby

    3.1 SLA management framework

    SLA Performance Management

    • SLA monitoring provides data for SLO reports or dashboards. Reports provide attainment data for tacking over time. Attainment data feeds scorecards and allows for trending analysis. Missed attainment data triggers remedies.
    • All service providers monitor their systems, platforms, tickets, agents, sensors etc. to be able to do their jobs. Therefore, monitoring is readily available from your service provider in some form.
    • One of the key purposes of monitoring is to generate data into internal reports or dashboards that capture the performance metrics of the various services. Therefore, service-level and metric reports are readily available for all of the service levels that a service provider is contracted or engaged to provide.
    • Monitoring and reporting are the key elements that validate how your service provider is meeting its SLA obligations and thus are very important elements of an SLA. SLO report data becomes attainment data once the metric or KPI has been captured.
    • As a component of effective SLA management, this attainment data needs to be tracked/recorded in an easy-to-read format or table over a period of time. Attainment data can then be used to generate scorecards and trending reports for your review both internally and with the provider as required.
    • If attainment data shows that the service provider is meeting their SLA obligations, then the SLA is meeting your requirements and expectations. If on the other hand, attainment data shows that obligations are not being met, then actions must be taken to hold the service provider accountable. The most common method is through remedies that are typically in the form of a credit through a defined process (see Sec. 1.3). Any credits due for missed SLOs should also be tracked and reported to stakeholders and accounting for validation, reconciliation, and collection.

    3.2 Reporting

    Monitoring & Reporting

    • Many SLAs are silent on monitoring and reporting elements and require that the customer, if aware or able, to monitor the providers service levels and attainment and create their own KPI and reports. Then if SLOs are not met there is an arduous process that the customer must go through to request their rightful credit. This manual and reactive method creates all kinds of risk and cost to the customer and they should make all attempts to ensure that the service provider proactively provides SLO/KPI attainment reports on a regular basis.
    • Automated monitoring and reporting is a common task for many IT departments. There is no reason that a service provider can’t send reports proactively in a format that can be easily interpreted by the customer. The ideal state would be to capture KPI report data into a customer’s internal service provider scorecard.
    • Automated or automatic credit posting is another key element that service providers tend to ignore, primarily in hopes that the customer won’t request or go through the trouble of the process. This needs to change. Some large cloud vendors already have automated processes that automatically post a credit to your account if they miss an SLO. This proactive credit process should be at the top of your negotiation checklist. Service providers are avoiding thousands of credit dollars every year based on the design of their credit process. As more customers push back and negotiate more efficient credit processes, vendors will soon start to change and may use it as a differentiator with their service.

    3.2.1 Performance tracking and trending

    What gets measured gets done

    SLO Attainment Tracking

    A primary goal of proactive and automated reporting and credit process is to capture the provider’s attainment data into a tracker or vendor scorecard. These tracking scorecards can easily create status reports and performance trending of service providers, to IT leadership as well as feed QBR agenda content.

    Remedy Reconciliation

    Regardless of how a credit is processed it should be tracked and reconciled with internal stakeholders and accounting to ensure credits are duly applied or received from the provider and in a timely manner. Tracking and reconciliation must also align with your payment terms, whether monthly or annually.

    “While the adage, ‘You can't manage what you don't measure,’ continues to be true, the downside for organizations using metrics is that the provider will change their behavior to maximize their scores on performance benchmarks.” – Rob Lemos

    3.2.1 Activity SLA Tracker and Trending Tool

    1-2 hours setup

    Input

    • SLO metrics/KPIs from the SLA
    • Credit values associated with SLO

    Output

    • Monthly SLO attainment data
    • Credit tracking
    • SLO trending graphs

    Materials

    • Service provider SLO reports
    • Service provider SLA
    • SLO Tracker & Trending Tool

    Participants

    • Contract or vendor managers
    • Application or service managers
    • Service provider

    An important activity in the SLA management framework is to track the provider’s SLO attainment on a monthly or quarterly basis. In addition, if an SLO is missed, an associated credit needs to be tracked and captured. This activity allows you to capture the SLOs from the SLA and track them continually and provide data for trending and review at vendor performance meetings and executive updates.

    Instructions: Enter SLOs from the SLA as applicable.

    Each month, from the provider’s reports or dashboards, enter the SLO metric attainment.

    When an SLO is met, the cell will turn green. If the SLO is missed, the cell will turn red and a corresponding cell in the Credit Tracker will turn green, meaning that a credit needs to be reconciled.

    Use the Trending tab to view trending graphs of key service levels and SLOs.

    Download the SLO Tracker and Trending Tool

    3.3 Vendor SLA reviews and optimizing

    Regular reviews should be done with providers

    Collecting attainment data with scorecards or tracking tools provides summary information on the performance of the service provider to their SLA obligations. This information should be used for regular reviews both internally and with the provider.

    Regular attainment reviews should be used for:

    • Performance trending upward or downward
    • Identifying opportunities to revise or improve SLOs
    • Optimizing SLO and processes
    • Creating a Performance Improvement Plan (PIP) for the service provider

    Some organizations choose to review SLA performance with providers at regular QBRs or at specific SLA review meetings

    This should be determined based on the criticality, risk, and strategic importance of the provider’s service. Providers that provide essential services like ERP, payroll, CRM, HRIS, IaaS etc. should be reviewed much more regularly to ensure that any decline in service is identified early and addressed properly in accordance with the service provider. Negative trending performance should also be documented for consideration at renewal time.

    3.4 Performance management

    Dealing with persistent poor performance and termination

    Service providers that consistently miss key service level metrics or KPIs present financial and security risk to the organization. Poor performance of a service provider reflects directly on the IT leadership and will affect many other business aspects of the organization including:

    • Ability to conduct day-to-day business activities
    • Meet internal obligations and expectations
    • Employee productivity and satisfaction
    • Maintain corporate policies or industry compliance
    • Meet security requirements

    Communication is key. Poor performance of a service provider needs to be dealt with in a timely manner in order to avoid more critical impact of the poor performance. Actions taken with the provider can also vary depending again on the criticality, risk, and strategic importance of the provider’s service.

    Performance reviews should provide the actions required with the goal of:

    • Making the performance problems into opportunities
    • Working with the provider to create a PIP with aggressive timelines and ramifications if not attained
    • Non-renewal or termination consideration, if feasible including provider replacement options, risk, costs, etc.
    • SLA renegotiation or revisions
    • Warning notifications to the service provider with concise issues and ramifications

    To avoid the issues and challenges of dealing with chronic poor performance, consider a Persistent or Chronic Failure clause into the SLA contract language. These clauses can define chronic failure, scenarios, ramifications there of, and defined options for the client including increased credit values, non-monetary remedies, and termination options without liability.

    Info-Tech Insight

    It’s difficult to prevent chronic poor performance but you can certainly track it and deal with it in a way that reduces risk and cost to your organization.

    SLA Hall of Shame

    Crazy service provider SLA content collection

    • Excessive list of unreasonable exclusions
    • Subcontractors’ behavior could be excluded
    • Downtime credit, equal to downtime percent x the MRC
    • Controllable FM events (internal labor issues, health events)
    • Difficult downtime or credit calculations that don’t make sense
    • Credits are not valid if agreement is terminated early or not renewed
    • Customer is not current on their account, SLA or credits do not count/apply
    • Total downtime = to prorated credit value (down 3 hrs = 3/720hrs = 0.4% credit)
    • SLOs don’t apply if customer fails to report the issue or request a trouble ticket
    • Downtime during off hours (overnight) do not count towards availability metrics
    • Different availability commitments based on different support-levels packages
    • Extending the agreement term by the length of downtime as a form of a remedy

    SLA Dos and Don’ts

    Dos

    • Do negotiate SLOs to vendor’s average performance
    • Do strive for automated reporting and credit processes
    • Do right-size and create your SLO criteria based on risk mitigation
    • Do review SLA attainment results with strategic service providers on a regular basis
    • Do ensure that all key elements and components of an SLA are present in the document or appendix

    Don'ts

    • Don’t accept the providers response that “we can’t change the SLOs for you because then we’d have to change them for everyone”
    • Don’t leave SLA preparation to the last minute. Give it priority as you negotiate with the provider
    • Don’t create complex SLAs with numerous service levels and SLOs that need to be reported and managed
    • Don’t aim for absolute perfection. Rather, prioritize which service levels are most important to you for the service

    Summary of Accomplishment

    Problem Solved

    Knowledge Gained

    • Understanding of the elements and components of an SLA
    • A list of SLO metrics aligned to service types that meet your organization’s criteria
    • SLA metric/KPI templates
    • SLA Management process for your provider’s service objectives
    • Reporting and tracking process for performance trending

    Deliverables Completed

    • SLA component and contract element checklist
    • Evaluation or service provider SLAs
    • SLA templates for strategic service types
    • SLA tracker for strategic service providers

    If you would like additional support, have our analysts guide you through other phases as part of an Info-Tech workshop.

    Contact your account representative for more information.

    workshops@infotech.com

    1-888-670-8889

    Related Info-Tech Research

    Improve IT-Business Alignment Through an Internal SLA

    • Understand business requirements, clarify current capabilities, and enable strategies to close service-level gaps.

    Data center Co-location SLA & Service Definition Template

    • In essence, the SLA defines the “product” that is being purchased, permitting the provider to rationalize resources to best meet the needs of varied clients, and permits the buyer to ensure that business requirements are being met.

    Ensure Cloud Security in IaaS, PaaS, and SaaS Environments

    • Keep your information security risks manageable when leveraging the benefits of cloud computing.

    Bibliography

    Henderson, George. “3 Most Common Types of Service Level Agreement (SLA).” Master of Project Academy. N.d. Web.

    “Guide to Security Operations Metrics.” Logsign. Oct 5, 2020. Web.

    Lemos, Rob. “4 lessons from SOC metrics: What your SpecOps team needs to know.” TechBeacon. N.d. Web.

    “Measuring and Making the Most of Service Desk Metrics.” Freshworks. N.d. Web.

    Overby, Stephanie. “15 SLA Mistakes IT Leaders Still Make.” CIO. Jan 21, 2021.

    Build Your Data Quality Program

    • Buy Link or Shortcode: {j2store}127|cart{/j2store}
    • member rating overall impact: 9.1/10 Overall Impact
    • member rating average dollars saved: $40,241 Average $ Saved
    • member rating average days saved: 33 Average Days Saved
    • Parent Category Name: Data Management
    • Parent Category Link: /data-management
    • Experiencing the pitfalls of poor data quality and failing to benefit from good data quality, including:
      • Unreliable data and unfavorable output.
      • Inefficiencies and costly remedies.
      • Dissatisfied stakeholders.
    • The chances of successful decision-making capabilities are hindered with poor data quality.

    Our Advice

    Critical Insight

    • Address the root causes of your data quality issues and form a viable data quality program.
      • Be familiar with your organization’s data environment and business landscape.
      • Prioritize business use cases for data quality fixes.
      • Fix data quality issues at the root cause to ensure proper foundation for your data to flow.
    • It is important to sustain best practices and grow your data quality program.

    Impact and Result

    • Implement a set of data quality initiatives that are aligned with overall business objectives and aimed at addressing data practices and the data itself.
    • Develop a prioritized data quality improvement project roadmap and long-term improvement strategy.
    • Build related practices such as artificial intelligence and analytics with more confidence and less risk after achieving an appropriate level of data quality.

    Build Your Data Quality Program Research & Tools

    Start here – read the Executive Brief

    Read our concise Executive Brief to find out why you should establish a data quality program, review Info-Tech’s methodology, and understand the four ways we can support you in completing this project.

    Besides the small introduction, subscribers and consulting clients within this management domain have access to:

    1. Define your organization’s data environment and business landscape

    Learn about what causes data quality issues, how to measure data quality, what makes a good data quality practice in relation to your data and business environments.

    • Business Capability Map Template

    2. Analyze your priorities for data quality fixes

    Determine your business unit priorities to create data quality improvement projects.

    • Data Quality Problem Statement Template
    • Data Quality Practice Assessment and Project Planning Tool

    3. Establish your organization’s data quality program

    Revisit the root causes of data quality issues and identify the relevant root causes to the highest priority business unit, then determine a strategy for fixing those issues.

    • Data Lineage Diagram Template
    • Data Quality Improvement Plan Template

    4. Grow and sustain your data quality practices

    Identify strategies for continuously monitoring and improving data quality at the organization.

    Infographic

    Workshop: Build Your Data Quality Program

    Workshops offer an easy way to accelerate your project. If you are unable to do the project yourself, and a Guided Implementation isn't enough, we offer low-cost delivery of our project workshops. We take you through every phase of your project and ensure that you have a roadmap in place to complete your project successfully.

    1 Define Your Organization’s Data Environment and Business Landscape

    The Purpose

    Evaluate the maturity of the existing data quality practice and activities.

    Assess how data quality is embedded into related data management practices.

    Envision a target state for the data quality practice.

    Key Benefits Achieved

    Understanding of the current data quality landscape

    Gaps, inefficiencies, and opportunities in the data quality practice are identified

    Target state for the data quality practice is defined

    Activities

    1.1 Explain approach and value proposition

    1.2 Detail business vision, objectives, and drivers

    1.3 Discuss data quality barriers, needs, and principles

    1.4 Assess current enterprise-wide data quality capabilities

    1.5 Identify data quality practice future state

    1.6 Analyze gaps in data quality practice

    Outputs

    Data Quality Management Primer

    Business Capability Map Template

    Data Culture Diagnostic

    Data Quality Diagnostic

    Data Quality Problem Statement Template

    2 Create a Strategy for Data Quality Project 1

    The Purpose

    Define improvement initiatives

    Define a data quality improvement strategy and roadmap

    Key Benefits Achieved

    Improvement initiatives are defined

    Improvement initiatives are evaluated and prioritized to develop an improvement strategy

    A roadmap is defined to depict when and how to tackle the improvement initiatives

    Activities

    2.1 Create business unit prioritization roadmap

    2.2 Develop subject areas project scope

    2.3 By subject area 1 data lineage analysis, root cause analysis, impact assessment, and business analysis

    Outputs

    Business Unit Prioritization Roadmap

    Subject area scope

    Data Lineage Diagram

    3 Create a Strategy for Data Quality Project 2

    The Purpose

    Define improvement initiatives

    Define a data quality improvement strategy and roadmap

    Key Benefits Achieved

    Improvement initiatives are defined

    Improvement initiatives are evaluated and prioritized to develop an improvement strategy

    A roadmap is defined to depict when and how to tackle the improvement initiatives

    Activities

    3.1 Understand how data quality management fits in with the organization’s data governance and data management programs

    3.2 By subject area 2 data lineage analysis, root cause analysis, impact assessment, and business analysis

    Outputs

    Data Lineage Diagram

    Root Cause Analysis

    Impact Analysis

    4 Create a Strategy for Data Quality Project 3

    The Purpose

    Determine a strategy for fixing data quality issues for the highest priority business unit

    Key Benefits Achieved

    Strategy defined for fixing data quality issues for highest priority business unit

    Activities

    4.1 Formulate strategies and actions to achieve data quality practice future state

    4.2 Formulate a data quality resolution plan for the defined subject area

    4.3 By subject area 3 data lineage analysis, root cause analysis, impact assessment, and business analysis

    Outputs

    Data Quality Improvement Plan

    Data Lineage Diagram

    5 Create a Plan for Sustaining Data Quality

    The Purpose

    Plan for continuous improvement in data quality

    Incorporate data quality management into the organization’s existing data management and governance programs

    Key Benefits Achieved

    Sustained and communicated data quality program

    Activities

    5.1 Formulate metrics for continuous tracking of data quality and monitoring the success of the data quality improvement initiative

    5.2 Workshop Debrief with Project Sponsor

    5.3 Meet with project sponsor/manager to discuss results and action items

    5.4 Wrap up outstanding items from the workshop, deliverables expectations, GIs

    Outputs

    Data Quality Practice Improvement Roadmap

    Data Quality Improvement Plan (for defined subject areas)

    Further reading

    Build Your Data Quality Program

    Quality Data Drives Quality Business Decisions

    Executive Brief

    Analyst Perspective

    Get ahead of the data curve by conquering data quality challenges.

    Regardless of the driving business strategy or focus, organizations are turning to data to leverage key insights and help improve the organization’s ability to realize its vision, key goals, and objectives.

    Poor quality data, however, can negatively affect time-to-insight and can undermine an organization’s customer experience efforts, product or service innovation, operational efficiency, or risk and compliance management. If you are looking to draw insights from your data for decision making, the quality of those insights is only as good as the quality of the data feeding or fueling them.

    Improving data quality means having a data quality management practice that is sustainably successful and appropriate to the use of the data, while evolving to keep pace with or get ahead of changing business and data landscapes. It is not a matter of fixing one data set at a time, which is resource and time intensive, but instead identifying where data quality consistently goes off the rails, and creating a program to improve the data processes at the source.

    Crystal Singh

    Research Director, Data and Analytics

    Info-Tech Research Group

    Executive Summary

    Your Challenge

    Your organization is experiencing the pitfalls of poor data quality, including:

    • Unreliable data and unfavorable output.
    • Inefficiencies and costly remedies.
    • Dissatisfied stakeholders.

    Poor data quality hinders successful decision making.

    Common Obstacles

    Not understanding the purpose and execution of data quality causes some disorientation with your data.

    • Failure to realize the importance/value of data quality.
    • Unsure of where to start with data quality.
    • Lack of investment in data quality.

    Organizations tend to adopt a project mentality when it comes to data quality instead of taking the strategic approach that would be all-around more beneficial in the long term.

    Info-Tech’s Approach

    Address the root causes of your data quality issues by forming a viable data quality program.

    • Be familiar with your organization’s data environment and business landscape.
    • Prioritize business use cases for data quality fixes.
    • Fixing data quality issues at the root cause to ensure a proper foundation for your data to flow.

    It is important to sustain best practices and grow your data quality program.

    Info-Tech Insight

    Fix data quality issues as close as possible to the source of data while understanding that business use cases will each have different requirements and expectations from data quality.

    Data is the foundation of your organization’s knowledge

    Data enables your organization to make decisions.

    Reliable data is needed to facilitate data consumers at all levels of the enterprise.

    Insights, knowledge, and information are needed to inform operational, tactical, and strategic decision-making processes. Data and information are needed to manage the business and empower business processes such as billing, customer touchpoints, and fulfillment.

    Raw Data

    Business Information

    Actionable Insights

    Data should be at the foundation of your organization’s evolution. The transformational insights that executives are constantly seeking can be uncovered with a data quality practice that makes high-quality, trustworthy information readily available to the business users who need it.

    98% of companies use data to improve customer experience. (Experian Data Quality, 2019)

    High-Level Data Architecture

    The image is a graphic, which at the top shows different stages of data, and in the lower part of the graphic shows the data processes.

    Build Your Data Quality Program

    1. Data Quality & Data Culture Diagnostics Business Landscape Exercise
    2. Business Strategy & Use Cases
    3. Prioritize Use Cases With Poor Quality

    Info-Tech Insight

    As data is ingested, integrated, and maintained in the various streams of the organization's system and application architecture, there are multiple points where the quality of the data can degrade.

    1. Understand the organization's data culture and data quality environment across the business landscape.
    2. Prioritize business use cases with poor data quality.
    3. For each use case, identify data quality issues and requirements throughout the data pipeline.
    4. Fix data quality issues at the root cause.
    5. As data flow through quality assurance monitoring checkpoints, monitor data to ensure good quality output.

    Insight:

    Proper application of data quality dimensions throughout the data pipeline will result in superior business decisions.

    Data quality issues can occur at any stage of the data flow.

    The image shows the flow of data through various stages: Data Creation; Data Ingestion; Data Accumulation and Engineering; Data Delivery; and Reporting & Analytics. At the bottom, there are two bars: the left one labelled Fix data quality root causes here...; and the right reads: ...to prevent expensive cures here.

    The image is a legend that accompanies the data flow graphic. It indicates that a white and green square icon indicates Data quality dimensions; a red cube indicates a potential point of data quality degradation; the pink square indicates Root cause of poor data quality; and a green flag indicates Quality Assurance Monitoring.

    Prevent the domino effect of poor data quality

    Data is the foundation of decisions made at data-driven organizations.

    Therefore, if there are problems with the organization’s underlying data, this can have a domino effect on many downstream business functions.

    Let’s use an example to illustrate the domino effect of poor data quality.

    Organization X is looking to migrate their data to a single platform, System Y. After the migration, it has become apparent that reports generated from this platform are inconsistent and often seem wrong. What is the effect of this?

    1. Time must be spent on identifying the data quality issues, and often manual data quality fixes are employed. This will extend the time to deliver the project that depends on system Y by X months.
    2. To repair these issues, the business needs to contract two additional resources to complete the unforeseen work. The new resources cost $X each, as well as additional infrastructure and hardware costs.
    3. Now, the strategic objectives of the business are at risk and there is a feeling of mistrust in the new system Y.

    Three key challenges impacting the ability to deliver excellent customer experience

    30% Poor data quality

    30% Method of interaction changing

    30% Legacy systems or lack of new technology

    95% Of organizations indicated that poor data quality undermines business performance.

    (Source: Experian Data Quality, 2019)

    Maintaining quality data will support more informed decisions and strategic insight

    Improving your organization’s data quality will help the business realize the following benefits:

    Data-Driven Decision Making

    Business decisions should be made with a strong rationale. Data can provide insight into key business questions, such as, “How can I provide better customer satisfaction?”

    89% Of CIOs surveyed say lack of quality data is an obstacle to good decision making. (Larry Dignan, CIOs juggling digital transformation pace, bad data, cloud lock0in and business alignment, 2020)

    Customer Intimacy

    Improve marketing and the customer experience by using the right data from the system of record to analyze complete customer views of transactions, sentiments, and interactions.

    94% Percentage of senior IT leaders who say that poor data quality impinges business outcomes. (Clint Boulton, Disconnect between CIOs and LOB managers weakens data quality, 2016)

    Innovation Leadership

    Gain insights on your products, services, usage trends, industry directions, and competitor results to support decisions on innovations, new products, services, and pricing.

    20% Businesses lose as much as 20% of revenue due to poor data quality. (RingLead Data Management Solutions, 10 Stats About Data Quality I Bet You Didn’t Know)

    Operational Excellence

    Make sure the right solution is delivered rapidly and consistently to the right parties for the right price and cost structure. Automate processes by using the right data to drive process improvements.

    10-20% The implementation of data quality initiatives can lead to reductions in corporate budget of up to 20%. (HaloBI, 2015)

    However, maintaining data quality is difficult

    Avoid these pitfalls to get the true value out of your data.

    1. Data debt drags down ROI – a high degree of data debt will hinder you from attaining the ROI you’re expecting.
    2. Lack of trust means lack of usage – a lack of confidence in data results in a lack of data usage in your organization, which negatively effects strategic planning, KPIs, and business outcomes.
    3. Strategic assets become a liability – bad data puts your business at risk of failing compliance standards, which could result in you paying millions in fines.
    4. Increased costs and inefficiency – time spent fixing bad data means less workload capacity for your important initiatives and the inability to make data-based decisions.
    5. Barrier to adopting data-driven tech – emerging technologies, such as predictive analytics and artificial intelligence, rely on quality data. Inaccurate, incomplete, or irrelevant data will result in delays or a lack of ROI.
    6. Bad customer experience – Running your business on bad data can hinder your ability to deliver to your customers, growing their frustration, which negatively impacts your ability to maintain your customer base.

    Info-Tech Insight

    Data quality suffers most at the point of entry. This is one of the causes of the domino effect of data quality – and can be one of the most costly forms of data quality errors due to the error propagation. In other words, fix data ingestion, whether through improving your application and database design or improving your data ingestion policy, and you will fix a large majority of data quality issues.

    Follow Our Data & Analytics Journey

    Data Quality is laced into Data Strategy, Data Management, and Data Governance.

    • Data Strategy
      • Data Management
        • Data Quality
        • Data Governance
          • Data Architecture
            • MDM
            • Data Integration
            • Enterprise Content Management
            • Information Lifecycle Management
              • Data Warehouse/Lake/Lakehouse
                • Reporting and Analytics
                • AI

    Data quality is rooted in data management

    Extract Maximum Benefit Out of Your Data Quality Management.

    • Data management is the planning, execution, and oversight of policies, practices, and projects that acquire, control, protect, deliver, and enhance the value of data and information assets (DAMA, 2009).
    • In other words, getting the right information, to the right people, at the right time.
    • Data quality management exists within each of the data practices, information dimensions, business resources, and subject areas that comprise the data management framework.
    • Within this framework, an effective data quality practice will replace ad hoc processes with standardized practices.
    • An effective data quality practice cannot succeed without proper alignment and collaboration across this framework.
    • Alignment ensures that the data quality practice is fit for purpose to the business.

    The DAMA DMBOK2 Data Management Framework

    • Data Governance
      • Data Quality
      • Data Architecture
      • Data Modeling & Design
      • Data Storage & Operations
      • Data Security
      • Data Integration & Interoperability
      • Documents & Content
      • Reference & Master Data
      • Data Warehousing & Business Intelligence
      • Meta-data

    (Source: DAMA International)

    Related Info-Tech Research

    Build a Robust and Comprehensive Data Strategy

    • People often think that the main problems they need to fix first are related to data quality when the issues transpire at a much larger level. This blueprint is the key to building and fostering a data-driven culture.

    Create a Data Management Roadmap

    • Refer to this blueprint to understand data quality in the context of data disciplines and methods for improving your data management capabilities.

    Establish Data Governance

    • Define an effective data governance strategy and ensure the strategy integrates well with data quality with this blueprint.

    Info-Tech’s methodology for Data Quality

    Phase Steps 1. Define Your Organization’s Data Environment and Business Landscape 2. Analyze Your Priorities for Data Quality Fixes 3. Establish Your Organization’s Data Quality Program 4. Grow and Sustain Your Data Quality Practice
    Phase Outcomes This step identifies the foundational understanding of your data and business landscape, the essential concepts around data quality, as well as the core capabilities and competencies that IT needs to effectively improve data quality. To begin addressing specific, business-driven data quality projects, you must identify and prioritize the data-driven business units. This will ensure that data improvement initiatives are aligned to business goals and priorities. After determining whose data is going to be fixed based on priority, determine the specific problems that they are facing with data quality, and implement an improvement plan to fix it. Now that you have put an improvement plan into action, make sure that the data quality issues don’t keep cropping up. Integrate data quality management with data governance practices into your organization and look to grow your organization’s overall data maturity.

    Info-Tech Insight

    “Data Quality is in the eyes of the beholder.”– Igor Ikonnikov, Research Director

    Data quality means tolerance, not perfection

    Data from Info-Tech’s CIO Business Vision Diagnostic, which represents over 400 business stakeholders, shows that data quality is very important when satisfaction with data quality is low.

    However, when data quality satisfaction hit a threshold, it became less important.

    The image is a line graph, with the X-axis labelled Satisfaction with Data Quality, and the Y axis labelled Rated Importance for Data Quality. The line begins high, and then descends. There is text inside the graph, which is transcribed below.

    Respondents were asked “How satisfied are you with the quality, reliability, and effectiveness of the data you use to manage your group?” as well as to rank how important data quality was to their organization.

    When the business satisfaction of data quality reached a threshold value of 71-80%, the rated importance reached its lowest value.

    Info-Tech Insight

    Data needs to be good, but truly spectacular data may go unnoticed.

    Provide the right level of data quality, with the appropriate effort, for the correct usage. This blueprint will help you to determine what “the right level of data quality” means, as well as create a plan to achieve that goal for the business.

    Data Roles and Responsibilities

    Data quality occurs through three main layers across the data lifecycle

    Data Strategy

    Data Strategy should contain Data Quality as a standard component.

    ← Data Quality issues can occur throughout at any stage of the data flow →

    DQ Dimensions

    Timeliness – Representation – Usability – Consistency – Completeness – Uniqueness – Entry Quality – Validity – Confidence – Importance

    Source System Layer

    • Data Resource Manager/Collector: Enters data into a database and ensures that data collection sources are accurate

    Data Transformation Layer

    • ETL Developer: Designs data storage systems
    • Data Engineer: Oversees data integrations, data warehouses and data lakes, data pipelines
    • Database Administrator: Manages database systems, ensures they meet SLAs, performances, backups
    • Data Quality Engineer: Finds and cleanses bad data in data sources, creates processes to prevent data quality problems

    Consumption Layer

    • Data Scientist: Gathers and analyses data from databases and other sources, runs models, and creates data visualizations for users
    • BI Analyst: Evaluates and mines complex data and transforms it into insights that drive business value. Uses BI software and tools to analyze industry trends and create visualizations for business users
    • Data Analyst: Extracts data from business systems, analyzes it, and creates reports and dashboards for users
    • BI Engineer: Documents business needs on data analysis and reporting and develops BI systems, reports, and dashboards to support them
    Data Creation → [SLA] Data Ingestion [ QA] →Data Accumulation & Engineering → [SLA] Data Delivery [QA] →Reporting & Analytics
    Fix Data Quality root causes here… to prevent expensive cures here.

    Executive Brief Case Study

    Industry: Healthcare

    Source: Primary Info-Tech Research

    Align source systems to maximize business output.

    A healthcare insurance agency faced data quality issues in which a key business use case was impacted negatively. Business rules were not well defined, and default values instead of real value caused a concern. When dealing with multiple addresses, data was coming from different source systems.

    The challenge was to identify the most accurate address, as some were incomplete, and some lacked currency and were not up to date. This especially challenged a key business unit, marketing, to derive business value in performing key activities by being unable to reach out to existing customers to advertise any additional products.

    For this initiative, this insurance agency took an economic approach by addressing those data quality issues using internal resources.

    Results

    Without having any MDM tools or having a master record or any specific technology relating to data quality, this insurance agency used in-house development to tackle those particular issues at the source system. Data quality capabilities such as data profiling were used to uncover those issues and address them.

    “Data quality is subjective; you have to be selective in terms of targeting the data that matters the most. When getting business tools right, most issues will be fixed and lead to achieving the most value.” – Asif Mumtaz, Data & Solution Architect

    Info-Tech offers various levels of support to best suit your needs

    DIY Toolkit

    "Our team has already made this critical project a priority, and we have the time and capability, but some guidance along the way would be helpful."

    Guided Implementation

    "Our team knows that we need to fix a process, but we need assistance to determine where to focus. Some check-ins along the way would help keep us on track."

    Workshop

    "We need to hit the ground running and get this project kicked off immediately. Our team has the ability to take this over once we get a framework and strategy in place."

    Consulting

    "Our team does not have the time or the knowledge to take this project on. We need assistance through the entirety of this project."

    Diagnostic and consistent frameworks are used throughout all four options.

    Guided Implementation

    What does a typical GI on this topic look like?

    Phase 1 Phase 2 Phase 3 Phase 4
    • Call #1: Learn about the concepts of data quality and the common root causes of poor data quality.
    • Call #2: Identify the core capabilities of IT for improving data quality on an enterprise scale.
    • Call #3: Determine which business units use data and require data quality remediation.
    • Call #4: Create a plan for addressing business unit data quality issues according to priority of the business units based on value and impact of data.
    • Call #5: Revisit the root causes of data quality issues and identify the relevant root causes to the highest priority business unit.
    • Call #6: Determine a strategy for fixing data quality issues for the highest priority business unit.
    • Call #7: Identify strategies for continuously monitoring and improving data quality at the organization.
    • Call #8: Learn how to incorporate data quality practices in the organization’s larger data management and data governance frameworks.
    • Call #9: Summarize results and plan next steps on how to evolve your data landscape.

    A Guided Implementation (GI) is a series of calls with an Info-Tech analyst to help implement our best practices in your organization.

    A typical GI is between eight to twelve calls over the course of four to six months.

    Workshop Overview

    Contact your account representative for more information. workshops@infotech.com 1-888-670-8889

    Day 1 Day 2 Day 3 Day 4 Day 5
    Define Your Organization’s Data Environment and Business Landscape Create a Strategy for Data Quality Project 1 Create a Strategy for Data Quality Project 2 Create a Strategy for Data Quality Project 3 Create a Plan for Sustaining Data Quality
    Activities
    1. Explain approach and value proposition.
    2. Detail business vision, objectives, and drivers.
    3. Discuss data quality barriers, needs, and principles.
    4. Assess current enterprise-wide data quality capabilities.
    5. Identify data quality practice future state.
    6. Analyze gaps in data quality practice.
    1. Create business unit prioritization roadmap.
    2. Develop subject areas project scope.
    3. By subject area 1:
    • Data lineage analysis
    • Root cause analysis
    • Impact assessment
    • Business analysis
    1. Understand how data quality management fits in with the organization’s data governance and data management programs.
    2. By subject area 2:
    • Data lineage analysis
    • Root cause analysis
    • Impact assessment
    • Business analysis
    1. Formulate strategies and actions to achieve data quality practice future state.
    2. Formulate data quality resolution plan for defined subject area.
    3. By subject area 3:
    • Data lineage analysis
    • Root cause analysis
    • Impact assessment
    • Business analysis
    1. Formulate metrics for continuous tracking of data quality and monitoring the success of the data quality improvement initiative.
    2. Workshop Debrief with Project Sponsor.
    • Meet with project sponsor/manager to discuss results and action items.
    • Wrap up outstanding items from the workshop, deliverables expectations, GIs.
    Deliverables
    1. Data Quality Management Primer
    2. Business Capability Map Template
    3. Data Culture Diagnostic
    4. Data Quality Diagnostic
    5. Data Quality Problem Statement Template
    1. Business Unit Prioritization Roadmap
    2. Subject area scope
    3. Data Lineage Diagram
    1. Data Lineage Diagram
    2. Root Cause Analysis
    3. Impact Analysis
    1. Data Lineage Diagram
    2. Data Quality Improvement Plan
    1. Data Quality Practice Improvement Roadmap
    2. Data Quality Improvement Plan (for defined subject areas)

    Phase 1

    Define Your Organization’s Data Environment and Business Landscape

    Build Your Data Quality Program

    Data quality is a methodology and must be treated as such

    A comprehensive data quality practice includes appropriate business requirements gathering, planning, governance, and oversight capabilities, as well as empowering technologies for properly trained staff, and ongoing development processes.

    Some common examples of appropriate data management methodologies for data quality are:

    • The data quality team has the necessary competencies and resources to perform the outlined workload.
    • There are processes that exist for continuously evaluating data quality performance capabilities.
    • Improvement strategies are designed to increase data quality performance capabilities.
    • Policies and procedures that govern data quality are well-documented, communicated, followed, and updated.
    • Change controls exist for revising policies and procedures, including communication of updates and changes.
    • Self-auditing techniques are used to ensure business-IT alignment when designing or recalibrating strategies.

    Effective data quality practices coordinate with other overarching data disciplines, related data practices, and strategic business objectives.

    “You don’t solve data quality with a Band-Aid; you solve it with a methodology.” – Diraj Goel, Growth Advisor, BC Tech

    Data quality can be defined by four key quality indicators

    Similar to measuring the acidity of a substance with a litmus test, the quality of your data can be measured using a simple indicator test. As you learn about common root causes of data quality problems in the following slides, think about these four quality indicators to assess the quality of your data:

    • Completeness – Closeness to the correct value. Encompasses accuracy, consistency, and comparability to other databases.
    • Usability – The degree to which data meets current user needs. To measure this, you must determine if the user is satisfied with the data they are using to complete their business functions.
    • Timeliness – Length of time between creation and availability of data.
    • Accessibility – How easily a user can access and understand the data (including data definitions and context). Interpretability can also be used to describe this indicator.

    Info-Tech Insight

    Quality is a relative term. Data quality is measured in terms of tolerance. Perfect data quality is both impossible and a waste of time and effort.

    How to get investment for your data quality program

    Follow these steps to convince leadership of the value of data quality:

    “You have to level with people, you cannot just start talking with the language of data and expect them to understand when the other language is money and numbers.” – Izabela Edmunds, Information Architect at Mott MacDonald

    1. Perform Phases 0 & 1 of this blueprint as this will offer value in carrying out the following steps.
    2. Build credibility. Show them your understanding of data and how it aligns to the business.
    3. Provide tangible evidence of how significant business use cases are impacted by poor quality data.
    4. Present the ROI of fixing the data quality issues you have prioritized.
    5. Explain how the data quality program will be established, implemented, and sustained.
    6. Prove the importance of fixing data quality issues at the source and how it is the most efficient, effective, and cost-friendly solution.

    Phase 1 deliverables

    Each of these deliverables serve as inputs to detect key outcomes about your organization and to help complete this blueprint:

    1. Data Culture Diagnostic

    Use this report to understand where your organization lies across areas relating to data culture.

    While the Quality & Trust area of the report might be most prevalent to this blueprint, this diagnostic may point out other areas demanding more attention.

    Please speak to your account manager for access

    2. Business Capability Map Template

    Perform this process to understand the capabilities that enable specific value streams. The output of this deliverable is a high-level view of your organization’s defined business capabilities.

    Download this tool

    Info-Tech Insight

    Understanding your data culture and business capabilities are foundational to starting the journey of data quality improvement.

    Key deliverable:

    3. Data Quality Diagnostic

    The Data Quality Report is designed to help you understand, assess, and improve key organizational data quality issues. This is where respondents across various areas in the organization can assess Data Quality across various dimensions.

    Download this tool

    Data Quality Diagnostic Value

    Prioritize business use cases with our data quality dimensions.

    • Complete this diagnostic for each major business use case. The output from the Data Culture Diagnostic and the Business Capability Map should help you understand which use cases to address.
    • Involve all key stakeholders involved in the business use case. There may be multiple business units involved in a single use case.
    • Prioritize the business use cases that need the most attention pertaining to data quality by comparing the scores of the Importance and Confidence data quality dimensions.

    If there are data elements that are considered of high importance and low confidence, then they must be prioritized.

    Sample Scorecard

    The image shows a screen capture of a scorecard, with sample information filled in.

    The image shows a screen capture of a scorecard, with sample information filled in.

    Poor data quality develops due to multiple root causes

    After you get to know the properties of good quality data, understand the underlying causes of why those indicators can point to poor data quality.

    If you notice that the usability, completeness, timeliness, or accessibility of the organization’s data is suffering, one or more of the following root causes are likely plaguing your data:

    Common root causes of poor data quality, through the lens of Info-Tech’s Five-Tier Data Architecture:

    The image shows a graphic of Info-Tech's Five-Tier Data Architecture, with root causes of poor data quality identified. In the data creation and ingestion stages, the root causes are identified as Poor system/application design, Poor database design, Inadequate enterprise integration. The root causes identified in the latter stages are: Absence of data quality policies, procedures, and standards, and Incomplete/suboptimal business processes

    These root causes of poor data quality are difficult to avoid, not only because they are often generated at an organization’s beginning stages, but also because change can be difficult. This means that the root causes are often propagated through stale or outdated business processes.

    Data quality problems root cause #1:

    Poor system or application design

    Application design plays one of the largest roles in the quality of the organization’s data. The proper design of applications can prevent data quality issues that can snowball into larger issues downstream.

    Proper ingestion is 90% of the battle. An ounce of prevention is worth a pound of cure. This is true in many different topics, and data quality is one of them. Designing an application so that data gets entered properly, whether by internal staff or external customers, is the single most effective way to prevent data quality issues.

    Some common causes of data quality problems at the application/system level include:

    • Too many open fields (free-form text fields that accept a variety of inputs).
    • There are no lookup capabilities present. Reference data should be looked up instead of entered.
    • Mandatory fields are not defined, resulting in blank fields.
    • No validation of data entries before writing to the underlying database.
    • Manual data entry encourages human error. This can be compounded by poor application design that facilitates the incorrect data entry.

    Data quality problems root cause #2:

    Poor database design

    Database design also affects data quality. How a database is designed to handle incoming data, including the schema and key identification, can impact the integrity of the data used for reporting and analytics.

    The most common type of database is the relational database. Therefore, we will focus on this type of database.

    When working with and designing relational databases, there are some important concepts that must be considered.

    Referential integrity is a term that is important for the design of relational database schema, and indicates that table relationships must always be consistent.

    For table relationships to be consistent, primary keys (unique value for each row) must uniquely identify entities in columns of the table. Foreign keys (field that is defined in a second table but refers to the primary key in the first table) must agree with the primary key that is referenced by the foreign key. To maintain referential integrity, any updates must be propagated to the primary parent key.

    Info-Tech Insight

    Other types of databases, including databases with unstructured data, need data quality consideration. However, unstructured data may have different levels of quality tolerance.

    At the database level, some common root causes include:

    1. Lack of referential integrity.
    2. Lack of unique keys.
    3. Don’t have restricted data range.
    4. Incorrect datatype, string fields that can hold too many characters.
    5. Orphaned records.

    Databases and People:

    Even though database design is a technology issue, don’t forget about the people.

    A lack of training employees on database permissions for updating/entering data into the physical databases is a common problem for data quality.

    Data quality problems root cause #3:

    Improper integration and synchronization of enterprise data

    Data ingestion is another category of data-quality-issue root causes. When moving data in Tier 2, whether it is through ETL, ESB, point-to-point integration, etc., the integrity of the data during movement and/or transformation needs to be maintained.

    Tier 2 (the data ingestion layer) serves to move data for one of two main purposes:

    • To move data from originating systems to downstream systems to support integrated business processes.
    • To move data to Tier 3 where data rests for other purposes. This movement of data in its purest form means we move raw data to storage locations in an overall data warehouse environment reflecting any security, compliance and other standards in our choices for how to store. Also, it is where data is transformed for unique business purpose that will also be moved to a place of rest or a place of specific use. Data cleansing and matching and other data-related blending tasks occur at this layer.

    This ensures the data is pristine throughout the process and improves trustworthiness of outcomes and speed to task completion.

    At the integration layer, some common root causes of data quality problems include:

    1. No data mask. For example, zip code should have a mask of five numeric characters.
    2. Questionable aggregation, transformation process, or incorrect logic.
    3. Unsynchronized data refresh process in an integrated environment.
    4. Lack of a data matching tool.
    5. Lack of a data quality tool.
    6. Don’t have data profiling capability.
    7. Errors with data conversion or migration processes – when migrating, decommissioning, or converting systems – movement of data sets.
    8. Incorrect data mapping between data sources and targets.

    Data quality problems root cause #4:

    Insufficient and ineffective data quality policies and procedures

    Data policies and procedures are necessary for establishing standards around data and represent another category of data-quality-issue root causes. This issue spans across all five of the 5 Tier Architecture.

    Data policies are short statements that seek to manage the creation, acquisition, integrity, security, compliance, and quality of data. These policies vary amongst organizations, depending on your specific data needs.

    • Policies describe what to do, while standards and procedures describe how to do something.
    • There should be few data policies, and they should be brief and direct. Policies are living documents and should be continuously updated to respond to the organization’s data needs.
    • The data policies should highlight who is responsible for the data under various scenarios and rules around how to manage it effectively.

    Some common root causes of data quality issues related to policies and procedures include:

    1. Policies are absent or out of date.
    2. Employees are largely unaware of policies in effect.
    3. Policies are unmonitored and unenforced.
    4. Policies are in multiple locations.
    5. Multiple versions of the same policy exist.
    6. Policies are managed inconsistently across different silos.
    7. Policies are written poorly by untrained authors.
    8. Inadequate policy training program.
    9. Draft policies stall and lose momentum.
    10. Weak policy support from senior management.

    Data quality problems root cause #5:

    Inefficient or ineffective business processes

    Some common root causes of data quality issues related to business processes include:

    1. Multiple entries of the same record leads to duplicate records proliferating in the database.
    2. Many business definitions of data.
    3. Failure to document data manipulations when presenting data.
    4. Failure to train people on how to understand data.
    5. Manually intensive processes can result in duplication of effort (creates room for errors).
    6. No clear delineation of dependencies of business processes within or between departments, which leads to a siloed approach to business processes, rather than a coordinated and aligned approach.

    Business processes can impact data quality. How data is entered into systems, as well as employee training and knowledge about the correct data definitions, can impact the quality of your organization’s data.

    These problematic business process root causes can lead to:

    Duplicate records

    Incomplete data

    Improper use of data

    Wrong data entered into fields

    These data quality issues will result in costly and inefficient manual fixes, wasting valuable time and resources.

    Phase 1 Summary

    1. Data Quality Understanding

    • Understanding that data quality is a methodology and should be treated as such.
    • Data quality can be defined by four key indicators which are completeness, usability, timeliness, and accessibility.
    • Explained how to get investment for your data quality program and showcasing its value to leadership.

    2. Phase 0 Deliverables

    Introduced foundational tools to help you throughout this blueprint:

    • Complete the Data Culture Diagnostic and Business Capability Map Template as they are foundational in understanding your data culture and business capabilities to start the journey of data quality improvement.
    • Involve key relevant stakeholders when completing the Data Quality Diagnostic for each major business use case. Use the Importance and Confidence dimensions to help you prioritize which use case to address.

    3. Common Root Causes

    Addressed where multiple root causes can occur throughout the flow of your data.

    Analyzed the following common root causes of data quality:

    1. Poor system or application design
    2. Poor database design
    3. Improper integration and synchronization of enterprise data
    4. Insufficient and ineffective data quality policies and procedures
    5. Inefficient or ineffective business processes

    Phase 2

    Analyze Your Priorities for Data Quality Fixes

    Build Your Data Quality Program

    Business Context & Data Quality

    Establish the business context of data quality improvement projects at the business unit level to find common goals.

    • To ensure the data improvement strategy is business driven, start your data quality project evaluation by understanding the business context. You will then determine which business units use data and create a roadmap for prioritizing business units for data quality repairs.
    • Your business context is represented by your corporate business vision, mission, goals and objectives, differentiators, and drivers. Collectively, they provide essential information on what is important to your organization, and some hints on how to achieve that. In this step, you will gather important information about your business view and interpret the business view to establish a data view.

    Business Vision

    Business Goals

    Business Drivers

    Business Differentiators

    Not every business unit uses data to the same extent

    A data flow diagram can provide value by allowing an organization to adopt a proactive approach to data quality. Save time by knowing where the entry points are and where to look for data flaws.

    Understanding where data lives can be challenging as it is often in motion and rarely resides in one place. There are multiple benefits that come from taking the time to create a data flow diagram.

    • Mapping out the flow of data can help provide clarity on where the data lives and how it moves through the enterprise systems.
    • Having a visual of where and when data moves helps to understand who is using data and how it is being manipulated at different points.
    • A data flow diagram will allow you to elicit how data is used in a different use case.

    Info-Tech’s Four-Column Model of Data will help you to identify the essential aspects of your data:

    Business Use Case →Used by→Business Unit →Housed in→Systems→Used for→Usage of the Data

    Not every business unit requires the same standard of data quality

    To prioritize your business units for data quality improvement projects, you must analyze the relative importance of the data they use to the business. The more important the data is to the business, the higher the priority is of fixing that data. There are two measures for determining the importance of data: business value and business impact.

    Business Value of Data

    Business value of data can be evaluated by thinking about its ties to revenue generation for the organization, as well as how it is used for productivity and operations at the organization.

    The business value of data is assessed by asking what would happen to the following parameters if the data is not usable (due to poor quality, for example):

    • Loss of Revenue
    • Loss of Productivity
    • Increased Operating Costs

    Business Impact of Data

    Business impact of data should take into account the effects of poor data on both internal and external parties.

    The business impact of data is assessed by asking what the impact would be of bad data on the following parameters:

    • Impact on Customers
    • Impact on Internal Staff
    • Impact on Business Partners

    Value + Impact = Data Priority Score

    Ensure that the project starts on the right foot by completing Info-Tech’s Data Quality Problem Statement Template

    Before you can identify a solution, you must identify the problem with the business unit’s data.

    Download this tool

    Use Info-Tech’s Data Quality Problem Statement Template to identify the symptoms of poor data quality and articulate the problem.

    Info-Tech’s Data Quality Problem Statement Template will walk you through a step-by-step approach to identifying and describing the problems that the business unit feels regarding its data quality.

    Before articulating the problem, it helps to identify the symptoms of the problem. The following W’s will help you to describe the symptoms of the data quality issues:

    What

    Define the symptoms and feelings produced by poor data quality in the business unit.

    Where

    Define the location of the data that are causing data quality issues.

    When

    Define how severe the data quality issues are in frequency and duration.

    Who

    Define who is affected by the data quality problems and who works with the data.

    Info-Tech Best Practice

    Symptoms vs. Problems. Often, people will identify a list of symptoms of a problem and mistake those for the problem. Identifying the symptoms helps to define the problem, but symptoms do not help to identify the solution. The problem statement helps you to create solutions.

    Define the project problem to articulate the purpose

    1 hour

    Input

    • Symptoms of data quality issues in the business unit

    Output

    • Refined problem description

    Materials

    • Data Quality Problem Statement Template

    Participants

    • Data Quality Improvement Project team
    • Business line representatives

    A defined problem helps you to create clear goals, as well as lead your thinking to determine solutions to the problem.

    A problem statement consists of one or two sentences that summarize a condition or issue that a quality improvement team is meant to address. For the improvement team to fix the problem, the problem statement therefore has to be specific and concise.

    Instructions

    1. Gather the Data Quality Improvement Project Team in a room and start with an issue that is believed to be related to data quality.
    2. Ask what are the attributes and symptoms of that reality today; do this with the people impacted by the issue. This should be an IT and business collaboration.
    3. Draw your conclusions of what it all means: what have you collectively learned?
    4. Consider the implications of your conclusions and other considerations that must be taken into account such as regulatory needs, compliance, policy, and targets.
    5. Develop solutions – Contain the problem to something that can be solved in a realistic timeframe, such as three months.

    Download the Data Quality Problem Statement Template

    Case Study

    A strategic roadmap rooted in business requirements primes a data quality improvement plan for success.

    MathWorks

    Industry

    Software Development

    Source

    Primary Info-Tech Research

    As part of moving to a formalized data quality practice, MathWorks leveraged an incremental approach that took its time investigating business cases to support improvement actions. Establishing realistic goals for improvement in the form of a roadmap was a central component for gaining executive approval to push the project forward.

    Roadmap Creation

    In constructing a comprehensive roadmap that incorporated findings from business process and data analyses, MathWorks opted to document five-year and three-year overall goals, with one-year objectives that supported each goal. This approach ensured that the tactical actions taken were directed by long-term strategic objectives.

    Results – Business Alignment

    In presenting their roadmap for executive approval, MathWorks placed emphasis on communicating the progression and impact of their initiatives in terms that would engage business users. They focused on maintaining continual lines of communication with business stakeholders to demonstrate the value of the initiatives and also to gradually shift the corporate culture to one that is invested in an effective data quality practice.

    “Don’t jump at the first opportunity, because you may be putting out a fire with a cup of water where a fire truck is needed.” – Executive Advisor, IT Research and Advisory Firm

    Use Info-Tech’s Practice Assessment and Project Planning Tool to create your strategy for improving data quality

    Assess IT’s capabilities and competencies around data quality and plan to build these as the organization’s data quality practice develops. Before you can fix data quality, make sure you have the necessary skills and abilities to fix data quality correctly.

    The following IT capabilities are developed on an ongoing basis and are necessary for standardizing and structuring a data quality practice:

    • Meeting Business Needs
    • Services and Projects
    • Policies, Procedures, and Standards
    • Roles and Organizational Structure
    • Oversight and Communication
    • Data Quality of Different Data Types

    Download this Tool

    Data Handling and Remediation Competencies:

    • Data Standardization: Formatting values into consistent standards based on industry standards and business rules.
    • Data Cleansing: Modification of values to meet domain restrictions, integrity constraints, or other business rules for sufficient data quality for the organization.
    • Data Matching: Identification, linking, and merging related entries in or across sets of data.
    • Data Validation: Checking for correctness of the data.

    After these capabilities and competencies are assessed for a current and desired target state, the Data Quality Practice Assessment and Project Planning Tool will suggest improvement actions that should be followed in order to build your data quality practice. In addition, a roadmap will be generated after target dates are set to create your data quality practice development strategy.

    Benchmark current and identify target capabilities for your data quality practice

    1 hour

    Input

    • Current and desired data quality practices in the organization

    Output

    • Assessment of where the gaps lie in your data quality practice

    Materials

    • Data Quality Practice Assessment and Project Planning Tool

    Participants

    • Data Quality Project Lead
    • Business Line Representatives
    • Business Architects

    Use the Data Quality Practice Assessment and Project Planning Tool to evaluate the baseline and target capabilities of your practice in terms of how data quality is approached and executed.

    Download this Tool

    Instructions

    1. Invite the appropriate stakeholders to participate in this exercise. Examples:
      1. Business executives will have input in Tab 2
      2. Unique stakeholders: communications expert or executive advisors may have input
    2. On Tab 2: Practice Components, assess the current and target states of each capability on a scale of 1–5. Note: “Ad hoc” implies a capability is completed, but randomly, informally, and without a standardized method.

    These results will set the baseline against which you will monitor performance progress and keep track of improvements over time.

    Info-Tech Insight

    Focus on early alignment. Assessing capabilities within specific people’s job functions can naturally result in disagreement or debate, especially between business and IT people. Remind everyone that data quality should ultimately serve business needs wherever possible.

    Visualization improves the holistic understanding of where gaps exist in your data quality practice

    To enable deeper analysis on the results of your practice assessment, Tab 3: Data Quality Practice Scorecard in the Data Quality Practice Assessment and Project Planning Tool creates visualizations of the gaps identified in each of your practice capabilities and related data management practices. These diagrams serve as analysis summaries.

    Gap assessment of “Meeting Business Needs” capabilities

    The image shows a screen capture of the Gap assessment of
“Meeting Business Needs” capabilities, with sample information filled in.

    Visualization of gap assessment of data quality practice capabilities

    The image shows a bar graph titled Data Quality Capabilities.

    1. Enhance your gap analyses by forming a relative comparison of total gaps in key practice capability areas, which will help in determining priorities.
    • Example: In Tab 2 compare your capabilities within “Policies, Procedures, and Standards.” Then in Tab 3, compare your overall capabilities in “Policies, Procedures, and Standards” versus “Empowering Technologies.”
  • Put these up on display to improve discussion in the gap analyses and prioritization sessions.
  • Improve the clarity and flow of your strategy template, final presentations, and summary documents by copying and pasting the gap assessment diagrams.
  • Before engaging in the data quality improvement project plan, receive signoff from IT regarding feasibility

    The final piece of the puzzle is to gain sign-off from IT.

    Hofstadter's law: It always takes longer than you expect, even when you take into account Hofstadter’s Law.

    This means that before engaging IT in data quality projects to fix the business units’ data in Phase 2, IT must assess feasibility of the data quality improvement plan. A feasibility analysis is typically used to review the strengths and weaknesses of the projects, as well as the availability of required skills and technologies needed to complete them. Use the following workflow to guide you in performing a feasibility analysis:

    Project evaluation process:

    Present capabilities

    • Operational Capabilities
    • System Capabilities
    • Schedule Capabilities
      • Summary of Evaluation Results
        • Recommendations/ modifications to the project plan

    Info-Tech Best Practice

    While the PMO identifies and coordinates projects, IT must determine how long and for how much.

    Conduct gap analysis sessions to review and prioritize the capability gaps

    1 hour

    Input

    • Current and Target State Assessment

    Output

    • Documented initiatives to help you get to the target state

    Materials

    • Data Quality Practice Assessment and Project Planning Tool

    Participants

    • Data Quality team
    • IT representatives

    Instructions

    • Analyze Gap Analysis Results – As a group, discuss the high-level results on Tab 3: Data Quality Practice Score. Discuss the implications of the gaps identified.
    • Do a line-item review of the gaps between current and target levels for each assessed capability by using Tab 2: Practice Components.
    • Brainstorm Alignment Strategies – Brainstorm the effort and activities that will be necessary to support the practice in building its capabilities to the desired target level. Ask the following questions:
      • What activities must occur to enable this capability?
      • What changes/additions to resources, process, technology, business involvement, and communication must occur?
    • Document Data Quality Initiatives – Turn activities into initiatives by documenting them in Tab 4. Data Quality Practice Roadmap. Review the initiatives and estimate the start and end dates of each one.
    • Continue to evaluate the assessment results in order to create a comprehensive set of data quality initiatives that support your practice in building capabilities.

    Download this Tool

    Create the organization’s data quality improvement strategy roadmap

    1 hour

    Input

    • Data quality practice gaps and improvement actions

    Output

    • Data quality practice improvement roadmap

    Materials

    • Data Quality Practice Assessment and Project Planning Tool

    Participants

    • Data Quality Project Lead
    • Business Executives
    • IT Executives
    • Business Architects

    Generating Your Roadmap

    1. Plan the sequence, starting time, and length of each initiative in the Data Quality Practice Assessment and Project Planning Tool.
    2. The tool will generate a Gantt chart based on the start and length of your initiatives.
    3. The Gantt chart is generated in Tab 4: Data Quality Practice Roadmap, and can be used to organize and ensure that all of the essential aspects of data quality are addressed.

    Use the Practice Roadmap to plan and improve data quality capabilities

    Download this Tool

    Info-Tech Best Practice

    To help get you started, Info-Tech has provided an extensive list of data quality improvement initiatives that are commonly undertaken by organizations looking to improve their data quality.

    Establish Baseline Metrics

    Baseline metrics will be improved through:

    2 hours

    Create practice-level metrics to monitor your data quality practice.

    Instructions:

    1. Establish metrics for both the business and IT that will be used to determine if the data quality practice development is effective.
    2. Set targets for each metric.
    3. Collect current data to calculate the metrics and establish a baseline.
    4. Assign an owner for tracking each metric to be accountable for performance.
    Metric Current Goal
    Usage (% of trained users using the data warehouse)
    Performance (response time)
    Performance (response time)
    Resource utilization (memory usage, number of machine cycles)
    User satisfaction (quarterly user surveys)
    Data quality (% values outside valid values, % fields missing, wrong data type, data outside acceptable range, data that violates business rules. Some aspects of data quality can be automatically tracked and reported)
    Costs (initial installation and ongoing, Total Cost of Ownership including servers, software licenses, support staff)
    Security (security violations detected, where violations are coming from, breaches)
    Patterns that are used
    Reduction in time to market for the data
    Completeness of data that is available
    How many "standard" data models are being used
    What is the extra business value from the data governance program?
    How much time is spent for data prep by BI & analytics team?

    Phase 2 summary

    As you improve your data quality practice and move from reactive to stable, don’t rest and assume that you can let data quality keep going by itself. Rapidly changing consumer requirements or other pains will catch up to your organization and you will fall behind again. By moving to the proactive and predictive end of the maturity scale, you can stay ahead of the curve. By following the methodology laid out in Phase 1, the data quality practices at your organization will improve over time, leading to the following results:

    Chaotic

    Before Data Quality Practice Improvements

    • No standards to data quality

    Reactive

    Year 1

    • Processes defined
    • Data cleansing approach to data quality

    Stable

    Year 2

    • Business rules/ stewardship in place
    • Education and training

    Proactive

    Year 3

    • Data quality practices fully in place and embedded in the culture
    • Trusted and intelligent enterprise

    (Global Data Excellence, Data Excellence Maturity Model)

    Phase 3

    Establish Your Organization’s Data Quality Program

    Build Your Data Quality Program

    Create a data lineage diagram to map the data journey and identify the data subject areas to be targeted for fixes

    It is important to understand the various data that exist in the business unit, as well as which data are essential to business function and require the highest degree of quality efforts.

    Visualize your databases and the flow of data. A data lineage diagram can help you and the Data Quality Improvement Team visualize where data issues lie. Keeping the five-tier architecture in mind, build your data lineage diagram.

    Reminder: Five-Tier Architecture

    The image shows the Five-Tier Architecture graphic.

    Use the following icons to represent your various data systems and databases.

    The image shows four icons. They are: the image of a square and a computer monitor, labelled Application; the image of two sheets of paper, labelled Desktop documents; the image of a green circle next to a computer monitor, labelled Web Application; and a blue cylinder labelled Database.

    Use Info-Tech’s Data Lineage Diagram to document the data sources and applications used by the business unit

    2 hours

    Input

    • Data sources and applications used by the business unit

    Output

    • Data lineage diagram

    Materials

    • Data Lineage Diagram Template

    Participants

    • Business Unit Head/Data Owner
    • Business Unit SMEs
    • Data Analysts/Architects

    Map the flow and location of data within a business unit by creating a system context diagram.

    Gain an accurate view of data locations and uses: Engage business users and representatives with a wide breadth of knowledge-related business processes and the use of data by related business operations.

    1. Sit down with key business representatives of the business unit.
    2. Document the sources of data and processes in which they’re involved, and get IT confirmation that the sources of the data are correct.
    3. Map out the sources and processes in a system context diagram.

    Download this Tool

    Sample Data Lineage Diagram

    The image shows a sample data lineage diagram, split into External Applications and Internal Applications, and showing the processes involved in each.

    Leverage Info-Tech’s Data Quality Practice Assessment and Project Planning Tool to document business context

    1 hour

    Input

    • Business vision, goals, and drivers

    Output

    • Business context for the data quality improvement project

    Materials

    • Data Quality Practice Assessment and Project Planning Tool

    Participants

    • Data Quality project lead
    • Business line representatives
    • IT executives

    Develop goals and align them with specific objectives to set the framework for your data quality initiatives.

    In the context of achieving business vision, mission, goals, and objectives and sustaining differentiators and key drivers, think about where and how data quality is a barrier. Then brainstorm data quality improvement objectives that map to these barriers. Document your list of objectives in Tab 5. Prioritize business units of the Data Quality Practice Assessment and Project Planning Tool.

    Establishing Business Context Example

    Healthcare Industry

    Vision To improve member services and make service provider experience more effective through improving data quality and data collection, aggregation, and accessibility for all the members.
    Goals

    Establish meaningful metrics that guide to the improvement of healthcare for member effectiveness of health care providers:

    • Data collection
    • Data harmonization
    • Data accessibility and trust by all constituents.
    Differentiator Connect service consumers with service providers, that comply with established regulations by delivering data that is accurate, trusted, timely, and easy to understand to connect service providers and eliminate bureaucracy and save money and time.
    Key Driver Seamlessly provide a healthcare for members.

    Download this Tool

    Document the identified business units and their associated data

    30 minutes

    Input

    • Business units

    Output

    • Documented business units to begin prioritization

    Materials

    • Data Quality Practice Assessment and Project Planning Tool

    Participants

    • Project Manager

    Instructions

    1. Using Tab 5: Prioritize Business Units of the Data Quality Practice Assessment and Project Planning Tool, document the business units that use data in the organization. This will likely be all business units in the organization.
    2. Next, document the primary data used by those business units.
    3. These inputs will then be used to assess business unit priority to generate a data quality improvement project roadmap.

    The image shows a screen capture of Tab 5: Prioritize Business Units, with sample information inputted.

    Reminder – Not every business unit requires the same standard of data quality

    To prioritize your business units for data quality improvement projects, you must analyze the relative importance of the data they use to the business. The more important the data is to the business, the higher the priority is of fixing that data. There are two measures for determining the importance of data: business value and business impact.

    Business Value of Data

    Business value of data can be evaluated by thinking about its ties to revenue generation for the organization, as well as how it is used for productivity and operations at the organization.

    The business value of data is assessed by asking what would happen to the following parameters if the data is not usable (due to poor quality, for example):

    • Loss of Revenue
    • Loss of Productivity
    • Increased Operating Costs

    Business Impact of Data

    Business impact of data should take into account the effects of poor data on both internal and external parties.

    The business impact of data is assessed by asking what the impact would be of bad data on the following parameters:

    • Impact on Customers
    • Impact on Internal Staff
    • Impact on Business Partners

    Value + Impact = Data Priority Score

    Assess the business unit priority order for data quality improvements

    2 hours

    Input

    • Assessment of value and impact of business unit data

    Output

    • Prioritization list for data quality improvement projects

    Materials

    • Data Quality Practice Assessment and Project Planning Tool

    Participants

    • Project Manager
    • Data owners

    Instructions

    Instructions In Tab 5: Prioritize Business Units of the Data Quality Practice Assessment and Project Planning Tool, assess business value and business impact of the data within each documented business unit.

    Use the ratings High, Medium, and Low to measure the financial, productivity, and efficiency value and impact of each business unit’s data.

    In addition to these ratings, assess the number of help desk tickets that are submitted to IT regarding data quality issues. This parameter is an indicator that the business unit’s data is high priority for data quality fixes.

    Download this Tool

    Create a business unit order roadmap for your data quality improvement projects

    1 hour

    Input

    • Rating of importance of data for each business unit

    Output

    • Roadmap for data quality improvement projects

    Materials

    • Data Quality Practice Assessment and Project Planning Tool

    Participants

    • Project Manager
    • Product Manager
    • Business line representatives

    Instructions

    After assessing the business units for the business value and business impact of their data, the Data Quality Practice Assessment and Project Planning Tool automatically assesses the prioritization of the business units based on your ratings. These prioritizations are then summarized in a roadmap on Tab 6: Data Quality Project Roadmap. The following is an example of a project roadmap:

    The image shows an example of a project roadmap, with three business units listed vertically along the left hand side, and a Gantt chart showing the time periods in which each Business Unit would work. At the bottom, a table shows the Length of the Project in days (100), and the start date for the first project.

    On Tab 6, insert the timeline for your data quality improvement projects, as well as the starting date of your first data quality project. The roadmap will automatically update with the chosen timing and dates.

    Download this Tool

    Identify metrics at the business unit level to track data quality improvements

    As you improve the data quality for specific business units, measuring the benefits of data quality improvements will help you demonstrate the value of the projects to the business.

    Use the following table to guide you in creating business-aligned metrics:

    Business Unit Driver Metrics Goal
    Sales Customer Intimacy Accuracy of customer data. Percent of missing or incomplete records. 10% decrease in customer record errors.

    Marketing

    Customer Intimacy Accuracy of customer data. Percent of missing or incomplete records. 10% decrease in customer record errors.
    Finance Operational Excellence Relevance of financial reports. Decrease in report inaccuracy complaints.
    HR Risk Management Accuracy of employee data. 10% decrease in employee record errors.
    Shipping Operational Excellence Timeliness of invoice data. 10% decrease in time to report.

    Info-Tech Insight

    Relating data governance success metrics to overall business benefits keeps executive management and executive sponsors engaged because they are seeing actionable results. Review metrics on an ongoing basis with those data owners/stewards who are accountable, the data governance steering committee, and the executive sponsors.

    Case Study

    Address data quality with the right approach to maximize the ROI

    EDC

    Industry: Government

    Source: Environment Development of Canada (EDC)

    Challenge

    Environment Development Canada (EDC) would initially identify data elements that are important to the business purely based on their business instinct.

    Leadership attempted to tackle the enterprise’s data issues by bringing a set of different tools into the organization.

    It didn’t work out because the fundamental foundational layer, which is the data and infrastructure, was not right – they didn't have the foundational capabilities to enable those tools.

    Solution

    Leadership listened to the need for one single team to be responsible for the data persistence.

    Therefore, the data platform team was granted that mandate to extensively execute the data quality program across the enterprise.

    A data quality team was formed under the Data & Analytics COE. They had the mandate to profile the data and to understand what quality of data needed to be achieved. They worked constantly with the business to build the data quality rules.

    Results

    EDC tackled the source of their data quality issues through initially performing a data quality management assessment with business stakeholders.

    From then on, EDC was able to establish their data quality program and carry out other key initiatives that prove the ROI on data quality.

    Begin your data quality improvement project starting with the highest priority business unit

    Now that you have a prioritized list for your data quality improvement projects, identify the highest priority business unit. This is the business unit you will work through Phase 3 with to fix their data quality issues.

    Once you have initiated and identified solutions for the first business unit, tackle data quality for the next business unit in the prioritized list.

    The image is a graphic labelled as Phase 2. On the left, there is a vertical arrow pointing upward labelled Priority of Business Units. Next to it, there are three boxes, with downward pointing arrows between them, each box labelled as each Business Unit's Data Quality Improvement Project. From there an arrow points right to a circle. Inside the circle are the steps necessary to complete the data quality improvement project.

    Create and document your data quality improvement team

    1 hour

    Input

    • Individuals who fit the data quality improvement plan team roles

    Output

    • Project team

    Materials

    • Data Quality Improvement Plan Template

    Participants

    • Data owner
    • Project Manager
    • Product Manager

    The Data Quality Improvement Plan is a concise document that should be created for each data quality project (i.e. for each business unit) to keep track of the project.

    Instructions

    1. Meet with the data owner of the business unit identified for the data quality improvement project.
    2. Identify individuals who fit the data quality improvement plan team roles.
    3. Using the Data Quality Improvement Plan Template to document the roles and individuals who will fit those roles.
    4. Have an introductory meeting with the Improvement team to clarify roles and responsibilities for the project.

    Download this Tool

    Team role Assigned to
    Data Owner [Name]
    Project Manager [Name]
    Business Analyst/BRM [Name]
    Data Steward [Name]
    Data Analyst [Name]

    Document the business context of the Data Quality Improvement Plan

    1 hour

    Input

    • Project team
    • Identified data attributes

    Output

    • Business context for the data quality improvement plan

    Materials

    • Data Quality Improvement Plan Template

    Participants

    • Data owner
    • Project Sponsor
    • Product owner

    Data quality initiatives have to be relevant to the business, and the business context will be used to provide inputs to the data improvement strategy. The context can then be used to determine exactly where the root causes of data quality issues are, which will inform your solutions.

    Instructions

    The business context of the data quality improvement plan includes documenting from previous activities:

    1. The Data Quality Improvement Team.
    2. Your Data Lineage Diagram.
    3. Your Data Quality Problem Statement.

    Info-Tech Best Practice

    While many organizations adopt data quality principles, not all organizations express them along the same terms. Have multiple perspectives within your organization outline principles that fit your unique data quality agenda. Anyone interested in resolving the day-to-day data quality issues that they face can be helpful for creating the context around the project.

    Download this tool

    Now that you have a defined problem, revisit the root causes of poor data quality

    You previously fleshed out the problem with data quality present in the business unit chosen as highest priority. Now it is time to figure out what is causing those problems.

    In the table below, you will find some of the common categories of causes of data quality issues, as well as some specific root causes.

    Category Description
    1. System/Application Design Ineffective, insufficient, or even incorrect system/application design accepts incorrect and missing data elements to the source applications and databases. The data records in those source systems may propagate into systems in tiers 2, 3, 4, and 5 of the 5-tier architecture, creating domino and ripple effects.
    2. Database design Database is created and modeled in an incorrect manner so that the management of the data records is incorrect, resulting in duplicated and orphaned records, and records that are missing data elements or records that contain incorrect data elements. Poor operational data in databases often leads to issues in tiers 2, 3, 4, and 5.
    3. Enterprise Integration Data or information is improperly integrated, transformed, masked, and aggregated in tier 2. In addition, some data integration tasks might not be timely, resulting in out-of-date data or even data that contradicts with other data. Enterprise integration is a precursor of loading a data warehouse and data marts. Issues in this layer affect tier 3, 4 and 5 on the 5-tier architecture.
    4. Policies and Procedures Policies and procedures are not effectively used to reinforce data quality. In some situations, policy gaps are found. In others, policies are overlapped and duplicated. Policies may also be out-of-date or too complex, affecting the users’ ability to interpret the policy objectives. Policies affect all tiers in the 5-tier architecture.
    5. Business Processes Improper business process design introduces poor data into the data systems. Failure to create processes around approving data changes, failure to document key data elements, and failure to train employees on the proper uses of data make data quality a burning problem.

    Leverage a root cause analysis approach to pinpoint the origins of your data issues

    A root cause analysis is a systematic approach to decompose a problem into its components. Use fishbone diagrams to help reveal the root causes of data issues.

    The image shows a fishbone diagram on the left, which starts with Process on the left, and then leads to Application and Integration, and then Database and Policies. This section is titled Root causes. The right hand section is titled Lead to problems with data... and includes 4 circles with the word or in between each. The circles are labelled: Completeness; Usability; Timeliness; Accessibility.

    Info-Tech recommends five root cause categories for assessing data quality issues:

    Application Design. Is the issue caused by human error at the application level? Consider internal employees, external partners/suppliers, and customers.

    Database Design. Is the issue caused by a particular database and stems from inadequacies in its design?

    Integration. Data integration tools may not be fully leveraged, or data matching rules may be poorly designed.

    Policies and Procedures. Do the issues take place because of lack of governance?

    Business Processes. Do the issues take place due to insufficient processes?

    For Example:

    When performing a deeper analysis of your data issues related to the accuracy of the business unit’s data, you would perform a root cause analysis by assessing the contribution of each of the five categories of data quality problem root causes:

    The image shows another fishbone diagram, with example information filled in. The first section on the left is titled Application Design, and includes the text: Data entry problems lead to incorrect accounting entries. The second is Integration, and includes the text: Data integration tools are not fully leveraged. The third section is Policies, and includes the text: No policy on standardizing name and address. The last section is Database design, with text that reads: Databases do not contain unique keys. The diagram ends with an arrow pointing right to a blue circle with Accuracy in it.

    Leverage a combination of data analysis techniques to identify and quantify root causes

    Info-Tech Insight

    Including all attributes of the key subject area in your data profiling activities may produce too much information to make sense of. Conduct data profiling primarily at the table level and undergo attribute profiling only if you are able to narrow down your scope sufficiently.

    Data Profiling Tool

    Data profiling extracts a sample of the target data set and runs it through multiple levels of analysis. The end result is a detailed report of statistics about a variety of data quality criteria (duplicate data, incomplete data, stale data, etc.).

    Many data profiling tools have built-in templates and reports to help you uncover data issues. In addition, they quantify the occurrences of the data issues.

    E-Discovery Tool

    This supplements a profiling tool. For Example, use a BI tool to create a custom grouping of all the invalid states (e.g. “CAL,” “AZN,” etc.) and visualize the percentage of invalid states compared to all states.

    SQL Queries

    This supplements a profiling tool. For example, use a SQL statement to group the customer data by customer segment and then by state to identify which segment–state combinations contain poor data.

    Identify the data issues for the particular business unit under consideration

    2 hours

    Input

    • Issues with data quality felt by the business unit
    • Data lineage diagram

    Output

    • Categorized data quality issues

    Materials

    • Whiteboard, markers, sticky notes
    • Data Quality Improvement Plan Template

    Participants

    • Data quality improvement project team
    • Business line representatives

    Instructions

    1. Gather the data quality improvement project team in a room, along with sticky notes and a whiteboard.
    2. Display your previously created data lineage diagram on the whiteboard.
    3. Using color-coded sticky notes, attach issues to each component of the data lineage diagram that team members can identify. Use different colors for the four quality attributes: Completeness, Usability, Timeliness, and Accessibility.

    Example:

    The image shows the data lineage diagram that has been shown in previous sections. In addition, the image shows 4 post-its arranges around the diagram, labelled: Usability; Completeness; Timeliness; and Accessibility.

    Map the data issues on fishbone diagrams to identify root causes

    1 hour

    Input

    • Categorized data quality issues

    Output

    • Completed fishbone diagrams

    Materials

    • Whiteboard, markers, sticky notes
    • Data Quality Improvement Plan Template

    Participants

    • Data quality improvement project team

    Now that you have data quality issues classified according to the data quality attributes, map these issues onto four fishbone diagrams.

    The image shows a fishbone diagram, which is titled Example: Root cause analysis diagram for data accuracy.

    Download this Tool

    Get to know the root causes behind system/application design mistakes

    Suboptimal system/application design provides entry points for bad data.

    Business Process
    Usually found in → Tier 1 Tier 2 Tier 3 Tier 4 Tier 5
    Issue Root Causes Usability Completeness Timeliness Accessibility
    Insufficient data mask No data mask is defined for a free-form text field in a user interface. E.g. North American phone number should have 4 masks – country code (1-digit), area code (3-digit), and local number (7-digit). X X
    Too many free-form text fields Incorrect use of free-form text fields (fields that accept a variety of inputs). E.g. Use a free-form text field for zip code instead of a backend look up. X X
    Lack of value lookup Reference data is not looked up from a reference list. E.g. State abbreviation is entered instead of being looked up from a standard list of states. X X
    Lack of mandatory field definitions Mandatory fields are not identified and reinforced. Resulting data records with many missing data elements. E.g. Some users may fill up 2 or 3 fields in a UI that has 20 non-mandatory fields. X

    The image shows a fishbone diagram, with the following sections, from left to right: Application Design; Integration; Processes; Policies; Database Design; Data Quality Measure. The Application Design section is highlighted.

    Get to know the root causes behind common database design mistakes

    Improper database design allows incorrect data to be stored and propagated.

    Business Process
    Usually found in → Tier 1 Tier 2 Tier 3 Tier 4 Tier 5
    Issue Root Causes Usability Completeness Timeliness Accessibility
    Incorrect referential integrity Referential integrity constraints are absent or incorrectly implemented, resulting in child records without parent records, or related records are updated or deleted in a cascading manner. E.g. An invoice line item is created before an invoice is created. X X
    Lack of unique keys Lack of unique keys creating scenarios where record uniqueness cannot be guaranteed. E.g. Customer records with the same customer_ID. X X
    Data range Fail to define a data range for incoming data, resulting in data values that are out of range. E.g. The age field is able to store an age of 999. X X
    Incorrect data type Incorrect data types are used to store data fields. E.g. A string field is used to store zip codes. Some users use that to store phone numbers, birthdays, etc. X X

    The image shows a fishbone diagram, with the following sections, from left to right: Application Design; Integration; Processes; Policies; Database Design; Data Quality Measure. The Database Design section is highlighted

    Get to know the root causes behind enterprise integration mistakes

    Improper data integration or synchronization may create poor analytical data.

    Business Process
    Usually found in → Tier 1 Tier 2 Tier 3 Tier 4 Tier 5
    Issue Root Causes Usability Completeness Timeliness Accessibility
    Incorrect transformation Transformation is done incorrectly. A wrong formula may have been used, transformation is done at the wrong data granularity, or aggregation logic is incorrect. E.g. Aggregation is done for all customers instead of just active customers. X X
    Data refresh is out of sync Data is synchronized at different intervals, resulting in a data warehouse where data domains are out of sync. E.g. Customer transactions are refreshed to reflect the latest activities but the account balance is not yet refreshed. X X
    Data is matched incorrectly Fail to match records from disparate systems, resulting in duplications and unmatched records. E.g. Unable to match customers from different systems because they have different cust_ID. X X
    Incorrect data mapping Fields from source systems are not properly matched with data warehouse fields. E.g. Status fields from different systems are mixed into one field. X X

    The image shows a fishbone diagram, with the following sections, from left to right: Application Design; Integration; Processes; Policies; Database Design; Data Quality Measure. The Integration section is highlighted

    Get to know the root causes behind policy and procedure mistakes

    Suboptimal policies and procedures undermine the effect of best practices.

    Business Process
    Usually found in → Tier 1 Tier 2 Tier 3 Tier 4 Tier 5
    Issue Root Causes Usability Completeness Timeliness Accessibility
    Policy Gaps There are gaps in the policy landscape in terms of some missing key policies or policies that are not refreshed to reflect the latest changes. E.g. A data entry policy is absent, leading to inconsistent data entry practices. X X
    Policy Communications Policies are in place but the policies are not communicated effectively to the organization, resulting in misinterpretation of policies and under-enforcement of policies. E.g. The data standard is created but very few developers are aware of its existence. X X
    Policy Enforcement Policies are in place but not proactively re-enforced and that leads to inconsistent application of policies and policy adoption. E.g. Policy adoption is dropping over time due to lack of reinforcement. X X
    Policy Quality Policies are written by untrained authors and they do not communicate the messages. E.g. A non-technical data user may find a policy that is loaded with technical terms confusing. X X

    The image shows a fishbone diagram, with the following sections, from left to right: Application Design; Integration; Processes; Policies; Database Design; Data Quality Measure. The Policies section is highlighted

    Get to know the root causes behind common business process mistakes

    Ineffective and inefficient business processes create entry points for poor data.

    Business Process
    Usually found in → Tier 1 Tier 2 Tier 3 Tier 4 Tier 5
    Issue Root Causes Usability Completeness Timeliness Accessibility
    Lack of training Key data personnel and business analysts are not trained in data quality and data governance, leading to lack of accountability. E.g. A data steward is not aware of downstream impact of a duplicated financial statement. X X
    Ineffective business process The same piece of information is entered into data systems two or more times. Or a piece of data is stalled in a data system for too long. E.g. A paper form is scanned multiple times to extract data into different data systems. X X
    Lack of documentation Fail to document the work flows of the key business processes. A lack of work flow results in sub-optimal use of data. E.g. Data is modeled incorrectly due to undocumented business logic. X X
    Lack of integration between business silos Business silos hold on to their own datasets resulting in data silos in which data is not shared and/or data is transferred with errors. E.g. Data from a unit is extracted as a data file and stored in a shared drive with little access. X X

    The image shows a fishbone diagram, with the following sections, from left to right: Application Design; Integration; Processes; Policies; Database Design; Data Quality Measure. The Processes section is highlighted

    Phase 3 Summary

    1. Data Lineage Diagram
    • Creating the data lineage diagram is recommended to help visualize the flow of your data and to map the data journey and identify the data subject areas to be targeted for fixes.
    • The data lineage diagram was leveraged multiple times throughout this Phase. For example, the data lineage diagram was used to document the data sources and applications used by the business unit
  • Business Context
    • Business context was documented through the Data Quality Practice Assessment and Project Planning Tool.
    • The same tool was used to document identified business units and their associated data.
    • Metrics were also identified at the business unit level to track data quality improvements.
  • Common Root Causes
    • Leverage a root cause analysis approach to pinpoint the origins of your data quality issues.
    • Analyzed and got to know the root causes behind the following:
      1. System/application design mistakes
      2. Common database design mistakes
      3. Enterprise integration mistakes
      4. Policies and procedures mistakes
      5. Common business processes mistakes
  • Phase 4

    Grow and Sustain Your Data Quality Program

    Build Your Data Quality Program

    For the identified root causes, determine the solutions for the problem

    As you worked through the previous step, you identified the root causes of your data quality problems within the business unit. Now, it is time to identify solutions.

    The following slides provide an overview of the solutions to common data quality issues. As you identify solutions that apply to the business unit being addressed, insert the solution tables in Section 4: Proposed Solutions of the Data Quality Improvement Plan Template.

    All data quality solutions have two components to them:

    • Technology
    • People

    For the next five data quality solution slides, look for the slider for the contributions of each category to the solution. Use this scale to guide you in creating solutions.

    When designing solutions, keep in mind that solutions to data quality problems are not mutually exclusive. In other words, an identified root cause may have multiple solutions that apply to it.

    For example, if an application is plagued with inaccurate data, the application design may be suboptimal, but also the process that leads to data being entered may need fixing.

    Data quality improvement strategy #1:

    Fix data quality issues by improving system/application design.

    Technology

    Application Interface Design

    Restrict field length – Capture only the characters you need for your application.

    Leverage data masks – Use data masks in standardized fields like zip code and phone number.

    Restrict the use of open text fields and use reference tables – Only present open text fields when there is a need. Use reference tables to limit data values.

    Provide options – Use radio buttons, drop-down lists, and multi-select instead of using open text fields.

    Data Validation at the Application Level

    Validate data before committing – Use simple validation to ensure the data entered is not random numbers and letters.

    Track history – Keep track of who entered what fields.

    Cannot submit twice – Only design for one-time submission.

    People

    Training

    Data-entry training – Training that is related to data entry, creating, or updating data records.

    Data resolution training – Training data stewards or other dedicated data personnel on how to resolve data records that are not entered properly.

    Continuous Improvement

    Standards – Develop application design principles and standards.

    Field testing – Field data entry with a few people to look for abnormalities and discrepancies.

    Detection and resolution – Abnormal data records should be isolated and resolved ASAP.

    Application Testing

    Thorough testing – Application design is your first line of defence against poor data. Test to ensure bad data is kept out of the systems.

    Case Study

    HMS

    Industry: Healthcare

    Source: Informatica

    Improve your data quality ingestion procedures to provide better customer intimacy for your users

    Healthcare Management Systems (HMS) provides cost containment services for healthcare sponsors and payers, and coordinates benefits services. This is to ensure that healthcare claims are paid correctly to both government agencies and individuals. To do so, HMS relies on data, and this data needs to be of high quality to ensure the correct decisions are made, the right people get the correct claims, and the appropriate parties pay out.

    To improve the integrity of HMS’s customer data, HMS put in place a framework that helped to standardize the collection of high volume and highly variable data.

    Results

    Working with a data quality platform vendor to establish a framework for data standardization, HMS was able to streamline data analysis and reduce new customer implementations from months to weeks.

    HMS data was plagued with a lack of standardization of data ingestion procedures.

    Before improving data quality processes After improving data quality processes
    Data Ingestion Data Ingestion
    Many standards of ingestion. Standardized data ingestion
    Data Storage Data Storage
    Lack of ability to match data, creating data quality errors.
    Data Analysis Data Analysis
    = =
    Slow Customer Implementation Time 50% Reduction in Customer Implementation Time

    Data quality improvement strategy #2:

    Fix data quality issues using proper database design.

    Technology

    Database Design Best Practices

    Referential integrity – Ensure parent/child relationships are maintained in terms of cascade creation, update, and deletion.

    Primary key definition – Ensure there is at least one key to guarantee the uniqueness of the data records, and primary key should not allow null.

    Validate data domain – Create triggers to check the data values entered in the database fields.

    Field type and length – Define the most suitable data type and length to hold field values.

    One-Time Data Fix (more on the next slide)

    Explore solutions – Where to fix the data issues? Is there a case to fix the issues?

    Running profiling tools to catch errors – Run scans on the database with defined criteria to identify occurrences of questionable data.

    Fix a sample before fixing all records – Use a proof-of-concept approach to explore fix options and evaluate impacts before fixing the full set.

    People

    The DBA Team

    Perform key tasks in pairs – Take a pair approach to perform key tasks so that validation and cross-check can happen.

    Skilled DBAs – DBAs should be certified and accredited.

    Competence – Assess DBA competency on an ongoing basis.

    Preparedness – Develop drills to stimulate data issues and train DBAs.

    Cross train – Cross train team members so that one DBA can cover another DBA.

    Data quality improvement strategy #3:

    Improve integration and synchronization of enterprise data.

    Technology

    Integration Architecture

    Info-Tech’s 5-Tier Architecture – When doing transformations, it is good practice to persist the integration results in tier 3 before the data is further refined and presented in tier 4.

    Timing, timing, and timing – Think of the sequence of events. You may need to perform some ETL tasks before other tasks to achieve synchronization and consistence.

    Historical changes – Ensure your tier 3 is robust enough to include historical data. You need to enable type 2 slowly, changing dimension to recreate the data at a point in time.

    Data Cleansing

    Standardize – Leverage data standardization to standardize name and address fields to improve matching and integration.

    Fuzzy matching – When there are no common keys between datasets. The datasets can only be matched by fuzzy matching. Fuzzy matching is not hard science; define a confidence level and think about a mechanism to deal with the unmatched.

    People

    Reporting and Documentations

    Business data glossary and data lineage – Define a business data glossary to enhance findability of key data elements. Document data mappings and ETL logics.

    Create data quality reports – Many ETL platforms provide canned data quality reports. Leverage those quality reports to monitor the data health.

    Code Review

    Create data quality reports – Many ETL platforms provide canned data quality reports. Leverage those quality reports to monitor the data health.

    ARB (architectural review board) – All ETL codes should be approved by the architectural review board to ensure alignment with the overall integration strategy.

    Data quality improvement strategy #4:

    Improve data quality policies and procedures.

    Technology

    Policy Reporting

    Data quality reports – Leverage canned data quality reports from the ETL platforms to monitor data quality on an on-going basis. When abnormalities are found, provoke the right policies to deal with the issues.

    Store policies in a central location that is well known and easy to find and access. A key way that technology can help communicate policies is by having them published on a centralized website.

    Make the repository searchable and easily navigable. myPolicies helps you do all this and more.

    myPolicies helps you do all this and more.

    Go to this link

    People

    Policy Review and Training

    Policy review – Create a schedule for reviewing policies on a regular basis – invite professional writers to ensure polices are understandable.

    Policy training – Policies are often unread and misread. Training users and stakeholders on policies is an effective way to make sure those users and stakeholders understand the rationale of the policies. It is also a good practice to include a few scenarios that are handled by the policies.

    Policy hotline/mailbox – To avoid misinterpretation of the policies, a policy hotline/mailbox should be set up to answer any data policy questions from the end users/stakeholders.

    Policy Communications

    Simplified communications – Create handy one-pagers and infographic posters to communicate the key messages of the polices.

    Policy briefing – Whenever a new data project is initiated, a briefing of data policies should be given to ensure the project team follows the policies from the very beginning.

    Data quality improvement strategy #5:

    Streamline and optimize business processes.

    Technology

    Requirements Gathering

    Data Lineage – Leverage a metadata management tool to construct and document data lineage for future reference.

    Documentations Repository – It is a best practice to document key project information and share that knowledge across the project team and with the stakeholder. An improvement understanding of the project helps to identify data quality issues early on in the project.

    “Automating creation of data would help data quality most. You have to look at existing processes and create data signatures. You can then derive data off those data codes.” – Patrick Bossey, Manager of Business Intelligence, Crawford and Company

    People

    Requirements Gathering

    Info-Tech’s 4-Column Model – The datasets may exist but the business units do not have an effective way of communicating the quality needs. Use our four-column model and the eleven supporting questions to better understand the quality needs. See subsequent slides.

    I don’t know what the data means so I think the quality is poor – It is not uncommon to see that the right data presented to the business but the business does not trust the data. They also do not understand the business logic done on the data. See our Business Data Glossary in subsequent slides.

    Understand the business workflow – Know the business workflow to understand the manual steps associated with the workflow. You may find steps in which data is entered, manipulated, or consumed inappropriately.

    “Do a shadow data exercise where you identify the human workflows of how data gets entered, and then you can identify where data entry can be automated.” – Diraj Goel, Growth Advisor, BC Tech

    Brainstorm solutions to your data quality issues

    4 hours

    Input

    • Data profiling results
    • Preliminary root cause analyses

    Output

    • Proposals for data fix
    • Fixed issues

    Materials

    • Data Quality Improvement Plan Template

    Participants

    • Business and Data Analysts
    • Data experts and stewards

    After walking through the best-practice solutions to data quality issues, propose solutions to fix your identified issues.

    Instructions

    1. Review Root Cause Analyses: Revisit the root cause analysis and data lineage diagram you have generated in Step 3.2. to understand the issues in greater details.
    2. Characterize Each Issue: You may need to generate a data profiling report to characterize the issue. The report can be generated by using data quality suites, BI platforms, or even SQL statements.
    3. Brainstorm the Solutions: As a group, discuss potential ways to fix the issue. You can tackle the issues by approaching from these areas:
    Solution Approaches
    Technology Approach
    People Approach

    X crossover with

    Problematic Areas
    Application/System Design
    Database Design
    Data Integration and Synchronization
    Policies and Procedures
    Business Processes
    1. Document and Communicate: Document the solutions to your data issues. You may need to reuse or refer to the solutions. Also brainstorm some ideas on how to communicate the results back to the business.

    Download this Tool

    Sustaining your data quality requires continuous oversight through a data governance practice

    Quality data is the ultimate outcome of data governance and data quality management. Data governance enables data quality by providing the necessary oversight and controls for business processes in order to maintain data quality. There are three primary groups (at right) that are involved in a mature governance practice. Data quality should be tightly integrated with all of them.

    Define an effective data governance strategy and ensure the strategy integrates well with data quality with Info-Tech’s Establish Data Governance blueprint.

    Visit this link

    Data Governance Council

    This council establishes data management practices that span across the organization. This should be comprised of senior management or C-suite executives that can represent the various departments and lines of business within the organization. The data governance council can help to promote the value of data governance, facilitate a culture that nurtures data quality, and ensure that the goals of the data governance program are well aligned with business objectives.

    Data Owners

    Identifying the data owner role within an organization helps to create a greater degree of accountability for data issues. They often oversee how the data is being generated as well as how it is being consumed. Data owners come from the business side and have legal rights and defined control over a data set. They ensure data is available to the right people within the organization.

    Data Stewards

    Conflict can occur within an organization’s data governance program when a data steward’s role is confused with that of the steering committee’s role. Data stewards exist to enforce decisions made about data governance and data management. Data stewards are often business analysts or power users of a particular system/dataset. Where a data owner is primarily responsible for access, a data steward is responsible for the quality of a dataset.

    Integrate the data quality management strategy with existing data governance committees

    Ongoing and regular data quality management is the responsibility of the data governance bodies of the organization.

    The oversight of ongoing data quality activities rests on the shoulders of the data governance committees that exist in the organization.

    There is no one-size-fits-all data governance structure. However, most organizations follow a similar pattern when establishing committees, councils, and cross-functional groups. They strive to identify roles and responsibilities at a strategic, tactical, and operational level:

    The image shows a pyramid, with Executive Sponsors at the top, with the following roles in descending order: DG Council; Steering Committee; Working Groups; Data Owners and Data Stewards; and Data Users. Along the left side of the pyramid, there are three labels, in ascending order: Operational, Tactical, and Strategic.

    The image is a flow chart showing project roles, in two sections: the top section is labelled Governing Bodies, and the lower section is labelled Data Quality Improvement Team. There is a note indicating that the Data Owner reports to and provides updates regarding the state of data quality and data quality initiatives.

    Create and update the organization’s Business Data Glossary to keep up with current data definitions

    2 hours

    Input

    • Metrics and goals for data quality

    Output

    • Regularly scheduled data quality checkups

    Materials

    • Business Data Glossary Template
    • Data Quality Dashboard

    Participants

    • Data steward

    A crucial aspect of data quality and governance is the Business Data Glossary. The Business Data Glossary helps to align the terminology of the business with the organization’s data assets. It allows the people who interact with the data to quickly identify the applications, processes, and stewardship associated with it, which will enhance the accuracy and efficiency of searches for organization data definitions and attributes, enabling better access to the data. This will, in turn, enhance the quality of the organization’s data because it will be more accurate, relevant, and accessible.

    Use the Business Data Glossary Template to document key aspects of the data, such as:

    • Definition
    • Source System
    • Possible Values
    • Data Steward
    • Data Sensitivity
    • Data Availability
    • Batch or Live
    • Retention

    Data Element

    • Mkt-Product
    • Fin-Product

    Info-Tech Insight

    The Business Data Glossary ensures that the crucial data that has key business use by key business systems and users is appropriately owned and defined. It also establishes rules that lead to proper data management and quality to be enforced by the data owners.

    Download this Tool

    Data Steward(s): Use the Data Quality Improvement Plan of the business unit for ongoing quality monitoring

    Integrating your data quality strategy into the organization’s data governance program requires passing the strategy over to members of the data governance program. The data steward role is responsible for data quality at the business unit level, and should have been involved with the creation and implementation of the data quality improvement project. After the data quality repairs have been made, it is the responsibility of the data steward to regularly monitor the quality of the business unit’s data.

    Create Improvement Plan ↓
    • Data Quality Improvement Team identifies root cause issues.
    • Brainstorm solutions.
    Implement Improvement Plan ↓
    • Data Quality Improvement Team works with IT.
    Sustain Improvement Plan
    • Data Steward should regularly monitor data quality.

    Download this tool

    See Info-Tech’s Data Steward Job Description Template for a detailed understanding of the roles and responsibilities of the data steward.

    Responsible for sustaining

    The image shows a screen capture of a document entitled Business Context & Subject Area Selection.

    Develop a business-facing data quality dashboard to show improvements or a sudden dip in data quality

    One tool that the data steward can take advantage of is the data quality dashboard. Initiatives that are implemented to address data quality must have metrics defined by business objectives in order to demonstrate the value of the data quality improvement projects. In addition, the data steward should have tools for tracking data quality in the business unit to report issues to the data owner and data governance steering committee.

    • Example 1: Marketing uses data for direct mail and e-marketing campaigns. They care about customer data in particular. Specifically, they require high data quality in attributes such as customer name, address, and product profile.
    • Example 2: Alternatively, Finance places emphasis on financial data, focusing on attributes like account balance, latency in payment, credit score, and billing date.

    The image is Business dashboard on Data Quality for Marketing. It features Data Quality metrics, listed in the left column, and numbers for each quarter over the course of one year, on the right.

    Notes on chart:

    General improvement in billing address quality

    Sudden drop in touchpoint accuracy may prompt business to ask for explanations

    Approach to creating a business-facing data quality dashboard:

    1. Schedule a meeting with the functional unit to discuss what key data quality metrics are essential to their business operations. You should consider the business context, functional area, and subject area analyses you completed in Phase 1 as a starting point.
    2. Discuss how to gather data for the key metrics and their associated calculations.
    3. Discuss and decide the reporting intervals.
    4. Discuss and decide the unit of measurement.
    5. Generate a dashboard similar to the example. Consider using a BI or analytics tool to develop the dashboard.

    Data quality management must be sustained for ongoing improvements to the organization’s data

    • Data quality is never truly complete; it is a set of ongoing processes and disciplines that requires a permanent plan for monitoring practices, reviewing processes, and maintaining consistent data standards.
    • Setting the expectation to stakeholders that a long-term commitment is required to maintain quality data within the organization is critical to the success of the program.
    • A data quality maintenance program will continually revise and fine-tune ongoing practices, processes, and procedures employed for organizational data management.

    Data quality is a program that requires continual care:

    →Maintain→Good Data →

    Data quality management is a long-term commitment that shifts how an organization views, manages, and utilizes its corporate data assets. Long-term buy-in from all involved is critical.

    “Data quality is a process. We are trying to constantly improve the quality over time. It is not a one-time fix.” – Akin Akinwumi, Manager of Data Governance, Startech.com

    Define a data quality review agenda for data quality sustainment

    2 hours

    Input

    • Metrics and goals for data quality

    Output

    • Regularly scheduled data quality checkups

    Materials

    • Data Quality Diagnostic
    • Data Quality Dashboard

    Participants

    • Data Steward

    As a data steward, you are responsible for ongoing data quality checks of the business unit’s data. Define an improvement agenda to organize the improvement activities. Organize the activities yearly and quarterly to ensure improvement is done year-round.

    Quarterly

    • Measure data quality metrics against milestones. Perform a regular data quality health check with Info-Tech’s Data Quality Diagnostic.
    • Review the business unit’s Business Data Glossary to ensure that it is up to date and comprehensive.
    • Assess progress of practice area initiatives (time, milestones, budget, benefits delivered).
    • Analyze overall data quality and report progress on key improvement projects and corrective actions in the executive dashboard.
    • Communicate overall status of data quality to oversight body.

    Annually

    • Calculate your current baseline and measure progress by comparing it to previous years.
    • Set/revise quality objectives for each practice area and inter-practice hand-off processes.
    • Re-evaluate/re-establish data quality objectives.
    • Set/review data quality metrics and tracking mechanisms.
    • Set data quality review milestones and timelines.
    • Revisit data quality training from an end-user perspective and from a practitioner perspective.

    Info-Tech Insight

    Do data quality diagnostic at the beginning of any improvement plan, then recheck health with the diagnostic at regular intervals to see if symptoms are coming back. This should be a monitoring activity, not a data quality fixing activity. If symptoms are bad enough, repeat the improvement plan process.

    Take the next step in your Data & Analytics Journey

    After establishing your data quality program, look to increase your data & analytics maturity.

    • Artificial Intelligence (AI) is a concept that many organizations strive to implement. AI can really help in areas such as data preparation. However, implementing AI solutions requires a level of maturity that many organizations are not at.
    • While a solid data quality foundation is essential for AI initiatives being successful, AI can also ensure high data quality.
    • An AI analytics solution can address data integrity issues at the earliest point of data processing, rapidly transforming these vast volumes of data into trusted business information. This can be done through Anomaly detection, which flags “bad” data, identifying suspicious anomalies that can impact data quality. By tracking and evaluating data, anomaly detection gives critical insights into data quality as data is processed. (Ira Cohen, The End to a Never-Ending Story? Improve Data Quality with AI Analytics, anodot, 2020)

    Consider… “Garbage in, garbage out.”

    Lay a solid foundation by addressing your data quality issues prior to investing heavily in an AI solution.

    Related Info-Tech Research

    Are You Ready for AI?

    • Use AI as a compelling event to expedite funding, resources, and project plans for your data-related initiatives. Check out this note to understand what it takes to be ready to implement AI solutions.

    Get Started With Artificial Intelligence

    • Current AI technology is data-enabled, automated, adaptive decision support. Once you believe you are ready for AI, check out this blueprint on how to get started.

    Build a Data Architecture Roadmap

    • The data lineage diagram was a key tool used in establishing your data quality program. Check out this blueprint and learn how to optimize your data architecture to provide greatest value from data.

    Create an Architecture for AI

    • Build your target state architecture from predefined best practice building blocks. This blueprint assists members first to assess if they have the maturity to embrace AI in their organization, and if so, which AI acquisition model fits them best.

    Phase 4 Summary

    1. Data Quality Improvement Strategy
    • Brainstorm solutions to your data quality issues using the following data quality improvement strategies as a guide:
      1. Fix data quality issues by improving system/application design
      2. Fix data quality issues using proper database design
      3. Improve integration and synchronization of enterprise data
      4. Improve data quality policies and procedures
      5. Streamline and optimize business processes
  • Sustain Your Data Quality Program
    • Quality data is the ultimate outcome of data governance and data quality management.
    • Sustaining your data quality requires continuous oversight through a data governance practice.
    • There are three primary groups (Data Governance Council, Data Owners, and Data Stewards) that are involved in a mature governance practice.
  • Grow Your Data & Analytics Maturity
    • After establishing your data quality program, take the next step in increasing your data & analytics maturity.
    • Good data quality is the foundation of pursuing different ways of maximizing the value of your data such as implementing AI solutions.
    • Continue your data & analytics journey by referring to Info-Tech’s quality research.
  • Research Contributors and Experts

    Izabela Edmunds

    Information Architect Mott MacDonald

    Akin Akinwumi

    Manager of Data Governance Startech.com

    Diraj Goel

    Growth Advisor BC Tech

    Sujay Deb

    Director of Data Analytics Technology and Platforms Export Development Canada

    Asif Mumtaz

    Data & Solution Architect Blue Cross Blue Shield Association

    Patrick Bossey

    Manager of Business Intelligence Crawford and Company

    Anonymous Contributors

    Ibrahim Abdel-Kader

    Research Specialist Info-Tech Research Group

    Ibrahim is a Research Specialist at Info-Tech Research Group. In his career to date he has assisted many clients using his knowledge in process design, knowledge management, SharePoint for ECM, and more. He is expanding his familiarity in many areas such as data and analytics, enterprise architecture, and CIO-related topics.

    Reddy Doddipalli

    Senior Workshop Director Info-Tech Research Group

    Reddy is a Senior Workshop Director at Info-Tech Research Group, focused on data management and specialized analytics applications. He has over 25 years of strong industry experience in IT leading and managing analytics suite of solutions, enterprise data management, enterprise architecture, and artificial intelligence–based complex expert systems.

    Andy Neill

    Practice Lead, Data & Analytics and Enterprise Architecture Info-Tech Research Group

    Andy leads the data and analytics and enterprise architecture practices at ITRG. He has over 15 years of experience in managing technical teams, information architecture, data modeling, and enterprise data strategy. He is an expert in enterprise data architecture, data integration, data standards, data strategy, big data, and development of industry standard data models.

    Crystal Singh

    Research Director, Data & Analytics Info-Tech Research Group

    Crystal is a Research Director at Info-Tech Research Group. She brings a diverse and global perspective to her role, drawing from her professional experiences in various industries and locations. Prior to joining Info-Tech, Crystal led the Enterprise Data Services function at Rogers Communications, one of Canada’s leading telecommunications companies.

    Igor Ikonnikov

    Research Director, Data & Analytics Info-Tech Research Group

    Igor is a Research Director at Info-Tech Research Group. He has extensive experience in strategy formation and execution in the information management domain, including master data management, data governance, knowledge management, enterprise content management, big data, and analytics.

    Andrea Malick

    Research Director, Data & Analytics Info-Tech Research Group

    Andrea Malick is a Research Director at Info-Tech Research Group, focused on building best practices knowledge in the enterprise information management domain, with corporate and consulting leadership in enterprise architecture and content management (ECM).

    Natalia Modjeska

    Research Director, Data & Analytics Info-Tech Research Group

    Natalia Modjeska is a Research Director at Info-Tech Research Group. She advises members on topics related to AI, machine learning, advanced analytics, and data science, including ethics and governance. Natalia has over 15 years of experience in developing, selling, and implementing analytical solutions.

    Rajesh Parab

    Research Director, Data & Analytics Info-Tech Research Group

    Rajesh Parab is a Research Director at Info-Tech Research Group. He has over 20 years of global experience and brings a unique mix of technology and business acumen. He has worked on many data-driven business applications. In his previous architecture roles, Rajesh created a number of product roadmaps, technology strategies, and models.

    Bibliography

    Amidon, Kirk. "Case Study: How Data Quality Has Evolved at MathWorks." The Fifth MIT Information Quality Industry Symposium. 13 July 2011. Web. 19 Aug. 2015.

    Boulton, Clint. “Disconnect between CIOs and LOB managers weakens data quality.” CIO. 05 February 2016. Accessed June 2020.

    COBIT 5: Enabling Information. Rolling Meadows, IL: ISACA, 2013. Web.

    Cohen, Ira. “The End to a Never-Ending Story? Improve Data Quality with AI Analytics.” anodot. 2020.

    “DAMA Guide to the Data Management Body of Knowledge (DAMA-DMBOK Guide).” First Edition. DAMA International. 2009. Digital. April 2014.

    "Data Profiling: Underpinning Data Quality Management." Pitney Bowes. Pitney Bowes - Group 1 Software, 2007. Web. 18 Aug. 2015.

    Data.com. “Data.com Clean.” Salesforce. 2016. Web. 18 Aug. 2015.

    “Dawn of the CDO." Experian Data Quality. 2015. Web. 18 Aug. 2015.

    Demirkan, Haluk, and Bulent Dal. "Why Do So Many Analytics Projects Fail?" The Data Economy: Why Do so Many Analytics Projects Fail? Analytics Magazine. July-Aug. 2014. Web.

    Dignan, Larry. “CIOs juggling digital transformation pace, bad data, cloud lock-in and business alignment.” ZDNet. 11 March 2020. Accessed July.

    Dumbleton, Janani, and Derek Munro. "Global Data Quality Research - Discussion Paper 2015." Experian Data Quality. 2015. Web. 18 Aug. 2015.

    Eckerson, Wayne W. "Data Quality and the Bottom Line - Achieving Business Success through a Commitment to High Quality Data." The Data Warehouse Institute. 2002. Web. 18 Aug. 2015.

    “Infographic: Data Quality in BI the Costs and Benefits.” HaloBI. 2015 Web.

    Lee, Y.W. and Strong, D.M. “Knowing-Why About Data Processes and Data Quality.” Journal of Management Information Systems. 2004.

    “Making Data Quality a Way of Life.” Cognizant. 2014. Web. 18 Aug. 2015.

    "Merck Serono Achieves Single Source of Truth with Comprehensive RIM Solutions." www.productlifegroup.com. ProductLife Group. 15 Apr. 2015. Web. 23 Nov. 2015.

    Myers, Dan. “List of Conformed Dimensions of Data Quality.” Conformed Dimensions of Data Quality (CDDQ). 2019. Web.

    Redman, Thomas C. “Make the Case for Better Data Quality.” Harvard Business Review. 24 Aug. 2012. Web. 19 Aug. 2015.

    RingLead Data Management Solutions. “10 Stats About Data Quality I Bet You Didn’t Know.” RingLead. Accessed 7 July 2020.

    Schwartzrock, Todd. "Chrysler's Data Quality Management Case Study." Online video clip. YouTube. 21 April. 2011. Web. 18 Aug. 2015

    “Taking control in the digital age.” Experian Data Quality. Jan 2019. Web.

    “The data-driven organization, a transformation in progress.” Experian Data Quality. 2020. Web.

    "The Data Quality Benchmark Report." Experian Data Quality. Jan. 2015. Web. 18 Aug. 2015.

    “The state of data quality.” Experian Data Quality. Sept. 2013. Web. 17 Aug. 2015.

    Vincent, Lanny. “Differentiating Competence, Capability and Capacity.” Innovation Management Services. Web. June 2008.

    “7 ways poor data quality is costing your business.” Experian Data Quality. July 2020. Web.

    Infrastructure and Operations Priorities 2023

    • Buy Link or Shortcode: {j2store}54|cart{/j2store}
    • member rating overall impact: N/A
    • member rating average dollars saved: N/A
    • member rating average days saved: N/A
    • Parent Category Name: Disruptive & Emerging Technologies
    • Parent Category Link: /disruptive-emerging-technologies
    • Get out of your I&O silo. I&O teams must be expected to work alongside and integrate with cyber security operations.
    • Being unprepared for new ESG reporting mandates without a clear and validated ESG reporting process puts your organization at risk.
    • Get ahead of inflationary pressures with early budgetary planning and identify the gap between the catchup projects and required critical net new investments.

    Our Advice

    Critical Insight

    • Establish I&O within an AI governance program to build trust in AI results, behaviors, and limit legal exposure.
    • Develop data governance program that includes an I&O data steward for oversight.
    • Ready or not, the metaverse is coming to an infrastructure near you. Start expanding I&O technologies and processes to support a metaverse infrastructure.

    Impact and Result

    • Provide a framework that highlight the impacts the threats of an economic slowdown, growing regulatory reporting requirements, cyber security attacks and opportunity that smart governance over AI, data stewardship and the looming explosion of augmented reality and Web 3.0 technologies.
    • Info-Tech can help communicate your I&O priorities into compelling cases for your stakeholders.

    Infrastructure and Operations Priorities 2023 Research & Tools

    Besides the small introduction, subscribers and consulting clients within this management domain have access to:

    1. Infrastructure & Operations Priorities 2023 – A framework to dive deeper into the trends most relevant to you and your organization

    Discover Info-Tech's six priorities for Infrastructure & Operations leaders.

    Infographic

    Further reading

    Infrastructure &Operations Priorities 2023

    Navigate the liminal space between threats and opportunities.

    2023: A liminal space between threats and opportunities

    Over the last several years, successful CEOs turned to their Infrastructure and Operations (I&O) departments to survive the effects of the pandemic. It was I&O leaders who were able to reconfigure critical infrastructure on the fly to support remote work, adapt to critical supply chain shortages, and work with lines of business managers to innovate operational workflows.

    2023 promises to bring a new set of challenges. Building on the credibility established during the pandemic, I&O is in a unique position to influence the direction a business will take to be successful in a time of austerity.

    I&O members are going to be asked to mitigate the threats of volatility from recession pressures, new cybersecurity attacks, and operational process and litigation from regulatory mandates. At the same time, I&O members are being asked for fundamental digital transformation items to realize long-term opportunities to their organizations in 2023.

    Seemingly counter-intuitive in a time of economic slowdown, organizations in 2023 will want to start the groundwork to realizing the I&O opportunities that unstructured data and artificial intelligence have promised, while prepping for what has been mislabeled as the Metaverse.

    If you are in a traditionally risk adverse industry, you’re more likely to be impacted by the threat mitigation.

    Opportunistic I&O members will use 2023 to proactively jumpstart digital transformation.

    Introduction

    Welcome to the Info-Tech 2023 I&O Priorities Report

    If I&O members learned anything from the last few years, it’s how to tactically respond to the disruptive waves often arising from sources external to the organization. The good news is that Info-Tech’s I&O priorities report provides forward-looking insights to help members become more proactive to the tsunami of change predicted in our Trends Report to happen over the next three to five years.

    Info-Tech I&O priorities are generated through a phased approach. The first phase senses and identifies mega and macro tends in the digital landscape to formulate hypotheses about the trends for the next three to five years. These hypotheses are validated by sending out a survey to Info-Tech members. The responses from 813 members was used to produce an Info-Tech Trends Report focused on major long-term trends.

    The I&O Priorities were determined by combining the I&O member responses within the Info-tech Trends Survey with insightful signals from secondary research, economic markets, regulatory bodies, industry organizations, and vendors. The six I&O priorities identified in this report are presented in a framework that highlight the impacts of an economic slowdown, growing regulatory reporting requirements, cybersecurity threats, smart governance of AI, embracing stewardship of data, and the looming explosion of augmented reality and Web 3.0 technologies.

    We also have a challenge exercise to help you communicate which priorities to focus your I&O organization on. Additionally, we linked some Info-tech research and tools related to the priorities that help your I&O organization formulate actionable plans for each area.

    Priorities

    Six forward-looking priorities for the next year.

    Focus

    Activity to help select which priorities are relevant for you.

    Actions

    Actionable Info-tech research and tools to help you deliver.

    Infrastructure & Operations priorities

    The I&O priorities were determined by combining I&O member responses from the Tech Trends and Priorities 2023 survey with insightful signals from secondary research, economic markets, regulatory bodies, industry organizations, and vendors.

    The image contains a screenshot of the Infrastructure & Operations priorities.

    I&O Priorities 2023

    The image contains a screenshot of the I&O Priorities.

    I&O priorities framework

    Threats signals

    Enhance I&O Cybersecurity

    Produce ESG Reporting

    Recession Readiness

    Get out of your silo. Forget your job description and start doing what needs to be done.

    Infrastructure rarely has authority in these areas, but somehow it ends up with many of the responsibilities. You can't afford to be reactive. Forget about your traditional silo and get out in front of these topics. Not in your job description? Find out whose job it is and make them aware. Better yet – take charge! If you're going to be responsible you might as well be in control.

    Opportunities signals

    AI Governance: Watching the Watchers

    Prep for A Brave New Metaverse

    Data Governance: Cornerstone of Value

    Proper stewardship of data is an I&O must. If thought you had problems with your unstructured data, wait until you see the data sprawl coming from the metaverse.

    I&O needs to be so much more than just an order taker for the dev teams and lines of business. The sprawl of unstructured data in Word, Excel, PDF and PowerPoint was bad historically; imagine those same problems at metaverse scale! Simple storage and connectivity is no longer enough – I&O must move upstream with more sophisticated service and product offerings generated through proper governance and stewardship.

    Challenge: Expand the I&O border

    The hidden message in this report is that I&O priorities extend beyond the traditional scope of I&O functions. I&O members need to collaborate across functional areas to successfully address the priorities presented in this report.

    Info-Tech can help! Align your priorities with our material on how to Build a Business-Aligned IT Strategy. Use a modified version of the Strategy Initiative Template (next slide) to convey your strong opinion on the priorities you need your stakeholders to know about. And do so in a way that is familiar so they will easily understand.

    The image contains a screenshot of Info-Tech's Maturity Ladder.
    Info-Tech 2023 Trends Survey Results

    Call your Executive Advisor or Counselor to help identify the one or two key messages you want to bring forward for success in 2023!

    Info-Tech IT Strategy Initiative Template, from the IT Strategy Presentation Template & Priorities Report Initiative Template

    .
    The image contains a screenshot of a template for your priorities.

    Protect from threats

    Get out of your silo. Forget your job description and just start doing what needs to be done.

    Enhance I&O Cybersecurity

    Produce ESG Reporting

    Recession Readiness

    Enhance cybersecurity response

    SIGNALS

    Cybersecurity incidents are
    a clear and present danger
    to I&O members.

    Cybersecurity incidents have
    a large financial impact
    on organizations.

    Related Info-Tech Research

    Of the surveyed I&O members, 53% identified cybersecurity incidents as the number one threat disrupting their operations in 2023. It’s understandable, as over 18% of surveyed I&O members experienced a cybersecurity incident in 2022. Alarmingly, 10% of surveyed I&O members didn’t know if they had a cybersecurity incident. The impact to the organization was with 14% of those incidents directly impacting their organizations for anywhere from 6 to 60 days.

    The 2022 report “Cost of a Data Breach” was conducted by IBM and the Ponemon Institute using data from 550 companies (across 17 countries) that experienced a security incident during a 12-month period ending in March 2022. It highlighted that the average total organizational cost of a security breach globally was USD 4.35M (locally these numbers expand to USA at USD 9.44M, Canada at USD 5.64, UK at USD 5.05M, Germany at USD 4.85M).

    (Source: IBM, 2022)

    Enhance cybersecurity response

    SIGNALS

    Organizations' exposure comes from internal and external sources.

    The right tools and process can reduce the impact of a cybersecurity incident.

    Related Info-Tech Research

    The IBM/Ponemon Institute report highlighted the following:

    • 59% of organizations didn’t deploy a zero-trust architecture on critical infrastructure to reduce exposure.
    • 19% of the breaches originated from within their business partner eco-system.
    • 45% were cloud-based.

    (Source: IBM, 2022)

    The IBM/Ponemon Institute report also identified technologies and procedures to reduce the fiscal impacts of cybersecurity breaches. Having a dedicated security incident response team with a regularly tested plan reduced the incident cost by an average of USD 2.66M. A fully implemented AI security deduction and response automation system can provide average incident savings of 27.6%.

    Enhance cybersecurity response

    SIGNALS

    Cybersecurity spending is a major and expanding expenditure for our members.

    Cybersecurity is going
    to include brand misinformation.

    For 36% of surveyed I&O members, cybersecurity consumed between 10-20% of their total budget in 2022. Moreover, cybersecurity defense funding is expected to increase for 57% of I&O members.

    A third of surveyed I&O members viewed misinformation as a major risk to their organization for 2023 and 2024. Only 38% of the I&O members reported that they will have software in place to monitor and manage social media posts.

    Increasing environment and regulatory complexity demands more sophisticated cybersecurity operations.

    Infrastructure teams must be expected to work alongside and integrate with cybersecurity operations.

    Enhance cybersecurity response

    CALL TO ACTION

    Get out of your I&O silo and form cross-functional cybersecurity teams.

    I&O priority actions

    Establish a cross-functional security steering committee to coordinate security processes and technologies. The complexity of managing security across modern applications, cloud, IoT, and network infrastructure that members operate is greater than ever before and requires coordinated teamwork.

    Contain the cyber threat with zero trust (ZT) architecture. Extend ZT to network and critical infrastructure to limit exposure.

    Leverage AI to build vigilant security intelligence. Smart I&O operators will make use of AI automation to augment their security technologies to help detect threats and contain security incidents on critical infrastructure.

    Enhance cybersecurity response

    I&O priority actions

    Build specialized cybersecurity incident management protocols with your service desk. Build integrated security focused teams within service desk operations that continually test and improve security incident response protocols internally and with specialized security vendors. In some organizations, security incident response teams extend beyond traditional infrastructure into social media. Work cross-functionally to determine the risk exposure to misinformation and incident response procedures.

    Treat lost or stolen equipment as a security incident. Develop hardware asset management protocols for tracking and reporting on these incidents and keep a record of equipment disposal. Implement tools that allow for remote deletion of data and report on lost or stolen equipment.

    Produce ESG reporting

    SIGNALS

    Government mandates present an operational risk to I&O members.

    ESG reporting is
    often incomplete.

    Related Info-Tech Research

    Surveyed members identified government-enacted policy changes to be a top risk to disrupting to their business operations in 2023. One of the trends identified by Info-Tech is that the impact of regulations on environmental, social, and governance (ESG) reporting are being rolled out by governments worldwide.

    Alarmingly, only 7% of surveyed members responded that they could very accurately report on their carbon footprint and 23% said they were not able to report accurately at all.

    Produce ESG reporting

    SIGNALS

    ESG mandates are being rolled out globally.

    ESG reporting has greatly expanded since a 2017 report by Task Force on Climate-Related Financial Disclosures (TCFD, 2017) which recommended that organizations disclose climate-related financial metrics for investors to appropriately price climate-related risks to share price. In 2021, the Swiss Finance Institute research paper (Sautner, 2021) identified 29 countries that require ESG reporting, primarily for larger public companies, financial institutions, and state-owned corporations.

    Global ESG mandates

    The image contains a screenshot of a world map that demonstrates the Global ESG Mandates.

    29 nations with ESG mandates identified by the Swiss Finance Institute

    Produce ESG reporting

    SIGNALS

    ESG mandates are being rolled out globally.

    The EU has mandated ESG reporting for approximately 11,700 large public companies with more than 500 employees under the Non-Financial Reporting Directive (NFRD), since 2014. The EU is going to replace the NFRD with the Corporate Sustainability Reporting Directive (European Council, 2022), which has set a 3-year timetable for escalating the ESG reporting level to what is estimated to be about 75% of EU total turnover (WorldFavor, 2022).

    • 2024: Companies with 500 or more employees.
    • 2025: Companies with 250 or more employee or 40M EU in revenue/20M in total assets.
    • 2026: SMEs, smaller credit financial, and captive insurance institutions.

    It's been a long time since most enterprises had to report on things like power efficiency factors.

    But don't think that being in the cloud will insulate you from a renewed interest in ESG reporting.

    Produce ESG reporting

    CALL TO ACTION

    Being unprepared for new ESG reporting mandates without a clear and validated ESG reporting process puts your organization at risk.

    I&O priority actions

    Understand ESG risk exposure. Define the gap between what ESG reporting is required in your jurisdiction and current reporting capabilities to meet them. Build the I&O role with responsibility for ESG reporting.

    Include vendors in ESG reporting. Review infrastructure facilities with landlords, utilities, and hosting providers to see if they can provide ESG reporting on sustainable power generation, then map it to I&O power consumption as part of their contractual obligations. Ask equipment vendors to provide ESG reporting on manufacturing materials and energy consumption to boot-strap data collection.

    Implement a HAM process to track asset disposal and other types of e-waste. Update agreements with disposal vendors to get reporting on waste and recycle volumes.

    Produce ESG reporting

    I&O priority actions

    Implement an ESG reporting framework. There are five major ESG reporting frameworks being used globally. Select one of the frameworks below that makes sense for your organization, and implement it.

    ISO 14001 Environmental Management: Part of the ISO Technical Committee family of standards that allows your organization to understand its legal requirements to become certified in ESG.

    Global Reporting Initiative (GRI) Sustainability Reporting Standards: GRI has been developing ESG reporting standards since 1997. GRI provides a modular ESG framework applicable to all sizes and sectors of organizations worldwide.

    Principles for Responsible Investment: UN-developed framework for ESG reporting framework for disclosure in responsible investments.

    Sustainability Accounting Standards Board (SASB): ESG report framework to be used by investors.

    UN Global Compact: ESG reporting framework based on 10 principles that organizations can voluntarily contribute data to.

    Implement a HAM process to track asset disposal and other types of e-waste. Update agreements with disposal vendors to get reports on waste and recycle volumes.

    Recession readiness

    SIGNALS

    Managing accelerated technical debt.

    Recessionary pressures.

    Related Info-Tech Research

    I&O members experienced a spike in technical debt following the global pandemic economic shutdown, workforce displacement, and highly disrupted supply chains. 2023 presents a clear opportunity to work on these projects.

    The shortages in workforce and supply chain have accelerated inflation post pandemic. Central banks have started to slow down inflation in 2022 by raising interest rates. However, the World Bank has forecast a potential 2% rise in interest rates as the battle with inflation continues into 2023 and beyond, which could set off a global slowdown in GDP growth to 0.5%, qualifying as a recession. If interest rates continue to climb, I&O members may struggle with the higher cost of capital for their investments.

    (Source: World Bank Organization, 2022)

    Recession readiness

    SIGNALS

    I&O budgets expected to increase.

    Focused budgetary increases.

    Despite economists’ prediction of a looming recession and inflationary pressures, only 11% of I&O members surveyed indicated that they anticipated any reduction in IT budgets for 2023. In fact, 44% of I&O members expected an increase of IT budgets of between 6% and 30%.

    These increases in budget are not uniform across all investments. Surveyed I&O members indicated that the largest anticipated budget increases (compared to 2022) were in the areas of:

    • AI/machine learning ( +7.5%)
    • 5G (+7%)
    • Data Mesh/Fabric and Data Lake infrastructure (+5.7% and +4.4%, respectively)
    • Mixed reality technologies (augmented or virtual reality) (+3.3%)
    • Next generation cybersecurity (+1.7%)

    "2022 has been the first true opportunity to start getting caught up on technical debt stemming from the post pandemic supply chain and resource shortages. That catch-up is going to continue for some time.

    Unfortunately, the world isn't sitting still while doing that. In fact, we see new challenges around inflationary pressures. 2023 planning is going to be a balancing act between old and new projects."

    Paul Sparks,
    CTO at Brookshire Grocery Company

    Recession readiness

    SIGNALS

    Tough choices on budgetary spends.

    The responses indicated that I&O members expect decreased reinvestment for 2023 for the following:

    • API programming (-21.7%)
    • Cloud computing (-19.4%)
    • 44% of I&O members indicated if 2023 requires costs cutting, 5-20% of their cloud computing investment will be at risk of the chopping block!
    • Workforce management (-9.4%)
    • No-code /low-code infrastructure (-5.3%)

    Make sure you can clearly measure the value of all budgeted I&O activities.

    Anything that can't demonstrate clear value to leadership is potentially on the chopping block.

    Recession readiness

    CALL TO ACTION

    Get ahead of inflationary pressures with early budgetary planning, and identify the gap between the catch-up projects and required critical net new investments.

    II&O priority actions

    Hedge against inflation on infrastructure projects. Develop and communicate value-based strategies to lock in pricing and mitigate inflationary risk with vendors.

    Communicate value-add on all I&O budgeted items. Define an infrastructure roadmap to highlight which projects are technical debt and which are new strategic investments, and note their value to the organization.

    Look for cost saving technologies. Focus on I&O projects that automate services to increase productivity and optimize head count.

    Realize opportunities

    Build on a record of COVID-related innovation success and position the enterprise to take advantage of 2023.

    AI governance: Watching the watchers

    Data stewardship: Cornerstone of value

    Prep for a brave new metaverse

    AI governance: Watching the watchers

    SIGNALS

    Continued investment
    in AI technologies

    AI technology is permeating diverse I&O functional areas.

    Related Info-Tech Research

    About 32% of survey respondents who work in I&O said that they already invest in AI, and 40% intend to invest in 2023.

    I&O members have identified the following areas as the top five focal points for AI uses within their organizations.

    • Automated repetitive, low-level tasks
    • Business analytics or intelligence
    • Identification of risks and improvement of security response
    • Monitoring and governance
    • Sensor data analysis

    AI governance: Watching the watchers

    SIGNALS

    Consequences for misbehaving AI.

    I&O leaders can expect to have silos of AI in pockets scattered across the enterprise. Without oversight on the learning model and the data used for training and analytics there is a risk of overprovisioning, which could reduce the efficiency and effectiveness of AI models and results.

    This scale advantage of AI could result in operational inefficiencies without oversight. For example, bad governance means garbage in / garbage out. Which is worse: getting 100 outputs from a system with a 1% error rate, or getting 10,000 outputs from a system with an 1% error rate?

    These are just the operational issues; legally you can be on the hook, as well. The EU Parliament has issued a civil liability regime for AI (European Parliament, n.d.) which imposes liability to operators of AI systems, regardless of whether they acted with operational due diligence. Additionally, the IEEE (IEEE, 2019) is advocating for legal frameworks and accountability for AI that violates human rights and privacy laws and causes legal harm.

    Who is going to instill standards for AI Operations? Who is going to put in the mechanisms to validate and explain the output of AI black boxes?

    If you said it’s going to end up
    being Infrastructure and Operations – you were right!

    AI governance: Watching the watchers

    CALL TO ACTION

    Establish I&O within an AI governance program to build trust in AI results and behaviors and limit legal exposure.

    I&O priority actions

    Define who has overall AI accountability for AI governance within I&O. This role is responsible for establishing strategic governance metrics over AI use and results, and identifying liability risks.

    Maintain an inventory of AI use. Conduct an audit of where AI is used within I&O, and identify gaps in documentation and alignment with I&O processes and organizational values.

    Define an I&O success map. Provide transparency of AI use by generating pseudo code of AI models, and scorecard AI decision making with expected predictions and behavioral actions taken.

    AI governance: Watching the watchers

    Manage bias in AI decision making. Work with AI technology vendors to identify how unethical bias can enter the results, using operational data sets for validation prior to rollout.

    Protect AI data sets from manipulation. Generate new secure storage for AI technology audit trails on AI design making and results. Work with your security team to ensure data sets used by AI for training can’t be corrupted.

    Data governance: Cornerstone of value

    SIGNALS

    Data volumes grow
    with time.

    Data is seen as a source for generating new value.

    Related Info-Tech Research

    Of surveyed I&O members, 63% expected to see the data storage grow by at least 10% in 2023, and 15% expected a 30% or more growth in data storage volumes.

    I&O members identified the top three ways data brings value to the organization:

    • Helping reduce operational costs.
    • Presenting value-added to existing products and services.
    • Acquiring new customers.

    Data governance: Cornerstone of value

    SIGNALS

    Approach to data analysis is primarily done in-house.

    85% of surveyed I&O members are doing data analysis with custom-made or external tools. Interestingly, 10% of I&O members do not conduct any data analysis.

    Members are missing a formal data governance process.

    81% of surveyed I&O members do not have a formal or automated process for data governance. Ironically, 24% of members responded that they aim to have publicly accessible data-as-a-service or information repositories.

    Despite investment in data initiatives, organizations carry high levels of data debt.

    Info-Tech research, Establish Data Governance, points out that data debt, the accumulated cost associated with sub-optimal governance of data assets, is a problem for 78% of organizations.

    What the enterprise expects out of enterprise storage is much more complicated in 2023.

    Data protection and governance are non-negotiable aspects of enterprise storage, even when it’s unstructured.

    Data governance: Cornerstone of value

    SIGNALS

    Data quality is the primary driver for data governance.

    The data governance market
    is booming.

    Related Info-Tech Research

    In the 2022 Zaloni survey of data governance professionals, 71% indicated that consistent data quality was the top metric for data governance, followed by reduced time to insight and regulatory compliance.

    (Source: Zaloni DATAVERSITY, 2022)

    The Business Research Company determined that the global data governance market is expected to grow from $3.28 billion in 2022 to $7.42 billion in 2026 at a CAGR of 22.7% in response to 74 zettabytes of data in 2021, with a growth rate of 1.145 trillion MB of new data being created every day.

    (Source: Business Research Company, 2022)

    Data governance: Cornerstone of value

    CALL TO ACTION

    Develop a data governance program that includes an I&O data steward for oversight.

    I&O priority actions

    Establish an I&O data steward. Make data governance by establishing a data steward role with accountability for governance. The steward works collaboratively with DataOPs to control access to I&O data, enforce policies, and reduce the time to make use of the data.

    Define a comprehensive storage architecture. If you thought you had a data sprawl problem before, wait until you see the volume of data generated from IoT and Web 3.0 applications. Get ahead of the problem by creating an infrastructure roadmap for structured and unstructured data storage.

    Build a solid backbone for AI Operations using data quality best practices. Data quality is the foundation for generation of operational value from the data and artificial intelligence efforts. Focus on using a methodology to build a culture of data quality within I&O systems and applications that generate data rather than reactive fixes.

    Look to partner with third-party vendors for your master data management (MDM) efforts. Modern MDM vendors can work with your existing data fabrics/lake and help leverage your data governance policies into the cloud.

    Prep for a brave new metaverse

    SIGNALS

    From science fiction to science fact.

    The term metaverse was coined in 1992 by Neal Stephenson and is a common theme in science fiction. For most I&O surveyed professionals, the term metaverse conjures up more confusion than clarity, as it’s not one place, but multiple metaverse worlds. The primordial metaverse was focused on multiplayer gaming and some educational experiences. It wasn’t until recently that it gained a critical mass in the fashion and entertainment industries with the use of non-fungible tokens (NFT). The pandemic created a unique opportunity for metaverse-related technologies to expand Web 3.0.

    Related Info-Tech Research

    Prep for a brave new metaverse

    SIGNALS

    Collaboration and beyond.

    On one hand, metaverse technologies virtual reality(VR)/augmented reality (AR) headsets can be a method of collaborating internally within a single organization. About 10% of our surveyed I&O members engaged this type of collaborative metaverse in 2022, with another 24% looking to run proof of concept projects in 2023. However, there is a much larger terrain for metaverse projects outside of workforce collaboration, which 17% of surveyed I&O members are planning to engage with in 2023.

    These are sophisticated new metaverse worlds, and digital twins of production environments are being created for B2B collaboration, operations, engineering, healthcare, architecture, and education that include the use of block chain, NFTs, smart contracts, and other Web 3.0 technologies

    “They are the audiovisual bodies that people use to communicate with each other in the Metaverse.”

    Neal Stephenson,
    Snow Crash 1992

    Prep for a brave new metaverse

    SIGNALS

    Metaverse requires multidimensional security.

    Security in the context of the metaverse presents new challenges to I&O. The infrastructure that runs the metaverse is still vulnerable to “traditional” security threats. New attack vectors include financial and identity fraud, privacy and data loss, along with new cyber-physical threats which are predicted to occur as the metaverse begins to integrate with IoT and other 3D objects in the physical world.

    The ultimate in "not a product" – the metaverse promises to be a hodgepodge of badly standardized technologies for the near future.

    Be prepared to take care of pets and not cattle for the foreseeable future, but keep putting the fencing around the ranch.

    Prep for a brave new metaverse

    SIGNALS

    Generating new wave of sophisticated engineering coming.

    Economics boom around metaverse set to explode.

    Related Info-Tech Research

    Beyond the current online educational resources, there are reputable universities around the world, including Stanford University, that are offering courses on metaverse and Web 3.0 concepts.

    (Source: Arti, 2022)

    So, what’s providing the impetus for all this activity and investment? Economics. In their 2022 report, Metaverse and Money, Citi estimated that the economic value of the metaverse(s) will have 900M to 1B VR/AR users and 5 billion Web 3.0 users with market sizes of $1-2T and $8-$13T, respectively. Yes, that’s a “T” for Trillions.

    (Source: Ghose, 2022)

    Prep for a brave new metaverse

    CALL TO ACTION

    Ready or not, the metaverse is coming to an infrastructure near you. Start expanding I&O technologies and processes to support a metaverse infrastructure.

    I&O priority actions

    Develop a plan for network upgrades.

    A truly immersive VR/AR experience requires very low latency. Identify gaps and develop a plan to enhance your network infrastructure surrounding your metaverse space(s) and end users.

    Extend security posture into the metaverse.

    Securing the infrastructure that runs your metaverse is going to extend the end-user equipment used to navigate it. More importantly, security policies need to encompass the avatars that navigate it and the spatial web that they interact with, which can include physical world items like IoT.

    Prep for a brave new metaverse

    I&O priority actions

    Metaverse theft prevention

    Leverage existing strategies to identify management in the metaverse. Privacy policies need to extend their focus to data loss prevention within the metaverse.

    Collaborate

    The skill set required to build, deploy, manage, and support the metaverse is complex. Develop a metaverse support organization that extends beyond I&O functions into security, DevOps, and end-user experiences.

    Educate

    Web 3.0 technologies and business models are complex. Education of I&O technical- and commerce-focused team members is going to help prevent you from getting blindsided. Seek out specialized training programs for technical staff and strategic education for executives, like the Wharton School of Business certification program.

    Authors

    John Annand

    Theo Antoniadis

    John Annand

    Principal Research Director

    Theo Antoniadis

    Principal Research Director

    Contributors

    Paul Sparks,
    CTO at Brookshire Grocery Company

    2 Anonymous Contributors

    Figuring out the true nature of the “Turbo” button of his 486DX100 launched John on a 20-year career in managed services and solution architecture, exploring the secrets of HPC, virtualization, and DIY WANs built with banks of USR TotalControl modems. Today he focuses his research and advisory on software-defined infrastructure technologies, strategy, organization, and service design in an increasingly Agile and DevOps world.

    Theo has decades of operational and project management experience with start-ups and multinationals across North America and Europe. He has held various consulting, IT management and operations leadership positions within telecommunications, SaaS, and software companies.

    Bibliography

    “3 Cybersecurity Trends that are Changing Financial Data Management." FIMA US. Accessed August 2022.
    Arti. “While much of the world is just discovering the Metaverse, a number of universities have already established centers for studying Web 3." Analytics Insight. 10 July 2022.
    “Artificial intelligence (AI) for cybersecurity." IBM. Accessed September 2022
    “Business in the Metaverse Economy." Wharton School of University of Pennsylvania. Accessed October 2022.
    “Cost of a data breach 2022: A million-dollar race to detect and respond." IBM. Accessed September 2022.
    “Countries affected by mandatory ESG reporting – here’s the list." New Zealand Ministry of Business, Innovation & Employment. Accessed September 2022.
    “Countries affected by mandatory ESG reporting – here’s the list.” WorldFavor. Accessed September 2022.
    Crenshaw, Caroline A. “SEC Proposes to Enhance Disclosures by Certain Investment Advisers and Investment Companies About ESG Investment Practices." U.S. Securities and Exchange Commission. May 2022.
    “Cutting through the metaverse hype: Practical guidance and use cases for business." Avanade. Accessed October 2022.
    “Data Governance Global Market Sees Growth Rate Of 25% Through 2022." The Business Research Company. August 2022.
    “DIRECTIVE 2014/95/EU OF THE EUROPEAN PARLIAMENT AND OF THE COUNCIL of 22 October 2014 amending Directive 2013/34/EU as regards disclosure of non-financial and diversity information by certain large undertakings and groups." UER-Lex. Accessed September 2022.
    "Ethically Aligned Design: A Vision for Prioritizing Human Well-being with Autonomous and Intelligent Systems." IEEE. March 2019.
    “European Parliament resolution of 20 October 2020 with recommendations to the Commission on a civil liability regime for artificial intelligence." European Parliament. Accessed October 2022.
    Ghose, Ronit et al. "Metaverse and Money." Citi GPS. March 2022.
    Hernandez, Roberto, et al. “Demystifying the metaverse." PWC. Accessed August 2022.
    Info-Tech Trends Report Survey, 2023; N=813.
    “ISO 14000 Family: Environmental Management." ISO. Accessed October 2022.
    Knight, Michelle & Bishop, Annie, ”The 2022 State of Cloud Data Governance.“ Zaloni DATAVERSITY. 2022.

    Bibliography

    Kompella, Kashyap, “What is AI governance and why do you need it?“ TechTarget. March 2022.
    “Management of electronic waste worldwide in 2019, by method." Statista. 2022.
    “Model Artificial Intelligence Governance Framework and Assessment Guide.“ World Economic Forum. Accessed September 2022.
    “Model Artificial Intelligence Governance Framework." PDPC Singapore. Accessed October 2022.
    “New rules on corporate sustainability reporting: provisional political agreement between the Council and the European Parliament.“ European Council. June 2022.
    "OECD Economic Outlook Volume 2022." OECD iLibrary. June 2022.
    "Recommendations of the Task Force on Climate-related Financial Disclosures." TCFD. Accessed August 2022.
    “Risk of Global Recession in 2023 Rises Amid Simultaneous Rate Hikes.” World Bank Organization. September 2022.
    Sautner, Zacharias, et al. “The Effects of Mandatory ESG Disclosure around the World.” SSRN. November 2021.
    Sondergaard, Peter. “AI GOVERNANCE – WHAT ARE THE KPIS? AND WHO IS ACCOUNTABLE?“ The Sondergaard Group. November 2019.
    Srivastavam Sudeep, “How can your business enter the Metaverse?." Appinventiv.
    September 2022.
    “Standards Overview." SASB. Accessed October 2022.
    Stephenson, Neal. Snow Crash. Bantam Books, 1992.
    “Sustainability Reporting Standards." Global Reporting Initiative. Accessed October 2022.
    “The Ten Principles of the UN Global Compact." UN Global Compact. Accessed October 2022.
    Tian Tong Lee, Sheryl. "China Unveils ESG Reporting Guidelines to Catch Peers.” Bloomberg. May 2022.
    “What are the Principles for Responsible Investment?" UNPRI. Accessed October 2022.
    "What is the EU's Corporate Sustainability Reporting Directive (CSRD)?" WorldFavor.
    June 2022.
    West, Darrell M. “Six Steps to Responsible AI in the Federal Government.“ Brookings Institution. March 2022. Web.

    Contact Tymans Group

    We're here to get your IT Operations performant and resilient

    We have the highest respect for your person. We contact you only with responses to your questions. Our company ethics insist on transparency and honesty.

    Continue reading

    Develop Meaningful Service Metrics

    • Buy Link or Shortcode: {j2store}399|cart{/j2store}
    • member rating overall impact: 9.5/10 Overall Impact
    • member rating average dollars saved: $20,308 Average $ Saved
    • member rating average days saved: 30 Average Days Saved
    • Parent Category Name: Service Management
    • Parent Category Link: /service-management
    • IT organizations measure services from a technology perspective but rarely from a business goal or outcome perspective.
    • Most organizations do a poor job of identifying and measuring service outcomes over the duration of a service’s lifecycle – never ensuring the services remain valuable and meet expected long-term ROI.

    Our Advice

    Critical Insight

    • Service metrics are critical to ensuring alignment of IT service performance and business service value achievement.
    • Service metrics reinforce positive business and end-user relationships by providing user-centric information that drives responsiveness and consistent service improvement.
    • Poorly designed metrics drive unintended and unproductive behaviors that have negative impacts on IT and produce negative service outcomes.

    Impact and Result

    Effective service metrics will provide the following service gains:

    • Confirm service performance and identify gaps.
    • Drive service improvement to maximize service value.
    • Validate performance improvements while quantifying and demonstrating business value.
    • Ensure service reporting aligns with end-user experience.
    • Achieve and confirm process and regulatory compliance.

    Which will translate into the following relationship gains:

    • Embed IT into business value achievement.
    • Improve the relationship between the business and IT.
    • Achieve higher customer satisfaction (happier end users receiving expected service, the business is able to identify how things are really performing).
    • Reinforce desirable actions and behaviors from both IT and the business.

    Develop Meaningful Service Metrics Research & Tools

    Start here – read the Executive Brief

    Read our concise Executive Brief to find out why you should develop meaningful service metrics, review Info-Tech’s methodology, and understand the four ways we can support you in completing this project.

    Besides the small introduction, subscribers and consulting clients within this management domain have access to:

    • Develop Meaningful Service Metrics – Executive Brief
    • Develop Meaningful Service Metrics – Phases 1-3

    1. Design the metrics

    Identify the appropriate service metrics based on stakeholder needs.

    • Develop Meaningful Service Metrics to Ensure Business and User Satisfaction – Phase 1: Design the Metrics
    • Metrics Development Workbook

    2. Design reports and dashboards

    Present the right metrics in the most interesting and stakeholder-centric way possible.

    • Develop Meaningful Service Metrics to Ensure Business and User Satisfaction – Phase 2: Design Reports and Dashboards
    • Metrics Presentation Format Selection Guide

    3. Implement, track, and maintain

    Run a pilot with a smaller sample of defined service metrics, then continuously validate your approach and make refinements to the processes.

    • Develop Meaningful Service Metrics to Ensure Business and User Satisfaction – Phase 3: Implement, Track, and Maintain
    • Metrics Tracking Tool
    [infographic]

    Workshop: Develop Meaningful Service Metrics

    Workshops offer an easy way to accelerate your project. If you are unable to do the project yourself, and a Guided Implementation isn't enough, we offer low-cost delivery of our project workshops. We take you through every phase of your project and ensure that you have a roadmap in place to complete your project successfully.

    1 Design the Metrics

    The Purpose

    Define stakeholder needs for IT based on their success criteria and identify IT services that are tied to the delivery of business outcomes.

    Derive meaningful service metrics based on identified IT services and validate that metrics can be collected and measured.

    Key Benefits Achieved

    Design meaningful service metrics from stakeholder needs.

    Validate that metrics can be collected and measured.

    Activities

    1.1 Determine stakeholder needs, goals, and pain points.

    1.2 Determine the success criteria and related IT services.

    1.3 Derive the service metrics.

    1.4 Validate the data collection process.

    1.5 Validate metrics with stakeholders.

    Outputs

    Understand stakeholder priorities

    Adopt a business-centric perspective to align IT and business views

    Derive meaningful business metrics that are relevant to the stakeholders

    Determine if and how the identified metrics can be collected and measured

    Establish a feedback mechanism to have business stakeholders validate the meaningfulness of the metrics

    2 Design Reports and Dashboards

    The Purpose

    Determine the most appropriate presentation format based on stakeholder needs.

    Key Benefits Achieved

    Ensure the metrics are presented in the most interesting and stakeholder-centric way possible to guarantee that they are read and used.

    Activities

    2.1 Understand the different presentation options.

    2.2 Assess stakeholder needs for information.

    2.3 Select and design the metric report.

    Outputs

    Learn about infographic, scorecard, formal report, and dashboard presentation options

    Determine how stakeholders would like to view information and how the metrics can be presented to aid decision making

    Select the most appropriate presentation format and create a rough draft of how the report should look

    3 Implement, Track, and Maintain Your Metrics

    The Purpose

    Run a pilot with a smaller sample of defined service metrics to validate your approach.

    Make refinements to the implementation and maintenance processes prior to activating all service metrics.

    Key Benefits Achieved

    High user acceptance and usability of the metrics.

    Processes of identifying and presenting metrics are continuously validated and improved.

    Activities

    3.1 Select the pilot metrics.

    3.2 Gather data and set initial targets.

    3.3 Generate the reports and validate with stakeholders.

    3.4 Implement the service metrics program.

    3.5 Track and maintain the metrics program.

    Outputs

    Select the metrics that should be first implemented based on urgency and impact

    Complete the service intake form for a specific initiative

    Create a process to gather data, measure baselines, and set initial targets

    Establish a process to receive feedback from the business stakeholders once the report is generated

    Identify the approach to implement the metrics program across the organization

    Set up mechanism to ensure the success of the metrics program by assessing process adherence and process validity

    Further reading

    Develop Meaningful Service Metrics

    Select IT service metrics that drive business value.

    ANALYST PERSPECTIVE

    Are you measuring and reporting what the business needs to know?

    “Service metrics are one of the key tools at IT’s disposal in articulating and ensuring its value to the business, yet metrics are rarely designed and used for that purpose.

    Creating IT service metrics directly from business and stakeholder outcomes and goals, written from the business perspective and using business language, is critical to ensuring that the services that IT provides are meeting business needs.

    The ability to measure, manage, and improve IT service performance in relation to critical business success factors, with properly designed metrics, embeds IT in the value chain of the business and ensures IT’s focus on where and how it enables business outcomes.”

    Valence Howden,
    Senior Manager, CIO Advisory
    Info-Tech Research Group

    Our understanding of the problem

    This Research Is Designed For:
    • CIO
    • IT VPs
    This Research Will Help You:
    • Align business/IT objectives (design top-down or outside-in)
    • Significantly improve the relationship between the business and IT aspects of the organization
    • Reinforce desirable actions and behaviors
    This Research Will Also Assist:
    • Service Level Managers
    • Service Owners
    • Program Owners
    This Research Will Help Them
    • Identify unusual deviations from the normal operating state
    • Drive service improvement to maximize service value
    • Validate the value of performance improvements while quantifying and demonstrating benefits realization

    Executive summary

    Situation

    • IT organizations measure services from a technology perspective yet rarely measure services from a business goal/outcome perspective.
    • Most organizations do a poor job of identifying and measuring service outcomes over the duration of a service’s lifecycle – never ensuring the services remain valuable and meet expected long-term ROI.

    Complication

    • IT organizations have difficulty identifying the right metrics to demonstrate the value of IT services to the business in tangible terms.
    • IT metrics, as currently designed, reinforce division between the IT and business perspectives of service performance. They drive siloed thinking and finger-pointing within the IT structure, and prevent IT resources from understanding how their work impacts business value.

    Resolution

    • Our program enables IT to develop the right service metrics to tie IT service performance to business value and user experience.
    • Ensure the metrics you implement have immediate stakeholder value, reinforcing alignment between IT and the business while influencing behavior in the desired direction.
    • Make sure that your metrics are defined in relation to the business goals and drivers, ensuring they will provide actionable outcomes.

    Info-Tech Insight

    1. Service metrics are critical to ensuring alignment of IT service performance and business service value achievement.
    2. Service metrics reinforce positive business and end-user relationships by providing user-centric information that drives responsiveness and consistent service improvement.
    3. Poorly designed metrics drive unintended and unproductive behaviors, which have negative impacts on IT and produce negative service outcomes.

    Service metrics 101

    What are service metrics?

    Service metrics measure IT services in a way that relates to a business outcome. IT needs to measure performance from the business perspective using business language.

    Why do we need service metrics?

    To ensure the business cares about the metrics that IT produces, start with business needs to make sure you’re measuring the right things. This will give IT the opportunity talk to the right stakeholders and develop metrics that will meet their business needs.

    Service metrics are designed with the business perspective in mind, so they are fully aligned with business objectives.

    Perspectives Matter

    Different stakeholders will require different types of metrics. A CEO may require metrics that provide a snapshot of the critical success of the company while a business manager is more concerned about the performance metrics of their department.

    What are the benefits of implementing service metrics?

    Service metrics help IT communicate with the business in business terms and enables IT to articulate how and where they provide business value. Business stakeholders can also easily understand how IT services contribute to their success.

    The majority of CIOs feel metrics relating to business value and stakeholder satisfaction require significant improvement

    A significantly higher proportion of CIOs than CEOs feel that there is significant improvement necessary for business value metrics and stakeholder satisfaction reporting. Stacked horizontal bar chart presenting survey results from CIOs and CXOs of 'Business Value Metrics'. Answer options are 'Effective', 'Some Improvement Necessary', 'Significant Improvement Necessary', and 'Not Required'.N=364

    Stacked horizontal bar chart presenting survey results from CIOs and CXOs of 'Stakeholder Satisfaction Reporting'. Answer options are 'Effective', 'Some Improvement Necessary', 'Significant Improvement Necessary', and 'Not Required'.N=364

    (Source: Info-Tech CIO-CXO Alignment Diagnostic Survey)

    Meaningless metrics are a headache for the business

    A major pitfall of many IT organizations is that they often provide pages of technical metrics that are meaningless to their business stakeholders.

    1. Too Many MetricsToo many metrics are provided and business leaders don’t know what to do with these metrics.
    2. Metrics Are Too TechnicalIT provides technical metrics that are hard to relate to business needs, and methods of calculating metrics are not clearly understood, articulated, and agreed on.
    3. Metrics Have No Business ValueService metrics are not mapped to business goals/objectives and they drive incorrect actions or spend.
    When considering only CEOs who said that stakeholder satisfaction reporting needed significant improvement, the average satisfaction score goes down to 61.6%, which is a drop in satisfaction of 12%.

    A bar that says 73% dropping to a bar that says 61%. Description above.

    (Source: Info-Tech Research Group CIO-CXO Alignment Diagnostic Survey)

    Poorly designed metrics hurt IT’s image within the organization

    By providing metrics that do not articulate the value of IT services, IT reinforces its role as a utility provider and an outsider to strategic decisions.

    When the CIOs believe business value metrics weren’t required, 50% of their CEOs said that significant improvements were necessary.

    Pie Chart presenting the survey results from CEOs regarding 'Business Value Metrics'. Description above.

    (Source: Info-Tech Research Group CIO-CXO Alignment Diagnostic Survey)
    1. Reinforce the wrong behaviorThe wrong metrics drive us-against-them, siloed thinking within IT, and meeting metric targets is prioritized over providing meaningful outcomes.
    2. Do not reflect user experienceMetrics don’t align with actual business/user experience, reinforcing a poor view of IT services.
    3. Effort ≠ ValueInvesting dedicated resources and effort to the achievement of the wrong metrics will only leave IT more constrained for other important initiatives.

    Articulate meaningful service performance that supports the achievement of business outcomes

    Service metrics measure the performance of IT services and how they enable or drive the activity outcomes.

    A business process consists of multiple business activities. In many cases, these business activities require one or more supporting IT services.

    A 'Business Process' broken down to its parts, multiple 'Business Activities' and their 'IT Services'. For each business process, business stakeholders and their goals and objectives should be identified.

    For each business activity that supports the completion of a business process, define the success criteria that must be met in order to produce the desirable outcome.

    Identify the IT services that are used by business stakeholders for each business activity. Measure the performance of these services from a business perspective to arrive at the appropriate service metrics.

    Differentiate between different types of metrics

    Stakeholders have different goals and objectives; therefore, it is critical to identify what type of metrics should be presented to each stakeholder.

    Business Metrics

    Determine Business Success

    Business metrics are derived from a pure business perspective. These are the metrics that the business stakeholders will measure themselves on, and business success is determined using these metrics.

    Arrow pointing right.

    Service Metrics

    Manage Service Value to the Business

    Service metrics are used to measure IT service performance against business outcomes. These metrics, while relating to IT services, are presented in business terms and are tied to business goals.

    Arrow pointing right.

    IT Metrics

    Enable Operational Excellence

    IT metrics are internal to the IT organization and used to manage IT service delivery. These metrics are technical, IT-specific, and drive action for IT. They are not presented to the business, and are not written in business language.

    Implementing service metrics is a key step in becoming a service provider and business partner

    As a prerequisite, IT organizations must have already established a solid relationship with the business and have a clear understanding of its critical business-facing services.

    At the very least, IT needs to have a service-oriented view and understand the specific needs and objectives associated with each stakeholder.

    Visualization of 'Business Relationship Management' with an early point on the line representing 'Service Provider: Establish service-oriented culture and business-centric service delivery', and the end of the line being 'Strategic Partner'.

    Once IT can present service metrics that the business cares about, it can continue on the service provider journey by managing the performance of services based on business needs, determine and influence service demand, and assess service value to maximize benefits to the business.

    Which processes drive service metrics?

    Both business relationship management (BRM) and service level management (SLM) provide inputs into and receive outputs from service metrics.

    Venn Diagram of 'Business Relationship Management', 'Service Metrics', and 'Service Level Management'.

    Business Relationship Management

    BRM works to understand the goals and objectives of the business and inputs them into the design of the service metrics.

    Service Metrics

    BRM leverages service metrics to help IT organizations manage the relationship with the business.

    BRM articulates and manages expectations and ensures IT services are meeting business requirements.

    Which processes drive service metrics?

    Both BRM and SLM provide inputs into and receive outputs from service metrics.

    Venn Diagram of 'Business Relationship Management', 'Service Metrics', and 'Service Level Management'.

    Service Level Management

    SLM works with the business to understand service requirements, which are key inputs in designing the service metrics.

    Service Metrics

    SLM leverages service metrics in overseeing the day-to-day delivery of IT services. It ensures they are provided to meet expected service level targets and objectives.

    Effective service metrics will deliver both service gains and relationship gains

    Effective service metrics will provide the following service gains:

    • Confirm service performance and identify gaps
    • Drive service improvement to maximize service value
    • Validate performance improvements while quantifying and demonstrating business value
    • Ensure service reporting aligns with end-user experience
    • Achieve and confirm process and regulatory compliance
        Which will translate into the following relationship gains:
        • Embed IT into business value achievement
        • Improve relationship between the business and IT
        • Achieve higher customer satisfaction (happier end users receiving expected service, the business is able to identify how things are really performing)
        • Reinforce desirable actions and behaviors from both IT and the business

    Don’t let conventional wisdom become your roadblock

    Conventional Wisdom

    Info-Tech Perspective

    Metrics are measured from an application or technology perspective Metrics need to be derived from a service and business outcome perspective.
    The business doesn’t care about metrics Metrics are not usually designed to speak in business terms about business outcomes. Linking metrics to business objectives creates metrics that the business cares about.
    It is difficult to have a metrics discussion with the business It is not a metrics/number discussion, it is a discussion on goals and outcomes.
    Metrics are only presented for the implementation of the service, not the ongoing outcome of the service IT needs to focus on service outcome and not project outcome.
    Quality can’t be measured Quality must be measured in order to properly manage services.

    Our three-phase approach to service metrics development

    Let Info-Tech guide you through your service metrics journey

    1

    2

    3

    Design Your Metrics Develop and Validate Reporting Implement, Track, and Maintain
    Sample of Phase 1 of Info-Tech's service metric development package, 'Design Your Metrics'. Sample of Phase 2 of Info-Tech's service metric development package, 'Develop and Validate Reporting'. Sample of Phase 3 of Info-Tech's service metric development package, 'Implement, Track, and Maintain'.
    Start the development and creation of your service metrics by keeping business perspectives in mind, so they are fully aligned with business objectives. Identify the most appropriate presentation format based on stakeholder preference and need for metrics. Track goals and success metrics for your service metrics programs. It allows you to set long-term goals and track your results over time.

    CIOs must actively lead the design of the service metrics program

    The CIO must actively demonstrate support for the service metrics program and lead the initial discussions to determine what matters to business leaders.

    1. Lead the initiative by defining the need
      Show visible support and demonstrate importance
    2. Articulate the value to both IT and the business
      Establish the urgency and benefits
    3. Select and assemble an implementation group
      Find the best people to get the job done
    4. Drive initial metrics discussions: goals, objectives, actions
      Lead brainstorming with senior business leaders
    5. Work with the team to determine presentation formats and communication methods
      Identify the best presentation approach for senior stakeholders
    6. Establish a feedback loop for senior management
      Solicit feedback on improvements
    7. Validate the success of the metrics
      Confirm service metrics support business outcomes

    Measure the success of your service metrics

    It is critical to determine if the designed service metrics are fulfilling their intended purpose. The process of maintaining the service metrics program and the outcomes of implementing service metrics need to be monitored and tracked.

    Validating Service Metrics Design

    Target Outcome

    Related Metrics

    The business is enabled to identify and improve service performance to their end customer # of improvement initiatives created based on service metrics
    $ cost savings/revenue generated due to actions derived from service metrics

    Procedure to validate the usefulness of IT metrics

    # / % of service metrics added/removed per year

    Alignment between IT and business objectives and processes Business’ satisfaction with IT

    Measure the success of your service metrics

    It is critical to determine if the designed service metrics are fulfilling their intended purpose. The process of maintaining the service metrics program and the outcomes of implementing service metrics need to be monitored and tracked.

    Validating Service Metrics Process

    Target Outcome

    Related Metrics

    Properly defined service metrics aligned with business goals/outcomes
    Easy understood measurement methodologies
    % of services with (or without) defined service metrics

    % of service metrics tied to business goals

    Consistent approach to review and adjust metrics# of service metrics adjusted based on service reviews

    % of service metrics reviewed on schedule

    Demonstrate monetary value and impact through the service metrics program

    In a study done by the Aberdeen Group, organizations engaged in the use of metrics benchmarking and measurement have:
    • 88% customer satisfaction rate
    • 60% service profitability
    • 15% increase in workforce productivity over the last 12 months

    Stock image of a silhouette of three people's head and shoulders.
    (Source: Aberdeen Group. “Service Benchmarking and Measurement.”)

    A service metric is defined for: “Response time for Business Application A

    The expected response time has not been achieved and this is visible in the service metrics. The reduced performance has been identified as having an impact of $250,000 per month in lost revenue potential.

    The service metric drove an action to perform a root-cause analysis, which identified a network switch issue and drove a resolution action to fix the technology and architect redundancy to ensure continuity.

    The fix eliminated the performance impact, allowing for recovery of the $250K per month in revenue, improved end-user confidence in the organization, and increased use of the application, creating additional revenue.

    Implementing and measuring a video conferencing service

    CASE STUDY
    Industry: Manufacturing | Source: CIO interview and case material
    Situation

    The manufacturing business operates within numerous countries and requires a lot of coordination of functions and governance oversight. The company has monthly meetings, both regional and national, and key management and executives travel to attend and participate in the meetings.

    Complication

    While the meetings provide a lot of organizational value, the business has grown significantly and the cost of business travel has started to become prohibitive.

    Action

    It was decided that only a few core meetings would require onsite face-to-face meetings, and for all other meetings, the company would look at alternative means. The face-to-face aspect of the meetings was still considered critical so they focused on options to retain that aspect.

    The IT organization identified that they could provide a video conferencing service to meet the business need. The initiative was approved and rolled out in the organization.

    Result:

    IT service metrics needed to be designed to confirm that the expected value outcome of the implementation of video conferencing was achieved.

    Under the direction of the CIO, the business goals and needs driving use of the service (i.e. reduction in travel costs, efficiency, no loss of positive outcome) were used to identify success criteria and key questions to confirm success.

    With this information, the service manager was able to implement relevant service metrics in business language and confirmed an 80% adoption rate and a 95% success rate in term meetings running as expected and achieving core outcomes.

    Use these icons to help direct you as you navigate this research

    Use these icons to help guide you through each step of the blueprint and direct you to content related to the recommended activities.

    A small monochrome icon of a wrench and screwdriver creating an X.

    This icon denotes a slide where a supporting Info-Tech tool or template will help you perform the activity or step associated with the slide. Refer to the supporting tool or template to get the best results and proceed to the next step of the project.

    A small monochrome icon depicting a person in front of a blank slide.

    This icon denotes a slide with an associated activity. The activity can be performed either as part of your project or with the support of Info-Tech team members, who will come onsite to facilitate a workshop for your organization.

    Info-Tech offers various levels of support to best suit your needs

    DIY Toolkit

    Guided Implementation

    Workshop

    Consulting

    "Our team has already made this critical project a priority, and we have the time and capability, but some guidance along the way would be helpful." "Our team knows that we need to fix a process, but we need assistance to determine where to focus. Some check-ins along the way would help keep us on track." "We need to hit the ground running and get this project kicked off immediately. Our team has the ability to take this over once we get a framework and strategy in place." "Our team does not have the time or the knowledge to take this project on. We need assistance through the entirety of this project."

    Diagnostics and consistent frameworks used throughout all four options

    Develop meaningful service metrics to ensure business and user satisfaction

    1. Design the Metrics 2. Design Reports and Dashboards 3. Implement, Track, and Maintain
    Supporting Tool icon

    Best-Practice Toolkit

    1. Defining stakeholder needs for IT based on their success criteria
    2. Derive meaningful service metrics based on identified IT services and validate with business stakeholders
    3. Validate metrics can be collected and measured
    4. Determine calculation methodology
    1. Presentation format selected based on stakeholder needs and preference for information
    2. Presentation format validated with stakeholders
    1. Identify metrics that will be presented first to the stakeholders based on urgency or impact of the IT service
    2. Determine the process to collect data, select initial targets, and integrate with SLM and BRM functions
    3. Roll out the metrics implementation for a broader audience
    4. Establish roles and timelines for metrics maintenance

    Guided Implementations

    • Design metrics based on business needs
    • Validate the metrics
    • Select presentation format
    • Review metrics presentation design
    • Select and implement pilot metrics
    • Determine rollout process and establish maintenance/tracking mechanism
    Associated Activity icon

    Onsite Workshop

    Module 1:
    Derive Service Metrics From Business Goals
    Module 2:
    Select and Design Reports and Dashboards
    Module 3:
    Implement, Track, and Maintain Your Metrics to Ensure Success
    Phase 1 Outcome:
    • Meaningful service metrics designed from stakeholder needs
    Phase 2 Outcome:
    • Appropriate presentation format selected for each stakeholder
    Phase 3 Outcome:
    • Metrics implemented and process established to maintain and track program success

    Workshop overview

    Contact your account representative or email Workshops@InfoTech.com for more information.
    Workshop Day 1 Workshop Day 2 Workshop Day 3 Workshop Day 4
    Design the Metrics
    Determine Presentation Format and Implement Metrics
    Gather Service Level Requirements
    Monitor and Improve Service Levels

    Activities

    • 1.1 Determine stakeholder needs
    • 1.2 Determine success criteria and key performance indicators
    • 1.3 Derive metrics
    • 1.4 Validate the metric collection
    • 2.1 Discuss stakeholder needs/preference for data and select presentation format
    • 2.2 Select and design the metric report
    • Requirements
    • 3.1 Determine the business requirements
    • 3.2 Negotiate service levels
    • 3.3 Align operational level agreements (OLAs) and supplier contracts
    • 4.1 Conduct service report and perform service review
    • 4.2 Communicate service review
    • 4.3 Remediate issues using action plan
    • 4.4 Proactive prevention

    Deliverables

    1. Metrics Development Workbook
    1. Metrics Presentation Format Selection Guide
    2. Metrics Tracking Tool
    1. Service Level Management SOP
    2. Service Level Agreement
    1. Service Level Report
    2. Service Level Review
    3. Business Satisfaction Report

    Develop Meaningful Service Metrics to Ensure Business and User Satisfaction

    PHASE 1

    Design the Metrics

    Step (1): Design the Metrics

    PHASE 1 PHASE 2 PHASE 3

    1.1

    Derive the Service Metrics

    1.2

    Validate the Metrics

    2.1

    Determine Reporting Format

    3.1

    Select Pilot Metrics

    3.2

    Activate and Maintain Metrics

    This step involves the following participants:

    • CIO
    • Business Relationship Manager (BRM)
    • Service Level Manager (SLM)

    Outcomes of this step

    • Defined stakeholder needs for IT based on their success criteria
    • Identified IT services that are tied to the delivery of business outcomes
    • Derived meaningful service metrics based on identified IT services and validated with business stakeholders
    • Validated that metrics can be collected and measured
    • Determined calculation methodology

    Phase 1 outline

    Associated Activity icon Call 1-888-670-8889 or email GuidedImplementations@InfoTech.com for more information.

    Complete these steps on your own, or call us to complete a guided implementation. A guided implementation is a series of 2-3 advisory calls that help you execute each phase of a project. They are included in most advisory memberships.

    Guided Implementation 1: Design the Metrics

    Proposed Time to Completion (in weeks): 4 weeks
    Step 1.1: Design Metrics Step 1.2: Validate the Metrics
    Start with an analyst kick-off call:
    • Determine the stakeholder and their needs
    • Identify IT services that are tied to the delivery of business outcomes
    • Derive the service metrics
    Review findings with analyst:
    • For the selected metrics, identify the data source for collection
    • Validate whether or not the data can be created
    • Create a calculation method for the metrics
    Then complete these activities…
    • Using the methodology provided, identify additional stakeholders and map out their success criteria, including KPIs to determine the appropriate service metrics
    Then complete these activities…
    • Determine whether the designed metrics are measurable, and if so, how
    With these tools & templates:
    • Metrics Development Workbook
    With these tools & templates:
    • Metrics Development Workbook

    Design your service metrics – overview

    Figure representing 'CIO'. Step 1
    Derive your service metrics

    Metrics Worksheet

    Figure representing 'SLM' and/or 'BRM'. Step 2
    Validate your metrics

    Metrics Worksheet

    Figures representing 'CIO', 'SLM', and/or 'BRM'. Step 3
    Confirm with stakeholders

    Metrics Tracking Sheet

    A star.

    Defined IT Service Metrics

    Deriving the right metrics is critical to ensuring that you will generate valuable and actionable service metrics.

    Derive your service metrics from business objectives and needs

    Service metrics must be designed with the business perspective in mind so they are fully aligned with business objectives.

    Thus, IT must start by identifying specific stakeholder needs. The more IT understands about the business, the more relevant the metrics will be to the business stakeholders.

    1. Who are your stakeholders?
    2. What are their goals and pain points?
    3. What do the stakeholders need to know?
    4. What do I need to measure?
    5. Derive your service metrics

    Derive your service metrics

    Supporting Tool icon 1.1 Metrics Development Workbook

    This workbook guides the development and creation of service metrics that are directly tied to stakeholder needs.

    This process will ensure that your service metrics are designed with the business perspective in mind so they are fully aligned with business objectives.

    1. Who are the relevant stakeholders?
    2. What are the goals and pain points of your stakeholders?
    3. What do the stakeholders need to know?
    4. What does IT need to measure?
    5. What are the appropriate IT metrics?

    Download the Metrics Development Workbook.

    Sample of Info-Tech's Metrics Development Workbook.

    Determine your stakeholders

    Supporting Tool icon 1.1 0.5 Hour

    Who are your stakeholders?

    1. Identify the primary stakeholders of your service metrics. Stakeholders are the people who have a very specific need to know about how IT services affect their business outcomes. Different stakeholders can have different perspective on the same IT service metric.Most often, the primary target of service metrics are the business stakeholders, e.g. VP of a business unit.
    2. Identify any additional stakeholders. The CIO is also a stakeholder since they are effectively the business relationship manager for the senior leaders.

    Video Conferencing Case Study
    Manufacturing company

    For this phase, we will demonstrate how to derive the service metrics by going through the steps in the methodology.

    At a manufacturing company, the CIO’s main stakeholder is the CEO, whose chief concern is to improve the financial position of the company.

    Identify goals and pain points of your stakeholders

    Supporting Tool icon 1.2 0.5 Hour

    What are their goals and pain points?

    1. Clearly identify each stakeholder’s business goals and outcomes. These would be particular business goals related to a specific business unit.
    2. Identify particular pain points for each business unit to understand what is preventing them from achieving the desirable business outcome.

    VC Case Study

    One of the top initiatives identified by the company to improve financial performance was to reduce expense.

    Because the company has several key locations in different states, company executives used to travel extensively to carry out meetings at each location.

    Therefore, travel expenses represent a significant proportion of operational expenses and reducing travel costs is a key goal for the company’s executives.

    What do the stakeholders need to know?

    Supporting Tool icon 1.3 0.5 Hour

    What do the stakeholders need to know?

    1. Identify the key things that the stakeholders would need to know based on the goals and pain points derived from the previous step.These are your success criteria and must be met to successfully achieve the desired goals.

    VC Case Study

    The CEO needs to have assurance that without executives traveling to each location, remote meetings can be as effective as in-person meetings.

    These meetings must provide the same outcome and allow executives to collaborate and make similar strategic decisions without the onsite, physical presence.

    Therefore, the success criteria are:

    • Reduced travel costs
    • Effective collaboration
    • High-quality meetings

    What do I need to measure?

    Supporting Tool icon 1.4 1 Hour

    What does IT need to measure?

    1. Identify the IT services that are leveraged to achieve the business goals and success criteria.
    2. Identify the users of those services and determine the nature of usage for each group of users.
    3. Identify the key indicators that must be measured for those services from an IT perspective.

    VC Case Study

    The IT department decides to implement the video conferencing service to reduce the number of onsite meetings. This technology would allow executives to meet remotely with both audio and video and is the best option to replicate a physical meeting.

    The service is initially available to senior executives and will be rolled out to all internal users once the initial implementation is deemed successful.

    To determine the success of the service, the following needs to be measured:

    1. Outcomes of VC meetings
    2. Quality of the VC meetings
    3. Reduction in travel expenses

    Derive service metrics

    Supporting Tool icon 1.5 0.5 Hour

    Derive your service metrics

    1. Derive the service metrics that are meaningful to business stakeholders based on the IT services and the key indicators identified in the previous steps.
    2. Distinguish between service metrics and business metrics. You may identify some business metrics in addition to the IT metrics, and although these are important, IT doesn’t own the process of tracking and reporting business metrics.

    VC Case Study

    In the previous step, IT identified that it must measure the outcomes of VC meetings, quality of the VC meetings, and the reduction in travel expenses. From these, the appropriate service metrics can be derived to answer the needs of the CEO.

    IT needs to measure:

    1. Percent of VC meetings successfully delivered
    2. Growth of number of executive meetings conducted via VC
    Outcomes

    IT also identified the following business metrics:

    1. Reduction in percent of travel expense/spend
    2. Reduction in lost time due to travel

    Validate your metrics

    Once appropriate service metrics are derived from business objectives, the next step is to determine whether or not it is viable to actually measure the metrics.

    Can you measure it? The first question IT must answer is whether the metric is measurable. IT must identify the data source, validate its ability to collect the data, and specify the data requirement. Not all metrics can be measured!
    How will you measure it? If the metric is measurable, the next step is to create a way to measure the actual data. In most cases, simple formulas that can be easily understood are the best approach.
    Define your actions Metrics must be used to drive or reinforce desirable outcomes and behaviors. Thus, IT must predetermine the necessary actions associated with the different metric levels, thresholds, or trends.

    Determine if you can measure the identified metric

    Supporting Tool icon 1.6 0.5 Hour

    INSTRUCTIONS

    1. Determine what data sources are available. Make sure that you know where the information you need is captured, or will need to be captured. This would include:
      • A ticket/request system
      • An auto discovery tool
      • A configuration management database ( CMDB)
    2. Confirm that IT has the ability to collect the information.
      • If the necessary data is already contained in an identified data source, then you can proceed.
      • If not, consider whether it’s possible to gather the information using current sources and systems.
      • Understand the constraints and cost/ROI to implement new technology or revise processes and data gathering to produce the data.

    VC Case Study

    Using the metric derived from the video conferencing service example, IT wants to measure the % of VC meetings successfully delivered.

    What are the data sources?

    • Number of VC meetings that took place
    • Number of service incidents
    • User survey

    Determine if you can measure the identified metric

    Supporting Tool icon 1.6 0.5 Hour

    INSTRUCTIONS

    1. Understand your data requirements
      • To produce relevant metrics from your data, you need to ensure the level of quality and currency that provides you with useful information. You need to define:
        • The level of detail that has to be captured to make the data useful.
        • The consistency of the data, and how it needs to be entered or gathered.
        • The accuracy of the data. This includes how current the data needs to be, how quickly changes have to be made, and how data quality will be verified.

    VC Case Study

    Data requirement for percent of successful VC meetings:

    • Level of detail – user category, location, date/time,
    • Consistency – how efficiently are VC-related incidents opened and closed? Is the data collected and stored consistently?
    • Accuracy – is the information entered accurately?

    Create the calculation to measure it

    Supporting Tool icon 1.7 0.5 Hour

    Determine how to calculate the metrics.

    INSTRUCTIONS
    1. Develop the calculations that will be used for each accepted metric. The measurement needs to be clear and straightforward.
    2. Define the scope and assumptions for each calculation, including:
      • The defined measurement period (e.g. monthly, weekly)
      • Exclusions (e.g. nonbusiness hours, during maintenance windows)

    VC Case Study

    Metric: Percent of VC meetings delivered successfully

    IT is able to determine the total number of VC meetings that took place and the number of VC service requests to the help desk.

    That makes it possible to use the following formula to determine the success percentage of the VC service:

    ((total # VC) – (# of VC with identified incidents)) / (total # VC) * 100

    Define the actions to be taken for each metric

    Supporting Tool icon 1.7 1.5 Hour

    INSTRUCTIONS

    Centered on the defined metrics and their calculations, IT can decide on the actions that should be driven out of each metric based on one of the following scenarios:
    • Scenario 1: Ad hoc remedial action and root-cause investigation. If the reason for the result is unknown, determining root cause or identifying trends is required to determine required actions.
    • Scenario 2: Predefined remedial action. A set of predetermined actions associated with different results. This is useful when the meaning of the results is clear and points to specific issues within the environment.
    • Scenario 3: Nonremedial action. The metrics may produce a result that reinforces or supports company direction and strategy, or identifies an opportunity that may drive a new initiative or idea.

    VC Case Study

    If the success rate of the VC meetings is below 90%, IT needs to focus on determining if there is a common cause and identify if this is a consistent downward trend.

    A root-cause analysis is performed that identifies that network issues are causing difficulties, impacting the connection quality and usability of the VC service.

    Validate the confirmed metrics with the business

    Supporting Tool icon 1.8 1 Hour

    INPUT: Selected service metrics, Discussion with the business

    OUTPUT: Validated metrics with the business

    Materials: Metrics with calculation methodology

    Participants: IT and business stakeholders, Service owners

    INSTRUCTIONS

    1. Once you have derived the appropriate metrics and established that the metrics are measurable, you must go back to the targeted stakeholders and validate that the selected metrics will provide the right information to meet their identified goals and success criteria.
    2. Add confirmed metrics to the Metrics Tracking Tool, in the Metrics Tracking Plan tab.
    Service Metric Corresponding
    Business Goal
    Measurement
    Method
    Defined Actions

    Example: Measuring the online banking service at a financial institution

    Who are IT’s stakeholders? The financial institution provides various banking solutions to its customers. Retail banking is a core service offered by the bank and the VP of retail banking is a major stakeholder of IT.
    What are their goals and pain points? The VP of retail banking’s highest priorities are to increase revenue, increase market share, and maintain the bank’s brand and reputation amongst its customers.
    What do they need to know? In order to measure success, the VP of retail banking needs to determine performance in attracting new clients, retaining clients, expanding into new territory, and whether they have increased the number of services provided to existing clients.
    What does IT need to measure? The recent implementation of an online banking service is a key initiative that will keep the bank competitive and help retail banking meet its goals. The key indicators of this service are: the total number of clients, the number of products per client, percent of clients using online banking, number of clients by segment, service, territory.
    Derive the service metrics Based on the key indicators, IT can derive the following service metrics:
    1. Number of product applications originated from online banking
    2. Customer satisfaction/complaints
    As part of the process, IT also identified some business metrics, such as the number of online banking users per month or the number of times a client accesses online banking per month.

    Design service metrics to track service performance and value

    CASE STUDY
    Industry: Manufacturing | Source: CIO
    Challenge Solution Results
    The IT organization needed to generate metrics to show the business whether the video conferencing service was being adopted and if it was providing the expected outcome and value.

    Standard IT metrics were technical and did not provide a business context that allowed for easy understanding of performance and decision making.

    The IT organization, working through the CIO and service managers, sat down with the key business stakeholders of the video conferencing service.

    They discussed the goals for the meeting and defined the success criteria for those goals in the context of video conference meeting outcomes.

    The success criteria that were discussed were then translated into a set of questions (key performance indicators) that if answered, would show that the success criteria were achieved.

    The service manager identified what could be measured to answer the defined questions and eliminated any metrics that were either business metrics or non-IT related.

    The remaining metrics were identified as the possible service metrics, and the ability to gather the information and produce the metric was confirmed.

    Service metrics were defined for:

    1. Percent of video conference meetings delivered successfully
    2. Growth in the number of executive meetings conducted via video conference

    If you want additional support, have our analysts guide you through this phase as part of an Info-Tech Workshop Associated Activity icon

    Book a workshop with our Info-Tech analysts:

    Photo of Valence Howden, Senior Manager, CIO Advisory, Info-Tech Research Group.
    • To accelerate this project, engage your IT team in an Info-Tech workshop with an Info-Tech analyst team.
    • Info-Tech analyst will join you and your team onsite at your location or welcome you to Info-Tech's historic Toronto office to participate in an innovative onsite workshop.
    • Contact your account manager (www.infotech.com/account), or email Workshops@InfoTech.com for more information.

    The following are sample activities that will be conducted by Info-Tech analysts with your team:

    1.1

    Sample of activity 1.1 'Determine your stakeholders'. Determine stakeholder needs, goals, and pain points

    The onsite analyst will help you select key stakeholders and analyze their business objectives and current pain points.

    1.2

    Sample of activity 1.2 'Identify goals and pain points of your stakeholders'. Determine the success criteria and related IT services

    The analyst will facilitate a discussion to uncover the information that these stakeholders care about. The group will also identify the IT services that are supporting these objectives.

    If you want additional support, have our analysts guide you through this phase as part of an Info-Tech Workshop Associated Activity icon

    Book a workshop with our Info-Tech analysts:

    1.5

    Sample of activity 1.5 'Derive service metrics'. Derive the service metrics

    Based on the key performance indicators obtained in the previous page, derive meaningful business metrics that are relevant to the stakeholders.

    1.6

    Sample of activity 1.6 'Determine if you can measure the identified metric'. Validate the data collection process

    The analyst will help the workshop group determine whether the identified metrics can be collected and measured. If so, a calculation methodology is created.

    1.7

    Sample of activity 1.7 'Create the caluclation to measure it'. Validate metrics with stakeholders

    Establish a feedback mechanism to have business stakeholders validate the meaningfulness of the metrics.

    Develop Meaningful Service Metrics to Ensure Business and User Satisfaction

    PHASE 2

    Design Reports and Dashboards

    Step (2): Design Reports and Dashboards

    PHASE 1PHASE 2PHASE 3

    1.1

    Derive the Service Metrics

    1.2

    Validate the Metrics

    2.1

    Determine Reporting Format

    3.1

    Select Pilot Metrics

    3.2

    Activate and Maintain Metrics

    This step involves the following participants:

    • Business Relationship Manager
    • Service Level Manager
    • Business Stakeholders

    Outcomes of this step

    • Presentation format selected based on stakeholder needs and preference for information
    • Presentation format validated with stakeholders

    Phase 2 outline

    Associated Activity icon Call 1-888-670-8889 or email GuidedImplementations@InfoTech.com for more information.

    Complete these steps on your own, or call us to complete a guided implementation. A guided implementation is a series of 2-3 advisory calls that help you execute each phase of a project. They are included in most advisory memberships.

    Guided Implementation 2: Design Reports and Dashboards

    Proposed Time to Completion (in weeks): 3 weeks
    Step 2.1: Select Presentation Format Step 2.2: Review Design
    Start with an analyst kick-off call:
    • Review the different format of metrics presentation and discuss the pros/cons of each format
    • Discuss stakeholder needs/preference for data
    • Select the presentation format
    Review findings with analyst:
    • Discuss stakeholder feedback based on selected presentation format
    • Modify and adjust the presentation format as needed
    Then complete these activities…
    • Design the metrics using the selected format
    Then complete these activities…
    • Finalize the design for metrics presentation
    With these tools & templates:
    • Metrics Presentation Format Selection Guide
    With these tools & templates:
    • Metrics Presentation Format Selection Guide

    Design the reports – overview

    Figure representing 'SLM' and/or 'BRM'. Step 1
    Understand the pros and cons of different reporting styles
    Figure representing 'SLM' and/or 'BRM'. Step 2
    Determine your reporting and presentation style

    Presentation Format Selection

    Figure representing 'SLM' and/or 'BRM'. Step 3
    Design your metrics reports
    A star.

    Validated Service Reports

    The design of service metrics reporting is critically important. The reporting style must present the right information in the most interesting and stakeholder-centric way possible to ensure that it is read and used.

    The reports must also display information in a way that generates actions. If your stakeholders cannot make decisions, kick off activities, or ask questions based on your reports, then they have no value.

    Determine the right presentation format for your metrics

    Most often, metrics are presented in the following ways:

    Dashboard
    (PwC. “Mega-Trends and Implications.”)
    Sample of the 'Dashboard' metric presentation format.
    Infographic
    (PwC. “Healthcare’s new entrants.”)
    Sample of the 'Infographic' metric presentation format.
    Report
    (PwC Blogs. “Northern Lights.”)
    Sample of the 'Report' metric presentation format.
    Scorecard
    (PwC. “Annual Report 2015.”)
    Sample of the 'Scorecard' metric presentation format.

    Understand the advantages and disadvantages of each reporting style – Dashboard

    A dashboard is a reporting method that provides a dynamic at-a-glance view of key metrics from the perspective of key stakeholders. It provides a quick graphical way to process important performance information in real time.

    Features

    Typically web-based

    Dynamic data that is updated in real time

    Advantage

    Aggregates a lot of information into a single view

    Presents metrics in a simplistic style that is well understood

    Provides a quick point-in-time view of performance

    Easy to consume visual presentation style

    Disadvantage

    Complicated to set up well.
    Requires additional technology support: programming, API, etc.

    Promotes a short-term outlook – focus on now, no historical performance and no future trends. Doesn’t provide the whole picture and story.

    Existing dashboard tools are often not customized enough to provide real value to each stakeholder.

    Dashboards present real-time metrics that can be accessed and viewed at any time

    Sample of the 'Dashboard' metric presentation format.
    (Source: PwC. “Mega-Trends and Implications.”)
    Metrics presented through online dashboards are calculated in real time, which allows for a dynamic, current view into the performance of IT services at any time.

    Understand the advantages and disadvantages of each reporting style – Infographic

    An infographic is a graphical representation of metrics or data, which is used to show information quickly and clearly. It’s based on the understanding that people retain and process visual information more readily than written details.

    Features

    Turns dry into attractive –transforms data into eye-catching visual memory that is easier to retain

    Can be used as the intro to a formal report

    There are endless types of infographics

    Advantage

    Easily consumable

    Easy to retain

    Eye catching

    Easily shared

    Spurs conversation

    Customizable

    Disadvantage

    Require design expertise and resources

    Can be time consuming to generate

    Could be easily misinterpreted

    Message can be lost with poor design

    Infographics allow for completely unique designs

    Sample of the 'Infographic' metric presentation format.
    (Source: PwC. “Healthcare’s new entrants…”)
    There is no limit when it comes to designing an infographic. The image used here visually articulates the effects of new entrants pulling away the market.

    Understand the advantages and disadvantages of each reporting style – Formal Report

    A formal report is a more structured and official reporting style that contains detailed research, data, and information required to enable specific business decisions, and to help evaluate performance over a defined period of time.

    Definition

    Metrics can be presented as a component of a periodic, formal report

    A physical document that presents detailed information to a particular audience

    Advantage

    More detailed, more structured and broader reporting period

    Formal, shows IT has put in the effort

    Effectively presents a broader and more complete story

    Targets different stakeholders at the same time

    Disadvantage

    Requires significant effort and resources

    Higher risk if the report does not meet the expectation of the business stakeholder

    Done at a specific time and only valuable for that specific time period

    Harder to change format

    Formal reports provide a detailed view and analysis of performance

    Sample of the 'Formal Report' metric presentation format.
    (Source: PwC Blogs. “Northern Lights: Where are we now?”)
    An effective report incorporates visuals to demonstrate key improvements.

    Formal reports can still contain visuals, but they are accompanied with detailed explanations.

    Understand the advantages and disadvantages of each reporting style – Scorecard

    A scorecard is a graphic view of the progress and performance over time of key performance metrics. These are in relation to specified goals based on identified critical stakeholder objectives.

    Features

    Incorporates multiple metrics effectively.

    Scores services against the most important organizational goals and objectives. Scorecards may tie back into strategy and different perspectives of success.

    Advantage

    Quick view of performance against objectives

    Measure against a set of consistent objectives

    Easily consumable

    Easy to retain

    Disadvantage

    Requires a lot of forethought

    Scorecards provide a time-bound summary of performance against defined goals

    Sample of the 'Scorecard' metric presentation format.
    (PwC. “Annual Report 2015.”)
    Scorecards provide a summary of performance that is directly linked to the organizational KPIs.

    Determine your report style

    Supporting Tool icon 2.1 Metrics Presentation Format Selection Guide

    In this section, you will determine the optimal reporting style for the service metrics.

    This guide contains four questions, which will help IT organizations identify the most appropriate presentation format based on stakeholder preference and needs for metrics.

    1. Who is the relevant stakeholder?
    2. What are the defined actions for the metric?
    3. How frequently does the stakeholder need to see the metric?
    4. How does the stakeholder like to receive information?
    Sample of Info-Tech's Metrics Presentation Format Selection Guide.
    Download the Metrics Presentation Format Selection Guide.

    Determine your best presentation option

    Supporting Tool icon 2.1 2 Hours

    INPUT: Identified stakeholder and his/her role

    OUTPUT: Proper presentation format based on need for information

    Materials: Metrics Presentation Format Selection Guide

    Participants: BRM, SLM, Program Manager

    After deciding on the report type to be used to present the metric, the organization needs to consider how stakeholders will consume the metric.

    There are three options based on stakeholder needs and available presentation options within IT.

    1. Paper-based presentation is the most traditional form of reporting and works well with stakeholders who prefer physical copies. The report is produced at a specific time and requires no additional IT capability.
    2. Online documents stored on webpages, SharePoint, or another knowledge management system could be used to present the metrics. This allows the report to be linked to other information and easily shared.
    3. Online dashboards and graphics can be used to have dynamic, real-time reporting and anytime access. These webpages can be incorporated into an intranet and allow the user to view the metrics at any time. This will require IT to continuously update the data in order to maintain the accuracy of the metrics.

    Design your metric reports with these guidelines in mind

    Supporting Tool icon 2.2 30 Minutes
    1. Stakeholder-specificThe report must be driven by the identified stakeholder needs and preferences and articulate the metrics that are important to them.
    2. ClarityTo enable decision making and drive desired actions, the metrics must be clear and straightforward. They must be presented in a way that clearly links the performance measurement to the defined outcome without leading to different interpretations of the results.
    3. SimplicityThe report must be simple to read, understand, and analyze. The language of the report must be business-centric and remove as much complexity as possible in wording, imaging, and context.

    Be sure to consider access rights for more senior reports. Site and user access permissions may need to be defined based on the level of reporting.

    Metrics reporting on the video conferencing service

    CASE STUDY
    Industry: Manufacturing | Source: CIO Interview
    The Situation

    The business had a clear need to understand if the implementation of video conferencing would allow previously onsite meetings to achieve the same level of effectiveness.

    Reporting Context

    Provided reports had always been generated from an IT perspective and the business rarely used the information to make decisions.

    The metrics needed to help the business understand if the meetings were remaining effective and be tied into the financial reporting against travel expenses, but there would be limited visibility during the executive meetings.

    Approach

    The service manager reviewed the information that he had gathered to confirm how often they needed information related to the service. He also met with the CIO to get some insight into the reports that were already being provided to the business, including the ones that were most effective.

    Considerations

    The conversations identified that there was no need for a dynamic real-time view of the performance of the service, since tracking of cost savings and utility would be viewed monthly and quarterly. They also identified that the item would be discussed within a very small window of time during the management meetings.

    The Solution

    It was determined that the best style of reporting for the metric was an existing scorecard that was produced monthly, using some infographics to ensure that the information is clear at a glance to enable quick decision making.

    If you want additional support, have our analysts guide you through this phase as part of an Info-Tech Workshop Associated Activity icon

    Book a workshop with our Info-Tech analysts:

    Photo of Valence Howden, Senior Manager, CIO Advisory, Info-Tech Research Group.
    • To accelerate this project, engage your IT team in an Info-Tech workshop with an Info-Tech analyst team.
    • Info-Tech analyst will join you and your team onsite at your location or welcome you to Info-Tech's historic Toronto office to participate in an innovative onsite workshop.
    • Contact your account manager (www.infotech.com/account), or email Workshops@InfoTech.com for more information.

    The following are sample activities that will be conducted by Info-Tech analysts with your team:

    2.1

    Sample of presentation format option slide 'Determine the right presentation format for your metrics'. Understand the different presentation options

    The onsite analyst will introduce the group to the communication vehicles of infographic, scorecard, formal report, and dashboard.

    2.1

    Sample of activity 2.1 'Determine your best presentation option'. Assess stakeholder needs for information

    For selected stakeholders, the analyst will facilitate a discussion on how stakeholders would like to view information and how the metrics can be presented to aid decision making.

    If you want additional support, have our analysts guide you through this phase as part of an Info-Tech Workshop Associated Activity icon

    Book a workshop with our Info-Tech analysts:

    2.2

    Sample of activity 2.2 'Design your metric reports with these guidelines in mind'. Select and design the metric report

    Based on the discussion, the working group will select the most appropriate presentation format and create a rough draft of how the report should look.

    Develop Meaningful Service Metrics to Ensure Business and User Satisfaction

    PHASE 3

    Implement, Track, and Maintain Your Metrics

    Step (3): Implement, Track, and Maintain Your Metrics

    PHASE 1PHASE 2PHASE 3

    1.1

    Derive the Service Metrics

    1.2

    Validate the Metrics

    2.1

    Determine Reporting Format

    3.1

    Select Pilot Metrics

    3.2

    Activate and Maintain Metrics

    This step involves the following participants:

    • Service Level Manager
    • Business Relationship Manager
    • Service Metrics Program Manager

    Activities in this step

    • Determine the first batch of metrics to be implemented as part of the pilot program
    • Create a process to collect and validate data, determine initial targets, and integrate with SLM and BRM functions
    • Present the metric reports to the relevant stakeholders and incorporate the feedback into the metric design
    • Establish a standard process and roll out the implementation of metrics in batches
    • Establish a process to monitor and track the effectiveness of the service metrics program and make adjustments when necessary

    Phase 3 outline

    Associated Activity icon Call 1-888-670-8889 or email GuidedImplementations@InfoTech.com for more information.

    Complete these steps on your own, or call us to complete a guided implementation. A guided implementation is a series of 2-3 advisory calls that help you execute each phase of a project. They are included in most advisory memberships.

    Guided Implementation 3: Implement, Track, and Maintain Your Metrics

    Proposed Time to Completion (in weeks): 4 weeks
    Step 3.1: Select and Launch Pilot Metrics Step 3.2: Track and Maintain the Metrics
    Start with an analyst kick-off call:
    • Identify metrics that will be presented first to the stakeholders based on urgency or impact of the IT service
    • Determine the process to collect data, select initial targets, and integrate with SLM and BRM functions
    Review findings with analyst:
    • Review the success of metrics and discuss feedback from stakeholders
    • Roll out the metrics implementation to a broader audience
    • Establish roles and timelines for metrics maintenance
    Then complete these activities…
    • Document the first batch of metrics
    • Document the baseline, initial targets
    • Create a plan to integrate with SLM and BRM functions
    Then complete these activities…
    • Create a document that defines how the organization will track and maintain the success of the metrics program
    • Review the metrics program periodically
    With these tools & templates:
    • Metrics Tracking Tool
    With these tools & templates:
    • Metrics Tracking Tool

    Implement, Track, and Maintain the Metrics

    Figure representing 'SLM' and/or 'BRM'. Step 1
    Run your pilot

    Metrics Tracking Tool

    Figure representing 'SLM' and/or 'BRM'. Step 2
    Validate success

    Metrics Tracking Tool

    Figure representing 'SLM' and/or 'BRM'. Step 3
    Implement your metrics program in batches

    Metrics Tracking Tool

    A star.

    Active Service Metrics Program

    Once you have defined the way that you will present the metrics, you are ready to run a pilot with a smaller sample of defined service metrics.

    This allows you to validate your approach and make refinements to the implementation and maintenance processes where necessary, prior to activating all service metrics.

    Track the performance of your service metrics

    Supporting Tool icon 3.1

    The Metrics Tracking Tool will enable you to track goals and success metrics for your service metrics programs. It allows you to set long-term goals and track your results over time.

    There are three sections in this tool:
    1. Metrics Tracking Plan. Identify the metrics to be tracked and their purpose.
    2. Metrics Tracking Actuals. Monitor and track the actual performance of the metrics.
    3. Remediation Tracking. Determine and document the steps that need to be taken to correct a sub-performing metric.
    Sample of Info-Tech's Metrics Tracking Tool.

    Select pilot metrics

    Supporting Tool icon 3.1 30 Minutes

    INPUT: Identified services, Business feedback

    OUTPUT: Services with most urgent need or impact

    Materials: Service catalog or list of identified services

    Participants: BRM, SLM, Business representatives

    To start the implementation of your service metrics program and drive wider adoption, you need to run a pilot using a smaller subset of metrics.

    INSTRUCTIONS

    To determine the sample for the pilot, consider metrics that:

    • Are related to critical business services and functions
    • or
    • Address known/visible pain points for the business
    • or
    • Were designed for supportive or influential stakeholders

    Metrics that meet two or more criteria are ideal for the pilot

    Collect and validate data

    Supporting Tool icon 3.2 1 Hour

    INPUT: Identified metrics

    OUTPUT: A data collection mythology, Metrics tracking

    Materials: Metrics

    Participants: SLM, BRM, Service owner

    You will need to start collection and validation of your identified data in order to calculate the results for your pilot metrics.

    INSTRUCTIONS

    1. Initiate data collection
      • Use the data sources identified during the design phase and initiate the data collection process.
    2. Determine start date
      • If historical data can be retrieved and gathered, determine how far back you want your measurements to start.
    3. Compile data and validate
      • Ensure that the information is accurate and up to date. This will require some level of data validation and audit.
    4. Run the metric
      • Use the defined calculation and source data to generate the metrics result.
    5. Record metrics results
      • Use the metrics tracking sheet to track the actual results.

    Determine initial targets

    Supporting Tool icon 3.3 1 Hour

    INPUT: Historical data/baseline data

    OUTPUT: Realistic initial target for improvement

    Materials: Metrics Tracking Tool

    Participants: BRM, SLM, Service owner

    INSTRUCTIONS

    Identify an initial service objective based on one or more of the following options:

    1. Establish an initial target using historical data and trends of performance.
    2. Establish an initial target based on stakeholder-identified requirements and expectations.
    3. Run the metrics report over a defined period of time and use the baseline level of achievement to establish an initial target.

    The target may not always be a number - it could be a trend. The initial target will be changed after review with stakeholders

    Integrate with SLM and BRM processes

    Supporting Tool icon 3.4 1 Hour

    INPUT: SLM and BRM SOPs or responsibility documentations

    OUTPUT: Integrate service metrics into the SLM/BRM role

    Materials: SLM / BRM reports

    Participants: SLM, BRM, CIO, Program manager, Service manager

    The service metrics program is usually initiated, used, and maintained by the SLM and BRM functions.

    INSTRUCTIONS

    Ensure that the metrics pilot is integrated with those functions by:

    1. Engaging with SLM and BRM functions/resources
      • Identify SLM and BRM resources associated with or working on the services where the metrics are being piloted
      • Obtain their feedback on the metrics/reporting
    2. Integrating with the existing reporting and meeting cycles
      • Ensure the metrics will be calculated and available for discussion at standing meetings and with existing reports
    3. Establishing the metrics review and validation cycle for these metrics
      • Confirm the review and validation period for the metrics in order to ensure they remain valuable and actionable

    Generate reports and present to stakeholders

    Supporting Tool icon 3.5 1 Hour

    INPUT: Identified metrics, Selected presentation format

    OUTPUT: Metrics reports that are ready for distribution

    Materials: Metrics Presentation Format Selection Guide

    Participants: BRM, SLM, CIO, Business representatives

    INSTRUCTIONS

    Once you have completed the calculation for the pilot metrics:

    1. Confirm the report style for the selected metrics (as defined in Phase 2)
    2. Generate the reporting for the pilot metrics
    3. Present the pilot metric reports to the identified BRM and SLM resources who will present the reporting to the stakeholders
    4. Gather feedback from Stakeholders on metrics - results and process
    5. Create and execute remediation plans for any actions identified from the metrics
    6. Initiate the review cycle for metrics (to ensure they retain value)

    Plan the rollout and implementation of the metrics reporting program

    Supporting Tool icon 3.6 1 Hour

    INPUT: Feedback from pilot, Services in batch

    OUTPUT: Systematic implementation of metrics

    Materials: Metrics Tracking Tool

    Participants: BRM, SLM, Program manager

    Upon completion of the pilot, move to start the broader implementation of metrics across the organization:

    INSTRUCTIONS

    1. Identify the service metrics that you will implement. They can be selected based on multiple criteria, including:
      • Organizational area/business unit
      • Service criticality
      • Pain points
      • Stakeholder engagement (detractors, supporters)
    2. Create a rollout plan for implementation in batches, identifying expected launch timelines, owners, targeted stakeholders, and communications plans
    3. Use the implementation plan from the pilot to roll out each batch of service metrics:
      • Collect and validate data
      • Determine target(s)
      • Integrate with BRM and SLM
      • Generate and communicate reports to stakeholders

    Maintain the service metrics

    Supporting Tool icon 3.7 1.5 Hour

    INPUT: Feedback from business stakeholders

    OUTPUT: Modification to individual metrics or to the process

    Materials: Metrics Tracking Tool, Metrics Development Workbook

    Participants: CIO, BRM, SLM, Program manager, Service owner

    Once service metrics and reporting become active, it is necessary to determine the review time frame for your metrics to ensure they remain useful.

    INSTRUCTIONS

    1. Confirm and establish a review time frame with stakeholders (e.g. annually, bi-annually, after organizational or strategic changes).
    2. Meet with stakeholders by the review date to discuss the value of existing metrics and validate:
      • Whether the goals associated with the metrics are still valid
      • If the metric is still necessary
      • If there is a more effective way to present the metrics
    3. Track actions based on review outcomes and update the remediation tracking sheet.
    4. Update tracking sheet with last complete review date.

    Maintain the metrics

    Supporting Tool icon 3.7

    Based on the outcome of the review meeting, decide what needs to be done for each metric, using the following options:

    Add

    A new metric is required or an existing metric needs large-scale changes (example: calculation method or scope).
    Triggers metrics design as shown in phases 1 and 2.

    Change

    A minor change is required to the presentation format or data. Note: a major change in a metric would be performed through the Add option.

    Remove

    The metric is no longer required, and it needs to be removed from reporting and data gathering. A final report date for that metric should be determined.

    Maintain

    The metric is still useful and no changes are required to the metric, its measurement, or how it’s reported.

    Ensuring metrics remain valuable

    VC CASE STUDY
    Industry: Manufacturing | Source: CIO Interview

    Reviewing the value of active metrics

    When the video conferencing service was initially implemented, it was performed as a pilot with a group of executives, and then expanded for use throughout the company. It was understood that prior to seeing the full benefit in cost reduction and increased efficiency and effectiveness, the rate of use and adoption had to be understood.

    The primary service metrics created for the service were based on tracking the number of requests for video conference meetings that were received by the IT organization. This identified the growth in use and could be used in conjunction with financial metrics related to travel to help identify the impact of the service through its growth phase.

    Once the service was adopted, this metric continued to be tracked but no longer showed growth or expanded adoption.

    The service manager was no longer sure this needed to be tracked.

    Key Activity

    The metrics around requests for video conference meetings were reviewed at the annual metrics review meeting with the business. The service manager asked if the need for the metric, the goal of tracking adoption, was still important for the business.

    The discussion identified that the adoption rate was over 80%, higher than anticipated, and that there was no value in continuing to track this metric.

    Based on the discussion, the adoption metrics were discontinued and removed from data gathering and reporting, while a success rate metric was added (how many meetings ran successfully and without issue) to ensure the ongoing value of the video conferencing service.

    If you want additional support, have our analysts guide you through this phase as part of an Info-Tech Workshop Associated Activity icon

    Book a workshop with our Info-Tech analysts:

    Photo of Valence Howden, Senior Manager, CIO Advisory, Info-Tech Research Group.
    • To accelerate this project, engage your IT team in an Info-Tech workshop with an Info-Tech analyst team.
    • Info-Tech analyst will join you and your team onsite at your location or welcome you to Info-Tech's historic Toronto office to participate in an innovative onsite workshop.
    • Contact your account manager (www.infotech.com/account), or email Workshops@InfoTech.com for more information.

    The following are sample activities that will be conducted by Info-Tech analysts with your team:

    3.1

    Sample of activity 3.1 'Select pilot metrics'. Select the pilot metrics

    The onsite analyst will help the workshop group select the metrics that should be first implemented based on the urgency and impact of these metrics.

    3.2

    Sample of activity 3.2 'Collect and validate data'. Gather data and set initial targets

    The analyst will help the group create a process to gather data, measure baselines, and set initial targets.

    If you want additional support, have our analysts guide you through this phase as part of an Info-Tech Workshop Associated Activity icon

    Book a workshop with our Info-Tech analysts:

    3.5

    Sample of activity 3.5 'Generate reports and present to stakeholders'. Generate the reports and validate with stakeholders

    The Info-Tech analyst will help the group establish a process to receive feedback from the business stakeholders once the report is generated.

    3.6

    Sample of activity 3.6 'Plan the rollout and implementation of the metrics reporting program'. Implement the service metrics program

    The analyst will facilitate a discussion on how to implement the metrics program across the organization.

    3.7

    Sample of activity 3.7 'Maintain the service metrics'. Track and maintain the metrics program

    Set up a mechanism to ensure the success of the metrics program by assessing process adherence and process validity.

    Insight breakdown

    Insight 1

    Service metrics are critical to ensuring alignment of IT service performance and business service value achievement.

    Insight 2

    Service metrics reinforce positive business and end-user relationships by providing user-centric information that drives responsiveness and consistent service improvement.

    Insight 3

    Poorly designed metrics drive unintended and unproductive behaviors that have negative impacts on IT and produce negative service outcomes.

    Summary of accomplishment

    Knowledge Gained

    • Follow a methodology to identify metrics that are derived from business objectives.
    • Understand the proper presentation format based on stakeholder needs for information.
    • Establish a process to ensure the metrics provided will continue to provide value and aid decision making.

    Processes Optimized

    • Metrics presentation to business stakeholders
    • Metrics maintenance and tracking

    Deliverables Completed

    • Metrics Development Workbook
    • Metrics Presentation Format Selection Guide
    • Metrics Tracking Tool

    Research contributors and experts

    Name Organization
    Joe Evers Joe Evers Consulting
    Glen Notman Associate Partner, Citihub
    David Parker Client Program Manager, eHealth Ontario
    Marianne Doran Collins CIO, The CIO-Suite, LLC
    Chris Kalbfleisch Manager, Service Management, eHealth Ontario
    Joshua Klingenberg BHP Billiton Canada Inc.

    Related Info-Tech research

    Stock image of a menu. Design & Build a User-Facing Service Catalog
    The user-facing service catalog is the go-to place for IT service-related information.
    Stock image of a laptop keyboard. Unleash the True Value of IT by Transforming Into a Service Provider
    Earn your seat at the table and influence business strategy by becoming an IT service provider.

    Bibliography

    Pollock, Bill. “Service Benchmarking and Measurement: Using Metrics to Drive Customer Satisfaction and Profits.” Aberdeen Group. June 2009. http://722consulting.com/ServiceBenchmarkingandMeasurement.pdf

    PwC. “Mega-Trends and Implications.” RMI Discussion. LinkedIn SlideShare. September 2015. http://www.slideshare.net/AnandRaoPwC/mega-trends-and-implications-to-retirement

    PwC. “Healthcare’s new entrants: Who will be the industry’s Amazon.com?” Health Research Institute. April 2014. https://www.pwc.com/us/en/health-industries/healthcare-new-entrants/assets/pwc-hri-new-entrant-chart-pack-v3.pdf

    PwC. “Northern Lights: Where are we now?” PwC Blogs. 2012. http://pwc.blogs.com/files/12.09.06---northern-lights-2--summary.pdf

    PwC. “PwC’s key performance indicators

    Make the Case for Enterprise Business Analysis

    • Buy Link or Shortcode: {j2store}509|cart{/j2store}
    • member rating overall impact: N/A
    • member rating average dollars saved: N/A
    • member rating average days saved: N/A
    • Parent Category Name: Requirements & Design
    • Parent Category Link: /requirements-and-design
    • It can be difficult to secure alignment between the many lines of business, IT included, in your organization.
    • Historically, we have drawn a dividing line between IT and "the business.”
    • The reality of organizational politics and stakeholder bias means that, with selection and prioritization, sometimes the highest value option is dismissed to make way for the loudest voice’s option.

    Our Advice

    Critical Insight

    • Enterprise business analysis can help you stop the debate between IT and “the business,” as it sees everyone as part of the business. It can effectively break down silos, support the development of holistic strategies to address internal and external risks, and remove the bias and politics in decision making all too common in organizations.
    • The business analyst is the only role that can connect the strategic with the tactical, the systems, and the operations and do so objectively. It is the one source to show how people, process, and technology connect and relate, and the most skilled can remove bias and politics from their lens of view.
    • Maturity can’t be rushed. Build your enterprise business analysis program on a solid foundation of leading and consistent business analysis practices to secure buy-in and have a program that is sustainable in the long term.

    Impact and Result

    Let’s make the case for enterprise business analysis!

    • Organizations that have higher business analysis maturity and deploy enterprise analysis deliver better quality outcomes, with higher value, lower cost, and higher user satisfaction.
    • Business analysts should be contributing at the strategic level, as they need to understand multiple horizons simultaneously and be able to zoom in and out as the context calls for it. Business analysts aren’t only for projects.

    Make the Case for Enterprise Business Analysis Research & Tools

    Besides the small introduction, subscribers and consulting clients within this management domain have access to:

    1. Make the Case for Enterprise Business Analysis Storyboard – Take your business analysis from tactics to strategy.

    • Make the Case for Enterprise Business Analysis Storyboard

    2. Communicate the Case for Enterprise Business Analysis Template – Make the case for enterprise business analysis.

    • Communicate the Case for Enterprise Business Analysis
    [infographic]

    Further reading

    Make the Case for Enterprise Business Analysis

    Putting the strategic and tactical puzzle together.

    Analyst Perspective

    We commonly recognize the value of effective business analysis at a project or tactical level. A good business analysis professional can support the business by identifying its needs and recommending solutions to address them.
    Now, wouldn't it be great if we could do the same thing at a higher level?
    Enterprise (or strategic) business analysis is all about seeing that bigger picture, an approach that makes any business analysis professional a highly valuable contributor to their organization. It focuses on the enterprise, not a specific project or line of business.
    Leading the business analysis effort at an enterprise level ensures that your business is not only doing things right, but also doing the right things; aligned with the strategic vision of your organization to improve the way decisions are made, options are analyzed, and successful results are realized.

    Vincent Mirabelli

    Vincent Mirabelli
    Principal Research Director, Applications Delivery and Management
    Info-Tech Research Group

    Executive Summary

    Your Challenge

    • Difficulty properly aligning between the many lines of business in your organization.
    • Historically, we have drawn a dividing line between IT and the business.
    • The reality of organizational politics and stakeholder bias means that, with selection and prioritization, sometimes the highest value option is dismissed in favor of the loudest voice.

    Common Obstacles

    • Difficulty aligning an ever-changing backlog of projects, products, and services while simultaneously managing risks, external threats, and stakeholder expectations.
    • Many organizations have never heard of enterprise business analysis and only see the importance of business analysts at the project and delivery level.
    • Business analysis professionals rarely do enough to advocate for a seat at the strategic tables in their organizations.

    Info-Tech's Approach

    Let's make the case for enterprise business analysis!

    • Organizations that have higher business analysis maturity and deploy enterprise business analysis deliver better quality outcomes with higher value, lower cost, and higher user satisfaction.
    • Business analysts aren't only for projects. They should contribute at the strategic level, since they need to understand multiple horizons simultaneously and be able to zoom in and out as the context requires.

    Info-Tech Insight

    Enterprise business analysis can help you reframe the debate between IT and the business, since it sees everyone as part of the business. It can effectively break down silos, support the development of holistic strategies to address internal and external risks, and remove bias and politics from decision making.

    Phase 1

    Build the case for enterprise business analysis

    Phase 1

    Phase 2

    1.1 Define enterprise business analysis

    1.2 Identify your pains and opportunities

    2.1 Set your vision

    2.2 Define your roadmap and next steps

    2.3 Complete your executive communications deck

    This phase will walk you through the following activities:

    • 1.1.1 Discuss how business analysis is used in our organization
    • 1.1.2 Discuss your disconnects between strategy and tactics
    • 1.2.1 Identify your pains and opportunities

    This phase involves the following participants:

    • Business analyst(s)
    • Organizational business leaders
    • Any other relevant stakeholders

    How business analysis supports our success today

    Delivering value at the tactical level

    Effective business analysis helps guide an organization through improvements to processes, products, and services. Business analysts "straddle the line between IT and the business to help bridge the gap and improve efficiency" in an organization (CIO, 2019).
    They are most heavily involved in:

    • Defining needs
    • Modeling concepts, processes, and solutions
    • Conducting analysis
    • Maintaining and managing requirements
    • Managing stakeholders
    • Monitoring progress
    • Doing business analysis planning
    • Conducting elicitation

    In a survey, business analysts indicated that of their total working time, they spend 31% performing business analysis planning and 41% performing elicitation and analysis (PMI, 2017).

    By including a business analyst in a project, organizations benefit by:
    (IAG, 2009)

    87%

    Reduced time overspending

    75%

    Prevented budget overspending

    78%

    Reduction in missed functionality

    1.1.1 Discuss how business analysis is used in your organization

    15-30 minutes

    1. Gather the appropriate stakeholders to discuss their knowledge, experience, and perspectives on business analysis. This should relate to their experience and not a future or aspirational usage.
    2. Have a team member facilitate the session.
    3. Brainstorm and document all shared thoughts and perspectives.
    4. Synthesize those thoughts and perspectives and record the results for the group to review and discuss.
    5. Transfer the results to the Communicate the Case for Enterprise Business Analysis template

    Input

    • Stakeholder knowledge and experience

    Output

    • A shared understanding of how your organization leverages its business analysis function

    Materials

    • Whiteboard/Flip charts
    • Collaborative whiteboard
    • Communicate the Case for Enterprise Business Analysis template

    Participants

    • Business analyst(s)
    • Organizational business leaders
    • Any other relevant stakeholders

    Download the Communicate the Case for Enterprise Business Analysis template

    Executives and leadership are satisfied with IT when there is alignment between tactics and goals

    Info-Tech's CIO Business Vision Survey data highlights the importance of IT projects in supporting the business to achieve its strategic goals.

    However, Info-Tech's CEO-CIO Alignment Survey (N=124) data indicates that CEOs perceive IT as poorly aligned with the business' strategic goals.

    Info-Tech's CIO-CEO Alignment Diagnostics

    43%

    of CEOs believe that business goals are going unsupported by IT.

    60%

    of CEOs believe that IT must improve understanding of business goals.

    80%

    of CIOs/CEOs are misaligned on the target role of IT.

    30%

    of business stakeholders support their IT departments.

    Addressing problems solely with tactics does not always have the desired effect

    94%

    Source: "Out of the Crisis", Deming (via Harvard Business Review)

    According to famed management and quality thought leader and pioneer W. Edwards Deming, 94% of issues in the workplace are systemic cause significant organizational pain.

    Yet we continue to address them on the surface, rather than acknowledge how ingrained they are in our culture, systems, and processes.

    For example, we:

    • Create workarounds to address process and solution constraints
    • Expect that poor (or lack of ) leadership can be addressed in a course or seminar
    • Expect that "going Agile" will resolve our problems, and that decision making, governance, and organizational alignment will happen organically.

    Band-aid solutions rarely have the desired effect, particularly in the long-term.

    Our solutions should likewise focus on the systemic/macro environment. We can do this via projects, products and services, but those don't always address the larger issues.

    If we take the work our business analysis currently does in defining needs and solutions, and elevate this to the strategic level, the results can be impactful.

    Many organizations would benefit from enhancing their business analysis maturity

    The often-overlooked strategic value of the role comes with maturing your practices.

    Only 18% of organizations have mature (optimized or established) business analysis practices.

    With that higher level of maturity comes increased levels of capability, efficiency, and effectiveness in delivering value to people, processes, and technology. Through such efforts, they're better equipped and able to connect the strategy of their organization to the projects, processes, and products they deliver.

    They shift focus from "figuring business analysis out" to truly unleashing its potential, with business analysts contributing in strategic and tactical ways.

    an image showing the following data: Optimized- 5; Established- 13; Improving- 37; Starting- 25; Ad hoc- 21

    (Adapted from PMI, 2017)

    Info-Tech Insight

    Business analysts are best suited to connect the strategic with the tactical, the systems, and the operations. They maintain the most objective lens regarding how people, process, and technology connect and relate, and the most skilled of them can remove bias and politics from their perspective.

    1.1.2 Discuss your disconnects between strategy and tactics

    30-60 minutes

      1. Gather the appropriate stakeholders to discuss their knowledge, experience, and perspectives regarding failures that resulted from disconnects between strategy and tactics.
      2. Have a team member facilitate the session.
      3. Brainstorm and document all shared thoughts and perspectives.
      4. Synthesize those thoughts and perspectives and record the results.
      5. Transfer the results to the Communicate the Case for Enterprise Business Analysis template.

    Input

    • Stakeholder knowledge and experience

    Output

    • A shared understanding and list of failures due to disconnects between strategy and tactics

    Materials

    • Whiteboard/Flip charts
    • Collaborative whiteboard
    • Communicate the Case for Enterprise Business Analysis template

    Participants

    • Business analyst(s)
    • Organizational business leaders
    • Any other relevant stakeholders

    Download the Communicate the Case for Enterprise Business Analysis template

    Defining enterprise business analysis

    Terms may change, but the function remains the same.

    Enterprise business analysis (sometimes referred to as strategy analysis) "…focuses on defining the future and transition states needed to address the business need, and the work required is defined both by that need and the scope of the solution space. It covers strategic thinking in business analysis, as well as the discovery or imagining of possible solutions that will enable the enterprise to create greater value for stakeholders and/or capture more value for itself."
    (Source: "Business Analysis Body of Knowledge," v3)

    Define the function of enterprise business analysis

    This is a competitive advantage for mature organizations.

    Organizations with high-performing business analysis programs experience an enhanced alignment between strategy and operations. This contributes to improved organizational performance. We see this in financial (69% vs. 45%) and strategic performance (66% vs. 21%), also organizational agility (40% vs. 14%) and management of operational projects (62% vs. 29%). (PMI, 2017)

    When comparing enterprise with traditional business analysis, we see stark differences in the size and scope of their view, where they operate, and the role they play in organizational decision making.

    Enterprise Traditional
    Decision making Guides and influences Executes
    Time horizon 2-10 years 0-2 years
    Focus Strategy, connecting the strategic to the operational Operational, optimizing how business is done, and keeping the lights on
    Domain

    Whole organization

    Broader marketplace

    Only stakeholder lines of business relevant to the current project, product or service
    Organizational Level Executive/Leadership Project

    (Adapted from Schulich School of Business)

    Info-Tech Insight

    Maturity can't be rushed. Build your enterprise business analysis program on a solid foundation of leading and consistent business analysis practices to secure buy-in and have a program that is sustainable in the long term.

    An image showing the percentages of high- and low- maturity organizations, for the following categories: Financial performance; Strategy implementation; Organizational agility; Management of projects.

    (Adapted from PMI, 2017)

    How enterprise business analysis is used to improve organizations

    The biggest sources of project failure include:

    • Wrong (or poor) requirements
    • Unrealistic (or incomplete) business case
    • Lack of appropriate governance and oversight
    • Poor implementation
    • Poor benefits management
    • Environmental changes

    Source: MindTools.com, 2023.

    Enterprise business analysis addresses these sources and more.

    It brings a holistic view of the organization, improving collaboration and decision making across the many lines of business, effectively breaking down silos.

    In addition to ensuring we're doing the right things, not just doing things right in the form of improved requirements and more accurate business cases, or ensuring return on investment (ROI) and monitoring the broader landscape, enterprise business analysis also supports:

    • Reduced rework and waste
    • Understanding and improving operations
    • Making well-informed decisions through improved objectivity/reduced bias
    • Identifying new opportunities for growth and expansion
    • Identifying and mitigating risk
    • Eliminating projects and initiatives that do not support organizational goals or objectives
    • A career-pathing option for business analysts

    Identify your pains and opportunities

    There are many considerations in enterprise business analysis.

    Pains, gains, threats, and opportunities can come at your organization from anywhere. Be it a new product launch, an international expansion, or a new competitor, it can be challenging to keep up.

    This is where an enterprise business analyst can be the most helpful.

    By keeping a pulse on the external and internal environments, they can support growth, manage risks, and view your organization through multiple lenses and perspectives to get a single, complete picture.

    External

    Internal

    Identifying competitive forces

    In the global environment

    Organizational strengths and weaknesses

    • Monitoring and maintaining your competitive advantage.
    • Understanding trends, risks and threats in your business domain, and how they affect your organization.
    • Benchmarking performance against like and unlike organizations, to realize where you stand and set a baseline for continuous improvement and business development.
    • Leveraging tools and techniques to scan the broader landscape on an ongoing basis. Using PESTLE analysis, they can monitor the political, economic, social, technological, legal, and environmental factors that impact when, where, how, and with who you conduct your business and IT operations.
    • Supporting alignment between a portfolio or program of projects and initiatives.
    • Improving alignment between the various lines of business, who often lack full visibility outside of their silo, and can find themselves clashing over time, resources, and attention from leaders.
    • Improving solutions and outcomes through objective option selection.

    1.2.1 Identify your pains and opportunities

    30-60 minutes

    1. As a group, generate a list of the current pains and opportunities facing your organization. You can focus on a particular type (competitive, market, or internal) or leave it open. You can also focus on pains or opportunities separately, or simultaneously.
    2. Have a team member facilitate the session.
    3. Record the results for the group to review, discuss, and prioritize.
      1. Discuss the impact and likelihood of each item. This can be formally ranked and quantified if there is data to support the item or leveraging the wisdom of the group.
      2. Prioritize the top three to five items of each type, as agreed by the group, and document the results.
    4. Transfer the results to the Communicate the Case for Enterprise Business Analysis template.

    Download the Communicate the Case for Enterprise Business Analysis template

    Input

    • Attendee knowledge
    • Supporting data, if available

    Output

    • A list of identified organizational pains and opportunities that has been prioritized by the group

    Materials

    • Whiteboard/Flip charts
    • Collaborative whiteboard
    • Communicate the Case for Enterprise Business Analysis template

    Participants

    • Business analyst(s)
    • Organizational business leaders
    • Any other relevant stakeholders

    Phase 2

    Prepare the foundations for your enterprise business analysis program

    Phase 1

    Phase 2

    1.1 Define enterprise business analysis

    1.2 Identify your pains and opportunities

    2.1 Set your vision

    2.2 Define your roadmap and next steps

    2.3 Complete your executive communications deck

    This phase will walk you through the following activities:

    • 2.1.1 Define your vision and goals
    • 2.1.2 Identify your enterprise business analysis inventory
    • 2.2.1 Now, Next, Later

    This phase involves the following participants:

    • Business analyst(s)
    • Organizational business leaders
    • Any other relevant stakeholders

    Set your vision

    Your vision becomes your "north star," guiding your journey and decisions.

    When thinking about a vision statement for enterprise business analysis, think about:

    • Who are we doing this for? Who will benefit?
    • What do our business partners need? What do our customers need?
    • What value do we provide them? How can we best support them?
    • Why is this special/different from how we usually do business?

    Always remember: Your goal is not your vision!

    Not knowing the difference will prevent you from both dreaming big and achieving your dream.

    Your vision represents where you want to go. It's what you want to do.

    Your goals represent how you want to achieve your vision.

    • They are a key element of operationalizing your vision.
    • Your strategy, initiatives, and features will align with one or more goals.

    Info-Tech Best Practice

    Your vision shouldn't be so far out that it doesn't feel real, nor so short term that it gets bogged down in details. Finding balance will take some trial and error and will be different depending on your organization.

    2.1.1 Define your vision and goals

    1-2 hours

    1. Gather the appropriate stakeholders to discuss their vision for enterprise business analysis. It should address the questions used in framing your vision statement.
    2. Have a team member facilitate the session.
    3. Review your current organizational vision and goals.
    4. Discuss and document all shared thoughts and perspectives on how enterprise business analysis can align with the organizational vision.
    5. Synthesize those thoughts and perspectives to create a vision statement.
    6. Transfer the results to the Communicate the Case for Enterprise Business Analysis template.

    Download the Communicate the Case for Enterprise Business Analysis template

    Input

    • Stakeholder vision, knowledge, and experience
    • Current organizational vision and goals

    Output

    • A documented vision and goals for your enterprise business analysis program

    Materials

    • Whiteboard/Flip charts
    • Collaborative whiteboard
    • Communicate the Case for Enterprise Business Analysis template

    Participants

    • Business analyst(s)
    • Organizational business leaders
    • Any other relevant stakeholders

    Components of successful enterprise business analysis programs

    Ensure you're off to the best start by examining where you are and where you want to go.

    Training

    • Do the current team members have the right level of training?
    • Can we easily obtain training to close any gaps?

    Competencies and capabilities

    • Do our business analysts have the right skills, attributes, and behaviors to be successful?

    Structure and alignment

    • Would the organizational culture support enterprise business analysis (EBA)?
    • How might we structure the EBA unit to maximize effectiveness?
    • How can we best support the organization's goals and objectives?

    Methods and processes

    • How do we plan on managing the work to be done?
    • Can we define our processes and workflows?

    Tools, techniques, and templates

    • Do we have the most effective tools, techniques, and templates?

    Governance

    • How will we make decisions?
    • How will the program be managed?

    2.1.2 Identify your enterprise business analysis inventory

    30-60 minutes

    1. Gather the appropriate stakeholders to discuss the current business analysis assets, which could be leveraged for enterprise business analysis. This includes people, processes, and technologies which cover skills, knowledge, resources, experience, knowledge, and competencies. Focus on what the organization currently has, and not what it needs.
    2. Have a team member facilitate the session.
    3. Record the results for the group to review and discuss.
    4. Transfer the results to the Communicate the Case for Enterprise Business Analysis template.

    Download the Communicate the Case for Enterprise Business Analysis template

    Input

    • Your current business analysis assets and resources Stakeholder knowledge and experience

    Output

    • A list of assets and resources to enable enterprise business analysis

    Materials

    • Whiteboard/Flip charts
    • Collaborative whiteboard
    • Communicate the Case for Enterprise Business Analysis template

    Participants

    • Business analyst(s)
    • Organizational business leaders
    • Any other relevant stakeholders

    Define your roadmap and next steps

    What do we have? What do we need?

    From completing the enterprise business analysis inventory, you will have a comprehensive list of all available assets.

    The next question is, how can this be leveraged to start building for the future?

    To operationalize enterprise business analysis, consider:

    • What do we still need to do?
    • How important are the identified gaps? Can we still operate?
    • What decisions do we need to make?
    • What stakeholders do we need to involve? Have we engaged them all?

    Lay out your roadmap

    Taking steps to mature your enterprise business analysis practice.

    The Now, Next, Later technique is a method for prioritizing and planning improvements or tasks. This involves breaking down a list of tasks or improvements into three categories:

    • Now tasks are those that must be completed immediately. These tasks are usually urgent or critical, and they must be completed to keep the project or organization running smoothly.
    • Next tasks are those that should be completed soon. These tasks are not as critical as Now tasks, but they are still important and should be tackled relatively soon.
    • Later tasks are those that can be completed later. These tasks are less critical and can be deferred without causing major problems.

    By using this technique, you can prioritize and plan the most important tasks, while allowing the flexibility to adjust as necessary.

    This technique also helps clarify what must be done first vs. what can wait. This prioritizes the most important things while keeping track of what must be done next, maintaining a smooth development/improvement process.

    An image of the now - next - later roadmap technique.

    2.2.1 Now, Next, Later

    1-2 hours

    1. Use the list of items created in 2.1.2 (Identify your enterprise business analysis inventory). Add any you feel are missing during this exercise.
    2. Have a team member facilitate the session.
    3. In the Communicate the Case for Enterprise Business Analysis template, categorize these items according to Now, Next and Later, where:
      1. Now = Critically important items that may require little effort to complete. These must be done within the next six months.
      2. Next = Important items that may require more effort or depend on other factors. These must be done in six to twelve months.
      3. Later = Less important items that may require significant effort to complete. These must be done at some point within twelve months.

    Ultimately, the choice of priority and timing is yours. Recognize that items may change categories as new information arises.

    Download the Communicate the Case for Enterprise Business Analysis template

    Input

    • Your enterprise business analysis inventory and gaps
    • Stakeholder knowledge and experience

    Output

    • A prioritized list of items to enable enterprise business analysis

    Materials

    • Whiteboard/Flip charts
    • Collaborative whiteboard
    • Communicate the Case for Enterprise Business Analysis template

    Participants

    • Business analyst(s)
    • Organizational business leaders
    • Any other relevant stakeholders

    2.3 Complete your executive communication deck

    Use the results of your completed exercises to build your executive communication slide deck, to make the case for enterprise business analysis

    Slide Header Associated Exercise Rationale
    Pains and opportunities

    1.1.2 Discuss your disconnects between strategy and tactics

    1.2.1 Identify your pains and opportunities

    This helps build the case for enterprise business analysis (EBA), leveraging the existing pains felt in the organization. This will draw the connection for your stakeholders.
    Our vision and goals 2.1.1 Define your vision and goals Defines where you want to go and what effort will be required.
    What is enterprise business analysis

    1.1.1 How is BA being used in our organization today?
    Pre-populated supporting content

    Defines the discipline of EBA and how it can support and mature your organization.
    Expected benefits Pre-populated supporting content What's in it for us? This section helps answer that question. What benefits can we expect, and is this worth the investment of time and effort?
    Making this a reality 2.1.2 Identify your EBA inventory Identifies what the organization presently has that makes the effort easier. It doesn't feel as daunting if there are existing people, processes, and technologies in place and in use today.
    Next steps 2.2.1 Now, Next, Later A prioritized list of action items. This will demonstrate the work involved, but broken down over time, into smaller, more manageable pieces.

    Track metrics

    Track metrics throughout the project to keep stakeholders informed.

    As the project nears completion:

    1. You will have better-aligned and more satisfied stakeholders.
    2. You will see fewer projects and initiatives that don't align with the organizational goals and objectives.
    3. There will be a reduction in costs attributed to misaligned projects and initiatives (as mentioned in #2) and the opportunity to allocate valuable time and resources to other, higher-value work.
    Metric Description Target Improvement/Reduction
    Improved stakeholder satisfaction Lines of business and previously siloed departments/divisions will be more satisfied with time spent on solution involvement and outcomes. 10% year 1, 20% year 2
    Reduction in misaligned/non-priority project work Reduction in projects, products, and services with no clear alignment to organizational goals. With that, resource costs can be allocated to other, higher-value solutions. 10% year 1, 25% year 2
    Improved delivery agility/lead time With improved alignment comes reduced conflict and political infighting. As a result, the velocity of solution delivery will increase. 10%

    Bibliography

    Bossert, Oliver and Björn Münstermann. "Business's 'It's not my problem' IT problem." McKinsey Digital. 30 March, 2023.
    Brule, Glenn R. "The Lay of the Land: Enterprise Analysis." Modern Analyst.
    "Business Analysis: Leading Organizations to Better Outcomes." Project Management Institute (PMI), 2017
    Corporate Finance Institute. "Strategic Analysis." Updated 14 March 2023
    IAG Consulting. Business Analysis Benchmark Report, 2009.
    International Institute of Business Analysis. "A Guide to the Business Analysis Body of Knowledge" (BABOK Guide) version 3.
    Mirabelli, Vincent. "Business Analysis Foundations: Enterprise" LinkedIn Learning, February 2022.
    - - "Essential Techniques in Enterprise Analysis" LinkedIn Learning, September 2022.
    - - "The Essentials of Enterprise Analysis" Love the Process Academy. May 2020.
    - - "The Value of Enterprise Analysis." VincentMirabelli.com
    Praslova, Ludmila N. "Today's Most Critical Workplace Challenges Are About Systems." Harvard Business Review. 10 January 2023.
    Pratt, Mary K. and Sarah K. White. "What is a business analyst? A key role for business-IT efficiency." CIO. 17 April, 2019.
    Project Management Institute. "Business Analysis: Leading Organizations to Better Outcomes." October 2017.
    Sali, Sema. "The Importance of Strategic Business Analysis in Successful Project Outcomes." International Institute of Business Analysis. 26 May 2022.
    - - "What Does Enterprise Analysis Look Like? Objectives and Key Results." International Institute of Business Analysis. 02 June 2022.
    Shaker, Kareem. "Why do projects really fail?" Project Management Institute, PM Network. July 2010.
    "Strategic Analysis: Definition, Types and Benefits" Voxco. 25 February 2022.
    "The Difference Between Enterprise Analysis and Business Analysis." Schulich School of Business, Executive Education Center. 24 September 2018 (Updated June 2022)
    "Why Do Projects Fail: Learning How to Avoid Project Failure." MindTools.com. Accessed 24 April 2023.

    Terms and Conditions for consulting to businesses

    By signing an agreement with Gert Taeymans bvba, Client declares that he agrees with the Terms and Conditions referred to hereafter. Terms and conditions on Client's order form or any other similar document shall not be binding upon Gert Taeymans bvba.

    The prices, quantities and delivery time stated in any quotation are not binding upon Gert Taeymans bvba. They are commercial estimates only which Gert Taeymans bvba will make reasonable efforts to achieve. Prices quoted in final offers will be valid only for 30 days. All prices are VAT excluded and do not cover expenses, unless otherwise agreed in writing. Gert Taeymans bvba reserves the right to increase a quoted fee in the event that Client requests a variation to the work agreed.

    The delivery times stated in any quotation are of an indicative nature and not binding upon Gert Taeymans bvba, unless otherwise agreed in writing. Delivery times will be formulated in working days. In no event shall any delay in delivery be neither cause for cancellation of an order nor entitle Client to any damages.

    Amendments or variations of the initial agreement between Client and Gert Taeymans bvba will only be valid when accepted by both parties in writing.

    Any complaints concerning the performance of services must be addressed to Gert Taeymans bvba in writing and by registered mail within 7 working days of the date of the performance of the services.

    In no event shall any complaint be just cause for non-payment or deferred payment of invoices. Any invoice and the services described therein will be deemed irrevocably accepted by Client if no official protest of non-payment has been sent by Client within 7 working days from the date of the mailing of the invoice.

    Client shall pay all invoices of Gert Taeymans bvba within thirty (30) calendar days of the date of invoice unless otherwise agreed in writing by Gert Taeymans bvba. In the event of late payment, Gert Taeymans bvba may charge a monthly interest on the amount outstanding at the rate of two (2) percent with no prior notice of default being required, in which case each commenced month will count as a full month. Any late payment will entitle Gert Taeymans bvba to charge Client a fixed handling fee of 300 EUR. All costs related to the legal enforcement of the payment obligation, including lawyer fees, will be charged to Client.

    In no event will Gert Taeymans bvba be liable for damages of any kind, including without limitation, direct, incidental or consequential damages (including, but not limited to, damages for lost profits, business interruption and loss of programs or information) arising out of the use of Gert Taeymans bvba services.

    Gert Taeymans bvba collects personal data from Client for the performance of its services and the execution of its contracts. Such personal data can also be used for direct marketing, allowing Gert Taeymans bvba to inform Client of its activities on a regular basis. If Client objects to the employment of its personal data for direct marketing, Client must inform Gert Taeymans bvba on the following address: gert@gerttaeymans.consulting.

    Client can consult, correct or amend its personal data by addressing such request to Gert Taeymans bvba by registered mail. Personal data shall in no event be sold, rented or made available to other firms or third parties where not needed for the execution of the contract. Gert Taeymans bvba reserves the right to update and amend its privacy policy from time to time to remain consistent with applicable privacy legislation.

    The logo of the Client will be displayed on the Gert Taeymans bvba website, together with a short description of the project/services.

    Any changes to Client’s contact information such as addresses, phone numbers or e-mail addresses must be communicated to Gert Taeymans bvba as soon as possible during the project.

    Both parties shall maintain strict confidence and shall not disclose to any third party any information or material relating to the other or the other's business, which comes into that party's possession and shall not use such information and material. This provision shall not, however, apply to information or material, which is or becomes public knowledge other than by breach by a party of this clause.

    Gert Taeymans bvba has the right at any time to change or modify these terms and conditions at any time without notice.

    The agreement shall be exclusively governed by and construed in accordance with the laws of Belgium. The competent courts of Antwerp, Belgium will finally settle any dispute about the validity, the interpretation or the execution of this agreement.

    These Terms and Conditions are the only terms and conditions applicable to both parties.

    If any provision or provisions of these Terms and Conditions shall be held to be invalid, illegal or unenforceable, such provision shall be enforced to the fullest extent permitted by applicable law, and the validity, legality and enforceability of the remaining provisions shall not in any way be affected or impaired thereby.

    Build a Security Compliance Program

    • Buy Link or Shortcode: {j2store}257|cart{/j2store}
    • member rating overall impact: 9.6/10 Overall Impact
    • member rating average dollars saved: $23,879 Average $ Saved
    • member rating average days saved: 15 Average Days Saved
    • Parent Category Name: Governance, Risk & Compliance
    • Parent Category Link: /governance-risk-compliance
    • Most organizations spend between 25 and 40 percent of their security budget on compliance-related activities.
    • Despite this growing investment in compliance, only 28% of organizations believe that government regulations help them improve cybersecurity.
    • The cost of complying with cybersecurity and data protection requirements has risen to the point where 58% of companies see compliance costs as barriers to entering new markets.
    • However, recent reports suggest that while the costs of complying are higher, the costs of non-compliance are almost three times greater.

    Our Advice

    Critical Insight

    • Test once, attest many. Having a control framework allows you to satisfy multiple compliance requirements by testing a single control.
    • Choose your own conformance adventure. Conformance levels allow your organization to make informed business decisions on how compliance resources will be allocated.
    • Put the horse before the cart. Take charge of your audit costs by preparing test scripts and evidence repositories in advance.

    Impact and Result

    • Reduce complexity within the control environment by using a single framework to align multiple compliance regimes.
    • Provide senior management with a structured framework for making business decisions on allocating costs and efforts related to cybersecurity and data protection compliance obligations.
    • Reduces costs and efforts related to managing IT audits through planning and preparation.
    • This blueprint can help you comply with NIST, ISO, CMMC, SOC2, PCI, CIS, and other cybersecurity and data protection requirements.

    Build a Security Compliance Program Research & Tools

    Start here – read the Executive Brief

    Read our concise Executive Brief to find out why you should manage your security compliance obligations, review Info-Tech’s methodology, and understand the ways we can support you in completing this project.

    Besides the small introduction, subscribers and consulting clients within this management domain have access to:

    Infographic

    Workshop: Build a Security Compliance Program

    Workshops offer an easy way to accelerate your project. If you are unable to do the project yourself, and a Guided Implementation isn't enough, we offer low-cost delivery of our project workshops. We take you through every phase of your project and ensure that you have a roadmap in place to complete your project successfully.

    1 Establish the Program

    The Purpose

    Establish the security compliance management program.

    Key Benefits Achieved

    Reviewing and adopting an information security control framework.

    Understanding and establishing roles and responsibilities for security compliance management.

    Identifying and scoping operational environments for applicable compliance obligations.

    Activities

    1.1 Review the business context.

    1.2 Review the Info-Tech security control framework.

    1.3 Establish roles and responsibilities.

    1.4 Define operational environments.

    Outputs

    RACI matrix

    Environments list and definitions

    2 Identify Obligations

    The Purpose

    Identify security and data protection compliance obligations.

    Key Benefits Achieved

    Identifying the security compliance obligations that apply to your organization.

    Documenting obligations and obtaining direction from management on conformance levels.

    Mapping compliance obligation requirements into your control framework.

    Activities

    2.1 Identify relevant security and data protection compliance obligations.

    2.2 Develop conformance level recommendations.

    2.3 Map compliance obligations into control framework.

    2.4 Develop process for operationalizing identification activities.

    Outputs

    List of compliance obligations

    Completed Conformance Level Approval forms

    (Optional) Mapped compliance obligation

    (Optional) Identification process diagram

    3 Implement Compliance Strategy

    The Purpose

    Understand how to build a compliance strategy.

    Key Benefits Achieved

    Updating security policies and other control design documents to reflect required controls.

    Aligning your compliance obligations with your information security strategy.

    Activities

    3.1 Review state of information security policies.

    3.2 Recommend updates to policies to address control requirements.

    3.3 Review information security strategy.

    3.4 Identify alignment points between compliance obligations and information security strategy.

    3.5 Develop compliance exception process and forms.

    Outputs

    Recommendations and plan for updates to information security policies

    Compliance exception forms

    4 Track and Report

    The Purpose

    Track the status of your compliance program.

    Key Benefits Achieved

    Tracking the status of your compliance obligations.

    Managing exceptions to compliance requirements.

    Reporting on the compliance management program to senior stakeholders.

    Activities

    4.1 Define process and forms for self-attestation.

    4.2 Develop audit test scripts for selected controls.

    4.3 Review process and entity control types.

    4.4 Develop self-assessment process.

    4.5 Integrate compliance management with risk register.

    4.6 Develop metrics and reporting process.

    Outputs

    Self-attestation forms

    Completed test scripts for selected controls

    Self-assessment process

    Reporting process

    Recommended metrics

    Threat Preparedness Using MITRE ATT&CK®

    • Buy Link or Shortcode: {j2store}252|cart{/j2store}
    • member rating overall impact: N/A
    • member rating average dollars saved: N/A
    • member rating average days saved: N/A
    • Parent Category Name: Security Strategy & Budgeting
    • Parent Category Link: /security-strategy-and-budgeting
    • To effectively protect your business interests, you need to be able to address what the most pressing vulnerabilities in your network are. Which attack vectors should you model first? How do you adequately understand your threat vectors when attacks continually change and adapt?
    • Security can often be asked the world but given a minimal budget with which to accomplish it.
    • Security decisions are always under pressure from varying demands that pull even the most well-balanced security team in every direction.
    • Adequately modeling any and every possible scenario is ineffective and haphazard at best. Hoping that you have chosen the most pressing attack vectors to model will not work in the modern day of threat tactics.

    Our Advice

    Critical Insight

    • Precision is critical to being able to successfully defend against threats.
      • Traditional threat modeling such as STRIDE or PASTA is based on a spray-and-pray approach to identifying your next potential threat vector. Instead, take a structured risk-based approach to understanding both an attacker’s tactics and how they may be used against your enterprise. Threat preparedness requires precision, not guesswork.
    • Knowing is half the battle.
      • You may be doing better than you think. Undoubtedly, there is a large surface area to cover with threat modeling. By preparing beforehand, you can separate what’s important from what’s not and identify which attack vectors are the most pressing for your business.
    • Be realistic and measured.
      • Do not try to remediate everything. Some attack vectors and approaches are nearly impossible to account for. Take control of the areas that have reasonable mitigation methods and act on those.
    • Identify blind spots.
      • Understand what is out there and how other enterprises are being attacked and breached. See how you stack up to the myriad of attack tactics that have been used in real-life breaches and how prepared you are. Know what you’re ready for and what you’re not ready for.
    • Analyze the most pressing vectors.
      • Prioritize the attack vectors that are relevant to you. If an attack vector is an area of concern for your business, start there. Do not cover the entire tactics list if certain areas are not relevant.
    • Detection and mitigation lead to better remediation.
      • For each relevant tactic and techniques, there are actionable detection and mitigation methods to add to your list of remediation efforts.

    Impact and Result

    Using the MITRE ATT&CK® framework, Info-Tech’s approach helps you understand your preparedness and effective detection and mitigation actions.

    • Learn about potential attack vectors and the techniques that hostile actors will use to breach and maintain a presence on your network.
    • Analyze your current protocols versus the impact of an attack technique on your network.
    • Discover detection and mitigation actions.
    • Create a prioritized series of security considerations, with basic actionable remediation items. Plan your next threat model by knowing what you’re vulnerable to.
    • Ensure business data cannot be leaked or stolen.
    • Maintain privacy of data and other information.
    • Secure the network connection points.
    • Mitigate risks with the appropriate services.

    This blueprint and associated tool are scalable for all types of organizations within various industry sectors, allowing them to know what types of risk they are facing and what security services are recommended to mitigate those risks.

    Threat Preparedness Using MITRE ATT&CK® Research & Tools

    Start here – read the Executive Brief

    Read our concise Executive Brief to find out why threat preparedness is a crucial first step in defending your network against any attack type. Review Info-Tech’s methodology and understand the ways we can support you in completing this project.

    Besides the small introduction, subscribers and consulting clients within this management domain have access to:

    1. Attack tactics and techniques

    Review a breakdown of each of the various attack vectors and their techniques for additional context and insight into the most prevalent attack tactics.

    • Threat Preparedness Using MITRE ATT&CK® – Phase 1: Attack Tactics and Techniques

    2. Threat Preparedness Workbook mapping

    Map your current security protocols against the impacts of various techniques on your network to determine your risk preparedness.

    • Threat Preparedness Using MITRE ATT&CK® – Phase 2: Threat Preparedness Workbook Mapping
    • Enterprise Threat Preparedness Workbook

    3. Execute remediation and detective measures

    Use your prioritized attack vectors to plan your next threat modeling session with confidence that the most pressing security concerns are being addressed with substantive remediation actions.

    • Threat Preparedness Using MITRE ATT&CK® – Phase 3: Execute Remediation and Detective Measures
    [infographic]

    Develop a Targeted Flexible Work Program for IT

    • Buy Link or Shortcode: {j2store}542|cart{/j2store}
    • member rating overall impact: 9.0/10 Overall Impact
    • member rating average dollars saved: $18,909 Average $ Saved
    • member rating average days saved: 13 Average Days Saved
    • Parent Category Name: Attract & Select
    • Parent Category Link: /attract-and-select
    • Workplace flexibility continues to be top priority for IT employees. Organizations who fail to offer flexibility will have a difficult time attracting, recruiting, and retaining talent.
    • When the benefits of remote work are not available to everyone, this raises fairness and equity concerns.

    Our Advice

    Critical Insight

    IT excels at hybrid location work and is more effective as a business function when location flexibility is an option for its employees. But hybrid work is just a start. A comprehensive flex work program extends beyond flexible location, so organizations must understand the needs of unique employee groups to uncover the options that will attract and retain talent.

    Impact and Result

    • Uncover the needs of unique employee segments to shortlist flexible work options that employees want and will use.
    • Assess the feasibility of various flexible work options and select ones that meet employee needs and are feasible for the organization.
    • Equip leaders with the information and tools needed to implement and sustain a flexible work program.

    Develop a Targeted Flexible Work Program for IT Research & Tools

    Besides the small introduction, subscribers and consulting clients within this management domain have access to:

    1. Assess employee and organizational flexibility needs

    Identify prioritized employee segments, flexibility challenges, and the desired state to inform program goals.

    • Develop a Targeted Flexible Work Program for IT – Phases 1-3
    • Talent Metrics Library
    • Targeted Flexible Work Program Workbook
    • Fast-Track Hybrid Work Program Workbook

    2. Identify potential flex options and assess feasibility

    Review, shortlist, and assess the feasibility of common types of flexible work. Identify implementation issues and cultural barriers.

    • Flexible Work Focus Group Guide
    • Flexible Work Options Catalog

    3. Implement selected option(s)

    Equip managers and employees to adopt flexible work options while addressing implementation issues and cultural barriers and aligning HR programs.

    • Guide to Flexible Work for Managers and Employees
    • Flexible Work Time Policy
    • Flexible Work Time Off Policy
    • Flexible Work Location Policy

    Infographic

    Workshop: Develop a Targeted Flexible Work Program for IT

    Workshops offer an easy way to accelerate your project. If you are unable to do the project yourself, and a Guided Implementation isn't enough, we offer low-cost delivery of our project workshops. We take you through every phase of your project and ensure that you have a roadmap in place to complete your project successfully.

    1 Prepare to Assess Flex Work Feasibility

    The Purpose

    Gather information on organizational and employee flexibility needs.

    Key Benefits Achieved

    Understand the flexibility needs of the organization and its employees to inform a targeted flex work program.

    Activities

    1.1 Identify employee and organizational needs.

    1.2 Identify employee segments.

    1.3 Establish program goals and metrics.

    1.4 Shortlist flexible work options.

    Outputs

    Organizational context summary

    List of shortlisted flex work options

    2 Assess Flex Work Feasibility

    The Purpose

    Perform a data-driven feasibility analysis on shortlisted work options.

    Key Benefits Achieved

    A data-driven feasibility analysis ensures your flex work program meets its goals.

    Activities

    2.1 Conduct employee/manager focus groups to assess feasibility of flex work options.

    Outputs

    Summary of flex work options feasibility per employee segment

    3 Finalize Flex Work Options

    The Purpose

    Select the most impactful flex work options and create a plan for addressing implementation challenge

    Key Benefits Achieved

    A data-driven selection process ensures decisions and exceptions can be communicated with full transparency.

    Activities

    3.1 Finalize list of approved flex work options.

    3.2 Brainstorm solutions to implementation issues.

    3.3 Identify how to overcome cultural barriers.

    Outputs

    Final list of flex work options

    Implementation barriers and solutions summary

    4 Prepare for Implementation

    The Purpose

    Create supporting materials to ensure program implementation proceeds smoothly.

    Key Benefits Achieved

    Employee- and manager-facing guides and policies ensure the program is clearly documented and communicated.

    Activities

    4.1 Design employee and manager guide prototype.

    4.2 Align HR programs and policies to support flexible work.

    4.3 Create a communication plan.

    Outputs

    Employee and manager guide to flexible work

    Flex work roadmap and communication plan

    5 Next Steps and Wrap-Up

    The Purpose

    Put everything together and prepare to implement.

    Key Benefits Achieved

    Our analysts will support you in synthesizing the workshop’s efforts into a cohesive implementation strategy.

    Activities

    5.1 Complete in-progress deliverables from previous four days.

    5.2 Set up review time for workshop deliverables and to discuss next steps.

    Outputs

    Completed flexible work feasibility workbook

    Flexible work communication plan

    Further reading

    Develop a Targeted Flexible Work Program for IT

    Select flexible work options that balance organizational and employee needs to drive engagement and improve attraction and retention.

    Executive Summary

    Your Challenge

    • IT leaders continue to struggle with workplace flexibility, and it is a top priority for IT employees; as a result, organizations who fail to offer flexibility will have a difficult time attracting, recruiting, and retaining talent.
    • The benefits of remote work are not available to everyone, raising fairness and equity concerns for employees.

    Common Obstacles

    • A one-size-fits-all approach to selecting and implementing flexible work options fails to consider unique employee needs and will not reap the benefits of offering a flexible work program (e.g. higher engagement or enhanced employer brand).
    • Improper structure and implementation of flexible work programs exacerbates existing challenges (e.g. high turnover) or creates new ones.

    Info-Tech's Approach

    • Uncover the needs of unique employee segments to shortlist flexible work options that employees want and will use.
    • Assess the feasibility of various flexible work options and select ones that meet employee needs and are feasible for the organization.
    • Equip leaders with the information and tools needed to implement and sustain a flexible work program.

    Info-Tech Insight

    IT excels at hybrid location work and is more effective as a business function when location flexibility is an option for its employees. But hybrid work is just a start. A comprehensive flex work program extends beyond flexible location, so organizations must understand the needs of unique employee groups to uncover the options that will attract and retain talent.

    Flexible work arrangements are a requirement in today's world of work

    Flexible work continues to gain momentum…

    A 2022 LinkedIn report found that the following occurred between 2019 and 2021:

    +362%

    Increase in LinkedIn members sharing content with the term "flexible work."

    +83%

    Increase in job postings that mention "flexibility."
    (LinkedIn, 2022)

    In 2022, Into-Tech found that hybrid was the most commonly used location work model for IT across all industries.

    ("State of Hybrid Work in IT," Info-Tech Research Group, 2022)

    …and employees are demanding more flexibility

    90%

    of employees said they want schedule and location flexibility ("Global Employee Survey," EY, 2021).

    17%

    of resigning IT employees cited lack of flexible work options as a reason ("IT Talent Trends 2022," Info-Tech Research Group, 2022).

    71%

    of executives said they felt "pressure to change working models and adapt workplace policies to allow for greater flexibility" (LinkedIn, 2021).

    Therefore, organizations who fail to offer flexibility will be left behind

    Difficulty attracting and retaining talent

    98% of IT employees say flexible work options are important in choosing an employer ("IT Talent Trends 2022," Info-Tech Research Group, 2022).

    Worsening employee wellbeing and burnout

    Knowledge workers with minimal to no schedule flexibility are 2.2x more likely to experience work-related stress and are 1.4x more likely to suffer from burnout (Slack, 2022; N=10,818).

    Offering workplace flexibility benefits organizations and employees

    Higher performance

    IT departments that offer some degree of location flexibility are more effective at supporting the organization than those who do not.

    35% of service desk functions report improved service since implementing location flexibility.
    ("State of Hybrid Work in IT," Info-Tech Research Group, 2023).

    Enhanced employer brand

    Employees are 2.1x more likely to recommend their employer to others when they are satisfied with their organization's flexible work arrangements (LinkedIn, 2021).

    Improved attraction

    41% of IT departments cite an expanded hiring pool as a key benefit of hybrid work.

    Organizations that mention "flexibility" in their job postings have 35% more engagement with their posts (LinkedIn, 2022).

    Increased job satisfaction

    IT employees who have more control over their working arrangement experience a greater sense of contribution and trust in leadership ("State of Hybrid Work in IT," Info-Tech Research Group, 2023).

    Better work-life balance

    81% of employees say flexible work will positively impact their work-life balance (FlexJobs, 2021).

    Boosted inclusivity

    • Caregivers regardless of gender, supporting them in balancing responsibilities
    • Individuals with disabilities, enabling them to work from the comfort of their homes
    • Women who may have increased responsibilities
    • Women of color to mitigate the emotional tax experienced at work

    Info-Tech Insight

    Flexible work options are not a concession to lower productivity. Properly implemented, flex work enables employees to be more productive at reaching business goals.

    Despite the popularity of flexible work options, not all employees can participate

    IT organizations differ on how much flexibility different roles can have.

    IT employees were asked what percentage of IT roles were currently in a hybrid or remote work arrangement ("State of Hybrid Work in IT," Info-Tech Research Group, 2023).

    However, the benefits of remote work are not available to all, which raises fairness and equity concerns between remote and onsite employees.

    45%

    of employers said, "one of the biggest risks will be their ability to establish fairness and equity among employees when some jobs require a fixed schedule or location, creating a 'have and have not' dynamic based on roles" ("Businesses Suffering," EY, 2021).

    Offering schedule flexibility to employees who need to be fully onsite can be used to close the fairness and equity gap.

    When offered the choice, 54% of employees said they would choose schedule flexibility over location flexibility ("Global Employee Survey," EY, 2021).

    When employees were asked "What choice would you want your employer to provide related to when you have to work?" The top three choices were:

    68%

    Flexibility on when to start and finish work

    38%

    Compressed or four-day work weeks

    33%

    Fixed hours (e.g. 9am to 5pm)

    Disclaimer: "Percentages do not sum to 100%, as each respondent could choose up to three of the [five options provided]" ("Global Employee Survey," EY, 2021).

    Beware of the "all or nothing" approach

    There is no one-size-fits-all approach to workplace flexibility.

    Understanding the needs of various employee segments in the organization is critical to the success of a flexible work program.

    Working parents want more flexibility

    82%

    of working mothers desire flexibility in where they work.

    48%

    of working fathers "want to work remotely 3 to 5 days a week."

    Historically underrepresented groups value more flexibility

    38%

    "Thirty-eight percent of Black male employees and 33% of Black female employees would prefer a fully flexible schedule, compared to 25% of white female employees and 26% of white male employees."
    (Slack, 2022; N=10,818)

    33%

    Workplace flexibility must be customized to the organization to avoid longer working hours and heavy workloads that impact employee wellbeing

    84%

    of remote workers and 61% of onsite workers reported working longer hours post pandemic. Longer working hours were attributed to reasons such as pressure from management and checking emails after working hours (Indeed, 2021).

    2.6x

    Respondents who either agreed or strongly agreed with the statement "Generally, I find my workload reasonable" were 2.6x more likely to be engaged compared to those who stated they disagreed or strongly disagreed (McLean & Company Engagement Survey Database;2022; N=5,615 responses).

    Longer hours and unsustainable workloads can contribute to stress and burnout, which is a threat to employee engagement and retention. With careful management (e.g. setting clear expectations and establishing manageable workloads), flexible work arrangement benefits can be preserved.

    Info-Tech Insight

    Employees' lived experiences and needs determine if people use flexible work programs – a flex program that has limited use or excludes people will not benefit the organization.

    Develop a flexible work program that meets employee and organizational needs

    This is an image of a sample flexible work program which meets employee and organizational needs.

    Insight summary

    Overarching insight: IT excels at hybrid location work and is more effective as a business function when location, time, and time-off flexibility are an option for its employees.

    Introduction

    Step 1 insight

    Step 2 insight

    Step 3 insight

    • Flexible work options are not a concession to lower productivity. Properly implemented, flex work enables employees to be more productive at reaching business goals.
    • Employees' lived experiences and needs determine if people use flexible work programs – a flex program that has limited use or excludes people will not benefit the organization.
    • Flexible work benefits everyone. IT employees experience greater engagement, motivation, and company loyalty. IT organizations realize benefits such as better service coverage, reduced facilities costs, and increased productivity.
    • Hybrid work is a start. A comprehensive flex work program extends beyond flexible location to flexible time and time off. Organizations must understand the needs of unique employee groups to uncover the options that will attract and retain talent. Provide greater inclusivity to employees by broadening the scope to include flex location, flex time, and flex time off.
    • No two employee segments are the same. To be effective, flexible work options must align with the expectations and working processes of each segment.
    • Every role is eligible for hybrid location work. If onsite work duties prevent an employee group from participating, see if processes can be digitized or automated. Flexible work is an opportunity to go beyond current needs to future proofing your organization.
    • Flexible work options must balance organizational and employee needs. If an option is beneficial to employees but there is little or no benefit to the organization, or if the cost of the option is too high, it will not support the long-term success of the organization.
    • Prioritize flexible work options that employees want. Providing too many options often leads to information overload and results in employees not understanding what is available, lowering adoption of the flexible work program.
    • Leaders' collective support of the flexible program determines the program's successful adoption. Don't sweep cultural barriers under the rug; acknowledge and address them to overcome them.
    • Negative performance of a flexible work option does not necessarily mean failure. Take the time to evaluate whether the option simply needs to be tweaked or whether it truly isn't working for the organization.
    • A set of formal guidelines for IT ensures flexible work is:
      1. Administered fairly across all IT employees.
      2. Defensible and clear.
      3. Scalable to the rest of the organization.

    Case Study

    Expanding hybrid work at Info-Tech

    Challenge

    In 2020, Info-Tech implemented emergency work-from-home for its IT department, along with the rest of the organization. Now in 2023, hybrid work is firmly embedded in Info-Tech's culture, with plans to continue location flexibility for the foreseeable future.

    Adjusting to the change came with lessons learned and future-looking questions.

    Lessons Learned

    Moving into remote work was made easier by certain enablers that had already been put in place. These included issuing laptops instead of desktops to the user base and using an existing cloud-based infrastructure. Much support was already being done remotely, making the transition for the support teams virtually seamless.

    Continuing hybrid work has brought benefits such as reduced commuting costs for employees, higher engagement, and satisfaction among staff that their preferences were heard.

    Looking Forward

    Every flexible work implementation is a work in progress and must be continually revisited to ensure it continues to meet organizational and employee needs. Current questions being explored at Info-Tech are:

    • The concept of the "office as a tool" – how does use of the office change when it is used for specific collaboration-related tasks, rather than everything? How should the physical space change to support this?
    • What does a viable replacement for quick hallway meetings look like in a remote world where communication is much more deliberate? How can managers adjust their practices to ensure the benefits of informal encounters aren't lost?

    Info-Tech offers various levels of support to best suit your needs

    DIY Toolkit

    “Our team has already made this critical project a priority, and we have the time and capability, but some guidance along the way would be helpful.”

    Guided Implementation

    “Our team knows that we need to fix a process, but we need assistance to determine where to focus. Some check-ins along the way would help keep us on track.”

    Workshop

    “We need to hit the ground running and get this project kicked off immediately. Our team has the ability to take this over once we get a framework and strategy in place.”

    Consulting

    “Our team does not have the time or the knowledge to take this project on. We need assistance through the entirety of this project.”

    Diagnostics and consistent frameworks used throughout all four options

    Guided Implementation

    What does a typical GI on this topic look like?

    Preparation

    Step 1

    Step 2

    Step 3

    Follow-up

    Call #1: Scope requirements, objectives, and your specific challenges.

    Call #2: Assess employee and organizational needs.

    Call #3: Shortlist flex work options and assess feasibility.

    Call #4: Finalize flex work options and create rollout plan.

    Call #5: (Optional) Review rollout progress or evaluate pilot success.

    A Guided Implementation (GI) is a series of calls with an Info-Tech analyst to help implement our best practices in your organization.

    A typical GI is 3 to 5 calls over the course of 4 to 6 months.

    Workshop Overview

    Contact your account representative for more information.
    workshops@infotech.com 1-888-670-8889

    Day 1

    Day 2

    Day 3

    Day 4

    Day 5

    Activities

    Prepare to assess flex work feasibility

    Assess flex work feasibility

    Finalize flex work options

    Prepare for implementation

    Next Steps and Wrap-Up (offsite)

    1.1 Identify employee and organizational needs.

    1.2 Identify employee segments.

    1.3 Establish program goals and metrics.

    1.4 Shortlist flex work options.

    2.1 Conduct employee/manager focus groups to assess feasibility of flex work options.

    3.1 Finalize list of approved flex work options.

    3.2 Brainstorm solutions to implementation issues.

    3.2 Identify how to overcome cultural barriers.

    4.1 Design employee and manager guide prototype.

    4.2 Align HR programs and policies to support flexible work.

    4.3 Create a communication plan.

    5.1 Complete in-progress deliverables from previous four days.

    5.2 Set up review time for workshop deliverables and to discuss next steps.

    Deliverables

    1. Organizational context summary
    2. List of shortlisted flex work options
    1. Summary of flex work options' feasibility per employee segment
    1. 1.Final list of flex work options
    2. 2.Implementation barriers and solutions summary
    1. Employee and manager guide to flexible work
    2. Flex work roadmap and communication plan
    1. Completed flexible work feasibility workbook
    2. Flexible work communication plan

    Step 1

    Assess employee and organizational needs

    1. Assess employee and organizational flexibility needs
    2. Identify potential flex options and assess feasibility
    3. Implement selected option(s)

    After completing this step you will have:

    • Identified key stakeholders and their responsibilities
    • Uncovered the current and desired state of the organization
    • Analyzed feedback to identify flexibility challenges
    • Identified and prioritized employee segments
    • Determined the program goals
    • Identified the degree of flexibility for work location, timing, and deliverables

    Identify key stakeholders

    Organizational flexibility requires collaborative and cross-functional involvement to determine which flexible options will meet the needs of a diverse workforce. HR leads the project to explore flexible work options, while other stakeholders provide feedback during the identification and implementation processes.

    HR

    • Assist with the design, implementation, and maintenance of the program.
    • Provide managers and employees with guidance to establish successful flexible work arrangements.
    • Help develop communications to launch and maintain the program.

    Senior Leaders

    • Champion the project by modeling and promoting flexible work options
    • Help develop and deliver communications; set the tone for flexible work at the organization.
    • Provide input into determining program goals.

    Managers

    • Model flexible work options and encourage direct reports to request and discuss options.
    • Use flexible work program guidelines to work with direct reports to select suitable flexible work options.
    • Develop performance metrics and encourage communication between flexible and non-flexible workers.

    Flexible Workers

    • Indicate preferences of flexible work options to the manager.
    • Identify ways to maintain operational continuity and communication while working flexibly.
    • Flag issues and suggest improvements to the manager.
    • Develop creative ways to work with colleagues who don't work flexibly.

    Non-Flexible Workers

    • Share feedback on issues with flexible arrangements and their impact on operational continuity.

    Info-Tech Insight

    Flexible work is a holistic team effort. Leaders, flexible workers, teammates, and HR must clearly understand their roles to ensure that teams are set up for success.

    Uncover the current and desired state of flexibility in the organization

    Current State

    Target State

    Review:

    • Existing policies related to flexibility (e.g. vacation, work from anywhere)
    • Existing flexibility programs (e.g. seasonal hours) and their uptake
    • Productivity of employees
    • Current culture at the organization. Look for:
      • Employee autonomy
      • Reporting structure and performance management processes
      • Trust and psychological safety of employees
      • Leadership behavior (e.g. do leaders model work-life balance, or does the organization have a work 24/7 mentality?)

    Identify what is driving the need for flexible work options. Ask:

    • Why does the organization need flexible options?
      • For example, the introduction of flexibility for some employees has created a "have and have not" dynamic between roles that must be addressed.
    • What does the organization hope to gain from implementing flexible options? For example:
      • Improved retention
      • Increased attraction, remaining competitive for talent
      • Increased work-life balance for employees
      • Reduced burnout
    • What does the organization aspire to be?
      • For example, an organization that creates an environment that values output, not face time.

    These drivers identify goals for the organization to achieve through targeted flexible work options.

    Info-Tech Insight

    Hybrid work is a start. A comprehensive flex work program extends beyond flexible location, so organizations must understand the needs of unique employee groups to uncover the options that will attract and retain talent. Provide greater inclusivity to employees by broadening the scope to include flex location, flex time, and flex time off.

    Identify employee segments

    Using the data, feedback, and challenges analyzed and uncovered so far, assess the organization and identify employee segments.

    Identify employee segments with common characteristics to assess if they require unique flexible work options. Assess the feasibility options for the segments separately in Step 2.

    • Segments' unique characteristics include:
      • Role responsibilities (e.g. interacting with users, creating reports, development and testing)
      • Work location/schedule (e.g. geographic, remote vs. onsite, 9 to 5)
      • Work processes (e.g. server maintenance, phone support)
      • Group characteristics (e.g. specific teams, new hires)

    Identify employee segments and sort them into groups based on the characteristics above.

    Examples of segments:

    • Functional area (e.g. Service Desk, Security)
    • Job roles (e.g. desktop support, server maintenance)
    • Onsite, remote, or hybrid
    • Full-time or part-time
    • Job level (e.g. managers vs. independent contributors)
    • Employees with dependents

    Prioritize employee segments

    Determine whether the organization needs flexible work options for the entire organization or specific employee segments.
    For specific employee segments:

    • Answer the questions on the right to identify whether an employee segment is high, medium, or low priority. Complete slides 23 to 25 for each high-priority segment, repeating the process for medium-priority segments when resources allow.

    For the entire organization:

    • When identifying an option for the entire organization, consider all segments. The approach must create consistency and inclusion; keep this top of mind when identifying flexibility on slides 23 to 25. For example, the work location flexibility would be low in an organization where some segments can work remotely and others must be onsite due to machinery requirements.

    High priority: The employee segment has the lowest engagement scores or highest turnover within the organization. Segment sentiment is that current flexibility is nonexistent or not sufficiently meeting needs.
    Medium priority: The employee segment has low engagement or high turnover. Segment sentiment is that currently available flexibility is minimal or not sufficiently meeting needs.
    Low priority: The segment does not have the lowest engagement or the highest turnover rate. Segment sentiment is that currently available flexibility is sufficiently meeting needs.

    1. What is the impact on the organization if this segment's challenges aren't addressed (e.g. if low engagement and high turnover are not addressed)?
    2. How critical is flexibility to the segment's needs/engagement?
    3. How time sensitive is it to introduce flexibility to this segment (e.g. is the organization losing employees in this segment at a high rate)?
    4. Will providing flexibility to this segment increase organizational productivity or output

    Identify challenges to address with flexibility

    Uncover the lived experiences and expectations of employees to inform selection of segments and flexible options.

    1. Collect data from existing sources, such as:
      • Engagement surveys
      • New hire/exit surveys
      • Employee experience monitor surveys
      • Employee retention pulse surveys
      • Burnout surveys
      • DEI pulse surveys
    2. Analyze employee feedback on experiences with:
      • Work duties
      • Workload
      • Work-life balance
      • Operating processes and procedures
      • Achieving operational outcomes
      • Collaboration and communication
      • Individual experience and engagement
    3. Evaluate the data and identify challenges

    Example challenges:

    • Engagement: Low average score on work-life balance question; flexible work suggested in open-ended responses.
    • Retention: Exit survey indicating that lack of work-life balance is consistently a reason employees leave. Include the cost of turnover (e.g. recruitment, training, severance).
    • Burnout: Feedback from employees through surveys or HR business partner anecdotes indicating high burnout; high usage of wellness services or employee assistance programs.
    • Absenteeism: High average number of days employees were absent in the past year. Include the cost of lost productivity.
    • Operational continuity: Provide examples of when flexible work would have enabled operational continuity in the case of disaster or extended customer service coverage.
    • Program uptake: If the organization already has a flexible work program, provide data on the low proportion of eligible employees using available options.

    1.1 Prepare to evaluate flexible work options

    1-3 hours

    Follow the guidance on preceding slides to complete the following activities.
    Note: If you are only considering remote or hybrid work, use the Fast-Track Hybrid Work Program Workbook. Otherwise, proceed with the Targeted Flexible Work Program Workbook.

    1. Identify key stakeholders. Be sure to record the level of involvement and responsibility expected from each stakeholder. Use the "Stakeholders" tab of the workbook.
    2. Uncover current and desired state. Review and record your current state with respect to culture, productivity, and current flexible work options, if any. Next, record your desired future state, including reasons for implementing flexible work, and goals for the program. Record this in the "Current and Desired State" tab of the workbook.
    3. Identify and prioritize employee segments. Identify and record employee segments. Depending on the size of your department, you may identify a few or many. Be as granular as necessary to fully separate employee groups with different needs. If your resources or needs prevent you from rolling out flexible work to the entire department, record the priority level of each segment so you can focus on the highest priority first.
    4. Identify challenges with flexibility. With each employee segment in mind, analyze your available data to identify and record each segment's main challenges regarding flexible work. These will inform your program goals and metrics.

    Download the Targeted Flexible Work Program Workbook

    Download the Fast-Track Hybrid Work Program Workbook

    Input

    • List of departmental roles
    • Data on employee engagement, productivity, sentiment regarding flexible work, etc.

    Output

    • List of stakeholders and responsibilities
    • Flexible work challenges and aims
    • Prioritized list of employee segments

    Materials

    • Targeted Flexible Work Program Workbook
      Or
    • Fast-Track Hybrid Work Program Workbook

    Participants

    • IT department head
    • HR business partner
    • Flexible work program committee

    Determine goals and metrics for the flexible work program

    Sample program goals

    Sample metrics

    Increase productivity

    • Employee, team, and department key performance indicators (KPIs) before and after flexible work implementation
    • Absenteeism rate (% of lost working days due to all types of absence)

    Improve business satisfaction and perception of IT value

    Increase retention

    • % of exiting employees who cite lack of flexible work options or poor work-life balance as a reason they left
    • Turnover and retention rates

    Improve the employee value proposition (EVP) and talent attraction

    • # of responses on the new hire survey where flexible work options or work-life balance are cited as a reason for accepting an employment offer
    • # of views of career webpage that mentions flexible work program
    • Time-to-fill rates

    Improve engagement and work-life balance

    • Overall engagement score – deploy Info-Tech's Employee Engagement Diagnostics
    • Score for questions about work-life balance on employee engagement or pulse survey, including:
      • "I am able to maintain a balance between my work and personal life."
      • "I find my stress levels at work manageable."

    Info-Tech Insight

    Implementing flex work without solid performance metrics means you won't have a way of determining whether the program is enabling or hampering your business practices.

    1.2 Determine goals and metrics

    30 minutes

    Use the examples on the preceding slide to identify program goals and metrics:

    1. Brainstorm program goals. Be sure to consider both the business benefits (e.g. productivity, retention) and the employee benefits (work-life balance, engagement). A successful flexible work program benefits both the organization and its employees.
    2. Brainstorm metrics for each goal. Identify metrics that are easy to track accurately. Use Info-Tech's IT and HR metrics libraries for reference. Ideally, the metrics you choose should already exist in your organization so no extra effort will be necessary to implement them. It is also important to have a baseline measure of each one before flexible work is rolled out.
    3. Record your outputs on the "Goals and Metrics" tab of the workbook.

    Download the Targeted Flexible Work Program Workbook

    Download the IT Metrics Library

    Download the HR Metrics Library

    Input

    • Organizational and departmental strategy

    Output

    • List of program goals and metrics

    Materials

    • Targeted Flexible Work Program Workbook
      Or
    • Fast-Track Hybrid Work Program Workbook

    Participants

    • Flexible work program committee

    Determine work location flexibility for priority segments

    Work location looks at where a segment can complete all or some of their tasks (e.g. onsite vs. remote). For each prioritized employee segment, evaluate the amount of location flexibility available.

    Work Duties

    Processes

    Operational Outcomes

    High degree of flexibility

    • Low dependence on onsite equipment
    • Work easily shifts to online platforms
    • Low dependence on onsite external interactions (e.g. clients, customers, vendors)
    • Low interdependence of work duties internally (most work is independent)
    • Work processes and expectations are or can be formally documented
    • Remote work processes are sustainable long term

    Most or all operational outcomes can be achieved offsite (e.g. products/service delivery not impacted by WFH)

    • Some dependence on onsite equipment
    • Some work can shift to online platforms
    • Some dependence on onsite external interactions
    • Some interdependence of work duties internally (collaboration is critical)
    • Most work processes and expectations have been or can be formally documented
    • Remote work processes are sustainable (e.g. workarounds can be supported and didn't add work)

    Some operational outcomes can be achieved offsite (e.g. some impact of WFH on product/service delivery)

    Low degree of flexibility

    • High dependence on onsite equipment
    • Work cannot shift to online platforms
    • High dependence on onsite external interactions
    • High interdependence of work duties internally (e.g. line work)
    • Few work processes and expectations can be formally documented
    • Work processes cannot be done remotely, and workarounds for remote work are not sustainable long term

    Operational outcomes cannot be achieved offsite (e.g. significant impairment to product/service delivery)

    Note

    If roles within the segment have differing levels of location flexibility, use the lowest results (e.g. if role A in the segment has a high degree of flexibility for work duties and role B has a low degree of flexibility, use the results for role B).

    Identify work timing for priority segments

    Work timing looks at when work can or needs to be completed (e.g. Monday to Friday, 9am to 5pm).

    Work Duties

    Processes

    Operational Outcomes

    High degree of flexibility

    • No need to be available to internal and/or external customers during standard work hours
    • Equipment is available at any time
    • Does not rely on synchronous (occurring at the same time) work duties internally
    • Work processes and expectations are or can be formally documented
    • Low reliance on collaboration
    • Work is largely asynchronous (does not occur at the same time)

    Most or all operational outcomes are not time sensitive

    • Must be available to internal and/or external customers during some standard work hours
    • Some reliance on synchronous work duties internally (collaboration is critical)
    • Most work processes and expectations have been or can be formally documented
    • Moderate reliance on collaboration
    • Some work is synchronous

    Some operational outcomes are time sensitive and must be conducted within set date or time windows

    Low degree of flexibility

    • Must be available to internal and/or external customers during all standard work hours (e.g. Monday to Friday 9 to 5)
    • High reliance on synchronous work duties internally (e.g. line work)
    • Few work processes and expectations can be formally documented
    • High reliance on collaboration
    • Most work is synchronous

    Most or all operational outcomes are time sensitive and must be conducted within set date or time windows

    Note

    With additional coordination, flex time or flex time off options are still possible for employee segments with a low degree of flexibility. For example, with a four-day work week, the segment can be split into two teams – one that works Monday to Thursday and one that works Tuesday to Friday – so that employees are still available for clients five days a week.

    Examine work deliverables for priority segments

    Work deliverables look at the employee's ability to deliver on their role expectations (e.g. quota or targets) and whether reducing the time spent working would, in all situations, impact the work deliverables (e.g. constrained vs. unconstrained).

    Work Duties

    Operational Outcomes

    High degree of flexibility

    • Few or no work duties rely on equipment or processes that put constraints on output (unconstrained output)
    • Employees have autonomy over which work duties they focus on each day
    • Most or all operational outcomes are unconstrained (e.g. a marketing analyst who builds reports and strategies for clients can produce more reports, produce better reports, or identify new strategies)
    • Work quota or targets are achievable even if working fewer hours
    • Some work duties rely on equipment or processes that put constraints on output
    • Employees have some ability to decide which work duties they focus on each day
    • Some operational outcomes are constrained or moderately unconstrained (e.g. an analyst build reports based on client data; while it's possible to find efficiencies and build reports faster, it's not possible to attain the client data any faster)
    • Work quota or targets may be achievable if working fewer hours

    Low degree of flexibility

    • Most or all work duties rely on equipment or processes that put constraints on output (constrained output)
    • Daily work duties are prescribed (e.g. a telemarketer is expected to call a set number of people per day using a set list of contacts and a defined script)
    • Most or all operational outcomes are constrained (e.g. a machine operator works on a machine that produces 100 parts an hour; neither the machine nor the worker can produce more parts)
    • Work quota or targets cannot be achieved if fewer hours are worked

    Note

    For segments with a low degree of work deliverable flexibility (e.g. very constrained output), flexibility is still an option, but maintaining output would require additional headcount.

    1.3 Determine flexibility needs and constraints

    1-2 hours

    Use the guidelines on the preceding slides to document the parameters of each work segment.

    1. Determine work location flexibility. Work location looks at where a segment can complete all or some of their tasks (e.g. onsite vs. remote). For each prioritized employee segment, evaluate the amount of location flexibility available.
    2. Identify work timing. Work timing looks at when work can or needs to be completed (e.g. Monday to Friday, 9am to 5pm).
    3. Examine work deliverables. Work deliverables look at the employee's ability to deliver on their role expectations (e.g. quota or targets) and whether reducing the time spent working would, in all situations, impact the work deliverables (e.g. constrained vs. unconstrained).
    4. Record your outputs on the "Current and Desired State" tab of the workbook.

    Download the Targeted Flexible Work Program Workbook

    Input

    • List of employee segments

    Output

    • Summary of flexibility needs and constraints for each employee segment

    Materials

    • Targeted Flexible Work Program Workbook
      Or
    • Fast-Track Hybrid Work Program Workbook

    Participants

    • Flexible work program committee
    • Employee segment managers

    Step 2

    Identify potential flex options and assess feasibility

    1. Assess employee and organizational flexibility needs
    2. Identify potential flex options and assess feasibility
    3. Implement selected option(s)

    After completing this step you will have:

    • Created a shortlist of potential options for each prioritized employee segment
    • Evaluated the feasibility of each potential option
    • Determined the cost and benefit of each potential option
    • Gathered employee sentiment on potential options
    • Finalized options with senior leadership

    Prepare to identify and assess the feasibility of potential flexible work options

    First, review the Flexible Work Solutions Catalog

    Before proceeding to the next slide, review the Flexible Work Options Catalog to identify and shortlist five to seven flexible work options that are best suited to address the challenges faced for each of the priority employee segments identified in Step 1.

    Then, assess the feasibility of implementing selected options using slides 29 to 32

    Assess the feasibility of implementing the shortlisted solutions for the prioritized employee segments against the feasibility factors in this step. Repeat for each employee segment. Use the following slides to consult with and include leaders when appropriate.

    • Document your analysis in tabs 6 to 8 of the Targeted Flexible Work Program Workbook.
    • Note implementation issues throughout the assessment and record them in the tool. They will be addressed in Step 3: Implement Selected Program(s). Don't rule out an option simply because it presents some challenges; careful implementation can overcome many challenges.
    • At the end of this step, determine the final list of flexible work options and gain approval from senior leaders for implementation.

    Evaluate feasibility by reviewing the option's impact on continued operations and job performance

    Operational coverage

    Synchronous communication

    Time zones

    Face-to-face

    communication

    To what extent are employees needed to deliver products or services?

    • If constant customer service is required, stagger employees' schedules (e.g. one team works Monday-Thursday while another works Tuesday-Friday).

    To what extent do employees need to communicate with each other synchronously?

    • Break the workflow down and identify times when employees do and do not have to work at the same time to communicate with each other.

    To what extent do employees need to coordinate work across time zones?

    • If the organization already operates in different time zones, ensure that the option does not impact operations requiring continuous coverage.
    • When employees are located in different time zones, coordinate schedules based on the other operational factors.

    When do employees need to interact with each other or clients in person?

    • Examine the workflow closely to identify times when face-to-face communication is not required. Schedule "office days" for employees to work together when in-person interaction is needed.
    • When the interaction is only required with clients, determine whether employees are able to meet clients offsite.

    Info-Tech Insight

    Every role is eligible for hybrid location work. If onsite work duties prevent an employee group from participating, see if processes can be digitized or automated. Flexible work is an opportunity to go beyond current needs to future-proof your organization.

    Assess the option's alignment with organizational culture

    Symbols

    Values

    Behaviors

    How supportive of flexible work are the visible aspects of the organization's culture?

    • For example, the mission statement, newsletters, or office layout.
    • Note: Visible elements will need to be adapted to ensure they reinforce the value of the flexible work option.

    How supportive are both the stated and lived values of the organization?

    • When the flexible work option includes less direct supervision, assess how empowered employees feel to make decisions.
    • Assess whether all types of employees (e.g. virtual) are included, valued, and supported.

    How supportive are the attitudes and behaviors, especially of leaders?

    • Leaders set the expectations for acceptable behaviors in the organization. Determine how supportive leaders are toward flexible workers by examining their attitudes and perceptions.
    • Identify if employees are open to different ways of doing work.

    Determine the resources required for the option

    People

    Process

    Technology

    Do employees have the knowledge, skills, and abilities to adopt this option?

    • Identify any areas (e.g. process, technology) employees will need to be trained on and assess the associated costs.
    • Determine whether the option will require additional headcount to ensure operational continuity (e.g. two part-time employees in a job-sharing arrangement) and calculate associated costs (e.g. recruitment, training, benefits).

    How much will work processes need to change?

    • Interview organizational leaders with knowledge of the employee segment's core work processes. Determine whether a significant change will be required.
    • If a significant change is required, evaluate whether the benefits of the option outweigh the costs of the process and behavioral change (see the "net benefit" factor on slide 33).

    What new technologies will be required?

    • Identify the technology (e.g. that supports communication, work processes) required to enable the flexible work option.
    • Note whether existing technology can be used or additional technology will be required, and further investigate the viability and costs of these options.

    Examine the option's risks

    Data

    Health & Safety

    Legal

    How will data be kept secure?

    • Determine whether the organization's data policy and technology covers employees working remotely or other flexible work options.
    • If the employee segment handles sensitive data (e.g. personal employee information), consult relevant stakeholders to determine how data can be kept secure and assess any associated costs.

    How will employees' health and safety be impacted?

    • Consult your organization's legal counsel to determine whether the organization will be liable for the employees' health and safety while working from home or other locations.
    • Determine whether the organization's policies and processes will need to be modified.

    What legal risks might be involved?

    • Identify any policies in place or jurisdictional requirements to avoid any legal risks. Consult your organization's legal counsel about the situations below.
      • If the option causes significant changes to the nature of jobs, creating the risk of constructive dismissal.
      • If there are any risks to providing less supervision (e.g. higher chance of harassment).
      • When only some employee segments are eligible for the option, determine whether there is a risk of inequitable access.
      • If the option impacts any unionized employees or collective agreements.

    Determine whether the benefits of the option outweigh the costs

    Include senior leadership in the net benefit process to ensure any unfeasible options are removed from consideration before presenting to employees.

    1. Document the employee and employer benefits of the option from the previous feasibility factors on slides 29 to 32.
    • Include the benefits of reaching program goals identified in Step 1.
    • Quantify the benefits in dollar value where possible.
  • Document the costs and risks of the option, referring to the costs noted from previous feasibility factors.
    • Quantify the costs in dollar value where possible.
  • Compare the benefits and costs.
    • Add an option to your final list if the benefits are greater than the costs.
  • This is an image of a table with the main heading being Net Benefit, with the following subheadings: Benefits to organization; Benefits to employees; Costs.

    Info-Tech Insight

    Flexible work options must balance organizational and employee needs. If an option is beneficial to employees but there is little or no benefit to the organization as a whole, or if the cost of the option is too high, it will not support the long-term success of the organization.

    2.1a Identify and evaluate flexible work options

    30 minutes per employee segment per work option

    If you are only considering hybrid or remote work, skip to activity 2.1b. Use the guidelines on the preceding slides to conduct feasibility assessments.

    1. Shortlist flexible work options. Review the Flexible Work Options Catalog to identify and shortlist five to seven flexible work options that are best suited to address the challenges faced for each of the priority employee segments. Record these on the "Options Shortlist" tab of the workbook. Even if the decision is simple, ensure you record the rationale to help communicate your decision to employees. Transparent communication is the best way to avoid feelings of unfairness if desired work options are not implemented.
    2. Evaluate option feasibility. For each of the shortlisted options, complete one "Feasibility - Option" tab in the workbook. Make as many copies of this tab as needed.
      • When evaluating each option, consider each employee segment individually as you work through the prompts in the workbook. You may find that segments differ greatly in the feasibility of various types of flexible work. You will use this information to inform your overall policy and any exceptions to it.
      • You may need to involve each segment's management team to get an accurate picture of day-to-day responsibilities and flexible work feasibility.
    3. Weigh benefits and costs. At the end of each flexible work option evaluation, record the anticipated costs and benefits. Discuss whether this balance renders the option viable or rules it out.

    Download the Targeted Flexible Work Program Workbook

    Download the Flexible Work Options Catalog

    Input

    • List of employee segments

    Output

    • Shortlist of flexible work options
    • Feasibility analysis for each work option

    Materials

    • Targeted Flexible Work Program Workbook
    • Flexible Work Options Catalog

    Participants

    • Flexible work program committee
    • Employee segment managers

    2.1b Assess hybrid work feasibility

    30 minutes per employee segment

    Use the guidelines on the preceding slides to conduct a feasibility assessment. This exercise relies on having trialed hybrid or remote work before. If you have never implemented any degree of remote work, consider completing the full feasibility assessment in activity 2.1a.

    1. Evaluate hybrid work feasibility. Review the feasibility prompts on the "Work Unit Remote Work Assessment" tab and record your insight for each employee segment.
      • When evaluating each option, consider each employee segment individually as you work through the prompts in the workbook. You may find that segments differ greatly in their ability to accommodate hybrid work. You will use this information to inform your overall policy and any exceptions to it.
      • You may need to involve each segment's management team to get an accurate picture of day-to-day responsibilities and hybrid work feasibility.

    Download the Fast-Track Hybrid Work Program Workbook

    Input

    • List of employee segments

    Output

    • Feasibility analysis for each work option

    Materials

    • Fast-Track Hybrid Work Program Workbook

    Participants

    • Flexible work program committee
    • Employee segment managers

    Ask employees which options they prefer and gather feedback for implementation

    Deliver a survey and/or conduct focus groups with a selection of employees from all prioritized employee segments.

    Share

    • Present your draft list of options to select employees.
    • Communicate that the organization is in the process of assessing the feasibility of flexible work options and would like employee input to ensure flex work meets needs.
    • Be clear that the list is not final or guaranteed.

    Ask

    • Ask which options are preferred more than others.
    • Ask for feedback on each option – how could it be modified to meet employee needs better? Use this information to inform implementation in Step 3.

    Decide

    • Prioritize an option if many employees indicated an interest in it.
    • If employees indicate no interest in an option, consider eliminating it from the list, unless it will be required. There is no value in providing an option if employees won't use it.

    Survey

    • List the options and ask respondents to rate each on a Likert scale from 1 to 5.
    • Ask some open-ended questions with comment boxes for employee suggestions.

    Focus Group

    • Conduct focus groups to gather deeper feedback.
    • See Appendix I for sample focus group questions.

    Info-Tech Insight

    Prioritize flexible work options that employees want. Providing too many options often leads to information overload and results in employees not understanding what is available, lowering adoption of the flexible work program.

    Finalize options list with senior leadership

    1. Select one to three final options and outline the details of each. Include:
      • Scope: To what extent will the option be applied? E.g. work-from-home one or two days a week.
      • Eligibility: Which employee segments are eligible?
      • Cost: What investment will be required?
      • Critical implementation issues: Will any of the implementation issues identified for each feasibility factor impact whether the option will be approved?
      • Resources: What additional resources will be required (e.g. technology)?
    2. Present the options to stakeholders for approval. Include:
      • An outline of the finalized options, including what the option is and the scope, eligibility, and critical implementation issues.
      • The feasibility assessment results, including benefits, costs, and employee preferences. Have more detail from the other factors ready if leaders ask about them.
      • The investment (cost) required to implement the option.
    3. Proceed to Step 3 to implement approved options.

    Running an IT pilot of flex work

    • As a technology department, IT typically doesn't own flexible work implementation for the entire organization. However, it is common to trial flexible work options for IT first, before rolling out to the entire organization.
    • During a flex work pilot, ensure you are working closely with HR partners, especially regarding regulatory and compliance issues.
    • Keep the rest of the organizational stakeholders in the loop, especially regarding their agreement on the metrics by which the pilot's success will be evaluated.

    2.2a Finalize flexible work options

    2-3 hours + time to gather employee feedback

    If you are only considering hybrid or remote work, skip to activity 2.2b. Use the guidelines on the preceding slides to gather final feedback and finalize work option selections.

    1. Gather employee feedback. If employee preferences are already known, skip this step. If they are not, gather feedback to ascertain whether any of the shortlisted options are preferred. Remember that a successful flexible work program balances the needs of employees and the business, so employee preference is a key determinant in flexible work program success. Document this on the "Employee Preferences" tab of the workbook.
    2. Finalize flexible work options. Use your notes on the cost-benefit balance for each option, along with employee preferences, to decide whether the move forward with it. Record this decision on the "Options Final List" tab. Include information about eligible employee segments and any implementation challenges that came up during the feasibility assessments. This is the final decision summary that will inform your flexible program parameters and policies.

    Download the Targeted Flexible Work Program Workbook

    Input

    • Flexible work options shortlist

    Output

    • Final flexible work options list

    Materials

    • Targeted Flexible Work Program Workbook

    Participants

    • Flexible work program committee

    2.2b Finalize hybrid work parameters

    2-3 hours + time to gather employee feedback

    Use the guidelines on the preceding slides to gather final feedback and finalize work option selections.

    1. Summarize feasibility analysis. On the "Program Parameters" tab, record the main insights from your feasibility analysis. Finalize important elements, including eligibility for hybrid/remote work by employee segment. Additionally, record the standard parameters for the program (i.e. those that apply to all employee segments) and variable parameters (i.e. ones that differ by employee segment).

    Download the Fast-Track Hybrid Work Program Workbook

    Input

    • Hybrid work feasibility analysis

    Output

    • Final hybrid work program parameters

    Materials

    • Fast-Track Hybrid Work Program Workbook

    Participants

    • Flexible work program committee

    Step 3

    Implement selected option(s)

    1. Assess employee and organizational flexibility needs
    2. Identify potential flex options and assess feasibility
    3. Implement selected option(s)

    After completing this step, you will have:

    • Addressed implementation issues and cultural barriers
    • Equipped the organization to adopt flexible work options successfully
    • Piloted the program and assessed its success
    • Developed a plan for program rollout and communication
    • Established a program evaluation plan
    • Aligned HR programs to support the program

    Solve the implementation issues identified in your feasibility assessment

    1. Identify a solution for each implementation issue documented in the Targeted Flexible Work Program Workbook. Consider the following when identifying solutions:
      • Scope: Determine whether the solution will be applied to one or all employee segments.
      • Stakeholders: Identify stakeholders to consult and develop a solution. If the scope is one employee segment, work with organizational leaders of that segment. When the scope is the entire organization, consult with senior leaders.
      • Implementation: Collaborate with stakeholders to solve implementation issues. Balance the organizational and employee needs, referring to data gathered in Steps 1 and 2.

    Example:

    Issue

    Solution

    Option 1: Hybrid work

    Brainstorming at the beginning of product development benefits from face-to-face collaboration.

    Block off a "brainstorming day" when all team members are required in the office.

    Employee segment: Product innovation team

    One team member needs to meet weekly with the implementation team to conduct product testing.

    Establish a schedule with rotating responsibility for a team member to be at the office for product testing; allow team members to swap days if needed.

    Address cultural barriers by involving leaders

    To shift a culture that is not supportive of flexible work, involve leaders in setting an example for employees to follow.

    Misconceptions

    Tactics to overcome them

    • Flexible workers are less productive.
    • Flexible work disrupts operations.
    • Flexible workers are less committed to the organization.
    • Flexible work only benefits employees, not the organization.
    • Employees are not working if they aren't physically in the office.

    Make the case by highlighting challenges and expected benefits for both the organization and employees (e.g. same or increased productivity). Use data in the introductory section of this blueprint.

    Demonstrate operational feasibility by providing an overview of the feasibility assessment conducted to ensure operational continuity.

    Involve most senior leadership in communication.

    Encourage discovery and exploration by having managers try flexible work options themselves, which will help model it for employees.

    Highlight success stories within the organization or from competitors or similar industries.

    Invite input from managers on how to improve implementation and ownership, which helps to discover hidden options.

    Shift symbols, values, and behaviors

    • Work with senior leaders to identify symbols, values, and behaviors to modify to align with the selected flexible work options.
    • Validate that the final list aligns with your organization's mission, vision, and values.

    Info-Tech Insight

    Leaders' collective support of the flexible program determines the program's successful adoption. Don't sweep cultural barriers under the rug; acknowledge and address them to overcome them.

    Equip the organization for successful implementation

    Info-Tech recommends providing managers and employees with a guide to flexible work, introducing policies, and providing training for managers.

    Provide managers and employees with a guide to flexible work

    Introduce appropriate organization policies

    Equip managers with the necessary tools and training

    Use the guide to:

    • Familiarize employees and managers with the flexible work program.
    • Gain employee and manager buy-in and support for the program.
    • Explain the process and give guidance on selecting flexible work options and working with their colleagues to make it a success.

    Use Info-Tech's customizable policy templates to set guidelines, outline arrangements, and scope the organization's flexible work policies. This is typically done by, or in collaboration with, the HR department.

    Download the Guide to Flexible Work for Managers and Employees

    Download the Flex Location Policy

    Download the Flex Time-Off Policy

    Download the Flex Time Policy

    3.1 Prepare for implementation

    2-3 hours

    Use the guidelines on the preceding slides to brainstorm solutions to implementation issues and prepare to communicate program rollout to stakeholders.

    1. Solve implementation issues.
      • If you are working with the Targeted Flexible Work Program Workbook: For each implementation challenge identified on the "Final Options List" tab, brainstorm solutions. If you are working with the Fast-Track Hybrid Work Program Workbook: Work through the program enablement prompts on the "Program Enablement" tab.
      • You may need to involve relevant stakeholders to help you come up with appropriate solutions for each employee segment.
      • Ensure that any anticipated cultural barriers have been documented and are addressed during this step. Don't underestimate the importance of a supportive organizational culture to the successful rollout of flexible work.
    2. Prepare the employee guide. Modify the Guide to Flexible Work for Managers and Employees template to reflect your final work options list and the processes and expectations employees will need to follow.
    3. Create a communication plan. Use Info-Tech's Communicate Any IT Initiative blueprint and Appendix II to craft your messaging.

    Download the Guide to Flexible Work for Managers and Employees

    Download the Targeted Flexible Work Program Workbook

    Input

    • Flexible work options final list

    Output

    • Employee guide to flexible work
    • Flexible work rollout communication plan

    Materials

    • Guide to Flexible Work for Managers and Employees
    • Targeted Flexible Work Program Workbook
      Or
    • Fast-Track Hybrid Work Program Workbook

    Participants

    • Flexible work program committee
    • Employee segment managers

    Run an IT pilot for flexible work

    Prepare for pilot

    Launch Pilot

    Identify the flexible work options that will be piloted.

    • Refer to the final list of selected options for each priority segment to determine which options should be piloted.

    Select pilot participants.

    • If not rolling out to the entire IT department, look for the departments and/or team(s) where there is the greatest need and the biggest interest (e.g. team with lowest engagement scores).
    • Include all employees within the department, or team if the department is too large, in the pilot.
    • Start with a group whose managers are best equipped for the new flexibility options.

    Create an approach to collect feedback and measure the success of the pilot.

    • Feedback can be collected using surveys, focus groups, and/or targeted in-person interviews.

    The length of the pilot will greatly vary based on which flexible work options were selected (e.g. seasonal hours will require a shorter pilot period compared to implementing a compressed work week). Use discretion when deciding on pilot length and be open to extending or shortening the pilot length as needed.

    Launch pilot.

    • Launch the program through a town hall meeting or departmental announcement to build excitement and buy-in.
    • Develop separate communications for employee segments where appropriate. See Appendix II for key messaging to include.

    Gather feedback.

    • The feedback will be used to assess the pilot's success and to determine what modifications will be needed later for a full-scale rollout.
    • When gathering feedback, tailor questions based on the employee segment but keep themes similar. For example:
      • Employees: "How did this help your day-to-day work?"
      • Managers: "How did this improve productivity on your team?"

    Track metrics.

    • The success of the pilot is best communicated using your department's unique KPIs.
    • Metrics are critical for:
      • Accurately determining pilot success.
      • Getting buy-in to expand the pilot beyond IT.
      • Justifying to employees any changes made to the flexible work options.

    Assess the pilot's success and determine next steps

    Review the feedback collected on the previous slide and use this decision tree to decide whether to relaunch a pilot or proceed to a full-scale rollout of the program.

    This is an image of the flow chart used to assess the pilot's success and determine the next steps.  It will help you to determine whether you will Proceed to full-scale rollout on next slide, Major modifications to the option/launch (e.g. change operating time) – adjust and relaunch pilot or select a new employee segment and relaunch pilot, Minor modifications to the option/launch (e.g. introduce additional communications) – adjust and proceed to full scale rollout, or Return to shortlist (Step 2) and select a different option or launch pilot with a different employee segment.

    Prepare for full-scale rollout

    If you have run a team pilot prior to rolling out to all of IT, or run an IT pilot before an organizational rollout, use the following steps to transition from pilot to full rollout.

    1. Determine modifications
      • Review the feedback gathered during the pilot and determine what needs to change for a full-scale implementation.
      • Update HR policies and programs to support flexible work. Work closely with your HR business partner and other organizational leaders to ensure every department's needs are understood and compliance issues are addressed.
    2. Roll out and evaluate
      • Roll out the remainder of the program (e.g. to other employee segments or additional flexible work options) once there is significant uptake of the pilot by the target employee group and issues have been addressed.
      • Determine how feedback will be gathered after implementation, such as during engagement surveys, new hire and exit surveys, stay interviews, etc., and assess whether the program continues to meet employee and organizational needs.

    Rolling out beyond IT

    For a rollout beyond IT, HR will likely take over.

    However, this is your chance to remain at the forefront of your organization's flexible work efforts by continuing to track success and gather feedback within IT.

    Align HR programs and organizational policies to support flexible work

    Talent Management

    Learning & Development

    Talent Acquisition

    Reinforce managers' accountability for the success of flexible work in their teams:

    • Include "managing virtual teams" in the people management leadership competency.
    • Recognize managers who are modeling flexible work.

    Support flexible workers' career progression:

    • Monitor the promotion rates of flexible workers vs. non-flexible workers.
    • Make sure flexible workers are discussed during talent calibration meetings and have access to career development opportunities.

    Equip managers and employees with the knowledge and skills to make flexible work successful.

    • Provide guidance on selecting the right options and maintaining workflow.
    • If moving to a virtual environment, train managers on how to make it a success.

    Incorporate the flexible work program into the organization's employee value proposition to attract top talent who value flexible work options.

    • Highlight the program on the organization's career site and in job postings.

    Organizational policies

    Determine which organizational policies will be impacted as a result of the new flexible work options. For example, the introduction of flex time off can result in existing vacation policies needing to be updated.

    Plan to re-evaluate the program and make improvements

    Collect data

    Collect data

    Act on data

    Uptake

    Gather data on the proportion of employees eligible for each option who are using the option.

    If an option is tracking positively:

    • Maintain or expand the program to more of the organization.
    • Conduct a feasibility assessment (Step 2) for new employee segments.

    Satisfaction

    Survey managers and employees about their satisfaction with the options they are eligible for and provide an open box for suggestions on improvements.

    If an option is tracking negatively:

    • Investigate why. Gather additional data, interview organizational leaders, and/or conduct focus groups to gain deeper insight.
    • Re-assess the feasibility of the option (Step 2). If the costs outweigh the benefits based on new data, determine whether to cancel the option.
    • Take appropriate action based on the outcome of the evaluation, such as modifying or cancelling the option or providing employees with more support.
      • Note: Cancelling an option can impact the engagement of employees using the option. Ensure that the data, reasons for cancelling the option, and potential substitute options are communicated to employees in advance.

    Program goal progress

    Monitor progress against the program goals and metrics identified in Step 1 to evaluate the impact on issues that matter to the organization (e.g. retention, productivity, diversity).

    Career progression

    Evaluate flexible workers' promotion rates and development opportunities to determine if they are developing.

    Info-Tech Insight

    Negative performance of a flexible work option does not necessarily mean failure. Take the time to evaluate whether the option simply needs to be tweaked or whether it truly isn't working for the organization.

    Insight summary

    Overarching insight: IT excels at hybrid location work and is more effective as a business function when location, time, and time-off flexibility are an option for its employees.

    Introduction

    • Flexible work options are not a concession to lower productivity. Properly implemented, flex work enables employees to be more productive at reaching business goals.
    • Employees' lived experiences and needs determine if people use flexible work programs – a flex program that has limited use or excludes people will not benefit the organization.
    • Flexible work benefits everyone. IT employees experience greater engagement, motivation, and company loyalty. IT organizations realize benefits such as better service coverage, reduced facilities costs, and increased productivity.

    Step 1 insight

    • Hybrid work is a start. A comprehensive flex work program extends beyond flexible location to flexible time and time off. Organizations must understand the needs of unique employee groups to uncover the options that will attract and retain talent. Provide greater inclusivity to employees by broadening the scope to include flex location, flex time, and flex time off.
    • No two employee segments are the same. To be effective, flexible work options must align with the expectations and working processes of each segment.

    Step 2 insight

    • Every role is eligible for hybrid location work. If onsite work duties prevent an employee group from participating, see if processes can be digitized or automated. Flexible work is an opportunity to go beyond current needs to future proofing your organization.
    • Flexible work options must balance organizational and employee needs. If an option is beneficial to employees but there is little or no benefit to the organization, or if the cost of the option is too high, it will not support the long-term success of the organization.
    • Prioritize flexible work options that employees want. Providing too many options often leads to information overload and results in employees not understanding what is available, lowering adoption of the flexible work program.

    Step 3 insight

    • Leaders' collective support of the flexible program determines the program's successful adoption. Don't sweep cultural barriers under the rug; acknowledge and address them to overcome them.
    • Negative performance of a flexible work option does not necessarily mean failure. Take the time to evaluate whether the option simply needs to be tweaked or whether it truly isn't working for the organization.
    • A set of formal guidelines for IT ensures flexible work is:
      1. Administered fairly across all IT employees.
      2. Defensible and clear.
      3. Scalable to the rest of the organization.

    Research Contributors and Experts

    Quinn Ross
    CEO
    The Ross Firm Professional Corporation

    Margaret Yap
    HR Professor
    Ryerson University

    Heather Payne
    CEO
    Juno College

    Lee Nguyen
    HR Specialist
    City of Austin

    Stacey Spruell
    Division HR Director
    Travis County

    Don MacLeod
    Chief Administrative Officer
    Zorra Township

    Stephen Childs
    CHRO
    Panasonic North America

    Shawn Gibson
    Sr. Director
    Info Tech Research Group

    Mari Ryan
    CEO/Founder
    Advancing Wellness

    Sophie Wade
    Founder
    Flexcel Networks

    Kim Velluso
    VP Human Resources
    Siemens Canada

    Lilian De Menezes
    Professor of Decision Sciences
    Cass Business School, University of London

    Judi Casey
    WorkLife Consultant and former Director, Work and Family Researchers Network
    Boston College

    Chris Frame
    Partner – Operations
    LiveCA

    Rose M. Stanley, CCP, CBP, WLCP, CEBS
    People Services Manager
    Sunstate Equipment Co., LLC

    Shari Lava
    Director, Vendor Research
    Info-Tech Research Group

    Carol Cochran
    Director of People & Culture
    FlexJobs

    Kidde Kelly
    OD Practitioner

    Dr. David Chalmers
    Adjunct Professor
    Ted Rogers School of Management, Ryerson University

    Kashmira Nagarwala
    Change Manager
    Siemens Canada

    Dr. Isik U. Zeytinoglu
    Professor of Management and Industrial Relations McMaster University, DeGroote School of Business

    Claire McCartney
    Diversity & Inclusion Advisor
    CIPD

    Teresa Hopke
    SVP of Client Relations
    Life Meets Work – www.lifemeetswork.com

    Mark Tippey
    IT Leader and Experienced Teleworker

    Dr. Kenneth Matos
    Senior Director of Research
    Families and Work Institute

    1 anonymous contributor

    Appendix I: Sample focus group questions

    See Info-Tech's Focus Group Guidefor guidance on setting up and delivering focus groups. Customize the guide with questions specific to flexible work (see sample questions below) to gain deeper insight into employee preferences for the feasibility assessment in Step 2 of this blueprint.

    Document themes in the Targeted Flexible Work Program Workbook.

    • What do you need to balance/integrate your work with your personal life?
    • What challenges do you face in achieving work-life balance/integration?
    • What about your job is preventing you from achieving work-life balance/integration?
    • How would [flexible work option] help you achieve work-life balance/integration?
    • How well would this option work with the workflow of your team or department? What would need to change?
    • What challenges do you see in adopting [flexible work option]?
    • What else would be helpful for you to achieve work-life balance/integration?
    • How could we customize [flexible work option] to ensure it meets your needs?
    • If this program were to fail, what do you think would be the top reasons and why?

    Appendix II: Communication key messaging

    1. Program purpose

    Start with the name and high-level purpose of the program.

    2. Business reasons for the program

    Share data you gathered in Step 1, illustrating challenges causing the need for the program and the benefits.

    3. Options selection process

    Outline the process followed to select options. Remember to share the involvement of stakeholders and the planning around employees' feedback, needs, and lived experiences.

    4. Options and eligibility

    Provide a brief overview of the options and eligibility. Specify that the organization is piloting these options and will modify them based on feedback.

    5. Approval not guaranteed

    Qualify that employees need to be "flexible about flexible work" – the options are not guaranteed and may sometimes be unavailable for business reasons.

    6. Shared responsibility

    Highlight the importance of everyone (managers, flexible workers, the team) working together to make flexible work achievable.

    7. Next steps

    Share any next steps, such as where employees can find the organization's Guide to Flexible Work for Managers and Employees, how to make flexible work a success, or if managers will be providing further detail in a team meeting.

    8. Ongoing communications

    Normalize the program and embed it in organizational culture by continuing communications through various media, such as the organization's newsletter or announcements in town halls.

    Works Cited

    Baziuk, Jennifer, and Duncan Meadows. "Global Employee Survey - Key findings and implications for ICMIF." EY, June 2021. Accessed May 2022.
    "Businesses suffering 'commitment issues' on flexible working," EY, 21 Sep. 2021. Accessed May 2022.
    "IT Talent Trends 2022". Info-Tech Research Group, 2022.
    "Jabra Hybrid Ways of Working: 2021 Global Report." Jabra, Aug. 2021. Accessed May 2022.
    LinkedIn Talent Solutions. "2022 Global Talent Trends." LinkedIn, 2022. Accessed May 2022.
    Lobosco, Mark. "The Future of Work is Flexible: 71% of Leaders Feel Pressure to Change Working Models." LinkedIn, 9 Sep. 2021. Accessed May 2022.
    Ohm, Joy, et al. "Covid-19: Women, Equity, and Inclusion in the Future of Work." Catalyst, 28 May 2020. Accessed May 2022.
    Pelta, Rachel. "Many Workers Have Quit or Plan to After Employers Revoke Remote Work." FlexJobs, 2021. Accessed May 2022.
    Slack Future Forum. "Inflexible return-to-office policies are hammering employee experience scores." Slack, 19 April 2022. Accessed May 2022.
    "State of Hybrid Work in IT: A Trend Report". Info-Tech Research Group, 2023.
    Threlkeld, Kristy. "Employee Burnout Report: COVID-19's Impact and 3 Strategies to Curb It." Indeed, 11 March 2021. Accessed March 2022.

    Engineer Your Event Management Process

    • Buy Link or Shortcode: {j2store}461|cart{/j2store}
    • member rating overall impact: N/A
    • member rating average dollars saved: N/A
    • member rating average days saved: N/A
    • Parent Category Name: Operations Management
    • Parent Category Link: /i-and-o-process-management

    Build an event management practice that is situated in the larger service management environment. Purposefully choose valuable events to track and predefine their associated actions to cut down on data clutter.

    Our Advice

    Critical Insight

    Event management is useless in isolation. The goals come from the pain points of other ITSM practices. Build handoffs to other service management practices to drive the proper action when an event is detected.

    Impact and Result

    Create a repeatable framework to define monitored events, their root cause, and their associated action. Record your monitored events in a catalog to stay organized.

    Engineer Your Event Management Process Research & Tools

    Besides the small introduction, subscribers and consulting clients within this management domain have access to:

    1. Engineer Your Event Management Deck – A step-by-step document that walks you through how to choose meaningful, monitored events to track and action.

    Engineer your event management practice with tracked events informed by the business impact of the related systems, applications, and services. This storyboard will help you properly define and catalog events so you can properly respond when alerted.

    • Engineer Your Event Management Process – Phases 1-3

    2. Event Management Cookbook – A guide to help you walk through every step of scoping event management and defining every event you track in your IT environment.

    Use this tool to define your workflow for adding new events to track. This cookbook includes the considerations you need to include for every tracked event as well as the roles and responsibilities of those involved with event management.

    • Event Management Cookbook

    3. Event Management Catalog – Using the Event Management Cookbook as a guide, record all your tracked events in the Event Management Catalog.

    Use this tool to record your tracked events and alerts in one place. This catalog allows you to record the rationale, root-cause, action, and data governance for all your monitored events.

    • Event Management Catalog

    4. Event Management Workflow – Define your event management handoffs to other service management practices.

    Use this template to help define your event management handoffs to other service management practices including change management, incident management, and problem management.

    • Event Management Workflow (Visio)
    • Event Management Workflow (PDF)

    5. Event Management Roadmap – Implement and continually improve upon your event management practice.

    Use this tool to implement and continually improve upon your event management process. Record, prioritize, and assign your action items from the event management blueprint.

    • Event Management Roadmap
    [infographic]

    Workshop: Engineer Your Event Management Process

    Workshops offer an easy way to accelerate your project. If you are unable to do the project yourself, and a Guided Implementation isn't enough, we offer low-cost delivery of our project workshops. We take you through every phase of your project and ensure that you have a roadmap in place to complete your project successfully.

    1 Situate Event Management in Your Service Management Environment

    The Purpose

    Determine goals and challenges for event management and set the scope to business-critical systems.

    Key Benefits Achieved

    Defined system scope of Event Management

    Roles and responsibilities defined

    Activities

    1.1 List your goals and challenges

    1.2 Monitoring and event management RACI

    1.3 Abbreviated business impact analysis

    Outputs

    Event Management RACI (as part of the Event Management Cookbook)

    Abbreviated BIA (as part of the Event Management Cookbook)

    2 Define Your Event Management Scope

    The Purpose

    Define your in-scope configuration items and their operational conditions

    Key Benefits Achieved

    Operational conditions, related CIs and dependencies, and CI thresholds defined

    Activities

    2.1 Define operational conditions for systems

    2.2 Define related CIs and dependencies

    2.3 Define conditions for CIs

    2.4 Perform root-cause analysis for complex condition relationships

    2.5 Set thresholds for CIs

    Outputs

    Event Management Catalog

    3 Define Thresholds and Actions

    The Purpose

    Pre-define actions for every monitored event

    Key Benefits Achieved

    Thresholds and actions tied to each monitored event

    Activities

    3.1 Set thresholds to monitor

    3.2 Add actions and handoffs to event management

    Outputs

    Event Catalog

    Event Management Workflows

    4 Start Monitoring and Implement Event Management

    The Purpose

    Effectively implement event management

    Key Benefits Achieved

    Establish an event management roadmap for implementation and continual improvement

    Activities

    4.1 Define your data policy for event management

    4.2 Identify areas for improvement and establish an implementation plan

    Outputs

    Event Catalog

    Event Management Roadmap

    Further reading

    Engineer Your Event Management Process

    Track monitored events purposefully and respond effectively.

    EXECUTIVE BRIEF

    Analyst Perspective

    Event management is useless in isolation.

    Event management creates no value when implemented in isolation. However, that does not mean event management is not valuable overall. It must simply be integrated properly in the service management environment to inform and drive the appropriate actions.

    Every step of engineering event management, from choosing which events to monitor to actioning the events when they are detected, is a purposeful and explicit activity. Ensuring that event management has open lines of communication and actions tied to related practices (e.g. problem, incident, and change) allows efficient action when needed.

    Catalog your monitored events using a standardized framework to allow you to know:

    1. The value of tracking the event.
    2. The impact when the event is detected.
    3. The appropriate, right-sized reaction when the event is detected.
    4. The tool(s) involved in tracking the event.

    Properly engineering event management allows you to effectively monitor and understand your IT environment and bolster the proactivity of the related service management practices.

    Benedict Chang

    Benedict Chang
    Research Analyst, Infrastructure & Operations
    Info-Tech Research Group

    Executive Summary

    Your Challenge

    Strive for proactivity. Implement event management to reduce response times of technical teams to solve (potential) incidents when system performance degrades.

    Build an integrated event management practice where developers, service desk, and operations can all rely on event logs and metrics.

    Define the scope of event management including the systems to track, their operational conditions, related configuration items (CIs), and associated actions of the tracked events.

    Common Obstacles

    Managed services, subscription services, and cloud services have reduced the traditional visibility of on- premises tools.

    System(s) complexity and integration with the above services has increased, making true cause and effect difficult to ascertain.

    Info-Tech’s Approach

    Clearly define a limited number of operational objectives that may benefit from event management.

    Focus only on the key systems whose value is worth the effort and expense of implementing event management.

    Understand what event information is available from the CIs of those systems and map those against your operational objectives.

    Write a data retention policy that balances operational, audit, and debugging needs against cost and data security needs.

    Info-Tech Insight

    More is NOT better. Even in an AI-enabled world, every event must be collected with a specific objective in mind. Defining the purpose of each tracked event will cut down on data clutter and response time when events are detected.

    Your challenge

    This research is designed to help organizations who are facing these challenges or looking to:

    • Build an event management practice that is situated in the larger service management environment.
    • Purposefully choose events and to track as well as their related actions based on business-critical systems, their conditions, and their related CIs.
    • Cut down on the clutter of current events tracked.
    • Create a framework to add new events when new systems are onboarded.

    33%

    In 2020, 33% of organizations listed network monitoring as their number one priority for network spending. 27% of organizations listed network monitoring infrastructure as their number two priority.
    Source: EMA, 2020; n=350

    Common obstacles

    These barriers make this challenge difficult to address for many organizations:

    • Many organizations have multiple tools across multiple teams and departments that track the current state of infrastructure, making it difficult to consolidate event management into a single practice.
    • Managed services, subscription services, and cloud services have reduced the traditional visibility of on-premises tools
    • System(s) complexity and integration with the above services has increased, making true cause and effect difficult to ascertain.

    Build event management to bring value to the business

    33%

    33% of all IT organizations reported that end users detected and reported incidents before the network operations team was aware of them.
    Source: EMA, 2020; n=350

    64%

    64% of enterprises use 4-10 monitoring tools to troubleshoot their network.
    Source: EMA, 2020; n=350

    Info-Tech’s approach

    Choose your events purposefully to avoid drowning in data.

    A funnel is depicted. along the funnel are the following points: Event Candidates: 1. System Selection by Business Impact; 2. System Decomposition; 3. Event Selection and Thresholding; 4. Event Action; 5. Data Management; Valuable, Monitored, and Actioned Events

    The Info-Tech difference:

    1. Start with a list of your most business-critical systems instead of data points to measure.
    2. Decompose your business-critical systems into their configuration items. This gives you a starting point for choosing what to measure.
    3. Choose your events and label them as notifications, warnings, or exceptions. Choose the relevant thresholds for each CI.
    4. Have a pre-defined action tied to each event. That action could be to log the datapoint for a report or to open an incident or problem ticket.
    5. With your event catalog defined, choose how you will measure the events and where to store the data.

    Event management is useless in isolation

    Define how event management informs other management practices.

    Logging, Archiving, and Metrics

    Monitoring and event management can be used to establish and analyze your baseline. The more you know about your system baselines, the easier it will be to detect exceptions.

    Change Management

    Events can inform needed changes to stay compliant or to resolve incidents and problems. However, it doesn’t mean that changes can be implemented without the proper authorization.

    Automatic Resolution

    The best use case for event management is to detect and resolve incidents and problems before end users or IT are even aware.

    Incident Management

    Events sitting in isolation are useless if there isn’t an effective way to pass potential tickets off to incident management to mitigate and resolve.

    Problem Management

    Events can identify problems before they become incidents. However, you must establish proper data logging to inform problem prioritization and actioning.

    Info-Tech’s methodology for Engineering Your Event Management Process

    1. Situate Event Management in Your Service Management Environment 2. Define Your Monitoring Thresholds and Accompanying Actions 3. Start Monitoring and Implement Event Management

    Phase Steps

    1.1 Set Operational and Informational Goals

    1.2 Scope Monitoring and States of Interest

    2.1 Define Conditions and Related CIs

    2.2 Set Monitoring Thresholds and Alerts

    2.3 Action Your Events

    3.1 Define Your Data Policy

    3.2 Define Future State

    Event Cookbook

    Event Catalog

    Phase Outcomes

    Monitoring and Event Management RACI

    Abbreviated BIA

    Event Workflow

    Event Management Roadmap

    Insight summary

    Event management is useless in isolation.

    The goals come from the pain points of other ITSM practices. Build handoffs to other service management practices to drive the proper action when an event is detected.

    Start with business intent.

    Trying to organize a catalog of events is difficult when working from the bottom up. Start with the business drivers of event management to keep the scope manageable.

    Keep your signal-to-noise ratio as high as possible.

    Defining tracked events with their known conditions, root cause, and associated actions allows you to be proactive when events occur.

    Improve slowly over time.

    Start small if need be. It is better and easier to track a few items with proper actions than to try to analyze events as they occur.

    More is NOT better. Avoid drowning in data.

    Even in an AI-enabled world, every event must be collected with a specific objective in mind. Defining the purpose of each tracked event will cut down on data clutter and response time when events are detected.

    Add correlations in event management to avoid false positives.

    Supplement the predictive value of a single event by aggregating it with other events.

    Blueprint deliverables

    Each step of this blueprint is accompanied by supporting deliverables to help you accomplish your goals:

    Key deliverable:

    This is a screenshot of the Event Management Cookbook

    Event Management Cookbook
    Use the framework in the Event Management Cookbook to populate your event catalog with properly tracked and actioned events.

    This is a screenshot of the Event Management RACI

    Event Management RACI
    Define the roles and responsibilities needed in event management.

    This is a screenshot of the event management workflow

    Event Management Workflow
    Define the lifecycle and handoffs for event management.

    This is a screenshot of the Event Catalog

    Event Catalog
    Consolidate and organize your tracked events.

    This is a screenshot of the Event Roadmap

    Event Roadmap
    Roadmap your initiatives for future improvement.

    Blueprint benefits

    IT Benefits

    • Provide a mechanism to compare operating performance against design standards and SLAs.
    • Allow for early detection of incidents and escalations.
    • Promote timely actions and ensure proper communications.
    • Provide an entry point for the execution of service management activities.
    • Enable automation activity to be monitored by exception
    • Provide a basis for service assurance, reporting and service improvements.

    Business Benefits

    • Less overall downtime via earlier detection and resolution of incidents.
    • Better visibility into SLA performance for supplied services.
    • Better visibility and reporting between IT and the business.
    • Better real-time and overall understanding of the IT environment.

    Case Study

    An event management script helped one company get in front of support calls.

    INDUSTRY - Research and Advisory

    SOURCE - Anonymous Interview

    Challenge

    One staff member’s workstation had been infected with a virus that was probing the network with a wide variety of usernames and passwords, trying to find an entry point. Along with the obvious security threat, there existed the more mundane concern that workers occasionally found themselves locked out of their machine and needed to contact the service desk to regain access.

    Solution

    The system administrator wrote a script that runs hourly to see if there is a problem with an individual’s workstation. The script records the computer's name, the user involved, the reason for the password lockout, and the number of bad login attempts. If the IT technician on duty notices a greater than normal volume of bad password attempts coming from a single account, they will reach out to the account holder and inquire about potential issues.

    Results

    The IT department has successfully proactively managed two distinct but related problems: first, they have prevented several instances of unplanned work by reaching out to potential lockouts before they receive an incident report. They have also successfully leveraged event management to probe for indicators of a security threat before there is a breach.

    Info-Tech offers various levels of support to best suit your needs

    DIY Toolkit

    “Our team has already made this critical project a priority, and we have the time and capability, but some guidance along the way would be helpful.”

    Guided Implementation

    “Our team knows that we need to fix a process, but we need assistance to determine where to focus. Some check-ins along the way would help keep us on track.”

    Workshop

    “We need to hit the ground running and get this project kicked off immediately. Our team has the ability to take this over once we get a framework and strategy in place.”

    Consulting

    “Our team does not have the time or the knowledge to take this project on. We need assistance through the entirety of this project.”

    Diagnostics and consistent frameworks used throughout all four options

    Guided Implementation

    What does a typical GI on this topic look like?

    Phase 1 Phase 2 Phase 3

    Call #1: Scope requirements, objectives, and your specific challenges.

    Call #2: Introduce the Cookbook and explore the business impact analysis.

    Call #4: Define operational conditions.

    Call #6: Define actions and related practices.

    Call #8: Identify and prioritize improvements.

    Call #3: Define system scope and related CIs/ dependencies.

    Call #5: Define thresholds and alerts.

    Call #7: Define data policy.

    A Guided Implementation (GI) is a series of calls with an Info-Tech analyst to help implement our best practices in your organization.

    A typical GI is between 6 to 12 calls over the course of 4 to 6 months.

    Workshop Overview

    Contact your account representative for more information.
    workshops@infotech.com 1-888-670-8889

    Day 1 Day 2 Day 3 Day 4 Day 5
    Situate Event Management in Your Service Management Environment Define Your Event Management Scope Define Thresholds and Actions Start Monitoring and Implement Event Management Next Steps and Wrap-Up (offsite)

    Activities

    1.1 3.1 Set Thresholds to Monitor

    3.2 Add Actions and Handoffs to Event Management

    Introductions

    1.2 Operational and Informational Goals and Challenges

    1.3 Event Management Scope

    1.4 Roles and Responsibilities

    2.1 Define Operational Conditions for Systems

    2.2 Define Related CIs and Dependencies

    2.3 Define Conditions for CIs

    2.4 Perform Root-Cause Analysis for Complex Condition Relationships

    2.4 Set Thresholds for CIs

    3.1 Set Thresholds to Monitor

    3.2 Add Actions and Handoffs to Event Management

    4.1 Define Your Data Policy for Event Management

    4.2 Identify Areas for Improvement and Future Steps

    4.3 Summarize Workshop

    5.1 Complete In-Progress Deliverables From Previous Four Days

    5.2 Set Up Review Time for Workshop Deliverables and to Discuss Next Steps

    Deliverables
    1. Monitoring and Event Management RACI (as part of the Event Management Cookbook)
    2. Abbreviated BIA (as part of the Event Management Cookbook)
    3. Event Management Cookbook
    1. Event Management Catalog
    1. Event Management Catalog
    2. Event Management Workflows
    1. Event Management Catalog
    2. Event Management Roadmap
    1. Workshop Summary

    Phase 1

    Situate Event Management in Your Service Management Environment

    Phase 1 Phase 2 Phase 3

    1.1 Set Operational and Informational Goals
    1.2 Scope Monitoring and Event Management Using Business Impact

    2.1 Define Conditions and Related CIs
    2.2 Set Monitoring Thresholds and Alerts
    2.3 Action Your Events

    3.1 Define Your Data Policy
    3.2 Set Your Future of Event Monitoring

    Engineer Your Event Management Process

    This phase will walk you through the following activities:

    1.1.1 List your goals and challenges

    1.1.2 Build a RACI chart for event management

    1.2.1 Set your scope using business impact

    This phase involves the following participants:

    Infrastructure management team

    IT managers

    Step 1.1

    Set Operational and Informational Goals

    Activities

    1.1.1 List your goals and challenges

    1.1.2 Build a RACI chart for event management

    Situate Event Management in Your Service Management Environment

    This step will walk you through the following activities:

    Set the overall scope of event management by defining the governing goals. You will also define who is involved in event management as well as their responsibilities.

    This step involves the following participants:

    Infrastructure management team

    IT managers

    Outcomes of this step

    Define the goals and challenges of event management as well as their data proxies.

    Have a RACI matrix to define roles and responsibilities in event management.

    Situate event management among related service management practices

    This image depicts the relationship between Event Management and related service management practices.

    Event management needs to interact with the following service management practices:

    • Incident Management – Event management can provide early detection and/or prevention of incidents.
    • Availability and Capacity Management – Event management helps detect issues with availability and capacity before they become an incident.
    • Problem Management – The data captured in event management can aid in easier detection of root causes of problems.
    • Change Management – Event management can function as the rationale behind needed changes to fix problems and incidents.

    Consider both operational and informational goals for event management

    Event management may log real-time data for operational goals and non-real time data for informational goals

    Event Management

    Operational Goals (real-time)

    Informational Goals (non-real time)

    Incident Response & Prevention

    Availability Scaling

    Availability Scaling

    Modeling and Testing

    Investigation/ Compliance

    • Knowing what the outcomes are expected to achieve helps with the design of that process.
    • A process targeted to fewer outcomes will generally be less complex, easier to adhere to, and ultimately, more successful than one targeted to many goals.
    • Iterate for improvement.

    1.1.1 List your goals and challenges

    Gather a diverse group of IT staff in a room with a whiteboard.

    Have each participant write down their top five specific outcomes they want from improved event management.

    Consolidate similar ideas.

    Prioritize the goals.

    Record these goals in your Event Management Cookbook.

    Priority Example Goals
    1 Reduce response time for incidents
    2 Improve audit compliance
    3 Improve risk analysis
    4 Improve forecasting for resource acquisition
    5 More accurate RCAs

    Input

    • Pain points

    Output

    • Prioritized list of goals and outcomes

    Materials

    • Whiteboard/flip charts
    • Sticky notes

    Participants

    • Infrastructure management team
    • IT managers

    Download the Event Management Cookbook

    Event management is a group effort

    • Event management needs to involve multiple other service management practices and service management roles to be effective.
    • Consider the roles to the right to see how event management can fit into your environment.

    Infrastructure Team

    The infrastructure team is accountable for deciding which events to track, how to track, and how to action the events when detected.

    Service Desk

    The service desk may respond to events that are indicative of incidents. Setting a root cause for events allows for quicker troubleshooting, diagnosis, and resolution of the incident.

    Problem and Change Management

    Problem and change management may be involved with certain event alerts as the resultant action could be to investigate the root cause of the alert (problem management) or build and approve a change to resolve the problem (change management).

    1.1.2 Build a RACI chart for event management

    1. As a group, complete the RACI chart using the template to the right. RACI stands for the following:
      • Responsible. The person doing the work.
      • Accountable. The person who ensures the work is done.
      • Consulted. Two-way communication.
      • Informed. One-way communication
      • There must be one and only one accountable person for each task. There must also be at least one responsible person. Depending on the use case, RACI letters may be combined (e.g. AR means the person who ensures the work is complete but also the person doing the work).
    2. Start with defining the roles in the first row in your own environment.
    3. Look at the tasks on the first column and modify/add/subtract tasks as necessary.
    4. Populate the RACI chart as necessary.

    Download the Event Management Cookbook

    Event Management Task IT Manager SME IT Infrastructure Manager Service Desk Configuration Manager (Event Monitoring System) Change Manager Problem Manager
    Defining systems and configuration items to monitor R C AR R
    Defining states of operation R C AR C
    Defining event and event thresholds to monitor R C AR I I
    Actioning event thresholds: Log A R
    Actioning event thresholds: Monitor I R A R
    Actioning event thresholds: Submit incident/change/problem ticket R R A R R I I
    Close alert for resolved issues AR RC RC

    Step 1.2

    Scope Monitoring and Event Management Using Business Impact

    Activities

    1.2.1 Set your scope using business impact

    Situate Event Management in Your Service Management Environment

    This step will walk you through the following activities:

    • Set your scope of event management using an abbreviated business impact analysis.

    This step involves the following participants:

    • Infrastructure manager
    • IT managers

    Outcomes of this step

    • List of systems, services, and applications to monitor.

    Use the business impact of your systems to set the scope of monitoring

    Picking events to track and action is difficult. Start with your most important systems according to business impact.

    • Business impact can be determined by how costly system downtime is. This could be a financial impact ($/hour of downtime) or goodwill impact (internal/external stakeholders affected).
    • Use business impact to determine the rating of a system by Tier (Gold, Silver, or Bronze):
      • GOLD: Mission-critical services. An outage is catastrophic in terms of cost or public image/goodwill. Example: trading software at a financial institution.
      • SILVER: Important to daily operations but not mission critical. Example: email services at any large organization.
      • BRONZE: Loss of these services is an inconvenience more than anything, though they do serve a purpose and will be missed if they are never brought back online. Example: ancient fax machines.
    • Align a list of systems to track with your previously selected goals for event management to determine WHY you need to track that system. Tracking the system could inform critical SLAs (performance/uptime), vulnerability, compliance obligations, or simply system condition.

    More is not better

    Tracking too many events across too many tools could decrease your responsiveness to incidents. Start tracking only what is actionable to keep the signal-to-noise ratio of events as high as possible.

    % of Incidents Reported by End Users Before Being Recognized by IT Operations

    A bar graph is depicted. It displays the following Data: All Organizations: 40%; 1-3 Tools: 29; 4-10 Tools: 36%; data-verified=11 Tools: 52">

    Source: Riverbed, 2016

    1.2.1 Set your scope using business impact

    Collating an exhaustive list of applications and services is onerous. Start small, with a subset of systems.

    1. Gather a diverse group of IT staff and end users in a room with a whiteboard.
    2. List 10-15 systems and services. Solicit feedback from the group. Questions to ask:
      • What services do you regularly use? What do you see others using?
        (End users)
      • Which service comprises the greatest number of service calls? (IT)
      • What services are the most critical for business operations? (Everybody)
      • What is the cost of downtime (financial and goodwill) for these systems? (Business)
      • How does monitoring these systems align with your goals set in Step 1.1?
    3. Assign an importance to each of these systems from Gold (most important) to Bronze (least important).
    4. Record these systems in your Event Management Cookbook.
    Systems/Services/Applications Tier
    1 Core Infrastructure Gold
    2 Internet Access Gold
    3 Public-Facing Website Gold
    4 ERP Silver
    15 PaperSave Bronze

    Include a variety of services in your analysis

    It might be tempting to jump ahead and preselect important applications. However, even if an application is not on the top 10 list, it may have cross-dependencies that make it more valuable than originally thought.

    For a more comprehensive BIA, see Create a Right-Sized Disaster Recovery Plan
    Download the Event Management Cookbook

    Phase 2

    Define Your Monitoring Thresholds and Accompanying Actions

    Phase 1Phase 2Phase 3

    1.1 Set Operational and Informational Goals
    1.2 Scope Monitoring and Event Management Using Business Impact

    2.1 Define Conditions and Related CIs
    2.2 Set Monitoring Thresholds and Alerts
    2.3 Action Your Events

    3.1 Define Your Data Policy
    3.2 Set Your Future of Event Monitoring

    Engineer Your Event Management Process

    This phase will walk you through the following activities:

    • 2.1.1 Define performance conditions
    • 2.1.2 Decompose services into Related CIs
    • 2.2.1 Verify your CI conditions with a root-cause analysis
    • 2.2.2 Set thresholds for your events
    • 2.3.1 Set actions for your thresholds
    • 2.3.2 Build your event management workflow

    This phase involves the following participants:

    • Business system owners
    • Infrastructure manager
    • IT managers

    Step 2.1

    Define Conditions and Related CIs

    Activities

    2.1.1 Define performance conditions

    2.1.2 Decompose services into related CIs

    Define Your Monitoring Thresholds and Accompanying Actions

    This step will walk you through the following activities:

    For each monitored system, define the conditions of interest and related CIs.

    This step involves the following participants:

    Business system owners

    Infrastructure manager

    IT managers

    Outcomes of this step

    List of conditions of interest and related CIs for each monitored system.

    Consider the state of the system that is of concern to you

    Events present a snapshot of the state of a system. To determine which events you want to monitor, you need to consider what system state(s) of importance.

    • Systems can be in one of three states:
      • Up
      • Down
      • Degraded
    • What do these states mean for each of your systems chosen in your BIA?
    • Up and Down are self-explanatory and a good place to start.
    • However, degraded systems are indicative that one or more component systems of an overarching system has failed. You must uncover the nature of such a failure, which requires more sophisticated monitoring.

    2.1.1 Define system states of greatest importance for each of your systems

    1. With the system business owners and compliance officers in the room, list the performance states of your systems chosen in your BIA.
    2. If you have too many systems listed, start only with the Gold Systems.
    3. Use the following proof approaches if needed:
      • Positive Proof Approach – every system when it has certain technical and business performance expectations. You can use these as a baseline.
      • Negative Proof Approach – users know when systems are not performing. Leverage incident data and end-user feedback to determine failed or degraded system states and work backwards.
    4. Focus on the end-user facing states.
    5. Record your critical system states in the Event Management Cookbook.
    6. Use these states in the next several activities and translate them into measurable infrastructure metrics.

    Input

    • Results of business impact analysis

    Output

    • Critical system states

    Materials

    • Whiteboard/flip charts
    • Sticky notes
    • Markers

    Participants

    • Infrastructure manager
    • Business system owners

    Download the Event Management Cookbook

    2.1.2 Decompose services into relevant CIs

    Define your system dependencies to help find root causes of degraded systems.

    1. For each of your systems identified in your BIA, list the relevant CIs.
    2. Identify dependencies and relationship of those CIs with other CIs (linkages and dependencies).
    3. Starting with the Up/Down conditions for your Gold systems, list the conditions of the CIs that would lead to the condition of the system. This may be a 1:1 relationship (e.g. Core Switches down = Core Infrastructure down) or a many:1 relationship (some virtualization hosts + load balancers down = Core Infrastructure down). You do not need to define specific thresholds yet. Focus on conditions for the CIs.
    4. Repeat step 3 with Degraded conditions.
    5. Repeat step 3 and 4 with Silver and Bronze systems.
    6. Record the results in the Event Management Cookbook.

    Core Infrastructure Example

    An iceberg is depicted. below the surface, are the following terms in order from shallowest to deepest: MPLS Connection, Core Switches, DNS; DHCP, AD ADFS, SAN-01; Load Balancers, Virtualization Hosts (x 12); Power and Cooling

    Download the Event Management Cookbook

    Step 2.2

    Set Monitoring Thresholds and Alerts

    Activities

    2.2.1 Verify your CI conditions with a root-cause analysis

    2.2.2 Set thresholds for your events

    Define Your Monitoring Thresholds and Accompanying Actions

    This step will walk you through the following activities:

    Set monitoring thresholds for each CI related to each condition of interest.

    This step involves the following participants:

    Business system managers

    Infrastructure manager

    IT managers

    Service desk manager

    Outcomes of this step

    List of events to track along with their root cause.

    Event management will involve a significant number of alerts

    Separate the serious from trivial to keep the signal-to-noise ratio high.

    Event Categories: Exceptions: Alarms Indicate Failure; Alerts indicate exceeded thresholds; Normal Operation. Event Alerts: Informational; Exceptional; Warning

    Set your own thresholds

    You must set your own monitoring criteria based on operational needs. Events triggering an action should be reviewed via an assessment of the potential project and associated risks.

    Consider the four general signal types to help define your tracked events

    Latency – time to respond

    Examples:

    • Web server – time to complete request
    • Network – roundtrip ping time
    • Storage – read/write queue times

    Traffic – amount of activity per unit time

    Web sever – how many pages per minute

    Network – Mbps

    Storage – I/O read/writes per sec

    Errors – internally tracked erratic behaviors

    Web Server – page load failures

    Network – packets dropped

    Storage – disk errors

    Saturation – consumption compared to theoretical maximum

    Web Server – % load

    Network – % utilization

    Storage – % full

    2.2.1 Verify your CI conditions with a root-cause analysis

    RCAs postulate why systems go down; use the RCA to inform yourself of the events leading up to the system going down.

    1. Gather a diverse group of IT staff in a room with a whiteboard.
    2. Pick a complex example of a system condition (many:1 correlation) that has considerable data associated with it (e.g. recorded events, problem tickets).
    3. Speculate on the most likely precursor conditions. For example, if a related CI fails or is degraded, which metrics would you likely see before the failure?
    4. If something failed, imagine what you’d most likely see before the failure.
    5. Extend that timeline backward as far as you can be reasonably confident.
    6. Pick a value for that event.
    7. Write out your logic flow from event recognition to occurrence.
    8. Once satisfied, program the alert and ideally test in a non-prod environment.

    Public Website Example

    Dependency CIs Tool Metrics
    ISP WAN SNMP Traps Latency
    Telemetry Packet Loss
    SNMP Pooling Jitter
    Network Performance Web Server Response Time
    Connection Stage Errors
    Web Server Web Page DOM Load Time
    Performance
    Page Load Time

    Let your CIs help you

    At the end of the day, most of us can only monitor what our systems let us. Some (like Exchange Servers) offer a crippling number of parameters to choose from. Other (like MPLS) connections are opaque black boxes giving up only the barest of information. The metrics you choose are largely governed by the art of the possible.

    Case Study

    Exhaustive RCAs proved that 54% of issues were not caused by storage.

    This is the Nimble Storage Logo

    INDUSTRY - Enterprise IT
    SOURCE - ESG, 2017

    Challenge

    Despite a laser focus on building nothing but all-flash storage arrays, Nimble continued to field a dizzying number of support calls.

    Variability and complexity across infrastructure, applications, and configurations – each customer install being ever so slightly different – meant that the problem of customer downtime seemed inescapable.

    Solution

    Nimble embedded thousands of sensors into its arrays, both at a hardware level and in the code. Thousands of sensors per array multiplied by 7,500 customers meant millions of data points per second.

    This data was then analyzed against 12,000 anonymized app-data gap-related incidents.

    Patterns began to emerge, ones that persisted across complex customer/array/configuration combinations.

    These patterns were turned into signatures, then acted on.

    Results

    54% of app-data gap related incidents were in fact related to non-storage factors! Sub-optimal configuration, bad practices, poor integration with other systems, and even VM or hosts were at the root cause of over half of reported incidents.

    Establishing that your system is working fine is more than IT best practice – by quickly eliminating potential options the right team can get working on the right system faster thus restoring the service more quickly.

    Gain an even higher SNR with event correlation

    Filtering:

    Event data determined to be of minimal predictive value is shunted aside.

    Aggregation:

    De-duplication and combination of similar events to trigger a response based on the number or value of events, rather than for individual events.

    Masking:

    Ignoring events that occur downstream of a known failed system. Relies on accurate models of system relationships.

    Triggering:

    Initiating the appropriate response. This could be simple logging, any of the exception event responses, an alert requiring human intervention, or a pre-programmed script.

    2.2.2 Set thresholds for your events

    If the event management team toggles the threshold for an alert too low (e.g. one is generated every time a CPU load reaches 60% capacity), they will generate too many false positives and create far too much work for themselves, generating alert fatigue. If they go the other direction and set their thresholds too high, there will be too many false negatives – problems will slip through and cause future disruptions.

    1. Take your list of RCAs from the previous activity and conduct an activity with the group. The goal of the exercise is to produce the predictive event values that confidently predict an imminent event.
    2. Questions to ask:
      • What are some benign signs of this incident?
      • Is there something we could have monitored that would have alerted us to this issue before an incident occurred?
      • Should anyone have noticed this problem? Who? Why? How?
      • Go through this for each of the problems identified and discuss thresholds. When complete, include the information in the Event Management Catalog.

    Public Website Example

    Dependency Metrics Threshold
    Network Performance Latency 150ms
    Packet Loss 10%
    Jitter >1ms
    Web Server Response Time 750ms
    Performance
    Connection Stage Errors 2
    Web Page Performance DOM Load time 1100ms
    Page Load time 1200ms

    Download the Event Management Cookbook

    Step 2.3

    Action Your Events

    Activities

    2.3.1 Set actions for your thresholds

    2.3.2 Build your event management workflow

    Define Your Monitoring Thresholds and Associated Actions

    This step will walk you through the following activities:

    With your list of tracked events from the previous step, build associated actions and define the handoff from event management to related practices.

    This step involves the following participants:

    Event management team

    Infrastructure team

    Change manager

    Problem manager

    Incident manager

    Outcomes of this step

    Event management workflow

    Set actions for your thresholds

    For each of your thresholds, you will need an action tied to the event.

    • Review the event alert types:
      • Informational
      • Warning
      • Exception
    • Your detected events will require one of the following actions if detected.
    • Unactioned events will lead to a poor signal-to-noise ratio of data, which ultimately leads to confusion in the detection of the event and decreased response effectiveness.

    Event Logged

    For informational alerts, log the event for future analysis.

    Automated Resolution

    For a warning or exception event or a set of events with a well-known root cause, you may have an automated resolution tied to detection.

    Human Intervention

    For warnings and exceptions, human intervention may be needed. This could include manual monitoring or a handoff to incident, change, or problem management.

    2.3.1 Set actions for your thresholds

    Alerts generated by event management are useful for many different ITSM practitioners.

    1. With the chosen thresholds at hand, analyze the alerts and determine if they require immediate action or if they can be logged for later analysis.
    2. Questions to ask:
      1. What kind of response does this event warrant?
      2. How could we improve our event management process?
      3. What event alerts would have helped us with root-cause analysis in the past?
    3. Record the results in the Event Management Catalog.

    Public Website Example

    Outcome Metrics Threshold Response (s)
    Network Performance Latency 150ms Problem Management Tag to Problem Ticket 1701
    Web Page Performance DOM Load time 1100ms Change Management

    Download the Event Management Catalog

    Input

    • List of events generated by event management

    Output

    • Action plan for various events as they occur

    Materials

    • Whiteboard/flip charts
    • Pens
    • Paper

    Participants

    • Event Management Team
    • Infrastructure Team
    • Change Manager
    • Problem Manager
    • Incident Manager

    2.3.2 Build your event management workflow

    1. As a group, discuss your high-level monitoring, alerting, and actioning processes.
    2. Define handoff processes to incident, problem, and change management. If necessary, open your incident, problem, and change workflows and discuss how the event can further pass onto those practices. Discuss the examples below:
      • Incident Management: Who is responsible for opening the incident ticket? Can the incident ticket be automated and templated?
      • Change Management: Who is responsible for opening an RFC? Who will approve the RFC? Can it be a pre-approved change?
      • Problem Management : Who is responsible for opening the problem ticket? How can the event data be useful in the problem management process?
    3. Use and modify the example workflow as needed by downloading the Event Management Workflow.

    Example Workflow:

    This is an image of an example Event Management Workflow

    Download the Event Management Workflow

    Common datapoints to capture for each event

    Data captured will help related service management practices in different ways. Consider what you will need to record for each event.

    • Think of the practice you will be handing the event to. For example, if you’re handing the event off to incident or problem management, data captured will have to help in root-cause analysis to find and execute the right solution. If you’re passing the event off to change management, you may need information to capture the rationale of the change.
    • Knowing the driver for the data can help you define the right data captured for every event.
    • Consider the data points below for your events:

    Data Fields

    Device

    Date/time

    Component

    Parameters in exception

    Type of failure

    Value

    Download the Event Management Catalog

    Start Monitoring and Implement Event Management

    Phase 1Phase 2Phase 3

    1.1 Set Operational and Informational Goals
    1.2 Scope Monitoring and Event Management Using Business Impact

    2.1 Define Conditions and Related CIs
    2.2 Set Monitoring Thresholds and Alerts
    2.3 Action Your Events

    3.1 Define Your Data Policy
    3.2 Set Your Future of Event Monitoring

    Engineer Your Event Management Process

    This phase will walk you through the following activities:

    3.1.1 Define data policy needs

    3.2.1 Build your roadmap

    This phase involves the following participants:

    Business system owners

    Infrastructure manager

    IT managers

    Step 3.1

    Define Your Data Policy

    Activities

    3.1.1 Define data policy needs

    Start Monitoring and Implement Event Management

    This step will walk you through the following activities:

    Your overall goals from Phase 1 will help define your data retention needs. Document these policy statements in a data policy.

    This step involves the following participants:

    CIO

    Infrastructure manager

    IT managers

    Service desk manager

    Outcomes of this step

    Data retention policy statements for event management

    Know the difference between logs and metrics

    Logs

    Metrics

    A log is a complete record of events from a period:

    • Structured
    • Binary
    • Plaintext
    Missing entries in logs can be just as telling as the values existing in other entries. A metric is a numeric value that gives information about a system, generally over a time series. Adjusting the time series allows different views of the data.

    Logs are generally internal constructs to a system:

    • Applications
    • DB replications
    • Firewalls
    • SaaS services

    Completeness and context make logs excellent for:

    • Auditing
    • Analytics
    • Real-time and outlier analysis
    As a time series, metrics operate predictably and consistently regardless of system activity.

    This independence makes them ideal for:

    • Alerts
    • Dashboards
    • Profiling

    Large amounts of log data can make it difficult to:

    • Store
    • Transmit
    • Sift
    • Sort

    Context insensitivity means we can apply the same metric to dissimilar systems:

    • This is especially important for blackbox systems not fully under local control.

    Understand your data requirements

    Amount of event data logged by a 1000 user enterprise averages 113GB/day

    Source: SolarWinds

    Security Logs may contain sensitive information. Best practice is to ensure logs are secure at rest and in transit. Tailor your security protocol to your compliance regulations (PCI, etc.).
    Architecture and Availability When production infrastructure goes down, logging tends to go down as well. Holes in your data stream make it much more difficult to determine root causes of incidents. An independent secondary architecture helps solve problems when your primary is offline. At the very least, system agents should be able to buffer data until the pipeline is back online.
    Performance Log data grows: organically with the rest of the enterprise and geometrically in the event of a major incident. Your infrastructure design needs to support peak loads to prevent it from being overwhelmed when you need it the most.
    Access Control Events have value for multiple process owners in your enterprise. You need to enable access but also ensure data consistency as each group performs their own analysis on the data.
    Retention Near-real time data is valuable operationally; historic data is valuable strategically. Find a balance between the two, keeping in mind your obligations under compliance frameworks (GDPR, etc.).

    3.1.1 Set your data policy for every event

    1. Given your event list in the Event Management Catalog, include the following information for each event:
      • Retention Period
      • Data Sensitivity
      • Data Rate
    2. Record the results in the Event Management Catalog.

    Public Website Example

    Metrics/Log Retention Period Data Sensitivity Data Rate
    Latency 150ms No
    Packet Loss 10% No
    Jitter >1ms No
    Response Time 750ms No
    HAProxy Log 7 days Yes 3GB/day
    DOM Load time 1100ms
    Page Load time 1200ms
    User Access 3 years Yes

    Download the Event Management Catalog

    Input

    • List of events generated by event management
    • List of compliance standards your organization adheres to

    Output

    • Data policy for every event monitored and actioned

    Materials

    • Whiteboard/flip charts
    • Pens
    • Paper

    Participants

    • Event management team
    • Infrastructure team

    Step 3.2

    Set Your Future of Event Monitoring

    Activities

    3.2.1 Build your roadmap

    Start Monitoring and Implement Event Management

    This step will walk you through the following activities:

    Event management maturity is slowly built over time. Define your future actions in a roadmap to stay on track.

    This step involves the following participants:

    CIO

    Infrastructure manager

    IT managers

    Outcomes of this step

    Event management roadmap and action items

    Practice makes perfect

    For every event that generates an alert, you want to judge the predictive power of said event.

    Engineer your event management practice to be predictive. For example:

    • Up/Down Alert – Expected Consequence: Service desk will start working on the incident ticket before a user reports that said system has gone down.
    • SysVol Capacity Alert – Expected Consequence: Change will be made to free up space on the volume prior to the system crashing.

    If the expected consequence is not observed there are three places to look:

    1. Was the alert received by the right person?
    2. Was the alert received in enough time to do something?
    3. Did the event triggering the alert have a causative relationship with the consequence?

    While impractical to look at every action resulting from an alert, a regular review process will help improve your process. Effective alerts are crafted with specific and measurable outcomes.

    Info-Tech Insight

    False positives are worse than missed positives as they undermine confidence in the entire process from stakeholders and operators. If you need a starting point, action your false positives first.

    Mind Your Event Management Errors

    Two Donut charts are depicted. The first has a slice which is labeled 7% False Positive. The Second has a slice which is labeled 33% False Negative.

    Source: IEEE Communications Magazine March 2012

    Follow the Cookbook for every event you start tracking

    Consider building event management into new, onboarded systems as well.

    You now have several core systems, their CIs, conditions, and their related events listed in the Event Catalog. Keep the Catalog as your single reference point to help manage your tracked events across multiple tools.

    The Event Management Cookbook is designed to be used over and over. Keep your tracked events standard by running through the steps in the Cookbook.

    An additional step you could take is to pull the Cookbook out for event tracking for each new system added to your IT environment. Adding events in the Catalog during application onboarding is a good way to manage and measure configuration.

    Event Management Cookbook

    This is a screenshot of the Event Management Cookbook

    Use the framework in the Event Management Cookbook to populate your event catalog with properly tracked and actioned events.

    3.2.1 Build an event management roadmap

    Increase your event management maturity over time by documenting your goals.

    Add the following in-scope goals for future improvement. Include owner, timeline, progress, and priority.

    • Add additional systems/applications/services to event management
    • Expand condition lists for given systems
    • Consolidate tracking tools for easier data analysis and actioning
    • Integrate event management with additional service management practices

    This image contains a screenshot of a sample Event Management Roadmap

    Summary of Accomplishment

    Problem Solved

    You now have a structured event management process with a start on a properly tracked and actioned event catalog. This will help you detect incidents before they become incidents, changes needed to the IT environment, and problems before they spread.

    Continue to use the Event Management Cookbook to add new monitored events to your Event Catalog. This ensures future events will be held to the same or better standard, which allows you to avoid drowning in too much data.

    Lastly, stay on track and continually mature your event management practice using your Event Management Roadmap.

    If you would like additional support, have our analysts guide you through other phases as part of an Info-Tech workshop

    Contact your account representative for more information

    workshops@infotech.com

    1-888-670-8889

    Additional Support

    If you would like additional support, have our analysts guide you through other phases as part of an Info-Tech Workshop.

    To accelerate this project, engage your IT team in an Info-Tech workshop with an Info-Tech analyst team.

    Info-Tech analysts will join you and your team at your location or welcome you to Info-Tech’s historic Toronto office to participate in an innovative onsite workshop.

    Contact your account representative for more information.
    workshops@infotech.com 1-888-670-8889

    The following are sample activities that will be conducted by Info-Tech analysts with your team:

    This is an example of a RACI Chart for Event Management

    Build a RACI Chart for Event Management

    Define and document the roles and responsibilities in event management.

    This is an example of a business impact chart

    Set Your Scope Using Business Impact

    Define and prioritize in-scope systems and services for event management.

    Related Info-Tech Research

    Standardize the Service Desk

    Improve customer service by driving consistency in your support approach and meeting SLAs.

    Improve Incident and Problem Management

    Don’t let persistent problems govern your department

    Harness Configuration Management Superpowers

    Build a service configuration management practice around the IT services that are most important to the organization.

    Select Bibliography

    DeMattia, Adam. “Assessing the Financial Impact of HPE InfoSight Predictive Analytics.” ESG, Softchoice, Sept. 2017. Web.

    Hale, Brad. “Estimating Log Generation for Security Information Event and Log Management.” SolarWinds, n.d. Web.

    Ho, Cheng-Yuan, et al. “Statistical Analysis of False Positives and False Negatives from Real Traffic with Intrusion Detection/Prevention Systems.” IEEE Communications Magazine, vol. 50, no. 3, 2012, pp. 146-154.

    ITIL Foundation ITIL 4 Edition = ITIL 4. The Stationery Office, 2019.

    McGillicuddy, Shamus. “EMA: Network Management Megatrends 2016.” Riverbed, April 2016. Web.

    McGillicuddy, Shamus. “Network Management Megatrends 2020.” Enterprise Management Associates, APCON, 2020. Web.

    Rivas, Genesis. “Event Management: Everything You Need to Know about This ITIL Process.” GB Advisors, 22 Feb. 2021. Web.

    “Service Operations Processes.” ITIL Version 3 Chapters, 21 May 2010. Web.
